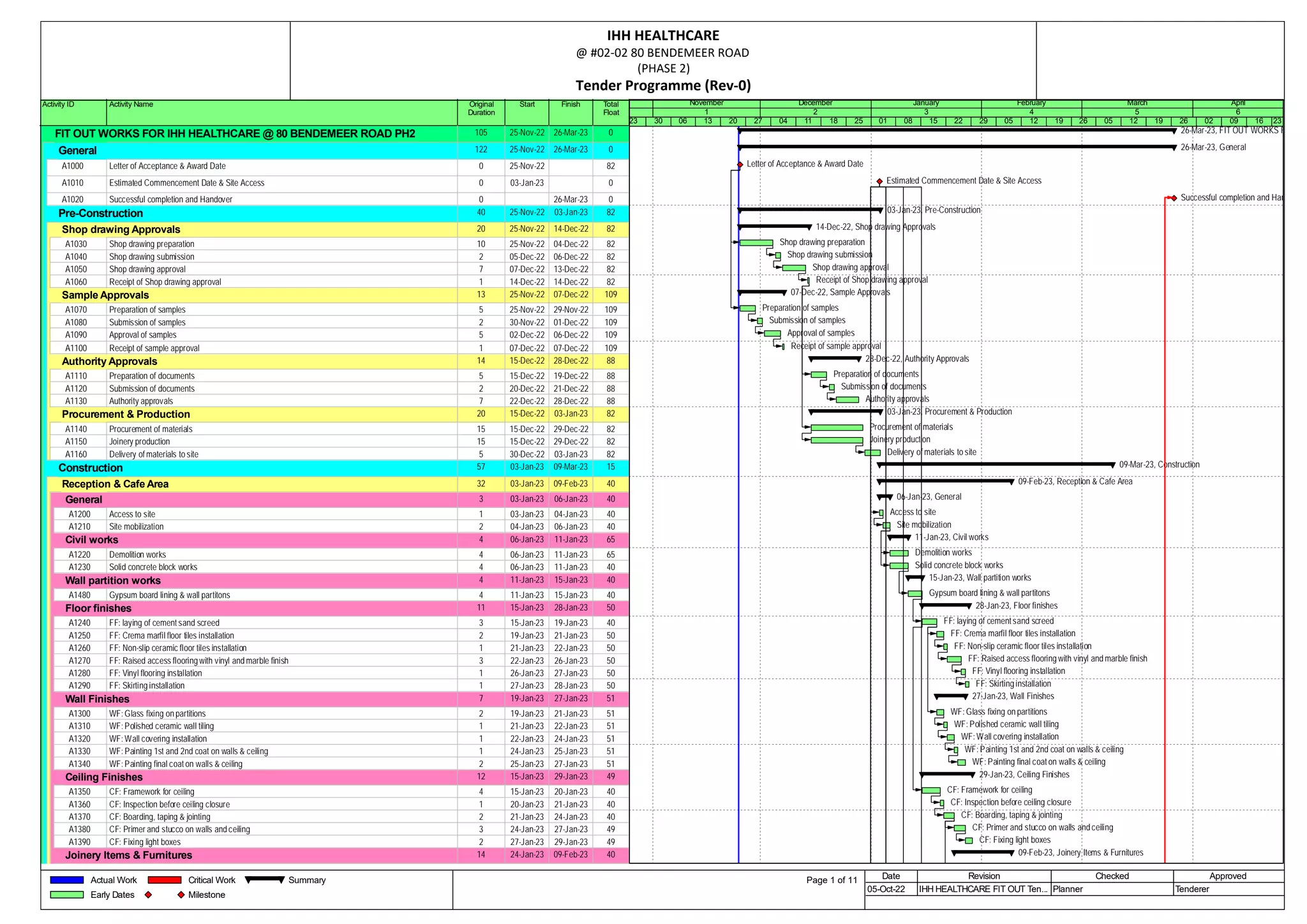

Activity ID Activity Name Original
Duration
Start Finish Total
Float
FIT OUT W
FIT OUT WORKS FOR IHH HEALTHCARE @ 80 BENDEMEER ROAD PH2 105 25-Nov-22 26-Mar-23 0
General
General 122 25-Nov-22 26-Mar-23 0
A1000 Letter of Acceptance & Award Date 0 25-Nov-22 82
A1010 Estimated Commencement Date & Site Access 0 03-Jan-23 0
A1020 Successful completion and Handover 0 26-Mar-23 0
Pre-Con
Pre-Construction 40 25-Nov-22 03-Jan-23 82
Shop dr
Shop drawing Approvals 20 25-Nov-22 14-Dec-22 82
A1030 Shop drawing preparation 10 25-Nov-22 04-Dec-22 82
A1040 Shop drawing submission 2 05-Dec-22 06-Dec-22 82
A1050 Shop drawing approval 7 07-Dec-22 13-Dec-22 82
A1060 Receipt of Shop drawing approval 1 14-Dec-22 14-Dec-22 82
Sample
Sample Approvals 13 25-Nov-22 07-Dec-22 109
A1070 Preparation of samples 5 25-Nov-22 29-Nov-22 109
A1080 Submission of samples 2 30-Nov-22 01-Dec-22 109
A1090 Approval of samples 5 02-Dec-22 06-Dec-22 109
A1100 Receipt of sample approval 1 07-Dec-22 07-Dec-22 109
Authorit
Authority Approvals 14 15-Dec-22 28-Dec-22 88
A1110 Preparation of documents 5 15-Dec-22 19-Dec-22 88
A1120 Submission of documents 2 20-Dec-22 21-Dec-22 88
A1130 Authority approvals 7 22-Dec-22 28-Dec-22 88
Procure
Procurement & Production 20 15-Dec-22 03-Jan-23 82
A1140 Procurement of materials 15 15-Dec-22 29-Dec-22 82
A1150 Joinery production 15 15-Dec-22 29-Dec-22 82
A1160 Delivery of materials to site 5 30-Dec-22 03-Jan-23 82
Construc
Construction 57 03-Jan-23 09-Mar-23 15
Receptio
Reception & Cafe Area 32 03-Jan-23 09-Feb-23 40
General
General 3 03-Jan-23 06-Jan-23 40
A1200 Access to site 1 03-Jan-23 04-Jan-23 40
A1210 Site mobilization 2 04-Jan-23 06-Jan-23 40
Civil wo
Civil works 4 06-Jan-23 11-Jan-23 65
A1220 Demolition works 4 06-Jan-23 11-Jan-23 65
A1230 Solid concrete block works 4 06-Jan-23 11-Jan-23 40
Wall pa
Wall partition works 4 11-Jan-23 15-Jan-23 40
A1480 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40
Floor fi
Floor finishes 11 15-Jan-23 28-Jan-23 50
A1240 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40
A1250 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50
A1260 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50
A1270 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50
A1280 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50
A1290 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50
Wall Fin
Wall Finishes 7 19-Jan-23 27-Jan-23 51
A1300 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51
A1310 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51
A1320 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51
A1330 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51
A1340 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51
Ceiling
Ceiling Finishes 12 15-Jan-23 29-Jan-23 49
A1350 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40
A1360 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40
A1370 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40
A1380 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49
A1390 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49
Joinery
Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
26-Mar-23, FIT OUT WORKS F
26-Mar-23, General
Letter of Acceptance & Award Date
Estimated Commencement Date & Site Access
Successful completion and Han
03-Jan-23, Pre-Construction
14-Dec-22, Shop drawing Approvals
Shop drawing preparation
Shop drawing submission
Shop drawing approval
Receipt of Shop drawing approval
07-Dec-22, Sample Approvals
Preparation of samples
Submission of samples
Approval of samples
Receipt of sample approval
28-Dec-22, Authority Approvals
Preparation of documents
Submission of documents
Authority approvals
03-Jan-23, Procurement & Production
Procurement of materials
Joinery production
Delivery of materials to site
09-Mar-23, Construction
09-Feb-23, Reception & Cafe Area
06-Jan-23, General
Access to site
Site mobilization
11-Jan-23, Civil works
Demolition works
Solid concrete block works
15-Jan-23, Wall partition works
Gypsum board lining & wall partitons
28-Jan-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
27-Jan-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
29-Jan-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
09-Feb-23, Joinery Items & Furnitures
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 1 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer

Activity ID Activity Name Original
Duration
Start Finish Total
Float
A1400 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40
A1410 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40
A1420 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40
A1490 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40
Patient
Patient Room 37 03-Jan-23 15-Feb-23 35
Patient
Patient Room 1 (226 Sf) 32 03-Jan-23 09-Feb-23 40
Genera
General 3 03-Jan-23 06-Jan-23 40
A1500 Access to site 1 03-Jan-23 04-Jan-23 40
A1510 Site mobilization 2 04-Jan-23 06-Jan-23 40
Civil w
Civil works 4 06-Jan-23 11-Jan-23 65
A1520 Demolition works 4 06-Jan-23 11-Jan-23 65
A1530 Solid concrete block works 4 06-Jan-23 11-Jan-23 40
Wall pa
Wall partition works 4 11-Jan-23 15-Jan-23 40
A1730 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40
Floor f
Floor finishes 11 15-Jan-23 28-Jan-23 50
A1540 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40
A1550 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50
A1560 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50
A1570 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50
A1580 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50
A1590 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50
Wall F
Wall Finishes 7 19-Jan-23 27-Jan-23 51
A1600 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51
A1610 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51
A1620 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51
A1630 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51
A1640 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51
Ceiling
Ceiling Finishes 12 15-Jan-23 29-Jan-23 49
A1650 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40
A1660 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40
A1670 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40
A1680 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49
A1690 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49
Joiner
Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40
A1700 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40
A1710 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40
A1720 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40
A1740 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40
Patient
Patient Room 2 (226 Sf) 37 03-Jan-23 15-Feb-23 35
Genera
General 8 03-Jan-23 12-Jan-23 35
A1750 Access to site 4 03-Jan-23 07-Jan-23 35
A1760 Site mobilization 4 07-Jan-23 12-Jan-23 35
Civil w
Civil works 4 12-Jan-23 17-Jan-23 60
A1770 Demolition works 4 12-Jan-23 17-Jan-23 60
A1780 Solid concrete block works 4 12-Jan-23 17-Jan-23 35
Wall pa
Wall partition works 4 17-Jan-23 21-Jan-23 35
A1980 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35
Floor f
Floor finishes 11 21-Jan-23 03-Feb-23 45
A1790 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35
A1800 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45
A1810 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45
A1820 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45
A1830 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45
A1840 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45
Wall F
Wall Finishes 7 25-Jan-23 02-Feb-23 46
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
15-Feb-23, Patient Room
09-Feb-23, Patient Room 1 (226 Sf)
06-Jan-23, General
Access to site
Site mobilization
11-Jan-23, Civil works
Demolition works
Solid concrete block works
15-Jan-23, Wall partition works
Gypsum board lining & wall partitons
28-Jan-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
27-Jan-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
29-Jan-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
09-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
15-Feb-23, Patient Room 2 (226 Sf)
12-Jan-23, General
Access to site
Site mobilization
17-Jan-23, Civil works
Demolition works
Solid concrete block works
21-Jan-23, Wall partition works
Gypsum board lining & wall partitons
03-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
02-Feb-23, Wall Finishes
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 2 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
A1850 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46
A1860 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46
A1870 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46
A1880 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46
A1890 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46
Ceiling
Ceiling Finishes 12 21-Jan-23 04-Feb-23 44
A1900 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35
A1910 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35
A1920 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35
A1930 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44
A1940 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44
Joiner
Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35
A1950 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35
A1960 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35
A1970 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35
A1990 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35
Waiting
Waiting Lounge / Library 32 03-Jan-23 09-Feb-23 40
General
General 3 03-Jan-23 06-Jan-23 40
A2000 Access to site 1 03-Jan-23 04-Jan-23 40
A2010 Site mobilization 2 04-Jan-23 06-Jan-23 40
Civil wo
Civil works 4 06-Jan-23 11-Jan-23 65
A2020 Demolition works 4 06-Jan-23 11-Jan-23 65
A2030 Solid concrete block works 4 06-Jan-23 11-Jan-23 40
Wall pa
Wall partition works 4 11-Jan-23 15-Jan-23 40
A2230 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40
Floor fi
Floor finishes 11 15-Jan-23 28-Jan-23 50
A2040 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40
A2050 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50
A2060 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50
A2070 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50
A2080 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50
A2090 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50
Wall Fin
Wall Finishes 7 19-Jan-23 27-Jan-23 51
A2100 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51
A2110 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51
A2120 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51
A2130 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51
A2140 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51
Ceiling
Ceiling Finishes 12 15-Jan-23 29-Jan-23 49
A2150 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40
A2160 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40
A2170 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40
A2180 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49
A2190 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49
Joinery
Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40
A2200 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40
A2210 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40
A2220 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40
A2240 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40
Training
Training Rooms 39 03-Jan-23 17-Feb-23 33
Training
Training Room 1 (26p) 34 03-Jan-23 11-Feb-23 38
Genera
General 5 03-Jan-23 08-Jan-23 38
A2250 Access to site 1 03-Jan-23 04-Jan-23 38
A2260 Site mobilization 4 04-Jan-23 08-Jan-23 38
Civil w
Civil works 4 08-Jan-23 13-Jan-23 63
A2270 Demolition works 4 08-Jan-23 13-Jan-23 63
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
04-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
15-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
09-Feb-23, Waiting Lounge / Library
06-Jan-23, General
Access to site
Site mobilization
11-Jan-23, Civil works
Demolition works
Solid concrete block works
15-Jan-23, Wall partition works
Gypsum board lining & wall partitons
28-Jan-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
27-Jan-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
29-Jan-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
09-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
17-Feb-23, Training Rooms
11-Feb-23, Training Room 1 (26p)
08-Jan-23, General
Access to site
Site mobilization
13-Jan-23, Civil works
Demolition works

IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 3 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
A2280 Solid concrete block works 4 08-Jan-23 13-Jan-23 38
Wall pa
Wall partition works 4 13-Jan-23 18-Jan-23 38
A2480 Gypsum board lining & wall partitons 4 13-Jan-23 18-Jan-23 38
Floor f
Floor finishes 11 18-Jan-23 31-Jan-23 48
A2290 FF: laying of cement sand screed 3 18-Jan-23 21-Jan-23 38
A2300 FF: Crema marfil floor tiles installation 2 21-Jan-23 24-Jan-23 48
A2310 FF: Non-slip ceramic floor tiles installation 1 24-Jan-23 25-Jan-23 48
A2320 FF: Raised access flooring with vinyl and marble finish 3 25-Jan-23 28-Jan-23 48
A2330 FF: Vinyl flooring installation 1 28-Jan-23 29-Jan-23 48
A2340 FF: Skirting installation 1 29-Jan-23 31-Jan-23 48
Wall F
Wall Finishes 7 21-Jan-23 29-Jan-23 49
A2350 WF: Glass fixing on partitions 2 21-Jan-23 24-Jan-23 49
A2360 WF: Polished ceramic wall tiling 1 24-Jan-23 25-Jan-23 49
A2370 WF: Wall covering installation 1 25-Jan-23 26-Jan-23 49
A2380 WF: Painting 1st and 2nd coat on walls & ceiling 1 26-Jan-23 27-Jan-23 49
A2390 WF: Painting final coat on walls & ceiling 2 27-Jan-23 29-Jan-23 49
Ceiling
Ceiling Finishes 12 18-Jan-23 01-Feb-23 47
A2400 CF: Framework for ceiling 4 18-Jan-23 22-Jan-23 38
A2410 CF: Inspection before ceiling closure 1 22-Jan-23 24-Jan-23 38
A2420 CF: Boarding, taping & jointing 2 24-Jan-23 26-Jan-23 38
A2430 CF: Primer and stucco on walls and ceiling 3 26-Jan-23 29-Jan-23 47
A2440 CF: Fixing light boxes 2 29-Jan-23 01-Feb-23 47
Joiner
Joinery Items & Furnitures 14 26-Jan-23 11-Feb-23 38
A2450 JI: Door frames installation 3 26-Jan-23 29-Jan-23 38
A2460 JI: Door panels & ironmongaries installaiton 3 29-Jan-23 02-Feb-23 38
A2470 JI:Dry pantry cabinets installation 3 02-Feb-23 05-Feb-23 38
A2490 Lockers & Furnitures, cabinets installation 5 05-Feb-23 11-Feb-23 38
Training
Training Room 2 (26p) 37 03-Jan-23 15-Feb-23 35
Genera
General 8 03-Jan-23 12-Jan-23 35
A2500 Access to site 4 03-Jan-23 07-Jan-23 35
A2510 Site mobilization 4 07-Jan-23 12-Jan-23 35
Civil w
Civil works 4 12-Jan-23 17-Jan-23 60
A2520 Demolition works 4 12-Jan-23 17-Jan-23 60
A2530 Solid concrete block works 4 12-Jan-23 17-Jan-23 35
Wall pa
Wall partition works 4 17-Jan-23 21-Jan-23 35
A2730 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35
Floor f
Floor finishes 11 21-Jan-23 03-Feb-23 45
A2540 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35
A2550 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45
A2560 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45
A2570 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45
A2580 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45
A2590 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45
Wall F
Wall Finishes 7 25-Jan-23 02-Feb-23 46
A2600 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46
A2610 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46
A2620 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46
A2630 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46
A2640 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46
Ceiling
Ceiling Finishes 12 21-Jan-23 04-Feb-23 44
A2650 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35
A2660 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35
A2670 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35
A2680 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44
A2690 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44
Joiner
Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
Solid concrete block works
18-Jan-23, Wall partition works
Gypsum board lining & wall partitons
31-Jan-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
29-Jan-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
01-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
11-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
15-Feb-23, Training Room 2 (26p)
12-Jan-23, General
Access to site
Site mobilization
17-Jan-23, Civil works
Demolition works
Solid concrete block works
21-Jan-23, Wall partition works
Gypsum board lining & wall partitons
03-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
02-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
04-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
15-Feb-23, Joinery Items & Furnitures
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 4 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original

Duration
Start Finish Total
Float
A2700 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35
A2710 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35
A2720 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35
A2740 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35
Training
Training Room 3 (26p) 37 03-Jan-23 15-Feb-23 35
Genera
General 8 03-Jan-23 12-Jan-23 35
A2750 Access to site 4 03-Jan-23 07-Jan-23 35
A2760 Site mobilization 4 07-Jan-23 12-Jan-23 35
Civil w
Civil works 4 12-Jan-23 17-Jan-23 60
A2770 Demolition works 4 12-Jan-23 17-Jan-23 60
A2780 Solid concrete block works 4 12-Jan-23 17-Jan-23 35
Wall pa

Wall partition works 4 17-Jan-23 21-Jan-23 35
A2980 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35
Floor f
Floor finishes 11 21-Jan-23 03-Feb-23 45
A2790 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35
A2800 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45
A2810 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45
A2820 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45
A2830 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45
A2840 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45
Wall F
Wall Finishes 7 25-Jan-23 02-Feb-23 46
A2850 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46
A2860 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46
A2870 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46
A2880 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46
A2890 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46
Ceiling
Ceiling Finishes 12 21-Jan-23 04-Feb-23 44
A2900 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35
A2910 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35
A2920 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35
A2930 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44
A2940 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44
Joiner
Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35
A2950 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35
A2960 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35
A2970 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35
A2990 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35
Training
Training Room 4 (26p) 39 03-Jan-23 17-Feb-23 33
Genera
General 8 03-Jan-23 12-Jan-23 33
A3000 Access to site 4 03-Jan-23 07-Jan-23 33
A3010 Site mobilization 4 07-Jan-23 12-Jan-23 33
Civil w
Civil works 4 12-Jan-23 17-Jan-23 60
A3020 Demolition works 4 12-Jan-23 17-Jan-23 60
A3030 Solid concrete block works 4 12-Jan-23 17-Jan-23 33
Wall pa
Wall partition works 4 17-Jan-23 21-Jan-23 33
A3230 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 33
Floor f
Floor finishes 11 21-Jan-23 03-Feb-23 45
A3040 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 33
A3050 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45
A3060 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45
A3070 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45
A3080 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45
A3090 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45
Wall F
Wall Finishes 7 25-Jan-23 02-Feb-23 46
A3100 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46
A3110 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
15-Feb-23, Training Room 3 (26p)
12-Jan-23, General
Access to site
Site mobilization
17-Jan-23, Civil works
Demolition works
Solid concrete block works
21-Jan-23, Wall partition works
Gypsum board lining & wall partitons
03-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
02-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
04-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
15-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
17-Feb-23, Training Room 4 (26p)
12-Jan-23, General
Access to site
Site mobilization
17-Jan-23, Civil works
Demolition works
Solid concrete block works
21-Jan-23, Wall partition works
Gypsum board lining & wall partitons
03-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
02-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 5 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float

A3120 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46
A3130 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46
A3140 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46
Ceiling
Ceiling Finishes 12 21-Jan-23 04-Feb-23 44
A3150 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 33
A3160 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 33
A3170 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 33
A3180 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44
A3190 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44
Joiner
Joinery Items & Furnitures 16 29-Jan-23 17-Feb-23 33
A3200 JI: Door frames installation 5 29-Jan-23 04-Feb-23 33
A3210 JI: Door panels & ironmongaries installaiton 3 04-Feb-23 08-Feb-23 33
A3220 JI:Dry pantry cabinets installation 3 08-Feb-23 11-Feb-23 33
A3240 Lockers & Furnitures, cabinets installation 5 11-Feb-23 17-Feb-23 33
Internal
Internal Work Area 41 07-Jan-23 24-Feb-23 26
General
General 8 07-Jan-23 17-Jan-23 26
A3250 Access to site 4 07-Jan-23 12-Jan-23 26
A3260 Site mobilization 4 12-Jan-23 17-Jan-23 26
Civil wo
Civil works 4 17-Jan-23 21-Jan-23 55
A3270 Demolition works 4 17-Jan-23 21-Jan-23 55
A3280 Solid concrete block works 4 17-Jan-23 21-Jan-23 26
Wall pa
Wall partition works 4 21-Jan-23 26-Jan-23 26
A3480 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 26
Floor fi
Floor finishes 11 26-Jan-23 08-Feb-23 40
A3290 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 26
A3300 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40
A3310 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40
A3320 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40
A3330 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40
A3340 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40
Wall Fin
Wall Finishes 7 29-Jan-23 07-Feb-23 41
A3350 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41
A3360 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41
A3370 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41
A3380 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41
A3390 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41
Ceiling
Ceiling Finishes 12 26-Jan-23 09-Feb-23 39
A3400 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 26
A3410 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 26
A3420 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 26
A3430 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39
A3440 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39
Joinery
Joinery Items & Furnitures 18 03-Feb-23 24-Feb-23 26
A3450 JI: Door frames installation 5 03-Feb-23 09-Feb-23 26
A3460 JI: Door panels & ironmongaries installaiton 4 09-Feb-23 14-Feb-23 26
A3470 JI:Dry pantry cabinets installation 4 14-Feb-23 18-Feb-23 26
A3490 Lockers & Furnitures, cabinets installation 5 18-Feb-23 24-Feb-23 26
Training
Training Labs 37 07-Jan-23 19-Feb-23 30
Training
Training Lab1 (16-20pax) 37 07-Jan-23 19-Feb-23 30
Genera
General 8 07-Jan-23 17-Jan-23 30
A4750 Access to site 4 07-Jan-23 12-Jan-23 30
A4760 Site mobilization 4 12-Jan-23 17-Jan-23 30
Civil w
Civil works 4 17-Jan-23 21-Jan-23 55
A4770 Demolition works 4 17-Jan-23 21-Jan-23 55
A4780 Solid concrete block works 4 17-Jan-23 21-Jan-23 30
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
04-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
17-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
24-Feb-23, Internal Work Area
17-Jan-23, General
Access to site
Site mobilization
21-Jan-23, Civil works
Demolition works
Solid concrete block works
26-Jan-23, Wall partition works
Gypsum board lining & wall partitons
08-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
07-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
09-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
24-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
19-Feb-23, Training Labs
19-Feb-23, Training Lab1 (16-20pax)
17-Jan-23, General
Access to site
Site mobilization
21-Jan-23, Civil works
Demolition works
Solid concrete block works
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 6 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
Wall pa
Wall partition works 4 21-Jan-23 26-Jan-23 30
A4980 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30
Floor f
Floor finishes 11 26-Jan-23 08-Feb-23 40
A4790 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30
A4800 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40
A4810 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40
A4820 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40
A4830 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40
A4840 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40
Wall F
Wall Finishes 7 29-Jan-23 07-Feb-23 41
A4850 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41
A4860 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41
A4870 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41
A4880 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41
A4890 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41
Ceiling
Ceiling Finishes 12 26-Jan-23 09-Feb-23 39
A4900 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30
A4910 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30
A4920 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30
A4930 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39
A4940 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39
Joiner
Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30
A4950 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30
A4960 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30
A4970 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30
A4990 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30
Training
Training Lab2 (16-20pax) 37 07-Jan-23 19-Feb-23 30
Genera
General 8 07-Jan-23 17-Jan-23 30
A5000 Access to site 4 07-Jan-23 12-Jan-23 30
A5010 Site mobilization 4 12-Jan-23 17-Jan-23 30
Civil w
Civil works 4 17-Jan-23 21-Jan-23 55
A5020 Demolition works 4 17-Jan-23 21-Jan-23 55
A5030 Solid concrete block works 4 17-Jan-23 21-Jan-23 30
Wall pa
Wall partition works 4 21-Jan-23 26-Jan-23 30
A5230 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30
Floor f
Floor finishes 11 26-Jan-23 08-Feb-23 40
A5040 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30
A5050 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40
A5060 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40
A5070 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40
A5080 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40
A5090 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40
Wall F
Wall Finishes 7 29-Jan-23 07-Feb-23 41
A5100 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41
A5110 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41
A5120 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41
A5130 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41
A5140 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41
Ceiling
Ceiling Finishes 12 26-Jan-23 09-Feb-23 39
A5150 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30
A5160 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30
A5170 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30
A5180 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39
A5190 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39
Joiner
Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30
A5200 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
26-Jan-23, Wall partition works
Gypsum board lining & wall partitons
08-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
07-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
09-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
19-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
19-Feb-23, Training Lab2 (16-20pax)
17-Jan-23, General
Access to site
Site mobilization
21-Jan-23, Civil works
Demolition works
Solid concrete block works
26-Jan-23, Wall partition works
Gypsum board lining & wall partitons
08-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
07-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
09-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
19-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 7 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
A5210 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30
A5220 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30
A5240 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30
Meeting
Meeting Rooms 37 07-Jan-23 19-Feb-23 30
General
General 8 07-Jan-23 17-Jan-23 30
A3500 Access to site 4 07-Jan-23 12-Jan-23 30
A3510 Site mobilization 4 12-Jan-23 17-Jan-23 30
Civil wo
Civil works 4 17-Jan-23 21-Jan-23 55
A3520 Demolition works 4 17-Jan-23 21-Jan-23 55
A3530 Solid concrete block works 4 17-Jan-23 21-Jan-23 30
Wall pa
Wall partition works 4 21-Jan-23 26-Jan-23 30
A3730 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30
Floor fi
Floor finishes 11 26-Jan-23 08-Feb-23 40
A3540 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30
A3550 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40
A3560 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40
A3570 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40
A3580 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40
A3590 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40
Wall Fin
Wall Finishes 7 29-Jan-23 07-Feb-23 41
A3600 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41
A3610 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41
A3620 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41
A3630 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41
A3640 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41
Ceiling
Ceiling Finishes 12 26-Jan-23 09-Feb-23 39
A3650 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30
A3660 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30
A3670 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30
A3680 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39
A3690 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39
Joinery
Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30
A3700 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30
A3710 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30
A3720 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30
A3740 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30
Flexi Hu
Flexi Hubs 41 12-Jan-23 01-Mar-23 22
General
General 8 12-Jan-23 21-Jan-23 22
A3750 Access to site 4 12-Jan-23 17-Jan-23 22
A3760 Site mobilization 4 17-Jan-23 21-Jan-23 22
Civil wo
Civil works 4 21-Jan-23 26-Jan-23 51
A3770 Demolition works 4 21-Jan-23 26-Jan-23 51
A3780 Solid concrete block works 4 21-Jan-23 26-Jan-23 22
Wall pa
Wall partition works 4 26-Jan-23 31-Jan-23 22
A3980 Gypsum board lining & wall partitons 4 26-Jan-23 31-Jan-23 22
Floor fi
Floor finishes 11 31-Jan-23 12-Feb-23 36
A3790 FF: laying of cement sand screed 3 31-Jan-23 03-Feb-23 22
A3800 FF: Crema marfil floor tiles installation 2 03-Feb-23 05-Feb-23 36
A3810 FF: Non-slip ceramic floor tiles installation 1 05-Feb-23 07-Feb-23 36
A3820 FF: Raised access flooring with vinyl and marble finish 3 07-Feb-23 10-Feb-23 36
A3830 FF: Vinyl flooring installation 1 10-Feb-23 11-Feb-23 36
A3840 FF: Skirting installation 1 11-Feb-23 12-Feb-23 36
Wall Fin
Wall Finishes 7 03-Feb-23 11-Feb-23 37
A3850 WF: Glass fixing on partitions 2 03-Feb-23 05-Feb-23 37
A3860 WF: Polished ceramic wall tiling 1 05-Feb-23 07-Feb-23 37
A3870 WF: Wall covering installation 1 07-Feb-23 08-Feb-23 37
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
19-Feb-23, Meeting Rooms
17-Jan-23, General
Access to site
Site mobilization
21-Jan-23, Civil works
Demolition works
Solid concrete block works
26-Jan-23, Wall partition works
Gypsum board lining & wall partitons
08-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
07-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
09-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
19-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
01-Mar-23, Flexi Hubs
21-Jan-23, General
Access to site
Site mobilization
26-Jan-23, Civil works
Demolition works
Solid concrete block works
31-Jan-23, Wall partition works
Gypsum board lining & wall partitons
12-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
11-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 8 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
A3880 WF: Painting 1st and 2nd coat on walls & ceiling 1 08-Feb-23 09-Feb-23 37
A3890 WF: Painting final coat on walls & ceiling 2 09-Feb-23 11-Feb-23 37
Ceiling
Ceiling Finishes 12 31-Jan-23 14-Feb-23 35
A3900 CF: Framework for ceiling 4 31-Jan-23 04-Feb-23 22
A3910 CF: Inspection before ceiling closure 1 04-Feb-23 05-Feb-23 22
A3920 CF: Boarding, taping & jointing 2 05-Feb-23 08-Feb-23 22
A3930 CF: Primer and stucco on walls and ceiling 3 08-Feb-23 11-Feb-23 35
A3940 CF: Fixing light boxes 2 11-Feb-23 14-Feb-23 35
Joinery
Joinery Items & Furnitures 18 08-Feb-23 01-Mar-23 22
A3950 JI: Door frames installation 5 08-Feb-23 14-Feb-23 22
A3960 JI: Door panels & ironmongaries installaiton 4 14-Feb-23 18-Feb-23 22
A3970 JI:Dry pantry cabinets installation 4 18-Feb-23 23-Feb-23 22
A3990 Lockers & Furnitures, cabinets installation 5 23-Feb-23 01-Mar-23 22
Patch R
Patch Room 37 12-Jan-23 24-Feb-23 26
General
General 8 12-Jan-23 21-Jan-23 26
A4000 Access to site 4 12-Jan-23 17-Jan-23 26
A4010 Site mobilization 4 17-Jan-23 21-Jan-23 26
Civil wo
Civil works 4 21-Jan-23 26-Jan-23 51
A4020 Demolition works 4 21-Jan-23 26-Jan-23 51
A4030 Solid concrete block works 4 21-Jan-23 26-Jan-23 26
Wall pa
Wall partition works 4 26-Jan-23 31-Jan-23 26
A4230 Gypsum board lining & wall partitons 4 26-Jan-23 31-Jan-23 26
Floor fi
Floor finishes 11 31-Jan-23 12-Feb-23 36
A4040 FF: laying of cement sand screed 3 31-Jan-23 03-Feb-23 26
A4050 FF: Crema marfil floor tiles installation 2 03-Feb-23 05-Feb-23 36
A4060 FF: Non-slip ceramic floor tiles installation 1 05-Feb-23 07-Feb-23 36
A4070 FF: Raised access flooring with vinyl and marble finish 3 07-Feb-23 10-Feb-23 36
A4080 FF: Vinyl flooring installation 1 10-Feb-23 11-Feb-23 36
A4090 FF: Skirting installation 1 11-Feb-23 12-Feb-23 36
Wall Fin
Wall Finishes 7 03-Feb-23 11-Feb-23 37
A4100 WF: Glass fixing on partitions 2 03-Feb-23 05-Feb-23 37
A4110 WF: Polished ceramic wall tiling 1 05-Feb-23 07-Feb-23 37
A4120 WF: Wall covering installation 1 07-Feb-23 08-Feb-23 37
A4130 WF: Painting 1st and 2nd coat on walls & ceiling 1 08-Feb-23 09-Feb-23 37
A4140 WF: Painting final coat on walls & ceiling 2 09-Feb-23 11-Feb-23 37
Ceiling
Ceiling Finishes 12 31-Jan-23 14-Feb-23 35
A4150 CF: Framework for ceiling 4 31-Jan-23 04-Feb-23 26
A4160 CF: Inspection before ceiling closure 1 04-Feb-23 05-Feb-23 26
A4170 CF: Boarding, taping & jointing 2 05-Feb-23 08-Feb-23 26
A4180 CF: Primer and stucco on walls and ceiling 3 08-Feb-23 11-Feb-23 35
A4190 CF: Fixing light boxes 2 11-Feb-23 14-Feb-23 35
Joinery
Joinery Items & Furnitures 14 08-Feb-23 24-Feb-23 26
A4200 JI: Door frames installation 3 08-Feb-23 11-Feb-23 26
A4210 JI: Door panels & ironmongaries installaiton 3 11-Feb-23 15-Feb-23 26
A4220 JI:Dry pantry cabinets installation 3 15-Feb-23 18-Feb-23 26
A4240 Lockers & Furnitures, cabinets installation 5 18-Feb-23 24-Feb-23 26
Podcast
Podcast Room 41 17-Jan-23 05-Mar-23 18
General
General 8 17-Jan-23 26-Jan-23 18
A4250 Access to site 4 17-Jan-23 21-Jan-23 18
A4260 Site mobilization 4 21-Jan-23 26-Jan-23 18
Civil wo
Civil works 4 26-Jan-23 31-Jan-23 47
A4270 Demolition works 4 26-Jan-23 31-Jan-23 47
A4280 Solid concrete block works 4 26-Jan-23 31-Jan-23 18
Wall pa
Wall partition works 4 31-Jan-23 04-Feb-23 18
A4480 Gypsum board lining & wall partitons 4 31-Jan-23 04-Feb-23 18
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
14-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
01-Mar-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
24-Feb-23, Patch Room
21-Jan-23, General
Access to site
Site mobilization
26-Jan-23, Civil works
Demolition works
Solid concrete block works
31-Jan-23, Wall partition works
Gypsum board lining & wall partitons
12-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
11-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
14-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
24-Feb-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
05-Mar-23, Podcast Room
26-Jan-23, General
Access to site
Site mobilization
31-Jan-23, Civil works
Demolition works
Solid concrete block works
04-Feb-23, Wall partition works
Gypsum board lining & wall partitons
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 9 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
Floor fi
Floor finishes 11 04-Feb-23 17-Feb-23 32
A4290 FF: laying of cement sand screed 3 04-Feb-23 08-Feb-23 18
A4300 FF: Crema marfil floor tiles installation 2 08-Feb-23 10-Feb-23 32
A4310 FF: Non-slip ceramic floor tiles installation 1 10-Feb-23 11-Feb-23 32
A4320 FF: Raised access flooring with vinyl and marble finish 3 11-Feb-23 15-Feb-23 32
A4330 FF: Vinyl flooring installation 1 15-Feb-23 16-Feb-23 32
A4340 FF: Skirting installation 1 16-Feb-23 17-Feb-23 32
Wall Fin
Wall Finishes 7 08-Feb-23 16-Feb-23 33
A4350 WF: Glass fixing on partitions 2 08-Feb-23 10-Feb-23 33
A4360 WF: Polished ceramic wall tiling 1 10-Feb-23 11-Feb-23 33
A4370 WF: Wall covering installation 1 11-Feb-23 12-Feb-23 33
A4380 WF: Painting 1st and 2nd coat on walls & ceiling 1 12-Feb-23 14-Feb-23 33
A4390 WF: Painting final coat on walls & ceiling 2 14-Feb-23 16-Feb-23 33
Ceiling
Ceiling Finishes 12 04-Feb-23 18-Feb-23 31
A4400 CF: Framework for ceiling 4 04-Feb-23 09-Feb-23 18
A4410 CF: Inspection before ceiling closure 1 09-Feb-23 10-Feb-23 18
A4420 CF: Boarding, taping & jointing 2 10-Feb-23 12-Feb-23 18
A4430 CF: Primer and stucco on walls and ceiling 3 12-Feb-23 16-Feb-23 31
A4440 CF: Fixing light boxes 2 16-Feb-23 18-Feb-23 31
Joinery
Joinery Items & Furnitures 18 12-Feb-23 05-Mar-23 18
A4450 JI: Door frames installation 5 12-Feb-23 18-Feb-23 18
A4460 JI: Door panels & ironmongaries installaiton 4 18-Feb-23 23-Feb-23 18
A4470 JI:Dry pantry cabinets installation 4 23-Feb-23 28-Feb-23 18
A4490 Lockers & Furnitures, cabinets installation 5 28-Feb-23 05-Mar-23 18
Content
Content Creation Room 44 17-Jan-23 09-Mar-23 15
General
General 8 17-Jan-23 26-Jan-23 0
A4500 Access to site 4 17-Jan-23 21-Jan-23 0
A4510 Site mobilization 4 21-Jan-23 26-Jan-23 0
Civil wo
Civil works 4 26-Jan-23 31-Jan-23 47
A4520 Demolition works 4 26-Jan-23 31-Jan-23 47
A4530 Solid concrete block works 4 26-Jan-23 31-Jan-23 0
Wall pa
Wall partition works 4 31-Jan-23 04-Feb-23 0
A4730 Gypsum board lining & wall partitons 4 31-Jan-23 04-Feb-23 0
Floor fi
Floor finishes 11 04-Feb-23 17-Feb-23 32
A4540 FF: laying of cement sand screed 3 04-Feb-23 08-Feb-23 0
A4550 FF: Crema marfil floor tiles installation 2 08-Feb-23 10-Feb-23 32
A4560 FF: Non-slip ceramic floor tiles installation 1 10-Feb-23 11-Feb-23 32
A4570 FF: Raised access flooring with vinyl and marble finish 3 11-Feb-23 15-Feb-23 32
A4580 FF: Vinyl flooring installation 1 15-Feb-23 16-Feb-23 32
A4590 FF: Skirting installation 1 16-Feb-23 17-Feb-23 32
Wall Fin
Wall Finishes 7 08-Feb-23 16-Feb-23 33
A4600 WF: Glass fixing on partitions 2 08-Feb-23 10-Feb-23 33
A4610 WF: Polished ceramic wall tiling 1 10-Feb-23 11-Feb-23 33
A4620 WF: Wall covering installation 1 11-Feb-23 12-Feb-23 33
A4630 WF: Painting 1st and 2nd coat on walls & ceiling 1 12-Feb-23 14-Feb-23 33
A4640 WF: Painting final coat on walls & ceiling 2 14-Feb-23 16-Feb-23 33
Ceiling
Ceiling Finishes 12 04-Feb-23 18-Feb-23 31
A4650 CF: Framework for ceiling 4 04-Feb-23 09-Feb-23 0
A4660 CF: Inspection before ceiling closure 1 09-Feb-23 10-Feb-23 0
A4670 CF: Boarding, taping & jointing 2 10-Feb-23 12-Feb-23 0
A4680 CF: Primer and stucco on walls and ceiling 3 12-Feb-23 16-Feb-23 31
A4690 CF: Fixing light boxes 2 16-Feb-23 18-Feb-23 31
Joinery
Joinery Items & Furnitures 21 12-Feb-23 09-Mar-23 0
A4700 JI: Door frames installation 5 12-Feb-23 18-Feb-23 0
A4710 JI: Door panels & ironmongaries installaiton 5 18-Feb-23 24-Feb-23 0
A4720 JI:Dry pantry cabinets installation 5 24-Feb-23 02-Mar-23 0
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
17-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
16-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
18-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
05-Mar-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
Lockers & Furnitures, cabinets installation
09-Mar-23, Content Creation Room
26-Jan-23, General
Access to site
Site mobilization
31-Jan-23, Civil works
Demolition works
Solid concrete block works
04-Feb-23, Wall partition works
Gypsum board lining & wall partitons
17-Feb-23, Floor finishes
FF: laying of cement sand screed
FF: Crema marfil floor tiles installation
FF: Non-slip ceramic floor tiles installation
FF: Raised access flooring with vinyl and marble finish
FF: Vinyl flooring installation
FF: Skirting installation
16-Feb-23, Wall Finishes
WF: Glass fixing on partitions
WF: Polished ceramic wall tiling
WF: Wall covering installation
WF: Painting 1st and 2nd coat on walls & ceiling
WF: Painting final coat on walls & ceiling
18-Feb-23, Ceiling Finishes
CF: Framework for ceiling
CF: Inspection before ceiling closure
CF: Boarding, taping & jointing
CF: Primer and stucco on walls and ceiling
CF: Fixing light boxes
09-Mar-23, Joinery Items & Furnitures
JI: Door frames installation
JI: Door panels & ironmongaries installaiton
JI:Dry pantry cabinets installation
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 10 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
Activity ID Activity Name Original
Duration
Start Finish Total
Float
A4740 Lockers & Furnitures, cabinets installation 6 02-Mar-23 09-Mar-23 0
Snaggin
Snagging & Handover 17 10-Mar-23 26-Mar-23 0
A1170 Snagging works 10 10-Mar-23 19-Mar-23 0
A1180 Final inspection by client 6 20-Mar-23 25-Mar-23 0
A1190 Client possession & Handover 1 26-Mar-23 26-Mar-23 0
23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23
1 2 3 4 5 6
November December January February March April
Lockers & Furnitures, cabinets installation
26-Mar-23, Snagging & Handov
Snagging works
Final inspection by client
Client possession & Handover
IHH HEALTHCARE
@ #02‐02 80 BENDEMEER ROAD
(PHASE 2)
Tender Programme (Rev‐0)
Actual Work
Early Dates
Critical Work
Milestone
Summary Page 11 of 11 Date Revision Checked Approved
05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer

IHH Healthcare Tender Programme.pdf

  • 1.
    Activity ID ActivityName Original Duration Start Finish Total Float FIT OUT W FIT OUT WORKS FOR IHH HEALTHCARE @ 80 BENDEMEER ROAD PH2 105 25-Nov-22 26-Mar-23 0 General General 122 25-Nov-22 26-Mar-23 0 A1000 Letter of Acceptance & Award Date 0 25-Nov-22 82 A1010 Estimated Commencement Date & Site Access 0 03-Jan-23 0 A1020 Successful completion and Handover 0 26-Mar-23 0 Pre-Con Pre-Construction 40 25-Nov-22 03-Jan-23 82 Shop dr Shop drawing Approvals 20 25-Nov-22 14-Dec-22 82 A1030 Shop drawing preparation 10 25-Nov-22 04-Dec-22 82 A1040 Shop drawing submission 2 05-Dec-22 06-Dec-22 82 A1050 Shop drawing approval 7 07-Dec-22 13-Dec-22 82 A1060 Receipt of Shop drawing approval 1 14-Dec-22 14-Dec-22 82 Sample Sample Approvals 13 25-Nov-22 07-Dec-22 109 A1070 Preparation of samples 5 25-Nov-22 29-Nov-22 109 A1080 Submission of samples 2 30-Nov-22 01-Dec-22 109 A1090 Approval of samples 5 02-Dec-22 06-Dec-22 109 A1100 Receipt of sample approval 1 07-Dec-22 07-Dec-22 109 Authorit Authority Approvals 14 15-Dec-22 28-Dec-22 88 A1110 Preparation of documents 5 15-Dec-22 19-Dec-22 88 A1120 Submission of documents 2 20-Dec-22 21-Dec-22 88 A1130 Authority approvals 7 22-Dec-22 28-Dec-22 88 Procure Procurement & Production 20 15-Dec-22 03-Jan-23 82 A1140 Procurement of materials 15 15-Dec-22 29-Dec-22 82 A1150 Joinery production 15 15-Dec-22 29-Dec-22 82 A1160 Delivery of materials to site 5 30-Dec-22 03-Jan-23 82 Construc Construction 57 03-Jan-23 09-Mar-23 15 Receptio Reception & Cafe Area 32 03-Jan-23 09-Feb-23 40 General General 3 03-Jan-23 06-Jan-23 40 A1200 Access to site 1 03-Jan-23 04-Jan-23 40 A1210 Site mobilization 2 04-Jan-23 06-Jan-23 40 Civil wo Civil works 4 06-Jan-23 11-Jan-23 65 A1220 Demolition works 4 06-Jan-23 11-Jan-23 65 A1230 Solid concrete block works 4 06-Jan-23 11-Jan-23 40 Wall pa Wall partition works 4 11-Jan-23 15-Jan-23 40 A1480 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40 Floor fi Floor finishes 11 15-Jan-23 28-Jan-23 50 A1240 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40 A1250 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50 A1260 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50 A1270 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50 A1280 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50 A1290 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50 Wall Fin Wall Finishes 7 19-Jan-23 27-Jan-23 51 A1300 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51 A1310 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51 A1320 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51 A1330 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51 A1340 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51 Ceiling Ceiling Finishes 12 15-Jan-23 29-Jan-23 49 A1350 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40 A1360 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40 A1370 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40 A1380 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49 A1390 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49 Joinery Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April 26-Mar-23, FIT OUT WORKS F 26-Mar-23, General Letter of Acceptance & Award Date Estimated Commencement Date & Site Access Successful completion and Han 03-Jan-23, Pre-Construction 14-Dec-22, Shop drawing Approvals Shop drawing preparation Shop drawing submission Shop drawing approval Receipt of Shop drawing approval 07-Dec-22, Sample Approvals Preparation of samples Submission of samples Approval of samples Receipt of sample approval 28-Dec-22, Authority Approvals Preparation of documents Submission of documents Authority approvals 03-Jan-23, Procurement & Production Procurement of materials Joinery production Delivery of materials to site 09-Mar-23, Construction 09-Feb-23, Reception & Cafe Area 06-Jan-23, General Access to site Site mobilization 11-Jan-23, Civil works Demolition works Solid concrete block works 15-Jan-23, Wall partition works Gypsum board lining & wall partitons 28-Jan-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 27-Jan-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 29-Jan-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 09-Feb-23, Joinery Items & Furnitures IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 1 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 2.
    Activity ID ActivityName Original Duration Start Finish Total Float A1400 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40 A1410 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40 A1420 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40 A1490 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40 Patient Patient Room 37 03-Jan-23 15-Feb-23 35 Patient Patient Room 1 (226 Sf) 32 03-Jan-23 09-Feb-23 40 Genera General 3 03-Jan-23 06-Jan-23 40 A1500 Access to site 1 03-Jan-23 04-Jan-23 40 A1510 Site mobilization 2 04-Jan-23 06-Jan-23 40 Civil w Civil works 4 06-Jan-23 11-Jan-23 65 A1520 Demolition works 4 06-Jan-23 11-Jan-23 65 A1530 Solid concrete block works 4 06-Jan-23 11-Jan-23 40 Wall pa Wall partition works 4 11-Jan-23 15-Jan-23 40 A1730 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40 Floor f Floor finishes 11 15-Jan-23 28-Jan-23 50 A1540 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40 A1550 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50 A1560 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50 A1570 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50 A1580 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50 A1590 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50 Wall F Wall Finishes 7 19-Jan-23 27-Jan-23 51 A1600 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51 A1610 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51 A1620 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51 A1630 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51 A1640 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51 Ceiling Ceiling Finishes 12 15-Jan-23 29-Jan-23 49 A1650 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40 A1660 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40 A1670 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40 A1680 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49 A1690 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49 Joiner Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40 A1700 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40 A1710 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40 A1720 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40 A1740 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40 Patient Patient Room 2 (226 Sf) 37 03-Jan-23 15-Feb-23 35 Genera General 8 03-Jan-23 12-Jan-23 35 A1750 Access to site 4 03-Jan-23 07-Jan-23 35 A1760 Site mobilization 4 07-Jan-23 12-Jan-23 35 Civil w Civil works 4 12-Jan-23 17-Jan-23 60 A1770 Demolition works 4 12-Jan-23 17-Jan-23 60 A1780 Solid concrete block works 4 12-Jan-23 17-Jan-23 35 Wall pa Wall partition works 4 17-Jan-23 21-Jan-23 35 A1980 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35 Floor f Floor finishes 11 21-Jan-23 03-Feb-23 45 A1790 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35 A1800 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45 A1810 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45 A1820 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45 A1830 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45 A1840 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45 Wall F Wall Finishes 7 25-Jan-23 02-Feb-23 46 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 15-Feb-23, Patient Room 09-Feb-23, Patient Room 1 (226 Sf) 06-Jan-23, General Access to site Site mobilization 11-Jan-23, Civil works Demolition works Solid concrete block works 15-Jan-23, Wall partition works Gypsum board lining & wall partitons 28-Jan-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 27-Jan-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 29-Jan-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 09-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 15-Feb-23, Patient Room 2 (226 Sf) 12-Jan-23, General Access to site Site mobilization 17-Jan-23, Civil works Demolition works Solid concrete block works 21-Jan-23, Wall partition works Gypsum board lining & wall partitons 03-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 02-Feb-23, Wall Finishes IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 2 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer

  • 3.
    Activity ID ActivityName Original Duration Start Finish Total Float A1850 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46 A1860 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46 A1870 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46 A1880 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46 A1890 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46 Ceiling Ceiling Finishes 12 21-Jan-23 04-Feb-23 44 A1900 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35 A1910 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35 A1920 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35 A1930 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44 A1940 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44 Joiner Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35 A1950 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35 A1960 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35 A1970 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35 A1990 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35 Waiting Waiting Lounge / Library 32 03-Jan-23 09-Feb-23 40 General General 3 03-Jan-23 06-Jan-23 40 A2000 Access to site 1 03-Jan-23 04-Jan-23 40 A2010 Site mobilization 2 04-Jan-23 06-Jan-23 40 Civil wo Civil works 4 06-Jan-23 11-Jan-23 65 A2020 Demolition works 4 06-Jan-23 11-Jan-23 65 A2030 Solid concrete block works 4 06-Jan-23 11-Jan-23 40 Wall pa Wall partition works 4 11-Jan-23 15-Jan-23 40 A2230 Gypsum board lining & wall partitons 4 11-Jan-23 15-Jan-23 40 Floor fi Floor finishes 11 15-Jan-23 28-Jan-23 50 A2040 FF: laying of cement sand screed 3 15-Jan-23 19-Jan-23 40 A2050 FF: Crema marfil floor tiles installation 2 19-Jan-23 21-Jan-23 50 A2060 FF: Non-slip ceramic floor tiles installation 1 21-Jan-23 22-Jan-23 50 A2070 FF: Raised access flooring with vinyl and marble finish 3 22-Jan-23 26-Jan-23 50 A2080 FF: Vinyl flooring installation 1 26-Jan-23 27-Jan-23 50 A2090 FF: Skirting installation 1 27-Jan-23 28-Jan-23 50 Wall Fin Wall Finishes 7 19-Jan-23 27-Jan-23 51 A2100 WF: Glass fixing on partitions 2 19-Jan-23 21-Jan-23 51 A2110 WF: Polished ceramic wall tiling 1 21-Jan-23 22-Jan-23 51 A2120 WF: Wall covering installation 1 22-Jan-23 24-Jan-23 51 A2130 WF: Painting 1st and 2nd coat on walls & ceiling 1 24-Jan-23 25-Jan-23 51 A2140 WF: Painting final coat on walls & ceiling 2 25-Jan-23 27-Jan-23 51 Ceiling Ceiling Finishes 12 15-Jan-23 29-Jan-23 49 A2150 CF: Framework for ceiling 4 15-Jan-23 20-Jan-23 40 A2160 CF: Inspection before ceiling closure 1 20-Jan-23 21-Jan-23 40 A2170 CF: Boarding, taping & jointing 2 21-Jan-23 24-Jan-23 40 A2180 CF: Primer and stucco on walls and ceiling 3 24-Jan-23 27-Jan-23 49 A2190 CF: Fixing light boxes 2 27-Jan-23 29-Jan-23 49 Joinery Joinery Items & Furnitures 14 24-Jan-23 09-Feb-23 40 A2200 JI: Door frames installation 3 24-Jan-23 27-Jan-23 40 A2210 JI: Door panels & ironmongaries installaiton 3 27-Jan-23 31-Jan-23 40 A2220 JI:Dry pantry cabinets installation 3 31-Jan-23 03-Feb-23 40 A2240 Lockers & Furnitures, cabinets installation 5 03-Feb-23 09-Feb-23 40 Training Training Rooms 39 03-Jan-23 17-Feb-23 33 Training Training Room 1 (26p) 34 03-Jan-23 11-Feb-23 38 Genera General 5 03-Jan-23 08-Jan-23 38 A2250 Access to site 1 03-Jan-23 04-Jan-23 38 A2260 Site mobilization 4 04-Jan-23 08-Jan-23 38 Civil w Civil works 4 08-Jan-23 13-Jan-23 63 A2270 Demolition works 4 08-Jan-23 13-Jan-23 63 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 04-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 15-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 09-Feb-23, Waiting Lounge / Library 06-Jan-23, General Access to site Site mobilization 11-Jan-23, Civil works Demolition works Solid concrete block works 15-Jan-23, Wall partition works Gypsum board lining & wall partitons 28-Jan-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 27-Jan-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 29-Jan-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 09-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 17-Feb-23, Training Rooms 11-Feb-23, Training Room 1 (26p) 08-Jan-23, General Access to site Site mobilization 13-Jan-23, Civil works Demolition works IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 3 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 4.
    Activity ID ActivityName Original Duration Start Finish Total Float A2280 Solid concrete block works 4 08-Jan-23 13-Jan-23 38 Wall pa Wall partition works 4 13-Jan-23 18-Jan-23 38 A2480 Gypsum board lining & wall partitons 4 13-Jan-23 18-Jan-23 38 Floor f Floor finishes 11 18-Jan-23 31-Jan-23 48 A2290 FF: laying of cement sand screed 3 18-Jan-23 21-Jan-23 38 A2300 FF: Crema marfil floor tiles installation 2 21-Jan-23 24-Jan-23 48 A2310 FF: Non-slip ceramic floor tiles installation 1 24-Jan-23 25-Jan-23 48 A2320 FF: Raised access flooring with vinyl and marble finish 3 25-Jan-23 28-Jan-23 48 A2330 FF: Vinyl flooring installation 1 28-Jan-23 29-Jan-23 48 A2340 FF: Skirting installation 1 29-Jan-23 31-Jan-23 48 Wall F Wall Finishes 7 21-Jan-23 29-Jan-23 49 A2350 WF: Glass fixing on partitions 2 21-Jan-23 24-Jan-23 49 A2360 WF: Polished ceramic wall tiling 1 24-Jan-23 25-Jan-23 49 A2370 WF: Wall covering installation 1 25-Jan-23 26-Jan-23 49 A2380 WF: Painting 1st and 2nd coat on walls & ceiling 1 26-Jan-23 27-Jan-23 49 A2390 WF: Painting final coat on walls & ceiling 2 27-Jan-23 29-Jan-23 49 Ceiling Ceiling Finishes 12 18-Jan-23 01-Feb-23 47 A2400 CF: Framework for ceiling 4 18-Jan-23 22-Jan-23 38 A2410 CF: Inspection before ceiling closure 1 22-Jan-23 24-Jan-23 38 A2420 CF: Boarding, taping & jointing 2 24-Jan-23 26-Jan-23 38 A2430 CF: Primer and stucco on walls and ceiling 3 26-Jan-23 29-Jan-23 47 A2440 CF: Fixing light boxes 2 29-Jan-23 01-Feb-23 47 Joiner Joinery Items & Furnitures 14 26-Jan-23 11-Feb-23 38 A2450 JI: Door frames installation 3 26-Jan-23 29-Jan-23 38 A2460 JI: Door panels & ironmongaries installaiton 3 29-Jan-23 02-Feb-23 38 A2470 JI:Dry pantry cabinets installation 3 02-Feb-23 05-Feb-23 38 A2490 Lockers & Furnitures, cabinets installation 5 05-Feb-23 11-Feb-23 38 Training Training Room 2 (26p) 37 03-Jan-23 15-Feb-23 35 Genera General 8 03-Jan-23 12-Jan-23 35 A2500 Access to site 4 03-Jan-23 07-Jan-23 35 A2510 Site mobilization 4 07-Jan-23 12-Jan-23 35 Civil w Civil works 4 12-Jan-23 17-Jan-23 60 A2520 Demolition works 4 12-Jan-23 17-Jan-23 60 A2530 Solid concrete block works 4 12-Jan-23 17-Jan-23 35 Wall pa Wall partition works 4 17-Jan-23 21-Jan-23 35 A2730 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35 Floor f Floor finishes 11 21-Jan-23 03-Feb-23 45 A2540 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35 A2550 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45 A2560 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45 A2570 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45 A2580 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45 A2590 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45 Wall F Wall Finishes 7 25-Jan-23 02-Feb-23 46 A2600 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46 A2610 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46 A2620 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46 A2630 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46 A2640 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46 Ceiling Ceiling Finishes 12 21-Jan-23 04-Feb-23 44 A2650 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35 A2660 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35 A2670 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35 A2680 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44 A2690 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44 Joiner Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April Solid concrete block works 18-Jan-23, Wall partition works Gypsum board lining & wall partitons 31-Jan-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 29-Jan-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 01-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 11-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 15-Feb-23, Training Room 2 (26p) 12-Jan-23, General Access to site Site mobilization 17-Jan-23, Civil works Demolition works Solid concrete block works 21-Jan-23, Wall partition works Gypsum board lining & wall partitons 03-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 02-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 04-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 15-Feb-23, Joinery Items & Furnitures IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 4 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 5.
    Activity ID ActivityName Original Duration Start Finish Total Float A2700 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35 A2710 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35 A2720 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35 A2740 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35 Training Training Room 3 (26p) 37 03-Jan-23 15-Feb-23 35 Genera General 8 03-Jan-23 12-Jan-23 35 A2750 Access to site 4 03-Jan-23 07-Jan-23 35 A2760 Site mobilization 4 07-Jan-23 12-Jan-23 35 Civil w Civil works 4 12-Jan-23 17-Jan-23 60 A2770 Demolition works 4 12-Jan-23 17-Jan-23 60 A2780 Solid concrete block works 4 12-Jan-23 17-Jan-23 35 Wall pa Wall partition works 4 17-Jan-23 21-Jan-23 35 A2980 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 35 Floor f Floor finishes 11 21-Jan-23 03-Feb-23 45 A2790 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 35 A2800 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45 A2810 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45 A2820 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45 A2830 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45 A2840 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45 Wall F Wall Finishes 7 25-Jan-23 02-Feb-23 46 A2850 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46 A2860 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46 A2870 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46 A2880 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46 A2890 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46 Ceiling Ceiling Finishes 12 21-Jan-23 04-Feb-23 44 A2900 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 35 A2910 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 35 A2920 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 35 A2930 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44 A2940 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44 Joiner Joinery Items & Furnitures 14 29-Jan-23 15-Feb-23 35 A2950 JI: Door frames installation 3 29-Jan-23 02-Feb-23 35 A2960 JI: Door panels & ironmongaries installaiton 3 02-Feb-23 05-Feb-23 35 A2970 JI:Dry pantry cabinets installation 3 05-Feb-23 09-Feb-23 35 A2990 Lockers & Furnitures, cabinets installation 5 09-Feb-23 15-Feb-23 35 Training Training Room 4 (26p) 39 03-Jan-23 17-Feb-23 33 Genera General 8 03-Jan-23 12-Jan-23 33 A3000 Access to site 4 03-Jan-23 07-Jan-23 33 A3010 Site mobilization 4 07-Jan-23 12-Jan-23 33 Civil w Civil works 4 12-Jan-23 17-Jan-23 60 A3020 Demolition works 4 12-Jan-23 17-Jan-23 60 A3030 Solid concrete block works 4 12-Jan-23 17-Jan-23 33 Wall pa Wall partition works 4 17-Jan-23 21-Jan-23 33 A3230 Gypsum board lining & wall partitons 4 17-Jan-23 21-Jan-23 33 Floor f Floor finishes 11 21-Jan-23 03-Feb-23 45 A3040 FF: laying of cement sand screed 3 21-Jan-23 25-Jan-23 33 A3050 FF: Crema marfil floor tiles installation 2 25-Jan-23 27-Jan-23 45 A3060 FF: Non-slip ceramic floor tiles installation 1 27-Jan-23 28-Jan-23 45 A3070 FF: Raised access flooring with vinyl and marble finish 3 28-Jan-23 01-Feb-23 45 A3080 FF: Vinyl flooring installation 1 01-Feb-23 02-Feb-23 45 A3090 FF: Skirting installation 1 02-Feb-23 03-Feb-23 45 Wall F Wall Finishes 7 25-Jan-23 02-Feb-23 46 A3100 WF: Glass fixing on partitions 2 25-Jan-23 27-Jan-23 46 A3110 WF: Polished ceramic wall tiling 1 27-Jan-23 28-Jan-23 46 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 15-Feb-23, Training Room 3 (26p) 12-Jan-23, General Access to site Site mobilization 17-Jan-23, Civil works Demolition works Solid concrete block works 21-Jan-23, Wall partition works Gypsum board lining & wall partitons 03-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 02-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 04-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 15-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 17-Feb-23, Training Room 4 (26p) 12-Jan-23, General Access to site Site mobilization 17-Jan-23, Civil works Demolition works Solid concrete block works 21-Jan-23, Wall partition works Gypsum board lining & wall partitons 03-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 02-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 5 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 6.
    Activity ID ActivityName Original Duration Start Finish Total Float A3120 WF: Wall covering installation 1 28-Jan-23 29-Jan-23 46 A3130 WF: Painting 1st and 2nd coat on walls & ceiling 1 29-Jan-23 31-Jan-23 46 A3140 WF: Painting final coat on walls & ceiling 2 31-Jan-23 02-Feb-23 46 Ceiling Ceiling Finishes 12 21-Jan-23 04-Feb-23 44 A3150 CF: Framework for ceiling 4 21-Jan-23 26-Jan-23 33 A3160 CF: Inspection before ceiling closure 1 26-Jan-23 27-Jan-23 33 A3170 CF: Boarding, taping & jointing 2 27-Jan-23 29-Jan-23 33 A3180 CF: Primer and stucco on walls and ceiling 3 29-Jan-23 02-Feb-23 44 A3190 CF: Fixing light boxes 2 02-Feb-23 04-Feb-23 44 Joiner Joinery Items & Furnitures 16 29-Jan-23 17-Feb-23 33 A3200 JI: Door frames installation 5 29-Jan-23 04-Feb-23 33 A3210 JI: Door panels & ironmongaries installaiton 3 04-Feb-23 08-Feb-23 33 A3220 JI:Dry pantry cabinets installation 3 08-Feb-23 11-Feb-23 33 A3240 Lockers & Furnitures, cabinets installation 5 11-Feb-23 17-Feb-23 33 Internal Internal Work Area 41 07-Jan-23 24-Feb-23 26 General General 8 07-Jan-23 17-Jan-23 26 A3250 Access to site 4 07-Jan-23 12-Jan-23 26 A3260 Site mobilization 4 12-Jan-23 17-Jan-23 26 Civil wo Civil works 4 17-Jan-23 21-Jan-23 55 A3270 Demolition works 4 17-Jan-23 21-Jan-23 55 A3280 Solid concrete block works 4 17-Jan-23 21-Jan-23 26 Wall pa Wall partition works 4 21-Jan-23 26-Jan-23 26 A3480 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 26 Floor fi Floor finishes 11 26-Jan-23 08-Feb-23 40 A3290 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 26 A3300 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40 A3310 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40 A3320 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40 A3330 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40 A3340 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40 Wall Fin Wall Finishes 7 29-Jan-23 07-Feb-23 41 A3350 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41 A3360 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41 A3370 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41 A3380 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41 A3390 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41 Ceiling Ceiling Finishes 12 26-Jan-23 09-Feb-23 39 A3400 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 26 A3410 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 26 A3420 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 26 A3430 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39 A3440 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39 Joinery Joinery Items & Furnitures 18 03-Feb-23 24-Feb-23 26 A3450 JI: Door frames installation 5 03-Feb-23 09-Feb-23 26 A3460 JI: Door panels & ironmongaries installaiton 4 09-Feb-23 14-Feb-23 26 A3470 JI:Dry pantry cabinets installation 4 14-Feb-23 18-Feb-23 26 A3490 Lockers & Furnitures, cabinets installation 5 18-Feb-23 24-Feb-23 26 Training Training Labs 37 07-Jan-23 19-Feb-23 30 Training Training Lab1 (16-20pax) 37 07-Jan-23 19-Feb-23 30 Genera General 8 07-Jan-23 17-Jan-23 30 A4750 Access to site 4 07-Jan-23 12-Jan-23 30 A4760 Site mobilization 4 12-Jan-23 17-Jan-23 30 Civil w Civil works 4 17-Jan-23 21-Jan-23 55 A4770 Demolition works 4 17-Jan-23 21-Jan-23 55 A4780 Solid concrete block works 4 17-Jan-23 21-Jan-23 30 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 04-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 17-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 24-Feb-23, Internal Work Area 17-Jan-23, General Access to site Site mobilization 21-Jan-23, Civil works Demolition works Solid concrete block works 26-Jan-23, Wall partition works Gypsum board lining & wall partitons 08-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 07-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 09-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 24-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 19-Feb-23, Training Labs 19-Feb-23, Training Lab1 (16-20pax) 17-Jan-23, General Access to site Site mobilization 21-Jan-23, Civil works Demolition works Solid concrete block works IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 6 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 7.
    Activity ID ActivityName Original Duration Start Finish Total Float Wall pa Wall partition works 4 21-Jan-23 26-Jan-23 30 A4980 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30 Floor f Floor finishes 11 26-Jan-23 08-Feb-23 40 A4790 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30 A4800 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40 A4810 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40 A4820 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40 A4830 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40 A4840 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40 Wall F Wall Finishes 7 29-Jan-23 07-Feb-23 41 A4850 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41 A4860 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41 A4870 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41 A4880 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41 A4890 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41 Ceiling Ceiling Finishes 12 26-Jan-23 09-Feb-23 39 A4900 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30 A4910 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30 A4920 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30 A4930 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39 A4940 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39 Joiner Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30 A4950 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30 A4960 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30 A4970 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30 A4990 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30 Training Training Lab2 (16-20pax) 37 07-Jan-23 19-Feb-23 30 Genera General 8 07-Jan-23 17-Jan-23 30 A5000 Access to site 4 07-Jan-23 12-Jan-23 30 A5010 Site mobilization 4 12-Jan-23 17-Jan-23 30 Civil w Civil works 4 17-Jan-23 21-Jan-23 55 A5020 Demolition works 4 17-Jan-23 21-Jan-23 55 A5030 Solid concrete block works 4 17-Jan-23 21-Jan-23 30 Wall pa Wall partition works 4 21-Jan-23 26-Jan-23 30 A5230 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30 Floor f Floor finishes 11 26-Jan-23 08-Feb-23 40 A5040 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30 A5050 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40 A5060 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40 A5070 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40 A5080 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40 A5090 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40 Wall F Wall Finishes 7 29-Jan-23 07-Feb-23 41 A5100 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41 A5110 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41 A5120 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41 A5130 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41 A5140 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41 Ceiling Ceiling Finishes 12 26-Jan-23 09-Feb-23 39 A5150 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30 A5160 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30 A5170 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30 A5180 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39 A5190 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39 Joiner Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30 A5200 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April 26-Jan-23, Wall partition works Gypsum board lining & wall partitons 08-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 07-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 09-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 19-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 19-Feb-23, Training Lab2 (16-20pax) 17-Jan-23, General Access to site Site mobilization 21-Jan-23, Civil works Demolition works Solid concrete block works 26-Jan-23, Wall partition works Gypsum board lining & wall partitons 08-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 07-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 09-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 19-Feb-23, Joinery Items & Furnitures JI: Door frames installation IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 7 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer

  • 8.
    Activity ID ActivityName Original Duration Start Finish Total Float A5210 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30 A5220 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30 A5240 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30 Meeting Meeting Rooms 37 07-Jan-23 19-Feb-23 30 General General 8 07-Jan-23 17-Jan-23 30 A3500 Access to site 4 07-Jan-23 12-Jan-23 30 A3510 Site mobilization 4 12-Jan-23 17-Jan-23 30 Civil wo Civil works 4 17-Jan-23 21-Jan-23 55 A3520 Demolition works 4 17-Jan-23 21-Jan-23 55 A3530 Solid concrete block works 4 17-Jan-23 21-Jan-23 30 Wall pa Wall partition works 4 21-Jan-23 26-Jan-23 30 A3730 Gypsum board lining & wall partitons 4 21-Jan-23 26-Jan-23 30 Floor fi Floor finishes 11 26-Jan-23 08-Feb-23 40 A3540 FF: laying of cement sand screed 3 26-Jan-23 29-Jan-23 30 A3550 FF: Crema marfil floor tiles installation 2 29-Jan-23 01-Feb-23 40 A3560 FF: Non-slip ceramic floor tiles installation 1 01-Feb-23 02-Feb-23 40 A3570 FF: Raised access flooring with vinyl and marble finish 3 02-Feb-23 05-Feb-23 40 A3580 FF: Vinyl flooring installation 1 05-Feb-23 07-Feb-23 40 A3590 FF: Skirting installation 1 07-Feb-23 08-Feb-23 40 Wall Fin Wall Finishes 7 29-Jan-23 07-Feb-23 41 A3600 WF: Glass fixing on partitions 2 29-Jan-23 01-Feb-23 41 A3610 WF: Polished ceramic wall tiling 1 01-Feb-23 02-Feb-23 41 A3620 WF: Wall covering installation 1 02-Feb-23 03-Feb-23 41 A3630 WF: Painting 1st and 2nd coat on walls & ceiling 1 03-Feb-23 04-Feb-23 41 A3640 WF: Painting final coat on walls & ceiling 2 04-Feb-23 07-Feb-23 41 Ceiling Ceiling Finishes 12 26-Jan-23 09-Feb-23 39 A3650 CF: Framework for ceiling 4 26-Jan-23 31-Jan-23 30 A3660 CF: Inspection before ceiling closure 1 31-Jan-23 01-Feb-23 30 A3670 CF: Boarding, taping & jointing 2 01-Feb-23 03-Feb-23 30 A3680 CF: Primer and stucco on walls and ceiling 3 03-Feb-23 07-Feb-23 39 A3690 CF: Fixing light boxes 2 07-Feb-23 09-Feb-23 39 Joinery Joinery Items & Furnitures 14 03-Feb-23 19-Feb-23 30 A3700 JI: Door frames installation 3 03-Feb-23 07-Feb-23 30 A3710 JI: Door panels & ironmongaries installaiton 3 07-Feb-23 10-Feb-23 30 A3720 JI:Dry pantry cabinets installation 3 10-Feb-23 14-Feb-23 30 A3740 Lockers & Furnitures, cabinets installation 5 14-Feb-23 19-Feb-23 30 Flexi Hu Flexi Hubs 41 12-Jan-23 01-Mar-23 22 General General 8 12-Jan-23 21-Jan-23 22 A3750 Access to site 4 12-Jan-23 17-Jan-23 22 A3760 Site mobilization 4 17-Jan-23 21-Jan-23 22 Civil wo Civil works 4 21-Jan-23 26-Jan-23 51 A3770 Demolition works 4 21-Jan-23 26-Jan-23 51 A3780 Solid concrete block works 4 21-Jan-23 26-Jan-23 22 Wall pa Wall partition works 4 26-Jan-23 31-Jan-23 22 A3980 Gypsum board lining & wall partitons 4 26-Jan-23 31-Jan-23 22 Floor fi Floor finishes 11 31-Jan-23 12-Feb-23 36 A3790 FF: laying of cement sand screed 3 31-Jan-23 03-Feb-23 22 A3800 FF: Crema marfil floor tiles installation 2 03-Feb-23 05-Feb-23 36 A3810 FF: Non-slip ceramic floor tiles installation 1 05-Feb-23 07-Feb-23 36 A3820 FF: Raised access flooring with vinyl and marble finish 3 07-Feb-23 10-Feb-23 36 A3830 FF: Vinyl flooring installation 1 10-Feb-23 11-Feb-23 36 A3840 FF: Skirting installation 1 11-Feb-23 12-Feb-23 36 Wall Fin Wall Finishes 7 03-Feb-23 11-Feb-23 37 A3850 WF: Glass fixing on partitions 2 03-Feb-23 05-Feb-23 37 A3860 WF: Polished ceramic wall tiling 1 05-Feb-23 07-Feb-23 37 A3870 WF: Wall covering installation 1 07-Feb-23 08-Feb-23 37 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 19-Feb-23, Meeting Rooms 17-Jan-23, General Access to site Site mobilization 21-Jan-23, Civil works Demolition works Solid concrete block works 26-Jan-23, Wall partition works Gypsum board lining & wall partitons 08-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 07-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 09-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 19-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 01-Mar-23, Flexi Hubs 21-Jan-23, General Access to site Site mobilization 26-Jan-23, Civil works Demolition works Solid concrete block works 31-Jan-23, Wall partition works Gypsum board lining & wall partitons 12-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 11-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 8 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 9.
    Activity ID ActivityName Original Duration Start Finish Total Float A3880 WF: Painting 1st and 2nd coat on walls & ceiling 1 08-Feb-23 09-Feb-23 37 A3890 WF: Painting final coat on walls & ceiling 2 09-Feb-23 11-Feb-23 37 Ceiling Ceiling Finishes 12 31-Jan-23 14-Feb-23 35 A3900 CF: Framework for ceiling 4 31-Jan-23 04-Feb-23 22 A3910 CF: Inspection before ceiling closure 1 04-Feb-23 05-Feb-23 22 A3920 CF: Boarding, taping & jointing 2 05-Feb-23 08-Feb-23 22 A3930 CF: Primer and stucco on walls and ceiling 3 08-Feb-23 11-Feb-23 35 A3940 CF: Fixing light boxes 2 11-Feb-23 14-Feb-23 35 Joinery Joinery Items & Furnitures 18 08-Feb-23 01-Mar-23 22 A3950 JI: Door frames installation 5 08-Feb-23 14-Feb-23 22 A3960 JI: Door panels & ironmongaries installaiton 4 14-Feb-23 18-Feb-23 22 A3970 JI:Dry pantry cabinets installation 4 18-Feb-23 23-Feb-23 22 A3990 Lockers & Furnitures, cabinets installation 5 23-Feb-23 01-Mar-23 22 Patch R Patch Room 37 12-Jan-23 24-Feb-23 26 General General 8 12-Jan-23 21-Jan-23 26 A4000 Access to site 4 12-Jan-23 17-Jan-23 26 A4010 Site mobilization 4 17-Jan-23 21-Jan-23 26 Civil wo Civil works 4 21-Jan-23 26-Jan-23 51 A4020 Demolition works 4 21-Jan-23 26-Jan-23 51 A4030 Solid concrete block works 4 21-Jan-23 26-Jan-23 26 Wall pa Wall partition works 4 26-Jan-23 31-Jan-23 26 A4230 Gypsum board lining & wall partitons 4 26-Jan-23 31-Jan-23 26 Floor fi Floor finishes 11 31-Jan-23 12-Feb-23 36 A4040 FF: laying of cement sand screed 3 31-Jan-23 03-Feb-23 26 A4050 FF: Crema marfil floor tiles installation 2 03-Feb-23 05-Feb-23 36 A4060 FF: Non-slip ceramic floor tiles installation 1 05-Feb-23 07-Feb-23 36 A4070 FF: Raised access flooring with vinyl and marble finish 3 07-Feb-23 10-Feb-23 36 A4080 FF: Vinyl flooring installation 1 10-Feb-23 11-Feb-23 36 A4090 FF: Skirting installation 1 11-Feb-23 12-Feb-23 36 Wall Fin Wall Finishes 7 03-Feb-23 11-Feb-23 37 A4100 WF: Glass fixing on partitions 2 03-Feb-23 05-Feb-23 37 A4110 WF: Polished ceramic wall tiling 1 05-Feb-23 07-Feb-23 37 A4120 WF: Wall covering installation 1 07-Feb-23 08-Feb-23 37 A4130 WF: Painting 1st and 2nd coat on walls & ceiling 1 08-Feb-23 09-Feb-23 37 A4140 WF: Painting final coat on walls & ceiling 2 09-Feb-23 11-Feb-23 37 Ceiling Ceiling Finishes 12 31-Jan-23 14-Feb-23 35 A4150 CF: Framework for ceiling 4 31-Jan-23 04-Feb-23 26 A4160 CF: Inspection before ceiling closure 1 04-Feb-23 05-Feb-23 26 A4170 CF: Boarding, taping & jointing 2 05-Feb-23 08-Feb-23 26 A4180 CF: Primer and stucco on walls and ceiling 3 08-Feb-23 11-Feb-23 35 A4190 CF: Fixing light boxes 2 11-Feb-23 14-Feb-23 35 Joinery Joinery Items & Furnitures 14 08-Feb-23 24-Feb-23 26 A4200 JI: Door frames installation 3 08-Feb-23 11-Feb-23 26 A4210 JI: Door panels & ironmongaries installaiton 3 11-Feb-23 15-Feb-23 26 A4220 JI:Dry pantry cabinets installation 3 15-Feb-23 18-Feb-23 26 A4240 Lockers & Furnitures, cabinets installation 5 18-Feb-23 24-Feb-23 26 Podcast Podcast Room 41 17-Jan-23 05-Mar-23 18 General General 8 17-Jan-23 26-Jan-23 18 A4250 Access to site 4 17-Jan-23 21-Jan-23 18 A4260 Site mobilization 4 21-Jan-23 26-Jan-23 18 Civil wo Civil works 4 26-Jan-23 31-Jan-23 47 A4270 Demolition works 4 26-Jan-23 31-Jan-23 47 A4280 Solid concrete block works 4 26-Jan-23 31-Jan-23 18 Wall pa Wall partition works 4 31-Jan-23 04-Feb-23 18 A4480 Gypsum board lining & wall partitons 4 31-Jan-23 04-Feb-23 18 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 14-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 01-Mar-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 24-Feb-23, Patch Room 21-Jan-23, General Access to site Site mobilization 26-Jan-23, Civil works Demolition works Solid concrete block works 31-Jan-23, Wall partition works Gypsum board lining & wall partitons 12-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 11-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 14-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 24-Feb-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 05-Mar-23, Podcast Room 26-Jan-23, General Access to site Site mobilization 31-Jan-23, Civil works Demolition works Solid concrete block works 04-Feb-23, Wall partition works Gypsum board lining & wall partitons IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 9 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
  • 10.
    Activity ID ActivityName Original Duration Start Finish Total Float Floor fi Floor finishes 11 04-Feb-23 17-Feb-23 32 A4290 FF: laying of cement sand screed 3 04-Feb-23 08-Feb-23 18 A4300 FF: Crema marfil floor tiles installation 2 08-Feb-23 10-Feb-23 32 A4310 FF: Non-slip ceramic floor tiles installation 1 10-Feb-23 11-Feb-23 32 A4320 FF: Raised access flooring with vinyl and marble finish 3 11-Feb-23 15-Feb-23 32 A4330 FF: Vinyl flooring installation 1 15-Feb-23 16-Feb-23 32 A4340 FF: Skirting installation 1 16-Feb-23 17-Feb-23 32 Wall Fin Wall Finishes 7 08-Feb-23 16-Feb-23 33 A4350 WF: Glass fixing on partitions 2 08-Feb-23 10-Feb-23 33 A4360 WF: Polished ceramic wall tiling 1 10-Feb-23 11-Feb-23 33 A4370 WF: Wall covering installation 1 11-Feb-23 12-Feb-23 33 A4380 WF: Painting 1st and 2nd coat on walls & ceiling 1 12-Feb-23 14-Feb-23 33 A4390 WF: Painting final coat on walls & ceiling 2 14-Feb-23 16-Feb-23 33 Ceiling Ceiling Finishes 12 04-Feb-23 18-Feb-23 31 A4400 CF: Framework for ceiling 4 04-Feb-23 09-Feb-23 18 A4410 CF: Inspection before ceiling closure 1 09-Feb-23 10-Feb-23 18 A4420 CF: Boarding, taping & jointing 2 10-Feb-23 12-Feb-23 18 A4430 CF: Primer and stucco on walls and ceiling 3 12-Feb-23 16-Feb-23 31 A4440 CF: Fixing light boxes 2 16-Feb-23 18-Feb-23 31 Joinery Joinery Items & Furnitures 18 12-Feb-23 05-Mar-23 18 A4450 JI: Door frames installation 5 12-Feb-23 18-Feb-23 18 A4460 JI: Door panels & ironmongaries installaiton 4 18-Feb-23 23-Feb-23 18 A4470 JI:Dry pantry cabinets installation 4 23-Feb-23 28-Feb-23 18 A4490 Lockers & Furnitures, cabinets installation 5 28-Feb-23 05-Mar-23 18 Content Content Creation Room 44 17-Jan-23 09-Mar-23 15 General General 8 17-Jan-23 26-Jan-23 0 A4500 Access to site 4 17-Jan-23 21-Jan-23 0 A4510 Site mobilization 4 21-Jan-23 26-Jan-23 0 Civil wo Civil works 4 26-Jan-23 31-Jan-23 47 A4520 Demolition works 4 26-Jan-23 31-Jan-23 47 A4530 Solid concrete block works 4 26-Jan-23 31-Jan-23 0 Wall pa Wall partition works 4 31-Jan-23 04-Feb-23 0 A4730 Gypsum board lining & wall partitons 4 31-Jan-23 04-Feb-23 0 Floor fi Floor finishes 11 04-Feb-23 17-Feb-23 32 A4540 FF: laying of cement sand screed 3 04-Feb-23 08-Feb-23 0 A4550 FF: Crema marfil floor tiles installation 2 08-Feb-23 10-Feb-23 32 A4560 FF: Non-slip ceramic floor tiles installation 1 10-Feb-23 11-Feb-23 32 A4570 FF: Raised access flooring with vinyl and marble finish 3 11-Feb-23 15-Feb-23 32 A4580 FF: Vinyl flooring installation 1 15-Feb-23 16-Feb-23 32 A4590 FF: Skirting installation 1 16-Feb-23 17-Feb-23 32 Wall Fin Wall Finishes 7 08-Feb-23 16-Feb-23 33 A4600 WF: Glass fixing on partitions 2 08-Feb-23 10-Feb-23 33 A4610 WF: Polished ceramic wall tiling 1 10-Feb-23 11-Feb-23 33 A4620 WF: Wall covering installation 1 11-Feb-23 12-Feb-23 33 A4630 WF: Painting 1st and 2nd coat on walls & ceiling 1 12-Feb-23 14-Feb-23 33 A4640 WF: Painting final coat on walls & ceiling 2 14-Feb-23 16-Feb-23 33 Ceiling Ceiling Finishes 12 04-Feb-23 18-Feb-23 31 A4650 CF: Framework for ceiling 4 04-Feb-23 09-Feb-23 0 A4660 CF: Inspection before ceiling closure 1 09-Feb-23 10-Feb-23 0 A4670 CF: Boarding, taping & jointing 2 10-Feb-23 12-Feb-23 0 A4680 CF: Primer and stucco on walls and ceiling 3 12-Feb-23 16-Feb-23 31 A4690 CF: Fixing light boxes 2 16-Feb-23 18-Feb-23 31 Joinery Joinery Items & Furnitures 21 12-Feb-23 09-Mar-23 0 A4700 JI: Door frames installation 5 12-Feb-23 18-Feb-23 0 A4710 JI: Door panels & ironmongaries installaiton 5 18-Feb-23 24-Feb-23 0 A4720 JI:Dry pantry cabinets installation 5 24-Feb-23 02-Mar-23 0 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April 17-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 16-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 18-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 05-Mar-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation Lockers & Furnitures, cabinets installation 09-Mar-23, Content Creation Room 26-Jan-23, General Access to site Site mobilization 31-Jan-23, Civil works Demolition works Solid concrete block works 04-Feb-23, Wall partition works Gypsum board lining & wall partitons 17-Feb-23, Floor finishes FF: laying of cement sand screed FF: Crema marfil floor tiles installation FF: Non-slip ceramic floor tiles installation FF: Raised access flooring with vinyl and marble finish FF: Vinyl flooring installation FF: Skirting installation 16-Feb-23, Wall Finishes WF: Glass fixing on partitions WF: Polished ceramic wall tiling WF: Wall covering installation WF: Painting 1st and 2nd coat on walls & ceiling WF: Painting final coat on walls & ceiling 18-Feb-23, Ceiling Finishes CF: Framework for ceiling CF: Inspection before ceiling closure CF: Boarding, taping & jointing CF: Primer and stucco on walls and ceiling CF: Fixing light boxes 09-Mar-23, Joinery Items & Furnitures JI: Door frames installation JI: Door panels & ironmongaries installaiton JI:Dry pantry cabinets installation IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 10 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer

  • 11.
    Activity ID ActivityName Original Duration Start Finish Total Float A4740 Lockers & Furnitures, cabinets installation 6 02-Mar-23 09-Mar-23 0 Snaggin Snagging & Handover 17 10-Mar-23 26-Mar-23 0 A1170 Snagging works 10 10-Mar-23 19-Mar-23 0 A1180 Final inspection by client 6 20-Mar-23 25-Mar-23 0 A1190 Client possession & Handover 1 26-Mar-23 26-Mar-23 0 23 30 06 13 20 27 04 11 18 25 01 08 15 22 29 05 12 19 26 05 12 19 26 02 09 16 23 1 2 3 4 5 6 November December January February March April Lockers & Furnitures, cabinets installation 26-Mar-23, Snagging & Handov Snagging works Final inspection by client Client possession & Handover IHH HEALTHCARE @ #02‐02 80 BENDEMEER ROAD (PHASE 2) Tender Programme (Rev‐0) Actual Work Early Dates Critical Work Milestone Summary Page 11 of 11 Date Revision Checked Approved 05-Oct-22 IHH HEALTHCARE FIT OUT Ten... Planner Tenderer
