iprocess

creating intelligent and cost conscious
          processes for shared services

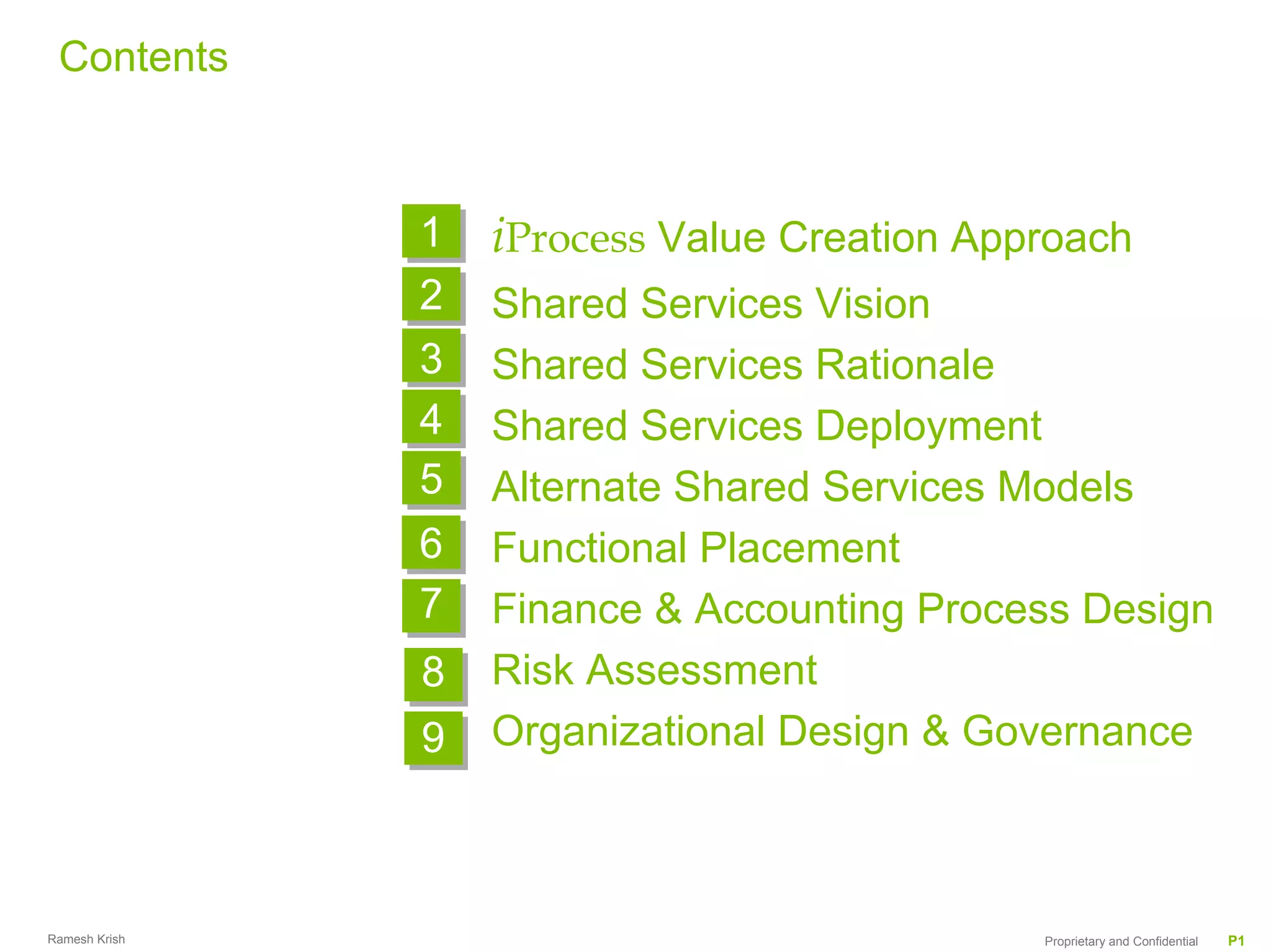

Contents

               1   iProcess Value Creation Approach
               2   Shared Services Vision
               3   Shared Services Rationale
               4   Shared Services Deployment
               5   Alternate Shared Services Models
               6
               6   Functional Placement
               7   Finance & Accounting Process Design
               8   Risk Assessment
               9   Organizational Design & Governance

Ramesh Krish                                  Proprietary and Confidential   P1
1   iProcess Value Creation
                   Approach

Ramesh Krish                          Proprietary and Confidential   P2

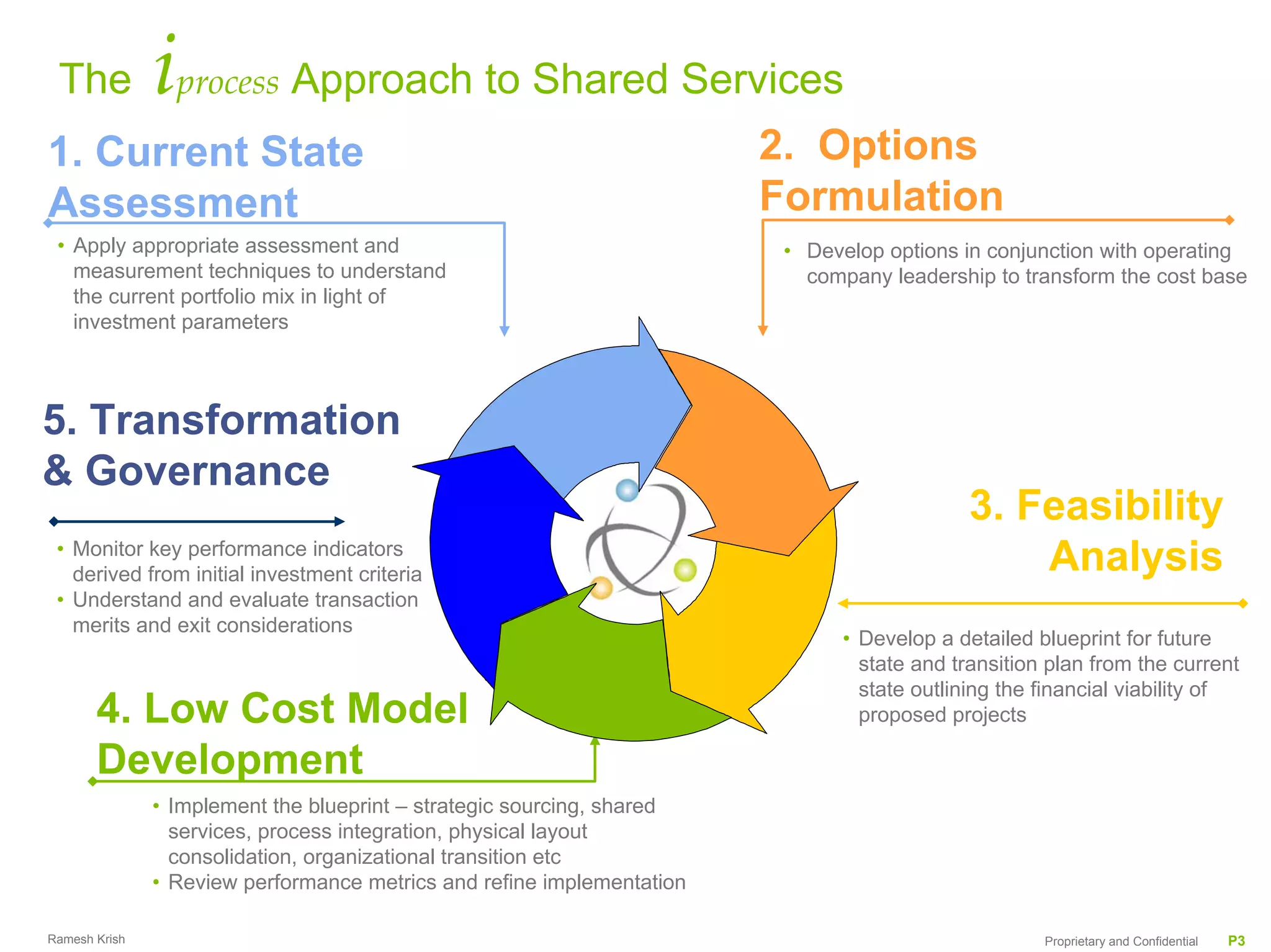

The           iprocess Approach to Shared Services
1. Current State                                                        2. Options
Assessment                                                              Formulation
 • Apply appropriate assessment and                                      • Develop options in conjunction with operating
   measurement techniques to understand                                    company leadership to transform the cost base
   the current portfolio mix in light of
   investment parameters

5. Transformation
& Governance
                                                                                            3. Feasibility
 • Monitor key performance indicators
   derived from initial investment criteria
                                                       CUSTOMER                                 Analysis
 • Understand and evaluate transaction
   merits and exit considerations
                                                                              • Develop a detailed blueprint for future
                                                                                state and transition plan from the current
                                                                                state outlining the financial viability of
       4. Low Cost Model                                                        proposed projects

       Development
               • Implement the blueprint – strategic sourcing, shared
                 services, process integration, physical layout
                 consolidation, organizational transition etc
               • Review performance metrics and refine implementation

Ramesh Krish                                                                                        Proprietary and Confidential   P3
2   Shared Services Vision

Ramesh Krish                          Proprietary and Confidential   P4

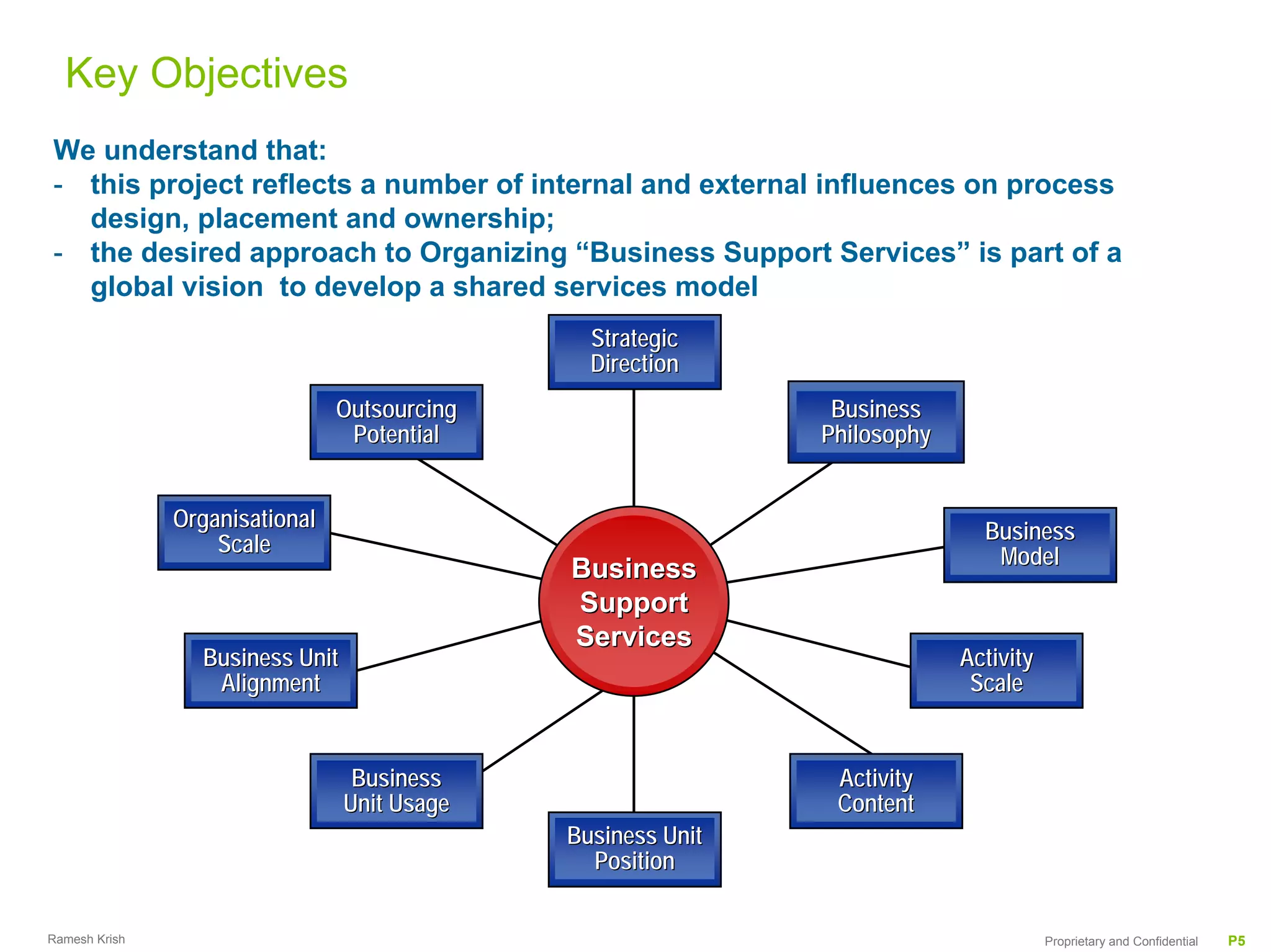

Key Objectives
We understand that:
- this project reflects a number of internal and external influences on process
  design, placement and ownership;
- the desired approach to Organizing “Business Support Services” is part of a
  global vision to develop a shared services model
                                                Strategic
                                                Direction
                                Outsourcing                    Business
                                 Potential                    Philosophy

               Organisational
                                                                             Business
                   Scale                                                      Model
                                              Business
                                              Support
                                              Services
                 Business Unit                                             Activity
                  Alignment                                                 Scale

                                  Business                     Activity
                                 Unit Usage                    Content
                                              Business Unit
                                                Position

Ramesh Krish                                                                          Proprietary and Confidential   P5

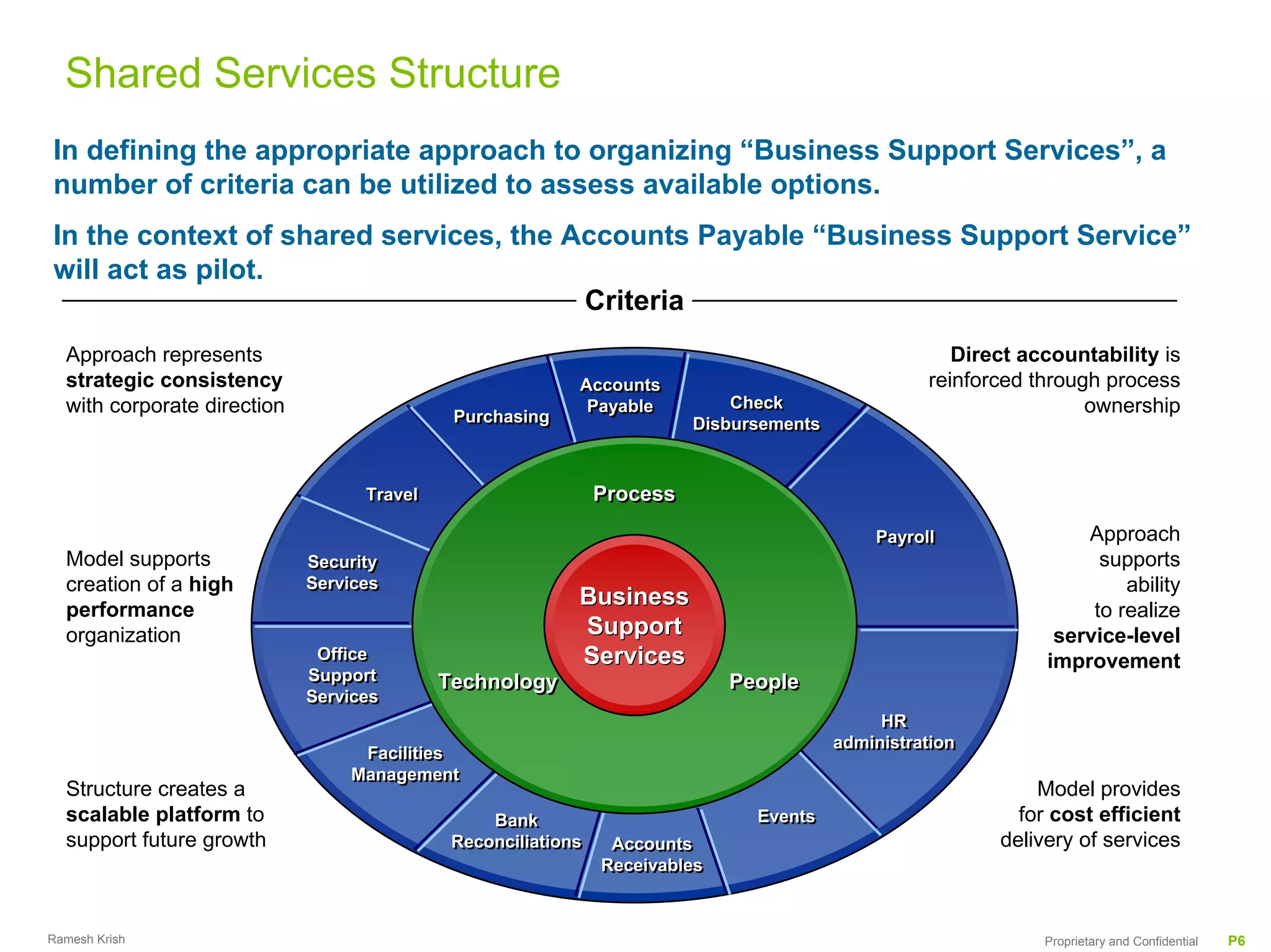

Shared Services Structure
In defining the appropriate approach to organizing “Business Support Services”, a
number of criteria can be utilized to assess available options.
In the context of shared services, the Accounts Payable “Business Support Service”
will act as pilot.
                                        Criteria
  Approach represents                                                                                  Direct accountability is
  strategic consistency                                    Accounts
                                                           Accounts                                 reinforced through process
  with corporate direction                                  Payable
                                                            Payable           Check
                                                                              Check                                  ownership
                                             Purchasing
                                             Purchasing                   Disbursements
                                                                          Disbursements

                                   Travel
                                   Travel                      Process
                                                               Services
                                                               Services

                                                                                              Payroll
                                                                                              Payroll               Approach
  Model supports             Security
                             Security                                                                                 supports
  creation of a high         Services
                             Services                                                                                    ability
  performance
                                                           Business
                                                                                                                     to realize
  organization                                             Support                                               service-level
                              Office
                              Office                       Services                                             improvement
                             Support
                             Support        Technology                       People
                             Services
                             Services
                                                                                               HR
                                                                                               HR
                                                                                          administration
                                                                                          administration
                                  Facilities
                                  Facilities
                                 Management
                                 Management
  Structure creates a                                                                                          Model provides
  scalable platform to                           Bank
                                                 Bank                           Events
                                                                                Events                       for cost efficient
  support future growth                      Reconciliations
                                             Reconciliations    Accounts
                                                                Accounts                                   delivery of services
                                                               Receivables
                                                               Receivables

Ramesh Krish                                                                                                    Proprietary and Confidential   P6
3   Shared Services Rationale

Ramesh Krish                          Proprietary and Confidential   P7

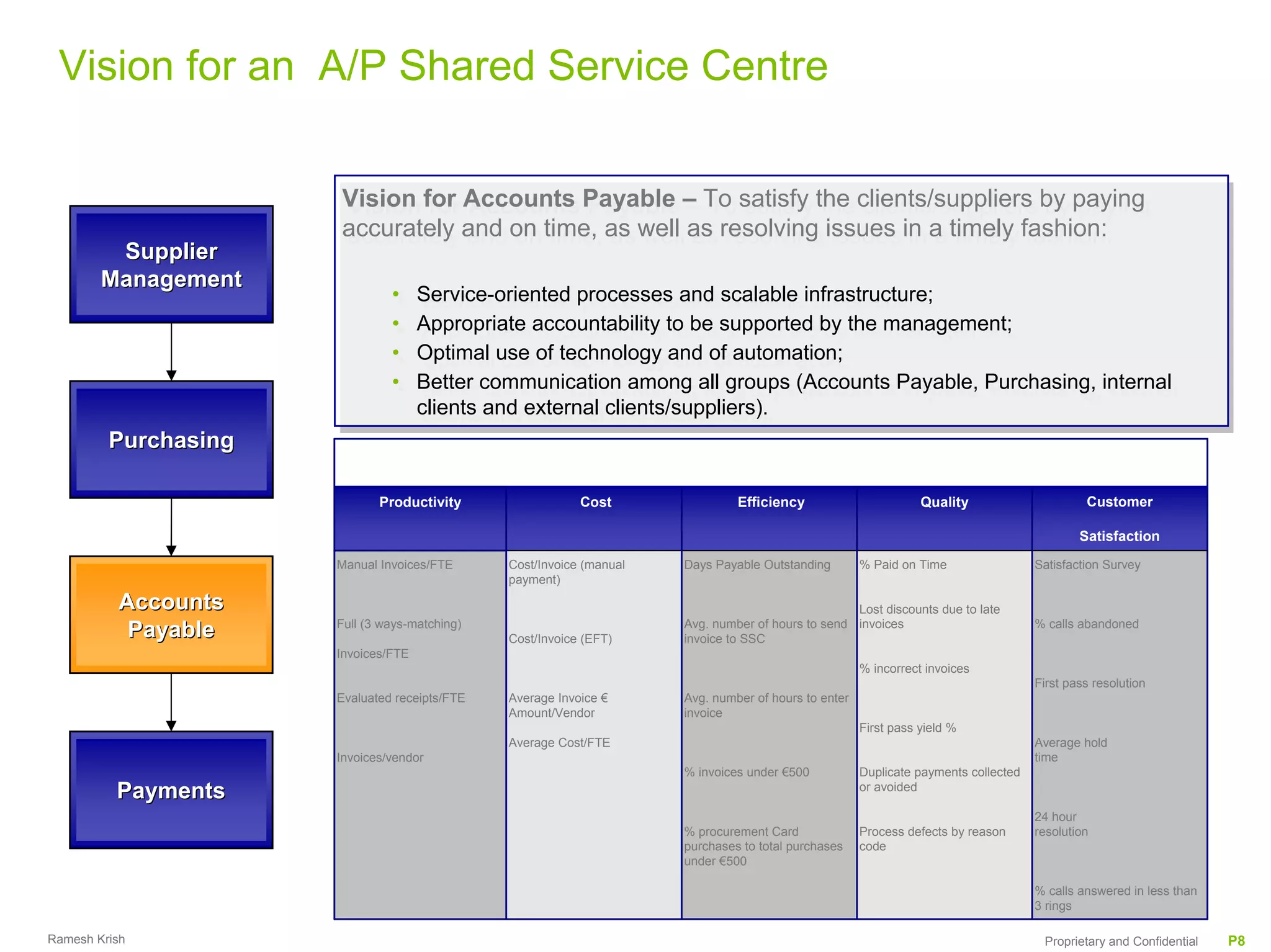

Vision for an A/P Shared Service Centre

                      Vision for Accounts Payable – To satisfy the clients/suppliers by paying
                      Vision for Accounts Payable – To satisfy the clients/suppliers by paying
                      accurately and on time, as well as resolving issues in a timely fashion:
                      accurately and on time, as well as resolving issues in a timely fashion:
         Supplier
        Management
                               ••    Service-oriented processes and scalable infrastructure;
                                      Service-oriented processes and scalable infrastructure;
                               ••    Appropriate accountability to be supported by the management;
                                      Appropriate accountability to be supported by the management;
                               ••    Optimal use of technology and of automation;
                                      Optimal use of technology and of automation;
                               ••    Better communication among all groups (Accounts Payable, Purchasing, internal
                                      Better communication among all groups (Accounts Payable, Purchasing, internal
                                     clients and external clients/suppliers).
                                      clients and external clients/suppliers).
         Purchasing
                                               Business Performance Dimensions – Sample of performance metrics for A/P

                             Productivity                    Cost                Efficiency                        Quality                      Customer

                                                                                                                                               Satisfaction
                      Manual Invoices/FTE        Cost/Invoice (manual   Days Payable Outstanding        % Paid on Time                 Satisfaction Survey
                                                 payment)

          Accounts                                                                                   Lost discounts due to late
                      Full (3 ways-matching)                            Avg. number of hours to send invoices                          % calls abandoned
           Payable                               Cost/Invoice (EFT)     invoice to SSC
                      Invoices/FTE
                                                                                                        % incorrect invoices
                                                                                                                                       First pass resolution
                      Evaluated receipts/FTE     Average Invoice €      Avg. number of hours to enter
                                                 Amount/Vendor          invoice
                                                                                                        First pass yield %
                                                 Average Cost/FTE                                                                      Average hold
                      Invoices/vendor                                                                                                  time
                                                                        % invoices under €500           Duplicate payments collected
          Payments                                                                                      or avoided

                                                                                                                                       24 hour
                                                                        % procurement Card              Process defects by reason      resolution
                                                                        purchases to total purchases    code
                                                                        under €500

                                                                                                                                       % calls answered in less than
                                                                                                                                       3 rings

Ramesh Krish                                                                                                                            Proprietary and Confidential   P8

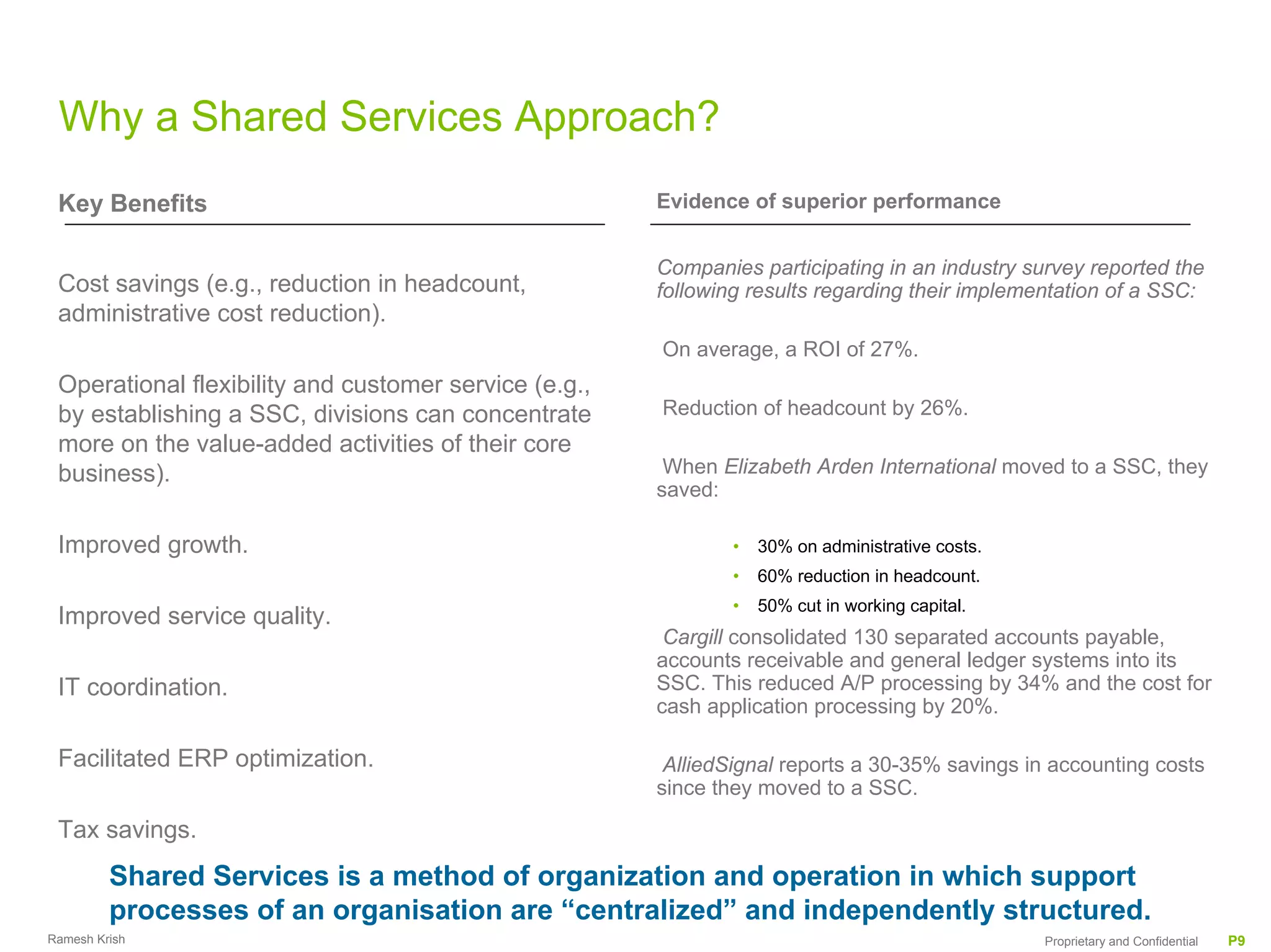

Why a Shared Services Approach?
 Key Benefits                                          Evidence of superior performance

                                                       Companies participating in an industry survey reported the
 Cost savings (e.g., reduction in headcount,           following results regarding their implementation of a SSC:
 administrative cost reduction).
                                                       On average, a ROI of 27%.
 Operational flexibility and customer service (e.g.,
 by establishing a SSC, divisions can concentrate      Reduction of headcount by 26%.
 more on the value-added activities of their core
 business).                                             When Elizabeth Arden International moved to a SSC, they
                                                       saved:

 Improved growth.                                              •   30% on administrative costs.
                                                               •   60% reduction in headcount.
                                                               •   50% cut in working capital.
 Improved service quality.
                                                        Cargill consolidated 130 separated accounts payable,
                                                       accounts receivable and general ledger systems into its
 IT coordination.                                      SSC. This reduced A/P processing by 34% and the cost for
                                                       cash application processing by 20%.

 Facilitated ERP optimization.                          AlliedSignal reports a 30-35% savings in accounting costs
                                                       since they moved to a SSC.

 Tax savings.
         Shared Services is a method of organization and operation in which support
         processes of an organisation are “centralized” and independently structured.
Ramesh Krish                                                                                      Proprietary and Confidential   P9

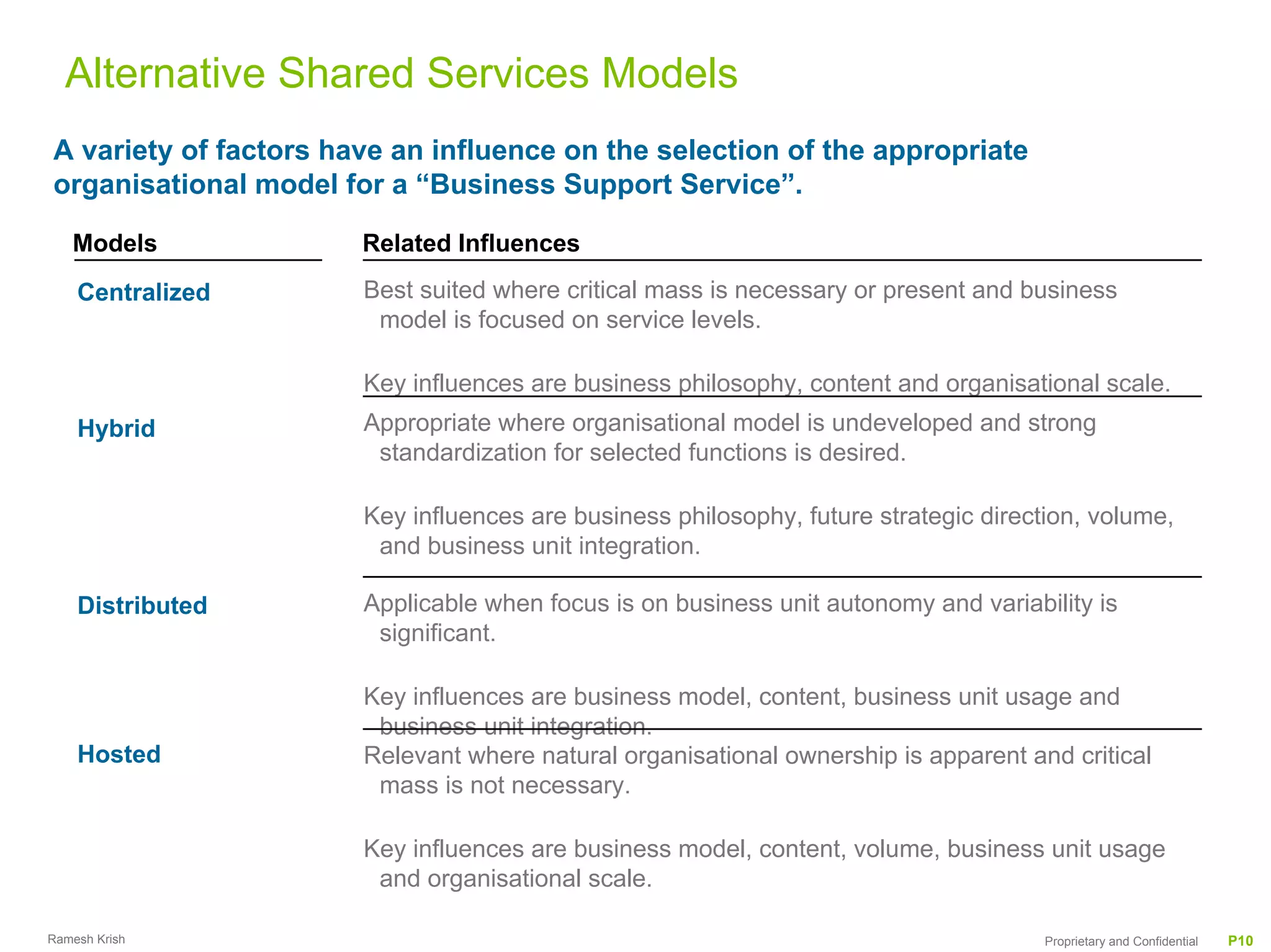

Alternative Shared Services Models
A variety of factors have an influence on the selection of the appropriate
organisational model for a “Business Support Service”.

   Models              Related Influences
    Centralized        Best suited where critical mass is necessary or present and business
                        model is focused on service levels.

                       Key influences are business philosophy, content and organisational scale.
    Hybrid             Appropriate where organisational model is undeveloped and strong
                        standardization for selected functions is desired.

                       Key influences are business philosophy, future strategic direction, volume,
                        and business unit integration.

    Distributed        Applicable when focus is on business unit autonomy and variability is
                        significant.

                       Key influences are business model, content, business unit usage and
                        business unit integration.
    Hosted             Relevant where natural organisational ownership is apparent and critical
                        mass is not necessary.

                       Key influences are business model, content, volume, business unit usage
                        and organisational scale.

Ramesh Krish                                                                          Proprietary and Confidential   P10

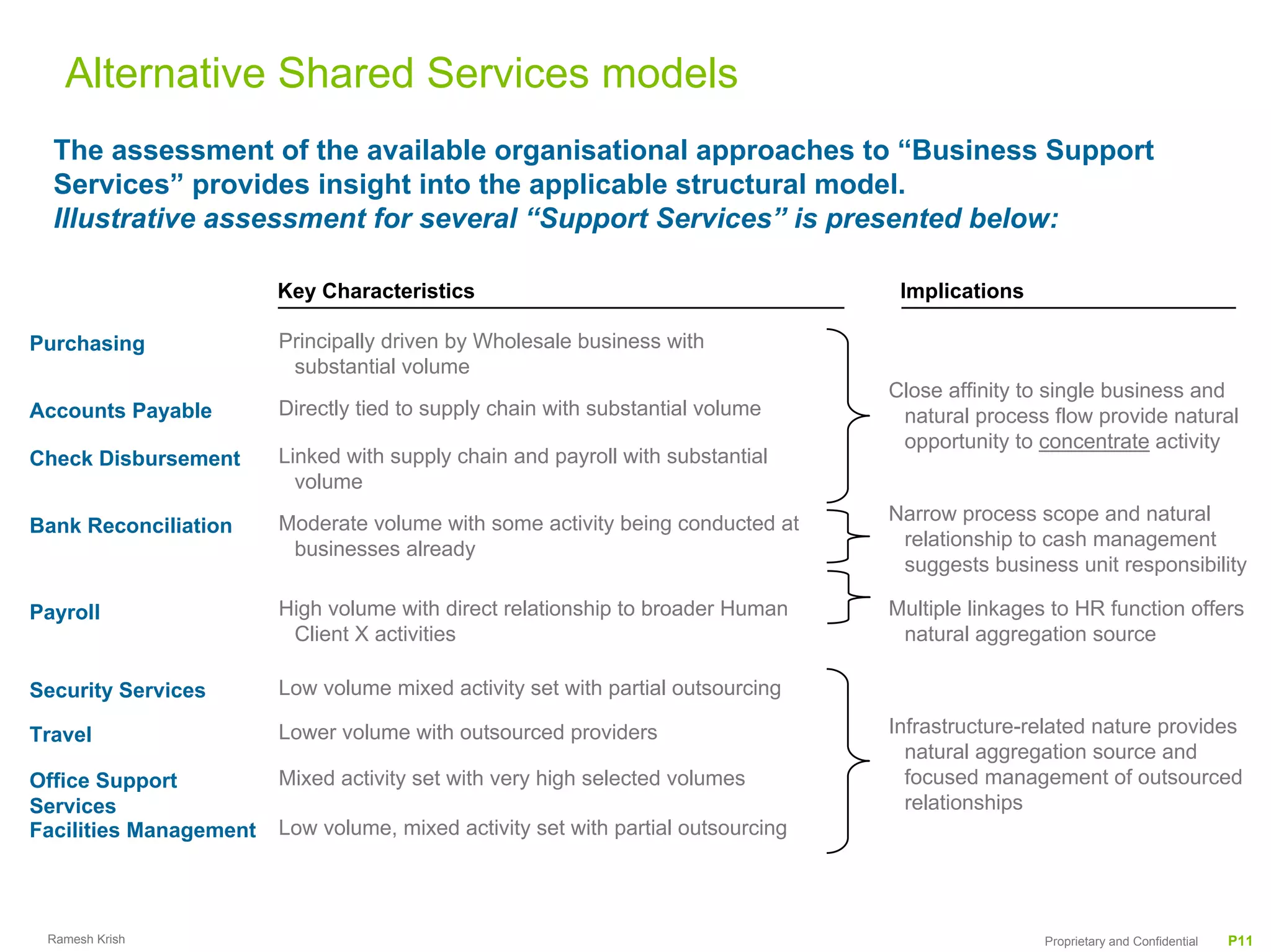

Alternative Shared Services models
  The assessment of the available organisational approaches to “Business Support
  Services” provides insight into the applicable structural model.
  Illustrative assessment for several “Support Services” is presented below:

                        Key Characteristics                                        Implications

Purchasing              Principally driven by Wholesale business with
                         substantial volume
                                                                                  Close affinity to single business and
Accounts Payable        Directly tied to supply chain with substantial volume      natural process flow provide natural
                                                                                   opportunity to concentrate activity
Check Disbursement      Linked with supply chain and payroll with substantial
                          volume
                        Moderate volume with some activity being conducted at     Narrow process scope and natural
Bank Reconciliation
                         businesses already                                        relationship to cash management
                                                                                   suggests business unit responsibility

Payroll                 High volume with direct relationship to broader Human     Multiple linkages to HR function offers
                         Client X activities                                       natural aggregation source

Security Services       Low volume mixed activity set with partial outsourcing

Travel                  Lower volume with outsourced providers                    Infrastructure-related nature provides
                                                                                    natural aggregation source and
Office Support          Mixed activity set with very high selected volumes          focused management of outsourced
Services                                                                            relationships
Facilities Management   Low volume, mixed activity set with partial outsourcing

 Ramesh Krish                                                                                      Proprietary and Confidential   P11

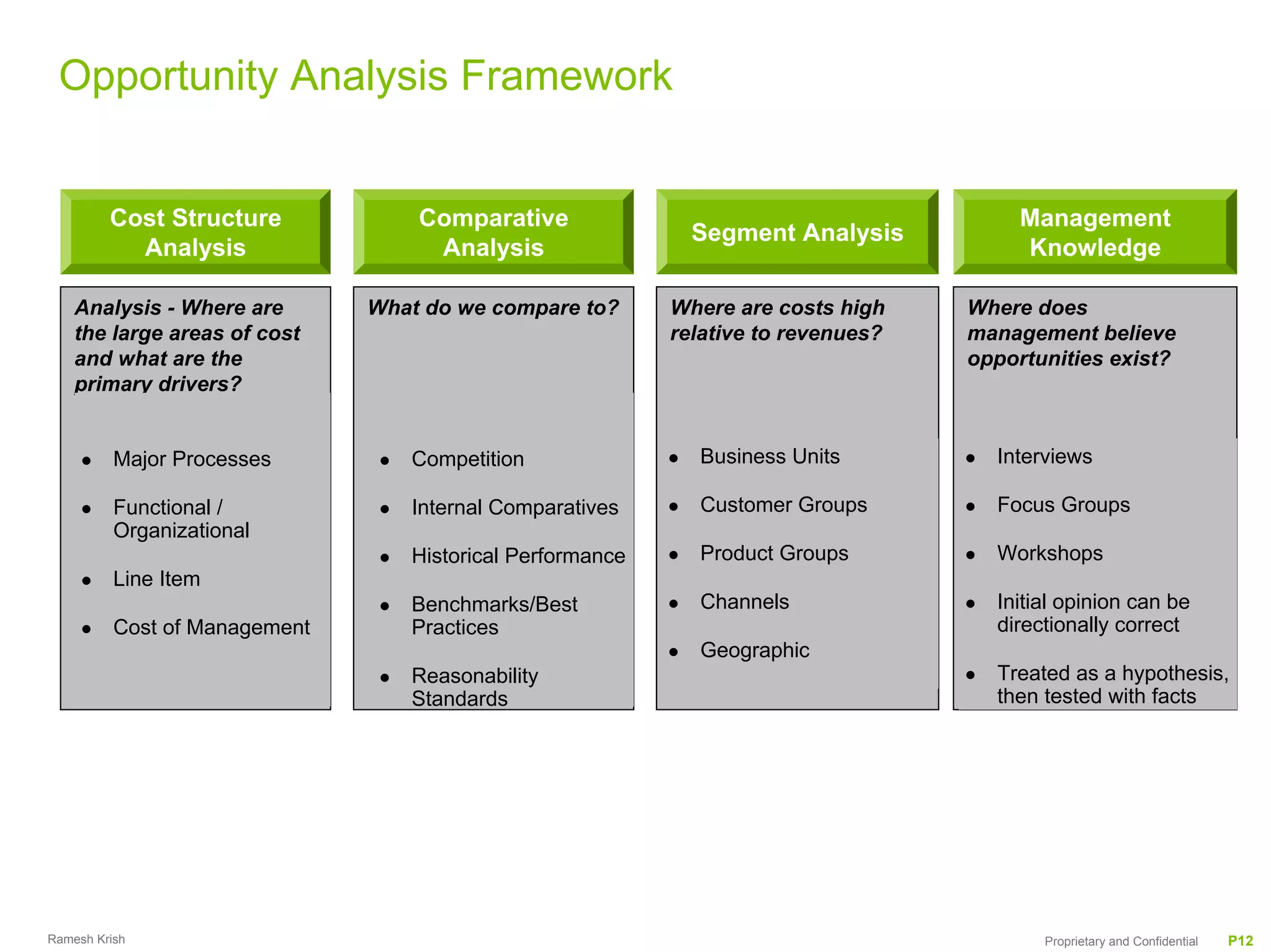

Opportunity Analysis Framework

         Cost Structure            Comparative                                          Management
                                                             Segment Analysis
           Analysis                 Analysis                                            Knowledge

    Analysis - Where are       What do we compare to?      Where are costs high    Where does
    the large areas of cost                                relative to revenues?   management believe
    and what are the                                                               opportunities exist?
    primary drivers?

          Major Processes         Competition                Business Units          Interviews

          Functional /            Internal Comparatives      Customer Groups         Focus Groups
          Organizational
                                  Historical Performance     Product Groups          Workshops
          Line Item
                                  Benchmarks/Best            Channels                Initial opinion can be
          Cost of Management      Practices                                          directionally correct
                                                             Geographic
                                  Reasonability                                      Treated as a hypothesis,
                                  Standards                                          then tested with facts

Ramesh Krish                                                                              Proprietary and Confidential   P12
4 Shared Services Deployment

Ramesh Krish                           Proprietary and Confidential   P13

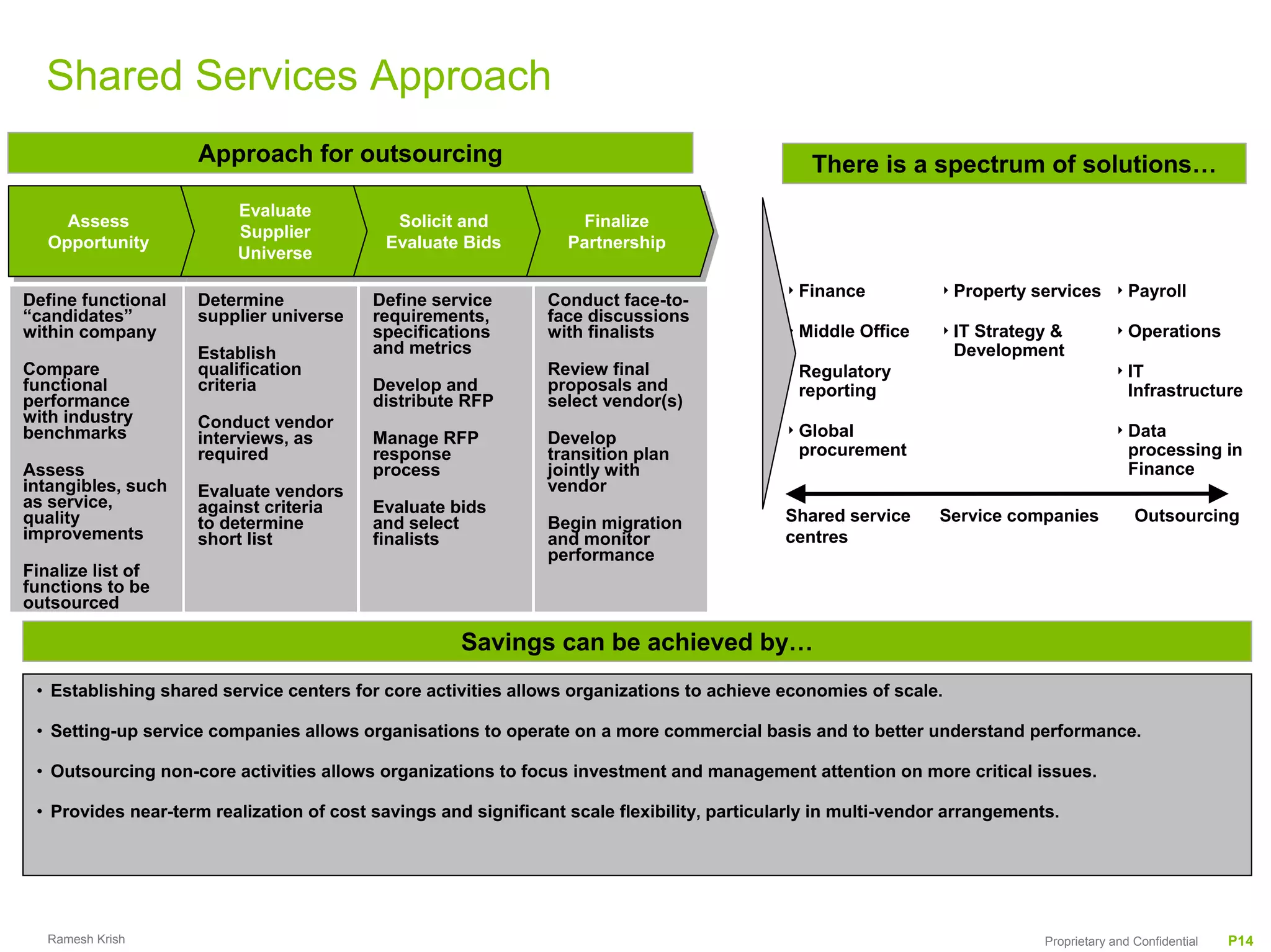

Shared Services Approach
                    Approach for outsourcing                                                    There is a spectrum of solutions…
                         Evaluate
                          Evaluate
     Assess
     Assess                                  Solicit and
                                              Solicit and          Finalize
                                                                    Finalize
                         Supplier
                          Supplier
   Opportunity
   Opportunity                              Evaluate Bids
                                            Evaluate Bids         Partnership
                                                                  Partnership
                         Universe
                         Universe
                                                                                             4 Finance           4 Property   services     4 Payroll
Define functional   Determine             Define service       Conduct face-to-
“candidates”        supplier universe     requirements,        face discussions
within company                            specifications       with finalists                4 Middle   Office   4 IT
                                                                                                                    Strategy &             4 Operations
                    Establish             and metrics                                                             Development
Compare             qualification                              Review final                  4 Regulatory                                  4 IT
functional          criteria              Develop and          proposals and                  reporting                                       Infrastructure
performance                               distribute RFP       select vendor(s)
with industry       Conduct vendor
benchmarks                                                                                   4 Global                                      4 Data
                    interviews, as        Manage RFP           Develop
                    required              response             transition plan                procurement                                     processing in
Assess                                    process              jointly with                                                                   Finance
intangibles, such   Evaluate vendors                           vendor
as service,         against criteria      Evaluate bids
quality             to determine          and select           Begin migration               Shared service      Service companies             Outsourcing
improvements        short list            finalists            and monitor                   centres
                                                               performance
Finalize list of
functions to be
outsourced

                                                     Savings can be achieved by…
 • Establishing shared service centers for core activities allows organizations to achieve economies of scale.

 • Setting-up service companies allows organisations to operate on a more commercial basis and to better understand performance.

 • Outsourcing non-core activities allows organizations to focus investment and management attention on more critical issues.

 • Provides near-term realization of cost savings and significant scale flexibility, particularly in multi-vendor arrangements.

   Ramesh Krish                                                                                                                Proprietary and Confidential   P14

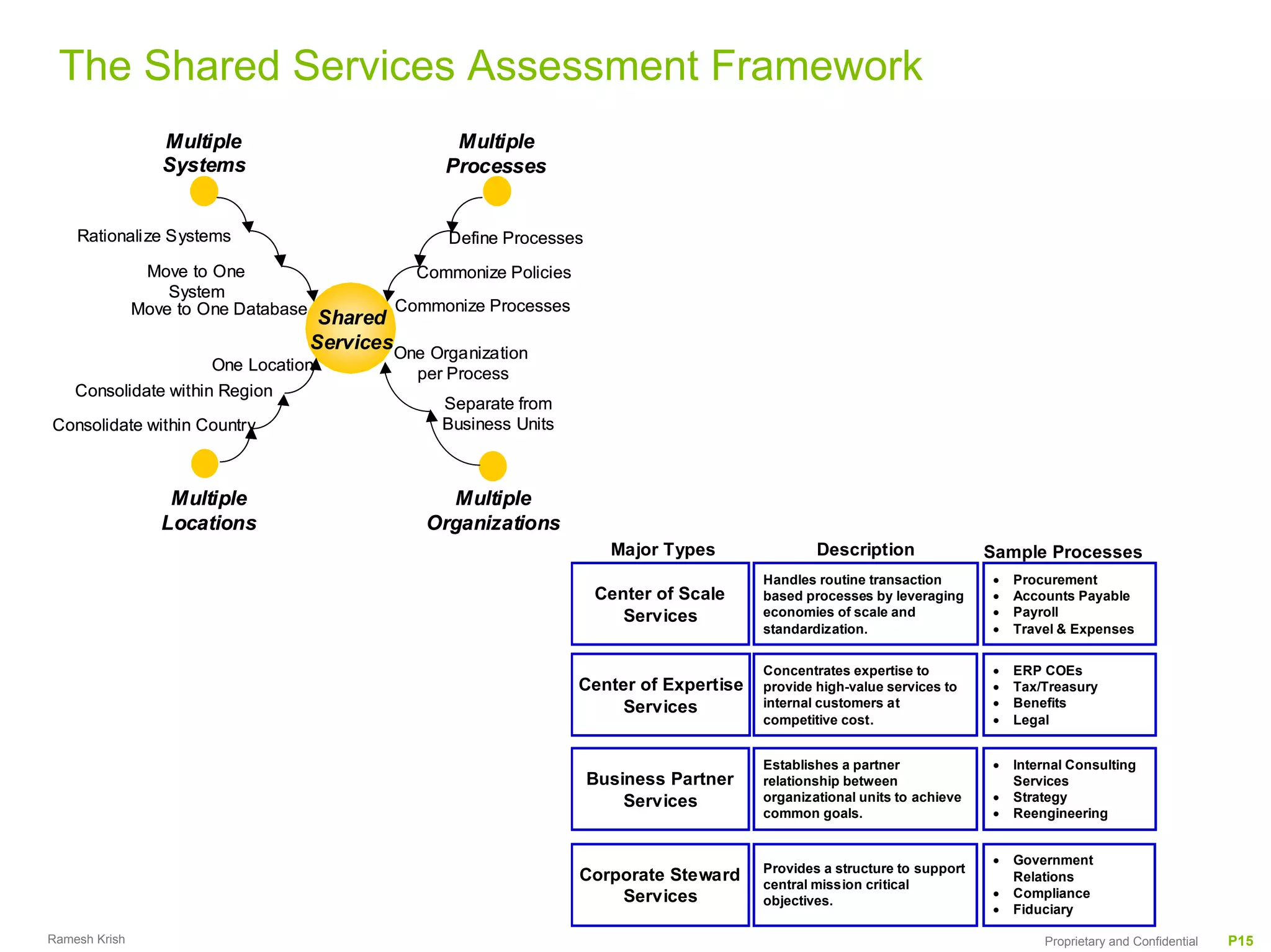

The Shared Services Assessment Framework
                  Multiple                           Multiple
                  Systems                           Processes

    Rationalize Systems                              Define Processes
                Move to One                      Commonize Policies
                   System
               Move to One Database            Commonize Processes
                                       Shared
                                      ServicesOne Organization
                        One Location
                                                 per Process
    Consolidate within Region
                                                    Separate from
Consolidate within Country                          Business Units

                   Multiple                         Multiple
                  Locations                       Organizations
                                                                          Major Types               Description               Sample Processes
                                                                                            Handles routine transaction       •   Procurement
                                                                        Center of Scale     based processes by leveraging     •   Accounts Payable
                                                                           Services         economies of scale and            •   Payroll
                                                                                            standardization.                  •   Travel & Expenses

                                                                                            Concentrates expertise to         •   ERP COEs
                                                                      Center of Expertise   provide high-value services to    •   Tax/Treasury
                                                                           Services         internal customers at             •   Benefits
                                                                                            competitive cost.                 •   Legal

                                                                                            Establishes a partner             •   Internal Consulting
                                                                        Business Partner    relationship between                  Services
                                                                            Services        organizational units to achieve   •   Strategy
                                                                                            common goals.                     •   Reengineering

                                                                                                                              •   Government
                                                                                            Provides a structure to support
                                                                      Corporate Steward     central mission critical
                                                                                                                                  Relations
                                                                          Services                                            •   Compliance
                                                                                            objectives.
                                                                                                                              •   Fiduciary

Ramesh Krish                                                                                                                          Proprietary and Confidential   P15

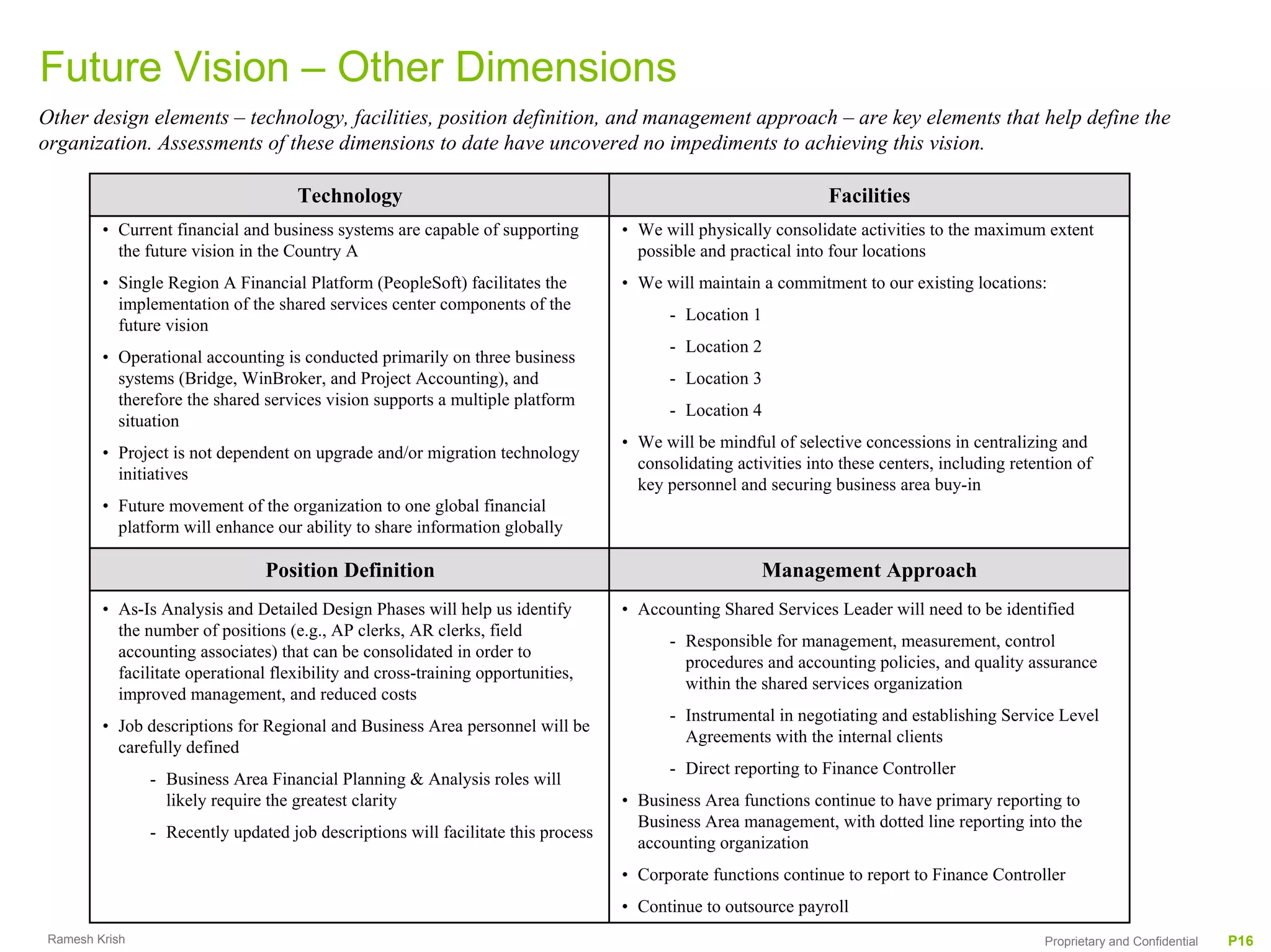

Future Vision – Other Dimensions
Other design elements – technology, facilities, position definition, and management approach – are key elements that help define the
organization. Assessments of these dimensions to date have uncovered no impediments to achieving this vision.

                                     Technology                                                                  Facilities
         • Current financial and business systems are capable of supporting        • We will physically consolidate activities to the maximum extent
           the future vision in the Country A                                        possible and practical into four locations
         • Single Region A Financial Platform (PeopleSoft) facilitates the         • We will maintain a commitment to our existing locations:
           implementation of the shared services center components of the
                                                                                          - Location 1
           future vision
                                                                                          - Location 2
         • Operational accounting is conducted primarily on three business
           systems (Bridge, WinBroker, and Project Accounting), and                       - Location 3
           therefore the shared services vision supports a multiple platform
                                                                                          - Location 4
           situation
                                                                                   • We will be mindful of selective concessions in centralizing and
         • Project is not dependent on upgrade and/or migration technology
                                                                                     consolidating activities into these centers, including retention of
           initiatives
                                                                                     key personnel and securing business area buy-in
         • Future movement of the organization to one global financial
           platform will enhance our ability to share information globally

                                 Position Definition                                                   Management Approach
         • As-Is Analysis and Detailed Design Phases will help us identify         • Accounting Shared Services Leader will need to be identified
           the number of positions (e.g., AP clerks, AR clerks, field
                                                                                          - Responsible for management, measurement, control
           accounting associates) that can be consolidated in order to
                                                                                            procedures and accounting policies, and quality assurance
           facilitate operational flexibility and cross-training opportunities,
                                                                                            within the shared services organization
           improved management, and reduced costs
                                                                                          - Instrumental in negotiating and establishing Service Level
         • Job descriptions for Regional and Business Area personnel will be
                                                                                            Agreements with the internal clients
           carefully defined
                                                                                          - Direct reporting to Finance Controller
                - Business Area Financial Planning & Analysis roles will
                  likely require the greatest clarity                              • Business Area functions continue to have primary reporting to
                                                                                     Business Area management, with dotted line reporting into the
                - Recently updated job descriptions will facilitate this process
                                                                                     accounting organization
                                                                                   • Corporate functions continue to report to Finance Controller
                                                                                   • Continue to outsource payroll
 Ramesh Krish                                                                                                                                    Proprietary and Confidential   P16

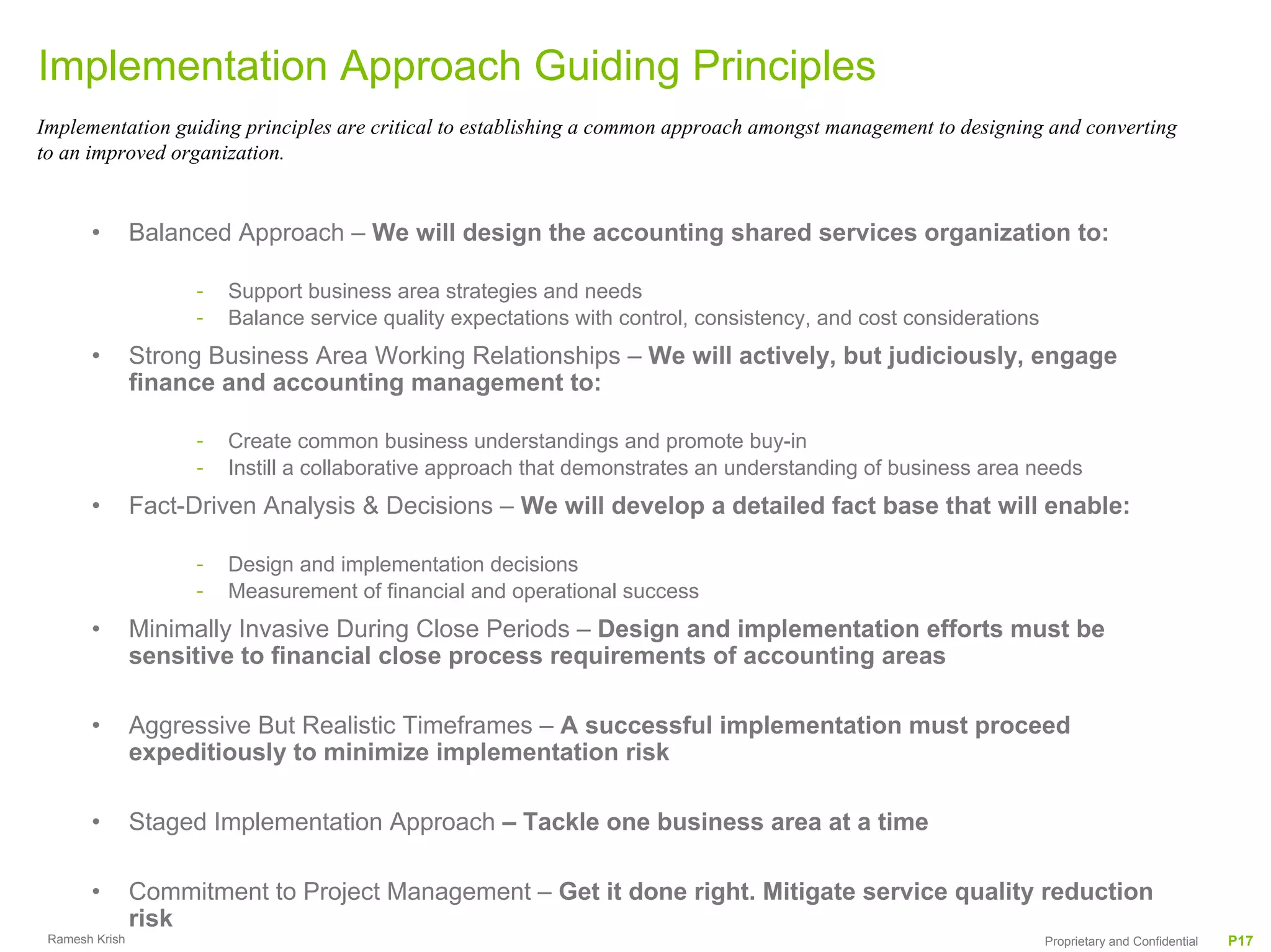

Implementation Approach Guiding Principles
Implementation guiding principles are critical to establishing a common approach amongst management to designing and converting
to an improved organization.

       •        Balanced Approach – We will design the accounting shared services organization to:

                     -   Support business area strategies and needs
                     -   Balance service quality expectations with control, consistency, and cost considerations
       •        Strong Business Area Working Relationships – We will actively, but judiciously, engage
                finance and accounting management to:

                     -   Create common business understandings and promote buy-in
                     -   Instill a collaborative approach that demonstrates an understanding of business area needs
       •        Fact-Driven Analysis & Decisions – We will develop a detailed fact base that will enable:

                     -   Design and implementation decisions
                     -   Measurement of financial and operational success
       •        Minimally Invasive During Close Periods – Design and implementation efforts must be
                sensitive to financial close process requirements of accounting areas

       •        Aggressive But Realistic Timeframes – A successful implementation must proceed
                expeditiously to minimize implementation risk

       •        Staged Implementation Approach – Tackle one business area at a time

       •        Commitment to Project Management – Get it done right. Mitigate service quality reduction
                risk
 Ramesh Krish                                                                                                      Proprietary and Confidential   P17

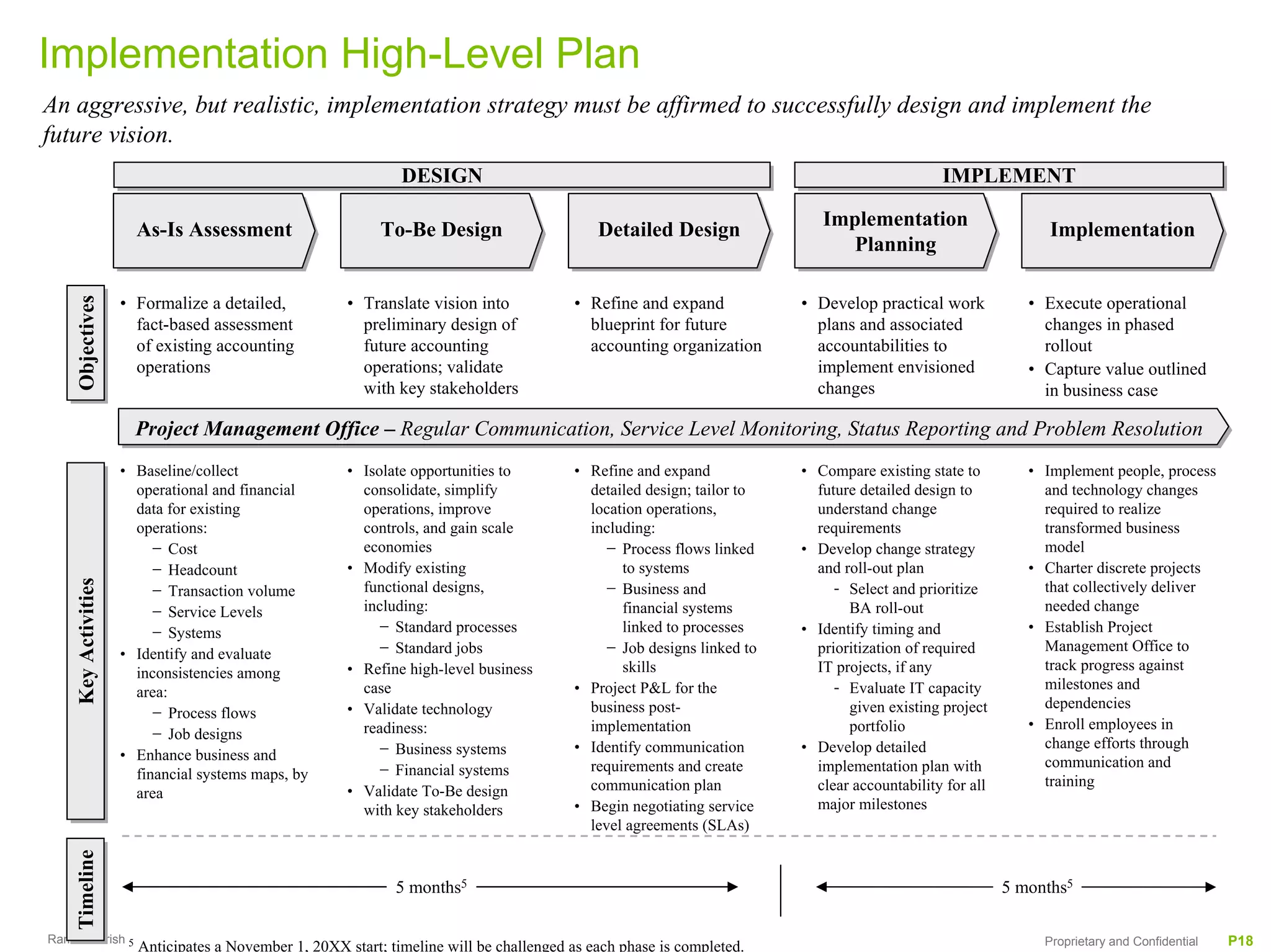

Implementation High-Level Plan
An aggressive, but realistic, implementation strategy must be affirmed to successfully design and implement the
future vision.
                                                                DESIGN
                                                                DESIGN                                                                         IMPLEMENT
                                                                                                                                               IMPLEMENT
                                                                                                                            Implementation
                        As-Is Assessment                     To-Be Design                     Detailed Design                                                   Implementation
                                                                                                                              Planning

                      • Formalize a detailed,           • Translate vision into           • Refine and expand            • Develop practical work            • Execute operational
     Objectives
     Objectives

                        fact-based assessment             preliminary design of             blueprint for future           plans and associated                changes in phased
                        of existing accounting            future accounting                 accounting organization        accountabilities to                 rollout
                        operations                        operations; validate                                             implement envisioned              • Capture value outlined
                                                          with key stakeholders                                            changes                             in business case

                        Project Management Office – Regular Communication, Service Level Monitoring, Status Reporting and Problem Resolution
                      • Baseline/collect                • Isolate opportunities to        • Refine and expand            • Compare existing state to         • Implement people, process
                        operational and financial         consolidate, simplify             detailed design; tailor to     future detailed design to           and technology changes
                        data for existing                 operations, improve               location operations,           understand change                   required to realize
                        operations:                       controls, and gain scale          including:                     requirements                        transformed business
                           − Cost                         economies                            − Process flows linked    • Develop change strategy             model
                           − Headcount                  • Modify existing                        to systems                and roll-out plan                 • Charter discrete projects
     Key Activities

                                                          functional designs,                  − Business and                 - Select and prioritize          that collectively deliver
     Key Activities

                           − Transaction volume
                           − Service Levels               including:                             financial systems              BA roll-out                    needed change
                           − Systems                         − Standard processes                linked to processes     • Identify timing and               • Establish Project
                                                             − Standard jobs                   − Job designs linked to     prioritization of required          Management Office to
                      • Identify and evaluate
                                                        • Refine high-level business             skills                    IT projects, if any                 track progress against
                        inconsistencies among
                                                          case                            • Project P&L for the               - Evaluate IT capacity           milestones and
                        area:
                                                        • Validate technology               business post-                      given existing project         dependencies
                           − Process flows
                                                          readiness:                        implementation                      portfolio                    • Enroll employees in
                           − Job designs
                                                             − Business systems           • Identify communication       • Develop detailed                    change efforts through
                      • Enhance business and                                                                                                                   communication and
                                                             − Financial systems            requirements and create        implementation plan with
                        financial systems maps, by                                                                                                             training
                                                        • Validate To-Be design             communication plan             clear accountability for all
                        area
                                                          with key stakeholders           • Begin negotiating service      major milestones
                                                                                            level agreements (SLAs)
    Timeline
    Timeline

                                                               5 months5                                                                                  5 months5

Ramesh Krish 5                                                                                                                                                 Proprietary and Confidential   P18
                        Anticipates a November 1, 20XX start; timeline will be challenged as each phase is completed.

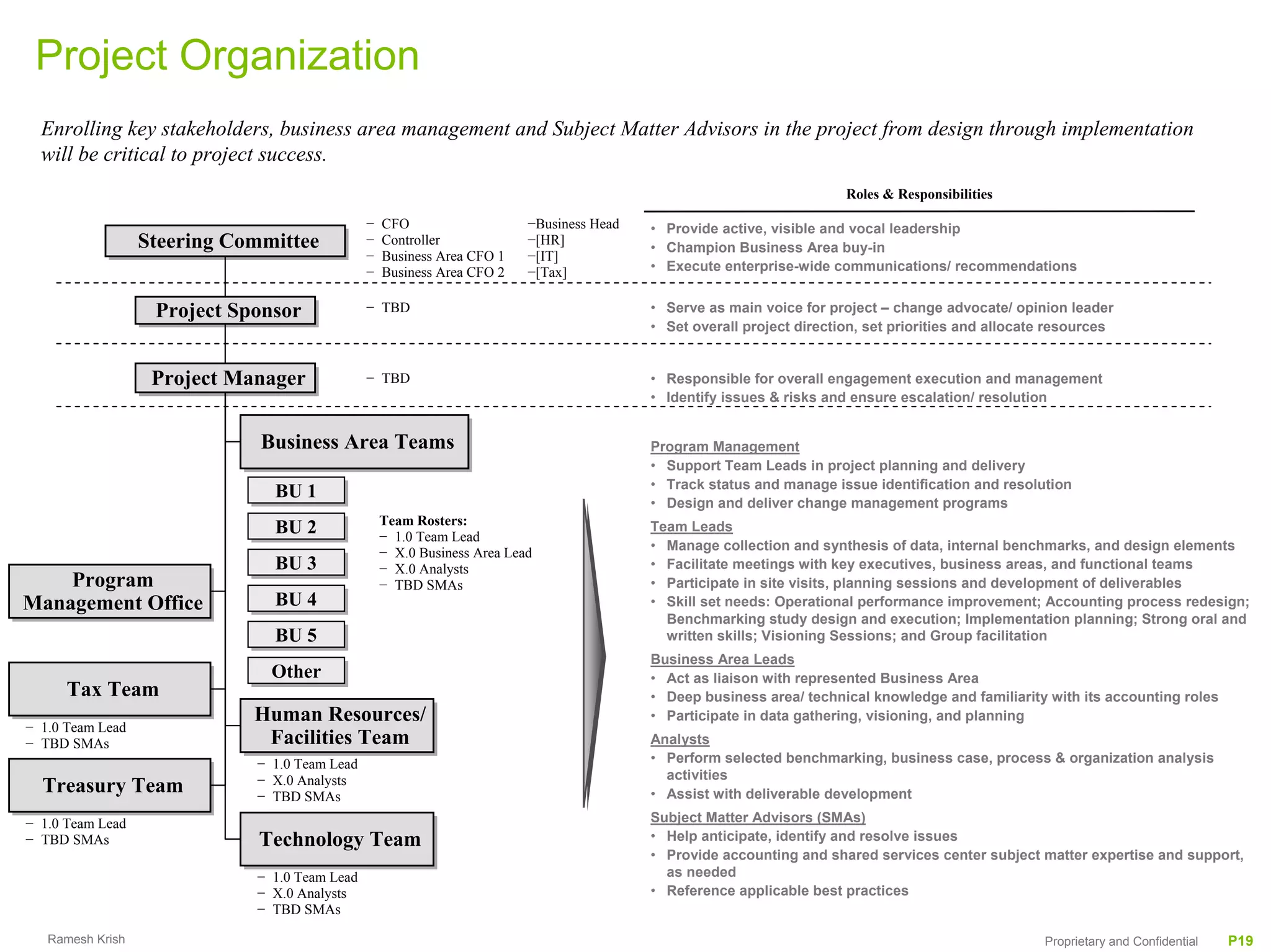

Project Organization
  Enrolling key stakeholders, business area management and Subject Matter Advisors in the project from design through implementation
  will be critical to project success.
                                                                                                                        Roles & Responsibilities

                                               −   CFO                    −Business Head   • Provide active, visible and vocal leadership
                  Steering Committee
                  Steering Committee           −   Controller             −[HR]
                                                                                           • Champion Business Area buy-in
                                               −   Business Area CFO 1    −[IT]
                                               −   Business Area CFO 2    −[Tax]           • Execute enterprise-wide communications/ recommendations

                   Project Sponsor             − TBD                                       • Serve as main voice for project – change advocate/ opinion leader
                   Project Sponsor
                                                                                           • Set overall project direction, set priorities and allocate resources

                   Project Manager
                   Project Manager             − TBD                                       • Responsible for overall engagement execution and management
                                                                                           • Identify issues & risks and ensure escalation/ resolution

                             Business Area Teams
                             Business Area Teams                                           Program Management
                                                                                           • Support Team Leads in project planning and delivery
                                                                                           • Track status and manage issue identification and resolution
                               BU 1
                               BU 1                                                        • Design and deliver change management programs
                                                   Team Rosters:
                               BU 2
                               BU 2                − 1.0 Team Lead
                                                                                           Team Leads
                                                                                           • Manage collection and synthesis of data, internal benchmarks, and design elements
                                                   − X.0 Business Area Lead
                               BU 3
                               BU 3                − X.0 Analysts                          • Facilitate meetings with key executives, business areas, and functional teams
    Program
    Program                                        − TBD SMAs                              • Participate in site visits, planning sessions and development of deliverables
Management Office
Management Office              BU 4
                               BU 4                                                        • Skill set needs: Operational performance improvement; Accounting process redesign;
                                                                                             Benchmarking study design and execution; Implementation planning; Strong oral and
                               BU 5
                               BU 5                                                          written skills; Visioning Sessions; and Group facilitation
                                                                                           Business Area Leads
                               Other
                               Other                                                       • Act as liaison with represented Business Area
      Tax Team
      Tax Team                                                                             • Deep business area/ technical knowledge and familiarity with its accounting roles
                             Human Resources/
                             Human Resources/                                              • Participate in data gathering, visioning, and planning
− 1.0 Team Lead
− TBD SMAs                    Facilities Team
                              Facilities Team                                              Analysts
                             − 1.0 Team Lead                                               • Perform selected benchmarking, business case, process & organization analysis
                             − X.0 Analysts                                                  activities
  Treasury Team
  Treasury Team              − TBD SMAs                                                    • Assist with deliverable development

− 1.0 Team Lead                                                                            Subject Matter Advisors (SMAs)
− TBD SMAs                   Technology Team                                               • Help anticipate, identify and resolve issues
                             Technology Team                                               • Provide accounting and shared services center subject matter expertise and support,
                             − 1.0 Team Lead                                                 as needed
                             − X.0 Analysts                                                • Reference applicable best practices
                             − TBD SMAs

   Ramesh Krish                                                                                                                                       Proprietary and Confidential   P19
5 Alternate Shared Services
                 Models

Ramesh Krish                         Proprietary and Confidential   P20

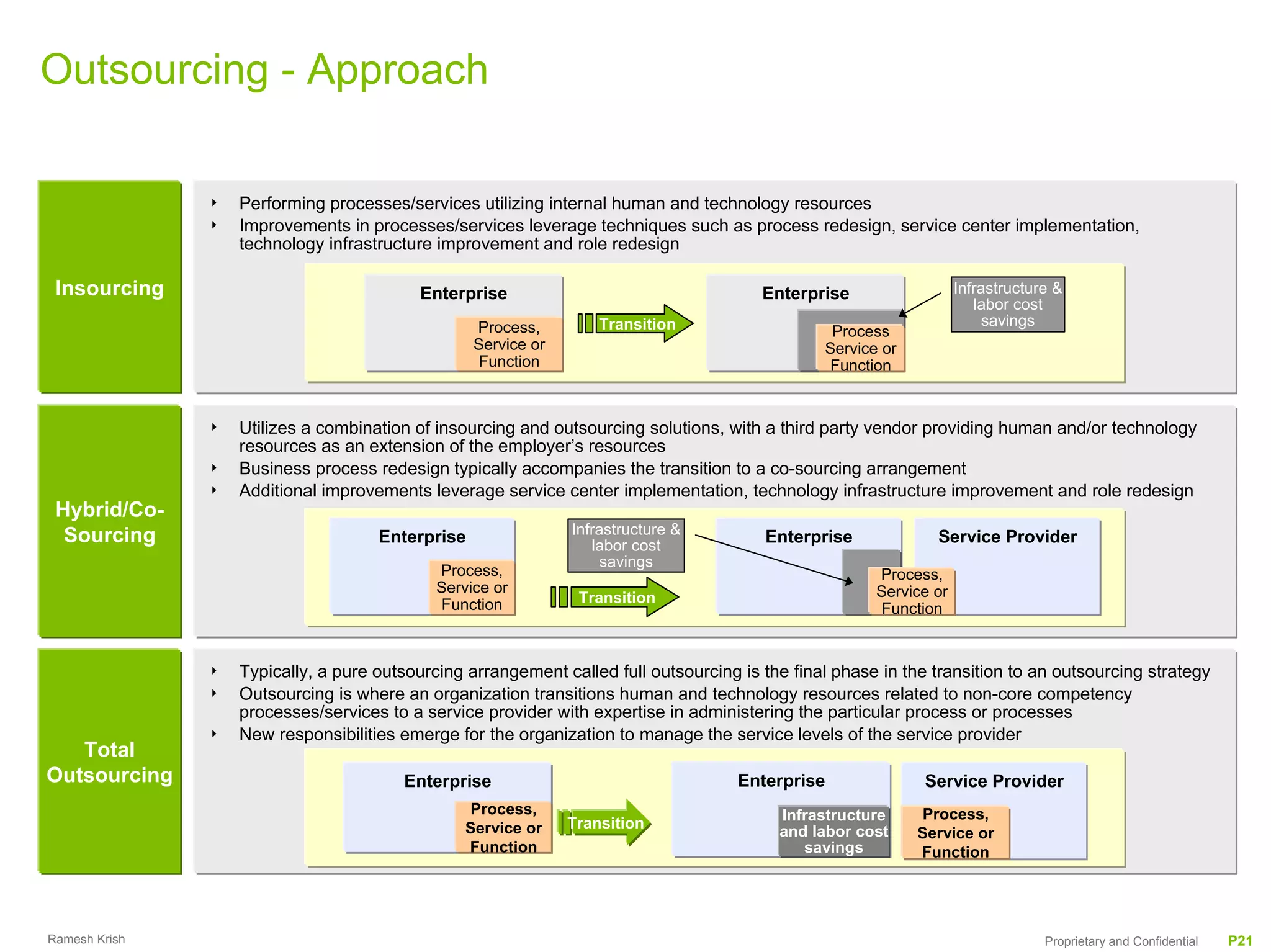

Outsourcing - Approach

               4   Performing processes/services utilizing internal human and technology resources
               4   Improvements in processes/services leverage techniques such as process redesign, service center implementation,
                   technology infrastructure improvement and role redesign

 Insourcing                                Enterprise                                   Enterprise                  Infrastructure &
                                                                                                                       labor cost
                                                  Process,         Transition                                            savings
                                                                                                 Process
                                                  Service or                                    Service or
                                                   Function                                      Function

               4   Utilizes a combination of insourcing and outsourcing solutions, with a third party vendor providing human and/or technology
                   resources as an extension of the employer’s resources
               4   Business process redesign typically accompanies the transition to a co-sourcing arrangement
               4   Additional improvements leverage service center implementation, technology infrastructure improvement and role redesign
 Hybrid/Co-
  Sourcing                                                     Infrastructure &
                                     Enterprise                   labor cost
                                                                                        Enterprise             Service Provider
                                                                    savings
                                             Process,                                                  Process,
                                             Service or                                                Service or
                                              Function          Transition
                                                                                                        Function

               4   Typically, a pure outsourcing arrangement called full outsourcing is the final phase in the transition to an outsourcing strategy
               4   Outsourcing is where an organization transitions human and technology resources related to non-core competency
                   processes/services to a service provider with expertise in administering the particular process or processes
               4   New responsibilities emerge for the organization to manage the service levels of the service provider
   Total
Outsourcing                             Enterprise                                   Enterprise               Service Provider
                                                  Process,                                Infrastructure      Process,
                                                 Service or    Transition
                                                                                          and labor cost     Service or
                                                 Function                                    savings         Function

Ramesh Krish                                                                                                                     Proprietary and Confidential   P21

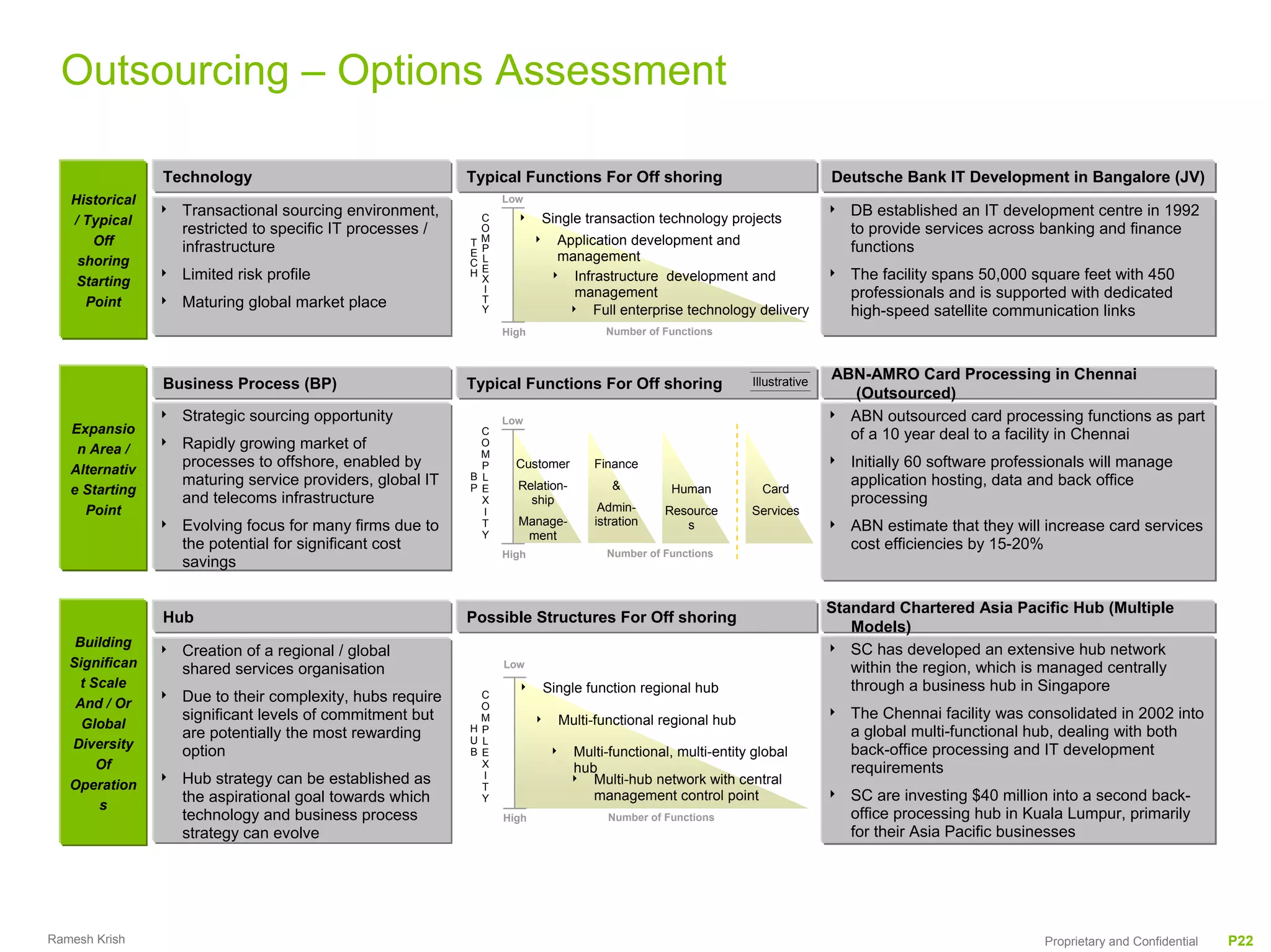

Outsourcing – Options Assessment

                Technology                                  Typical Functions For Off shoring                                    Deutsche Bank IT Development in Bangalore (JV)
   Historical                                                       Low
                4   Transactional sourcing environment,                                                                          4   DB established an IT development centre in 1992
   / Typical                                                    C     4    Single transaction technology projects
                    restricted to specific IT processes /       O                                                                    to provide services across banking and finance
      Off                                                   T   M          4    Application development and
                    infrastructure                          E   P                                                                    functions
    shoring                                                 C   L               management
                                                                E
                4   Limited risk profile                    H
                                                                X              4 Infrastructure development and                  4   The facility spans 50,000 square feet with 450
    Starting                                                    I
                                                                T
                                                                                  management                                         professionals and is supported with dedicated
     Point      4   Maturing global market place                Y                4 Full enterprise technology delivery               high-speed satellite communication links
                                                                    High                 Number of Functions

                                                                                                                  Illustrative
                                                                                                                                 ABN-AMRO Card Processing in Chennai
                Business Process (BP)                       Typical Functions For Off shoring
                                                                                                                                    (Outsourced)
                4   Strategic sourcing opportunity                  Low                                                          4 ABN outsourced card processing functions as part
   Expansio                                                   C                                                                    of a 10 year deal to a facility in Chennai
    n Area /    4   Rapidly growing market of                 O
                                                              M
   Alternativ
                    processes to offshore, enabled by         P       Customer         Finance                                   4   Initially 60 software professionals will manage
                    maturing service providers, global IT   B L                                                                      application hosting, data and back office
   e Starting                                               P E       Relation-           &         Human           Card
                    and telecoms infrastructure               X         ship                                                         processing
     Point                                                    I                         Admin-     Resource      Services
                4   Evolving focus for many firms due to      T       Manage-          istration      s                          4   ABN estimate that they will increase card services
                                                              Y        ment
                    the potential for significant cost                                                                               cost efficiencies by 15-20%
                                                                    High                 Number of Functions
                    savings

                                                                                                                                 Standard Chartered Asia Pacific Hub (Multiple
                Hub                                         Possible Structures For Off shoring
                                                                                                                                    Models)
    Building
                4   Creation of a regional / global                                                                              4 SC has developed an extensive hub network
   Significan       shared services organisation                    Low                                                             within the region, which is managed centrally
     t Scale                                                          4    Single function regional hub                             through a business hub in Singapore
                4   Due to their complexity, hubs require     C
    And / Or                                                  O
                    significant levels of commitment but      M                                                                  4   The Chennai facility was consolidated in 2002 into
     Global                                                                4    Multi-functional regional hub
                                                            HP                                                                       a global multi-functional hub, dealing with both
                    are potentially the most rewarding      U L
   Diversity                                                                                                                         back-office processing and IT development
                    option                                  B E                4   Multi-functional, multi-entity global
        Of                                                    X                    hub                                               requirements
                4   Hub strategy can be established as        I                    4 Multi-hub network with central
   Operation                                                  T
                    the aspirational goal towards which       Y                       management control point                   4   SC are investing $40 million into a second back-
        s
                    technology and business process                 High                 Number of Functions                         office processing hub in Kuala Lumpur, primarily
                    strategy can evolve                                                                                              for their Asia Pacific businesses

Ramesh Krish                                                                                                                                                     Proprietary and Confidential   P22

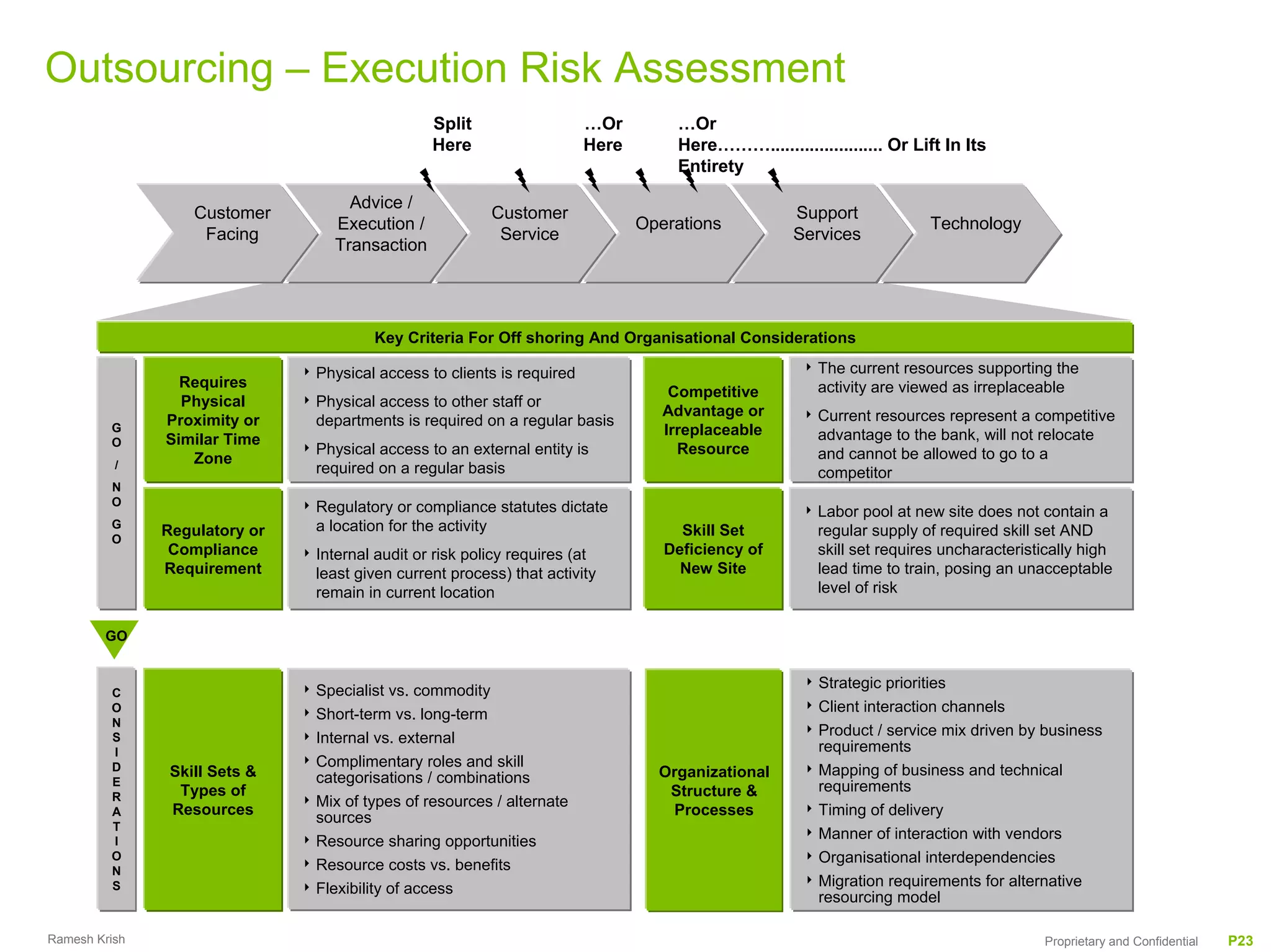

Outsourcing – Execution Risk Assessment
                                                   Split                    …Or        …Or
                                                   Here                     Here       Here………....................... Or Lift In Its
                                                                                       Entirety

                                      Advice /
                   Customer                                 Customer                                   Support
                                    Execution /                                    Operations                              Technology
                    Facing                                   Service                                   Services
                                    Transaction

                                            Key Criteria For Off shoring And Organisational Considerations

                               4 Physical   access to clients is required                                4 The  current resources supporting the
                 Requires                                                                                  activity are viewed as irreplaceable
                                                                                       Competitive
                 Physical      4 Physicalaccess to other staff or
                                                                                      Advantage or       4 Currentresources represent a competitive
         G
               Proximity or      departments is required on a regular basis
                                                                                      Irreplaceable        advantage to the bank, will not relocate
         O     Similar Time
                               4 Physical access to an external entity is               Resource           and cannot be allowed to go to a
          /       Zone
                                 required on a regular basis                                               competitor
         N
         O                     4 Regulatory   or compliance statutes dictate                             4 Labor   pool at new site does not contain a
         G
               Regulatory or     a location for the activity                            Skill Set          regular supply of required skill set AND
         O
                Compliance     4 Internal audit or risk policy requires (at           Deficiency of        skill set requires uncharacteristically high
               Requirement       least given current process) that activity             New Site           lead time to train, posing an unacceptable
                                 remain in current location                                                level of risk

        GO

                                                                                                         4 Strategic  priorities
         C                     4 Specialist  vs. commodity
         O                                                                                               4 Client interaction channels
                               4 Short-term vs. long-term
         N
                                                                                                         4 Product / service mix driven by business
         S                     4 Internal vs. external
         I                                                                                                 requirements
         D                     4 Complimentary roles and skill
                Skill Sets &                                                         Organizational      4 Mapping of business and technical
         E                       categorisations / combinations
                 Types of                                                             Structure &          requirements
         R                     4 Mix of types of resources / alternate
         A      Resources                                                             Processes          4 Timing of delivery
                                 sources
         T
                                                                                                         4 Manner of interaction with vendors
         I                     4 Resource sharing opportunities
         O                                                                                               4 Organisational interdependencies
         N                     4 Resource costs vs. benefits
         S                                                                                               4 Migration requirements for alternative
                               4 Flexibility of access
                                                                                                           resourcing model

Ramesh Krish                                                                                                                                Proprietary and Confidential   P23
6   Functional Placement

Ramesh Krish                              Proprietary and Confidential   P24

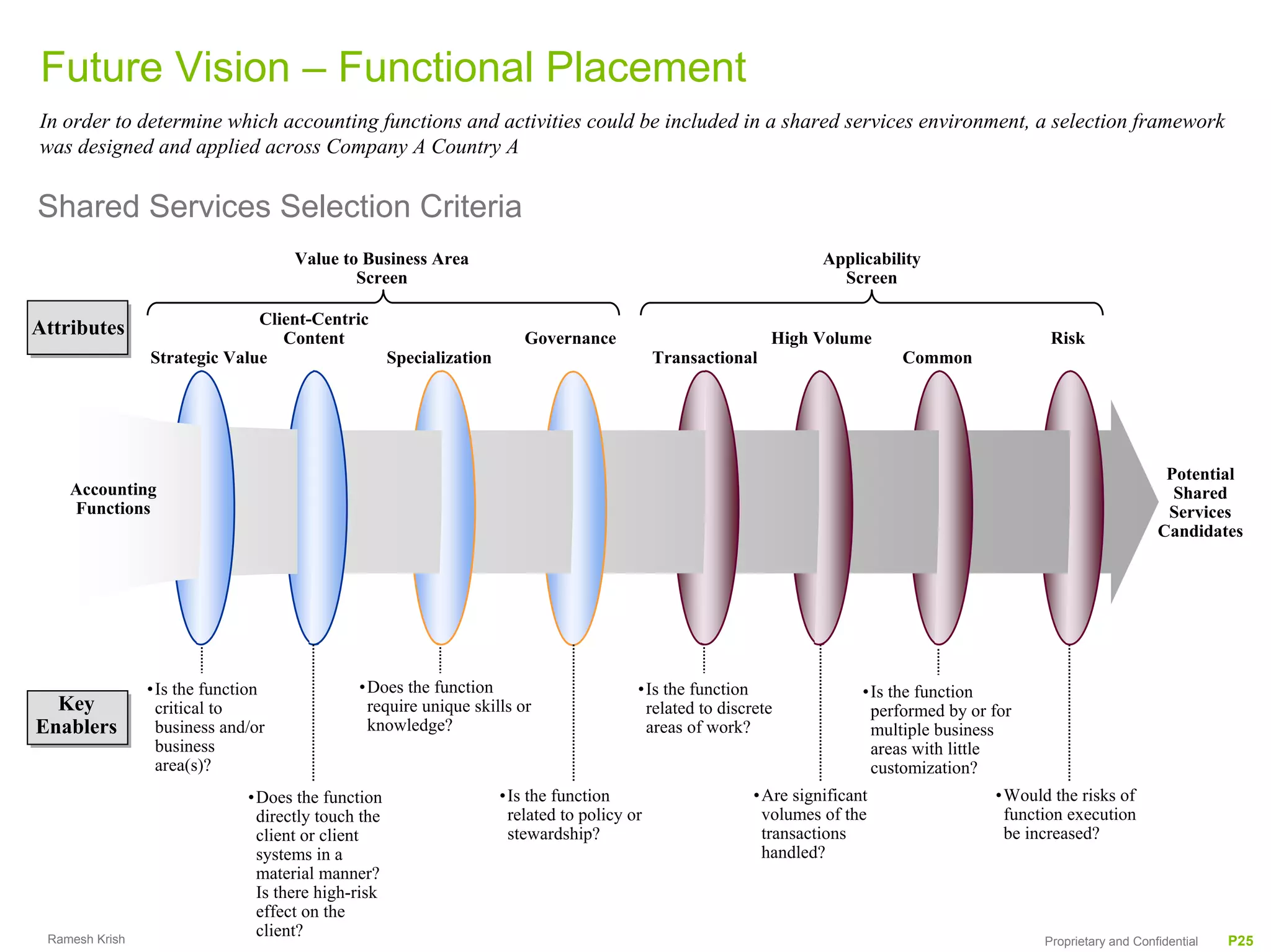

Future Vision – Functional Placement
In order to determine which accounting functions and activities could be included in a shared services environment, a selection framework
was designed and applied across Company A Country A

Shared Services Selection Criteria
                                   Value to Business Area                                                         Applicability
                                           Screen                                                                   Screen

                              Client-Centric
Attributes                       Content                               Governance                           High Volume                         Risk
                Strategic Value                    Specialization                           Transactional                    Common

                                                                                                                                                                    Potential
    Accounting                                                                                                                                                       Shared
    Functions                                                                                                                                                       Services
                                                                                                                                                                   Candidates

                •Is the function            •Does the function                          •Is the function                •Is the function
  Key            critical to                 require unique skills or                    related to discrete             performed by or for
Enablers         business and/or             knowledge?                                  areas of work?                  multiple business
                 business                                                                                                areas with little
                 area(s)?                                                                                                customization?
                             •Does the function                     •Is the function                     •Are significant                •Would the risks of
                              directly touch the                     related to policy or                 volumes of the                  function execution
                              client or client                       stewardship?                         transactions                    be increased?
                              systems in a                                                                handled?
                              material manner?
                              Is there high-risk
                              effect on the
 Ramesh Krish
                              client?
                                                                                                                                               Proprietary and Confidential   P25

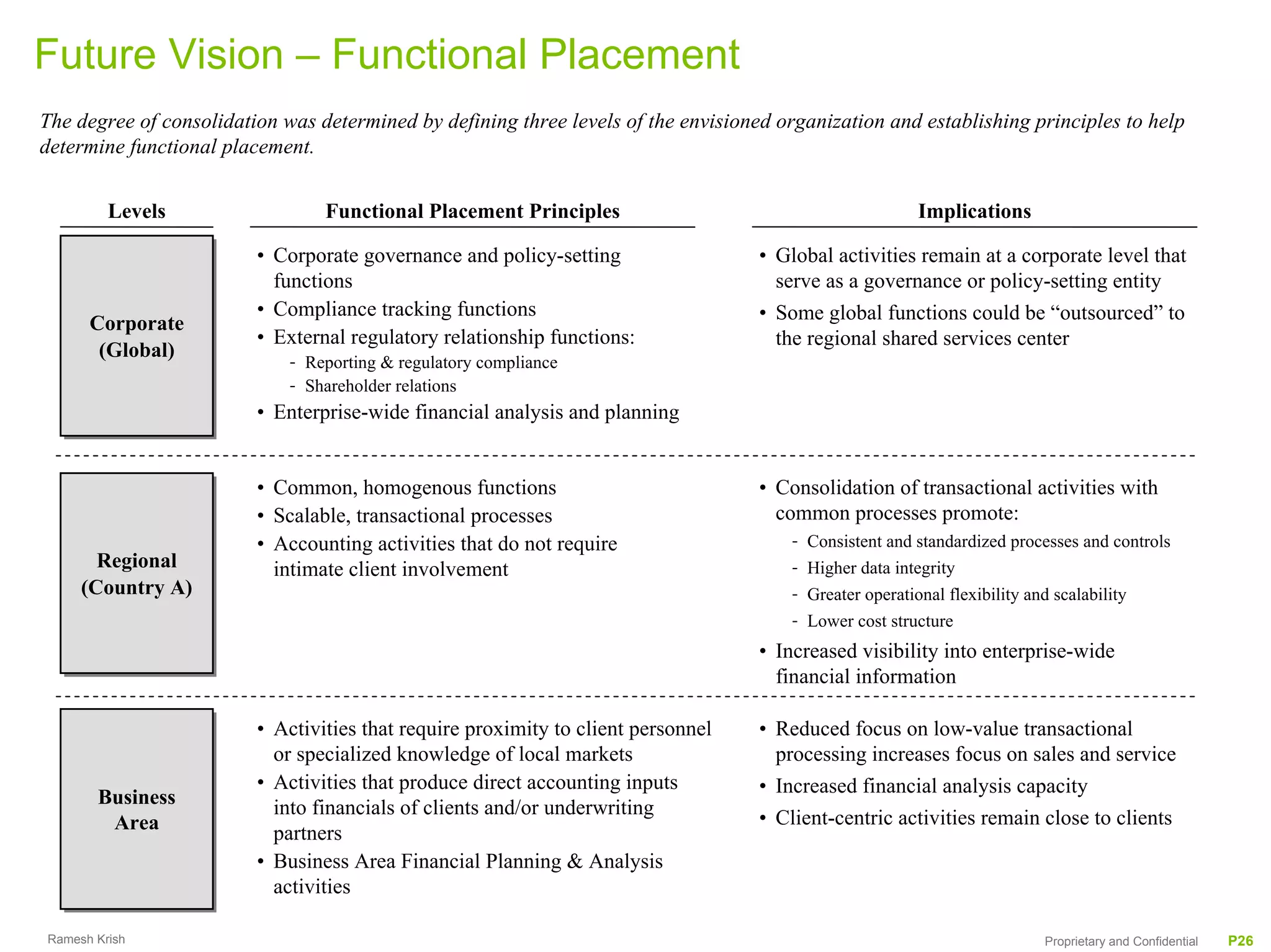

Future Vision – Functional Placement
The degree of consolidation was determined by defining three levels of the envisioned organization and establishing principles to help
determine functional placement.

         Levels                  Functional Placement Principles                                           Implications

                         • Corporate governance and policy-setting                  • Global activities remain at a corporate level that
                           functions                                                  serve as a governance or policy-setting entity
                         • Compliance tracking functions                            • Some global functions could be “outsourced” to
      Corporate
      Corporate          • External regulatory relationship functions:                the regional shared services center
       (Global)
       (Global)              - Reporting & regulatory compliance
                             - Shareholder relations
                         • Enterprise-wide financial analysis and planning

                         • Common, homogenous functions                             • Consolidation of transactional activities with
                         • Scalable, transactional processes                          common processes promote:
                         • Accounting activities that do not require                    -   Consistent and standardized processes and controls
       Regional
       Regional            intimate client involvement                                  -   Higher data integrity
     (Country A)
     (Country A)                                                                        -   Greater operational flexibility and scalability
                                                                                        -   Lower cost structure
                                                                                    • Increased visibility into enterprise-wide
                                                                                      financial information

                         • Activities that require proximity to client personnel    • Reduced focus on low-value transactional
                           or specialized knowledge of local markets                  processing increases focus on sales and service
                         • Activities that produce direct accounting inputs         • Increased financial analysis capacity
       Business
       Business            into financials of clients and/or underwriting
        Area
        Area                                                                        • Client-centric activities remain close to clients
                           partners
                         • Business Area Financial Planning & Analysis
                           activities

Ramesh Krish                                                                                                                Proprietary and Confidential   P26
Future Vision – Functional Placement
Accounting activities are divided across five functional groups and classified according to the organization level at which the activities will
be performed (slides 8-9). Activities2 classified as “Regional” are strong candidates for centralization into an accounting shared services
center.

                 Financial Planning &                   Client-Centric                   Non-Client-Centric                                                        Financial & Regulatory
                       Analysis                     Operational Accounting              Operational Accounting                 Financial Accounting                      Reporting
              • Translate business strategy       • Record operational transactions    • Record operational transactions    • Record general ledger              • Prepare accurate, valid
                into operational and capital        and prepare accounting data and      and prepare accounting data          transactions at the corporate        reporting to meet statutory,
                plans for parent company and        reports                              and reports                          (global) level and at the            SEC, and Shareholder needs
Description
Description

                business areas                    • Produce direct accounting inputs   • Primarily for internal use; no       regional level in shared
              • Support operations with             into financials and/or access        clients rely significantly on        service centers
                reporting analysis and advice       financial systems of clients         function for external reporting    • Monitor and maintain general
                                                    and/or underwriting partners;                                             ledger accounts
                                                    key part of sales and service
                                                    process

              • Possible Shared Services Center        All Activities Reside at        • Fiduciary Accounting               • General Ledger                     • Specific Business Area Audits &
                to support Business Area                Business Area Level               − Fiduciary Payables                 − GL Processing                     Regulatory Reporting, if any
                Analysis                                                                  − Fiduciary Receivables              − Journal Voucher Processing
                                                                                          − Client Setup                       − Shared Facilities & Expense
                                                                                       • Client Receivables                      Accounting
                                                                                          − Premiums & Claims                  − GL Maintenance
                                                                                            Receivable                         − Consolidations
                                                                                          − Premiums & Claims                  − Tax Documentation
                                                                                            Collections                        − Non-Trade Intercompany
                                                                                          − Billing                              Transactions
Regional

                                                                                          − Client Service Time & Expense   • Special Events Accounting
Regional

                                                                                       • Revenue Only Accruals &               − Mergers & Acquisitions
                                                                                         Commissions                        • Account Reconciliations
                                                                                          − Revenue Accruals                   − Account Reconciliations
                                                                                          − Commission Calculations            − Non-Trade Accounts Receivable
                                                                                       • General Ledger                          & Collections
                                                                                          − Trade Intercompany              • Cap-Ex Accounting
                                                                                            Transactions                       − Capital Expenditures
                                                                                          − Journal Voucher Processing         − Non-Capitalized Projects
                                                                                          − Business Systems & GL Feeds        − Fixed Assets
                                                                                                                            • Shared Services Centers –
                                                                                                                              Existing
                                                                                                                               − Payroll – HR & Benefits
                                                                                                                               − Vendors Payable

     Ramesh Krish Functions mapping and definitions are located in the Appendix.
      2 Accounting                                                                                                                                               Proprietary and Confidential   P27
Future Vision – Functional Placement
Activities3 classified as “Business Area” and “Corporate” will not be consolidated into the accounting shared services center.
                     Financial Planning &                   Client-Centric                   Non-Client-Centric                                                   Financial & Regulatory
                           Analysis                     Operational Accounting              Operational Accounting           Financial Accounting                       Reporting
                • Internal Performance Reporting       • Fiduciary Accounting                 All Activities Reside at         All Activities Reside                 All Activities Reside
                • Analysis & Forecasting                  − Fiduciary Payables                    Regional Level                  at Regional or                  at Corporate Level, except
                     − Planning & Budgeting               − Fiduciary Receivables                                               Corporate Levels                 Specific Business Area Audits
                     − Client / Broker Profitability      − Client Setup                                                                                           & Regulatory Reporting
                • Billing & Collection                 • Client External Reporting
                  Assistance, as required              • Client Receivables
                                                          − Premiums & Claims Receivable
Business Area
Business Area

                • Overrides from Carriers/                − Premiums & Claims Collections
                  Suppliers                               − Billing
                • Contingent Commissions from          • Revenue Only Accruals &
                  Carriers                               Commissions
                • Limited Revenue & Accrual               − Revenue Accruals
                  Analysis                                − Commission Calculations
                     − Incentive Compensation          • General Ledger
                     − Deferred Revenues                  − Trade Intercompany
                     − Bad Debt Allowance                   Transactions
                       Reserves                           − Journal Voucher Processing
                     − Work in Progress Reserves          − Business Systems & GL Feeds
                • Quality Assurance

                • Internal Performance Reporting           All Activities Reside at           All Activities Reside at   • General Ledger                        • External Reporting
                • Analysis & Forecasting                    Business Area Level                   Regional Level            − GL Processing                      • Financial Statement
                     − Planning & Budgeting                                                                                 − Journal Voucher Processing           Preparation
                     − Client / Broker Profitability                                                                        − Shared Facilities & Expense
                                                                                                                              Accounting                         • Financial Accounting
                • Quality Assurance                                                                                         − GL Maintenance                       Governance
                                                                                                                            − Consolidations                         − Financial Accounting
                                                                                                                            − Tax Documentation                        Policies & Procedures
                                                                                                                            − Non-Trade Intercompany                 − Standards & Reporting
                                                                                                                              Eliminations                             Package
                                                                                                                         • Special Events Accounting                 − Sarbanes-Oxley
Corporate
Corporate

                                                                                                                            − Litigation                               Compliance
                                                                                                                            − Mergers & Acquisitions
                                                                                                                         • Account Reconciliations
                                                                                                                            − Account Reconciliations
                                                                                                                            − Non-Trade Accounts Receivable
                                                                                                                              & Collections
                                                                                                                         • Cap-Ex Accounting
                                                                                                                            − Capital Expenditures
                                                                                                                            − Non-Capitalized Projects
                                                                                                                            − Fixed Assets
                                                                                                                         • Corporate Financial Systems
                                                                                                                         • Shared Services Centers – Existing
                                                                                                                            − Investment Accounting4
          Accounting Functions mapping and definitions are located in the Appendix.
                 3
   Ramesh Krish
        4 Investment Accounting is already in a shared services center.                                                                                         Proprietary and Confidential   P28
7   Finance & Accounting Process
                   Design

Ramesh Krish                            Proprietary and Confidential   P29
Accounting Functions

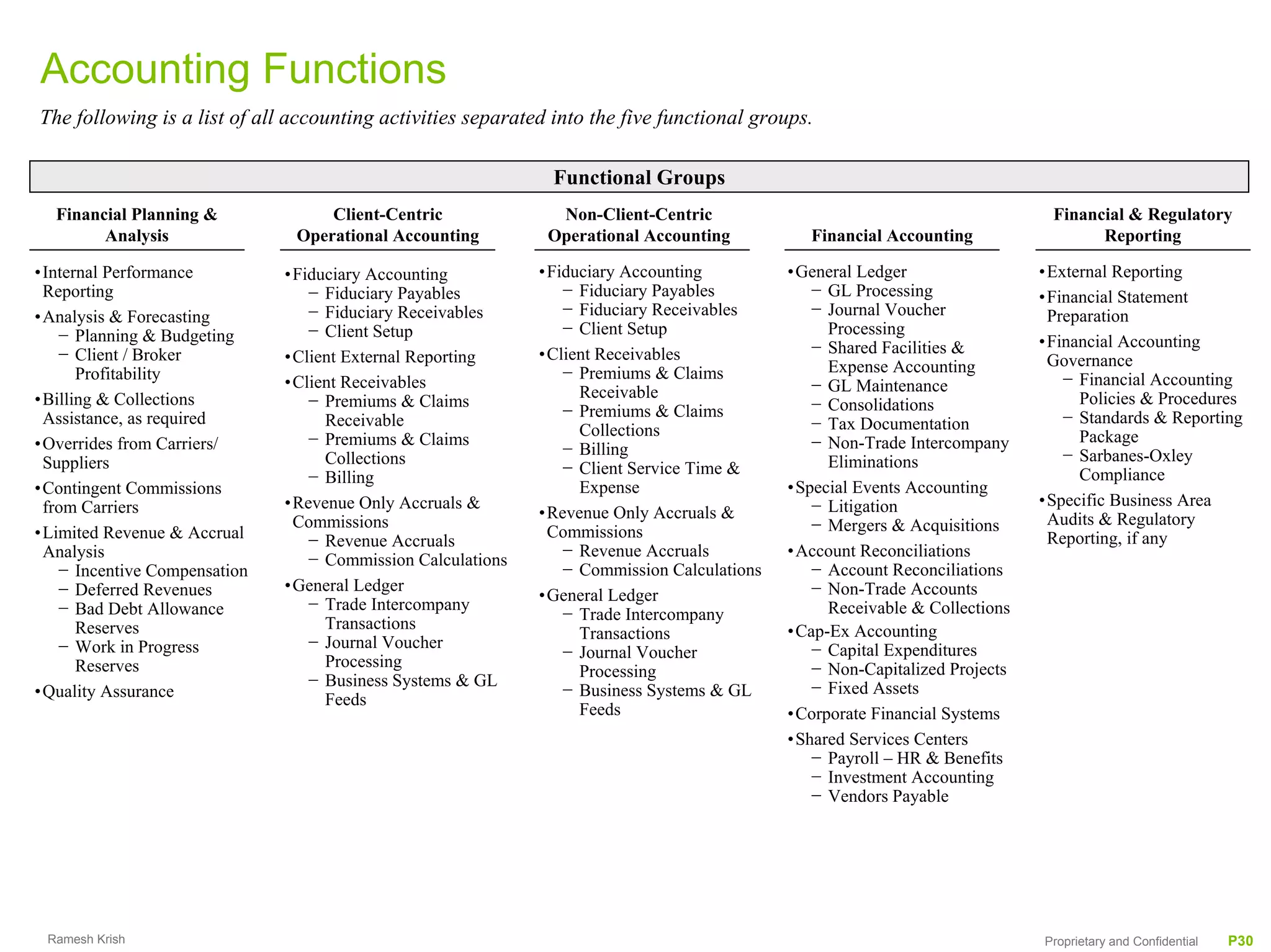

The following is a list of all accounting activities separated into the five functional groups.

                                                               Functional Groups
  Financial Planning &             Client-Centric              Non-Client-Centric                                            Financial & Regulatory
        Analysis               Operational Accounting         Operational Accounting           Financial Accounting                Reporting

•Internal Performance         •Fiduciary Accounting          •Fiduciary Accounting          •General Ledger                 •External Reporting
 Reporting                       − Fiduciary Payables           − Fiduciary Payables           − GL Processing              •Financial Statement
•Analysis & Forecasting          − Fiduciary Receivables        − Fiduciary Receivables        − Journal Voucher             Preparation
   − Planning & Budgeting        − Client Setup                 − Client Setup                   Processing
                                                                                               − Shared Facilities &        •Financial Accounting
   − Client / Broker          •Client External Reporting     •Client Receivables                                             Governance
      Profitability                                             − Premiums & Claims              Expense Accounting
                              •Client Receivables                                              − GL Maintenance                − Financial Accounting
•Billing & Collections                                            Receivable                                                     Policies & Procedures
                                 − Premiums & Claims                                           − Consolidations
 Assistance, as required                                        − Premiums & Claims                                            − Standards & Reporting
                                   Receivable                                                  − Tax Documentation
                                                                  Collections                                                    Package
•Overrides from Carriers/        − Premiums & Claims                                           − Non-Trade Intercompany
                                                                − Billing                                                      − Sarbanes-Oxley
 Suppliers                         Collections                                                   Eliminations
                                                                − Client Service Time &                                          Compliance
                                 − Billing
•Contingent Commissions                                           Expense                   •Special Events Accounting
 from Carriers                •Revenue Only Accruals &                                         − Litigation                 •Specific Business Area
                                                             •Revenue Only Accruals &                                        Audits & Regulatory
                               Commissions                                                     − Mergers & Acquisitions
•Limited Revenue & Accrual                                    Commissions                                                    Reporting, if any
                                 − Revenue Accruals
 Analysis                                                       − Revenue Accruals          •Account Reconciliations
                                 − Commission Calculations
   − Incentive Compensation                                     − Commission Calculations      − Account Reconciliations
   − Deferred Revenues        •General Ledger                                                  − Non-Trade Accounts
                                                             •General Ledger
   − Bad Debt Allowance          − Trade Intercompany                                            Receivable & Collections
                                                                − Trade Intercompany
      Reserves                     Transactions                                             •Cap-Ex Accounting
                                                                  Transactions
   − Work in Progress            − Journal Voucher                                             − Capital Expenditures
                                                                − Journal Voucher
      Reserves                     Processing                                                  − Non-Capitalized Projects
                                                                  Processing
                                 − Business Systems & GL                                       − Fixed Assets
•Quality Assurance                                              − Business Systems & GL
                                   Feeds
                                                                  Feeds                     •Corporate Financial Systems
                                                                                            •Shared Services Centers
                                                                                               − Payroll – HR & Benefits
                                                                                               − Investment Accounting
                                                                                               − Vendors Payable

 Ramesh Krish                                                                                                               Proprietary and Confidential   P30

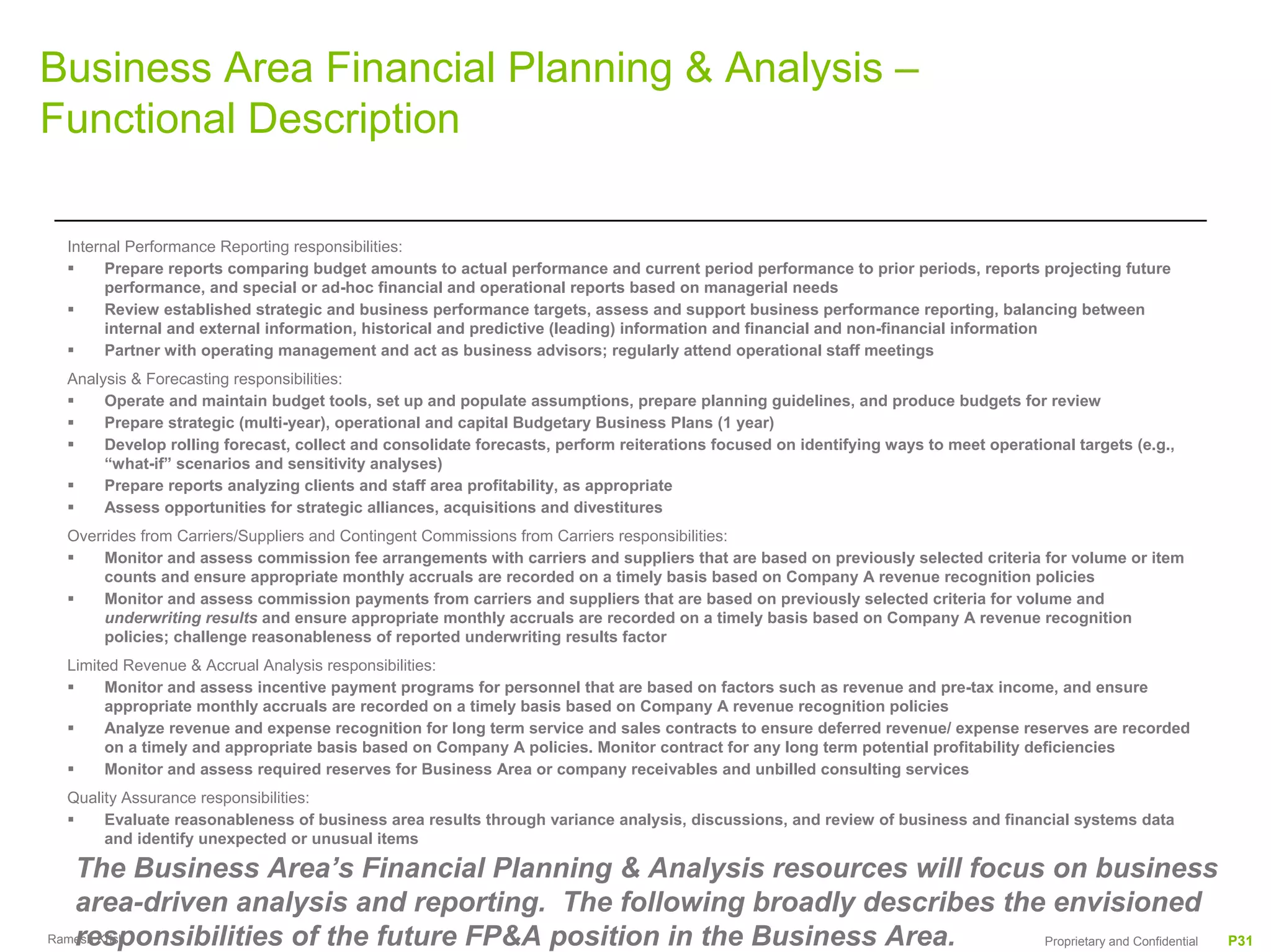

Business Area Financial Planning & Analysis –
Functional Description

 Internal Performance Reporting responsibilities:
       Prepare reports comparing budget amounts to actual performance and current period performance to prior periods, reports projecting future
       performance, and special or ad-hoc financial and operational reports based on managerial needs
       Review established strategic and business performance targets, assess and support business performance reporting, balancing between
       internal and external information, historical and predictive (leading) information and financial and non-financial information
       Partner with operating management and act as business advisors; regularly attend operational staff meetings
 Analysis & Forecasting responsibilities:
      Operate and maintain budget tools, set up and populate assumptions, prepare planning guidelines, and produce budgets for review
      Prepare strategic (multi-year), operational and capital Budgetary Business Plans (1 year)
      Develop rolling forecast, collect and consolidate forecasts, perform reiterations focused on identifying ways to meet operational targets (e.g.,
      “what-if” scenarios and sensitivity analyses)
      Prepare reports analyzing clients and staff area profitability, as appropriate
      Assess opportunities for strategic alliances, acquisitions and divestitures
 Overrides from Carriers/Suppliers and Contingent Commissions from Carriers responsibilities:
      Monitor and assess commission fee arrangements with carriers and suppliers that are based on previously selected criteria for volume or item
      counts and ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies
      Monitor and assess commission payments from carriers and suppliers that are based on previously selected criteria for volume and
      underwriting results and ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition
      policies; challenge reasonableness of reported underwriting results factor
 Limited Revenue & Accrual Analysis responsibilities:
      Monitor and assess incentive payment programs for personnel that are based on factors such as revenue and pre-tax income, and ensure
      appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies
      Analyze revenue and expense recognition for long term service and sales contracts to ensure deferred revenue/ expense reserves are recorded
      on a timely and appropriate basis based on Company A policies. Monitor contract for any long term potential profitability deficiencies
      Monitor and assess required reserves for Business Area or company receivables and unbilled consulting services
 Quality Assurance responsibilities:
      Evaluate reasonableness of business area results through variance analysis, discussions, and review of business and financial systems data
      and identify unexpected or unusual items

   The Business Area’s Financial Planning & Analysis resources will focus on business
   area-driven analysis and reporting. The following broadly describes the envisioned
   responsibilities of the future FP&A position in the Business Area.
Ramesh Krish                                                              Proprietary and Confidential                                                   P31

Accounting Functions – Mapping Summary
The following matrix (on slides 20-22) maps all accounting activities to their “future” organizational placements. Those activities listed in
the “Regional” column are the initial targets for a shared services center. All other functionality remains unchanged from current
positioning.                                                          Corporate        Regional        Business
                             Function/ Activity                        (Global)      (Country A)        Area
                      Internal Performance Reporting                      +                               +
                      Analysis & Forecasting
                        • Planning & Budgeting                            +                               +
                    Financial Planning & Analysis
                    Financial Planning & Analysis

                        • Client/ Broker Profitability                    +                               +
                      Billing & Collections Assistance                                                    +
                      Overrides From Carriers/ Suppliers                                                  +
                      Contingent Commissions From
                      Carriers
                                                                                                          +
                      Limited Revenue & Accrual Analysis
                        • Incentive Compensation                                                          +
                        • Deferred Revenue Analysis                                                       +
                        • Bad Debt Allowance Reserves                                                     +
                        • Work in Progress Reserves                                                       +
                      Quality Assurance                                   +                               +
                                                    Fiduciary Accounting
                                                      • Fiduciary Payables                                +
                                                      • Fiduciary Receivables                             +
               Operational Accounting
               Operational Accounting

                                                      • Client Setup                                      +
                                                                                                          +
                   Client-Centric

                                                    Client External Reporting
                   Client-Centric

                                                    Client Receivables
                                                      • Premiums & Claims Receivable                      +
                                                      • Premiums & Claims Collections                     +
                                                      • Billing                                           +
                                                    Revenue Only Accruals & Commissions
                                                      • Revenue Accruals Accounting                       +
                                                      • Commission Calculations                           +
Ramesh Krish                                                                                                           Proprietary and Confidential   P32
Accounting Functions – Mapping Summary
                                                                                Corporate   Regional   Business
               Client-Centric                  Function/ Activity                (Global)   (Country    Area
                                                                                               A)
               Client-Centric
                Operational               General Ledger
                Accounting
                Operational
                Accounting                 • Trade Intercompany Transactions                              +
                                           • Journal Voucher Processing                                   +
                                           • Business Systems & GL Feeds                                  +
                                          Fiduciary Accounting
                                            • Fiduciary Payables                              +
                                            • Fiduciary Receivables                           +
                                            • Client Setup                                    +
                                          Client Receivables
                 Operational Accounting
                 Operational Accounting

                                            • Premiums & Claims Receivable                    +
                   Non-Client-Centric
                  Non-Client-Centric

                                            • Premiums & Claims Collections                   +
                                            • Billing                                         +
                                            • Client Service Time & Expense
                                              Accounting
                                          Revenue Only Accruals & Commissions
                                            • Revenue Accruals Accounting                     +
                                            • Commission Calculations                         +
                                          General Ledger
                                            • Trade Intercompany Transactions                 +
                                            • Journal Voucher Processing                      +
                                            • Business Systems & GL Feeds                     +
                                           General Ledger & Cost Accounting
                 Accounting
                 Accounting

                                           • General Ledger Processing             +          +
                  Financial
                 Financial

                                           • Journal Voucher Processing            +          +
                                           • Shared Facilities & Expense
                                             Accounting
                                                                                   +          +
                                           • General Ledger Maintenance            +          +
Ramesh Krish                                                                                                      Proprietary and Confidential   P33
Accounting Functions – Mapping Summary
                                                                                  Corporate   Regional   Business
                                                Function/ Activity                 (Global)   (Country    Area
                                          General Ledger & Cost Accounting (continued)           A)
                                           • Consolidations Accounting                +         +
                                           • Tax Documentation                        +         +
                                           • Non-Trade Intercompany
                                             Eliminations
                                                                                      +         +
                                          Special Events Accounting
                                           • Litigation Accounting                    +
                                           • Mergers & Acquisitions Accounting        +         +
                   Financial Accounting
                   Financial Accounting

                                          Account Reconciliations
                                           • Account Reconciliations                  +         +
                                           • Non-Trade Accounts Receivable &
                                             Collections
                                                                                      +         +
                                          Capital Expenditures Accounting
                                           • Capital Expenditures                     +         +
                                           • Non-Capitalized Projects                 +         +
                                           • Fixed Assets Accounting                  +         +
                                          Corporate Financial Systems                 +
                                          Shared Services Centers - Existing
                                           • Payroll – Human Resources &
                                             Benefits
                                                                                                +
                                           • Investment Accounting                    +
                                           • Vendors Payable                                    +
                                          External Reporting                         +          +
               Regulatory Reporting
               Regulatory Reporting

                                          Financial Statement Preparation            +
                   Financial &
                   Financial &

                                          Financial Accounting Governance
                                            • Financial Accounting Policies &
                                              Procedures
                                                                                     +          +
                                            • Standards & Reporting Package          +
                                            • Sarbanes-Oxley Compliance              +
                                          Business Area Audit Regulatory
                                          Reporting
                                                                                                +
Ramesh Krish                                                                                                        Proprietary and Confidential   P34

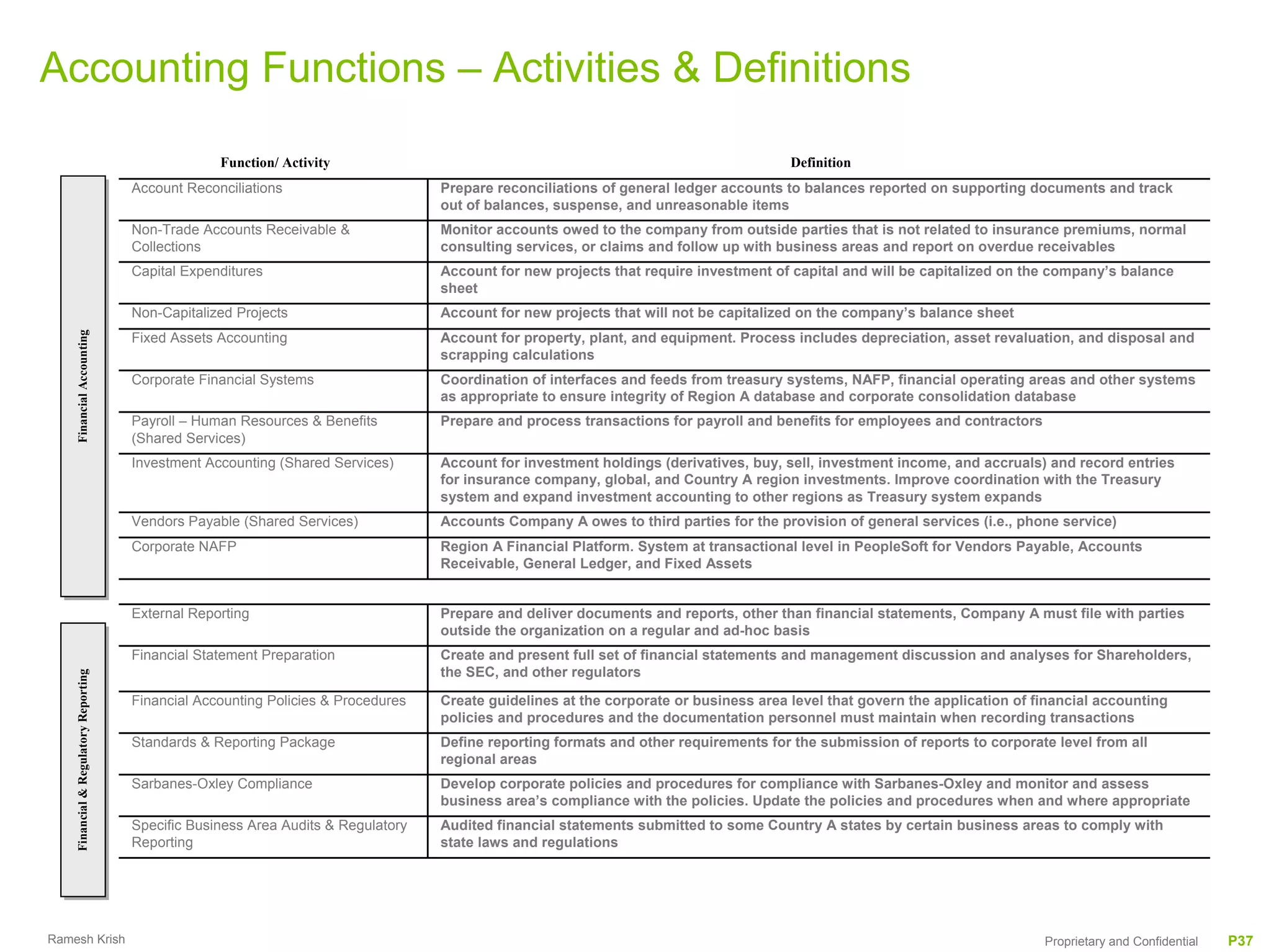

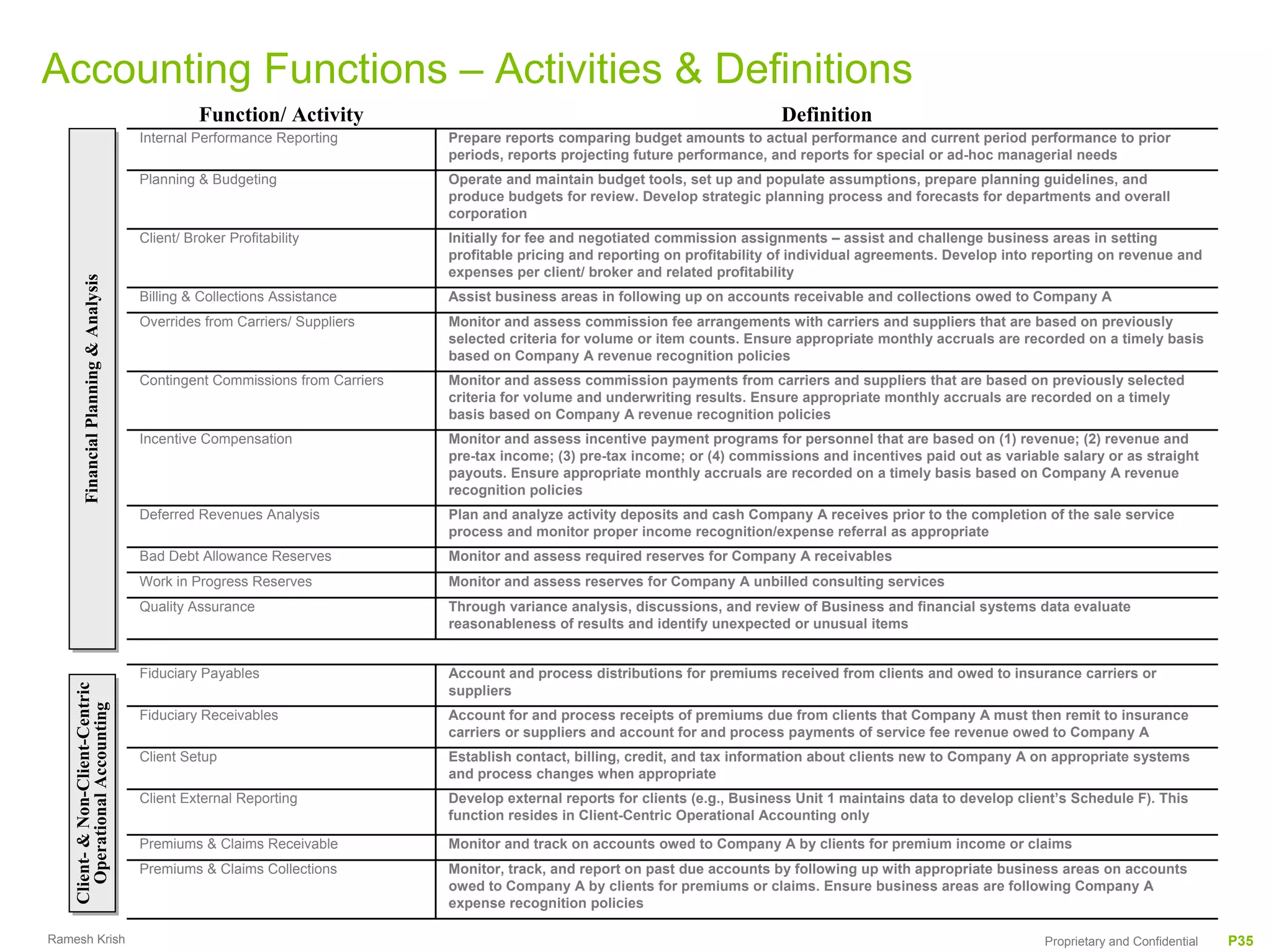

Accounting Functions – Activities & Definitions
                                                    Function/ Activity                                                             Definition
                                          Internal Performance Reporting         Prepare reports comparing budget amounts to actual performance and current period performance to prior
                                                                                 periods, reports projecting future performance, and reports for special or ad-hoc managerial needs
                                          Planning & Budgeting                   Operate and maintain budget tools, set up and populate assumptions, prepare planning guidelines, and
                                                                                 produce budgets for review. Develop strategic planning process and forecasts for departments and overall
                                                                                 corporation
                                          Client/ Broker Profitability           Initially for fee and negotiated commission assignments – assist and challenge business areas in setting
                                                                                 profitable pricing and reporting on profitability of individual agreements. Develop into reporting on revenue and
                                                                                 expenses per client/ broker and related profitability
          Financial Planning & Analysis
          Financial Planning & Analysis

                                          Billing & Collections Assistance       Assist business areas in following up on accounts receivable and collections owed to Company A
                                          Overrides from Carriers/ Suppliers     Monitor and assess commission fee arrangements with carriers and suppliers that are based on previously
                                                                                 selected criteria for volume or item counts. Ensure appropriate monthly accruals are recorded on a timely basis
                                                                                 based on Company A revenue recognition policies
                                          Contingent Commissions from Carriers   Monitor and assess commission payments from carriers and suppliers that are based on previously selected
                                                                                 criteria for volume and underwriting results. Ensure appropriate monthly accruals are recorded on a timely
                                                                                 basis based on Company A revenue recognition policies
                                          Incentive Compensation                 Monitor and assess incentive payment programs for personnel that are based on (1) revenue; (2) revenue and
                                                                                 pre-tax income; (3) pre-tax income; or (4) commissions and incentives paid out as variable salary or as straight
                                                                                 payouts. Ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue
                                                                                 recognition policies
                                          Deferred Revenues Analysis             Plan and analyze activity deposits and cash Company A receives prior to the completion of the sale service
                                                                                 process and monitor proper income recognition/expense referral as appropriate
                                          Bad Debt Allowance Reserves            Monitor and assess required reserves for Company A receivables
                                          Work in Progress Reserves              Monitor and assess reserves for Company A unbilled consulting services
                                          Quality Assurance                      Through variance analysis, discussions, and review of Business and financial systems data evaluate
                                                                                 reasonableness of results and identify unexpected or unusual items

                                          Fiduciary Payables                     Account and process distributions for premiums received from clients and owed to insurance carriers or
    Client- & Non-Client-Centric

                                                                                 suppliers
    Client- & Non-Client-Centric
       Operational Accounting
      Operational Accounting

                                          Fiduciary Receivables                  Account for and process receipts of premiums due from clients that Company A must then remit to insurance
                                                                                 carriers or suppliers and account for and process payments of service fee revenue owed to Company A
                                          Client Setup                           Establish contact, billing, credit, and tax information about clients new to Company A on appropriate systems
                                                                                 and process changes when appropriate
                                          Client External Reporting              Develop external reports for clients (e.g., Business Unit 1 maintains data to develop client’s Schedule F). This
                                                                                 function resides in Client-Centric Operational Accounting only

                                          Premiums & Claims Receivable           Monitor and track on accounts owed to Company A by clients for premium income or claims
                                          Premiums & Claims Collections          Monitor, track, and report on past due accounts by following up with appropriate business areas on accounts
                                                                                 owed to Company A by clients for premiums or claims. Ensure business areas are following Company A
                                                                                 expense recognition policies

Ramesh Krish                                                                                                                                                               Proprietary and Confidential   P35

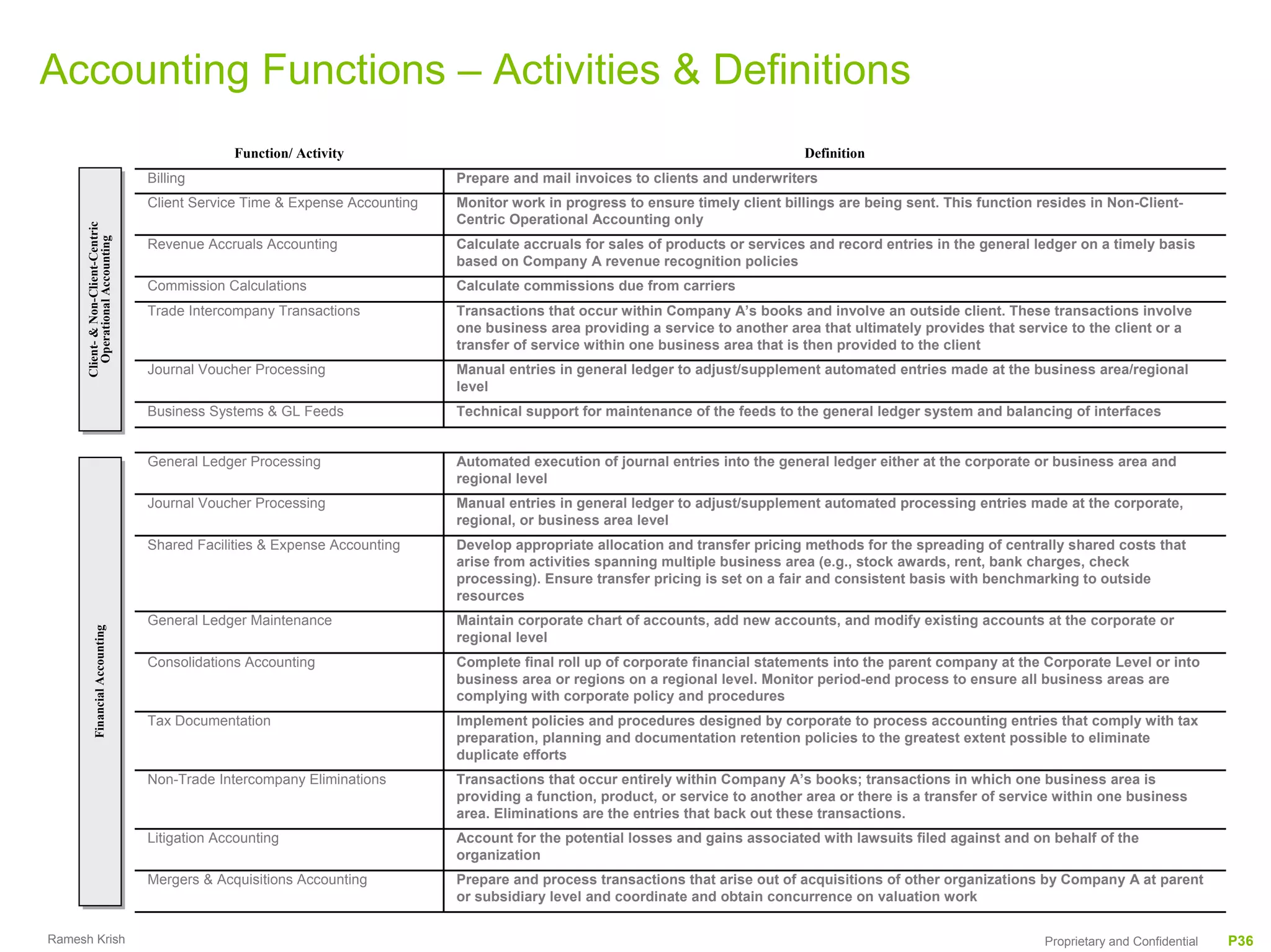

Accounting Functions – Activities & Definitions
                                                  Function/ Activity                                                                Definition
                                     Billing                                    Prepare and mail invoices to clients and underwriters
                                     Client Service Time & Expense Accounting   Monitor work in progress to ensure timely client billings are being sent. This function resides in Non-Client-
                                                                                Centric Operational Accounting only
      Client- & Non-Client-Centric
      Client- & Non-Client-Centric
         Operational Accounting

                                     Revenue Accruals Accounting                Calculate accruals for sales of products or services and record entries in the general ledger on a timely basis
         Operational Accounting

                                                                                based on Company A revenue recognition policies
                                     Commission Calculations                    Calculate commissions due from carriers
                                     Trade Intercompany Transactions            Transactions that occur within Company A’s books and involve an outside client. These transactions involve
                                                                                one business area providing a service to another area that ultimately provides that service to the client or a
                                                                                transfer of service within one business area that is then provided to the client
                                     Journal Voucher Processing                 Manual entries in general ledger to adjust/supplement automated entries made at the business area/regional
                                                                                level
                                     Business Systems & GL Feeds                Technical support for maintenance of the feeds to the general ledger system and balancing of interfaces

                                     General Ledger Processing                  Automated execution of journal entries into the general ledger either at the corporate or business area and
                                                                                regional level
                                     Journal Voucher Processing                 Manual entries in general ledger to adjust/supplement automated processing entries made at the corporate,
                                                                                regional, or business area level
                                     Shared Facilities & Expense Accounting     Develop appropriate allocation and transfer pricing methods for the spreading of centrally shared costs that
                                                                                arise from activities spanning multiple business area (e.g., stock awards, rent, bank charges, check
                                                                                processing). Ensure transfer pricing is set on a fair and consistent basis with benchmarking to outside
                                                                                resources
                                     General Ledger Maintenance                 Maintain corporate chart of accounts, add new accounts, and modify existing accounts at the corporate or
            Financial Accounting
            Financial Accounting

                                                                                regional level
                                     Consolidations Accounting                  Complete final roll up of corporate financial statements into the parent company at the Corporate Level or into
                                                                                business area or regions on a regional level. Monitor period-end process to ensure all business areas are
                                                                                complying with corporate policy and procedures
                                     Tax Documentation                          Implement policies and procedures designed by corporate to process accounting entries that comply with tax
                                                                                preparation, planning and documentation retention policies to the greatest extent possible to eliminate
                                                                                duplicate efforts
                                     Non-Trade Intercompany Eliminations        Transactions that occur entirely within Company A’s books; transactions in which one business area is
                                                                                providing a function, product, or service to another area or there is a transfer of service within one business
                                                                                area. Eliminations are the entries that back out these transactions.
                                     Litigation Accounting                      Account for the potential losses and gains associated with lawsuits filed against and on behalf of the
                                                                                organization
                                     Mergers & Acquisitions Accounting          Prepare and process transactions that arise out of acquisitions of other organizations by Company A at parent
                                                                                or subsidiary level and coordinate and obtain concurrence on valuation work

Ramesh Krish                                                                                                                                                             Proprietary and Confidential   P36
Accounting Functions – Activities & Definitions

                                                    Function/ Activity                                                                  Definition
                                       Account Reconciliations                      Prepare reconciliations of general ledger accounts to balances reported on supporting documents and track
                                                                                    out of balances, suspense, and unreasonable items
                                       Non-Trade Accounts Receivable &              Monitor accounts owed to the company from outside parties that is not related to insurance premiums, normal
                                       Collections                                  consulting services, or claims and follow up with business areas and report on overdue receivables
                                       Capital Expenditures                         Account for new projects that require investment of capital and will be capitalized on the company’s balance
                                                                                    sheet
                                       Non-Capitalized Projects                     Account for new projects that will not be capitalized on the company’s balance sheet
    Financial Accounting

                                       Fixed Assets Accounting                      Account for property, plant, and equipment. Process includes depreciation, asset revaluation, and disposal and
    Financial Accounting

                                                                                    scrapping calculations
                                       Corporate Financial Systems                  Coordination of interfaces and feeds from treasury systems, NAFP, financial operating areas and other systems
                                                                                    as appropriate to ensure integrity of Region A database and corporate consolidation database
                                       Payroll – Human Resources & Benefits         Prepare and process transactions for payroll and benefits for employees and contractors
                                       (Shared Services)
                                       Investment Accounting (Shared Services)      Account for investment holdings (derivatives, buy, sell, investment income, and accruals) and record entries
                                                                                    for insurance company, global, and Country A region investments. Improve coordination with the Treasury
                                                                                    system and expand investment accounting to other regions as Treasury system expands
                                       Vendors Payable (Shared Services)            Accounts Company A owes to third parties for the provision of general services (i.e., phone service)
                                       Corporate NAFP                               Region A Financial Platform. System at transactional level in PeopleSoft for Vendors Payable, Accounts
                                                                                    Receivable, General Ledger, and Fixed Assets

                                       External Reporting                           Prepare and deliver documents and reports, other than financial statements, Company A must file with parties
                                                                                    outside the organization on a regular and ad-hoc basis
                                       Financial Statement Preparation              Create and present full set of financial statements and management discussion and analyses for Shareholders,
                                                                                    the SEC, and other regulators
    Financial & Regulatory Reporting
    Financial & Regulatory Reporting

                                       Financial Accounting Policies & Procedures   Create guidelines at the corporate or business area level that govern the application of financial accounting
                                                                                    policies and procedures and the documentation personnel must maintain when recording transactions
                                       Standards & Reporting Package                Define reporting formats and other requirements for the submission of reports to corporate level from all
                                                                                    regional areas
                                       Sarbanes-Oxley Compliance                    Develop corporate policies and procedures for compliance with Sarbanes-Oxley and monitor and assess
                                                                                    business area’s compliance with the policies. Update the policies and procedures when and where appropriate
                                       Specific Business Area Audits & Regulatory   Audited financial statements submitted to some Country A states by certain business areas to comply with
                                       Reporting                                    state laws and regulations

Ramesh Krish                                                                                                                                                                  Proprietary and Confidential   P37
8 Risk Assessment

Ramesh Krish                       Proprietary and Confidential   P38
Appendix - Way Forward

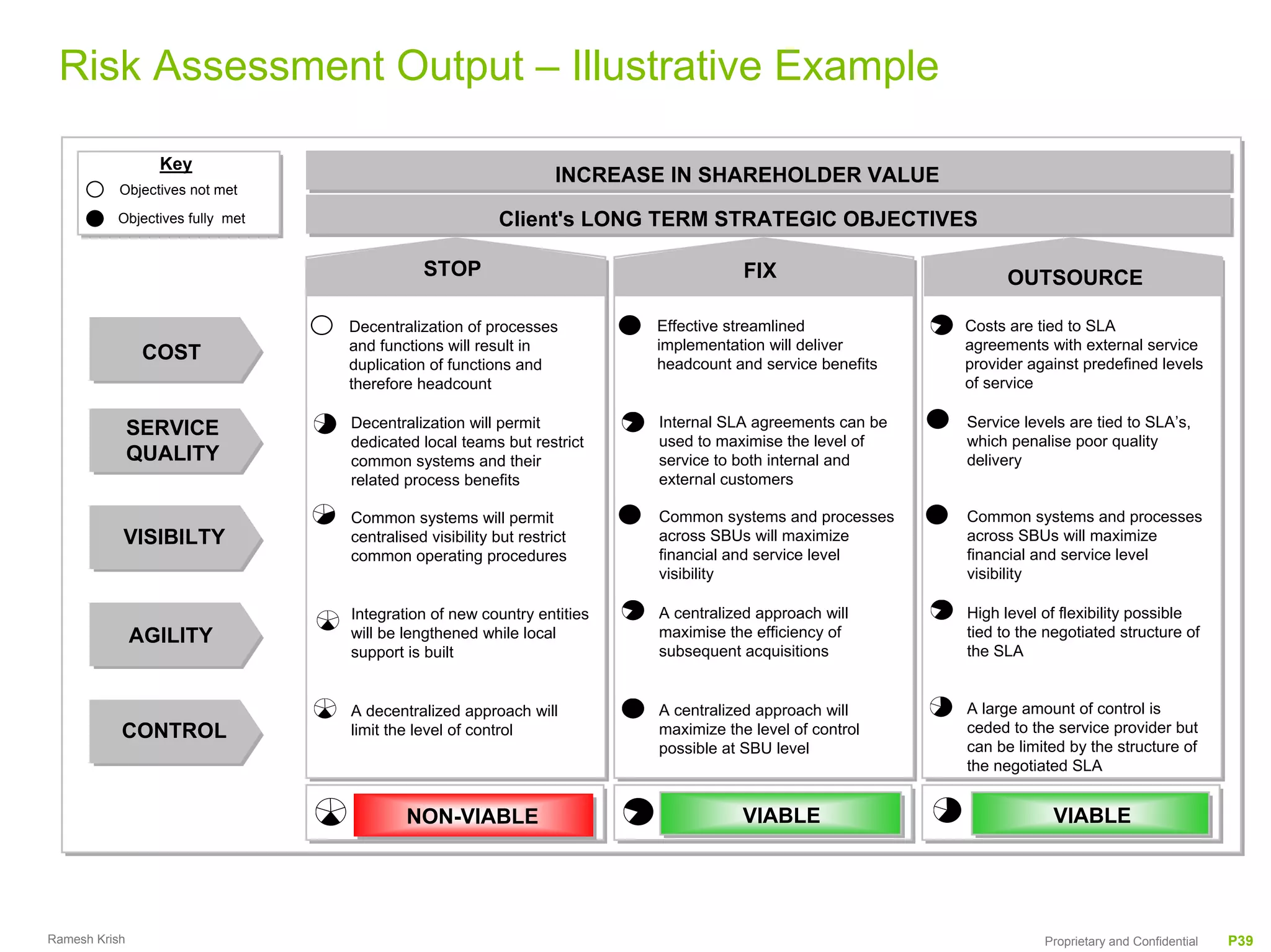

 Risk Assessment Output – Illustrative Example

                 Key
                                                                  INCREASE IN SHAREHOLDER VALUE
           Objectives not met

          Objectives fully met                          Client's LONG TERM STRATEGIC OBJECTIVES

                                            STOP                                     FIX                           OUTSOURCE

                                 Decentralization of processes           Effective streamlined               Costs are tied to SLA
                                 and functions will result in            implementation will deliver         agreements with external service
                COST             duplication of functions and            headcount and service benefits      provider against predefined levels
                                 therefore headcount                                                         of service

               SERVICE           Decentralization will permit            Internal SLA agreements can be      Service levels are tied to SLA’s,
                                 dedicated local teams but restrict      used to maximise the level of       which penalise poor quality
               QUALITY           common systems and their                service to both internal and        delivery
                                 related process benefits                external customers

                                 Common systems will permit              Common systems and processes        Common systems and processes
           VISIBILTY             centralised visibility but restrict     across SBUs will maximize           across SBUs will maximize
                                 common operating procedures             financial and service level         financial and service level
                                                                         visibility                          visibility

                                 Integration of new country entities     A centralized approach will         High level of flexibility possible
               AGILITY           will be lengthened while local          maximise the efficiency of          tied to the negotiated structure of
                                 support is built                        subsequent acquisitions             the SLA

                                 A decentralized approach will           A centralized approach will         A large amount of control is
           CONTROL               limit the level of control              maximize the level of control       ceded to the service provider but
                                                                         possible at SBU level               can be limited by the structure of
                                                                                                             the negotiated SLA

                                          NON-VIABLE                                 VIABLE                               VIABLE

Ramesh Krish                                                                                                            Proprietary and Confidential   P39

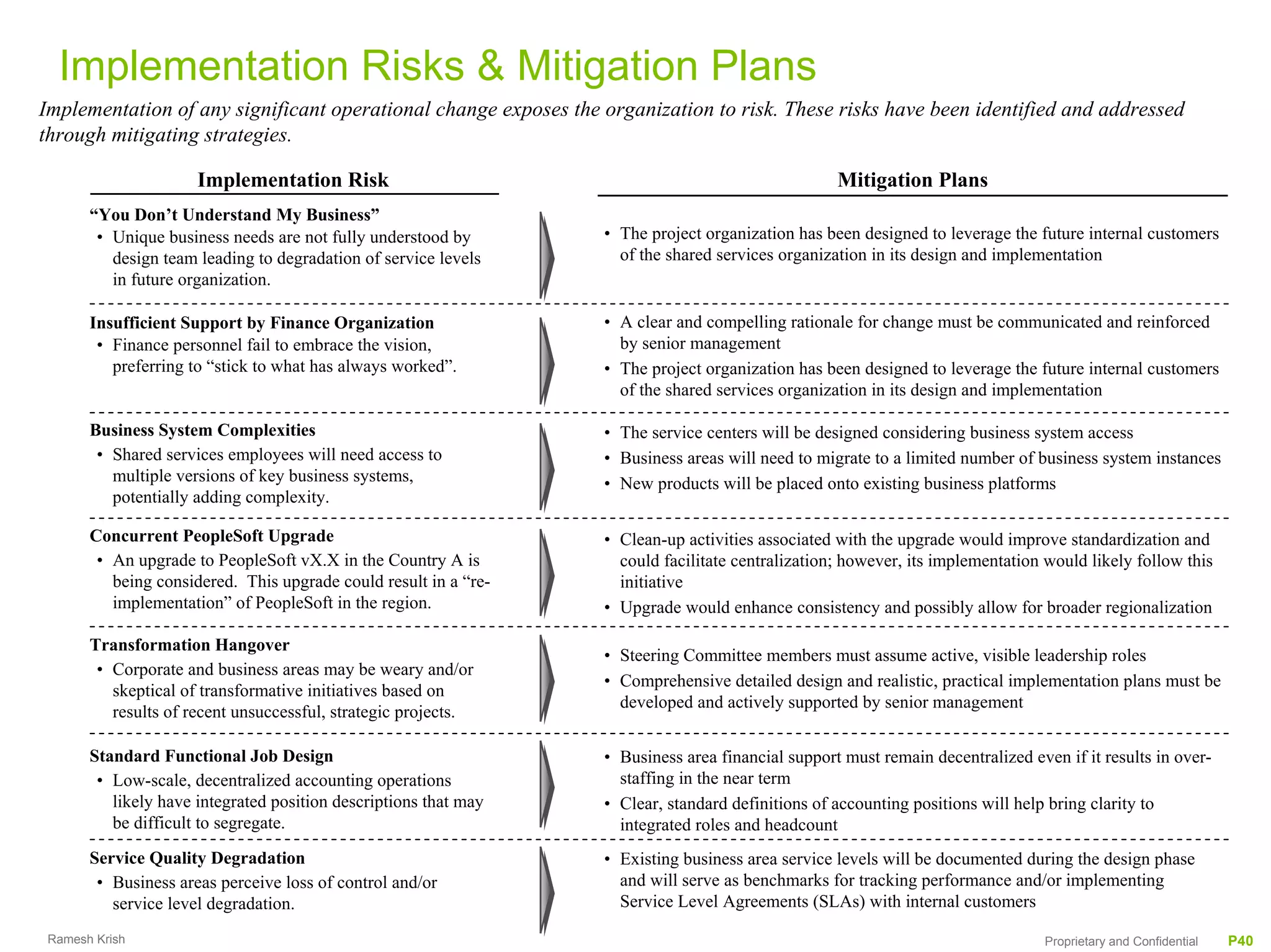

Implementation Risks & Mitigation Plans
Implementation of any significant operational change exposes the organization to risk. These risks have been identified and addressed
through mitigating strategies.

                      Implementation Risk                                                          Mitigation Plans
       “You Don’t Understand My Business”
        • Unique business needs are not fully understood by       • The project organization has been designed to leverage the future internal customers
          design team leading to degradation of service levels      of the shared services organization in its design and implementation
          in future organization.

       Insufficient Support by Finance Organization               • A clear and compelling rationale for change must be communicated and reinforced
        • Finance personnel fail to embrace the vision,             by senior management
          preferring to “stick to what has always worked”.        • The project organization has been designed to leverage the future internal customers
                                                                    of the shared services organization in its design and implementation

       Business System Complexities                               • The service centers will be designed considering business system access
        • Shared services employees will need access to           • Business areas will need to migrate to a limited number of business system instances
          multiple versions of key business systems,              • New products will be placed onto existing business platforms
          potentially adding complexity.

       Concurrent PeopleSoft Upgrade                              • Clean-up activities associated with the upgrade would improve standardization and
        • An upgrade to PeopleSoft vX.X in the Country A is         could facilitate centralization; however, its implementation would likely follow this
          being considered. This upgrade could result in a “re-     initiative
          implementation” of PeopleSoft in the region.            • Upgrade would enhance consistency and possibly allow for broader regionalization

       Transformation Hangover
                                                                  • Steering Committee members must assume active, visible leadership roles
        • Corporate and business areas may be weary and/or
                                                                  • Comprehensive detailed design and realistic, practical implementation plans must be
          skeptical of transformative initiatives based on
                                                                    developed and actively supported by senior management
          results of recent unsuccessful, strategic projects.

       Standard Functional Job Design                             • Business area financial support must remain decentralized even if it results in over-
        • Low-scale, decentralized accounting operations            staffing in the near term
          likely have integrated position descriptions that may   • Clear, standard definitions of accounting positions will help bring clarity to
          be difficult to segregate.                                integrated roles and headcount
       Service Quality Degradation                                • Existing business area service levels will be documented during the design phase
        • Business areas perceive loss of control and/or            and will serve as benchmarks for tracking performance and/or implementing
          service level degradation.                                Service Level Agreements (SLAs) with internal customers

 Ramesh Krish                                                                                                                    Proprietary and Confidential   P40
9   Organizational Design & Governance

Ramesh Krish                                 Proprietary and Confidential   P41

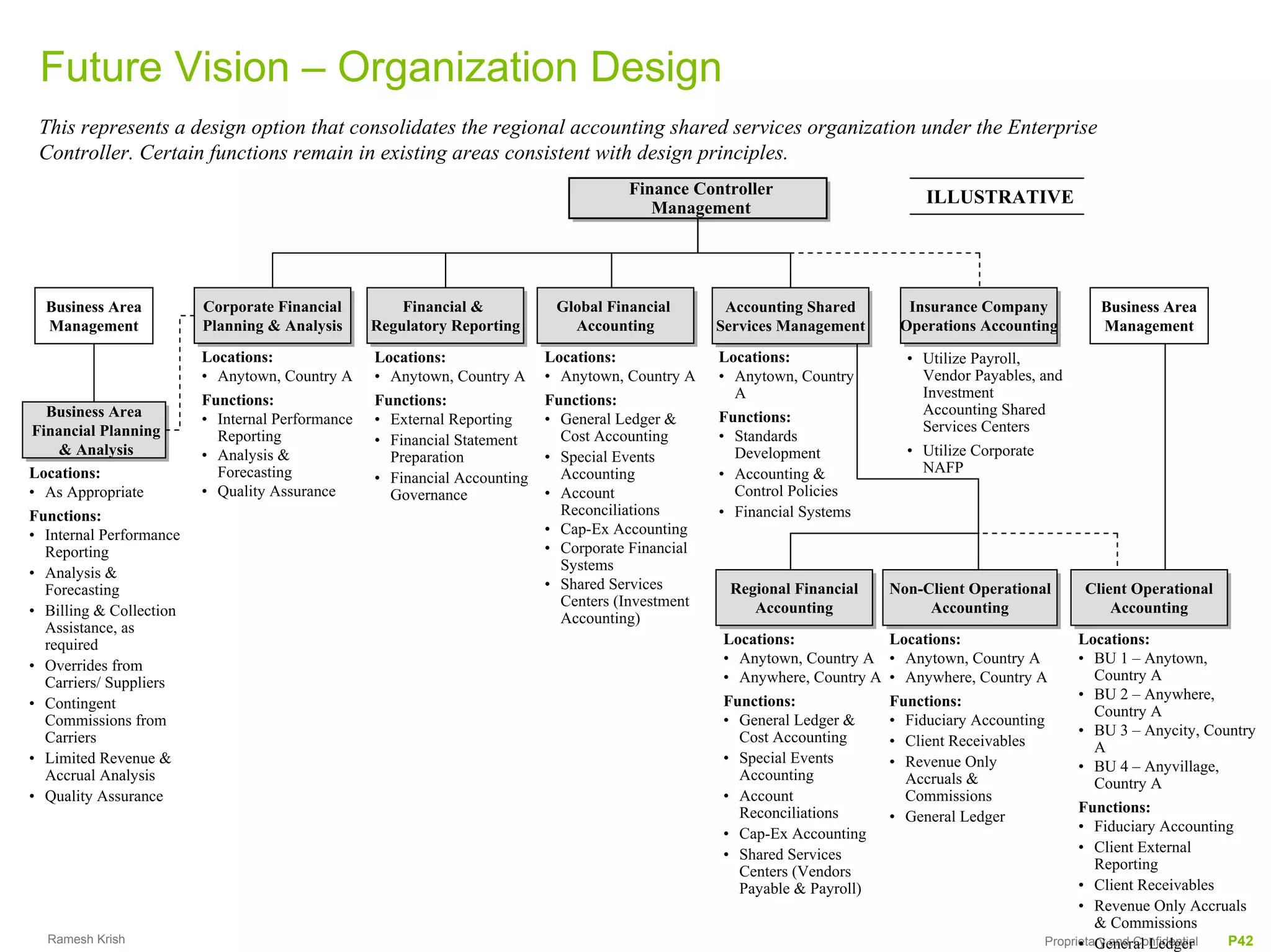

Future Vision – Organization Design
 This represents a design option that consolidates the regional accounting shared services organization under the Enterprise
 Controller. Certain functions remain in existing areas consistent with design principles.
                                                                                       Finance Controller
                                                                                       Finance Controller                       ILLUSTRATIVE
                                                                                          Management
                                                                                          Management

  Business Area          Corporate Financial
                         Corporate Financial          Financial &
                                                      Financial &           Global Financial
                                                                            Global Financial        Accounting Shared
                                                                                                     Accounting Shared       Insurance Company
                                                                                                                              Insurance Company            Business Area
  Management             Planning & Analysis
                         Planning & Analysis      Regulatory Reporting
                                                  Regulatory Reporting        Accounting
                                                                               Accounting          Services Management
                                                                                                   Services Management      Operations Accounting
                                                                                                                            Operations Accounting          Management
                         Locations:               Locations:               Locations:              Locations:                • Utilize Payroll,
                         • Anytown, Country A     • Anytown, Country A     • Anytown, Country A    • Anytown, Country          Vendor Payables, and
                         Functions:               Functions:               Functions:                A                         Investment
  Business Area
   Business Area                                                                                                               Accounting Shared
                         • Internal Performance   • External Reporting     • General Ledger &      Functions:
                                                                                                                               Services Centers
Financial Planning
 Financial Planning        Reporting                                         Cost Accounting       • Standards
                                                  • Financial Statement
    & Analysis
     & Analysis          • Analysis &               Preparation            • Special Events          Development             • Utilize Corporate
Locations:                 Forecasting                                       Accounting            • Accounting &              NAFP
                                                  • Financial Accounting
• As Appropriate         • Quality Assurance        Governance             • Account                 Control Policies
Functions:                                                                   Reconciliations       • Financial Systems
• Internal Performance                                                     • Cap-Ex Accounting
  Reporting                                                                • Corporate Financial
• Analysis &                                                                 Systems
  Forecasting                                                              • Shared Services        Regional Financial     Non-Client Operational        Client Operational
                                                                                                    Regional Financial     Non-Client Operational        Client Operational
                                                                             Centers (Investment
• Billing & Collection                                                       Accounting)
                                                                                                       Accounting
                                                                                                       Accounting               Accounting
                                                                                                                                Accounting                   Accounting
                                                                                                                                                             Accounting
  Assistance, as
  required                                                                                         Locations:              Locations:                    Locations:
• Overrides from                                                                                   • Anytown, Country A    • Anytown, Country A          • BU 1 – Anytown,
  Carriers/ Suppliers                                                                              • Anywhere, Country A   • Anywhere, Country A            Country A
                                                                                                                                                         • BU 2 – Anywhere,
• Contingent                                                                                       Functions:              Functions:
                                                                                                                                                            Country A
  Commissions from                                                                                 • General Ledger &      • Fiduciary Accounting
  Carriers                                                                                           Cost Accounting                                     • BU 3 – Anycity, Country
                                                                                                                           • Client Receivables             A
• Limited Revenue &                                                                                • Special Events        • Revenue Only                • BU 4 – Anyvillage,
  Accrual Analysis                                                                                   Accounting              Accruals &                     Country A
• Quality Assurance                                                                                • Account                 Commissions
                                                                                                     Reconciliations                                     Functions:
                                                                                                                           • General Ledger
                                                                                                   • Cap-Ex Accounting                                   • Fiduciary Accounting
                                                                                                   • Shared Services                                     • Client External
                                                                                                     Centers (Vendors                                       Reporting
                                                                                                     Payable & Payroll)                                  • Client Receivables
                                                                                                                                                         • Revenue Only Accruals
                                                                                                                                                            & Commissions
  Ramesh Krish                                                                                                                                           • General Ledger
                                                                                                                                                   Proprietary and Confidential P42

Best in Class Practices - A/P Operations

                              Sample of recommendations                                 Sample of key success factors
                              for optimizing A/P operations                       when implementing a Shared Service Center

               Conduct Education & Training:                                           An executive sponsorship should stress the importance
                Encourage consistent and appropriate use of the buying process by      and value of moving towards an SSC.
                educating internal clients on the “How to Buy” policy.                 Involve the entire set of stakeholders in the project.
                Decrease exceptions in the ERS process by educating vendors to         Do not underestimate the amounts of time, resources
                stop sending invoices and verify they will be able to apply payment    and energy needed to change corporate operations and
                based on the new information on the check stub.                        culture.
                Improve awareness of all SAP functionality by training A/P             Assemble cross-functional project teams with members
                department (e.g., automatic invoice reduction capability).             chosen for their skill and experience.
                Ensure complete “buy-in” process understanding through cross-          Consider the language skills of the SSC personnel to
                training of A/P and Purchasing personnel.                              provide an optimal service to internal or external
               Enforce Appropriate Accountability:                                     customers.
                Encourage Purchasing to enter accurate and necessary data by           Evaluate/Select candidates for new functions based
                increasing their understanding of the impact on A/P’s processes.       upon specific competency profiles.
                Improve vendor invoice quality by returning incomplete invoices.       Cross-training and shared capabilities facilitates
                Designate process champions to enforce appropriate accountability      replacement during holidays/illness and allows job
   People       where users are left to make their own process decision.               rotation that may improve employee morale and
                                                                                       productivity.
                Improve invoice approver accountability by implementing the deadline
                monitoring feature in workflow, which notifies individuals when an     Identify the process owners that will have to deal with
                invoice is not approved in a timely manner.                            all the process-related accountabilities.
                                                                                       Identify a key contact person for each client group.
               Build Effective Organisation:
                                                                                       Manage clearly expectations of internal stakeholders
                Improve communication with Purchasing to foster an understanding
                                                                                       and customers as a service “degradation” may be
                of the interrelated nature of the groups and encourage quick inquiry
                                                                                       expected during the kick-off period of the “go-live”.
                response time.
                                                                                       Using performance measure, create incentives and
                Enforce consistency and process analysis by creating and enforcing
                                                                                       rewards to motivate people and continuously improve
                guiding policies and procedures.
                                                                                       their efforts.
                Align the A/P support group with the Purchasing support group.
                                                                                       Define governance agreements, coordination standards
                                                                                       and establish a communication culture.

Ramesh Krish                                                                                                         Proprietary and Confidential   P43
Best in Class Practices - A/P Operations

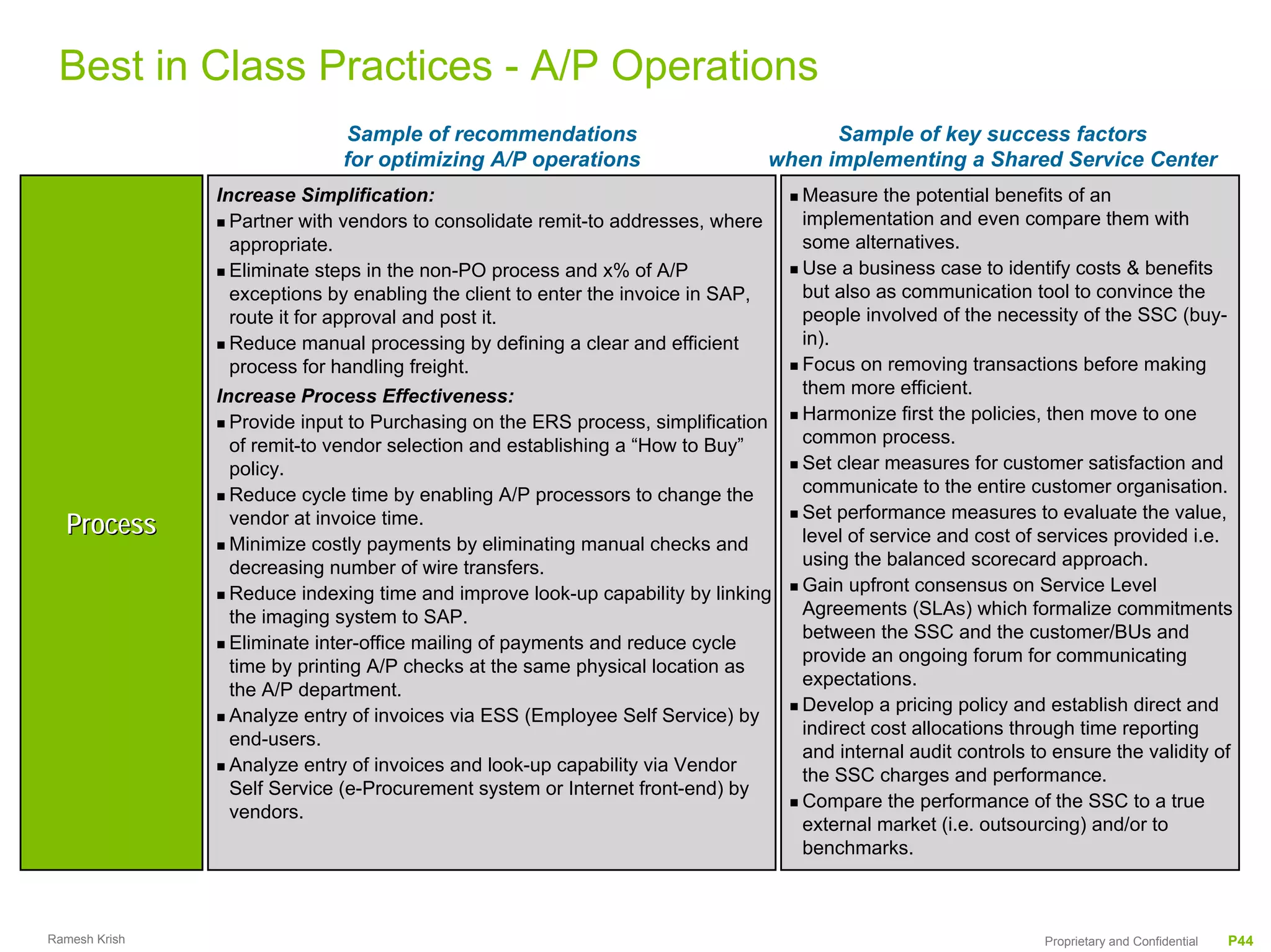

                             Sample of recommendations                                  Sample of key success factors
                             for optimizing A/P operations                        when implementing a Shared Service Center
               Increase Simplification:                                              Measure the potential benefits of an
                 Partner with vendors to consolidate remit-to addresses, where       implementation and even compare them with
                 appropriate.                                                        some alternatives.
                 Eliminate steps in the non-PO process and x% of A/P                 Use a business case to identify costs & benefits
                 exceptions by enabling the client to enter the invoice in SAP,      but also as communication tool to convince the
                 route it for approval and post it.                                  people involved of the necessity of the SSC (buy-
                 Reduce manual processing by defining a clear and efficient          in).
                 process for handling freight.                                       Focus on removing transactions before making
               Increase Process Effectiveness:                                       them more efficient.
                 Provide input to Purchasing on the ERS process, simplification      Harmonize first the policies, then move to one
                 of remit-to vendor selection and establishing a “How to Buy”        common process.
                 policy.                                                             Set clear measures for customer satisfaction and
                 Reduce cycle time by enabling A/P processors to change the          communicate to the entire customer organisation.
                                                                                     Set performance measures to evaluate the value,
  Process        vendor at invoice time.
                                                                                     level of service and cost of services provided i.e.
                 Minimize costly payments by eliminating manual checks and
                 decreasing number of wire transfers.                                using the balanced scorecard approach.
                 Reduce indexing time and improve look-up capability by linking      Gain upfront consensus on Service Level
                 the imaging system to SAP.                                          Agreements (SLAs) which formalize commitments
                                                                                     between the SSC and the customer/BUs and
                 Eliminate inter-office mailing of payments and reduce cycle
                                                                                     provide an ongoing forum for communicating
                 time by printing A/P checks at the same physical location as
                                                                                     expectations.
                 the A/P department.
                                                                                     Develop a pricing policy and establish direct and
                 Analyze entry of invoices via ESS (Employee Self Service) by
                                                                                     indirect cost allocations through time reporting
                 end-users.
                                                                                     and internal audit controls to ensure the validity of
                 Analyze entry of invoices and look-up capability via Vendor
                                                                                     the SSC charges and performance.
                 Self Service (e-Procurement system or Internet front-end) by
                                                                                     Compare the performance of the SSC to a true
                 vendors.
                                                                                     external market (i.e. outsourcing) and/or to
                                                                                     benchmarks.

Ramesh Krish                                                                                                      Proprietary and Confidential   P44
Best in Class Practices - A/P Operations
                              Sample of recommendations                                Sample of key success factors
                              for optimizing A/P operations                      when implementing a Shared Service Center
               Increase Flexibility:                                                 Systems play an important role in achieving a
                 Reduce check processing by increasing the use of electronic         successful and sustainable SSC implementation.
                 payments.                                                           Ensure that shared services design is flexible and
                 Decrease the number of invoices by increasing the use of ERS        scalable to support future acquisitions and
                 once the vendors establish they will be able to apply payment       divestitures easily.
                 with a bill of lading number.                                       Utilize technologies based on business needs.
                 Minimize manual handling through implementation of workflow         Use technologies that can be leveraged and
                 to route documents electronically for further processing.           supported throughout the organisation.
                 Limit manual processing by increasing the use of P-Cards and        Rationalize first the different systems/used
                 forcing users to charge their default account assignment.           functionalities, then move to one system/to a
                 Decrease processing time by using the Invoice Verification          common use of optimal functionalities.
                 transaction for processing PO invoices and / or upgrading to        Incorporate self-service as a critical component in
                 last SAP release.                                                   a shared services environment.
Technology       Partner with banks to create a plan to enable processing of
                 EDI payments larger than € x million.
                                                                                     Develop a migration plan that eases the transition
                                                                                     from the “as-is” to the “to-be” environment.
                 Partner with vendors to increase the use of ERS and EDI, both       Address security for facilities, data and
                 for inbound invoices and outbound payments, in order to             applications both from an internal and external
                 reduce manual invoices.                                             perspective.
                 Evaluate maturity and cost / benefit (if appropriate) of emerging   Maintain adequate backup facilities and disaster
                 technologies for A/P data input and validation.                     recovery plans.
                 Analyze and implement new P-Card program to enable                  Make a motivated choice between a greenfield
                 automated account distribution at the line item level.              (new) and a brownfield (extended existing)
                                                                                     location for the SSC.

Ramesh Krish                                                                                                     Proprietary and Confidential   P45

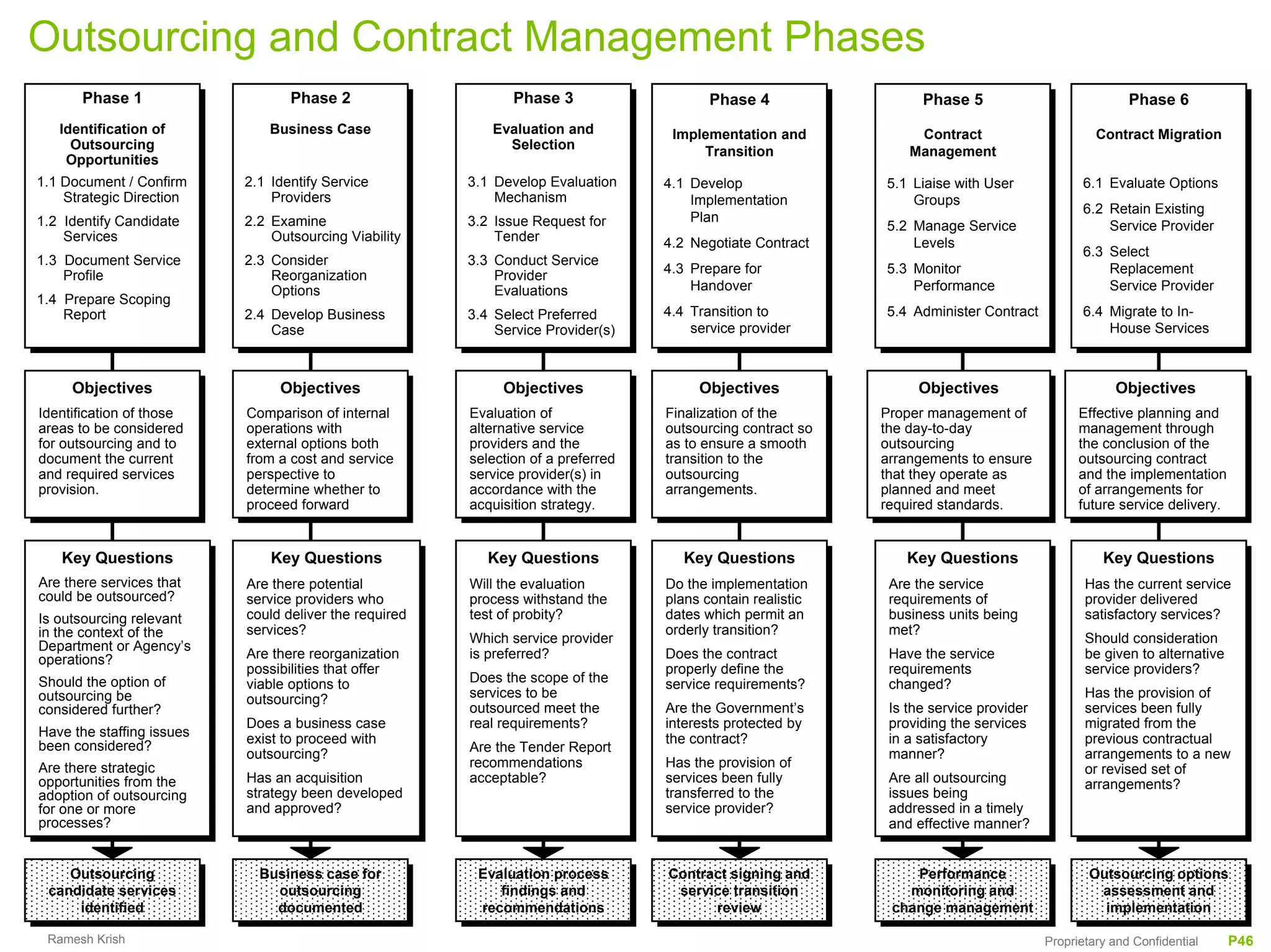

Outsourcing and Contract Management Phases
       Phase 1                     Phase 2                       Phase 3                    Phase 4                   Phase 5                              Phase 6
   Identification of            Business Case                Evaluation and           Implementation and             Contract                        Contract Migration
     Outsourcing                                               Selection                  Transition                Management
    Opportunities
1.1 Document / Confirm      2.1 Identify Service          3.1 Develop Evaluation     4.1 Develop                5.1 Liaise with User              6.1 Evaluate Options
    Strategic Direction         Providers                     Mechanism                  Implementation             Groups
                                                                                                                                                  6.2 Retain Existing
1.2 Identify Candidate      2.2 Examine                   3.2 Issue Request for          Plan
                                                                                                                5.2 Manage Service                    Service Provider
    Services                    Outsourcing Viability         Tender                 4.2 Negotiate Contract         Levels
                                                                                                                                                  6.3 Select
1.3 Document Service        2.3 Consider                  3.3 Conduct Service
    Profile                     Reorganization                Provider               4.3 Prepare for            5.3 Monitor                           Replacement
                                Options                       Evaluations                Handover                   Performance                       Service Provider
1.4 Prepare Scoping
    Report                  2.4 Develop Business          3.4 Select Preferred       4.4 Transition to          5.4 Administer Contract           6.4 Migrate to In-
                                Case                          Service Provider(s)        service provider                                             House Services

     Objectives
     Objectives                  Objectives
                                 Objectives                    Objectives
                                                               Objectives                 Objectives
                                                                                          Objectives                 Objectives
                                                                                                                     Objectives                         Objectives
                                                                                                                                                        Objectives
Identification of those
 Identification of those    Comparison of internal
                             Comparison of internal       Evaluation of
                                                           Evaluation of             Finalization of the
                                                                                      Finalization of the       Proper management of
                                                                                                                 Proper management of             Effective planning and
                                                                                                                                                   Effective planning and
areas to be considered
 areas to be considered     operations with
                             operations with              alternative service
                                                           alternative service       outsourcing contract so
                                                                                      outsourcing contract so   the day-to-day
                                                                                                                 the day-to-day                   management through
                                                                                                                                                   management through
for outsourcing and to
 for outsourcing and to     external options both
                             external options both        providers and the
                                                           providers and the         as to ensure aasmooth
                                                                                      as to ensure smooth       outsourcing
                                                                                                                 outsourcing                      the conclusion of the
                                                                                                                                                   the conclusion of the
document the current
 document the current       from aacost and service
                             from cost and service        selection of aapreferred
                                                           selection of preferred    transition to the
                                                                                      transition to the         arrangements to ensure
                                                                                                                 arrangements to ensure           outsourcing contract
                                                                                                                                                   outsourcing contract
and required services
 and required services      perspective to
                             perspective to               service provider(s) in
                                                           service provider(s) in    outsourcing
                                                                                      outsourcing               that they operate as
                                                                                                                 that they operate as             and the implementation
                                                                                                                                                   and the implementation
provision.
 provision.                 determine whether to
                             determine whether to         accordance with the
                                                           accordance with the       arrangements.
                                                                                      arrangements.             planned and meet
                                                                                                                 planned and meet                 of arrangements for
                                                                                                                                                   of arrangements for
                            proceed forward
                             proceed forward              acquisition strategy.
                                                           acquisition strategy.                                required standards.
                                                                                                                 required standards.              future service delivery.
                                                                                                                                                   future service delivery.

   Key Questions
   Key Questions                Key Questions
                                Key Questions                Key Questions
                                                             Key Questions              Key Questions
                                                                                        Key Questions              Key Questions
                                                                                                                   Key Questions                      Key Questions
                                                                                                                                                      Key Questions
Are there services that
 Are there services that    Are there potential
                             Are there potential          Will the evaluation
                                                           Will the evaluation       Do the implementation
                                                                                      Do the implementation      Are the service
                                                                                                                  Are the service                  Has the current service
                                                                                                                                                    Has the current service
could be outsourced?
 could be outsourced?       service providers who         process withstand the      plans contain realistic     requirements of                   provider delivered
                             service providers who         process withstand the      plans contain realistic     requirements of                   provider delivered
Is outsourcing relevant     could deliver the required
                             could deliver the required   test of probity?
                                                           test of probity?          dates which permit an
                                                                                      dates which permit an      business units being
                                                                                                                  business units being             satisfactory services?
                                                                                                                                                    satisfactory services?
 Is outsourcing relevant    services?                                                orderly transition?         met?
in the context of the
 in the context of the       services?                    Which service provider      orderly transition?         met?                             Should consideration
Department or Agency’s                                     Which service provider                                                                   Should consideration
 Department or Agency’s     Are there reorganization      is preferred?              Does the contract           Have the service                  be given to alternative
operations?
 operations?                 Are there reorganization      is preferred?              Does the contract           Have the service                  be given to alternative
                            possibilities that offer
                             possibilities that offer                                properly define the
                                                                                      properly define the        requirements
                                                                                                                  requirements                     service providers?
                                                                                                                                                    service providers?
Should the option of        viable options to             Does the scope of the
                                                           Does the scope of the     service requirements?       changed?
 Should the option of        viable options to            services to be              service requirements?       changed?                         Has the provision of
outsourcing be
 outsourcing be             outsourcing?                   services to be                                                                           Has the provision of
considered further?          outsourcing?                 outsourced meet the        Are the Government’s        Is the service provider           services been fully
 considered further?                                       outsourced meet the        Are the Government’s        Is the service provider           services been fully
                            Does aabusiness case
                             Does business case           real requirements?
                                                           real requirements?        interests protected by
                                                                                      interests protected by     providing the services
                                                                                                                  providing the services           migrated from the
                                                                                                                                                    migrated from the
Have the staffing issues
 Have the staffing issues   exist to proceed with                                    the contract?               in aasatisfactory                 previous contractual
been considered?             exist to proceed with        Are the Tender Report       the contract?               in satisfactory                   previous contractual
 been considered?           outsourcing?                   Are the Tender Report                                 manner?                           arrangements to aanew
                             outsourcing?                 recommendations            Has the provision of         manner?                           arrangements to new
Are there strategic
 Are there strategic                                       recommendations            Has the provision of                                         or revised set of
                                                                                                                                                    or revised set of
opportunities from the      Has an acquisition
                             Has an acquisition           acceptable?
                                                           acceptable?               services been fully
                                                                                      services been fully        Are all outsourcing
                                                                                                                  Are all outsourcing              arrangements?
 opportunities from the     strategy been developed                                  transferred to the          issues being                       arrangements?
adoption of outsourcing
 adoption of outsourcing     strategy been developed                                  transferred to the          issues being
for one or more
 for one or more            and approved?
                             and approved?                                           service provider?
                                                                                      service provider?          addressed in aatimely
                                                                                                                  addressed in timely
processes?
 processes?                                                                                                      and effective manner?
                                                                                                                  and effective manner?

    Outsourcing
     Outsourcing              Business case for
                               Business case for           Evaluation process
                                                            Evaluation process       Contract signing and
                                                                                      Contract signing and           Performance
                                                                                                                      Performance                   Outsourcing options
                                                                                                                                                    Outsourcing options
 candidate services
  candidate services             outsourcing
                                  outsourcing                 findings and
                                                               findings and            service transition
                                                                                        service transition          monitoring and
                                                                                                                    monitoring and                   assessment and
                                                                                                                                                       assessment and
     identified
      identified                documented
                                 documented                recommendations
                                                            recommendations                  review
                                                                                              review             change management
                                                                                                                  change management                   implementation
                                                                                                                                                       implementation
 Ramesh Krish                                                                                                                               Proprietary and Confidential   P46
i   process

Thank You

              Ramesh Krish
              Cell: 917-971-9701

Framework for shared services

  • 1.
    iprocess creating intelligent andcost conscious processes for shared services
  • 2.
    Contents 1 iProcess Value Creation Approach 2 Shared Services Vision 3 Shared Services Rationale 4 Shared Services Deployment 5 Alternate Shared Services Models 6 6 Functional Placement 7 Finance & Accounting Process Design 8 Risk Assessment 9 Organizational Design & Governance Ramesh Krish Proprietary and Confidential P1
  • 3.
    1 iProcess Value Creation Approach Ramesh Krish Proprietary and Confidential P2
  • 4.
    The iprocess Approach to Shared Services 1. Current State 2. Options Assessment Formulation • Apply appropriate assessment and • Develop options in conjunction with operating measurement techniques to understand company leadership to transform the cost base the current portfolio mix in light of investment parameters 5. Transformation & Governance 3. Feasibility • Monitor key performance indicators derived from initial investment criteria CUSTOMER Analysis • Understand and evaluate transaction merits and exit considerations • Develop a detailed blueprint for future state and transition plan from the current state outlining the financial viability of 4. Low Cost Model proposed projects Development • Implement the blueprint – strategic sourcing, shared services, process integration, physical layout consolidation, organizational transition etc • Review performance metrics and refine implementation Ramesh Krish Proprietary and Confidential P3
  • 5.
    2 Shared Services Vision Ramesh Krish Proprietary and Confidential P4
  • 6.
    Key Objectives We understandthat: - this project reflects a number of internal and external influences on process design, placement and ownership; - the desired approach to Organizing “Business Support Services” is part of a global vision to develop a shared services model Strategic Direction Outsourcing Business Potential Philosophy Organisational Business Scale Model Business Support Services Business Unit Activity Alignment Scale Business Activity Unit Usage Content Business Unit Position Ramesh Krish Proprietary and Confidential P5
  • 7.
    Shared Services Structure Indefining the appropriate approach to organizing “Business Support Services”, a number of criteria can be utilized to assess available options. In the context of shared services, the Accounts Payable “Business Support Service” will act as pilot. Criteria Approach represents Direct accountability is strategic consistency Accounts Accounts reinforced through process with corporate direction Payable Payable Check Check ownership Purchasing Purchasing Disbursements Disbursements Travel Travel Process Services Services Payroll Payroll Approach Model supports Security Security supports creation of a high Services Services ability performance Business to realize organization Support service-level Office Office Services improvement Support Support Technology People Services Services HR HR administration administration Facilities Facilities Management Management Structure creates a Model provides scalable platform to Bank Bank Events Events for cost efficient support future growth Reconciliations Reconciliations Accounts Accounts delivery of services Receivables Receivables Ramesh Krish Proprietary and Confidential P6
  • 8.
    3 Shared Services Rationale Ramesh Krish Proprietary and Confidential P7
  • 9.
    Vision for anA/P Shared Service Centre Vision for Accounts Payable – To satisfy the clients/suppliers by paying Vision for Accounts Payable – To satisfy the clients/suppliers by paying accurately and on time, as well as resolving issues in a timely fashion: accurately and on time, as well as resolving issues in a timely fashion: Supplier Management •• Service-oriented processes and scalable infrastructure; Service-oriented processes and scalable infrastructure; •• Appropriate accountability to be supported by the management; Appropriate accountability to be supported by the management; •• Optimal use of technology and of automation; Optimal use of technology and of automation; •• Better communication among all groups (Accounts Payable, Purchasing, internal Better communication among all groups (Accounts Payable, Purchasing, internal clients and external clients/suppliers). clients and external clients/suppliers). Purchasing Business Performance Dimensions – Sample of performance metrics for A/P Productivity Cost Efficiency Quality Customer Satisfaction Manual Invoices/FTE Cost/Invoice (manual Days Payable Outstanding % Paid on Time Satisfaction Survey payment) Accounts Lost discounts due to late Full (3 ways-matching) Avg. number of hours to send invoices % calls abandoned Payable Cost/Invoice (EFT) invoice to SSC Invoices/FTE % incorrect invoices First pass resolution Evaluated receipts/FTE Average Invoice € Avg. number of hours to enter Amount/Vendor invoice First pass yield % Average Cost/FTE Average hold Invoices/vendor time % invoices under €500 Duplicate payments collected Payments or avoided 24 hour % procurement Card Process defects by reason resolution purchases to total purchases code under €500 % calls answered in less than 3 rings Ramesh Krish Proprietary and Confidential P8
  • 10.
    Why a SharedServices Approach? Key Benefits Evidence of superior performance Companies participating in an industry survey reported the Cost savings (e.g., reduction in headcount, following results regarding their implementation of a SSC: administrative cost reduction). On average, a ROI of 27%. Operational flexibility and customer service (e.g., by establishing a SSC, divisions can concentrate Reduction of headcount by 26%. more on the value-added activities of their core business). When Elizabeth Arden International moved to a SSC, they saved: Improved growth. • 30% on administrative costs. • 60% reduction in headcount. • 50% cut in working capital. Improved service quality. Cargill consolidated 130 separated accounts payable, accounts receivable and general ledger systems into its IT coordination. SSC. This reduced A/P processing by 34% and the cost for cash application processing by 20%. Facilitated ERP optimization. AlliedSignal reports a 30-35% savings in accounting costs since they moved to a SSC. Tax savings. Shared Services is a method of organization and operation in which support processes of an organisation are “centralized” and independently structured. Ramesh Krish Proprietary and Confidential P9
  • 11.
    Alternative Shared ServicesModels A variety of factors have an influence on the selection of the appropriate organisational model for a “Business Support Service”. Models Related Influences Centralized Best suited where critical mass is necessary or present and business model is focused on service levels. Key influences are business philosophy, content and organisational scale. Hybrid Appropriate where organisational model is undeveloped and strong standardization for selected functions is desired. Key influences are business philosophy, future strategic direction, volume, and business unit integration. Distributed Applicable when focus is on business unit autonomy and variability is significant. Key influences are business model, content, business unit usage and business unit integration. Hosted Relevant where natural organisational ownership is apparent and critical mass is not necessary. Key influences are business model, content, volume, business unit usage and organisational scale. Ramesh Krish Proprietary and Confidential P10
  • 12.
    Alternative Shared Servicesmodels The assessment of the available organisational approaches to “Business Support Services” provides insight into the applicable structural model. Illustrative assessment for several “Support Services” is presented below: Key Characteristics Implications Purchasing Principally driven by Wholesale business with substantial volume Close affinity to single business and Accounts Payable Directly tied to supply chain with substantial volume natural process flow provide natural opportunity to concentrate activity Check Disbursement Linked with supply chain and payroll with substantial volume Moderate volume with some activity being conducted at Narrow process scope and natural Bank Reconciliation businesses already relationship to cash management suggests business unit responsibility Payroll High volume with direct relationship to broader Human Multiple linkages to HR function offers Client X activities natural aggregation source Security Services Low volume mixed activity set with partial outsourcing Travel Lower volume with outsourced providers Infrastructure-related nature provides natural aggregation source and Office Support Mixed activity set with very high selected volumes focused management of outsourced Services relationships Facilities Management Low volume, mixed activity set with partial outsourcing Ramesh Krish Proprietary and Confidential P11
  • 13.
    Opportunity Analysis Framework Cost Structure Comparative Management Segment Analysis Analysis Analysis Knowledge Analysis - Where are What do we compare to? Where are costs high Where does the large areas of cost relative to revenues? management believe and what are the opportunities exist? primary drivers? Major Processes Competition Business Units Interviews Functional / Internal Comparatives Customer Groups Focus Groups Organizational Historical Performance Product Groups Workshops Line Item Benchmarks/Best Channels Initial opinion can be Cost of Management Practices directionally correct Geographic Reasonability Treated as a hypothesis, Standards then tested with facts Ramesh Krish Proprietary and Confidential P12
  • 14.
    4 Shared ServicesDeployment Ramesh Krish Proprietary and Confidential P13
  • 15.
    Shared Services Approach Approach for outsourcing There is a spectrum of solutions… Evaluate Evaluate Assess Assess Solicit and Solicit and Finalize Finalize Supplier Supplier Opportunity Opportunity Evaluate Bids Evaluate Bids Partnership Partnership Universe Universe 4 Finance 4 Property services 4 Payroll Define functional Determine Define service Conduct face-to- “candidates” supplier universe requirements, face discussions within company specifications with finalists 4 Middle Office 4 IT Strategy & 4 Operations Establish and metrics Development Compare qualification Review final 4 Regulatory 4 IT functional criteria Develop and proposals and reporting Infrastructure performance distribute RFP select vendor(s) with industry Conduct vendor benchmarks 4 Global 4 Data interviews, as Manage RFP Develop required response transition plan procurement processing in Assess process jointly with Finance intangibles, such Evaluate vendors vendor as service, against criteria Evaluate bids quality to determine and select Begin migration Shared service Service companies Outsourcing improvements short list finalists and monitor centres performance Finalize list of functions to be outsourced Savings can be achieved by… • Establishing shared service centers for core activities allows organizations to achieve economies of scale. • Setting-up service companies allows organisations to operate on a more commercial basis and to better understand performance. • Outsourcing non-core activities allows organizations to focus investment and management attention on more critical issues. • Provides near-term realization of cost savings and significant scale flexibility, particularly in multi-vendor arrangements. Ramesh Krish Proprietary and Confidential P14
  • 16.
    The Shared ServicesAssessment Framework Multiple Multiple Systems Processes Rationalize Systems Define Processes Move to One Commonize Policies System Move to One Database Commonize Processes Shared ServicesOne Organization One Location per Process Consolidate within Region Separate from Consolidate within Country Business Units Multiple Multiple Locations Organizations Major Types Description Sample Processes Handles routine transaction • Procurement Center of Scale based processes by leveraging • Accounts Payable Services economies of scale and • Payroll standardization. • Travel & Expenses Concentrates expertise to • ERP COEs Center of Expertise provide high-value services to • Tax/Treasury Services internal customers at • Benefits competitive cost. • Legal Establishes a partner • Internal Consulting Business Partner relationship between Services Services organizational units to achieve • Strategy common goals. • Reengineering • Government Provides a structure to support Corporate Steward central mission critical Relations Services • Compliance objectives. • Fiduciary Ramesh Krish Proprietary and Confidential P15
  • 17.
    Future Vision –Other Dimensions Other design elements – technology, facilities, position definition, and management approach – are key elements that help define the organization. Assessments of these dimensions to date have uncovered no impediments to achieving this vision. Technology Facilities • Current financial and business systems are capable of supporting • We will physically consolidate activities to the maximum extent the future vision in the Country A possible and practical into four locations • Single Region A Financial Platform (PeopleSoft) facilitates the • We will maintain a commitment to our existing locations: implementation of the shared services center components of the - Location 1 future vision - Location 2 • Operational accounting is conducted primarily on three business systems (Bridge, WinBroker, and Project Accounting), and - Location 3 therefore the shared services vision supports a multiple platform - Location 4 situation • We will be mindful of selective concessions in centralizing and • Project is not dependent on upgrade and/or migration technology consolidating activities into these centers, including retention of initiatives key personnel and securing business area buy-in • Future movement of the organization to one global financial platform will enhance our ability to share information globally Position Definition Management Approach • As-Is Analysis and Detailed Design Phases will help us identify • Accounting Shared Services Leader will need to be identified the number of positions (e.g., AP clerks, AR clerks, field - Responsible for management, measurement, control accounting associates) that can be consolidated in order to procedures and accounting policies, and quality assurance facilitate operational flexibility and cross-training opportunities, within the shared services organization improved management, and reduced costs - Instrumental in negotiating and establishing Service Level • Job descriptions for Regional and Business Area personnel will be Agreements with the internal clients carefully defined - Direct reporting to Finance Controller - Business Area Financial Planning & Analysis roles will likely require the greatest clarity • Business Area functions continue to have primary reporting to Business Area management, with dotted line reporting into the - Recently updated job descriptions will facilitate this process accounting organization • Corporate functions continue to report to Finance Controller • Continue to outsource payroll Ramesh Krish Proprietary and Confidential P16
  • 18.
    Implementation Approach GuidingPrinciples Implementation guiding principles are critical to establishing a common approach amongst management to designing and converting to an improved organization. • Balanced Approach – We will design the accounting shared services organization to: - Support business area strategies and needs - Balance service quality expectations with control, consistency, and cost considerations • Strong Business Area Working Relationships – We will actively, but judiciously, engage finance and accounting management to: - Create common business understandings and promote buy-in - Instill a collaborative approach that demonstrates an understanding of business area needs • Fact-Driven Analysis & Decisions – We will develop a detailed fact base that will enable: - Design and implementation decisions - Measurement of financial and operational success • Minimally Invasive During Close Periods – Design and implementation efforts must be sensitive to financial close process requirements of accounting areas • Aggressive But Realistic Timeframes – A successful implementation must proceed expeditiously to minimize implementation risk • Staged Implementation Approach – Tackle one business area at a time • Commitment to Project Management – Get it done right. Mitigate service quality reduction risk Ramesh Krish Proprietary and Confidential P17
  • 19.
    Implementation High-Level Plan Anaggressive, but realistic, implementation strategy must be affirmed to successfully design and implement the future vision. DESIGN DESIGN IMPLEMENT IMPLEMENT Implementation As-Is Assessment To-Be Design Detailed Design Implementation Planning • Formalize a detailed, • Translate vision into • Refine and expand • Develop practical work • Execute operational Objectives Objectives fact-based assessment preliminary design of blueprint for future plans and associated changes in phased of existing accounting future accounting accounting organization accountabilities to rollout operations operations; validate implement envisioned • Capture value outlined with key stakeholders changes in business case Project Management Office – Regular Communication, Service Level Monitoring, Status Reporting and Problem Resolution • Baseline/collect • Isolate opportunities to • Refine and expand • Compare existing state to • Implement people, process operational and financial consolidate, simplify detailed design; tailor to future detailed design to and technology changes data for existing operations, improve location operations, understand change required to realize operations: controls, and gain scale including: requirements transformed business − Cost economies − Process flows linked • Develop change strategy model − Headcount • Modify existing to systems and roll-out plan • Charter discrete projects Key Activities functional designs, − Business and - Select and prioritize that collectively deliver Key Activities − Transaction volume − Service Levels including: financial systems BA roll-out needed change − Systems − Standard processes linked to processes • Identify timing and • Establish Project − Standard jobs − Job designs linked to prioritization of required Management Office to • Identify and evaluate • Refine high-level business skills IT projects, if any track progress against inconsistencies among case • Project P&L for the - Evaluate IT capacity milestones and area: • Validate technology business post- given existing project dependencies − Process flows readiness: implementation portfolio • Enroll employees in − Job designs − Business systems • Identify communication • Develop detailed change efforts through • Enhance business and communication and − Financial systems requirements and create implementation plan with financial systems maps, by training • Validate To-Be design communication plan clear accountability for all area with key stakeholders • Begin negotiating service major milestones level agreements (SLAs) Timeline Timeline 5 months5 5 months5 Ramesh Krish 5 Proprietary and Confidential P18 Anticipates a November 1, 20XX start; timeline will be challenged as each phase is completed.
  • 20.
    Project Organization Enrolling key stakeholders, business area management and Subject Matter Advisors in the project from design through implementation will be critical to project success. Roles & Responsibilities − CFO −Business Head • Provide active, visible and vocal leadership Steering Committee Steering Committee − Controller −[HR] • Champion Business Area buy-in − Business Area CFO 1 −[IT] − Business Area CFO 2 −[Tax] • Execute enterprise-wide communications/ recommendations Project Sponsor − TBD • Serve as main voice for project – change advocate/ opinion leader Project Sponsor • Set overall project direction, set priorities and allocate resources Project Manager Project Manager − TBD • Responsible for overall engagement execution and management • Identify issues & risks and ensure escalation/ resolution Business Area Teams Business Area Teams Program Management • Support Team Leads in project planning and delivery • Track status and manage issue identification and resolution BU 1 BU 1 • Design and deliver change management programs Team Rosters: BU 2 BU 2 − 1.0 Team Lead Team Leads • Manage collection and synthesis of data, internal benchmarks, and design elements − X.0 Business Area Lead BU 3 BU 3 − X.0 Analysts • Facilitate meetings with key executives, business areas, and functional teams Program Program − TBD SMAs • Participate in site visits, planning sessions and development of deliverables Management Office Management Office BU 4 BU 4 • Skill set needs: Operational performance improvement; Accounting process redesign; Benchmarking study design and execution; Implementation planning; Strong oral and BU 5 BU 5 written skills; Visioning Sessions; and Group facilitation Business Area Leads Other Other • Act as liaison with represented Business Area Tax Team Tax Team • Deep business area/ technical knowledge and familiarity with its accounting roles Human Resources/ Human Resources/ • Participate in data gathering, visioning, and planning − 1.0 Team Lead − TBD SMAs Facilities Team Facilities Team Analysts − 1.0 Team Lead • Perform selected benchmarking, business case, process & organization analysis − X.0 Analysts activities Treasury Team Treasury Team − TBD SMAs • Assist with deliverable development − 1.0 Team Lead Subject Matter Advisors (SMAs) − TBD SMAs Technology Team • Help anticipate, identify and resolve issues Technology Team • Provide accounting and shared services center subject matter expertise and support, − 1.0 Team Lead as needed − X.0 Analysts • Reference applicable best practices − TBD SMAs Ramesh Krish Proprietary and Confidential P19
  • 21.
    5 Alternate SharedServices Models Ramesh Krish Proprietary and Confidential P20
  • 22.
    Outsourcing - Approach 4 Performing processes/services utilizing internal human and technology resources 4 Improvements in processes/services leverage techniques such as process redesign, service center implementation, technology infrastructure improvement and role redesign Insourcing Enterprise Enterprise Infrastructure & labor cost Process, Transition savings Process Service or Service or Function Function 4 Utilizes a combination of insourcing and outsourcing solutions, with a third party vendor providing human and/or technology resources as an extension of the employer’s resources 4 Business process redesign typically accompanies the transition to a co-sourcing arrangement 4 Additional improvements leverage service center implementation, technology infrastructure improvement and role redesign Hybrid/Co- Sourcing Infrastructure & Enterprise labor cost Enterprise Service Provider savings Process, Process, Service or Service or Function Transition Function 4 Typically, a pure outsourcing arrangement called full outsourcing is the final phase in the transition to an outsourcing strategy 4 Outsourcing is where an organization transitions human and technology resources related to non-core competency processes/services to a service provider with expertise in administering the particular process or processes 4 New responsibilities emerge for the organization to manage the service levels of the service provider Total Outsourcing Enterprise Enterprise Service Provider Process, Infrastructure Process, Service or Transition and labor cost Service or Function savings Function Ramesh Krish Proprietary and Confidential P21
  • 23.
    Outsourcing – OptionsAssessment Technology Typical Functions For Off shoring Deutsche Bank IT Development in Bangalore (JV) Historical Low 4 Transactional sourcing environment, 4 DB established an IT development centre in 1992 / Typical C 4 Single transaction technology projects restricted to specific IT processes / O to provide services across banking and finance Off T M 4 Application development and infrastructure E P functions shoring C L management E 4 Limited risk profile H X 4 Infrastructure development and 4 The facility spans 50,000 square feet with 450 Starting I T management professionals and is supported with dedicated Point 4 Maturing global market place Y 4 Full enterprise technology delivery high-speed satellite communication links High Number of Functions Illustrative ABN-AMRO Card Processing in Chennai Business Process (BP) Typical Functions For Off shoring (Outsourced) 4 Strategic sourcing opportunity Low 4 ABN outsourced card processing functions as part Expansio C of a 10 year deal to a facility in Chennai n Area / 4 Rapidly growing market of O M Alternativ processes to offshore, enabled by P Customer Finance 4 Initially 60 software professionals will manage maturing service providers, global IT B L application hosting, data and back office e Starting P E Relation- & Human Card and telecoms infrastructure X ship processing Point I Admin- Resource Services 4 Evolving focus for many firms due to T Manage- istration s 4 ABN estimate that they will increase card services Y ment the potential for significant cost cost efficiencies by 15-20% High Number of Functions savings Standard Chartered Asia Pacific Hub (Multiple Hub Possible Structures For Off shoring Models) Building 4 Creation of a regional / global 4 SC has developed an extensive hub network Significan shared services organisation Low within the region, which is managed centrally t Scale 4 Single function regional hub through a business hub in Singapore 4 Due to their complexity, hubs require C And / Or O significant levels of commitment but M 4 The Chennai facility was consolidated in 2002 into Global 4 Multi-functional regional hub HP a global multi-functional hub, dealing with both are potentially the most rewarding U L Diversity back-office processing and IT development option B E 4 Multi-functional, multi-entity global Of X hub requirements 4 Hub strategy can be established as I 4 Multi-hub network with central Operation T the aspirational goal towards which Y management control point 4 SC are investing $40 million into a second back- s technology and business process High Number of Functions office processing hub in Kuala Lumpur, primarily strategy can evolve for their Asia Pacific businesses Ramesh Krish Proprietary and Confidential P22
  • 24.
    Outsourcing – ExecutionRisk Assessment Split …Or …Or Here Here Here………....................... Or Lift In Its Entirety Advice / Customer Customer Support Execution / Operations Technology Facing Service Services Transaction Key Criteria For Off shoring And Organisational Considerations 4 Physical access to clients is required 4 The current resources supporting the Requires activity are viewed as irreplaceable Competitive Physical 4 Physicalaccess to other staff or Advantage or 4 Currentresources represent a competitive G Proximity or departments is required on a regular basis Irreplaceable advantage to the bank, will not relocate O Similar Time 4 Physical access to an external entity is Resource and cannot be allowed to go to a / Zone required on a regular basis competitor N O 4 Regulatory or compliance statutes dictate 4 Labor pool at new site does not contain a G Regulatory or a location for the activity Skill Set regular supply of required skill set AND O Compliance 4 Internal audit or risk policy requires (at Deficiency of skill set requires uncharacteristically high Requirement least given current process) that activity New Site lead time to train, posing an unacceptable remain in current location level of risk GO 4 Strategic priorities C 4 Specialist vs. commodity O 4 Client interaction channels 4 Short-term vs. long-term N 4 Product / service mix driven by business S 4 Internal vs. external I requirements D 4 Complimentary roles and skill Skill Sets & Organizational 4 Mapping of business and technical E categorisations / combinations Types of Structure & requirements R 4 Mix of types of resources / alternate A Resources Processes 4 Timing of delivery sources T 4 Manner of interaction with vendors I 4 Resource sharing opportunities O 4 Organisational interdependencies N 4 Resource costs vs. benefits S 4 Migration requirements for alternative 4 Flexibility of access resourcing model Ramesh Krish Proprietary and Confidential P23
  • 25.
    6 Functional Placement Ramesh Krish Proprietary and Confidential P24
  • 26.
    Future Vision –Functional Placement In order to determine which accounting functions and activities could be included in a shared services environment, a selection framework was designed and applied across Company A Country A Shared Services Selection Criteria Value to Business Area Applicability Screen Screen Client-Centric Attributes Content Governance High Volume Risk Strategic Value Specialization Transactional Common Potential Accounting Shared Functions Services Candidates •Is the function •Does the function •Is the function •Is the function Key critical to require unique skills or related to discrete performed by or for Enablers business and/or knowledge? areas of work? multiple business business areas with little area(s)? customization? •Does the function •Is the function •Are significant •Would the risks of directly touch the related to policy or volumes of the function execution client or client stewardship? transactions be increased? systems in a handled? material manner? Is there high-risk effect on the Ramesh Krish client? Proprietary and Confidential P25
  • 27.
    Future Vision –Functional Placement The degree of consolidation was determined by defining three levels of the envisioned organization and establishing principles to help determine functional placement. Levels Functional Placement Principles Implications • Corporate governance and policy-setting • Global activities remain at a corporate level that functions serve as a governance or policy-setting entity • Compliance tracking functions • Some global functions could be “outsourced” to Corporate Corporate • External regulatory relationship functions: the regional shared services center (Global) (Global) - Reporting & regulatory compliance - Shareholder relations • Enterprise-wide financial analysis and planning • Common, homogenous functions • Consolidation of transactional activities with • Scalable, transactional processes common processes promote: • Accounting activities that do not require - Consistent and standardized processes and controls Regional Regional intimate client involvement - Higher data integrity (Country A) (Country A) - Greater operational flexibility and scalability - Lower cost structure • Increased visibility into enterprise-wide financial information • Activities that require proximity to client personnel • Reduced focus on low-value transactional or specialized knowledge of local markets processing increases focus on sales and service • Activities that produce direct accounting inputs • Increased financial analysis capacity Business Business into financials of clients and/or underwriting Area Area • Client-centric activities remain close to clients partners • Business Area Financial Planning & Analysis activities Ramesh Krish Proprietary and Confidential P26
  • 28.
    Future Vision –Functional Placement Accounting activities are divided across five functional groups and classified according to the organization level at which the activities will be performed (slides 8-9). Activities2 classified as “Regional” are strong candidates for centralization into an accounting shared services center. Financial Planning & Client-Centric Non-Client-Centric Financial & Regulatory Analysis Operational Accounting Operational Accounting Financial Accounting Reporting • Translate business strategy • Record operational transactions • Record operational transactions • Record general ledger • Prepare accurate, valid into operational and capital and prepare accounting data and and prepare accounting data transactions at the corporate reporting to meet statutory, plans for parent company and reports and reports (global) level and at the SEC, and Shareholder needs Description Description business areas • Produce direct accounting inputs • Primarily for internal use; no regional level in shared • Support operations with into financials and/or access clients rely significantly on service centers reporting analysis and advice financial systems of clients function for external reporting • Monitor and maintain general and/or underwriting partners; ledger accounts key part of sales and service process • Possible Shared Services Center All Activities Reside at • Fiduciary Accounting • General Ledger • Specific Business Area Audits & to support Business Area Business Area Level − Fiduciary Payables − GL Processing Regulatory Reporting, if any Analysis − Fiduciary Receivables − Journal Voucher Processing − Client Setup − Shared Facilities & Expense • Client Receivables Accounting − Premiums & Claims − GL Maintenance Receivable − Consolidations − Premiums & Claims − Tax Documentation Collections − Non-Trade Intercompany − Billing Transactions Regional − Client Service Time & Expense • Special Events Accounting Regional • Revenue Only Accruals & − Mergers & Acquisitions Commissions • Account Reconciliations − Revenue Accruals − Account Reconciliations − Commission Calculations − Non-Trade Accounts Receivable • General Ledger & Collections − Trade Intercompany • Cap-Ex Accounting Transactions − Capital Expenditures − Journal Voucher Processing − Non-Capitalized Projects − Business Systems & GL Feeds − Fixed Assets • Shared Services Centers – Existing − Payroll – HR & Benefits − Vendors Payable Ramesh Krish Functions mapping and definitions are located in the Appendix. 2 Accounting Proprietary and Confidential P27
  • 29.
    Future Vision –Functional Placement Activities3 classified as “Business Area” and “Corporate” will not be consolidated into the accounting shared services center. Financial Planning & Client-Centric Non-Client-Centric Financial & Regulatory Analysis Operational Accounting Operational Accounting Financial Accounting Reporting • Internal Performance Reporting • Fiduciary Accounting All Activities Reside at All Activities Reside All Activities Reside • Analysis & Forecasting − Fiduciary Payables Regional Level at Regional or at Corporate Level, except − Planning & Budgeting − Fiduciary Receivables Corporate Levels Specific Business Area Audits − Client / Broker Profitability − Client Setup & Regulatory Reporting • Billing & Collection • Client External Reporting Assistance, as required • Client Receivables − Premiums & Claims Receivable Business Area Business Area • Overrides from Carriers/ − Premiums & Claims Collections Suppliers − Billing • Contingent Commissions from • Revenue Only Accruals & Carriers Commissions • Limited Revenue & Accrual − Revenue Accruals Analysis − Commission Calculations − Incentive Compensation • General Ledger − Deferred Revenues − Trade Intercompany − Bad Debt Allowance Transactions Reserves − Journal Voucher Processing − Work in Progress Reserves − Business Systems & GL Feeds • Quality Assurance • Internal Performance Reporting All Activities Reside at All Activities Reside at • General Ledger • External Reporting • Analysis & Forecasting Business Area Level Regional Level − GL Processing • Financial Statement − Planning & Budgeting − Journal Voucher Processing Preparation − Client / Broker Profitability − Shared Facilities & Expense Accounting • Financial Accounting • Quality Assurance − GL Maintenance Governance − Consolidations − Financial Accounting − Tax Documentation Policies & Procedures − Non-Trade Intercompany − Standards & Reporting Eliminations Package • Special Events Accounting − Sarbanes-Oxley Corporate Corporate − Litigation Compliance − Mergers & Acquisitions • Account Reconciliations − Account Reconciliations − Non-Trade Accounts Receivable & Collections • Cap-Ex Accounting − Capital Expenditures − Non-Capitalized Projects − Fixed Assets • Corporate Financial Systems • Shared Services Centers – Existing − Investment Accounting4 Accounting Functions mapping and definitions are located in the Appendix. 3 Ramesh Krish 4 Investment Accounting is already in a shared services center. Proprietary and Confidential P28
  • 30.
    7 Finance & Accounting Process Design Ramesh Krish Proprietary and Confidential P29
  • 31.
    Accounting Functions The followingis a list of all accounting activities separated into the five functional groups. Functional Groups Financial Planning & Client-Centric Non-Client-Centric Financial & Regulatory Analysis Operational Accounting Operational Accounting Financial Accounting Reporting •Internal Performance •Fiduciary Accounting •Fiduciary Accounting •General Ledger •External Reporting Reporting − Fiduciary Payables − Fiduciary Payables − GL Processing •Financial Statement •Analysis & Forecasting − Fiduciary Receivables − Fiduciary Receivables − Journal Voucher Preparation − Planning & Budgeting − Client Setup − Client Setup Processing − Shared Facilities & •Financial Accounting − Client / Broker •Client External Reporting •Client Receivables Governance Profitability − Premiums & Claims Expense Accounting •Client Receivables − GL Maintenance − Financial Accounting •Billing & Collections Receivable Policies & Procedures − Premiums & Claims − Consolidations Assistance, as required − Premiums & Claims − Standards & Reporting Receivable − Tax Documentation Collections Package •Overrides from Carriers/ − Premiums & Claims − Non-Trade Intercompany − Billing − Sarbanes-Oxley Suppliers Collections Eliminations − Client Service Time & Compliance − Billing •Contingent Commissions Expense •Special Events Accounting from Carriers •Revenue Only Accruals & − Litigation •Specific Business Area •Revenue Only Accruals & Audits & Regulatory Commissions − Mergers & Acquisitions •Limited Revenue & Accrual Commissions Reporting, if any − Revenue Accruals Analysis − Revenue Accruals •Account Reconciliations − Commission Calculations − Incentive Compensation − Commission Calculations − Account Reconciliations − Deferred Revenues •General Ledger − Non-Trade Accounts •General Ledger − Bad Debt Allowance − Trade Intercompany Receivable & Collections − Trade Intercompany Reserves Transactions •Cap-Ex Accounting Transactions − Work in Progress − Journal Voucher − Capital Expenditures − Journal Voucher Reserves Processing − Non-Capitalized Projects Processing − Business Systems & GL − Fixed Assets •Quality Assurance − Business Systems & GL Feeds Feeds •Corporate Financial Systems •Shared Services Centers − Payroll – HR & Benefits − Investment Accounting − Vendors Payable Ramesh Krish Proprietary and Confidential P30
  • 32.
    Business Area FinancialPlanning & Analysis – Functional Description Internal Performance Reporting responsibilities: Prepare reports comparing budget amounts to actual performance and current period performance to prior periods, reports projecting future performance, and special or ad-hoc financial and operational reports based on managerial needs Review established strategic and business performance targets, assess and support business performance reporting, balancing between internal and external information, historical and predictive (leading) information and financial and non-financial information Partner with operating management and act as business advisors; regularly attend operational staff meetings Analysis & Forecasting responsibilities: Operate and maintain budget tools, set up and populate assumptions, prepare planning guidelines, and produce budgets for review Prepare strategic (multi-year), operational and capital Budgetary Business Plans (1 year) Develop rolling forecast, collect and consolidate forecasts, perform reiterations focused on identifying ways to meet operational targets (e.g., “what-if” scenarios and sensitivity analyses) Prepare reports analyzing clients and staff area profitability, as appropriate Assess opportunities for strategic alliances, acquisitions and divestitures Overrides from Carriers/Suppliers and Contingent Commissions from Carriers responsibilities: Monitor and assess commission fee arrangements with carriers and suppliers that are based on previously selected criteria for volume or item counts and ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies Monitor and assess commission payments from carriers and suppliers that are based on previously selected criteria for volume and underwriting results and ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies; challenge reasonableness of reported underwriting results factor Limited Revenue & Accrual Analysis responsibilities: Monitor and assess incentive payment programs for personnel that are based on factors such as revenue and pre-tax income, and ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies Analyze revenue and expense recognition for long term service and sales contracts to ensure deferred revenue/ expense reserves are recorded on a timely and appropriate basis based on Company A policies. Monitor contract for any long term potential profitability deficiencies Monitor and assess required reserves for Business Area or company receivables and unbilled consulting services Quality Assurance responsibilities: Evaluate reasonableness of business area results through variance analysis, discussions, and review of business and financial systems data and identify unexpected or unusual items The Business Area’s Financial Planning & Analysis resources will focus on business area-driven analysis and reporting. The following broadly describes the envisioned responsibilities of the future FP&A position in the Business Area. Ramesh Krish Proprietary and Confidential P31
  • 33.
    Accounting Functions –Mapping Summary The following matrix (on slides 20-22) maps all accounting activities to their “future” organizational placements. Those activities listed in the “Regional” column are the initial targets for a shared services center. All other functionality remains unchanged from current positioning. Corporate Regional Business Function/ Activity (Global) (Country A) Area Internal Performance Reporting + + Analysis & Forecasting • Planning & Budgeting + + Financial Planning & Analysis Financial Planning & Analysis • Client/ Broker Profitability + + Billing & Collections Assistance + Overrides From Carriers/ Suppliers + Contingent Commissions From Carriers + Limited Revenue & Accrual Analysis • Incentive Compensation + • Deferred Revenue Analysis + • Bad Debt Allowance Reserves + • Work in Progress Reserves + Quality Assurance + + Fiduciary Accounting • Fiduciary Payables + • Fiduciary Receivables + Operational Accounting Operational Accounting • Client Setup + + Client-Centric Client External Reporting Client-Centric Client Receivables • Premiums & Claims Receivable + • Premiums & Claims Collections + • Billing + Revenue Only Accruals & Commissions • Revenue Accruals Accounting + • Commission Calculations + Ramesh Krish Proprietary and Confidential P32
  • 34.
    Accounting Functions –Mapping Summary Corporate Regional Business Client-Centric Function/ Activity (Global) (Country Area A) Client-Centric Operational General Ledger Accounting Operational Accounting • Trade Intercompany Transactions + • Journal Voucher Processing + • Business Systems & GL Feeds + Fiduciary Accounting • Fiduciary Payables + • Fiduciary Receivables + • Client Setup + Client Receivables Operational Accounting Operational Accounting • Premiums & Claims Receivable + Non-Client-Centric Non-Client-Centric • Premiums & Claims Collections + • Billing + • Client Service Time & Expense Accounting Revenue Only Accruals & Commissions • Revenue Accruals Accounting + • Commission Calculations + General Ledger • Trade Intercompany Transactions + • Journal Voucher Processing + • Business Systems & GL Feeds + General Ledger & Cost Accounting Accounting Accounting • General Ledger Processing + + Financial Financial • Journal Voucher Processing + + • Shared Facilities & Expense Accounting + + • General Ledger Maintenance + + Ramesh Krish Proprietary and Confidential P33
  • 35.
    Accounting Functions –Mapping Summary Corporate Regional Business Function/ Activity (Global) (Country Area General Ledger & Cost Accounting (continued) A) • Consolidations Accounting + + • Tax Documentation + + • Non-Trade Intercompany Eliminations + + Special Events Accounting • Litigation Accounting + • Mergers & Acquisitions Accounting + + Financial Accounting Financial Accounting Account Reconciliations • Account Reconciliations + + • Non-Trade Accounts Receivable & Collections + + Capital Expenditures Accounting • Capital Expenditures + + • Non-Capitalized Projects + + • Fixed Assets Accounting + + Corporate Financial Systems + Shared Services Centers - Existing • Payroll – Human Resources & Benefits + • Investment Accounting + • Vendors Payable + External Reporting + + Regulatory Reporting Regulatory Reporting Financial Statement Preparation + Financial & Financial & Financial Accounting Governance • Financial Accounting Policies & Procedures + + • Standards & Reporting Package + • Sarbanes-Oxley Compliance + Business Area Audit Regulatory Reporting + Ramesh Krish Proprietary and Confidential P34
  • 36.
    Accounting Functions –Activities & Definitions Function/ Activity Definition Internal Performance Reporting Prepare reports comparing budget amounts to actual performance and current period performance to prior periods, reports projecting future performance, and reports for special or ad-hoc managerial needs Planning & Budgeting Operate and maintain budget tools, set up and populate assumptions, prepare planning guidelines, and produce budgets for review. Develop strategic planning process and forecasts for departments and overall corporation Client/ Broker Profitability Initially for fee and negotiated commission assignments – assist and challenge business areas in setting profitable pricing and reporting on profitability of individual agreements. Develop into reporting on revenue and expenses per client/ broker and related profitability Financial Planning & Analysis Financial Planning & Analysis Billing & Collections Assistance Assist business areas in following up on accounts receivable and collections owed to Company A Overrides from Carriers/ Suppliers Monitor and assess commission fee arrangements with carriers and suppliers that are based on previously selected criteria for volume or item counts. Ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies Contingent Commissions from Carriers Monitor and assess commission payments from carriers and suppliers that are based on previously selected criteria for volume and underwriting results. Ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies Incentive Compensation Monitor and assess incentive payment programs for personnel that are based on (1) revenue; (2) revenue and pre-tax income; (3) pre-tax income; or (4) commissions and incentives paid out as variable salary or as straight payouts. Ensure appropriate monthly accruals are recorded on a timely basis based on Company A revenue recognition policies Deferred Revenues Analysis Plan and analyze activity deposits and cash Company A receives prior to the completion of the sale service process and monitor proper income recognition/expense referral as appropriate Bad Debt Allowance Reserves Monitor and assess required reserves for Company A receivables Work in Progress Reserves Monitor and assess reserves for Company A unbilled consulting services Quality Assurance Through variance analysis, discussions, and review of Business and financial systems data evaluate reasonableness of results and identify unexpected or unusual items Fiduciary Payables Account and process distributions for premiums received from clients and owed to insurance carriers or Client- & Non-Client-Centric suppliers Client- & Non-Client-Centric Operational Accounting Operational Accounting Fiduciary Receivables Account for and process receipts of premiums due from clients that Company A must then remit to insurance carriers or suppliers and account for and process payments of service fee revenue owed to Company A Client Setup Establish contact, billing, credit, and tax information about clients new to Company A on appropriate systems and process changes when appropriate Client External Reporting Develop external reports for clients (e.g., Business Unit 1 maintains data to develop client’s Schedule F). This function resides in Client-Centric Operational Accounting only Premiums & Claims Receivable Monitor and track on accounts owed to Company A by clients for premium income or claims Premiums & Claims Collections Monitor, track, and report on past due accounts by following up with appropriate business areas on accounts owed to Company A by clients for premiums or claims. Ensure business areas are following Company A expense recognition policies Ramesh Krish Proprietary and Confidential P35
  • 37.
    Accounting Functions –Activities & Definitions Function/ Activity Definition Billing Prepare and mail invoices to clients and underwriters Client Service Time & Expense Accounting Monitor work in progress to ensure timely client billings are being sent. This function resides in Non-Client- Centric Operational Accounting only Client- & Non-Client-Centric Client- & Non-Client-Centric Operational Accounting Revenue Accruals Accounting Calculate accruals for sales of products or services and record entries in the general ledger on a timely basis Operational Accounting based on Company A revenue recognition policies Commission Calculations Calculate commissions due from carriers Trade Intercompany Transactions Transactions that occur within Company A’s books and involve an outside client. These transactions involve one business area providing a service to another area that ultimately provides that service to the client or a transfer of service within one business area that is then provided to the client Journal Voucher Processing Manual entries in general ledger to adjust/supplement automated entries made at the business area/regional level Business Systems & GL Feeds Technical support for maintenance of the feeds to the general ledger system and balancing of interfaces General Ledger Processing Automated execution of journal entries into the general ledger either at the corporate or business area and regional level Journal Voucher Processing Manual entries in general ledger to adjust/supplement automated processing entries made at the corporate, regional, or business area level Shared Facilities & Expense Accounting Develop appropriate allocation and transfer pricing methods for the spreading of centrally shared costs that arise from activities spanning multiple business area (e.g., stock awards, rent, bank charges, check processing). Ensure transfer pricing is set on a fair and consistent basis with benchmarking to outside resources General Ledger Maintenance Maintain corporate chart of accounts, add new accounts, and modify existing accounts at the corporate or Financial Accounting Financial Accounting regional level Consolidations Accounting Complete final roll up of corporate financial statements into the parent company at the Corporate Level or into business area or regions on a regional level. Monitor period-end process to ensure all business areas are complying with corporate policy and procedures Tax Documentation Implement policies and procedures designed by corporate to process accounting entries that comply with tax preparation, planning and documentation retention policies to the greatest extent possible to eliminate duplicate efforts Non-Trade Intercompany Eliminations Transactions that occur entirely within Company A’s books; transactions in which one business area is providing a function, product, or service to another area or there is a transfer of service within one business area. Eliminations are the entries that back out these transactions. Litigation Accounting Account for the potential losses and gains associated with lawsuits filed against and on behalf of the organization Mergers & Acquisitions Accounting Prepare and process transactions that arise out of acquisitions of other organizations by Company A at parent or subsidiary level and coordinate and obtain concurrence on valuation work Ramesh Krish Proprietary and Confidential P36
  • 38.
    Accounting Functions –Activities & Definitions Function/ Activity Definition Account Reconciliations Prepare reconciliations of general ledger accounts to balances reported on supporting documents and track out of balances, suspense, and unreasonable items Non-Trade Accounts Receivable & Monitor accounts owed to the company from outside parties that is not related to insurance premiums, normal Collections consulting services, or claims and follow up with business areas and report on overdue receivables Capital Expenditures Account for new projects that require investment of capital and will be capitalized on the company’s balance sheet Non-Capitalized Projects Account for new projects that will not be capitalized on the company’s balance sheet Financial Accounting Fixed Assets Accounting Account for property, plant, and equipment. Process includes depreciation, asset revaluation, and disposal and Financial Accounting scrapping calculations Corporate Financial Systems Coordination of interfaces and feeds from treasury systems, NAFP, financial operating areas and other systems as appropriate to ensure integrity of Region A database and corporate consolidation database Payroll – Human Resources & Benefits Prepare and process transactions for payroll and benefits for employees and contractors (Shared Services) Investment Accounting (Shared Services) Account for investment holdings (derivatives, buy, sell, investment income, and accruals) and record entries for insurance company, global, and Country A region investments. Improve coordination with the Treasury system and expand investment accounting to other regions as Treasury system expands Vendors Payable (Shared Services) Accounts Company A owes to third parties for the provision of general services (i.e., phone service) Corporate NAFP Region A Financial Platform. System at transactional level in PeopleSoft for Vendors Payable, Accounts Receivable, General Ledger, and Fixed Assets External Reporting Prepare and deliver documents and reports, other than financial statements, Company A must file with parties outside the organization on a regular and ad-hoc basis Financial Statement Preparation Create and present full set of financial statements and management discussion and analyses for Shareholders, the SEC, and other regulators Financial & Regulatory Reporting Financial & Regulatory Reporting Financial Accounting Policies & Procedures Create guidelines at the corporate or business area level that govern the application of financial accounting policies and procedures and the documentation personnel must maintain when recording transactions Standards & Reporting Package Define reporting formats and other requirements for the submission of reports to corporate level from all regional areas Sarbanes-Oxley Compliance Develop corporate policies and procedures for compliance with Sarbanes-Oxley and monitor and assess business area’s compliance with the policies. Update the policies and procedures when and where appropriate Specific Business Area Audits & Regulatory Audited financial statements submitted to some Country A states by certain business areas to comply with Reporting state laws and regulations Ramesh Krish Proprietary and Confidential P37
  • 39.
    8 Risk Assessment RameshKrish Proprietary and Confidential P38
  • 40.
    Appendix - WayForward Risk Assessment Output – Illustrative Example Key INCREASE IN SHAREHOLDER VALUE Objectives not met Objectives fully met Client's LONG TERM STRATEGIC OBJECTIVES STOP FIX OUTSOURCE Decentralization of processes Effective streamlined Costs are tied to SLA and functions will result in implementation will deliver agreements with external service COST duplication of functions and headcount and service benefits provider against predefined levels therefore headcount of service SERVICE Decentralization will permit Internal SLA agreements can be Service levels are tied to SLA’s, dedicated local teams but restrict used to maximise the level of which penalise poor quality QUALITY common systems and their service to both internal and delivery related process benefits external customers Common systems will permit Common systems and processes Common systems and processes VISIBILTY centralised visibility but restrict across SBUs will maximize across SBUs will maximize common operating procedures financial and service level financial and service level visibility visibility Integration of new country entities A centralized approach will High level of flexibility possible AGILITY will be lengthened while local maximise the efficiency of tied to the negotiated structure of support is built subsequent acquisitions the SLA A decentralized approach will A centralized approach will A large amount of control is CONTROL limit the level of control maximize the level of control ceded to the service provider but possible at SBU level can be limited by the structure of the negotiated SLA NON-VIABLE VIABLE VIABLE Ramesh Krish Proprietary and Confidential P39
  • 41.
    Implementation Risks &Mitigation Plans Implementation of any significant operational change exposes the organization to risk. These risks have been identified and addressed through mitigating strategies. Implementation Risk Mitigation Plans “You Don’t Understand My Business” • Unique business needs are not fully understood by • The project organization has been designed to leverage the future internal customers design team leading to degradation of service levels of the shared services organization in its design and implementation in future organization. Insufficient Support by Finance Organization • A clear and compelling rationale for change must be communicated and reinforced • Finance personnel fail to embrace the vision, by senior management preferring to “stick to what has always worked”. • The project organization has been designed to leverage the future internal customers of the shared services organization in its design and implementation Business System Complexities • The service centers will be designed considering business system access • Shared services employees will need access to • Business areas will need to migrate to a limited number of business system instances multiple versions of key business systems, • New products will be placed onto existing business platforms potentially adding complexity. Concurrent PeopleSoft Upgrade • Clean-up activities associated with the upgrade would improve standardization and • An upgrade to PeopleSoft vX.X in the Country A is could facilitate centralization; however, its implementation would likely follow this being considered. This upgrade could result in a “re- initiative implementation” of PeopleSoft in the region. • Upgrade would enhance consistency and possibly allow for broader regionalization Transformation Hangover • Steering Committee members must assume active, visible leadership roles • Corporate and business areas may be weary and/or • Comprehensive detailed design and realistic, practical implementation plans must be skeptical of transformative initiatives based on developed and actively supported by senior management results of recent unsuccessful, strategic projects. Standard Functional Job Design • Business area financial support must remain decentralized even if it results in over- • Low-scale, decentralized accounting operations staffing in the near term likely have integrated position descriptions that may • Clear, standard definitions of accounting positions will help bring clarity to be difficult to segregate. integrated roles and headcount Service Quality Degradation • Existing business area service levels will be documented during the design phase • Business areas perceive loss of control and/or and will serve as benchmarks for tracking performance and/or implementing service level degradation. Service Level Agreements (SLAs) with internal customers Ramesh Krish Proprietary and Confidential P40
  • 42.
    9 Organizational Design & Governance Ramesh Krish Proprietary and Confidential P41
  • 43.
    Future Vision –Organization Design This represents a design option that consolidates the regional accounting shared services organization under the Enterprise Controller. Certain functions remain in existing areas consistent with design principles. Finance Controller Finance Controller ILLUSTRATIVE Management Management Business Area Corporate Financial Corporate Financial Financial & Financial & Global Financial Global Financial Accounting Shared Accounting Shared Insurance Company Insurance Company Business Area Management Planning & Analysis Planning & Analysis Regulatory Reporting Regulatory Reporting Accounting Accounting Services Management Services Management Operations Accounting Operations Accounting Management Locations: Locations: Locations: Locations: • Utilize Payroll, • Anytown, Country A • Anytown, Country A • Anytown, Country A • Anytown, Country Vendor Payables, and Functions: Functions: Functions: A Investment Business Area Business Area Accounting Shared • Internal Performance • External Reporting • General Ledger & Functions: Services Centers Financial Planning Financial Planning Reporting Cost Accounting • Standards • Financial Statement & Analysis & Analysis • Analysis & Preparation • Special Events Development • Utilize Corporate Locations: Forecasting Accounting • Accounting & NAFP • Financial Accounting • As Appropriate • Quality Assurance Governance • Account Control Policies Functions: Reconciliations • Financial Systems • Internal Performance • Cap-Ex Accounting Reporting • Corporate Financial • Analysis & Systems Forecasting • Shared Services Regional Financial Non-Client Operational Client Operational Regional Financial Non-Client Operational Client Operational Centers (Investment • Billing & Collection Accounting) Accounting Accounting Accounting Accounting Accounting Accounting Assistance, as required Locations: Locations: Locations: • Overrides from • Anytown, Country A • Anytown, Country A • BU 1 – Anytown, Carriers/ Suppliers • Anywhere, Country A • Anywhere, Country A Country A • BU 2 – Anywhere, • Contingent Functions: Functions: Country A Commissions from • General Ledger & • Fiduciary Accounting Carriers Cost Accounting • BU 3 – Anycity, Country • Client Receivables A • Limited Revenue & • Special Events • Revenue Only • BU 4 – Anyvillage, Accrual Analysis Accounting Accruals & Country A • Quality Assurance • Account Commissions Reconciliations Functions: • General Ledger • Cap-Ex Accounting • Fiduciary Accounting • Shared Services • Client External Centers (Vendors Reporting Payable & Payroll) • Client Receivables • Revenue Only Accruals & Commissions Ramesh Krish • General Ledger Proprietary and Confidential P42
  • 44.
    Best in ClassPractices - A/P Operations Sample of recommendations Sample of key success factors for optimizing A/P operations when implementing a Shared Service Center Conduct Education & Training: An executive sponsorship should stress the importance Encourage consistent and appropriate use of the buying process by and value of moving towards an SSC. educating internal clients on the “How to Buy” policy. Involve the entire set of stakeholders in the project. Decrease exceptions in the ERS process by educating vendors to Do not underestimate the amounts of time, resources stop sending invoices and verify they will be able to apply payment and energy needed to change corporate operations and based on the new information on the check stub. culture. Improve awareness of all SAP functionality by training A/P Assemble cross-functional project teams with members department (e.g., automatic invoice reduction capability). chosen for their skill and experience. Ensure complete “buy-in” process understanding through cross- Consider the language skills of the SSC personnel to training of A/P and Purchasing personnel. provide an optimal service to internal or external Enforce Appropriate Accountability: customers. Encourage Purchasing to enter accurate and necessary data by Evaluate/Select candidates for new functions based increasing their understanding of the impact on A/P’s processes. upon specific competency profiles. Improve vendor invoice quality by returning incomplete invoices. Cross-training and shared capabilities facilitates Designate process champions to enforce appropriate accountability replacement during holidays/illness and allows job People where users are left to make their own process decision. rotation that may improve employee morale and productivity. Improve invoice approver accountability by implementing the deadline monitoring feature in workflow, which notifies individuals when an Identify the process owners that will have to deal with invoice is not approved in a timely manner. all the process-related accountabilities. Identify a key contact person for each client group. Build Effective Organisation: Manage clearly expectations of internal stakeholders Improve communication with Purchasing to foster an understanding and customers as a service “degradation” may be of the interrelated nature of the groups and encourage quick inquiry expected during the kick-off period of the “go-live”. response time. Using performance measure, create incentives and Enforce consistency and process analysis by creating and enforcing rewards to motivate people and continuously improve guiding policies and procedures. their efforts. Align the A/P support group with the Purchasing support group. Define governance agreements, coordination standards and establish a communication culture. Ramesh Krish Proprietary and Confidential P43
  • 45.
    Best in ClassPractices - A/P Operations Sample of recommendations Sample of key success factors for optimizing A/P operations when implementing a Shared Service Center Increase Simplification: Measure the potential benefits of an Partner with vendors to consolidate remit-to addresses, where implementation and even compare them with appropriate. some alternatives. Eliminate steps in the non-PO process and x% of A/P Use a business case to identify costs & benefits exceptions by enabling the client to enter the invoice in SAP, but also as communication tool to convince the route it for approval and post it. people involved of the necessity of the SSC (buy- Reduce manual processing by defining a clear and efficient in). process for handling freight. Focus on removing transactions before making Increase Process Effectiveness: them more efficient. Provide input to Purchasing on the ERS process, simplification Harmonize first the policies, then move to one of remit-to vendor selection and establishing a “How to Buy” common process. policy. Set clear measures for customer satisfaction and Reduce cycle time by enabling A/P processors to change the communicate to the entire customer organisation. Set performance measures to evaluate the value, Process vendor at invoice time. level of service and cost of services provided i.e. Minimize costly payments by eliminating manual checks and decreasing number of wire transfers. using the balanced scorecard approach. Reduce indexing time and improve look-up capability by linking Gain upfront consensus on Service Level the imaging system to SAP. Agreements (SLAs) which formalize commitments between the SSC and the customer/BUs and Eliminate inter-office mailing of payments and reduce cycle provide an ongoing forum for communicating time by printing A/P checks at the same physical location as expectations. the A/P department. Develop a pricing policy and establish direct and Analyze entry of invoices via ESS (Employee Self Service) by indirect cost allocations through time reporting end-users. and internal audit controls to ensure the validity of Analyze entry of invoices and look-up capability via Vendor the SSC charges and performance. Self Service (e-Procurement system or Internet front-end) by Compare the performance of the SSC to a true vendors. external market (i.e. outsourcing) and/or to benchmarks. Ramesh Krish Proprietary and Confidential P44
  • 46.
    Best in ClassPractices - A/P Operations Sample of recommendations Sample of key success factors for optimizing A/P operations when implementing a Shared Service Center Increase Flexibility: Systems play an important role in achieving a Reduce check processing by increasing the use of electronic successful and sustainable SSC implementation. payments. Ensure that shared services design is flexible and Decrease the number of invoices by increasing the use of ERS scalable to support future acquisitions and once the vendors establish they will be able to apply payment divestitures easily. with a bill of lading number. Utilize technologies based on business needs. Minimize manual handling through implementation of workflow Use technologies that can be leveraged and to route documents electronically for further processing. supported throughout the organisation. Limit manual processing by increasing the use of P-Cards and Rationalize first the different systems/used forcing users to charge their default account assignment. functionalities, then move to one system/to a Decrease processing time by using the Invoice Verification common use of optimal functionalities. transaction for processing PO invoices and / or upgrading to Incorporate self-service as a critical component in last SAP release. a shared services environment. Technology Partner with banks to create a plan to enable processing of EDI payments larger than € x million. Develop a migration plan that eases the transition from the “as-is” to the “to-be” environment. Partner with vendors to increase the use of ERS and EDI, both Address security for facilities, data and for inbound invoices and outbound payments, in order to applications both from an internal and external reduce manual invoices. perspective. Evaluate maturity and cost / benefit (if appropriate) of emerging Maintain adequate backup facilities and disaster technologies for A/P data input and validation. recovery plans. Analyze and implement new P-Card program to enable Make a motivated choice between a greenfield automated account distribution at the line item level. (new) and a brownfield (extended existing) location for the SSC. Ramesh Krish Proprietary and Confidential P45
  • 47.
    Outsourcing and ContractManagement Phases Phase 1 Phase 2 Phase 3 Phase 4 Phase 5 Phase 6 Identification of Business Case Evaluation and Implementation and Contract Contract Migration Outsourcing Selection Transition Management Opportunities 1.1 Document / Confirm 2.1 Identify Service 3.1 Develop Evaluation 4.1 Develop 5.1 Liaise with User 6.1 Evaluate Options Strategic Direction Providers Mechanism Implementation Groups 6.2 Retain Existing 1.2 Identify Candidate 2.2 Examine 3.2 Issue Request for Plan 5.2 Manage Service Service Provider Services Outsourcing Viability Tender 4.2 Negotiate Contract Levels 6.3 Select 1.3 Document Service 2.3 Consider 3.3 Conduct Service Profile Reorganization Provider 4.3 Prepare for 5.3 Monitor Replacement Options Evaluations Handover Performance Service Provider 1.4 Prepare Scoping Report 2.4 Develop Business 3.4 Select Preferred 4.4 Transition to 5.4 Administer Contract 6.4 Migrate to In- Case Service Provider(s) service provider House Services Objectives Objectives Objectives Objectives Objectives Objectives Objectives Objectives Objectives Objectives Objectives Objectives Identification of those Identification of those Comparison of internal Comparison of internal Evaluation of Evaluation of Finalization of the Finalization of the Proper management of Proper management of Effective planning and Effective planning and areas to be considered areas to be considered operations with operations with alternative service alternative service outsourcing contract so outsourcing contract so the day-to-day the day-to-day management through management through for outsourcing and to for outsourcing and to external options both external options both providers and the providers and the as to ensure aasmooth as to ensure smooth outsourcing outsourcing the conclusion of the the conclusion of the document the current document the current from aacost and service from cost and service selection of aapreferred selection of preferred transition to the transition to the arrangements to ensure arrangements to ensure outsourcing contract outsourcing contract and required services and required services perspective to perspective to service provider(s) in service provider(s) in outsourcing outsourcing that they operate as that they operate as and the implementation and the implementation provision. provision. determine whether to determine whether to accordance with the accordance with the arrangements. arrangements. planned and meet planned and meet of arrangements for of arrangements for proceed forward proceed forward acquisition strategy. acquisition strategy. required standards. required standards. future service delivery. future service delivery. Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Key Questions Are there services that Are there services that Are there potential Are there potential Will the evaluation Will the evaluation Do the implementation Do the implementation Are the service Are the service Has the current service Has the current service could be outsourced? could be outsourced? service providers who process withstand the plans contain realistic requirements of provider delivered service providers who process withstand the plans contain realistic requirements of provider delivered Is outsourcing relevant could deliver the required could deliver the required test of probity? test of probity? dates which permit an dates which permit an business units being business units being satisfactory services? satisfactory services? Is outsourcing relevant services? orderly transition? met? in the context of the in the context of the services? Which service provider orderly transition? met? Should consideration Department or Agency’s Which service provider Should consideration Department or Agency’s Are there reorganization is preferred? Does the contract Have the service be given to alternative operations? operations? Are there reorganization is preferred? Does the contract Have the service be given to alternative possibilities that offer possibilities that offer properly define the properly define the requirements requirements service providers? service providers? Should the option of viable options to Does the scope of the Does the scope of the service requirements? changed? Should the option of viable options to services to be service requirements? changed? Has the provision of outsourcing be outsourcing be outsourcing? services to be Has the provision of considered further? outsourcing? outsourced meet the Are the Government’s Is the service provider services been fully considered further? outsourced meet the Are the Government’s Is the service provider services been fully Does aabusiness case Does business case real requirements? real requirements? interests protected by interests protected by providing the services providing the services migrated from the migrated from the Have the staffing issues Have the staffing issues exist to proceed with the contract? in aasatisfactory previous contractual been considered? exist to proceed with Are the Tender Report the contract? in satisfactory previous contractual been considered? outsourcing? Are the Tender Report manner? arrangements to aanew outsourcing? recommendations Has the provision of manner? arrangements to new Are there strategic Are there strategic recommendations Has the provision of or revised set of or revised set of opportunities from the Has an acquisition Has an acquisition acceptable? acceptable? services been fully services been fully Are all outsourcing Are all outsourcing arrangements? opportunities from the strategy been developed transferred to the issues being arrangements? adoption of outsourcing adoption of outsourcing strategy been developed transferred to the issues being for one or more for one or more and approved? and approved? service provider? service provider? addressed in aatimely addressed in timely processes? processes? and effective manner? and effective manner? Outsourcing Outsourcing Business case for Business case for Evaluation process Evaluation process Contract signing and Contract signing and Performance Performance Outsourcing options Outsourcing options candidate services candidate services outsourcing outsourcing findings and findings and service transition service transition monitoring and monitoring and assessment and assessment and identified identified documented documented recommendations recommendations review review change management change management implementation implementation Ramesh Krish Proprietary and Confidential P46
  • 48.
    i process Thank You Ramesh Krish Cell: 917-971-9701
