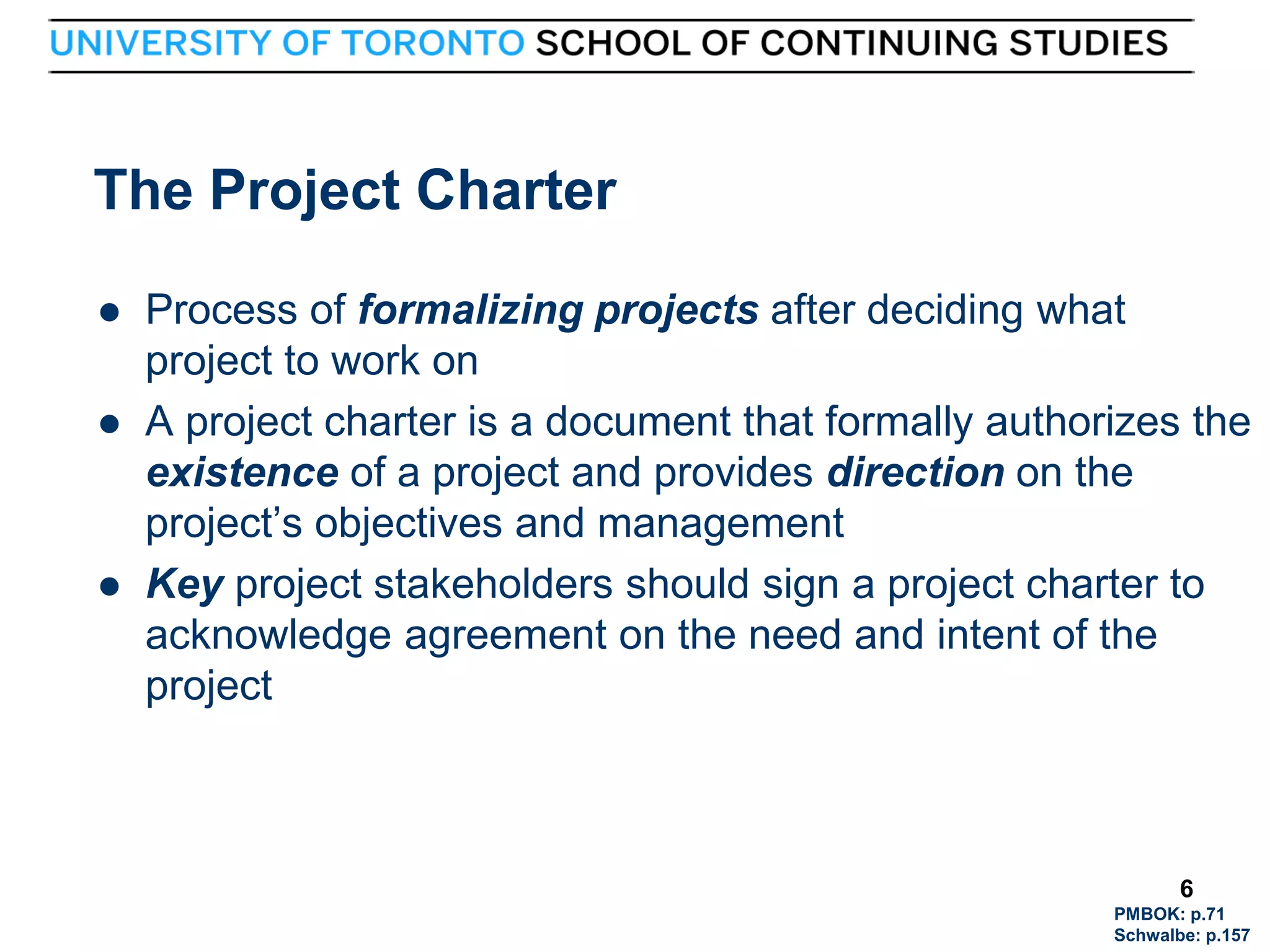

This document discusses developing a project charter, which formally authorizes a project and provides authority to the project manager. It covers the inputs, tools and techniques, and outputs of developing a charter. The key inputs include a business case, agreements, environmental factors, and organizational assets. Tools include expert judgment, data gathering techniques, and meeting skills. The main output is the project charter itself, which documents high-level project details and assigns a project manager. It also produces an assumption log. Developing the charter establishes partnership between organizations and gives the project manager authority over resources.
In persuit of perfection internal auditor the gate keepers of ethics in jamai...Patrick Thompson
I was recently asked to speak to the Institute of Internal Jamaica monthly chapter meetings on the topic Integrating Project Management Techniques for Internal Auditing. Given the leverage I had, I chose instead to speak on - In Pursuit of Perfection: Internal Auditors the Gatekeepers of Ethics in Jamaican Business.
Successful project managers know the value of engaging their stakeholders early to get everyone on the same page. Learn what to include in your project charters.
This document outlines the methodology for project appraisal. It discusses how appraisal involves carefully reviewing project data, assumptions, plans, costs, financing, organization, and viability. It also examines projects from technical, financial, economic, institutional, and social perspectives. The goal of appraisal is to determine if a project is sound and justified from both an individual and economy-wide viewpoint. It describes how different sections analyze technical, financial, economic, and social aspects of a project. Finally, it discusses techniques for appraisal such as discounted and undiscounted cash flows, as well as the importance of considering incremental costs and benefits compared to a base case without the project.
The document discusses software project management activities and methodologies. It describes the typical activities covered in project management, including feasibility studies, planning, execution, and the software development life cycle. The software development life cycle includes requirements analysis, architecture design, coding and testing, integration, qualification testing, installation, and acceptance support. The document also discusses plans, methods, and methodologies, categorizing different types of projects, and identifying stakeholders.
This document summarizes the key requirements under 24 CFR §92.250 (b)(2) for assessing applications for HOME Investment Partnerships Program funding. It outlines the "Big Four" criteria that must be addressed: (1) an assessment of current market demand; (2) the experience of the developer; (3) the financial capacity of the developer; and (4) firm written financial commitments for the project. It provides guidance on how to demonstrate each of these criteria, including through statistical data, financial statements and ratios, and fully executed commitment letters. Addressing these four areas is necessary to confirm a project's viability and ensure compliance with HUD regulations.
Project and process engineering management industrial engineering managementLuis Cabrera
Project and process engineering management focuses on managing engineering projects and processes. It uses standard project management methodologies to oversee tasks like scheduling, purchasing, documentation approval, and budget/cost management. An example project discussed is implementing an ERP system called Maximo to manage maintenance and calibration activities across multiple manufacturing sites. Key aspects of the proposed Maximo implementation include transitioning to electronic record keeping, enabling statistical analysis, and ensuring consistency. Resources, costs, timelines, and success metrics are outlined for the implementation. Risks are also assessed and mitigation plans proposed.
This document discusses developing a project charter, which formally authorizes a project and provides authority to the project manager. It covers the inputs, tools and techniques, and outputs of developing a charter. The key inputs include a business case, agreements, environmental factors, and organizational assets. Tools include expert judgment, data gathering techniques, and meeting skills. The main output is the project charter itself, which documents high-level project details and assigns a project manager. It also produces an assumption log. Developing the charter establishes partnership between organizations and gives the project manager authority over resources.
In persuit of perfection internal auditor the gate keepers of ethics in jamai...Patrick Thompson
I was recently asked to speak to the Institute of Internal Jamaica monthly chapter meetings on the topic Integrating Project Management Techniques for Internal Auditing. Given the leverage I had, I chose instead to speak on - In Pursuit of Perfection: Internal Auditors the Gatekeepers of Ethics in Jamaican Business.
Successful project managers know the value of engaging their stakeholders early to get everyone on the same page. Learn what to include in your project charters.
This document outlines the methodology for project appraisal. It discusses how appraisal involves carefully reviewing project data, assumptions, plans, costs, financing, organization, and viability. It also examines projects from technical, financial, economic, institutional, and social perspectives. The goal of appraisal is to determine if a project is sound and justified from both an individual and economy-wide viewpoint. It describes how different sections analyze technical, financial, economic, and social aspects of a project. Finally, it discusses techniques for appraisal such as discounted and undiscounted cash flows, as well as the importance of considering incremental costs and benefits compared to a base case without the project.
The document discusses the process for identifying and selecting projects for black belts. It provides criteria for project selection such as the problem being related to key business issues and having organizational support. It also describes documenting potential projects with a project charter that includes details like the customer and process owner. Project ideas are evaluated based on their estimated financial impact and strategic importance to prioritize resources.
Project Identification and Initiation Tool Kit Dave Angelow
The Project Initiation Document outlines the initiation of a project to standardize the product roadmapping process across business functions. It defines the current problem as inconsistent roadmapping that inhibits growth. The ideal state is described as a corporate-wide standard process supported by IT tools to deliver faster output. Key sections include defining the problem statement and impact, solution objective to standardize the process and select tools, scope, and high-level timeline.
This document contains multiple choice questions from 5 units on project management. It covers topics like project classification, project appraisal, social cost-benefit analysis, components of a project report, sources of finance for small businesses, and the roles of institutions like SIDBI, LIC, and UTI in providing financial support.
This document discusses project identification and formulation. It outlines the five stages of a project cycle: identification, formulation, appraisal, implementation, and monitoring and evaluation. Identification involves finding potential project ideas from various sources. Formulation includes conducting a feasibility study and market, technical, financial, and economic analyses. Appraisal involves an independent analysis of all project aspects. Implementation has pre-development, development, and operational phases. Monitoring and evaluation track project performance and identify lessons learned. The document also discusses generating project ideas, selecting opportunities, assessing viability through feasibility studies, and obtaining project financing through various capital sources.
The document discusses the Gujarat International Finance Tec (GIFT) City project in India. Key points:
- GIFT City was envisioned as a world-class financial hub to rival other global cities, but it is facing significant delays due to a lack of proper planning and clearances.
- Several buildings are left incomplete due to issues obtaining permission for heights from the Airport Authority. Additional delays stem from the lack of underground power line clearance.
- The project has not attracted any clients due to an absence of regulatory guidelines, jeopardizing the viability of establishing financial services there.
- Poor coordination between planning and implementation has put the 78,000 crore project at risk of becoming a "
Project management involves planning, organizing, securing, and managing resources to achieve specific goals within defined time and budget constraints. A project has a temporary nature with a clear start and end, and is undertaken to create beneficial change or added value. Key aspects of project management include identifying and formulating project ideas, appraising feasibility, selecting projects, implementing selected projects, and ongoing management. The life cycle of a project progresses through these phases.
Development project appraisal and sd(L6)1Farha Sharmin
The document discusses project appraisal for sustainable development. It defines a project and outlines the project cycle, which includes identification, preparation, approval, appraisal, implementation, monitoring, and evaluation. It describes the objectives, scope, and methods of project appraisal, including financial, economic, technical, social, and environmental analyses. The key goals of appraisal are to ensure resources are used effectively and the project benefits outweigh the costs.
concept of project
,
process vs project
,
general project characteristics
,
elements of projects
,
why are projects important
,
project phases
,
internal stakeholders
,
concept of project management
,
project management process
This document discusses project identification and selection as the first steps in setting up an enterprise. It defines a project as a work plan to achieve a specific objective within a time period. Projects are classified by quantifiability, sector, and techno-economic characteristics. The two main steps of project selection are project identification and project selection. Project identification involves generating ideas from internal and external sources. Project selection analyzes each idea's strengths, weaknesses, opportunities, threats and selects the most promising project to convert into an enterprise.
Project identification and Project selectionAmandaBvera
This presentation covers the topic of project identification and project selection. It sheds light on the meaning of the project, meaning of project identification, classification of projects, types of opportunities, dimensions of project identification, criteria for project selection and constraints involved in project selection. Enjoy learning!
This document is a template for JISC funded project plans. It provides guidance on completing sections on project overview, resources, and detailed planning. The overview includes objectives, outputs, approach, impact, stakeholders, and risks. Resources include partners, management, roles, and support needs. Detailed planning covers evaluation, quality assurance, communication, exit strategies, and sustainability.
This document provides an overview and instructions for creating and configuring applications using the FPM (Framework for Programming Models) in SAP. It covers basic topics like creating simple applications and configuring toolbars and headers, as well as more advanced topics like using variants, subroadmaps, application parameters, dynamic adjustments, and composite UIBBs. The document is intended to serve as a cookbook for both new and experienced FPM developers. It provides code examples and explains key classes, interfaces, and events involved in FPM application development.
This document discusses the strategic plan of Faruki Pulp Mills. It analyzes the company's strengths, weaknesses, opportunities, and threats through a SWOT analysis. It also evaluates the political, economic, social, and technological factors in the industry through a PEST analysis. The document outlines Faruki's mission, objectives, marketing strategies, and sales growth strategies. It proposes evaluating strategies based on greatest yield and developing contingency plans with alternative businesses to mitigate risks.
The document discusses developing targeted digital marketing personas, channels, and content. It covers defining personas, understanding buyer journeys and lead qualification, and developing relevant B2B content. Examples are provided of different types of content that can be created and distributed across various channels to engage identified personas at different stages of the buyer journey.

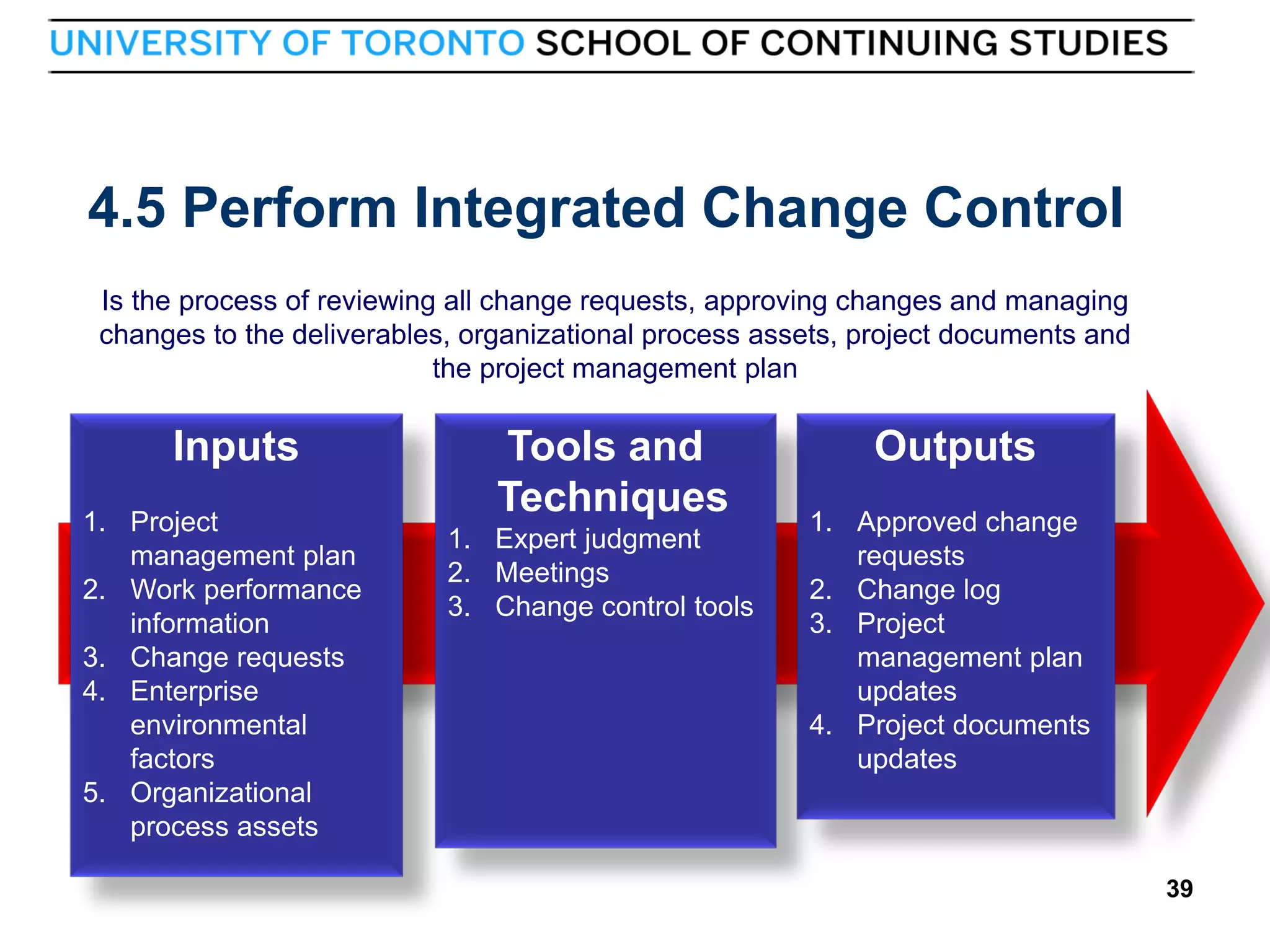

El documento describe el proceso de control integrado de cambios, el cual consiste en revisar solicitudes de cambio, aprobarlas, y gestionar los cambios aprobados. Se definen dos tipos de cambios: cambios al plan de proyecto o alcance, y correcciones de errores. El proceso involucra un comité de control de cambios que aprueba o rechaza solicitudes, y pasos como evaluar el impacto y actualizar la documentación.
Amendments to the LRA and the BCEA: Werksmans Labour & EmploymentWerksmans Attorneys
The draft Labour Relations Amendment Bill aims to protect vulnerable employees, regulate subcontracting and outsourcing, and extend the jurisdiction of the Labour Court. It proposes changes to organizational rights, the right to strike, lockouts, picketing rules, essential services, dispute resolution processes, and the review of arbitration awards. It also introduces regulations for temporary employment services and high-income dismissals.
Robot Framework is a generic test automation framework for keyword-driven testing. It is implemented with Python and runs on Jython and IronPython as well. It supports test data driven development and has built-in support for reporting, logging, libraries, and integration with tools like Jenkins. The framework is open source and has an active community around it.
10 Things To Do Before Emailing Your Sales Deck To A Potential ClientDeck Rooster
It's quite disheartening to see how so many sales people and entrepreneurs continue to send across their sales pitch deck over email when a potential clients says "Please email me that presentation" - without realising how doing so could affect the progress of the deal.
A presentation to be emailed has to be a version, but a very different presentation from the sales pitch deck.
Check out this presentation to understand why doing so is important and also how to do so in 10 easy steps.
The document discusses the process for identifying and selecting projects for black belts. It provides criteria for project selection such as the problem being related to key business issues and having organizational support. It also describes documenting potential projects with a project charter that includes details like the customer and process owner. Project ideas are evaluated based on their estimated financial impact and strategic importance to prioritize resources.
Project Identification and Initiation Tool Kit Dave Angelow
The Project Initiation Document outlines the initiation of a project to standardize the product roadmapping process across business functions. It defines the current problem as inconsistent roadmapping that inhibits growth. The ideal state is described as a corporate-wide standard process supported by IT tools to deliver faster output. Key sections include defining the problem statement and impact, solution objective to standardize the process and select tools, scope, and high-level timeline.
This document contains multiple choice questions from 5 units on project management. It covers topics like project classification, project appraisal, social cost-benefit analysis, components of a project report, sources of finance for small businesses, and the roles of institutions like SIDBI, LIC, and UTI in providing financial support.
This document discusses project identification and formulation. It outlines the five stages of a project cycle: identification, formulation, appraisal, implementation, and monitoring and evaluation. Identification involves finding potential project ideas from various sources. Formulation includes conducting a feasibility study and market, technical, financial, and economic analyses. Appraisal involves an independent analysis of all project aspects. Implementation has pre-development, development, and operational phases. Monitoring and evaluation track project performance and identify lessons learned. The document also discusses generating project ideas, selecting opportunities, assessing viability through feasibility studies, and obtaining project financing through various capital sources.
The document discusses the Gujarat International Finance Tec (GIFT) City project in India. Key points:
- GIFT City was envisioned as a world-class financial hub to rival other global cities, but it is facing significant delays due to a lack of proper planning and clearances.
- Several buildings are left incomplete due to issues obtaining permission for heights from the Airport Authority. Additional delays stem from the lack of underground power line clearance.
- The project has not attracted any clients due to an absence of regulatory guidelines, jeopardizing the viability of establishing financial services there.
- Poor coordination between planning and implementation has put the 78,000 crore project at risk of becoming a "
Project management involves planning, organizing, securing, and managing resources to achieve specific goals within defined time and budget constraints. A project has a temporary nature with a clear start and end, and is undertaken to create beneficial change or added value. Key aspects of project management include identifying and formulating project ideas, appraising feasibility, selecting projects, implementing selected projects, and ongoing management. The life cycle of a project progresses through these phases.
Development project appraisal and sd(L6)1Farha Sharmin
The document discusses project appraisal for sustainable development. It defines a project and outlines the project cycle, which includes identification, preparation, approval, appraisal, implementation, monitoring, and evaluation. It describes the objectives, scope, and methods of project appraisal, including financial, economic, technical, social, and environmental analyses. The key goals of appraisal are to ensure resources are used effectively and the project benefits outweigh the costs.
concept of project
,
process vs project
,
general project characteristics
,
elements of projects
,
why are projects important
,
project phases
,
internal stakeholders
,
concept of project management
,
project management process
This document discusses project identification and selection as the first steps in setting up an enterprise. It defines a project as a work plan to achieve a specific objective within a time period. Projects are classified by quantifiability, sector, and techno-economic characteristics. The two main steps of project selection are project identification and project selection. Project identification involves generating ideas from internal and external sources. Project selection analyzes each idea's strengths, weaknesses, opportunities, threats and selects the most promising project to convert into an enterprise.
Project identification and Project selectionAmandaBvera
This presentation covers the topic of project identification and project selection. It sheds light on the meaning of the project, meaning of project identification, classification of projects, types of opportunities, dimensions of project identification, criteria for project selection and constraints involved in project selection. Enjoy learning!
This document is a template for JISC funded project plans. It provides guidance on completing sections on project overview, resources, and detailed planning. The overview includes objectives, outputs, approach, impact, stakeholders, and risks. Resources include partners, management, roles, and support needs. Detailed planning covers evaluation, quality assurance, communication, exit strategies, and sustainability.
This document provides an overview and instructions for creating and configuring applications using the FPM (Framework for Programming Models) in SAP. It covers basic topics like creating simple applications and configuring toolbars and headers, as well as more advanced topics like using variants, subroadmaps, application parameters, dynamic adjustments, and composite UIBBs. The document is intended to serve as a cookbook for both new and experienced FPM developers. It provides code examples and explains key classes, interfaces, and events involved in FPM application development.
This document discusses the strategic plan of Faruki Pulp Mills. It analyzes the company's strengths, weaknesses, opportunities, and threats through a SWOT analysis. It also evaluates the political, economic, social, and technological factors in the industry through a PEST analysis. The document outlines Faruki's mission, objectives, marketing strategies, and sales growth strategies. It proposes evaluating strategies based on greatest yield and developing contingency plans with alternative businesses to mitigate risks.
The document discusses developing targeted digital marketing personas, channels, and content. It covers defining personas, understanding buyer journeys and lead qualification, and developing relevant B2B content. Examples are provided of different types of content that can be created and distributed across various channels to engage identified personas at different stages of the buyer journey.
El documento describe el proceso de control integrado de cambios, el cual consiste en revisar solicitudes de cambio, aprobarlas, y gestionar los cambios aprobados. Se definen dos tipos de cambios: cambios al plan de proyecto o alcance, y correcciones de errores. El proceso involucra un comité de control de cambios que aprueba o rechaza solicitudes, y pasos como evaluar el impacto y actualizar la documentación.
Amendments to the LRA and the BCEA: Werksmans Labour & EmploymentWerksmans Attorneys
The draft Labour Relations Amendment Bill aims to protect vulnerable employees, regulate subcontracting and outsourcing, and extend the jurisdiction of the Labour Court. It proposes changes to organizational rights, the right to strike, lockouts, picketing rules, essential services, dispute resolution processes, and the review of arbitration awards. It also introduces regulations for temporary employment services and high-income dismissals.
Robot Framework is a generic test automation framework for keyword-driven testing. It is implemented with Python and runs on Jython and IronPython as well. It supports test data driven development and has built-in support for reporting, logging, libraries, and integration with tools like Jenkins. The framework is open source and has an active community around it.
10 Things To Do Before Emailing Your Sales Deck To A Potential ClientDeck Rooster
It's quite disheartening to see how so many sales people and entrepreneurs continue to send across their sales pitch deck over email when a potential clients says "Please email me that presentation" - without realising how doing so could affect the progress of the deal.
A presentation to be emailed has to be a version, but a very different presentation from the sales pitch deck.
Check out this presentation to understand why doing so is important and also how to do so in 10 easy steps.
Organization development (OD) aims to improve how organizations function and increase effectiveness through planned interventions using behavioral science knowledge. OD focuses on diagnosing issues, planning and implementing changes, and evaluating results through an iterative process of action research. Some common OD interventions include team building, intergroup relations training, organizational restructuring, and culture change programs.
PGBM01 - MBA Financial Management And Control (2015-16 Trm1 A)Lecture 9 lon...Aquamarine Emerald
This document provides an overview of long-term decision making processes and techniques. It discusses the characteristics of long-term investments, the typical decision making process including initial investigation, evaluation, authorization, implementation and monitoring. It then covers techniques for evaluating investments, including payback period, accounting rate of return, net present value and internal rate of return. An example calculation compares two potential investment projects using these techniques, and recommends selecting the project with the highest net present value or internal rate of return.

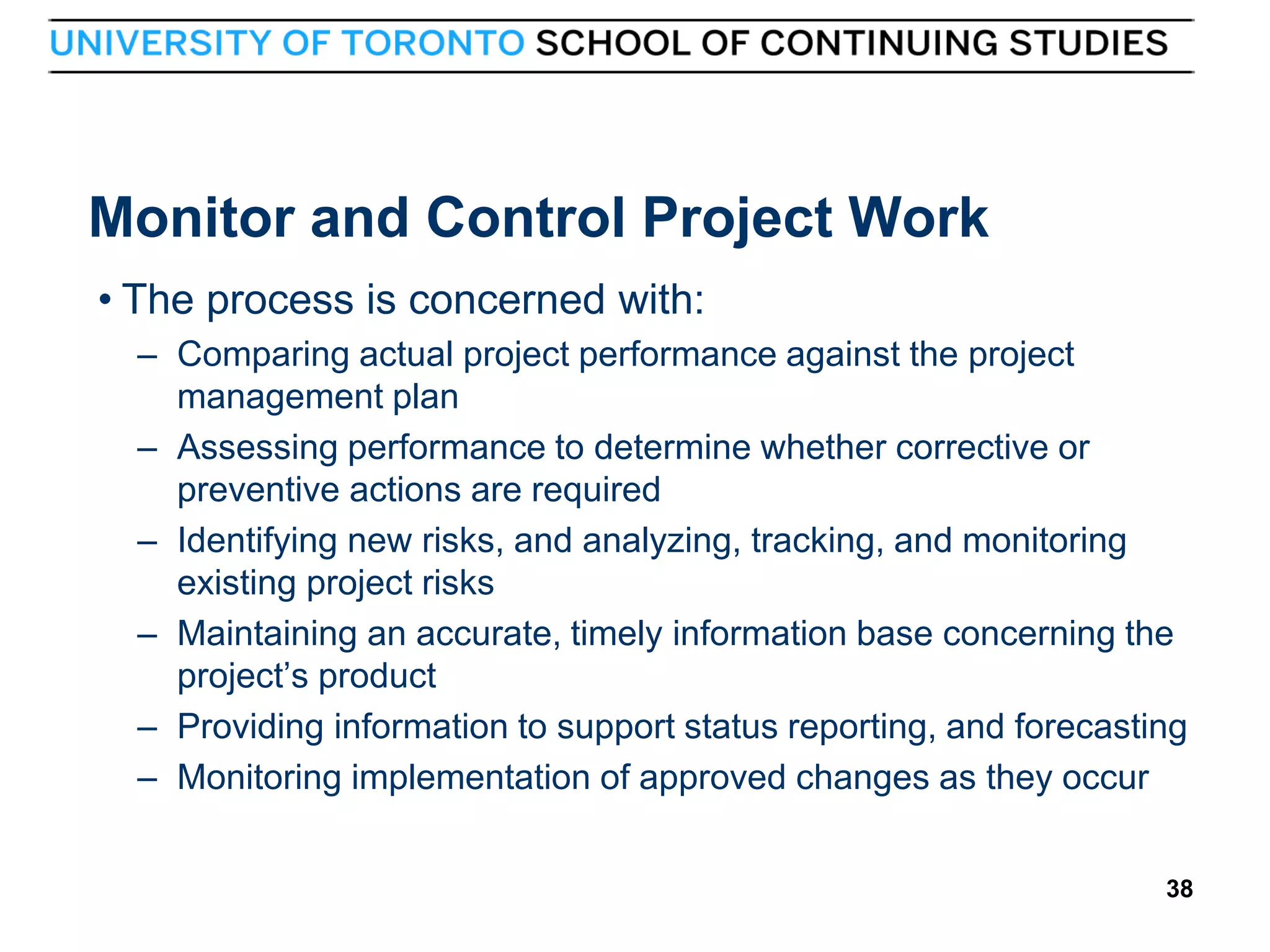

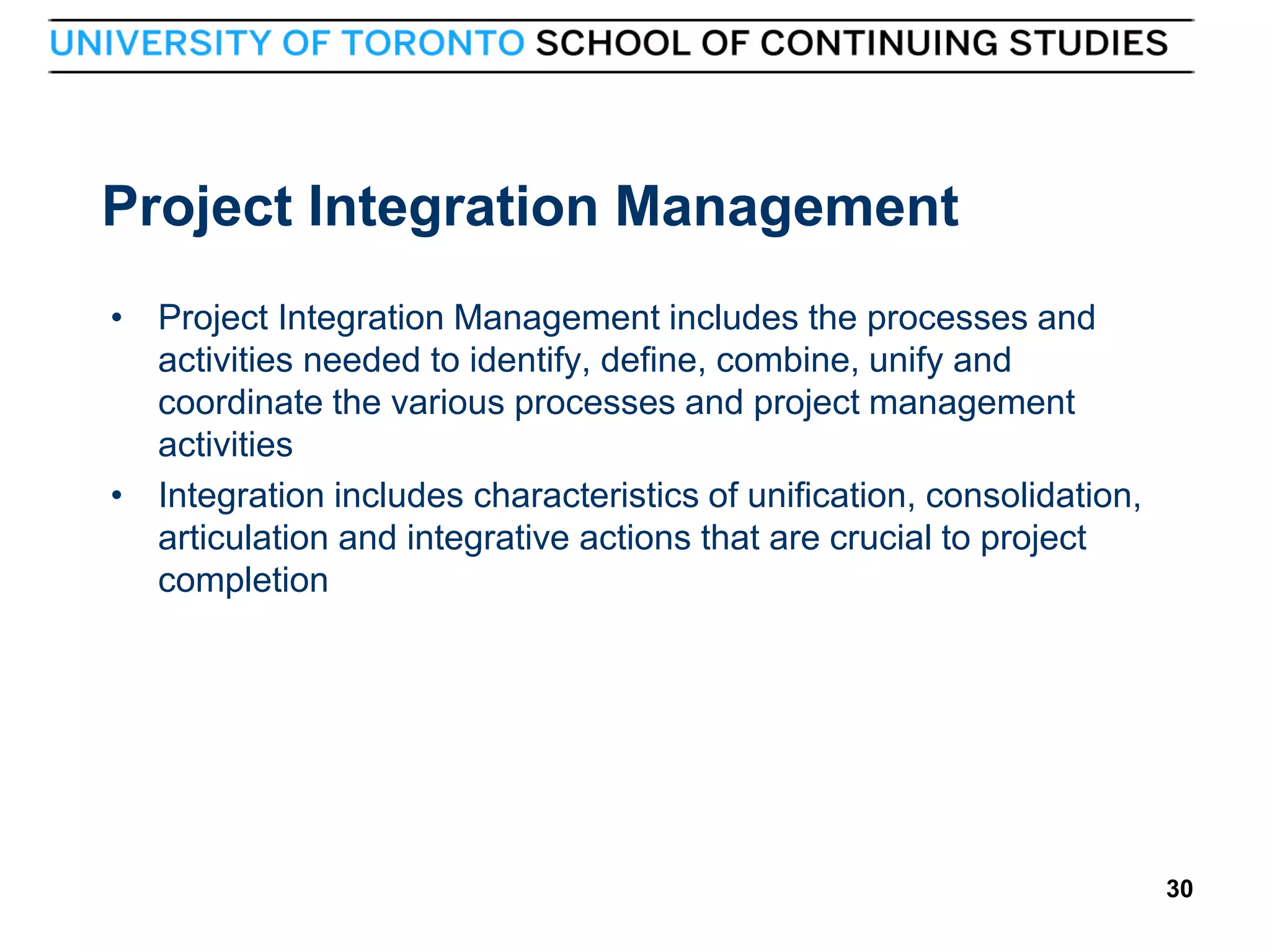

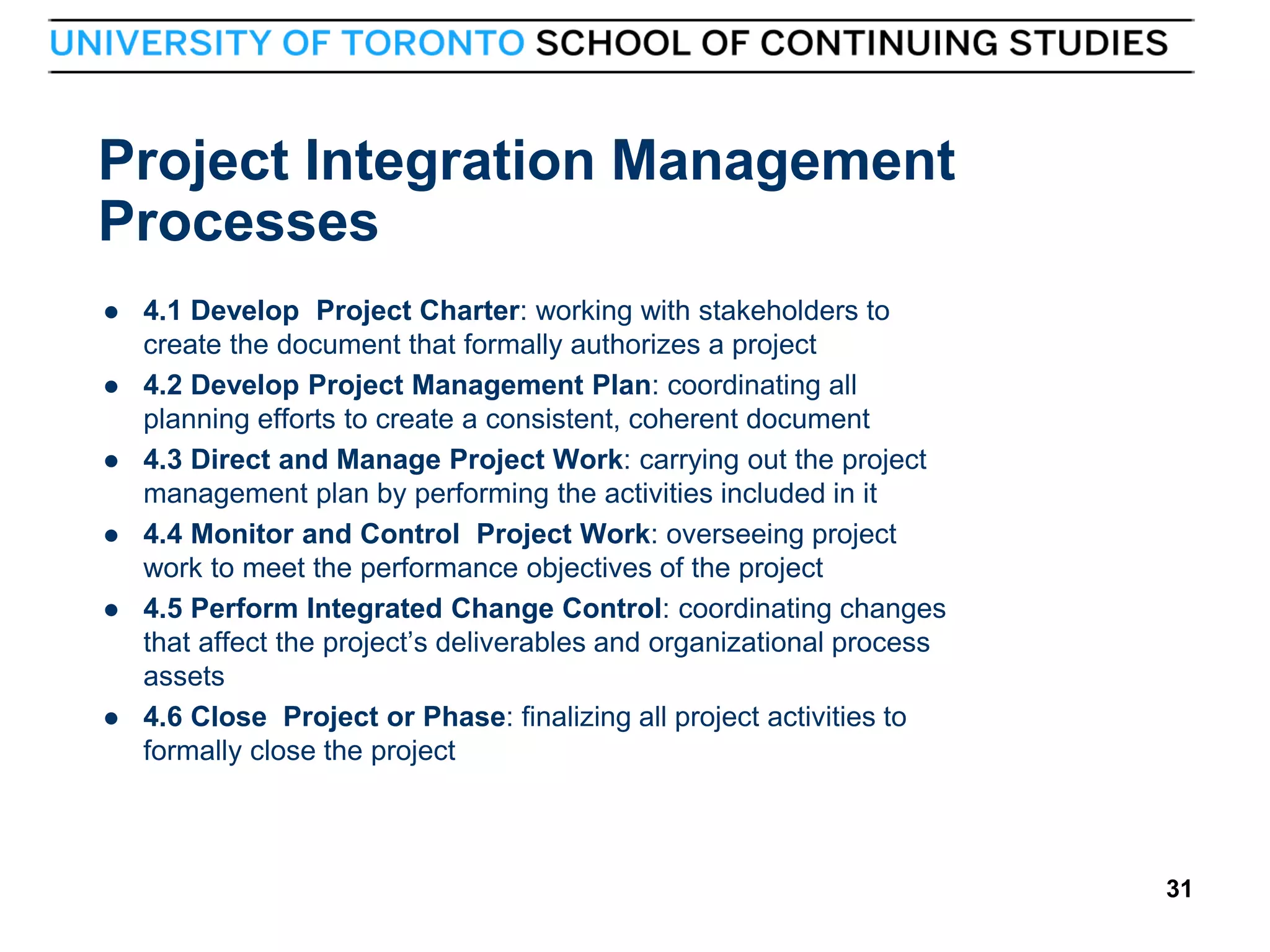

The document discusses key aspects of project integration management including:
1) The importance of project integration management and coordinating all project knowledge areas.
2) How the Airbus A380 project faced integration issues due to software version mismatches.
3) Key project integration processes like developing plans, directing execution, monitoring, and change control.

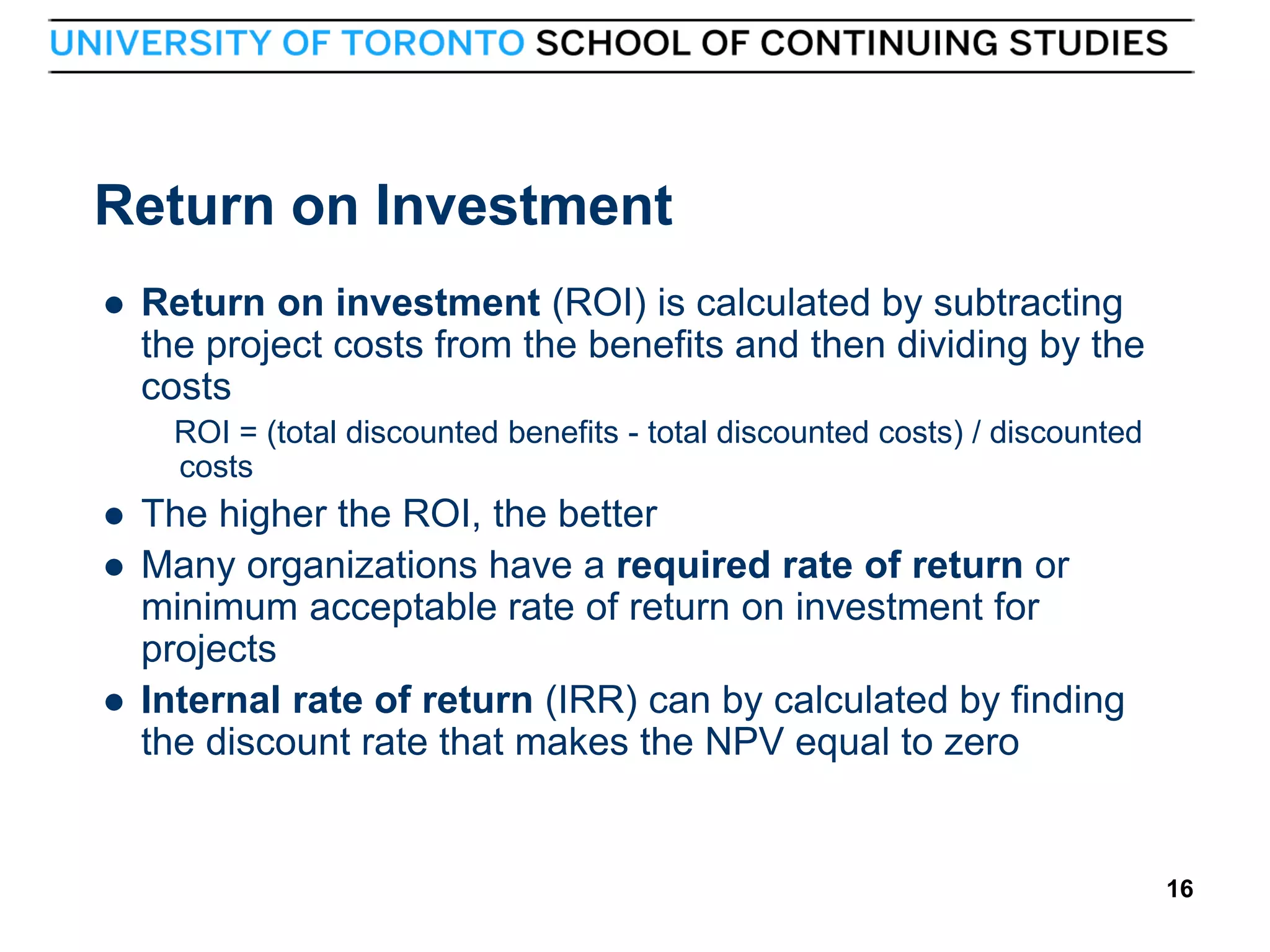

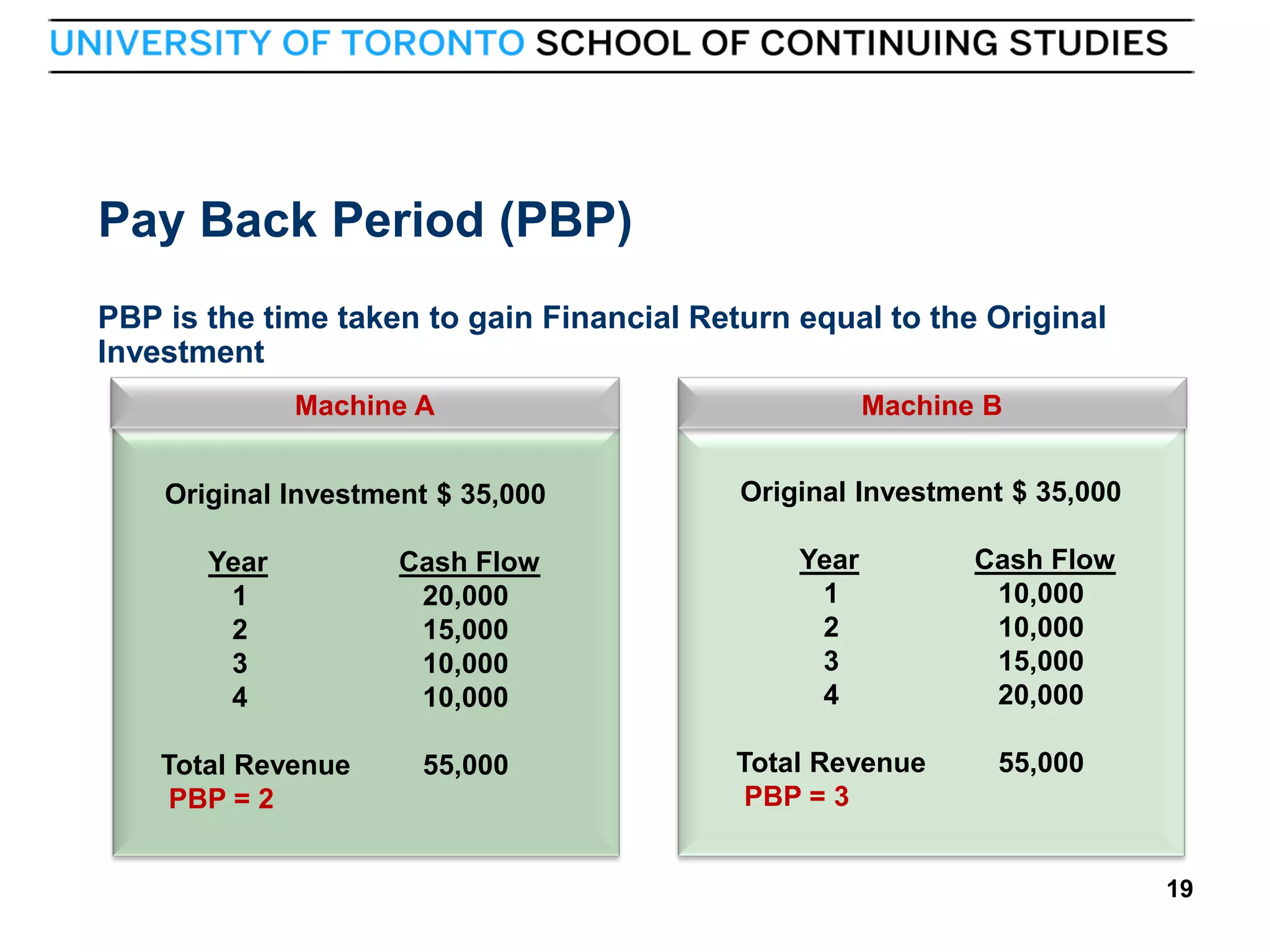

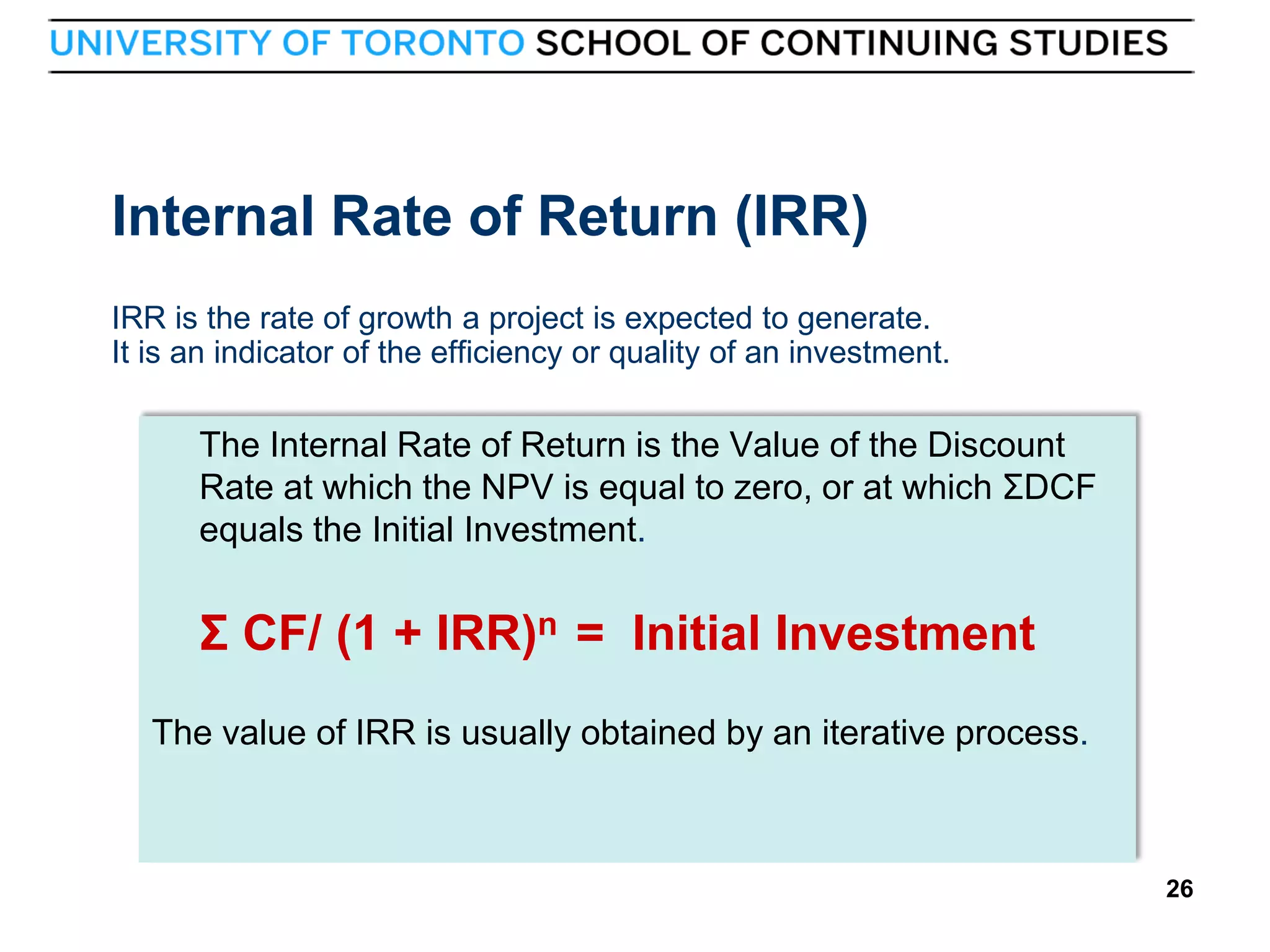

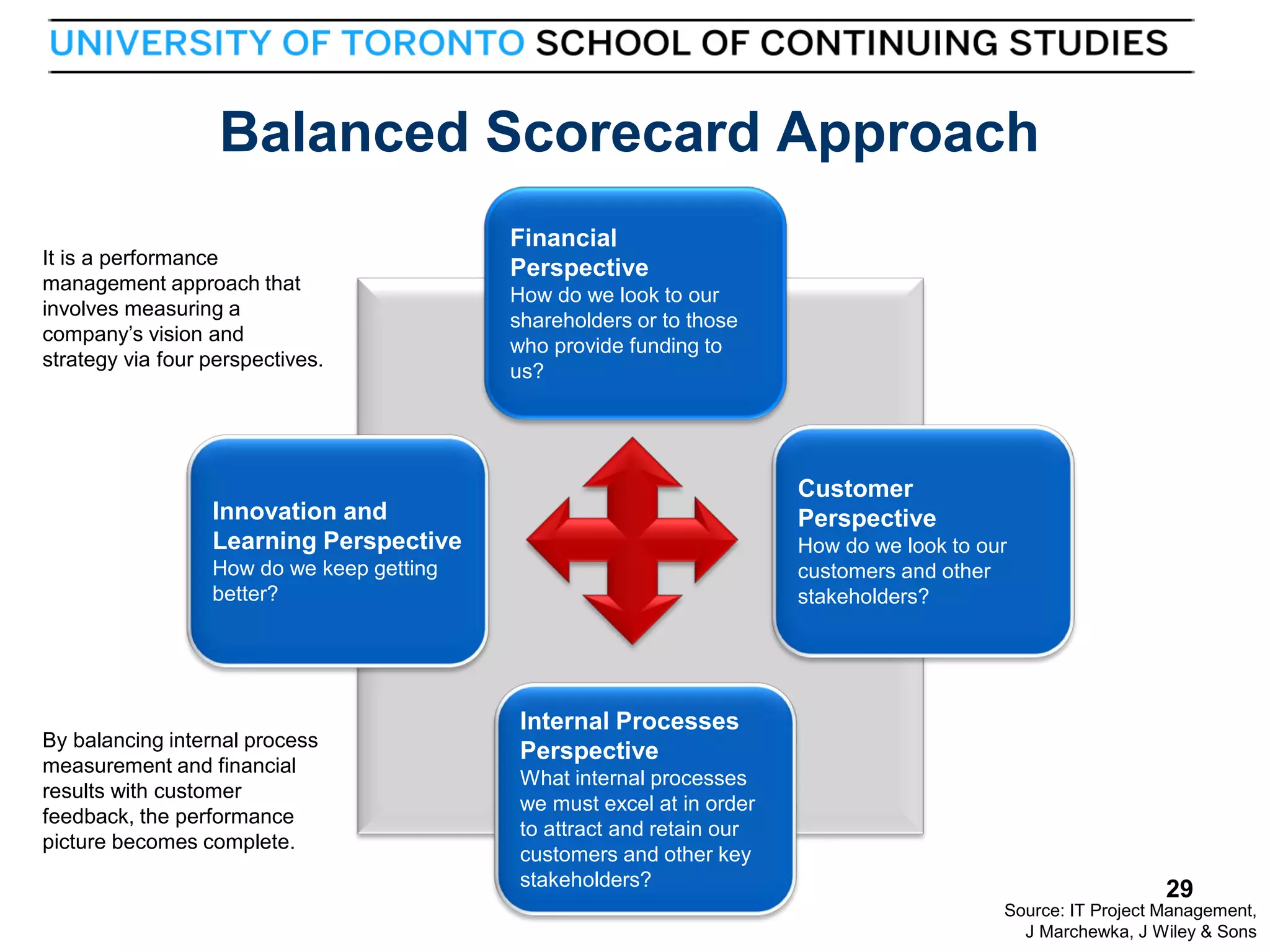

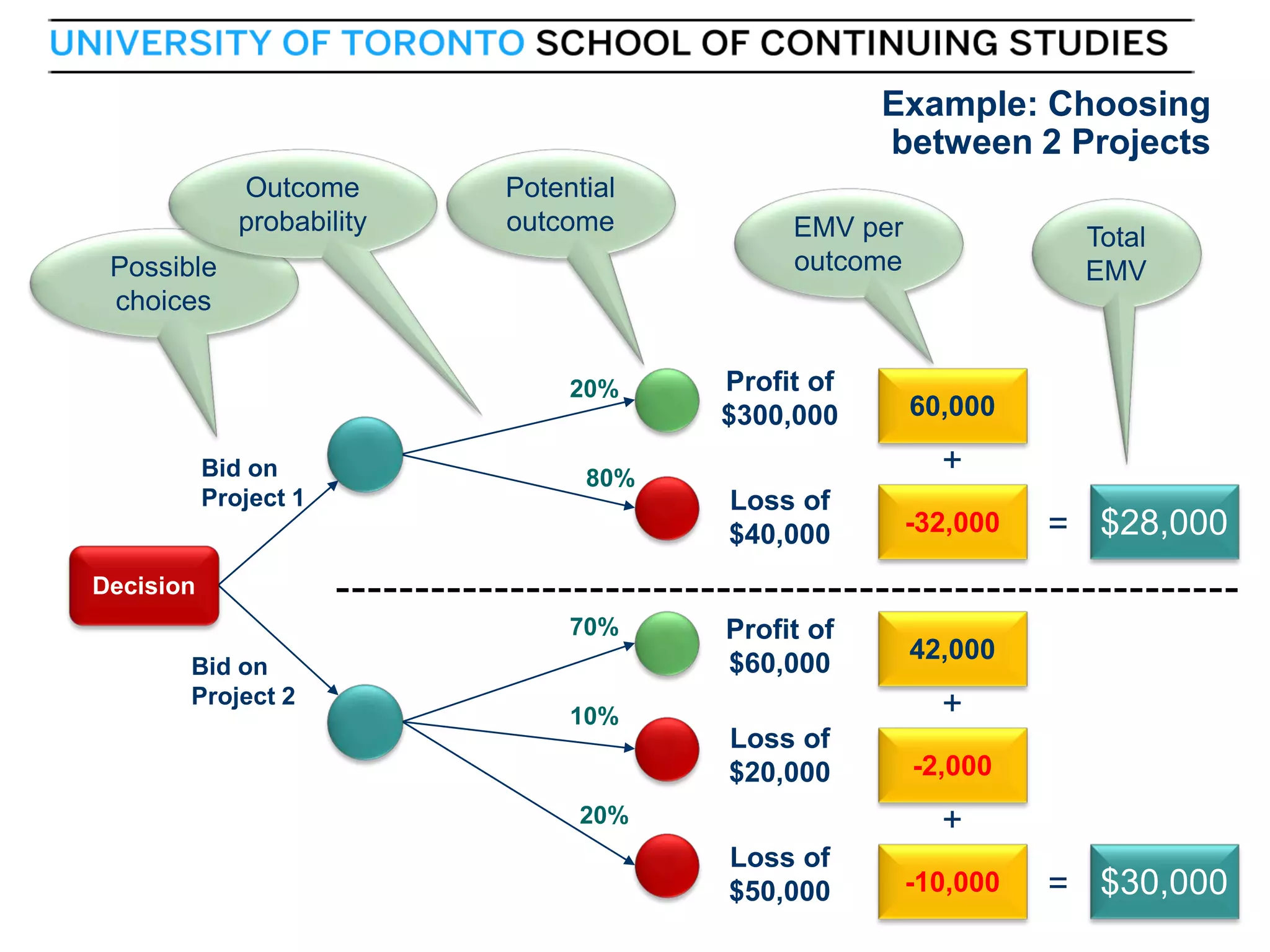

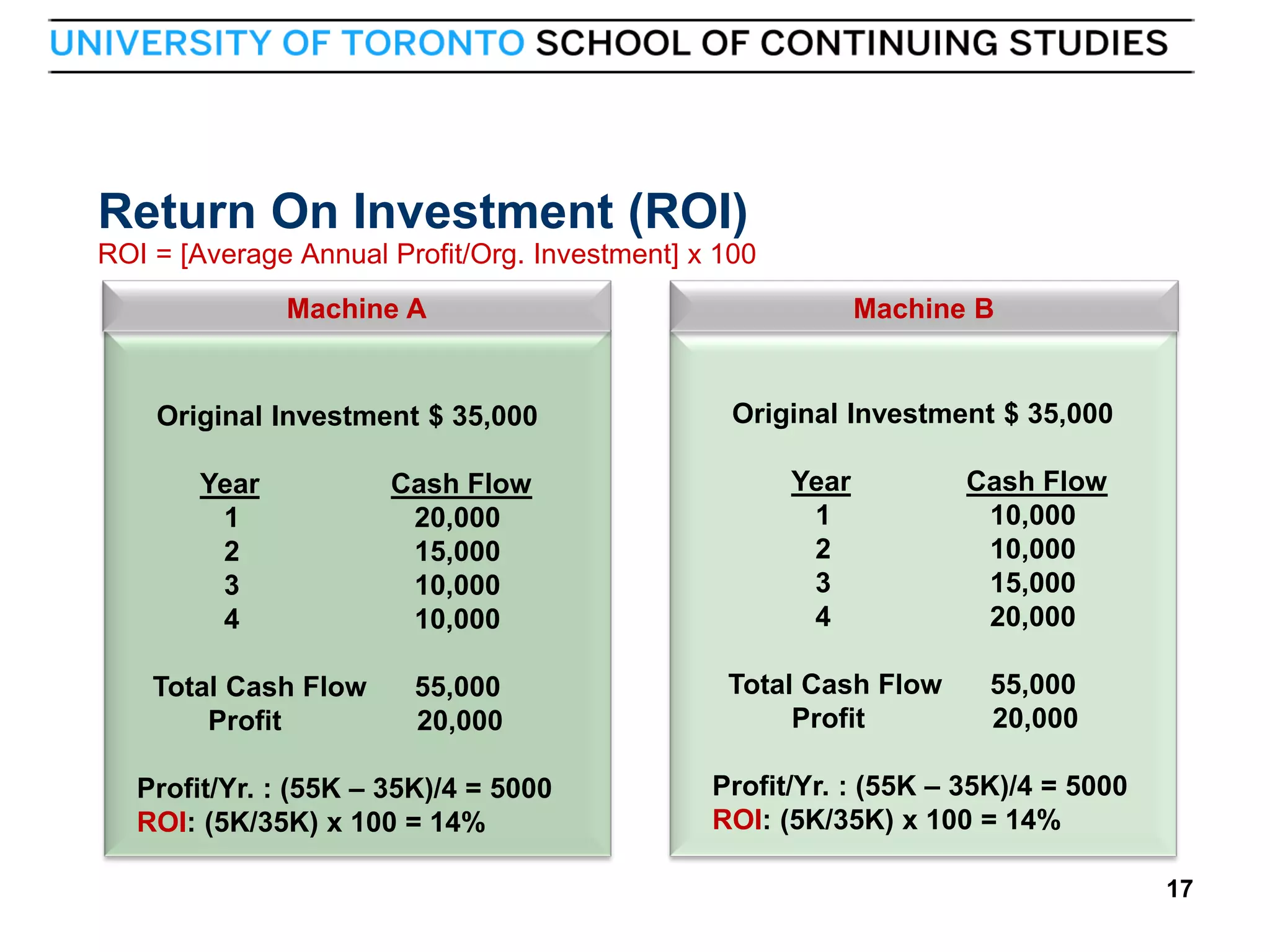

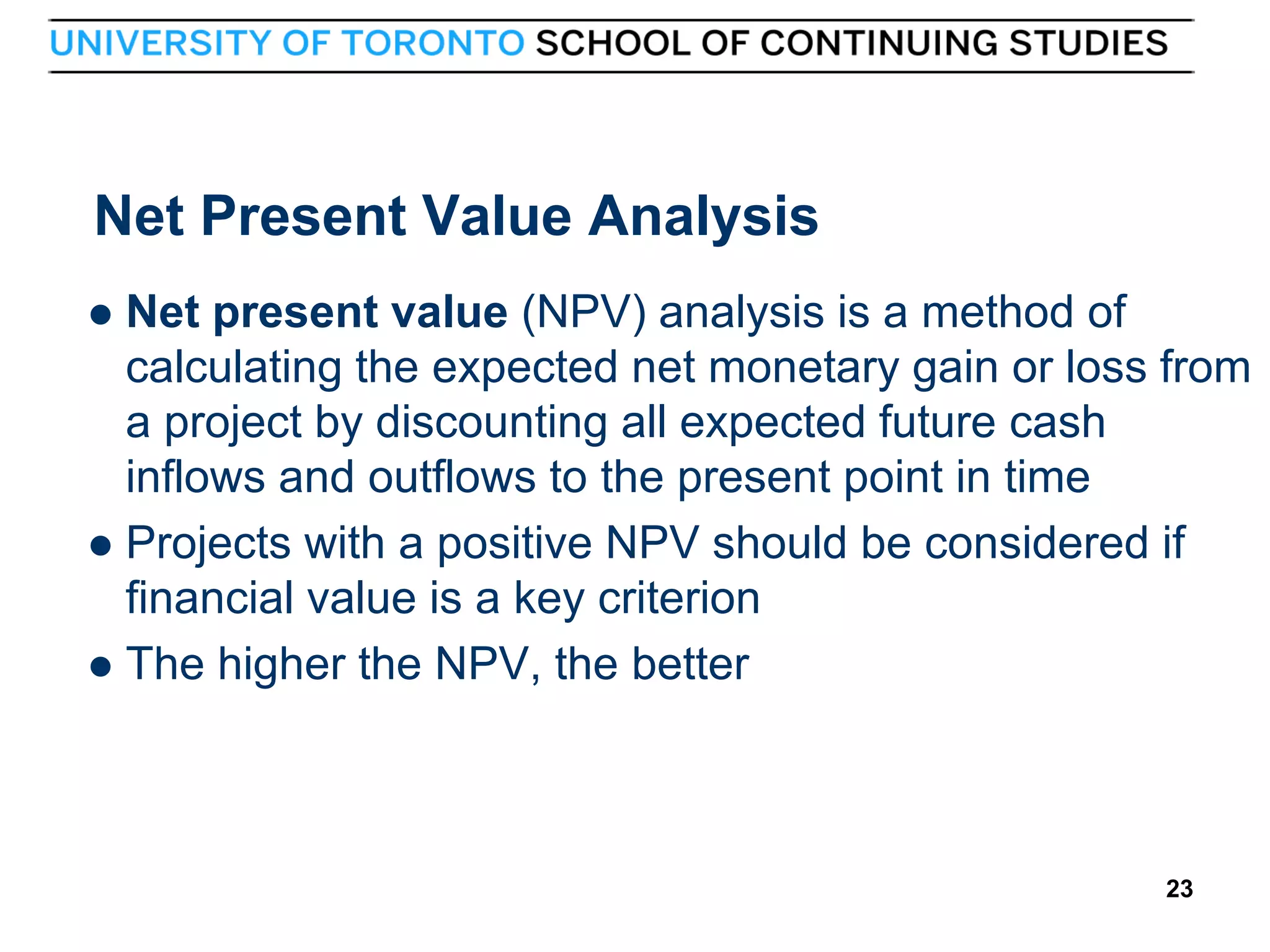

4) Methods for project selection like NPV, ROI, weighted scoring, and how a project charter and management plan are used.
Project Charter Components: The Power of the One-Page DocumentCIToolkit

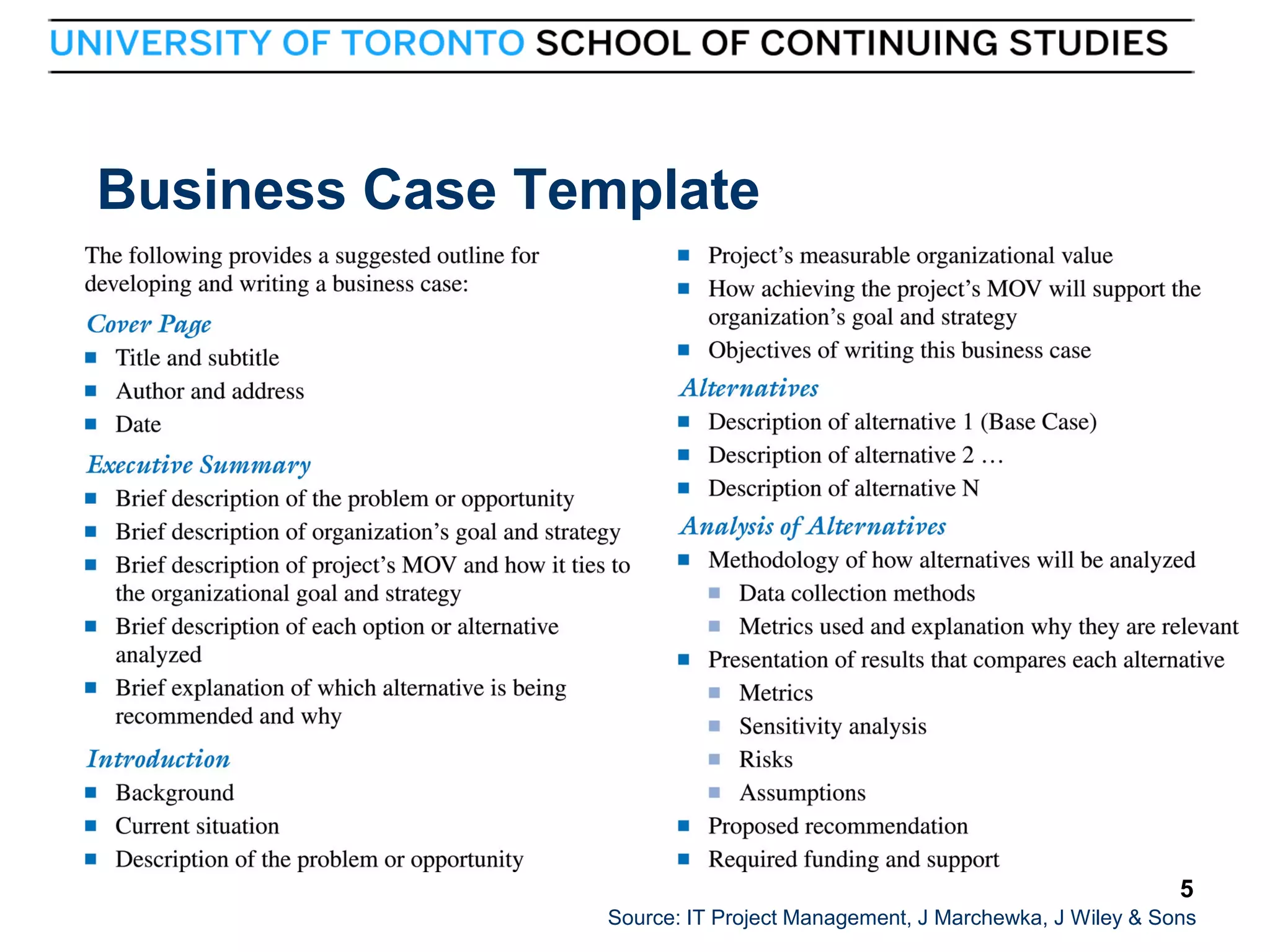

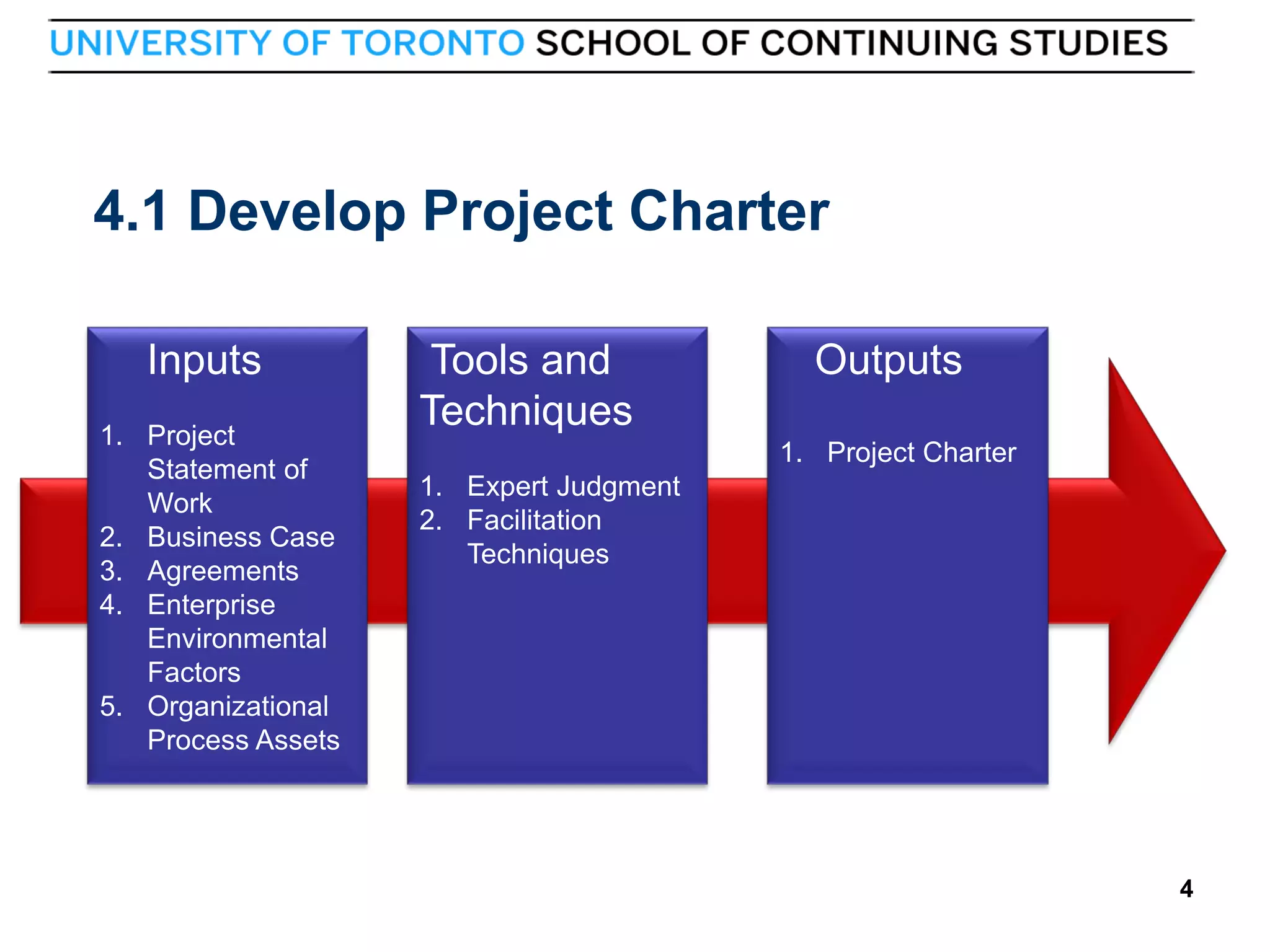

A Project Charter is a one-page document that summarizes the fundamental information of a project before it begins. The information in the project charter is critical for obtaining leadership support and commitment to provide the necessary funding and resources.
This document discusses the preparation and importance of project reports. It defines a project and outlines the key steps in project identification, selection, and preparation of a project report. These include identifying potential opportunities, evaluating ideas based on factors like size, location, technology, and marketing, and developing a comprehensive project report that covers technical, financial, production, and risk aspects of the proposed project. Conducting proper feasibility analysis and appraisal is important to determine if the project is viable and ensure successful implementation.
This document discusses project selection and initiation. It begins by outlining the learning outcomes and assessment criteria for Study Unit 2, which includes explaining how projects are identified and selected, developing a project charter, explaining outsourcing projects using requests for proposals, and describing the proposal solicitation process. It then provides information on identifying the source of projects, selecting projects using criteria, developing a project charter, explaining the use of requests for proposals, and fully explaining the solicitation process. The document discusses identifying needs, problems or opportunities; preparing requests for proposals; and selecting projects with the greatest benefit. It also outlines the project selection process and different methods for project evaluation and prioritization, including net present value, internal rate of return, benefit-
This document provides an overview of project management techniques including benefit measurement methods, project selection methods, project governance roles, and developing the project charter. It discusses scoring and rating systems like benefit-cost analysis, payback period, net present value, and internal rate of return for project selection. It also outlines the roles of the project sponsor, project manager, and project team. Finally, it addresses developing the project charter by gathering requirements, utilizing expert judgment, and identifying stakeholders.
CH-2.1 Conceptualizing and Initializing the IT Project.pptamanuel236786
The document discusses the phases and methodology of IT project management. It describes the five phases of an IT project as conceptualization and initialization, developing the project charter and plan, execution and control, closeout, and evaluation. It also explains how to develop a business case for a project, including defining its measurable organizational value (MOV) and analyzing costs, benefits, risks and alternatives. The business case and MOV help support project selection and alignment with organizational goals and strategies.
The document provides guidance on initiating projects through a 6-step process: 1) Define goals, 2) Identify team members, 3) Define work, 4) Develop a plan, 5) Delegate tasks, and 6) Execute and monitor progress. It emphasizes setting clear goals, assembling the right team to achieve those goals, breaking the work into specific tasks, creating a timeline and assigning responsibilities, and continuously tracking performance. Additional sections cover strategies for improving projects, criteria for selecting projects, and key project management terminology.
Project management chapter 4 - project integration management-1Eduardo Antero
The document discusses project integration management and provides details on key processes such as developing a project charter, preliminary scope statement, and management plan. It emphasizes the importance of project integration management in coordinating all project management knowledge areas throughout the project life cycle. Project managers must look at the big picture and coordinate planning efforts to create consistent, coherent management documents that guide project execution.
The document provides information on project management processes based on the PMBOK 5th edition. It begins with an overview of how people learn and retain information through different modalities like reading, listening, watching, doing, and teaching. The bulk of the document then covers the key processes involved in project management. It maps the project management knowledge areas to the five process groups of initiating, planning, executing, monitoring and controlling, and closing. It also provides information on developing the project charter, identifying stakeholders, and planning the scope, schedule, budget, quality, and risk management aspects of a project.
This document provides an overview of project management. It defines a project as a temporary set of activities undertaken to achieve unique objectives within defined cost and time parameters. Key aspects of projects include their unique purpose, temporary nature, use of various resources, and involvement of uncertainty. The document distinguishes projects from operations and programs/portfolios. It also outlines the triple constraints of quality, cost, and time that define projects. Additionally, it describes different types of project products and components of project management based on the Project Management Body of Knowledge (PMBOK).
The document discusses key concepts in project management. It defines a project as a temporary endeavor undertaken to create a unique product or service. Project management is described as a dynamic process that utilizes appropriate resources in a controlled manner to achieve clearly defined objectives. The document outlines the project life cycle, which includes initiation, planning, execution, controlling, and closing phases. It also discusses various project selection methods, including both numeric methods like net present value (NPV) and internal rate of return (IRR), as well as non-numeric justification approaches.
Project integration management involves coordinating all aspects of a project, including developing a charter, scope statement, and management plan. It also includes executing the project according to plan, monitoring for changes, controlling changes through an approval process, and closing out the project. Software can help with tasks like documentation, tracking, reporting, and integrating all project information. Effective integration is key to the overall success of projects.
ChapterPM_1.pptx for the course project managementDerbewBirhanu2
This document defines key concepts in project management. It begins by defining a project as a temporary endeavor undertaken to create a unique product or service, with defined start and end dates, funding limits, and that consumes resources. It then lists common examples of projects and types of projects. The document outlines the primary features of a project, including its lifecycle with distinct phases. It defines project management and its importance in controlling organizational change. Finally, it outlines the typical project management process and nine critical factors for project success.

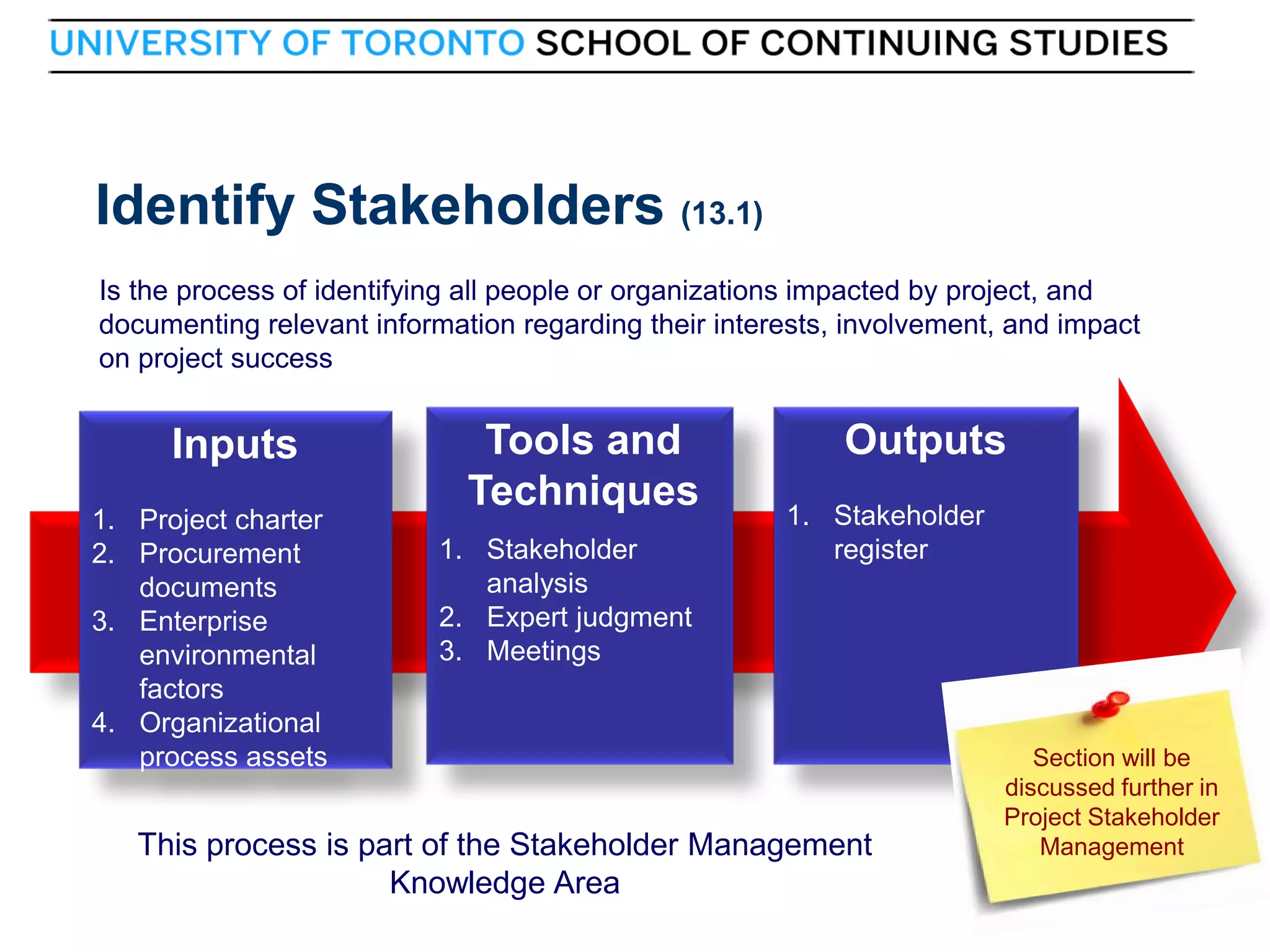

This presentation covers the two processes that fall under the Initiating Process Group
1. Develop Project charter
2. Identify Stakeholders
Additionally, it covers the ITTO of the processes
Pm ppt p roject selection and solicitationBhanu Tanwar
The document discusses project selection and solicitation planning for project management. It describes the process of project selection where projects are assessed and the highest priority project is chosen based on benefits and feasibility. Reasons for project selection include limited resources. Common project selection methods include quantitative methods like cost-benefit analysis and qualitative methods. The document also outlines the solicitation planning process which involves developing procurement documents like the procurement management plan, statement of work, and request for proposal to solicit bids from sellers for project needs. Key solicitation documents include requests for bids, quotes and proposals.

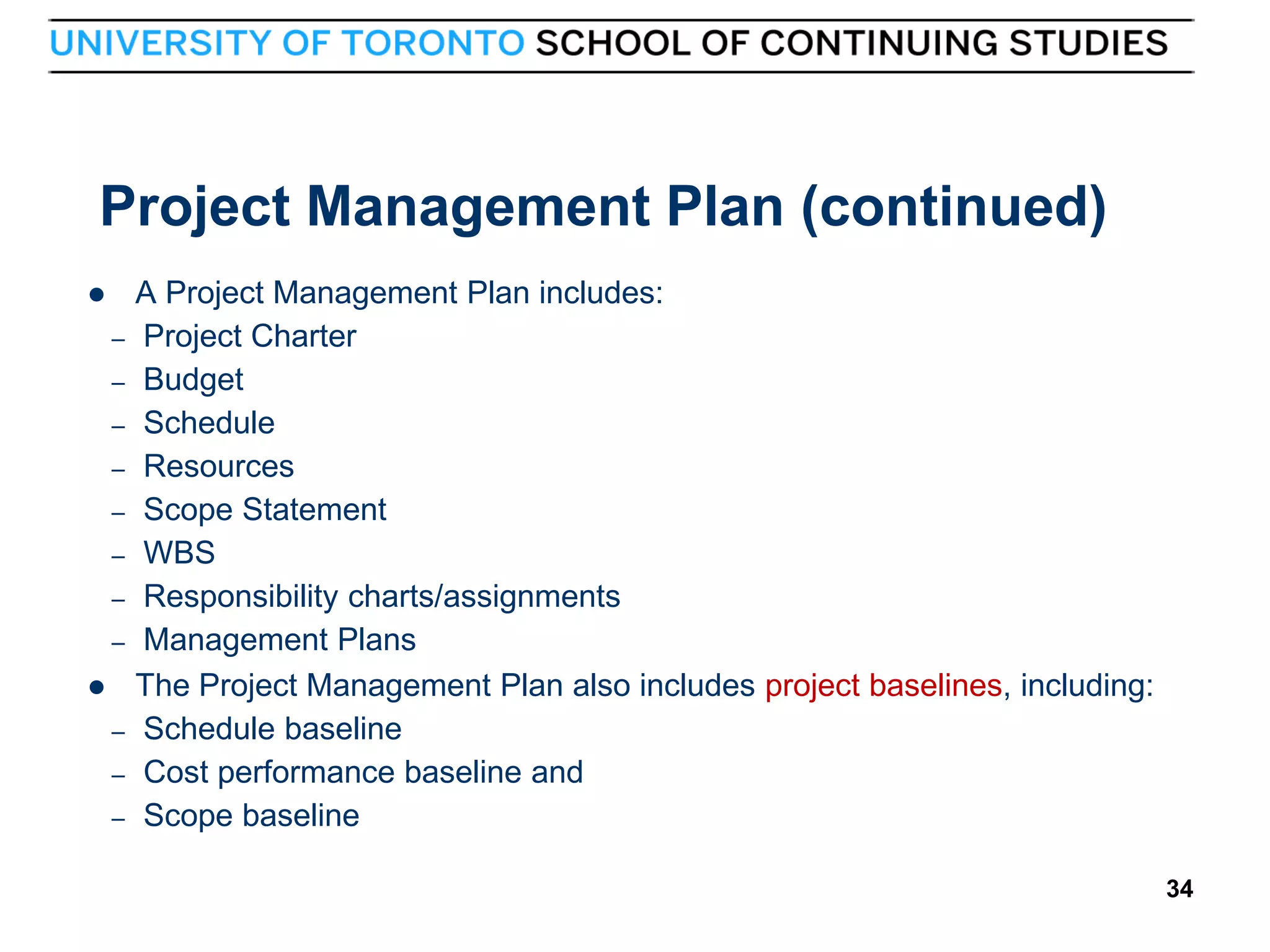

The project charter is the first document created for a project that defines the project's key elements. It establishes the authority of the project manager and outlines the project objectives, scope, stakeholders, costs, benefits, risks, and schedule. The charter for a diesel hydrodesulphurization unit project at an oil refinery seeks to reduce sulfur emissions from diesel by building new desulfurization facilities over 27 months at an estimated cost of 5500 million rupees in order to meet new fuel standards.
This is the short version of a Case Study showing the creation of a plan for a new operation for an eCommerce fulfillment business in healthcare in Canada. There is a longer version twice its length (the actual plan was more than 100 pages). It primarily shows the overall project, and then this piece's details of what was done, and what some of the output looked like.
Similar to Fpm module 02 initiation and integration april 11 2013 (20)
Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...my Pandit
Dive into the steadfast world of the Taurus Zodiac Sign. Discover the grounded, stable, and logical nature of Taurus individuals, and explore their key personality traits, important dates, and horoscope insights. Learn how the determination and patience of the Taurus sign make them the rock-steady achievers and anchors of the zodiac.
Easily Verify Compliance and Security with Binance KYCAny kyc Account
Use our simple KYC verification guide to make sure your Binance account is safe and compliant. Discover the fundamentals, appreciate the significance of KYC, and trade on one of the biggest cryptocurrency exchanges with confidence.
B2B payments are rapidly changing. Find out the 5 key questions you need to be asking yourself to be sure you are mastering B2B payments today. Learn more at www.BlueSnap.com.
How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...Aleksey Savkin
The Strategy Implementation System offers a structured approach to translating stakeholder needs into actionable strategies using high-level and low-level scorecards. It involves stakeholder analysis, strategy decomposition, adoption of strategic frameworks like Balanced Scorecard or OKR, and alignment of goals, initiatives, and KPIs.
Key Components:
- Stakeholder Analysis
- Strategy Decomposition
- Adoption of Business Frameworks
- Goal Setting
- Initiatives and Action Plans
- KPIs and Performance Metrics
- Learning and Adaptation
- Alignment and Cascading of Scorecards
Benefits:
- Systematic strategy formulation and execution.
- Framework flexibility and automation.
- Enhanced alignment and strategic focus across the organization.
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....Lacey Max
“After being the most listed dog breed in the United States for 31
years in a row, the Labrador Retriever has dropped to second place
in the American Kennel Club's annual survey of the country's most
popular canines. The French Bulldog is the new top dog in the
United States as of 2022. The stylish puppy has ascended the
rankings in rapid time despite having health concerns and limited
color choices.”
Discover timeless style with the 2022 Vintage Roman Numerals Men's Ring. Crafted from premium stainless steel, this 6mm wide ring embodies elegance and durability. Perfect as a gift, it seamlessly blends classic Roman numeral detailing with modern sophistication, making it an ideal accessory for any occasion.
https://rb.gy/usj1a2
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...APCO
The Radar reflects input from APCO’s teams located around the world. It distils a host of interconnected events and trends into insights to inform operational and strategic decisions. Issues covered in this edition include:
Zodiac Signs and Food Preferences_ What Your Sign Says About Your Tastemy Pandit
Know what your zodiac sign says about your taste in food! Explore how the 12 zodiac signs influence your culinary preferences with insights from MyPandit. Dive into astrology and flavors!
At Techbox Square, in Singapore, we're not just creative web designers and developers, we're the driving force behind your brand identity. Contact us today.
How MJ Global Leads the Packaging Industry.pdfMJ Global
MJ Global's success in staying ahead of the curve in the packaging industry is a testament to its dedication to innovation, sustainability, and customer-centricity. By embracing technological advancements, leading in eco-friendly solutions, collaborating with industry leaders, and adapting to evolving consumer preferences, MJ Global continues to set new standards in the packaging sector.
Storytelling is an incredibly valuable tool to share data and information. To get the most impact from stories there are a number of key ingredients. These are based on science and human nature. Using these elements in a story you can deliver information impactfully, ensure action and drive change.
[To download this presentation, visit:
https://www.oeconsulting.com.sg/training-presentations]
This PowerPoint compilation offers a comprehensive overview of 20 leading innovation management frameworks and methodologies, selected for their broad applicability across various industries and organizational contexts. These frameworks are valuable resources for a wide range of users, including business professionals, educators, and consultants.
Each framework is presented with visually engaging diagrams and templates, ensuring the content is both informative and appealing. While this compilation is thorough, please note that the slides are intended as supplementary resources and may not be sufficient for standalone instructional purposes.
This compilation is ideal for anyone looking to enhance their understanding of innovation management and drive meaningful change within their organization. Whether you aim to improve product development processes, enhance customer experiences, or drive digital transformation, these frameworks offer valuable insights and tools to help you achieve your goals.
INCLUDED FRAMEWORKS/MODELS:
1. Stanford’s Design Thinking
2. IDEO’s Human-Centered Design
3. Strategyzer’s Business Model Innovation
4. Lean Startup Methodology
5. Agile Innovation Framework
6. Doblin’s Ten Types of Innovation
7. McKinsey’s Three Horizons of Growth
8. Customer Journey Map
9. Christensen’s Disruptive Innovation Theory
10. Blue Ocean Strategy
11. Strategyn’s Jobs-To-Be-Done (JTBD) Framework with Job Map
12. Design Sprint Framework
13. The Double Diamond
14. Lean Six Sigma DMAIC
15. TRIZ Problem-Solving Framework
16. Edward de Bono’s Six Thinking Hats
17. Stage-Gate Model
18. Toyota’s Six Steps of Kaizen
19. Microsoft’s Digital Transformation Framework
20. Design for Six Sigma (DFSS)
To download this presentation, visit:
https://www.oeconsulting.com.sg/training-presentations
Digital Marketing with a Focus on Sustainabilitysssourabhsharma
Digital Marketing best practices including influencer marketing, content creators, and omnichannel marketing for Sustainable Brands at the Sustainable Cosmetics Summit 2024 in New York
The 10 Most Influential Leaders Guiding Corporate Evolution, 2024.pdfthesiliconleaders
In the recent edition, The 10 Most Influential Leaders Guiding Corporate Evolution, 2024, The Silicon Leaders magazine gladly features Dejan Štancer, President of the Global Chamber of Business Leaders (GCBL), along with other leaders.
3 Simple Steps To Buy Verified Payoneer Account In 2024SEOSMMEARTH
Buy Verified Payoneer Account: Quick and Secure Way to Receive Payments
Buy Verified Payoneer Account With 100% secure documents, [ USA, UK, CA ]. Are you looking for a reliable and safe way to receive payments online? Then you need buy verified Payoneer account ! Payoneer is a global payment platform that allows businesses and individuals to send and receive money in over 200 countries.
If You Want To More Information just Contact Now:
Skype: SEOSMMEARTH
Telegram: @seosmmearth
Gmail: seosmmearth@gmail.com

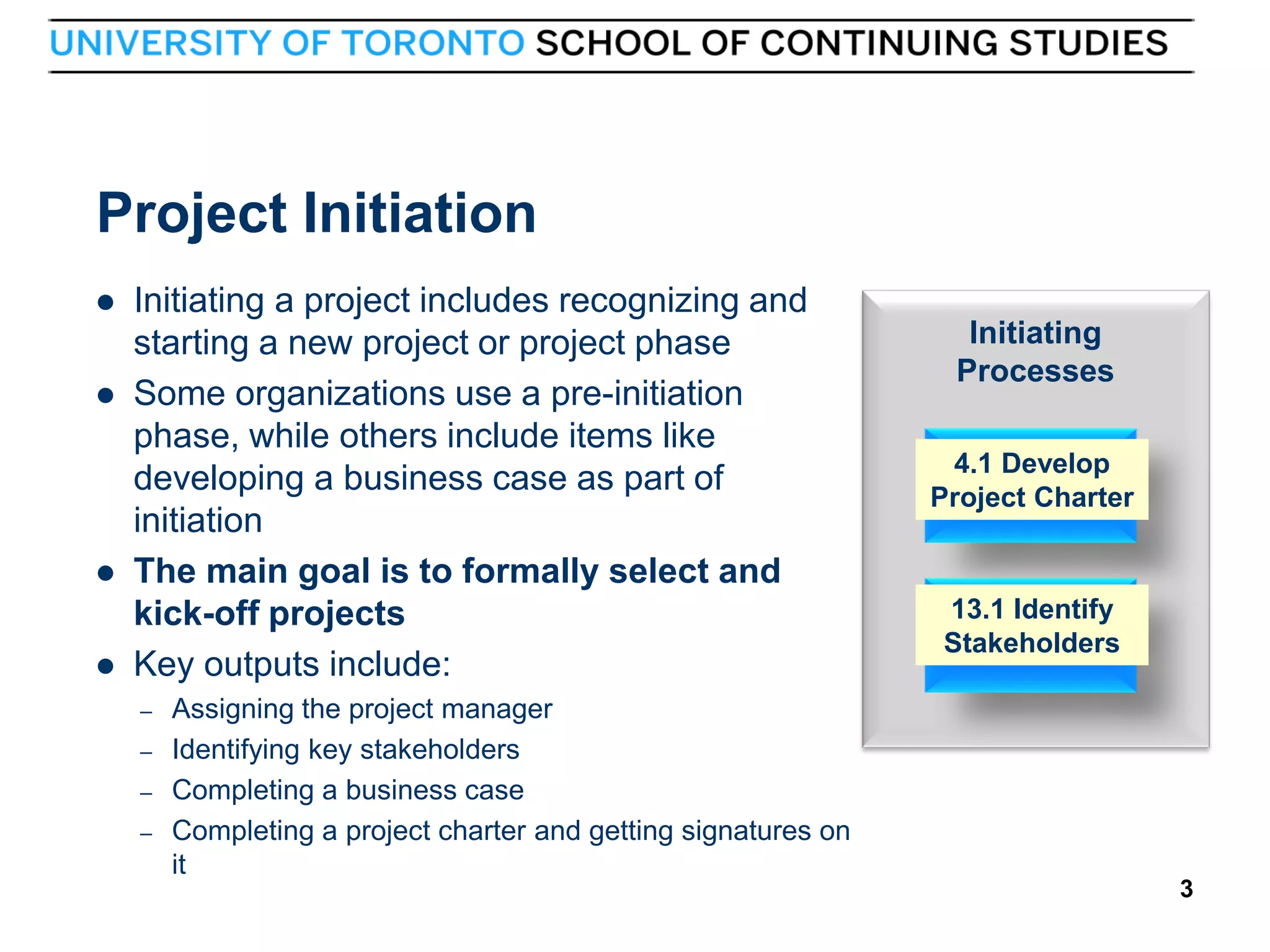

3. Project Initiation
Initiating a project includes recognizing and
starting a new project or project phase
Some organizations use a pre-initiation
phase, while others include items like
developing a business case as part of
initiation
The main goal is to formally select and
kick-off projects
Key outputs include:
–
–
–
–
3
Assigning the project manager
Identifying key stakeholders
Completing a business case
Completing a project charter and getting signatures on
it
Initiating
Processes
4.1 Develop
Project Charter
13.1 Identify
Stakeholders
3
4. 4.1 Develop Project Charter
Inputs
1. Project
Statement of
Work
2. Business Case
3. Agreements
4. Enterprise
Environmental
Factors
5. Organizational
Process Assets
4
Tools and
Techniques
Outputs
1. Project Charter
1. Expert Judgment
2. Facilitation
Techniques
4
6. The Project Charter
6
Process of formalizing projects after deciding what
project to work on
A project charter is a document that formally authorizes the
existence of a project and provides direction on the
project’s objectives and management
Key project stakeholders should sign a project charter to
acknowledge agreement on the need and intent of the
project
6
PMBOK: p.71
Schwalbe: p.157

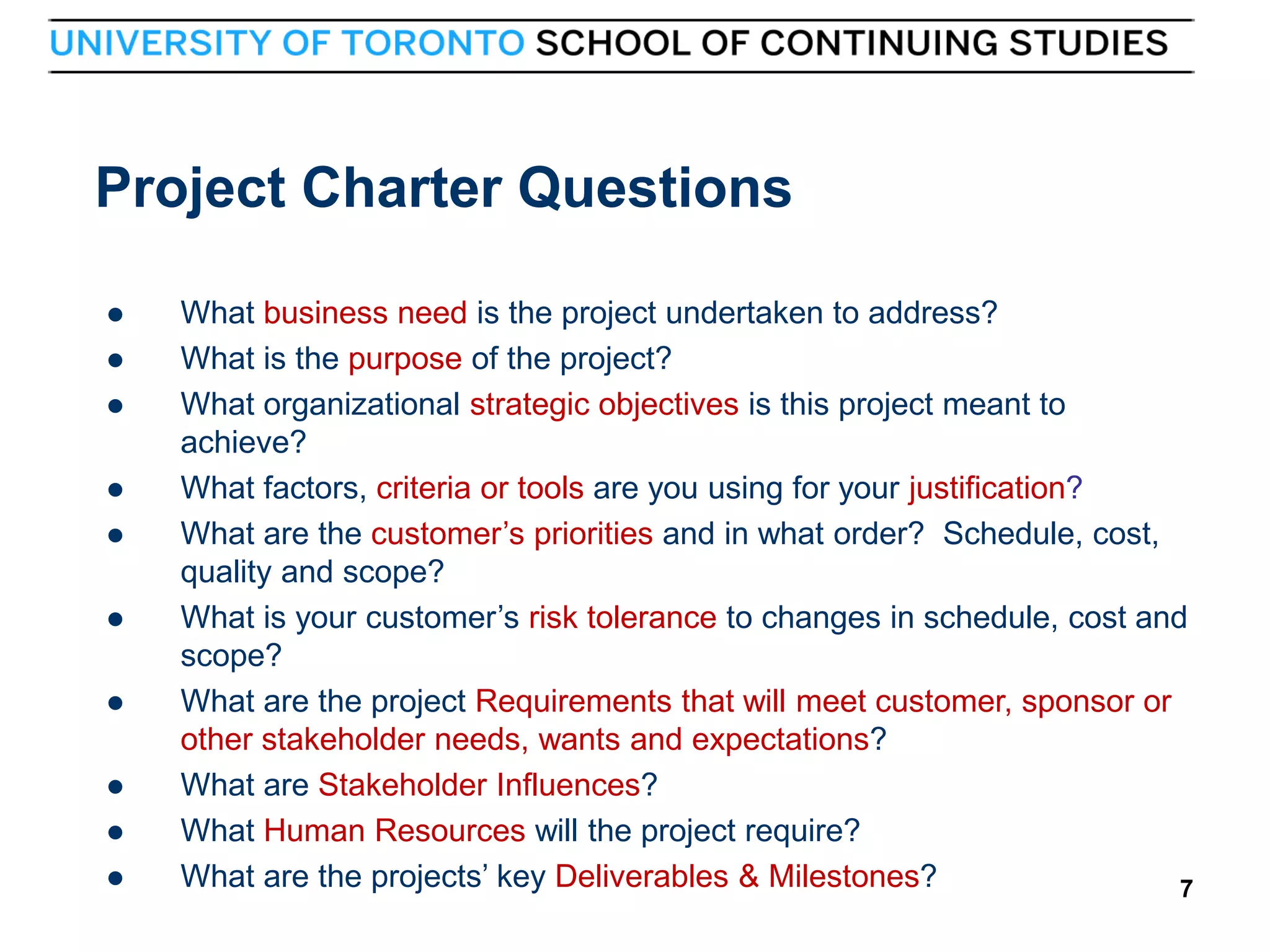

7. Project Charter Questions
7
What business need is the project undertaken to address?
What is the purpose of the project?
What organizational strategic objectives is this project meant to
achieve?
What factors, criteria or tools are you using for your justification?
What are the customer’s priorities and in what order? Schedule, cost,
quality and scope?
What is your customer’s risk tolerance to changes in schedule, cost and
scope?
What are the project Requirements that will meet customer, sponsor or
other stakeholder needs, wants and expectations?
What are Stakeholder Influences?
What Human Resources will the project require?
What are the projects’ key Deliverables & Milestones?
7

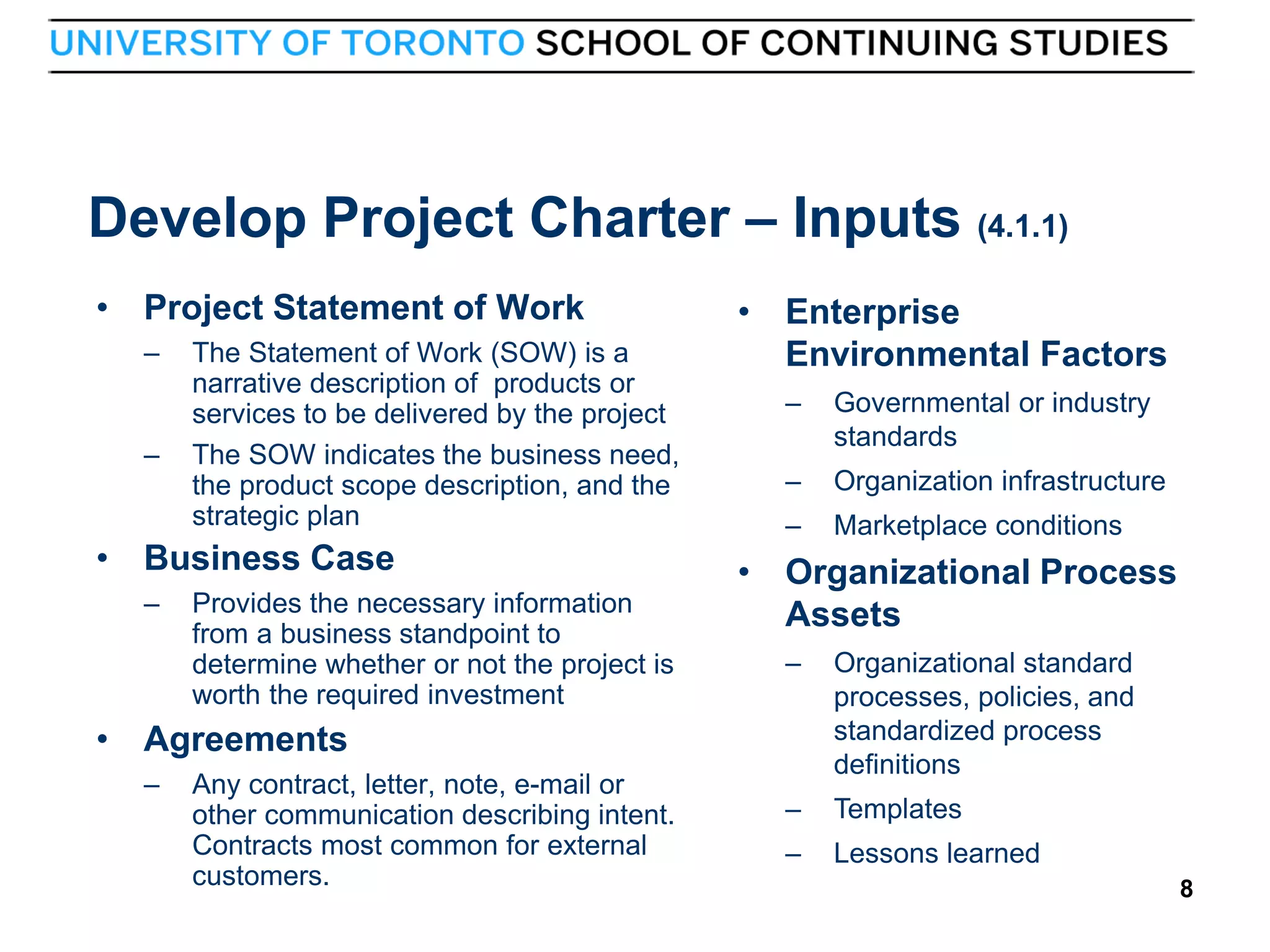

8. Develop Project Charter – Inputs (4.1.1)
• Project Statement of Work
–
–
The Statement of Work (SOW) is a
narrative description of products or
services to be delivered by the project
The SOW indicates the business need,
the product scope description, and the
strategic plan
• Business Case
–
Provides the necessary information
from a business standpoint to
determine whether or not the project is
worth the required investment
• Enterprise
Environmental Factors
–
Governmental or industry
standards
–
Organization infrastructure
–
Marketplace conditions
• Organizational Process
Assets
–
Organizational standard
processes, policies, and
standardized process
definitions
–
Templates
–
Lessons learned
• Agreements
–
8
Any contract, letter, note, e-mail or
other communication describing intent.
Contracts most common for external
customers.
8

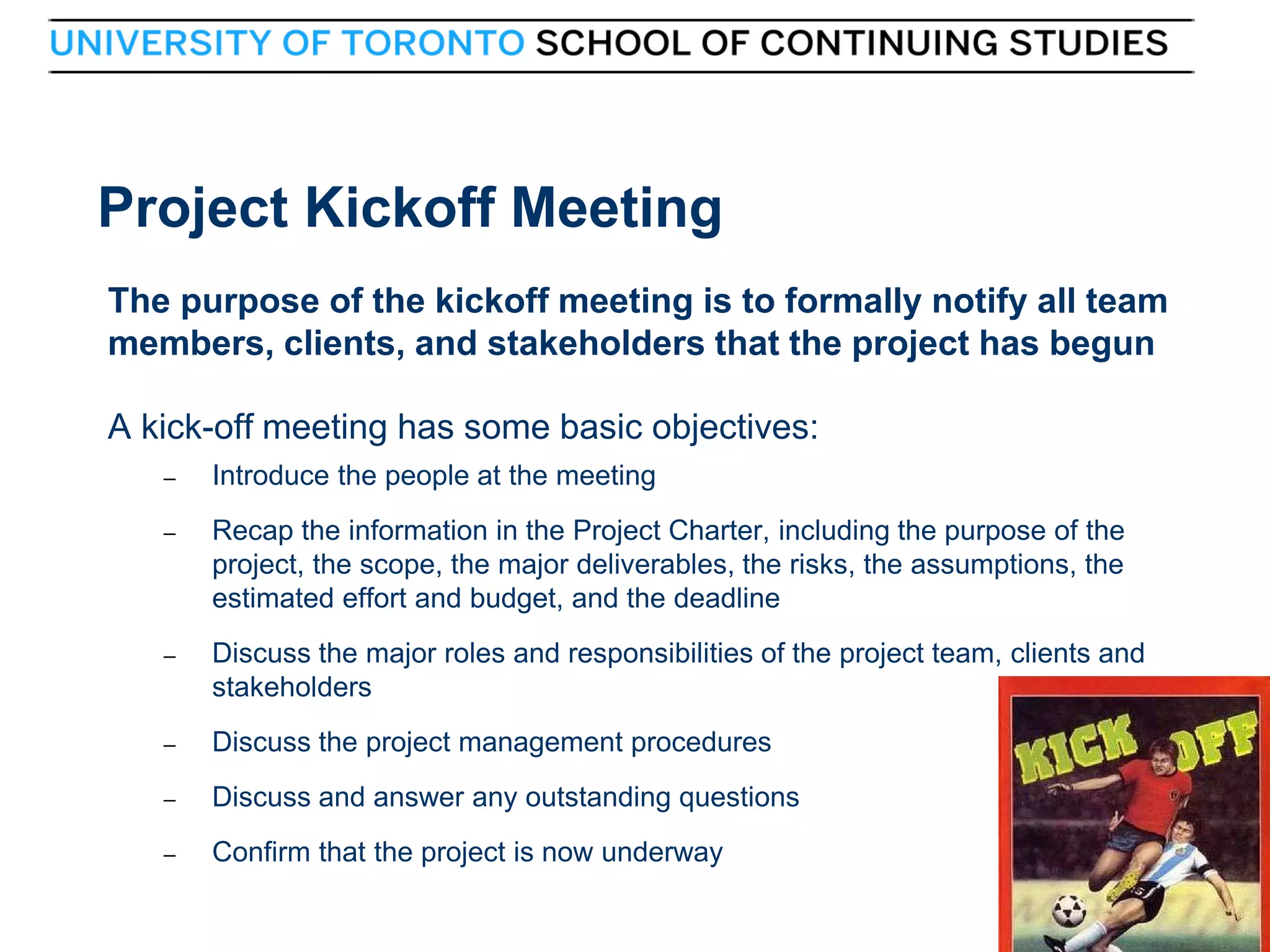

9. Project Kickoff Meeting
The purpose of the kickoff meeting is to formally notify all team
members, clients, and stakeholders that the project has begun
A kick-off meeting has some basic objectives:
–
–
Recap the information in the Project Charter, including the purpose of the
project, the scope, the major deliverables, the risks, the assumptions, the
estimated effort and budget, and the deadline
–
Discuss the major roles and responsibilities of the project team, clients and
stakeholders
–
Discuss the project management procedures
–
Discuss and answer any outstanding questions
–
9
Introduce the people at the meeting
Confirm that the project is now underway
9
10. Identify Stakeholders (13.1)
Is the process of identifying all people or organizations impacted by project, and
documenting relevant information regarding their interests, involvement, and impact
on project success
Inputs
1. Project charter
2. Procurement
documents
3. Enterprise
environmental
factors
4. Organizational
process assets
10
Tools and
Techniques
1. Stakeholder
analysis
2. Expert judgment
3. Meetings
Outputs
1. Stakeholder
register
This process is part of the Stakeholder Management
Knowledge Area
Section will be
discussed further in
Project Stakeholder
Management
10

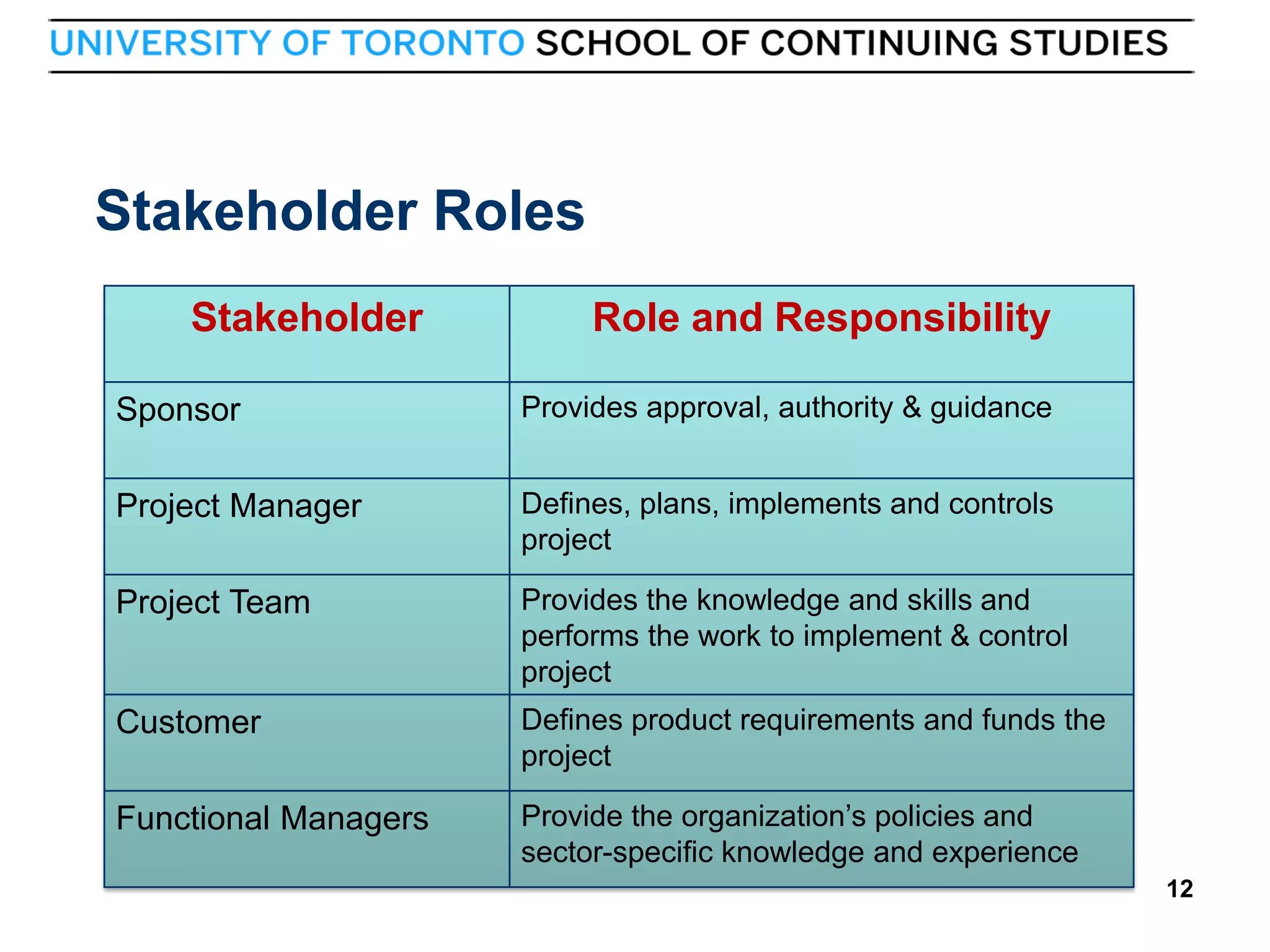

12. Stakeholder Roles
Stakeholder
Role and Responsibility
Sponsor
Project Manager
Defines, plans, implements and controls
project
Project Team
Provides the knowledge and skills and
performs the work to implement & control
project
Customer
Defines product requirements and funds the
project
Functional Managers
12
Provides approval, authority & guidance
Provide the organization’s policies and
sector-specific knowledge and experience
12

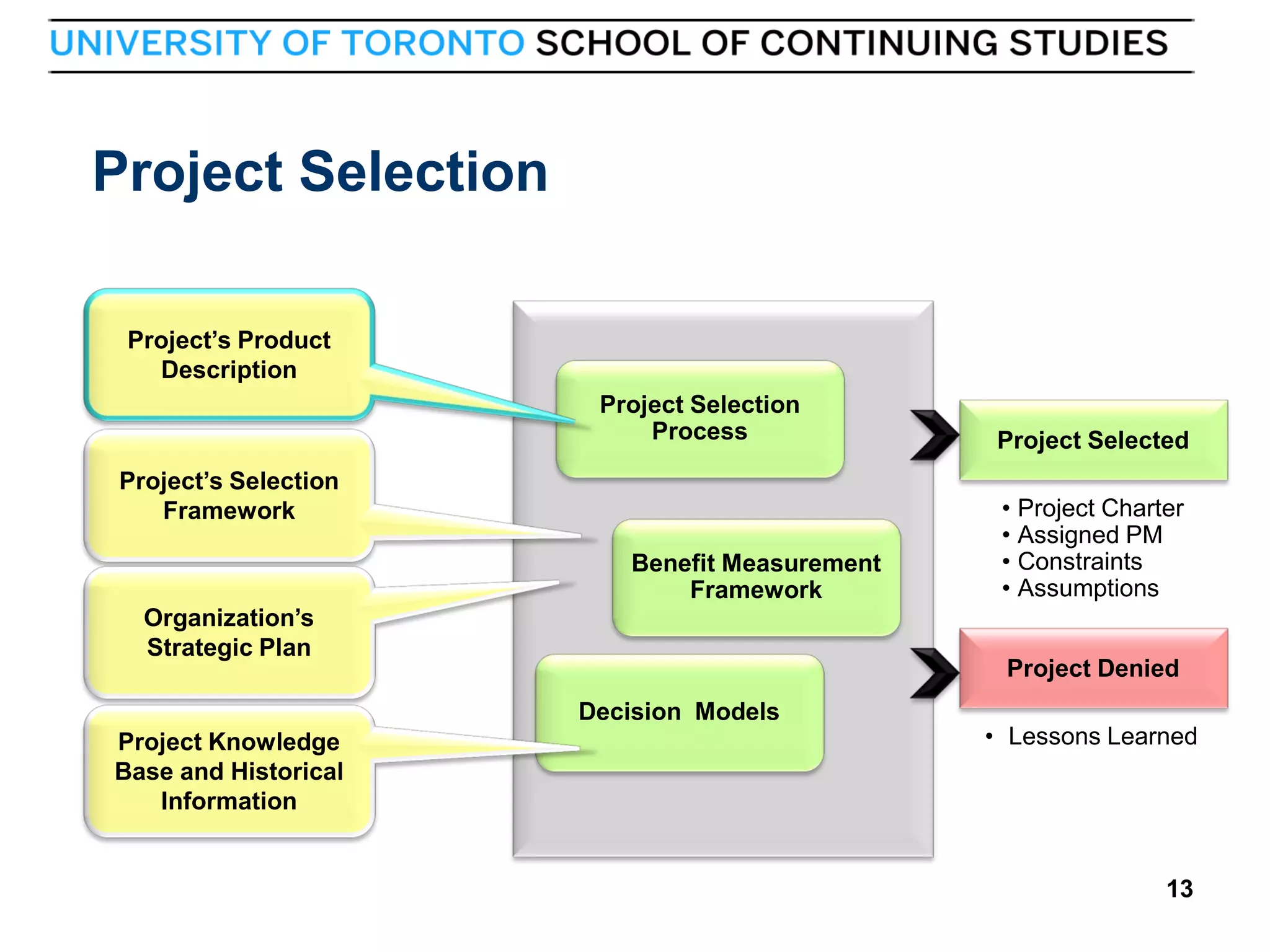

13. Project Selection
Project’s Product
Description
Project Selection
Process
Project’s Selection
Framework
Benefit Measurement
Framework
Organization’s
Strategic Plan
Project Selected
• Project Charter
• Assigned PM
• Constraints
• Assumptions
Project Denied
Decision Models
Project Knowledge
Base and Historical
Information
13
• Lessons Learned
13

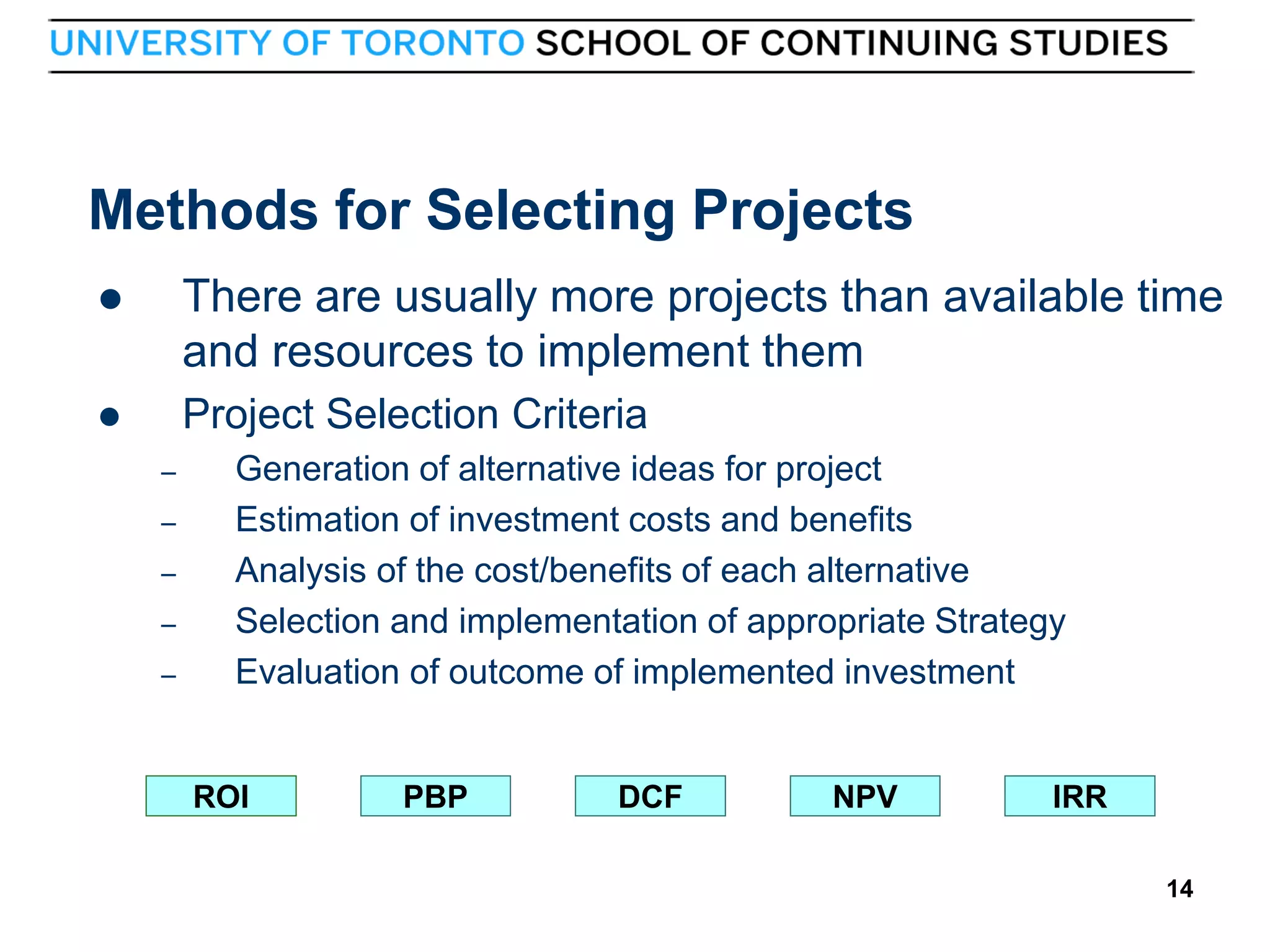

14. Methods for Selecting Projects
There are usually more projects than available time
and resources to implement them
Project Selection Criteria
–
–
–
–
–
Generation of alternative ideas for project
Estimation of investment costs and benefits
Analysis of the cost/benefits of each alternative
Selection and implementation of appropriate Strategy
Evaluation of outcome of implemented investment
ROI
14
PBP
DCF
NPV
IRR
14

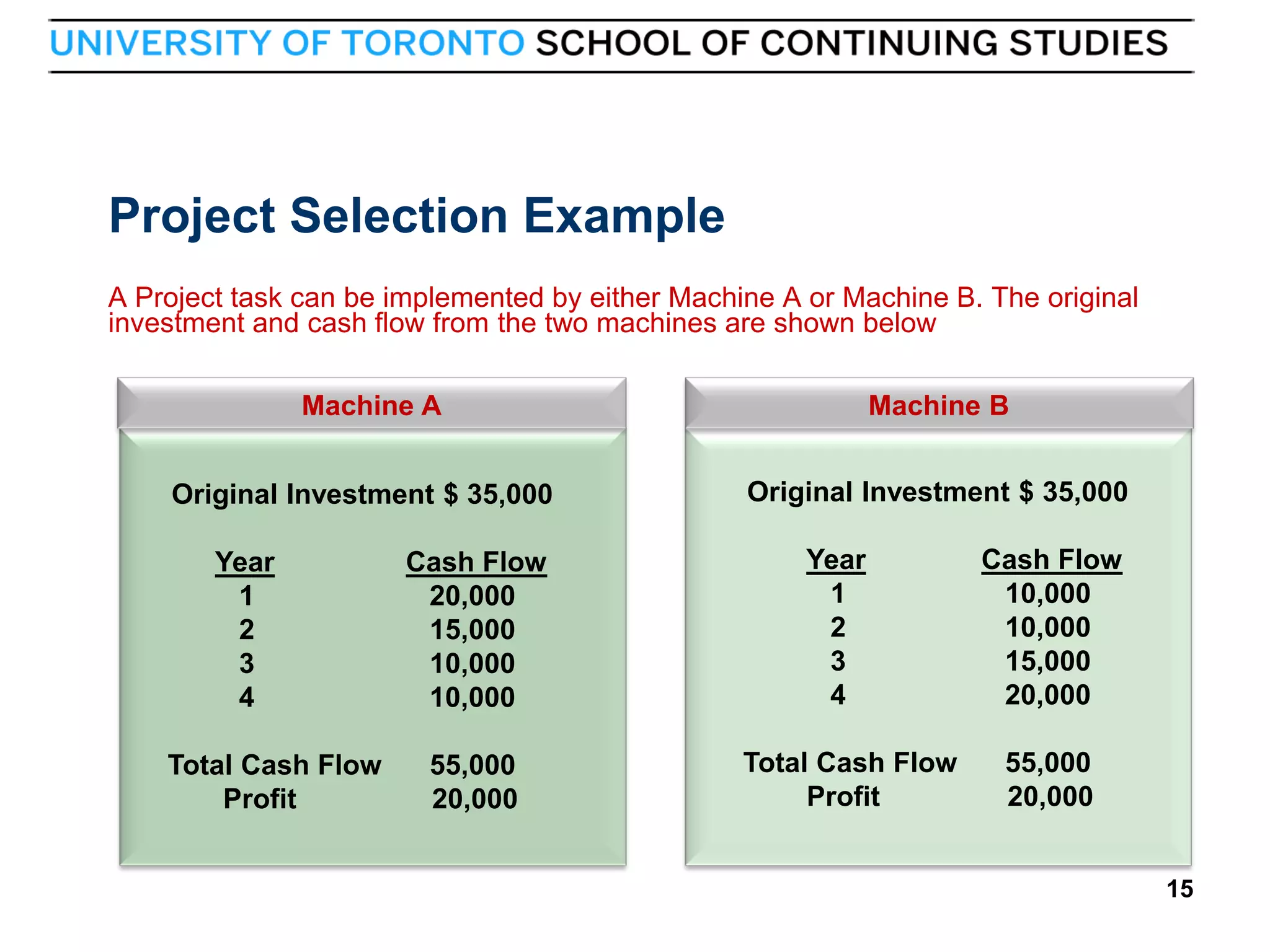

15. Project Selection Example
A Project task can be implemented by either Machine A or Machine B. The original
investment and cash flow from the two machines are shown below
Machine A
Original Investment $ 35,000
Year
1
2
3
4
Total Cash Flow
Profit
15
Cash Flow
20,000
15,000
10,000
10,000
55,000
20,000
Machine B
Original Investment $ 35,000
Year
1
2
3
4
Total Cash Flow
Profit
Cash Flow
10,000
10,000
15,000
20,000
55,000
20,000
15
16. Return on Investment
Return on investment (ROI) is calculated by subtracting
the project costs from the benefits and then dividing by the
costs
ROI = (total discounted benefits - total discounted costs) / discounted
costs
16
The higher the ROI, the better
Many organizations have a required rate of return or
minimum acceptable rate of return on investment for
projects
Internal rate of return (IRR) can by calculated by finding
the discount rate that makes the NPV equal to zero
16
17. Return On Investment (ROI)
ROI = [Average Annual Profit/Org. Investment] x 100
Machine A
Original Investment $ 35,000
Year
1
2
3
4
Total Cash Flow
Profit
Cash Flow
20,000
15,000
10,000
10,000
55,000
20,000
Profit/Yr. : (55K – 35K)/4 = 5000
ROI: (5K/35K) x 100 = 14%
17
Machine B
Original Investment $ 35,000
Year
1
2
3
4
Total Cash Flow
Profit
Cash Flow
10,000
10,000
15,000
20,000
55,000
20,000
Profit/Yr. : (55K – 35K)/4 = 5000
ROI: (5K/35K) x 100 = 14%
17

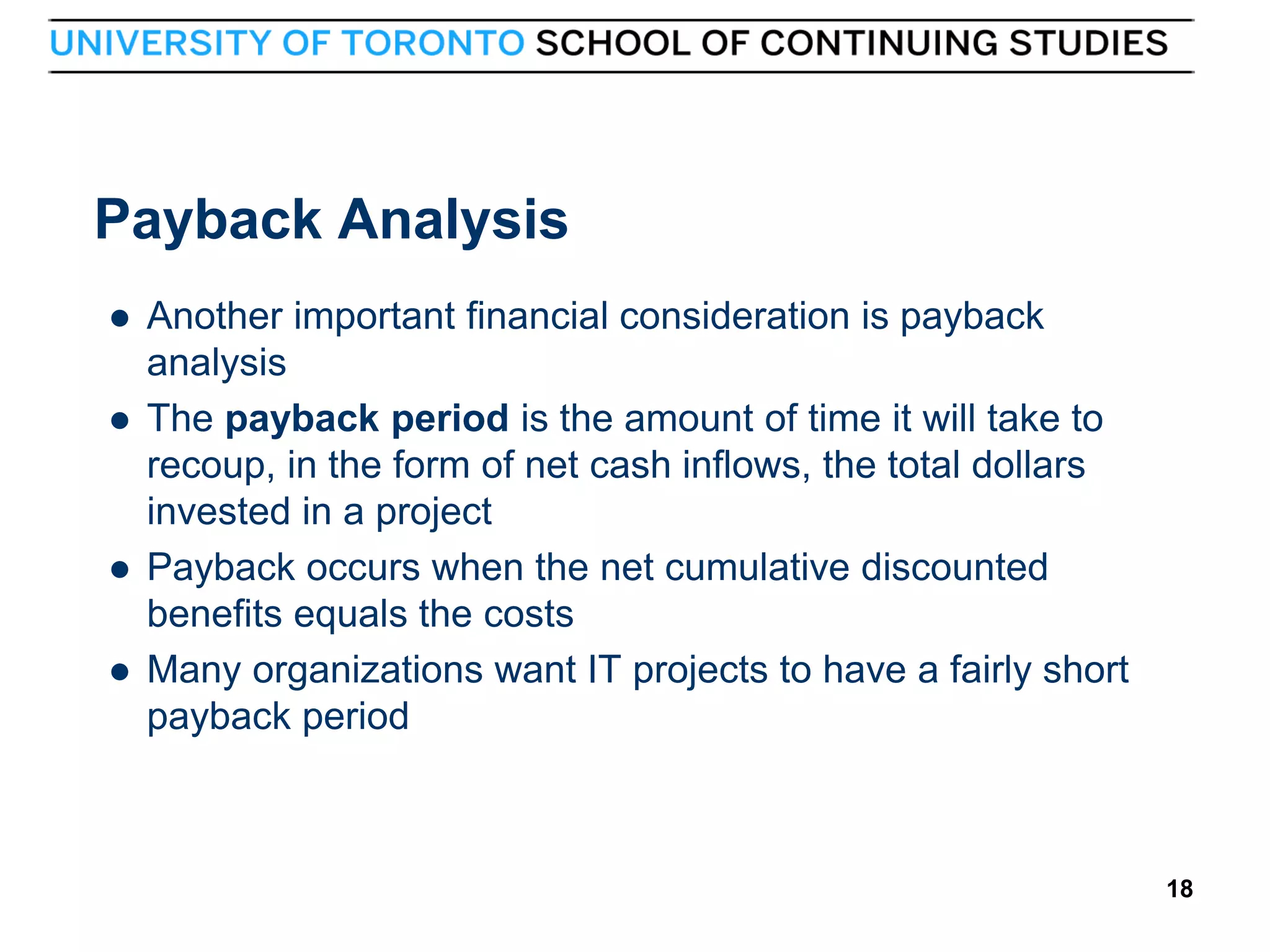

18. Payback Analysis
18
Another important financial consideration is payback
analysis
The payback period is the amount of time it will take to
recoup, in the form of net cash inflows, the total dollars
invested in a project
Payback occurs when the net cumulative discounted
benefits equals the costs
Many organizations want IT projects to have a fairly short
payback period
18
19. Pay Back Period (PBP)
PBP is the time taken to gain Financial Return equal to the Original
Investment
Machine A
Original Investment $ 35,000
Year
1
2
3
4
Total Revenue
PBP = 2
19
Machine B
Original Investment $ 35,000
Cash Flow
20,000
15,000
10,000
10,000
Year
1
2
3
4
Cash Flow
10,000
10,000
15,000
20,000
55,000
Total Revenue
PBP = 3
55,000
19

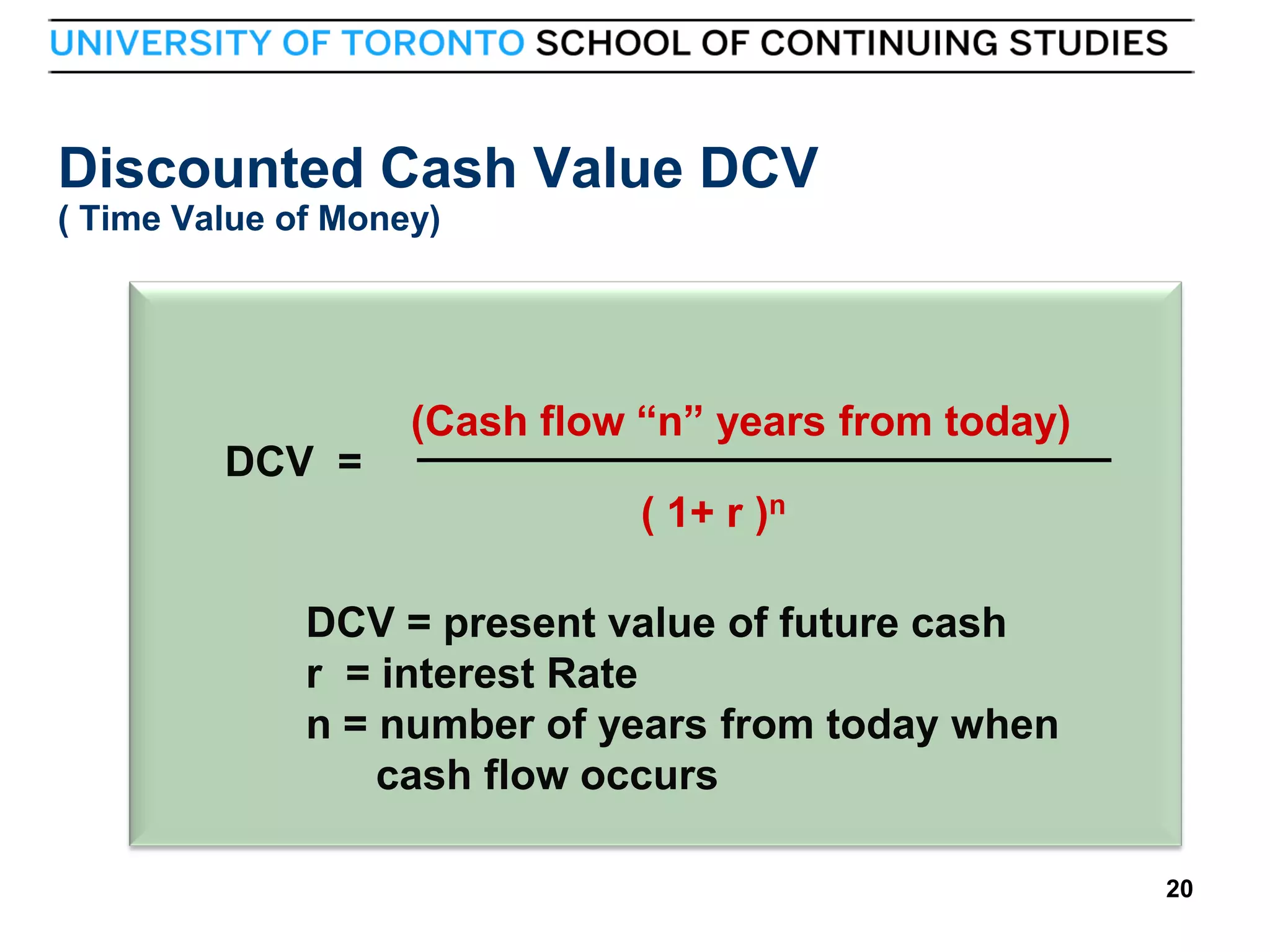

20. Discounted Cash Value DCV
( Time Value of Money)
(Cash flow “n” years from today)
DCV =
( 1+ r )n
DCV = present value of future cash
r = interest Rate
n = number of years from today when
cash flow occurs
20
20

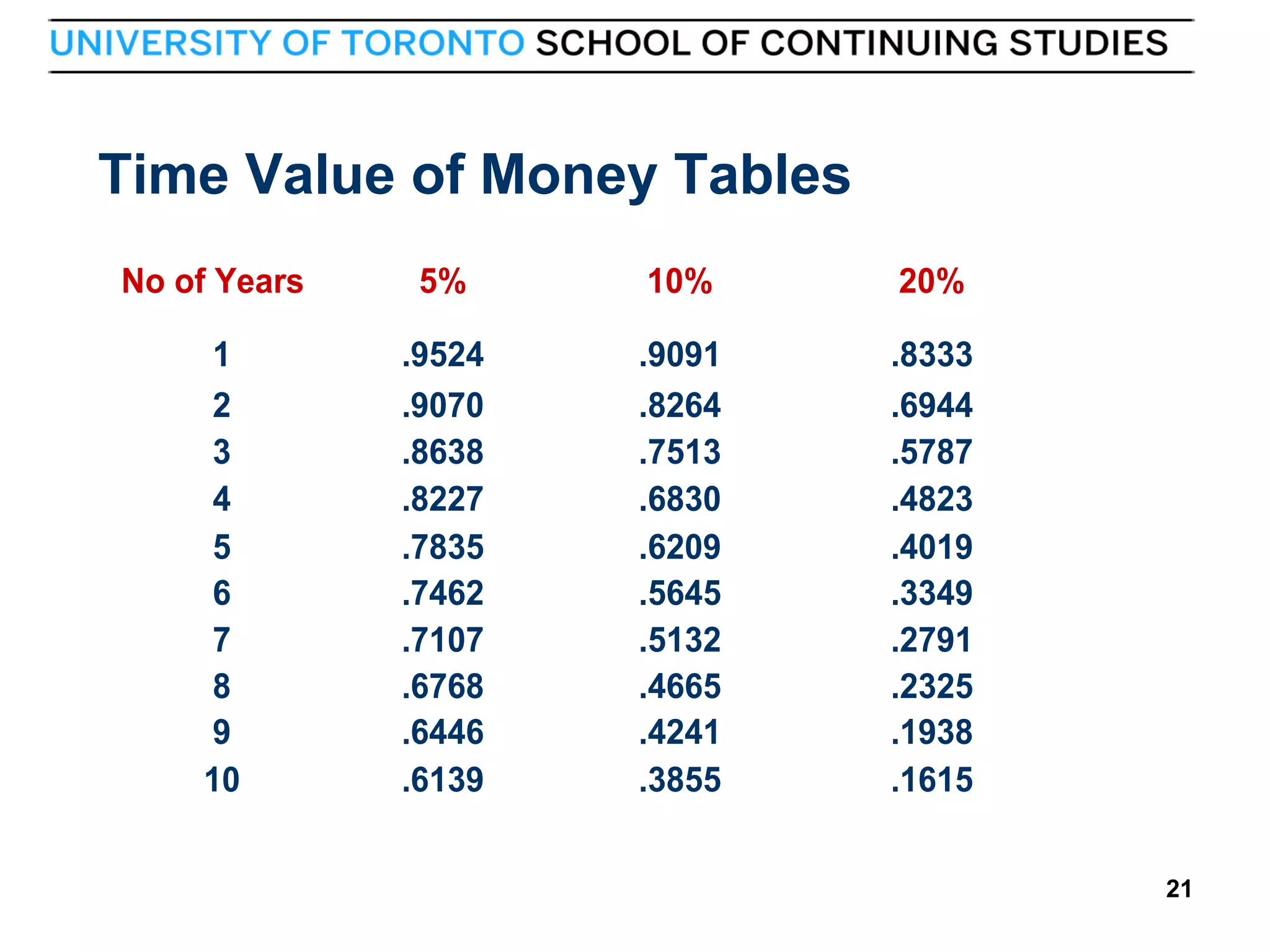

21. Time Value of Money Tables
No of Years
10%
20%
1
2
3
4
5
6
7
8
9
10
21
5%
.9524
.9070
.8638
.8227
.7835
.7462
.7107
.6768
.6446
.6139
.9091
.8264
.7513
.6830
.6209
.5645
.5132
.4665
.4241
.3855
.8333
.6944
.5787
.4823
.4019
.3349
.2791
.2325
.1938
.1615
21

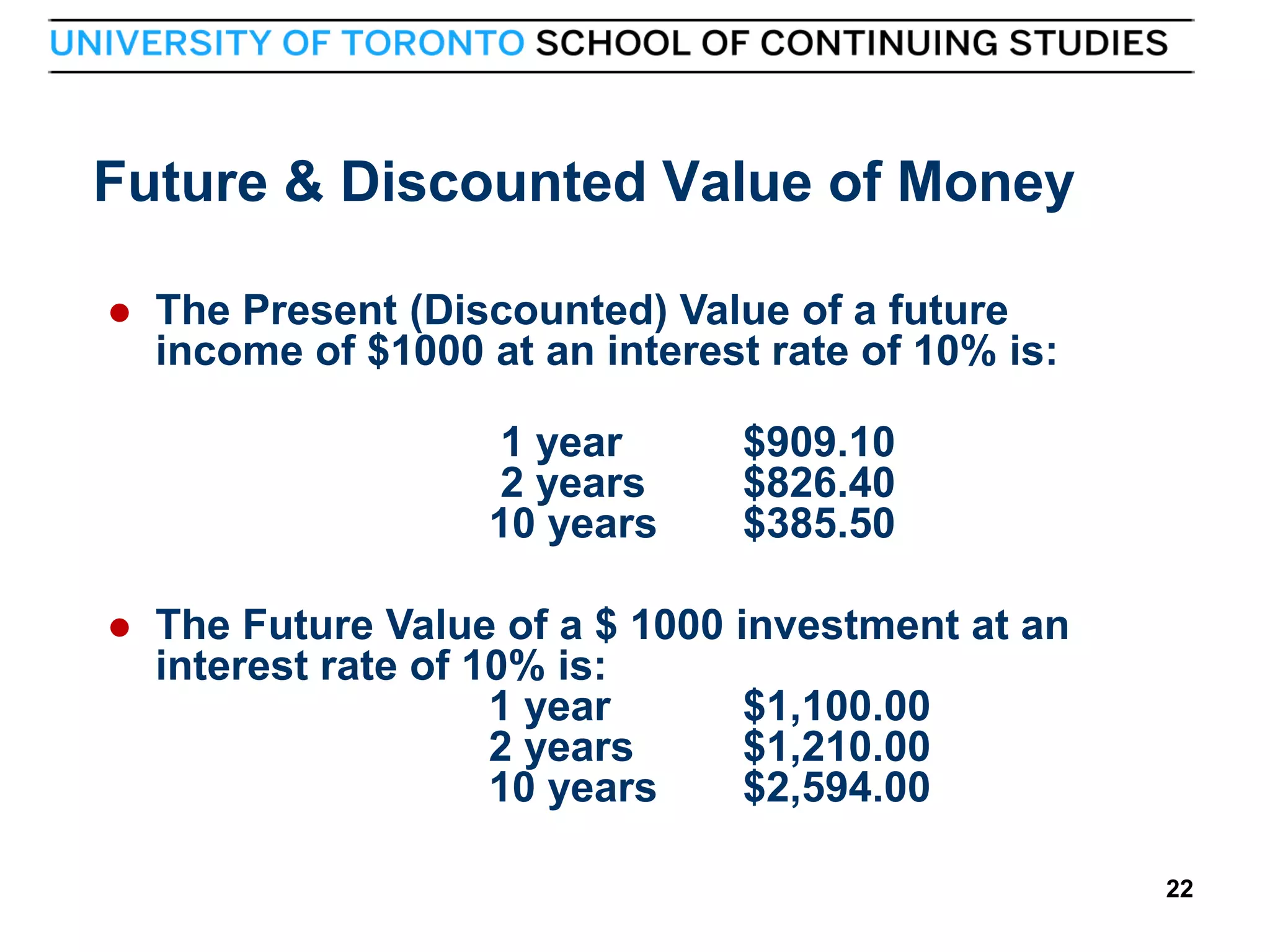

22. Future & Discounted Value of Money
The Present (Discounted) Value of a future
income of $1000 at an interest rate of 10% is:
1 year
2 years
10 years
22
$909.10
$826.40
$385.50
The Future Value of a $ 1000 investment at an
interest rate of 10% is:
1 year
$1,100.00
2 years
$1,210.00
10 years
$2,594.00
22
23. Net Present Value Analysis
Net present value (NPV) analysis is a method of
calculating the expected net monetary gain or loss from
a project by discounting all expected future cash
inflows and outflows to the present point in time
Projects with a positive NPV should be considered if
financial value is a key criterion
The higher the NPV, the better
23
23

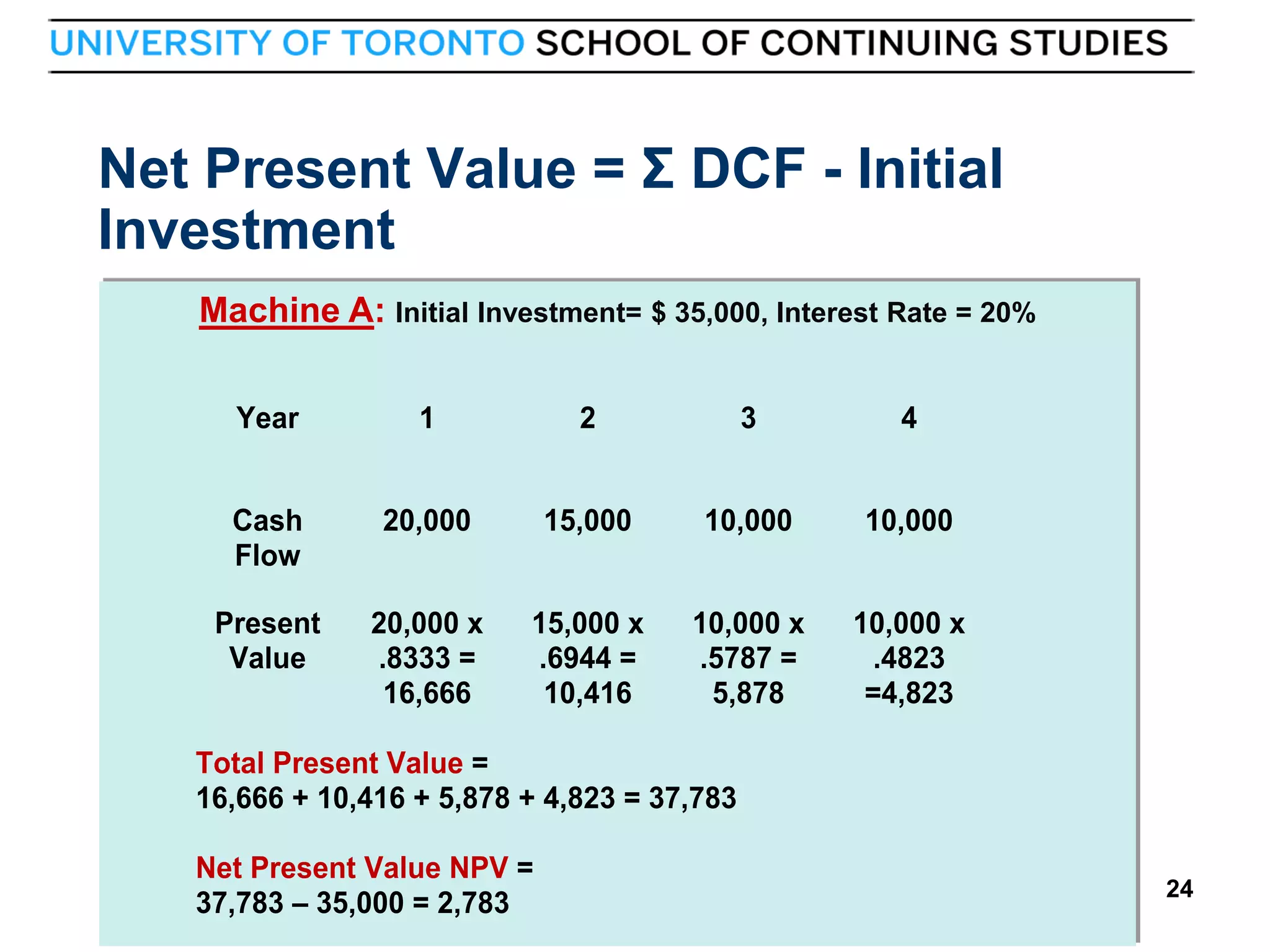

24. Net Present Value = Σ DCF - Initial
Investment
Machine A: Initial Investment= $ 35,000, Interest Rate = 20%
Year
1
2
3
4
Cash
Flow
20,000
15,000
10,000
10,000
Present
Value
20,000 x
.8333 =
16,666
15,000 x
.6944 =
10,416
10,000 x
.5787 =
5,878
10,000 x
.4823
=4,823
Total Present Value =
16,666 + 10,416 + 5,878 + 4,823 = 37,783
24
Net Present Value NPV =
37,783 – 35,000 = 2,783
24

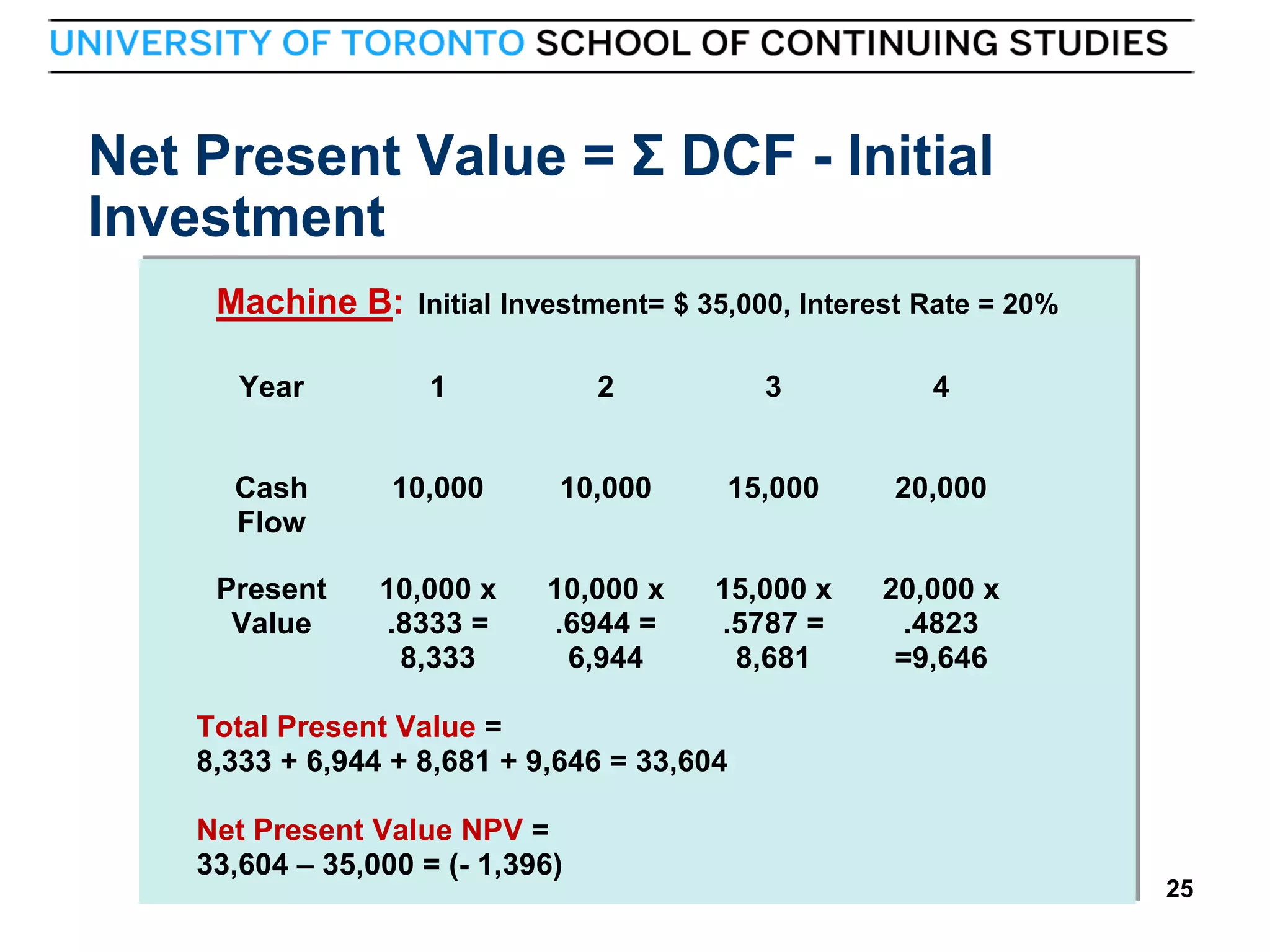

25. Net Present Value = Σ DCF - Initial
Investment
Machine B:
Initial Investment= $ 35,000, Interest Rate = 20%
Year
1
2
3
4
Cash
Flow
10,000
10,000
15,000
20,000
Present
Value
10,000 x
.8333 =
8,333
10,000 x
.6944 =
6,944
15,000 x
.5787 =
8,681
20,000 x
.4823
=9,646
Total Present Value =
8,333 + 6,944 + 8,681 + 9,646 = 33,604
Net Present Value NPV =
33,604 – 35,000 = (- 1,396)
25
25
26. Internal Rate of Return (IRR)
IRR is the rate of growth a project is expected to generate.
It is an indicator of the efficiency or quality of an investment.
The Internal Rate of Return is the Value of the Discount
Rate at which the NPV is equal to zero, or at which ΣDCF
equals the Initial Investment.
Σ CF/ (1 + IRR)n = Initial Investment
The value of IRR is usually obtained by an iterative process.
26
26

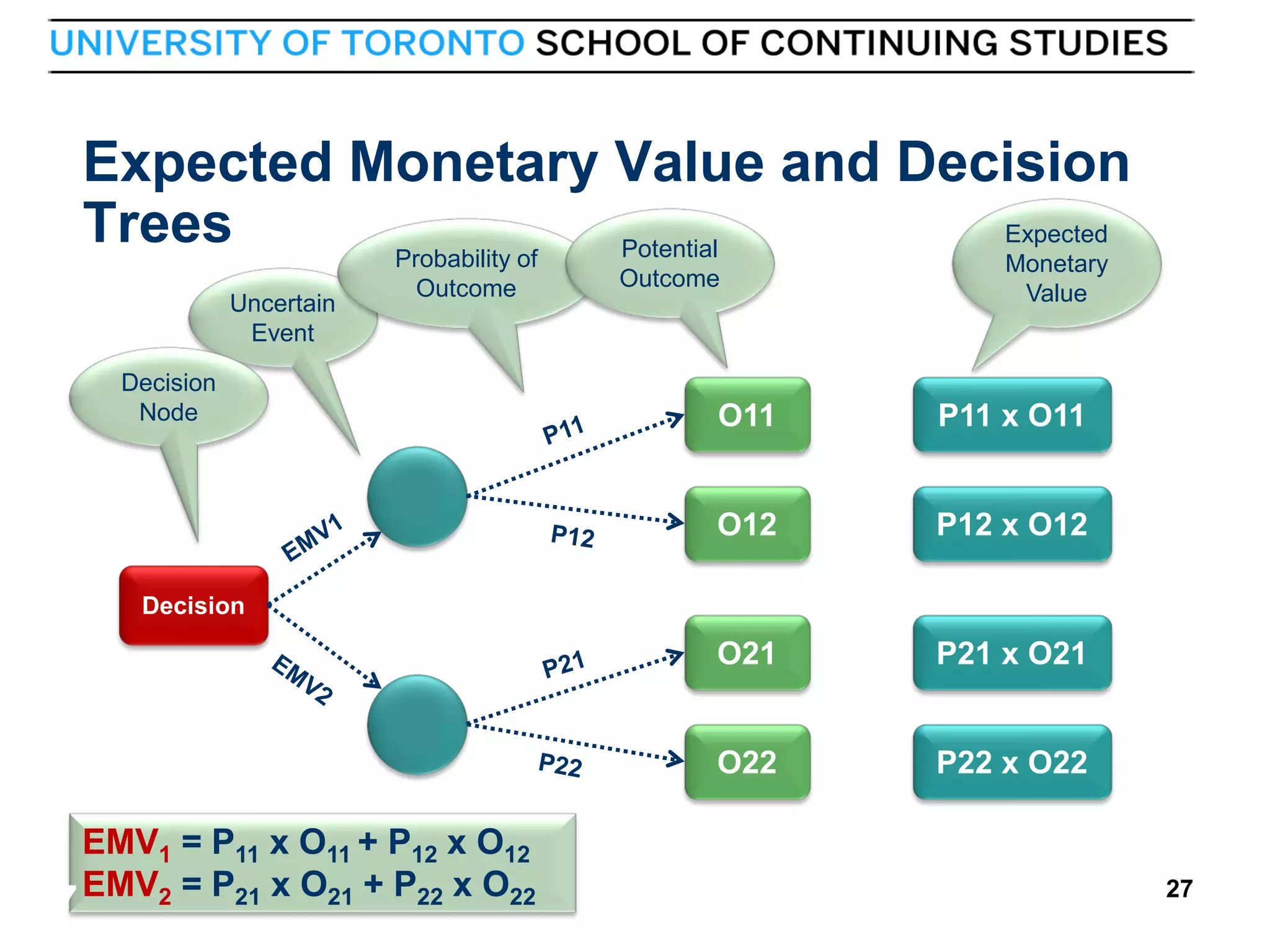

27. Expected Monetary Value and Decision
Trees
Expected
Potential
Probability of
Uncertain
Event
Outcome
Decision
Node
Outcome
Monetary
Value
O11
P11 x O11
O12
P12 x O12
O21
P21 x O21
O22
P22 x O22
Decision
27
EMV1 = P11 x O11 + P12 x O12
EMV2 = P21 x O21 + P22 x O22
27
28. Example: Choosing
between 2 Projects
Outcome
probability
Potential
outcome
Possible
choices
20%
Bid on
Project 1
80%
EMV per
outcome
Profit of
$300,000
Total
EMV
60,000
+
Loss of
$40,000
-32,000
Profit of
$60,000
42,000
= $28,000
Decision
70%
Bid on
Project 2
10%
+
Loss of
$20,000
20%
28
-2,000
+
Loss of
$50,000
-10,000
= $30,000
28
29. Balanced Scorecard Approach
It is a performance
management approach that
involves measuring a
company’s vision and
strategy via four perspectives.
Financial
Perspective
How do we look to our
shareholders or to those
who provide funding to
us?
Customer
Perspective
Innovation and
Learning Perspective
How do we look to our
customers and other
stakeholders?
How do we keep getting
better?
By balancing internal process
measurement and financial
results with customer
feedback, the performance
picture becomes complete.
29
Internal Processes
Perspective
What internal processes
we must excel at in order
to attract and retain our
customers and other key
stakeholders?
29
Source: IT Project Management,
J Marchewka, J Wiley & Sons
30. Project Integration Management
• Project Integration Management includes the processes and
activities needed to identify, define, combine, unify and
coordinate the various processes and project management
activities
• Integration includes characteristics of unification, consolidation,
articulation and integrative actions that are crucial to project
completion
30
30
31. Project Integration Management
Processes
31
4.1 Develop Project Charter: working with stakeholders to
create the document that formally authorizes a project
4.2 Develop Project Management Plan: coordinating all
planning efforts to create a consistent, coherent document
4.3 Direct and Manage Project Work: carrying out the project
management plan by performing the activities included in it
4.4 Monitor and Control Project Work: overseeing project
work to meet the performance objectives of the project
4.5 Perform Integrated Change Control: coordinating changes
that affect the project’s deliverables and organizational process
assets
4.6 Close Project or Phase: finalizing all project activities to
formally close the project
31

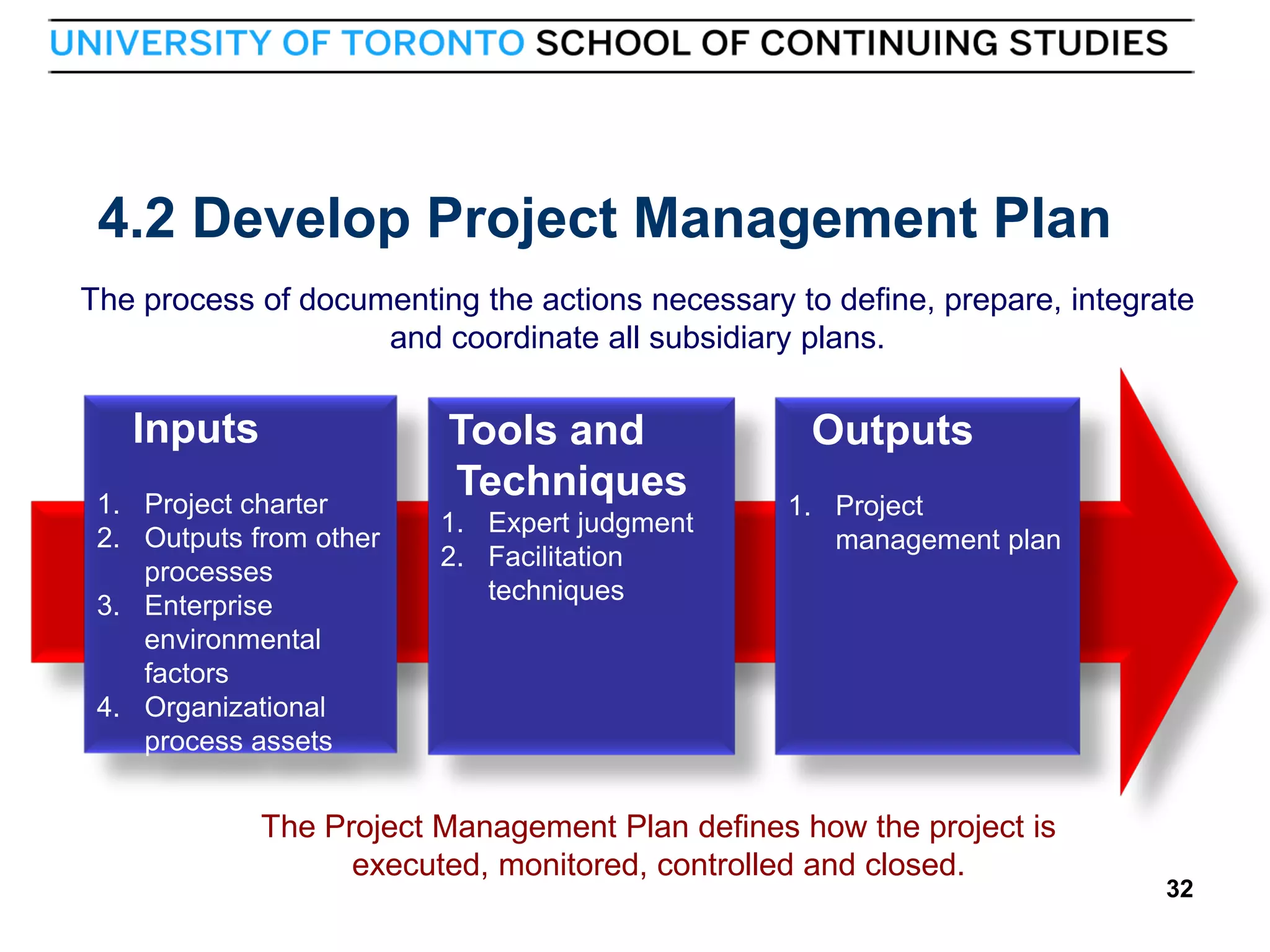

32. 4.2 Develop Project Management Plan
The process of documenting the actions necessary to define, prepare, integrate
and coordinate all subsidiary plans.
Inputs
1. Project charter
2. Outputs from other
processes
3. Enterprise
environmental
factors
4. Organizational
process assets
Tools and
Techniques
1. Expert judgment
2. Facilitation
techniques
Outputs
1. Project
management plan
The Project Management Plan defines how the project is
executed, monitored, controlled and closed.
32
32

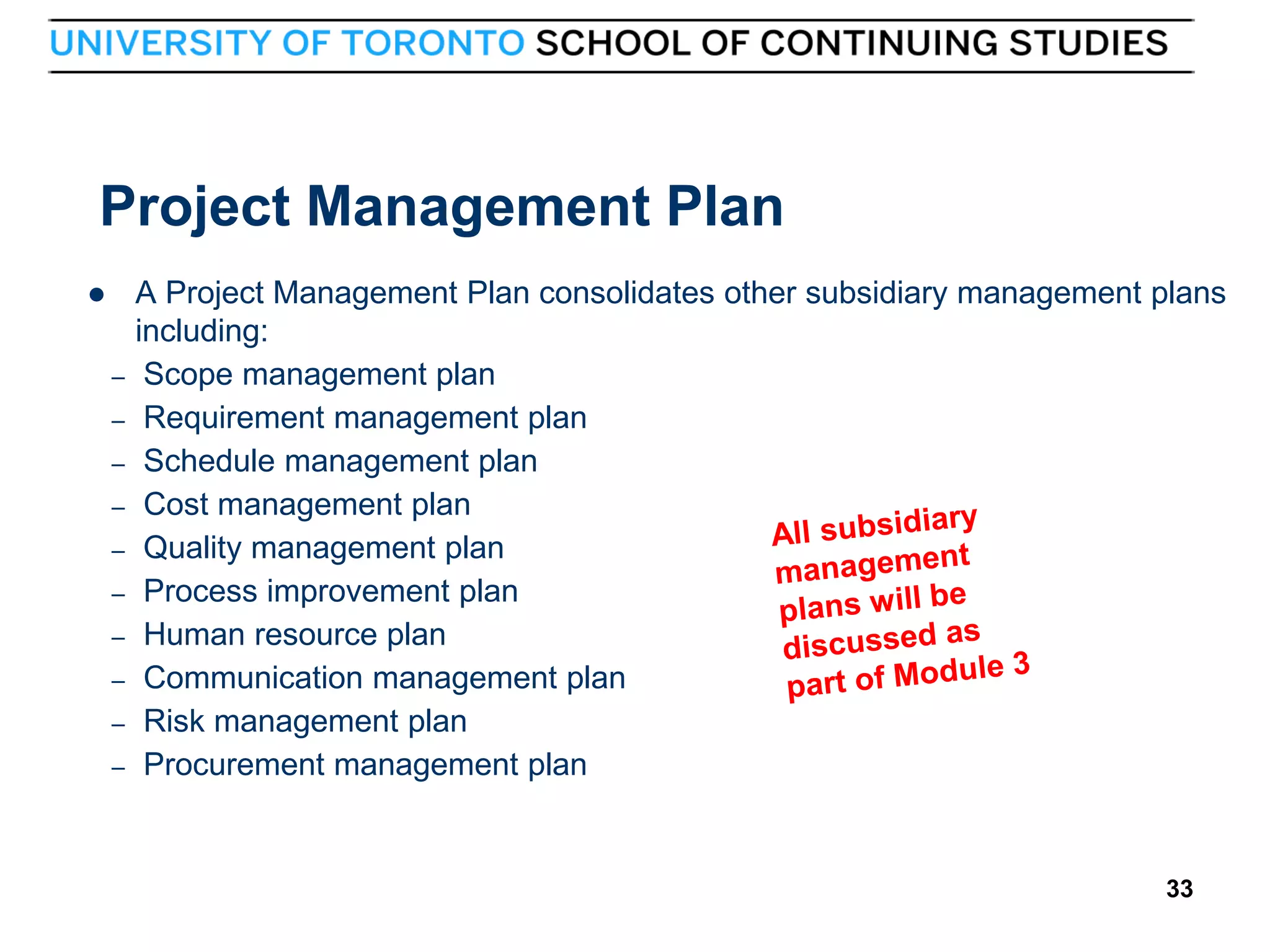

33. Project Management Plan
–
–
–
–
–
–
–
–
–
–
33
A Project Management Plan consolidates other subsidiary management plans
including:
Scope management plan
Requirement management plan
Schedule management plan
Cost management plan
Quality management plan
Process improvement plan
Human resource plan
Communication management plan
Risk management plan
Procurement management plan
33
34. Project Management Plan (continued)
–
–
–
–
–
–
–
–
–
–
–
34
A Project Management Plan includes:
Project Charter
Budget
Schedule
Resources
Scope Statement
WBS
Responsibility charts/assignments
Management Plans
The Project Management Plan also includes project baselines, including:
Schedule baseline
Cost performance baseline and
Scope baseline
34

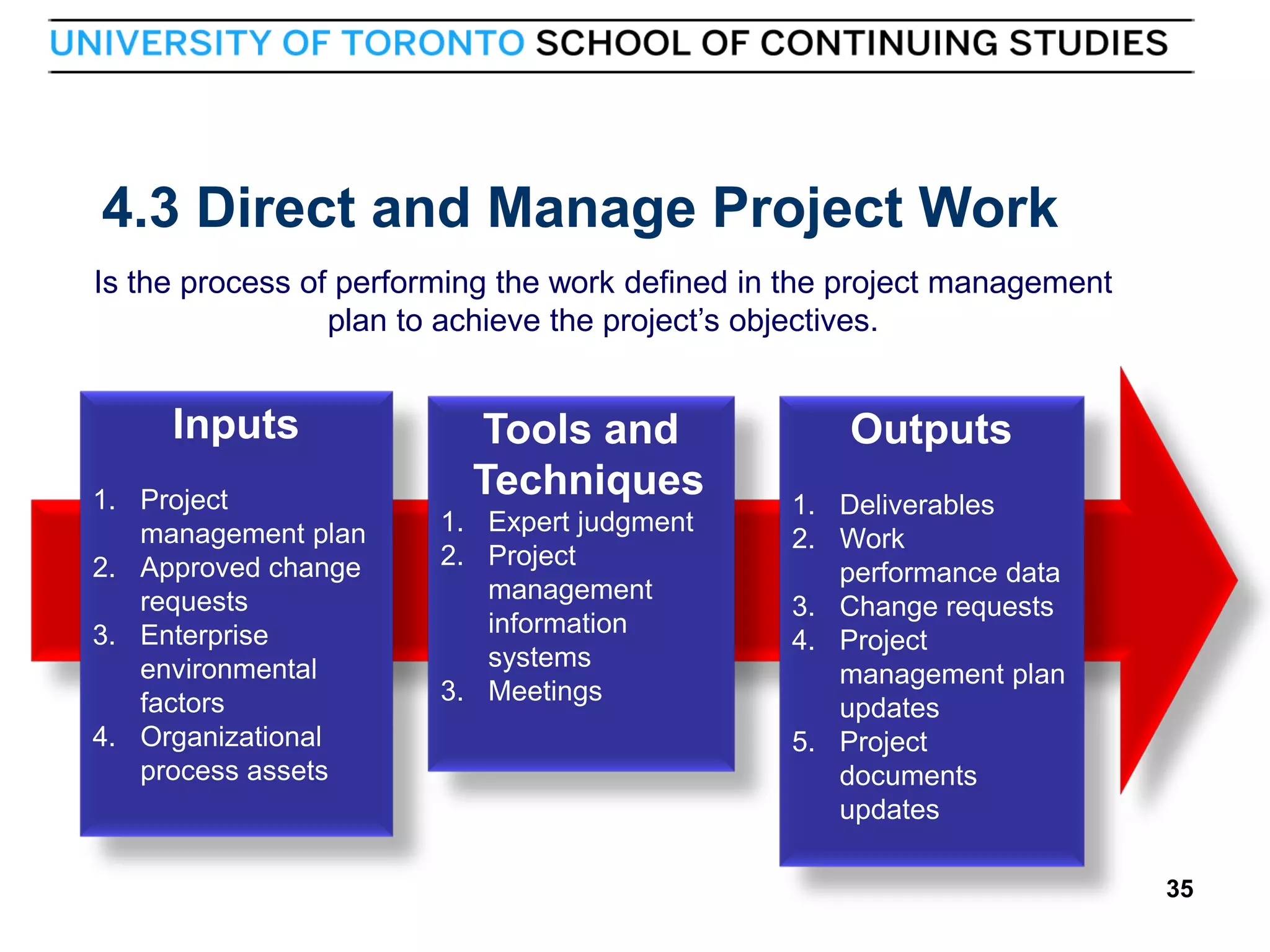

35. 4.3 Direct and Manage Project Work
Is the process of performing the work defined in the project management
plan to achieve the project’s objectives.
Inputs
1. Project
management plan
2. Approved change
requests
3. Enterprise
environmental
factors
4. Organizational
process assets
35
Tools and
Techniques
1. Expert judgment
2. Project
management
information
systems
3. Meetings
Outputs
1. Deliverables
2. Work
performance data
3. Change requests
4. Project
management plan
updates
5. Project
documents
updates
35
36. Direct and Manage Project Execution
The process includes:
–
–
–
–
–
–
–
–
–
–
36
Perform activities to accomplish project requirements
Create project deliverables
Staff, train, and manage the team members assigned
Obtain, manage, and use resources
Implement the planned methods
Establish and manage project communication channels
Generate project data, such as cost, schedule, technical progress, and
status
Manage risks and implement risk response activities
Manage sellers and suppliers
Collect and document lessons learned
36

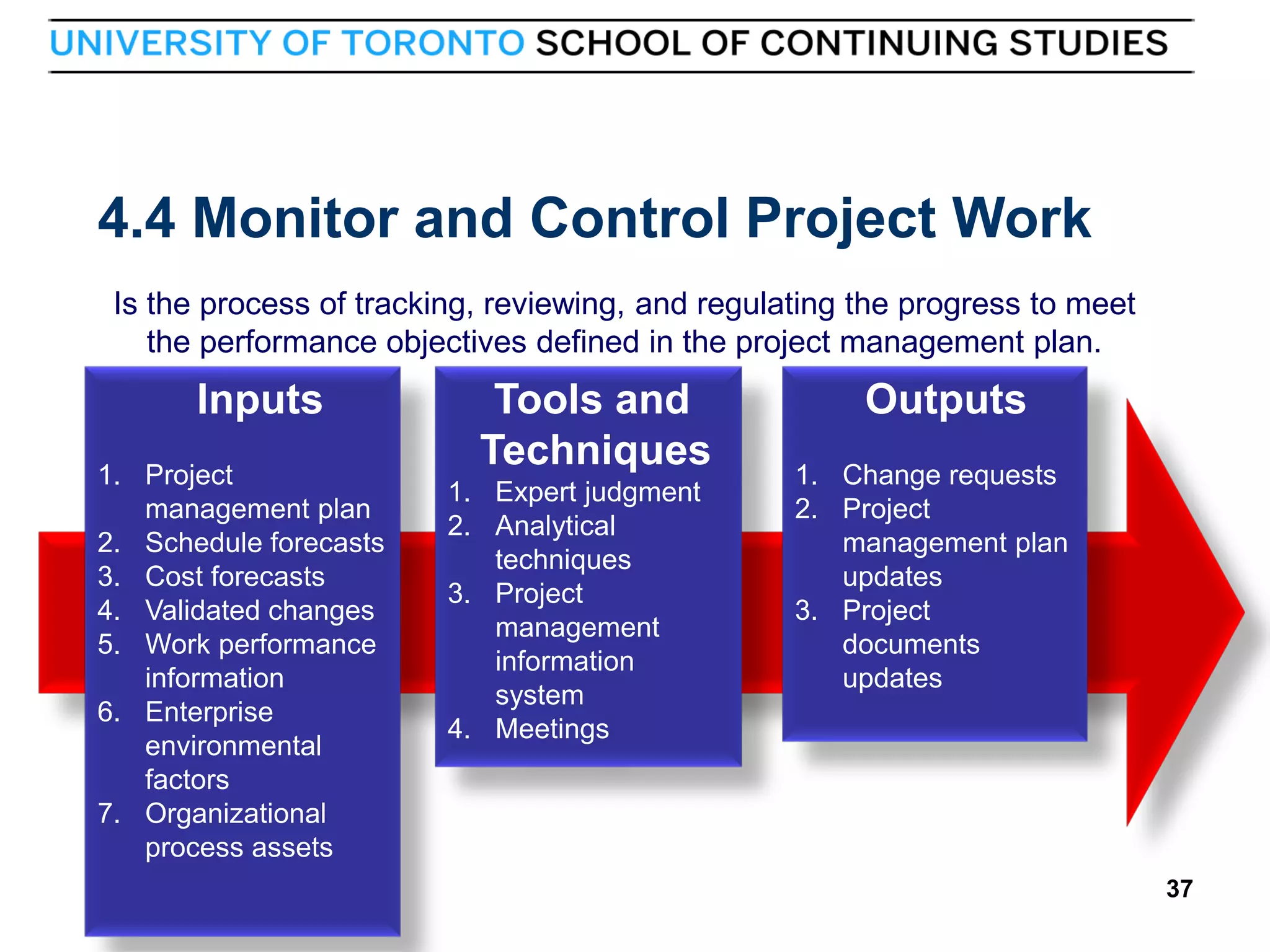

37. 4.4 Monitor and Control Project Work
Is the process of tracking, reviewing, and regulating the progress to meet
the performance objectives defined in the project management plan.
Inputs
1. Project
management plan
2. Schedule forecasts
3. Cost forecasts
4. Validated changes
5. Work performance
information
6. Enterprise
environmental
factors
7. Organizational
process assets
37
Tools and
Techniques
1. Expert judgment
2. Analytical
techniques
3. Project
management
information
system
4. Meetings
Outputs
1. Change requests
2. Project
management plan
updates
3. Project
documents
updates
37
38. Monitor and Control Project Work
• The process is concerned with:
– Comparing actual project performance against the project
management plan
– Assessing performance to determine whether corrective or
preventive actions are required
– Identifying new risks, and analyzing, tracking, and monitoring
existing project risks
– Maintaining an accurate, timely information base concerning the
project’s product
– Providing information to support status reporting, and forecasting
– Monitoring implementation of approved changes as they occur
38
38
39. 4.5 Perform Integrated Change Control
Is the process of reviewing all change requests, approving changes and managing
changes to the deliverables, organizational process assets, project documents and
the project management plan
Inputs
1. Project
management plan
2. Work performance
information
3. Change requests
4. Enterprise
environmental
factors
5. Organizational
process assets
39
Tools and
Techniques
1. Expert judgment
2. Meetings
3. Change control tools
Outputs
1. Approved change
requests
2. Change log
3. Project
management plan
updates
4. Project documents
updates
39

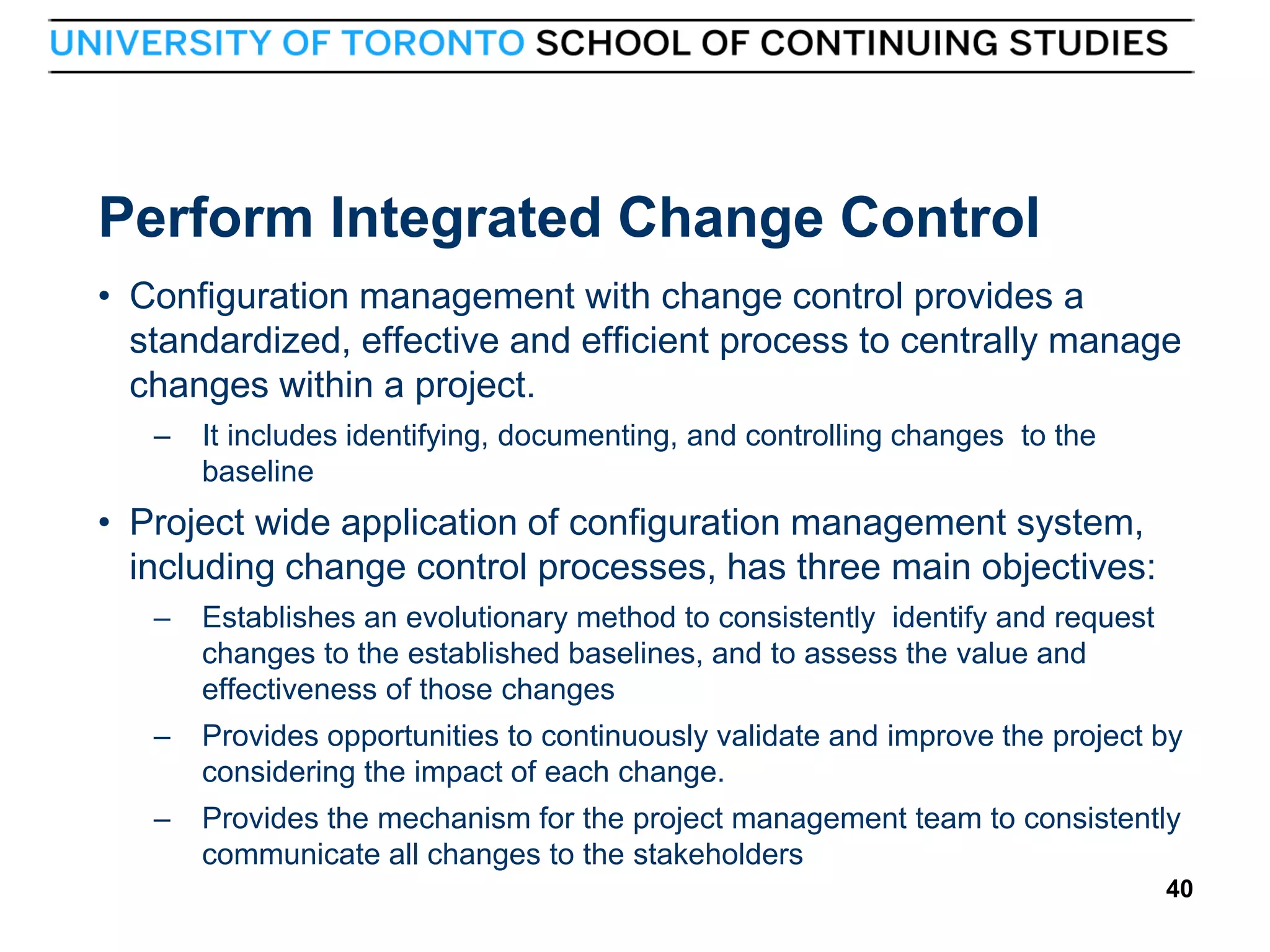

40. Perform Integrated Change Control
• Configuration management with change control provides a
standardized, effective and efficient process to centrally manage
changes within a project.
–
It includes identifying, documenting, and controlling changes to the
baseline
• Project wide application of configuration management system,
including change control processes, has three main objectives:
–
–
Provides opportunities to continuously validate and improve the project by
considering the impact of each change.
–
40
Establishes an evolutionary method to consistently identify and request
changes to the established baselines, and to assess the value and
effectiveness of those changes
Provides the mechanism for the project management team to consistently
communicate all changes to the stakeholders
40

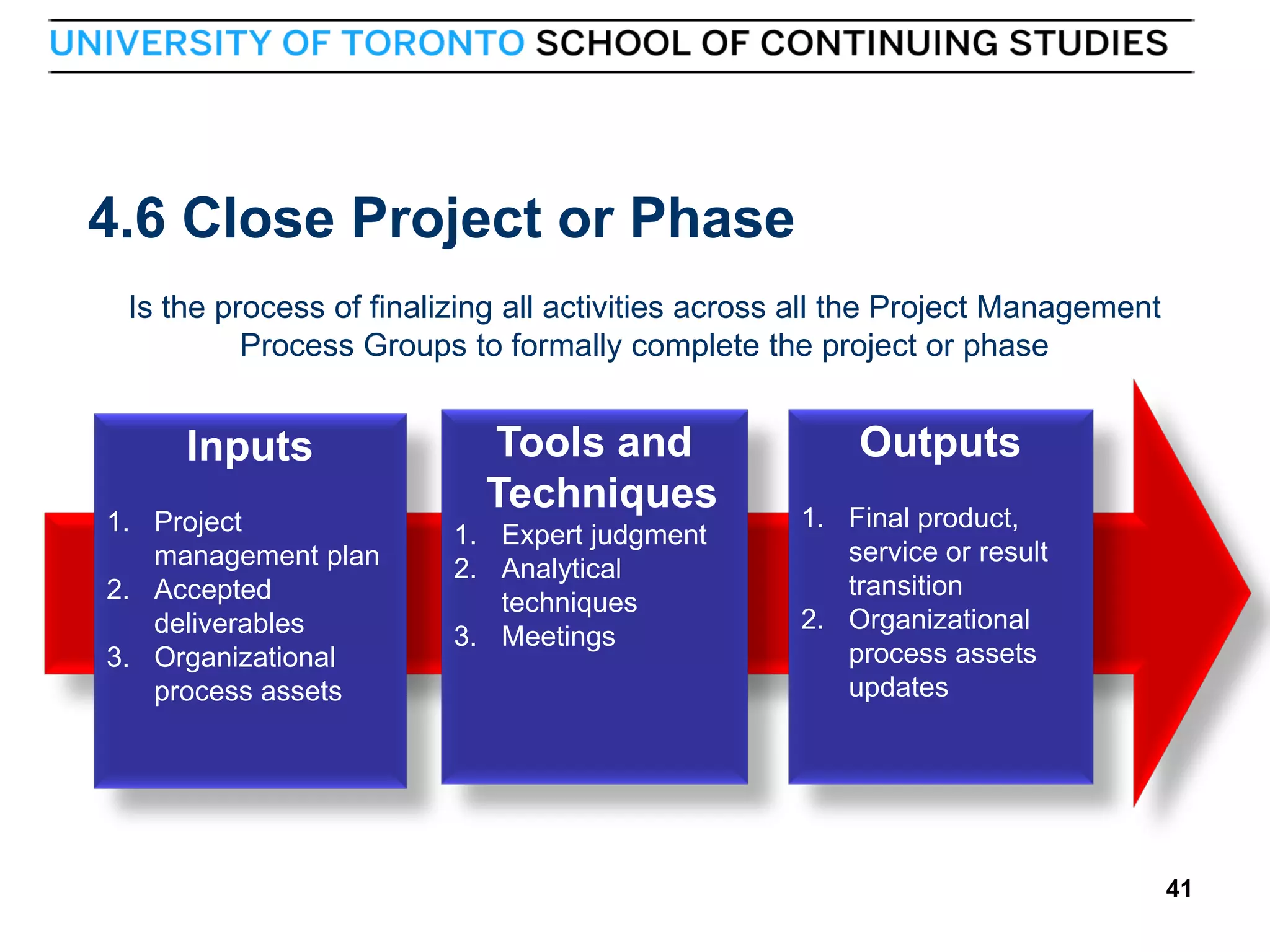

41. 4.6 Close Project or Phase
Is the process of finalizing all activities across all the Project Management
Process Groups to formally complete the project or phase
Inputs
1. Project
management plan
2. Accepted
deliverables
3. Organizational
process assets
41
Tools and
Techniques
1. Expert judgment
2. Analytical
techniques
3. Meetings
Outputs
1. Final product,
service or result
transition
2. Organizational
process assets
updates
41
42. Close Project or Phase
The act of completing a project or a phase of a project, either because it
has been completed or because it has been terminated early.
•
•
•
•
42
The close project or phase process also establishes the procedures to
investigate and document the reasons for actions taken if a project is
terminated before completion
Includes all of the activities necessary for administrative closure of the
project or phase
Also includes Releasing team members
Celebration of completion
42
