Oh ffs, can we please
stop estimating
Olga Loyev
Introduction
Why are we here?
Let’s step back

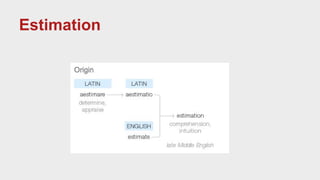

Estimation
What is it we’re trying to achieve?
What we did
Can we do better?
Work in Progress
= # of things in being
worked on
Lead Time
= Time from start to finish
Throughput
= How much you get
done per period of time

Looking at our data
The less guessing you do,
the better

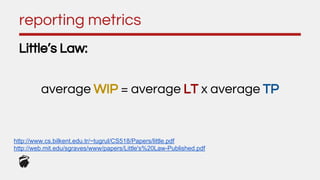

reporting metrics
Little’s Law:
average WIP = average LT x average TP
http://www.cs.bilkent.edu.tr/~tugrul/CS518/Papers/little.pdf
http://web.mit.edu/sgraves/www/papers/Little's%20Law-Published.pdf
Conditions/assumptions:
● Items of similar size
● Conservation of flow: departure rate =
average arrival rate
● All work items that enter the system will
eventually be completed and will exit the
system
How do we apply it?
Time to complete = N/aTP
Or
Time to complete = N* (aLT/aWIP)
Size of stories?
●
Transition mid project
Risk/issues/considerations?
Time/Price at start of project?
- Data
Time/Price at start of project?
- NO Data
Forecast future release

Milestones
Final thoughts

Oh ffs, can we please stop estimating
