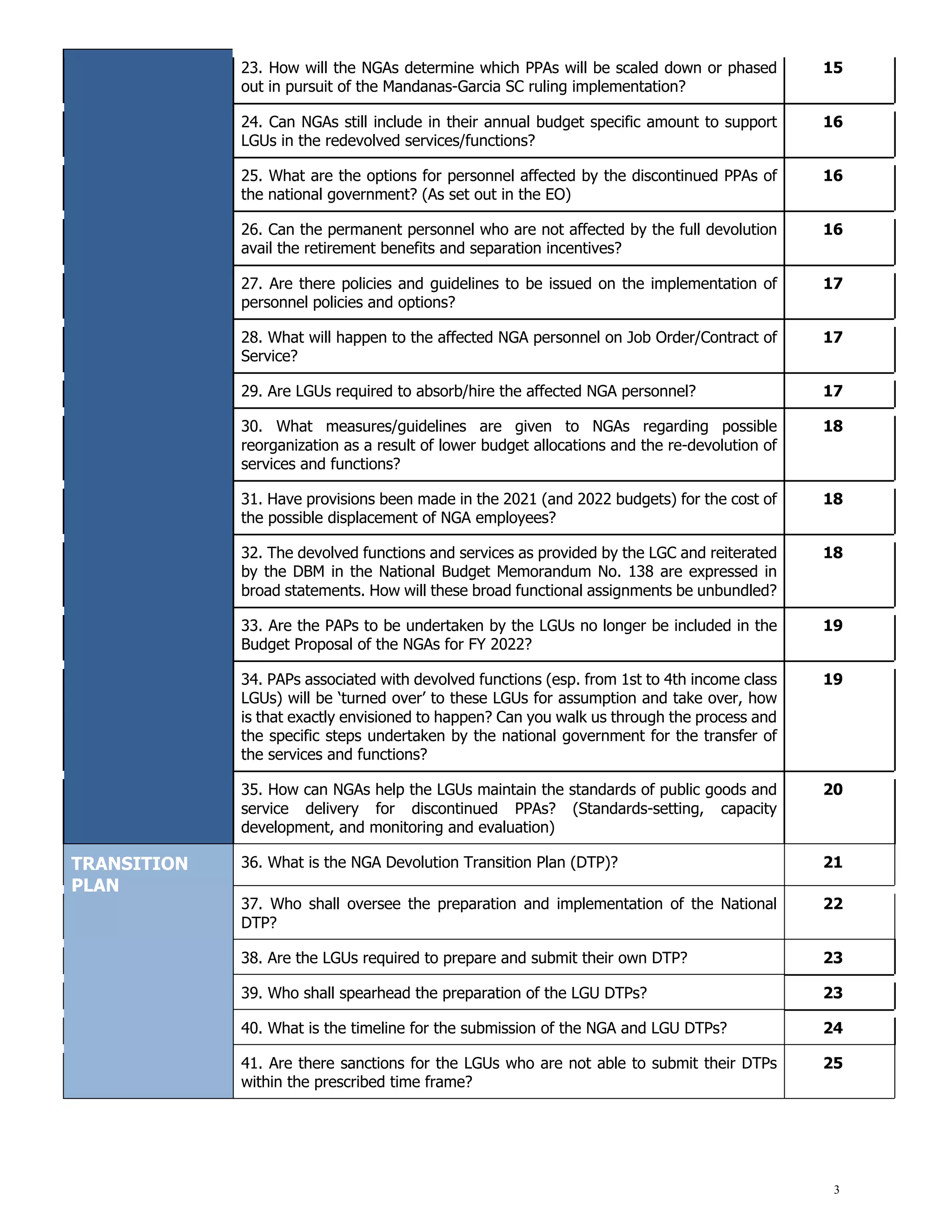

The document provides answers to frequently asked questions regarding the Mandanas-Garcia Supreme Court ruling which increased the tax base used to calculate the Internal Revenue Allotment of local government units from national internal revenue taxes to all national taxes. Key points include:

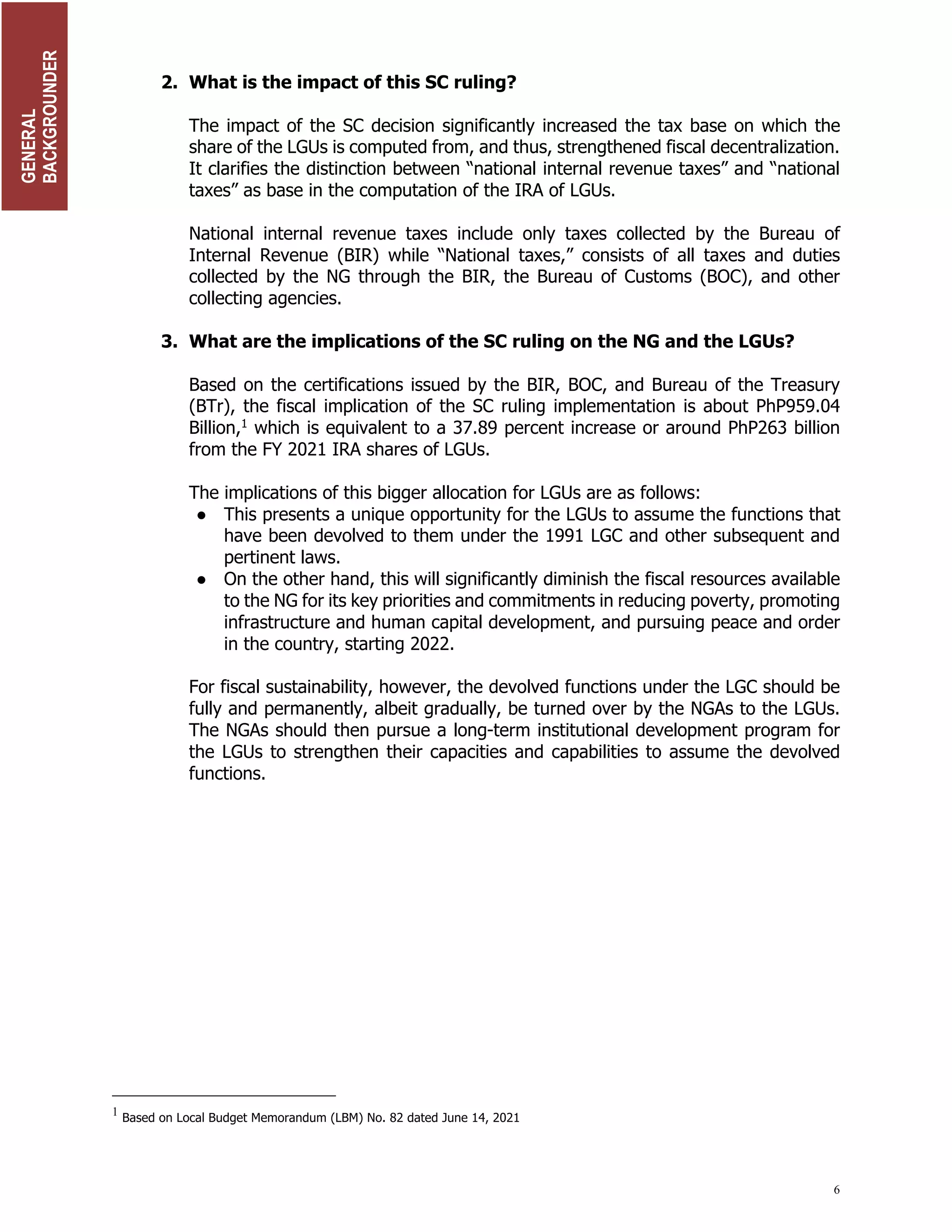

- The ruling significantly increases LGU shares by about 37.89% or PHP 263 billion for FY 2022, presenting opportunities for LGUs to assume devolved functions but also diminishing national government fiscal resources.
- The national tax allotment is determined based on the 40% share of LGUs in the collection of national taxes from the third fiscal year preceding the budget year as certified by revenue collecting agencies.
- Guidelines require LGU
