The Right Collaboration,
Leveraging Outsourcing Services to Focus on
Core Competencies

Presented By Exel and MavenWire
       Terrell Brown and Samuel Levin
June 22, 2009

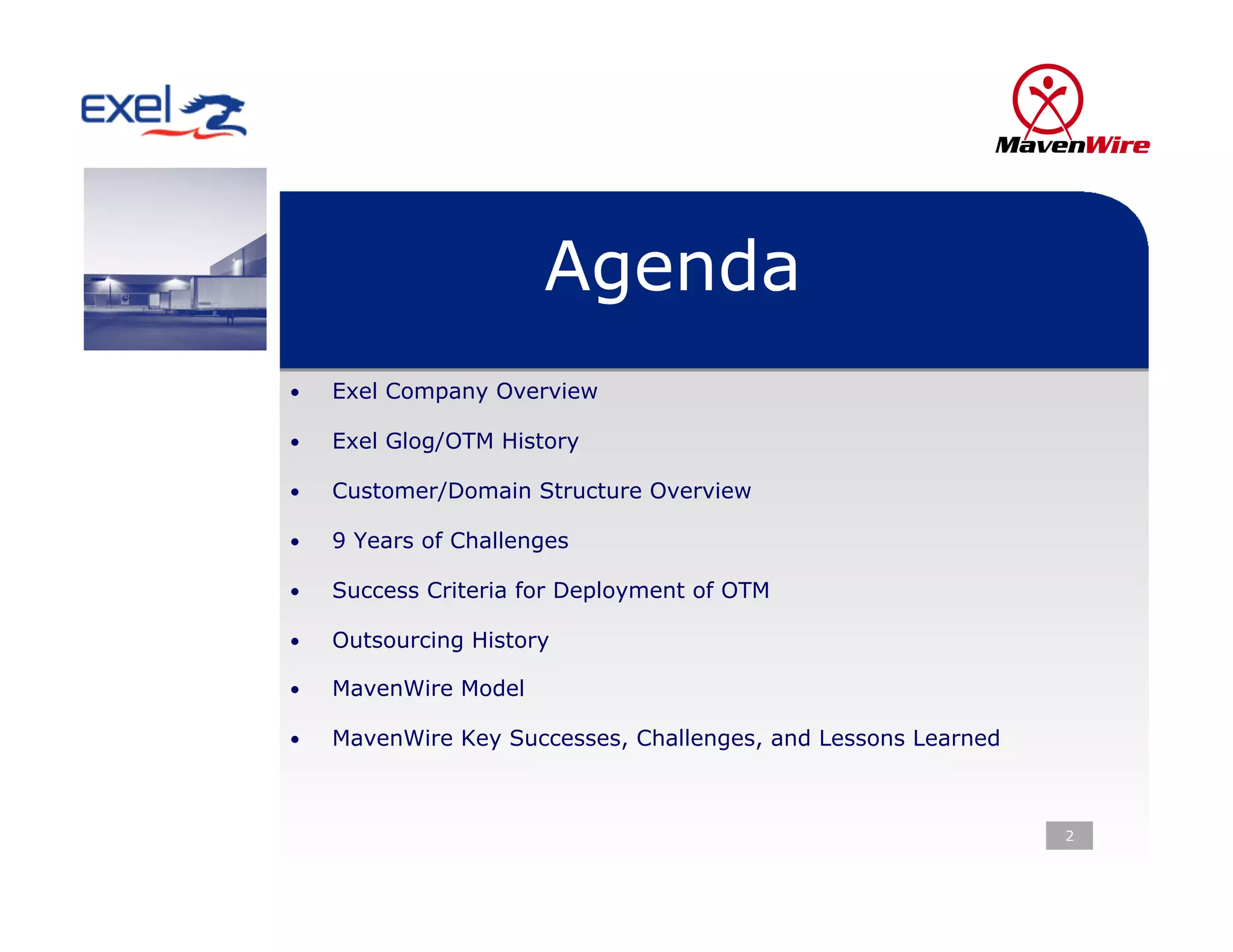

Agenda
•    Exel Company Overview

•    Exel Glog/OTM History

•    Customer/Domain Structure Overview

•    9 Years of Challenges

•    Success Criteria for Deployment of OTM

•    Outsourcing History

•    MavenWire Model

•    MavenWire Key Successes, Challenges, and Lessons Learned

                                                                2

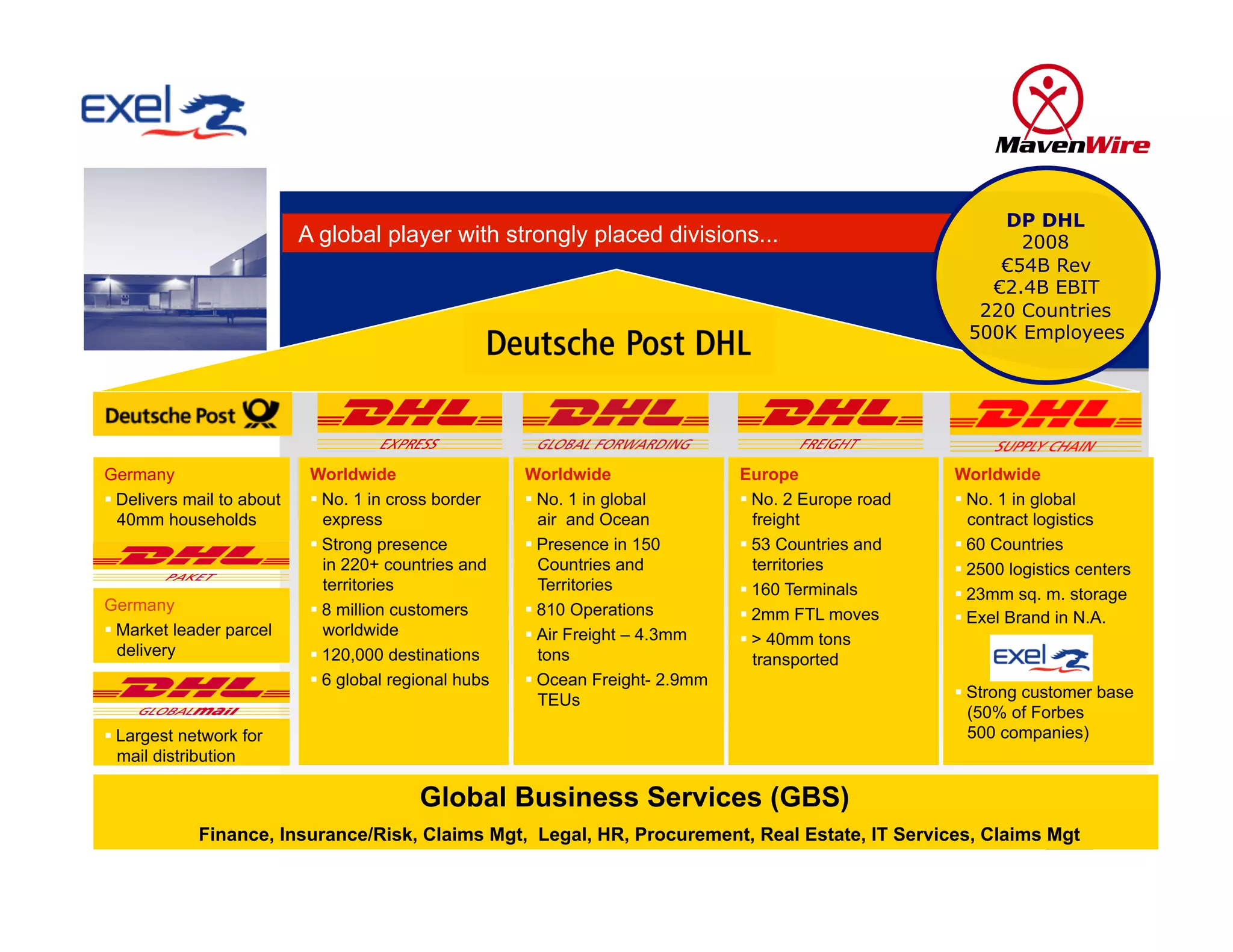

DP DHL
                           A global player with strongly placed divisions...                          2008
                                                                                                   € 54B Rev
                                                                                                  € 2.4B EBIT
                                                                                                 220 Countries
                                                                                                500K Employees

Germany
 Delivers mail to about
  40mm households

                                       Global Business Services (GBS)
            Finance, Insurance/Risk, Claims Mgt, Legal, HR, Procurement, Real Estate, IT Services, Claims Mgt
                                                                                                           3

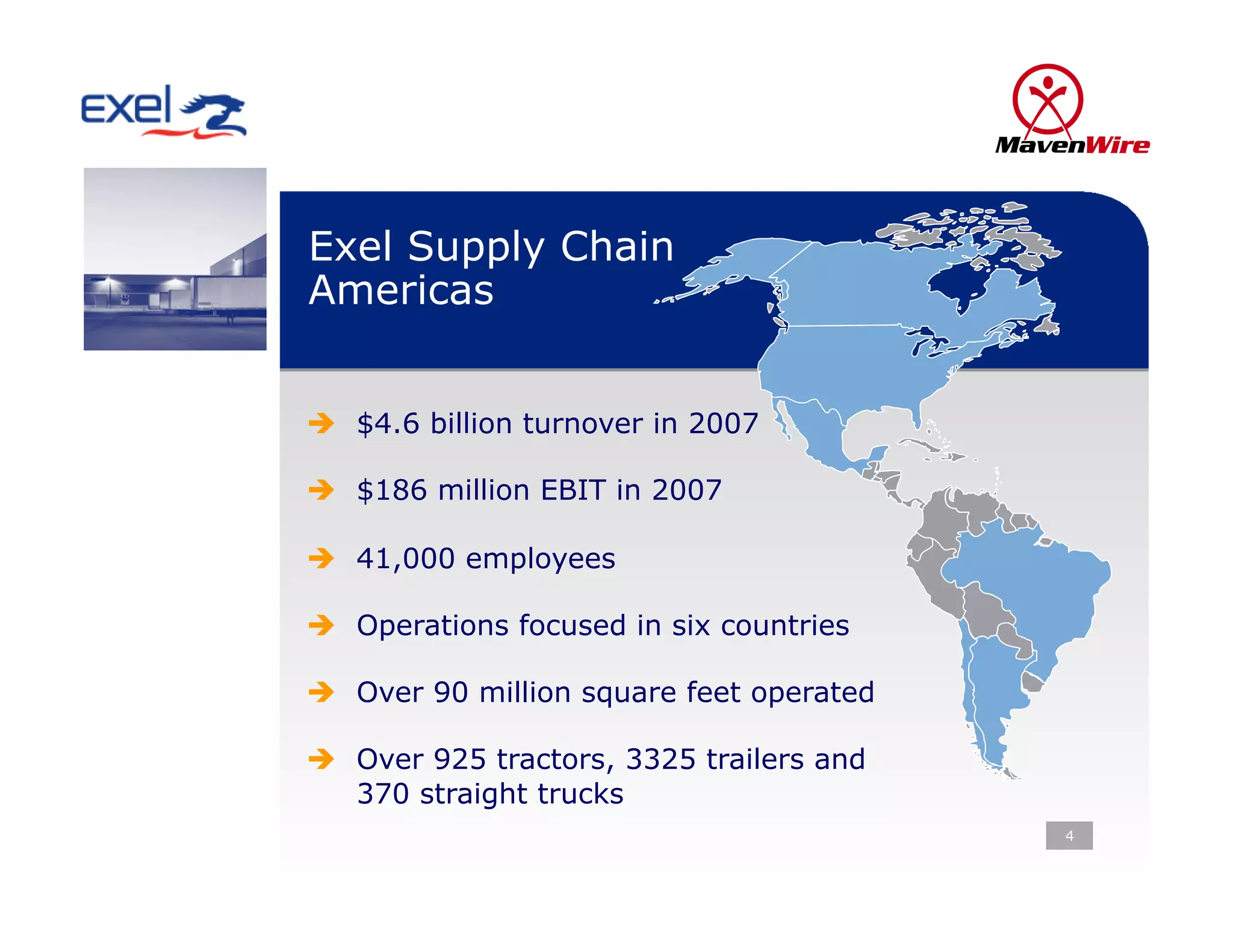

Exel Supply Chain
Americas

  $4.6 billion turnover in 2007

  $186 million EBIT in 2007

  41,000 employees

  Operations focused in six countries

  Over 90 million square feet operated

  Over 925 tractors, 3325 trailers and
   370 straight trucks
                                          4

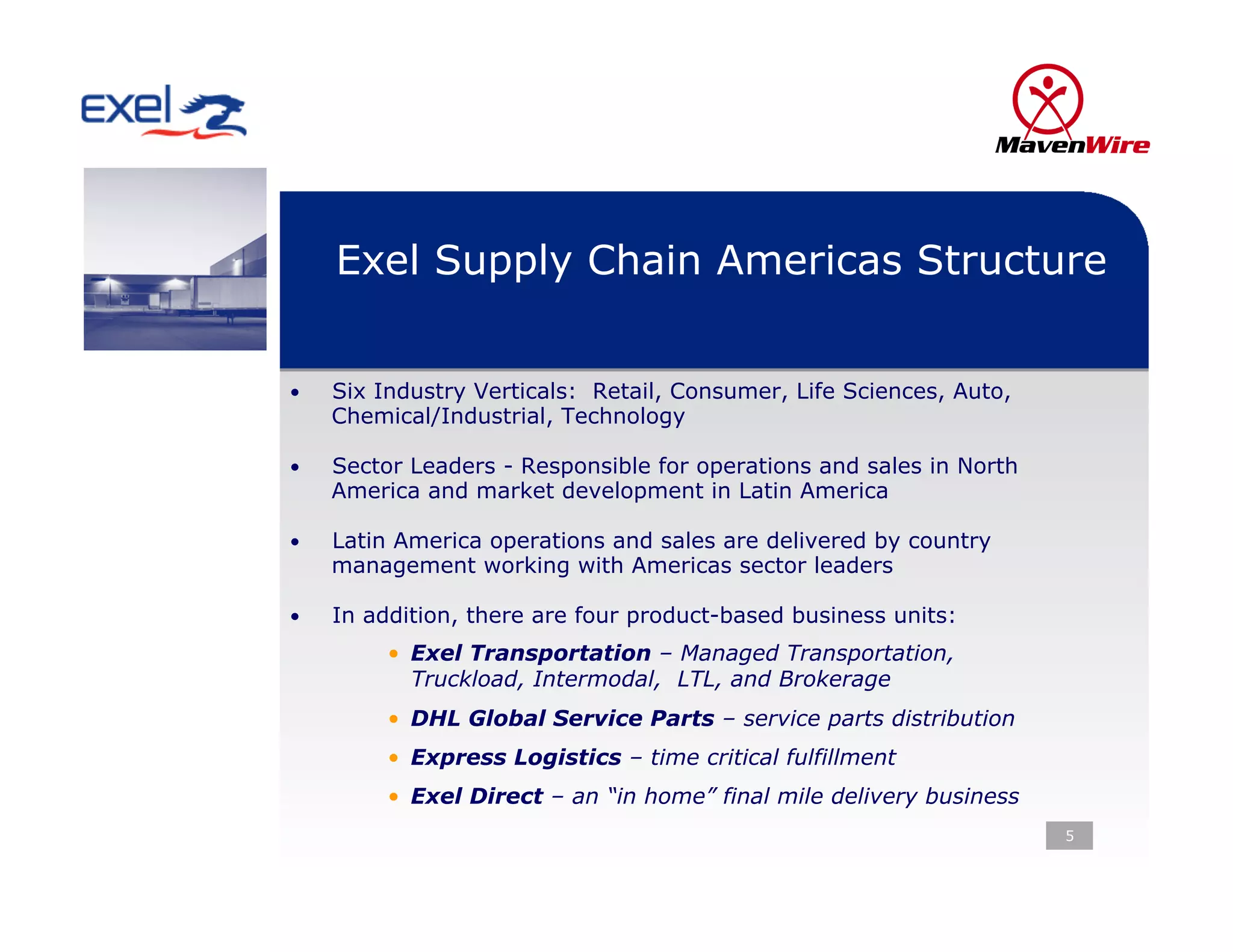

Exel Supply Chain Americas Structure

•    Six Industry Verticals: Retail, Consumer, Life Sciences, Auto,
     Chemical/Industrial, Technology

•    Sector Leaders - Responsible for operations and sales in North
     America and market development in Latin America

•    Latin America operations and sales are delivered by country
     management working with Americas sector leaders

•    In addition, there are four product-based business units:
          •  Exel Transportation – Managed Transportation,
             Truckload, Intermodal, LTL, and Brokerage
          •  DHL Global Service Parts – service parts distribution
          •  Express Logistics – time critical fulfillment
          •  Exel Direct – an “in home” final mile delivery business
                                                                       5

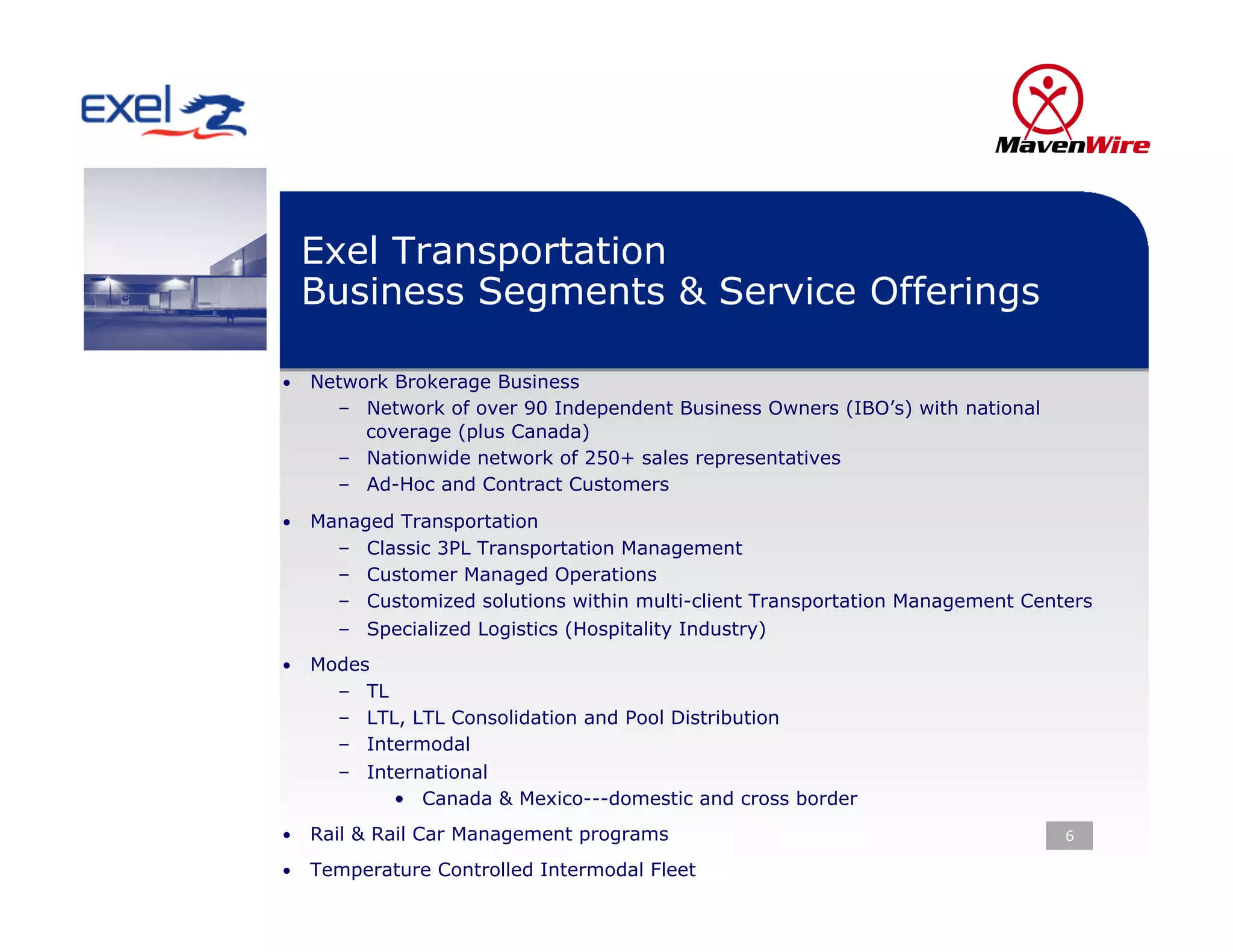

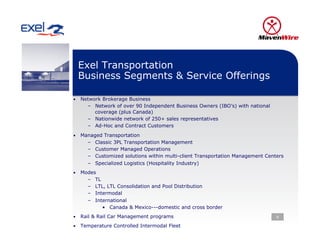

Exel Transportation
 Business Segments & Service Offerings

•  Network Brokerage Business
     –  Network of over 90 Independent Business Owners (IBO’s) with national
        coverage (plus Canada)
     –  Nationwide network of 250+ sales representatives
     –  Ad-Hoc and Contract Customers
•  Managed Transportation
     –    Classic 3PL Transportation Management
     –    Customer Managed Operations
     –    Customized solutions within multi-client Transportation Management Centers
     –    Specialized Logistics (Hospitality Industry)
•  Modes
     –    TL
     –    LTL, LTL Consolidation and Pool Distribution
     –    Intermodal
     –    International
             •  Canada & Mexico---domestic and cross border
•  Rail & Rail Car Management programs                                           6

•  Temperature Controlled Intermodal Fleet
Exel’s North America
Transportation Customers

                           7

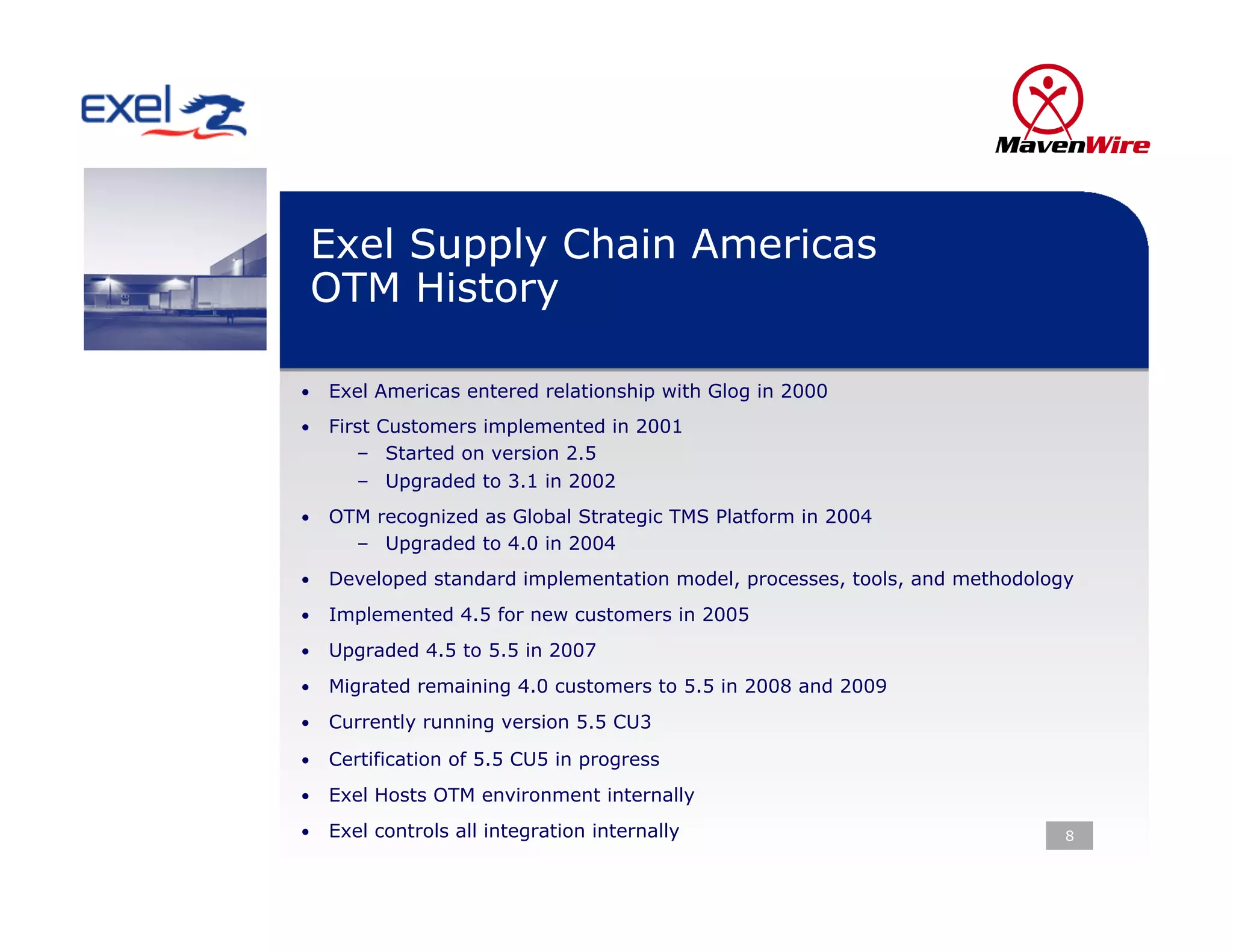

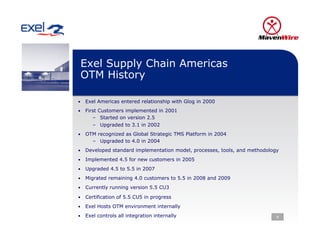

Exel Supply Chain Americas
 OTM History

•  Exel Americas entered relationship with Glog in 2000

•  First Customers implemented in 2001
      –  Started on version 2.5
      –  Upgraded to 3.1 in 2002
•  OTM recognized as Global Strategic TMS Platform in 2004
      –  Upgraded to 4.0 in 2004
•  Developed standard implementation model, processes, tools, and methodology

•  Implemented 4.5 for new customers in 2005

•  Upgraded 4.5 to 5.5 in 2007

•  Migrated remaining 4.0 customers to 5.5 in 2008 and 2009

•  Currently running version 5.5 CU3

•  Certification of 5.5 CU5 in progress

•  Exel Hosts OTM environment internally

•  Exel controls all integration internally                                 8

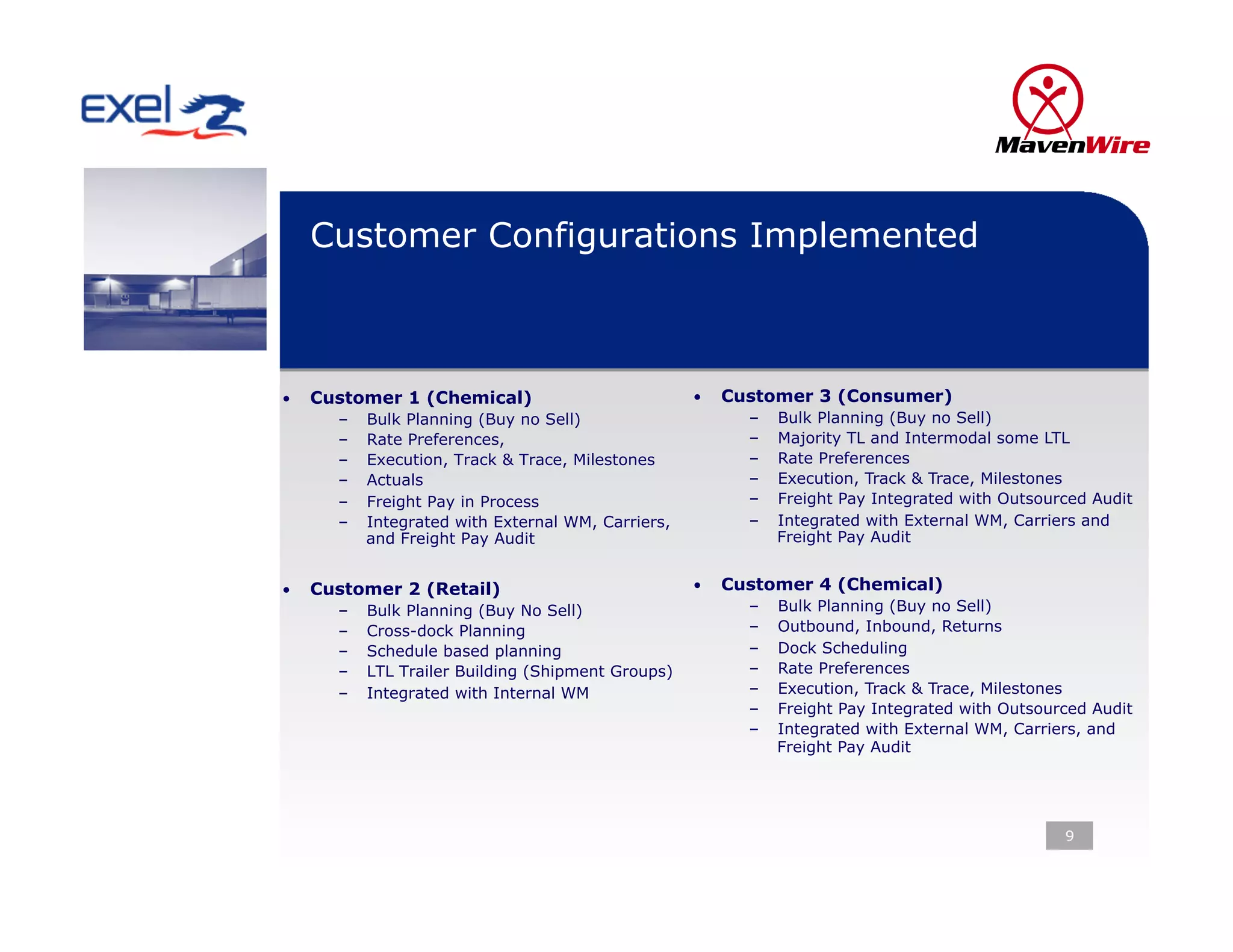

Customer Configurations Implemented

•    Customer 1 (Chemical)                           •    Customer 3 (Consumer)
       –    Bulk Planning (Buy no Sell)                     –    Bulk Planning (Buy no Sell)
       –    Rate Preferences,                               –    Majority TL and Intermodal some LTL
       –    Execution, Track & Trace, Milestones            –    Rate Preferences
       –    Actuals                                         –    Execution, Track & Trace, Milestones
       –    Freight Pay in Process                          –    Freight Pay Integrated with Outsourced Audit
       –    Integrated with External WM, Carriers,          –    Integrated with External WM, Carriers and
            and Freight Pay Audit                                Freight Pay Audit

•    Customer 2 (Retail)                             •    Customer 4 (Chemical)
       –    Bulk Planning (Buy No Sell)                     –    Bulk Planning (Buy no Sell)
       –    Cross-dock Planning                             –    Outbound, Inbound, Returns
       –    Schedule based planning                         –    Dock Scheduling
       –    LTL Trailer Building (Shipment Groups)          –    Rate Preferences
       –    Integrated with Internal WM                     –    Execution, Track & Trace, Milestones
                                                            –    Freight Pay Integrated with Outsourced Audit
                                                            –    Integrated with External WM, Carriers, and
                                                                 Freight Pay Audit

                                                                                                    9

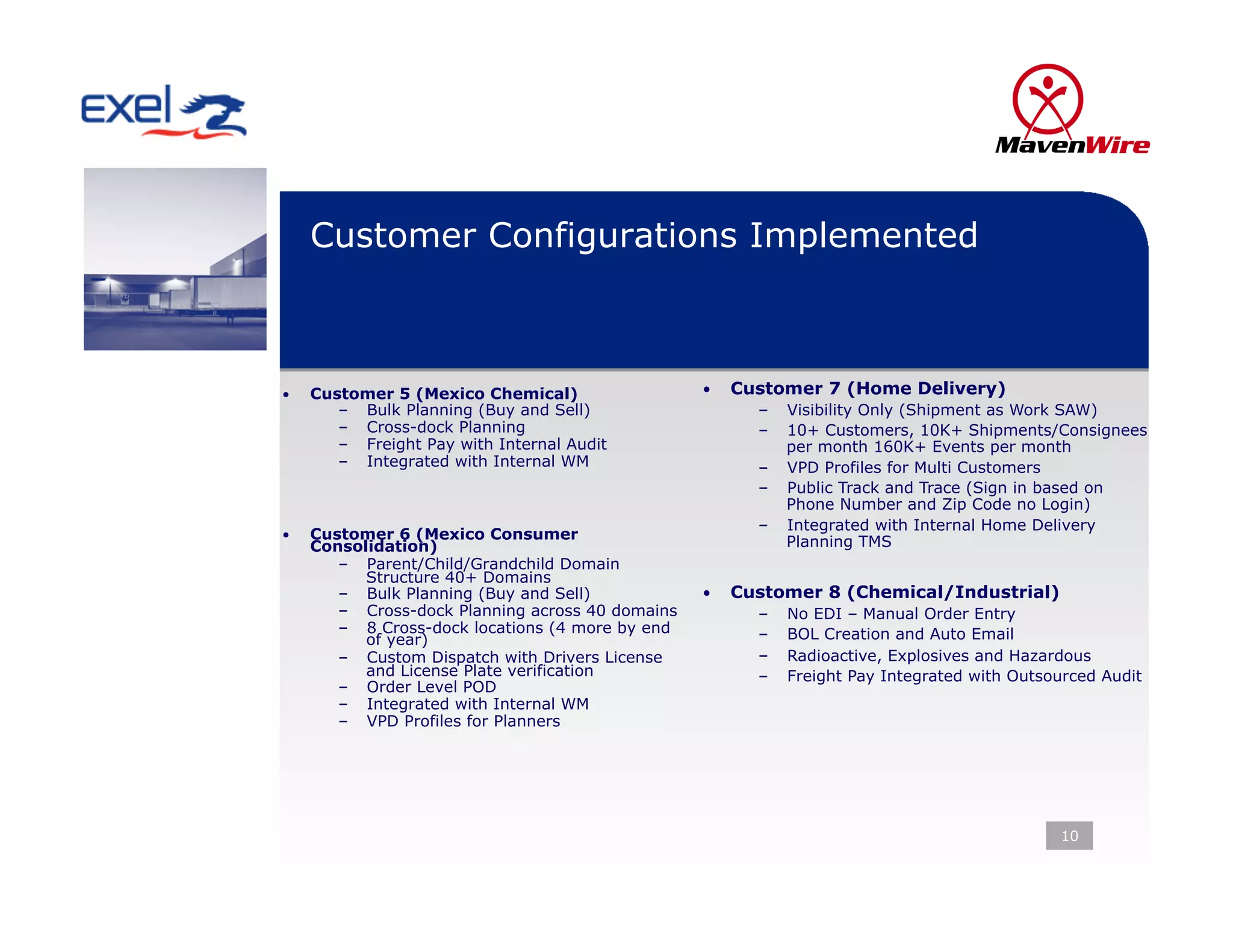

Customer Configurations Implemented

•    Customer 5 (Mexico Chemical)                  •    Customer 7 (Home Delivery)
        –  Bulk Planning (Buy and Sell)                   –    Visibility Only (Shipment as Work SAW)
        –  Cross-dock Planning                            –    10+ Customers, 10K+ Shipments/Consignees
        –  Freight Pay with Internal Audit                     per month 160K+ Events per month
        –  Integrated with Internal WM                    –    VPD Profiles for Multi Customers
                                                          –    Public Track and Trace (Sign in based on
                                                               Phone Number and Zip Code no Login)
                                                          –    Integrated with Internal Home Delivery
•    Customer 6 (Mexico Consumer                               Planning TMS
     Consolidation)
        –  Parent/Child/Grandchild Domain
           Structure 40+ Domains
        –  Bulk Planning (Buy and Sell)            •    Customer 8 (Chemical/Industrial)
        –  Cross-dock Planning across 40 domains          –    No EDI – Manual Order Entry
        –  8 Cross-dock locations (4 more by end          –    BOL Creation and Auto Email
           of year)
        –  Custom Dispatch with Drivers License           –    Radioactive, Explosives and Hazardous
           and License Plate verification                 –    Freight Pay Integrated with Outsourced Audit
        –  Order Level POD
        –  Integrated with Internal WM
        –  VPD Profiles for Planners

                                                                                                10

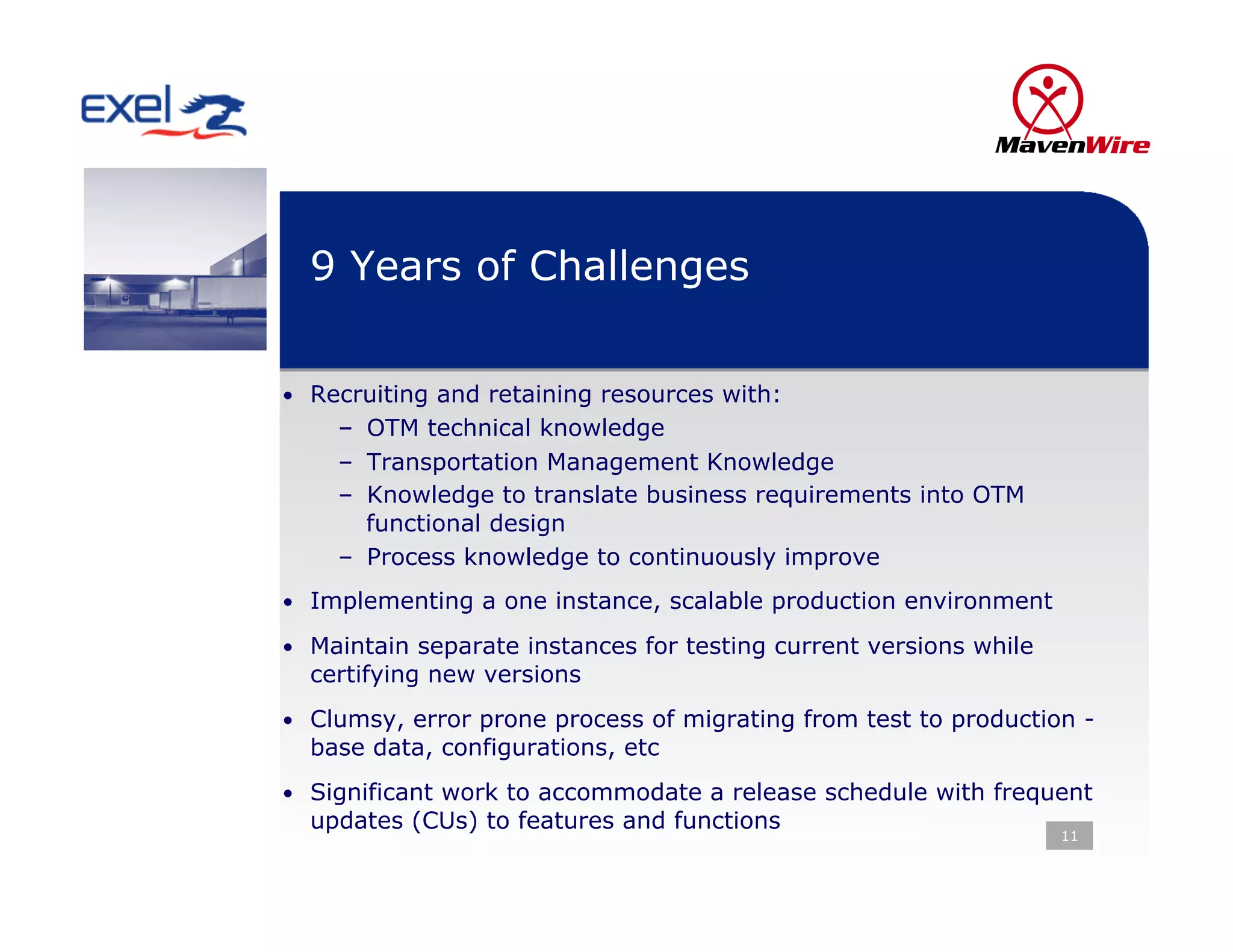

9 Years of Challenges

•  Recruiting and retaining resources with:
    –  OTM technical knowledge
    –  Transportation Management Knowledge
    –  Knowledge to translate business requirements into OTM
       functional design
    –  Process knowledge to continuously improve
•  Implementing a one instance, scalable production environment

•  Maintain separate instances for testing current versions while
  certifying new versions
•  Clumsy, error prone process of migrating from test to production -
  base data, configurations, etc
•  Significant work to accommodate a release schedule with frequent
  updates (CUs) to features and functions
                                                                    11

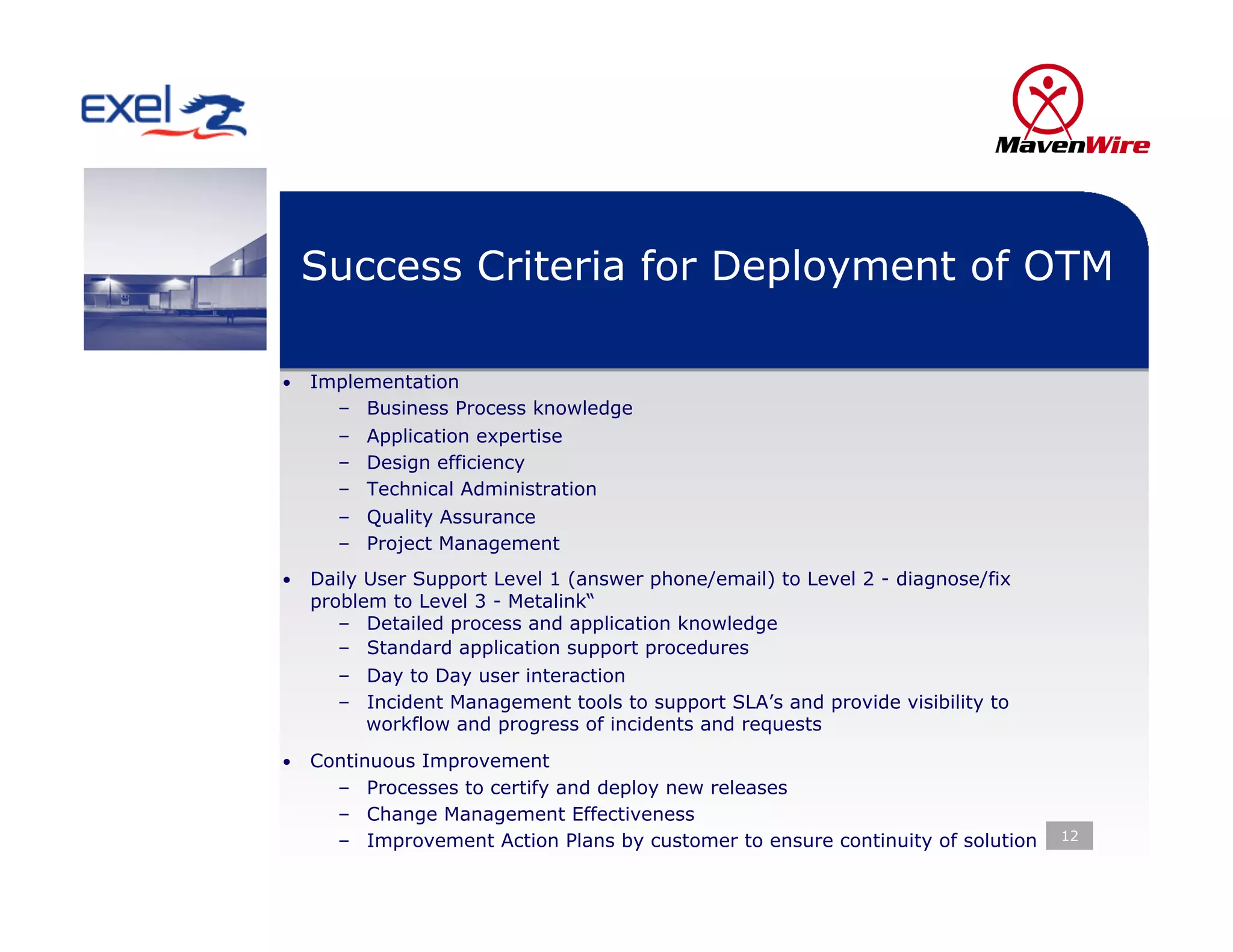

Success Criteria for Deployment of OTM

•  Implementation
     –    Business Process knowledge
     –    Application expertise
     –    Design efficiency
     –    Technical Administration
     –    Quality Assurance
     –    Project Management
•  Daily User Support Level 1 (answer phone/email) to Level 2 - diagnose/fix
  problem to Level 3 - Metalink“
     –  Detailed process and application knowledge
     –  Standard application support procedures
     –  Day to Day user interaction
     –  Incident Management tools to support SLA’s and provide visibility to
        workflow and progress of incidents and requests
•  Continuous Improvement
     –  Processes to certify and deploy new releases
     –  Change Management Effectiveness
     –  Improvement Action Plans by customer to ensure continuity of solution   12

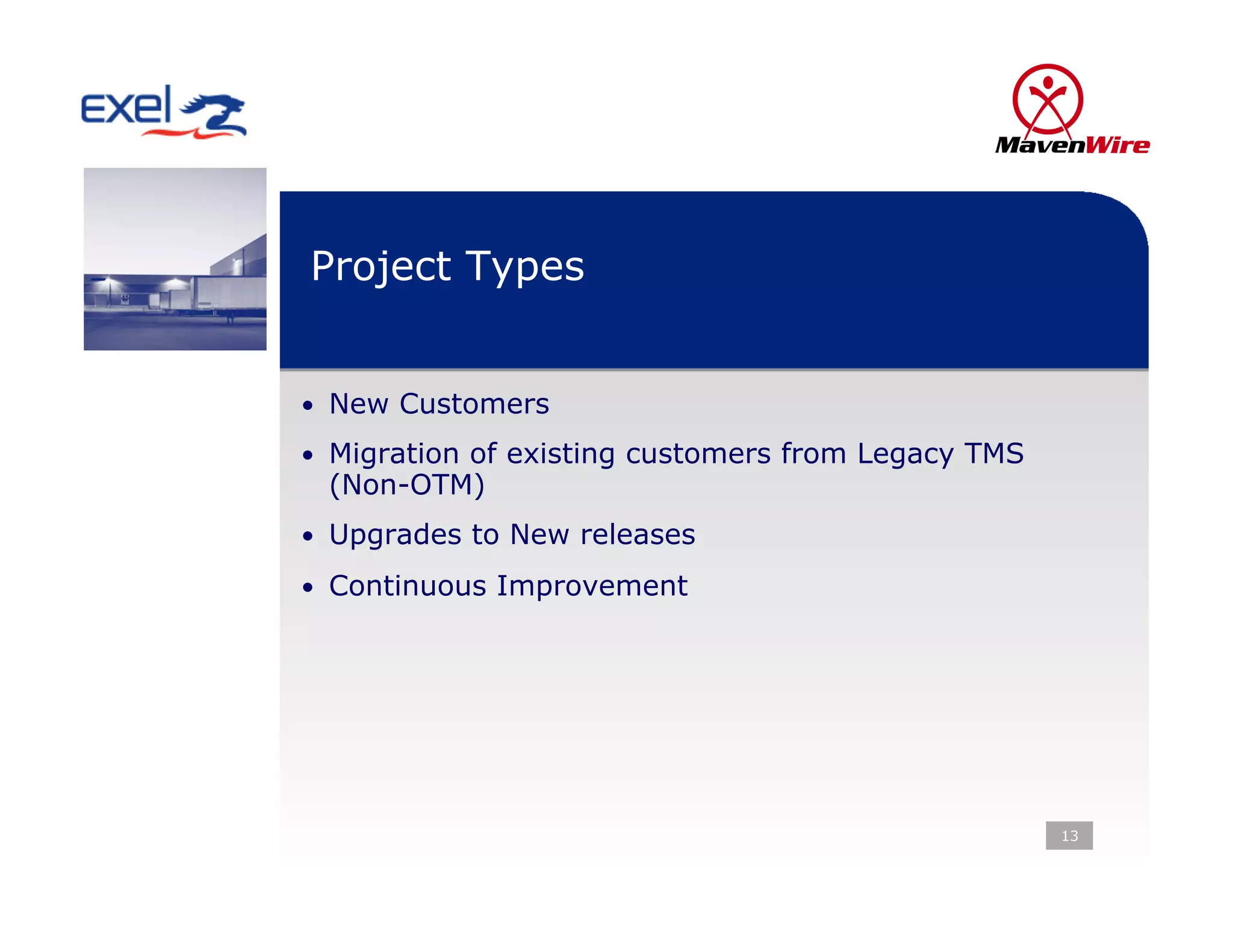

Project Types

•  New Customers
•  Migration of existing customers from Legacy TMS
 (Non-OTM)
•  Upgrades to New releases

•  Continuous Improvement

                                                     13

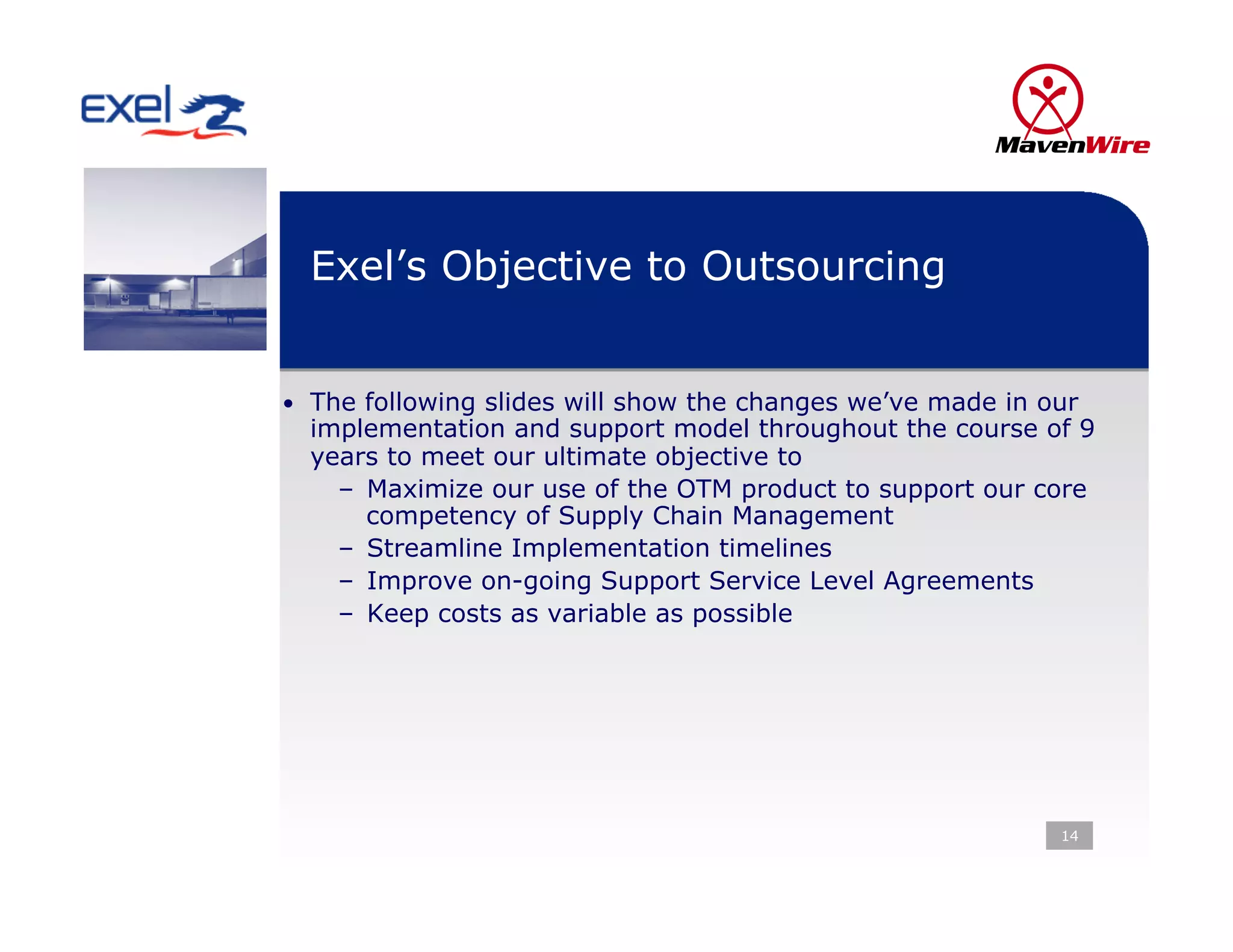

Exel’s Objective to Outsourcing

•  The following slides will show the changes we’ve made in our
  implementation and support model throughout the course of 9
  years to meet our ultimate objective to
    –  Maximize our use of the OTM product to support our core
       competency of Supply Chain Management
    –  Streamline Implementation timelines
    –  Improve on-going Support Service Level Agreements
    –  Keep costs as variable as possible

                                                             14

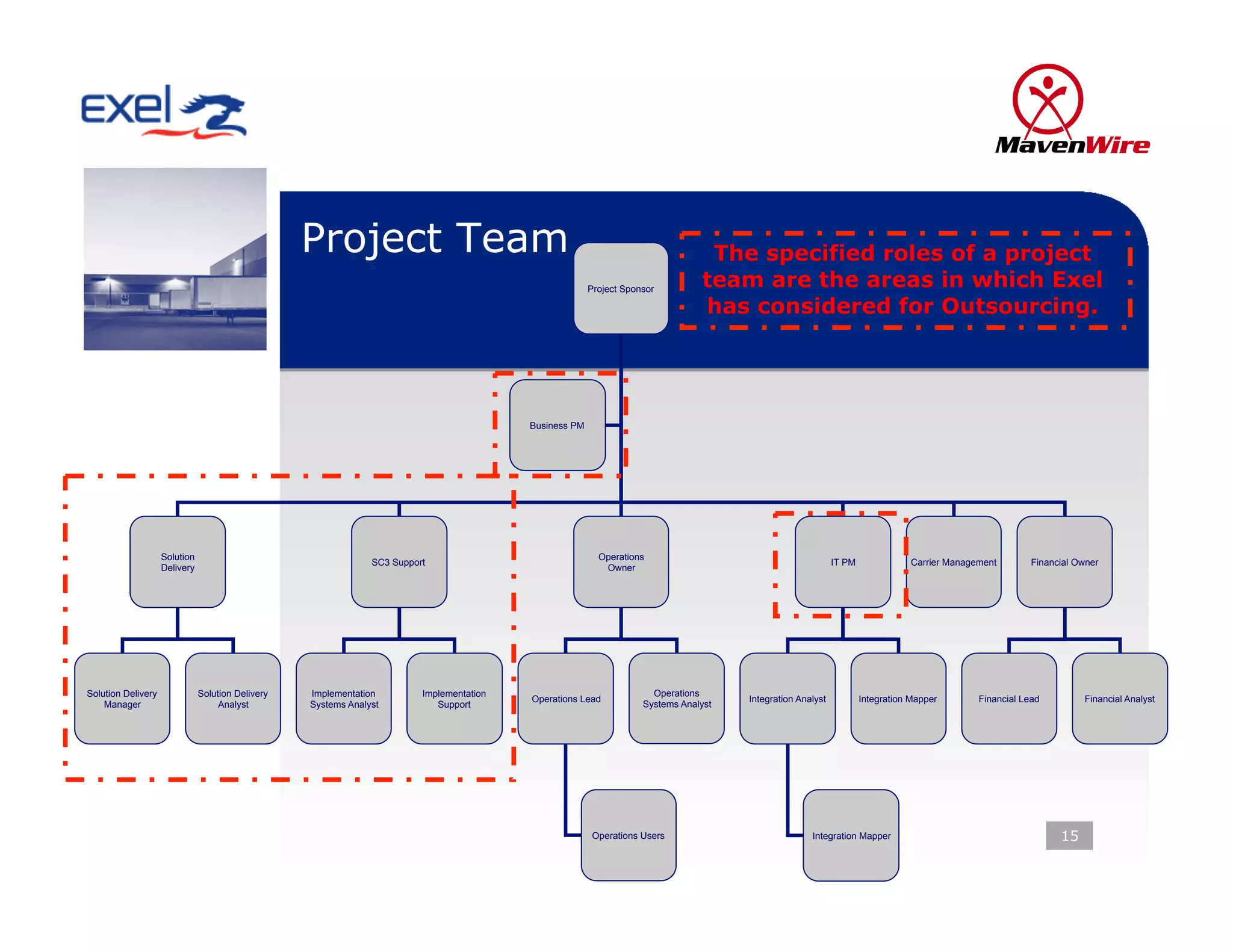

Project Team                                                                   The specified roles of a project
                                                                                                         Project Sponsor
                                                                                                                                 team are the areas in which Exel
                                                                                                                                 has considered for Outsourcing.

                                                                                           Business PM

                    Solution                                                                               Operations
                                                                SC3 Support                                                                                  IT PM              Carrier Management        Financial Owner
                    Delivery                                                                                Owner

Solution Delivery              Solution Delivery   Implementation         Implementation                               Operations
                                                                                           Operations Lead                             Integration Analyst           Integration Mapper       Financial Lead         Financial Analyst
    Manager                         Analyst        Systems Analyst           Support                                 Systems Analyst

                                                                                                          Operations Users                            Integration Mapper                                        15
Exel Outsourcing History 2000 – 2002
            Glog

Outsource
                                          Design
                          Requirements                Functional
                            Gathering                Configuration

                Project                                             Technical
              Management                                          Configuration
 Internal
                                          Ongoing
                                          Support

                Go Live
                                                                  Data Loading
                Support

                            Migration
 Shared                   To Production
                                                        Testing

                                          Training
                                                                                  16

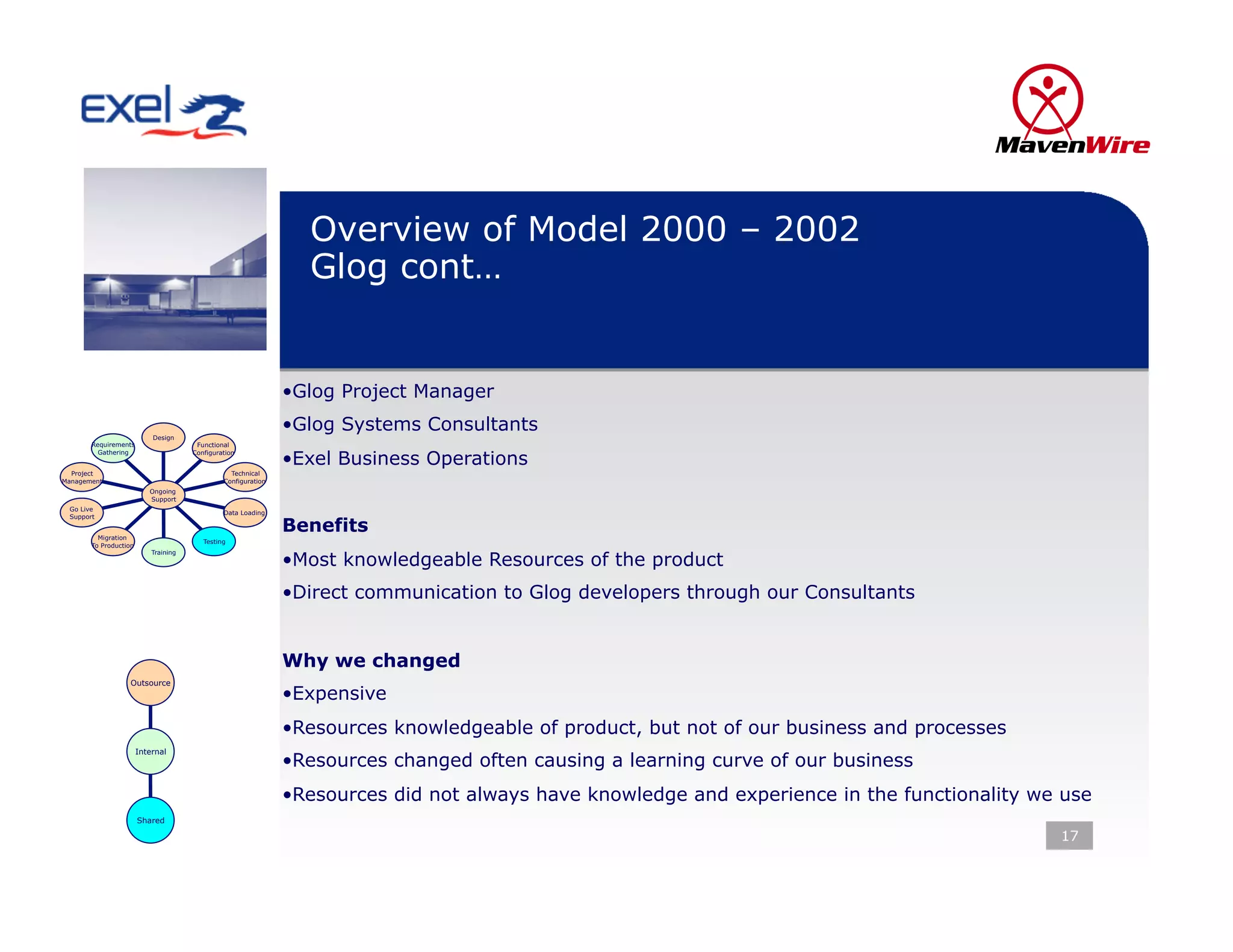

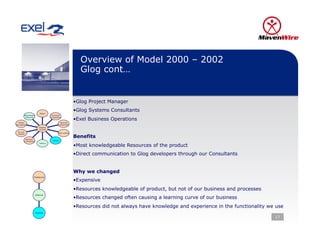

Overview of Model 2000 – 2002
                                                                 Glog cont…

                                                               • Glog Project Manager

                           Design
                                                               • Glog Systems Consultants
       Requirements                    Functional

                                                               • Exel Business Operations
         Gathering                    Configuration

  Project                                        Technical
Management                                     Configuration
                          Ongoing
                          Support
 Go Live
                                               Data Loading
 Support

         Migration
                                                               Benefits
                                         Testing
       To Production

                                                               • Most knowledgeable Resources of the product
                           Training

                                                               • Direct communication to Glog developers through our Consultants

                                                               Why we changed
                   Outsource
                                                               • Expensive
                                                               • Resources knowledgeable of product, but not of our business and processes
                       Internal
                                                               • Resources changed often causing a learning curve of our business
                                                               • Resources did not always have knowledge and experience in the functionality we use
                       Shared

                                                                                                                                               17

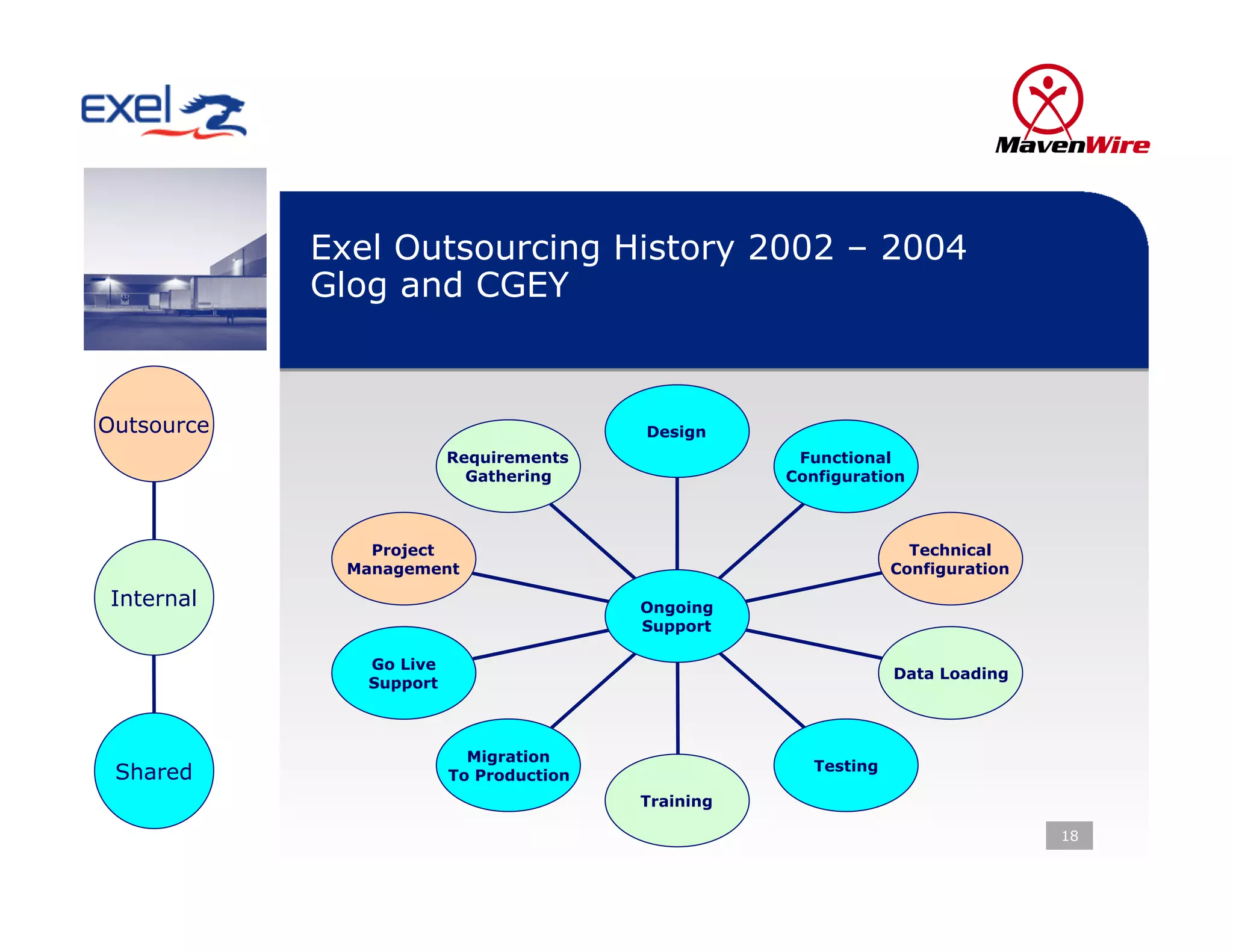

Exel Outsourcing History 2002 – 2004
            Glog and CGEY

Outsource                                Design
                         Requirements                Functional
                           Gathering                Configuration

                Project                                            Technical
              Management                                         Configuration

 Internal                                Ongoing
                                         Support

               Go Live
                                                                 Data Loading
               Support

                           Migration
                                                       Testing
 Shared                  To Production
                                         Training

                                                                                 18

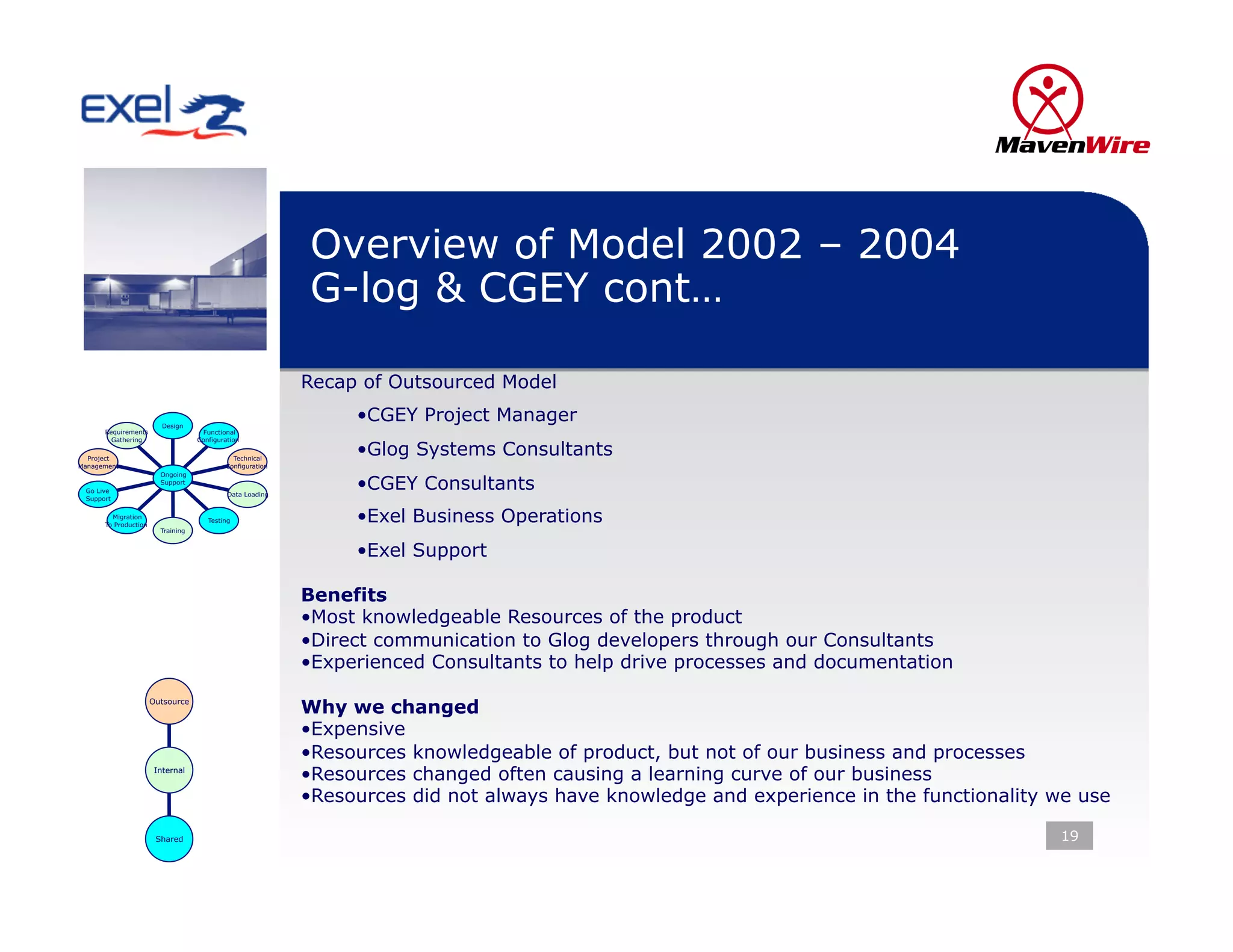

Overview of Model 2002 – 2004
                                                           G-log & CGEY cont…

                                                           Recap of Outsourced Model

                         Design
                                                                • CGEY Project Manager
      Requirements                  Functional
        Gathering                  Configuration

  Project                                    Technical
                                                                • Glog Systems Consultants
Management                                 Configuration
                        Ongoing

 Go Live
                        Support
                                            Data Loading
                                                                • CGEY Consultants
 Support

        Migration
      To Production
                                      Testing                   • Exel Business Operations
                        Training

                                                                • Exel Support

                                                           Benefits
                                                           • Most knowledgeable Resources of the product
                                                           • Direct communication to Glog developers through our Consultants
                                                           • Experienced Consultants to help drive processes and documentation
                      Outsource
                                                           Why we changed
                                                           • Expensive
                                                           • Resources knowledgeable of product, but not of our business and processes
                       Internal
                                                           • Resources changed often causing a learning curve of our business
                                                           • Resources did not always have knowledge and experience in the functionality we use

                       Shared                                                                                                            19

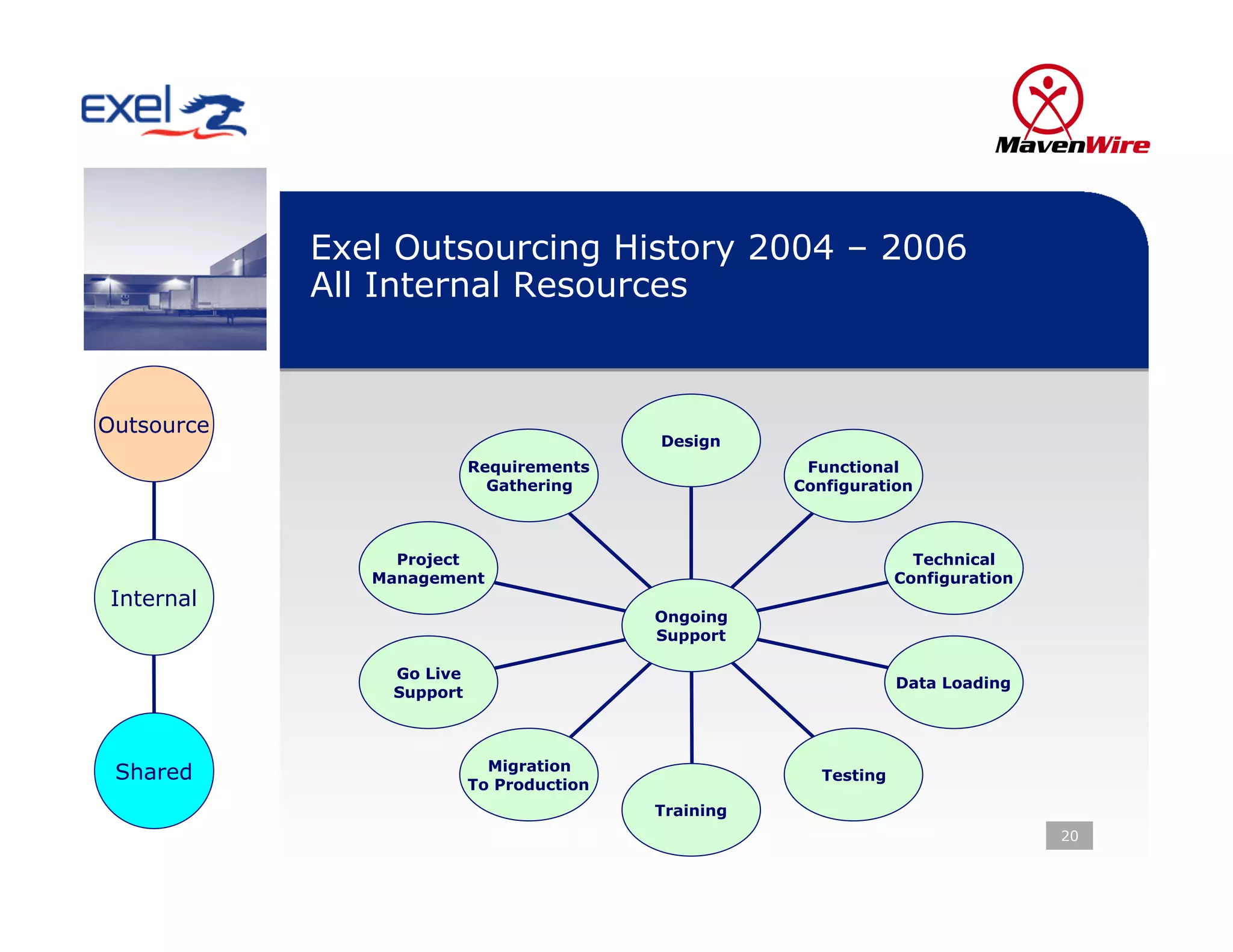

Exel Outsourcing History 2004 – 2006
            All Internal Resources

Outsource
                                          Design
                          Requirements                Functional
                            Gathering                Configuration

                 Project                                            Technical
               Management                                         Configuration
 Internal
                                          Ongoing
                                          Support

                Go Live
                                                                  Data Loading
                Support

                            Migration
 Shared                   To Production
                                                        Testing

                                          Training
                                                                                  20

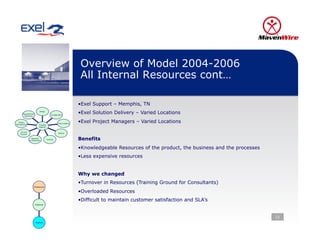

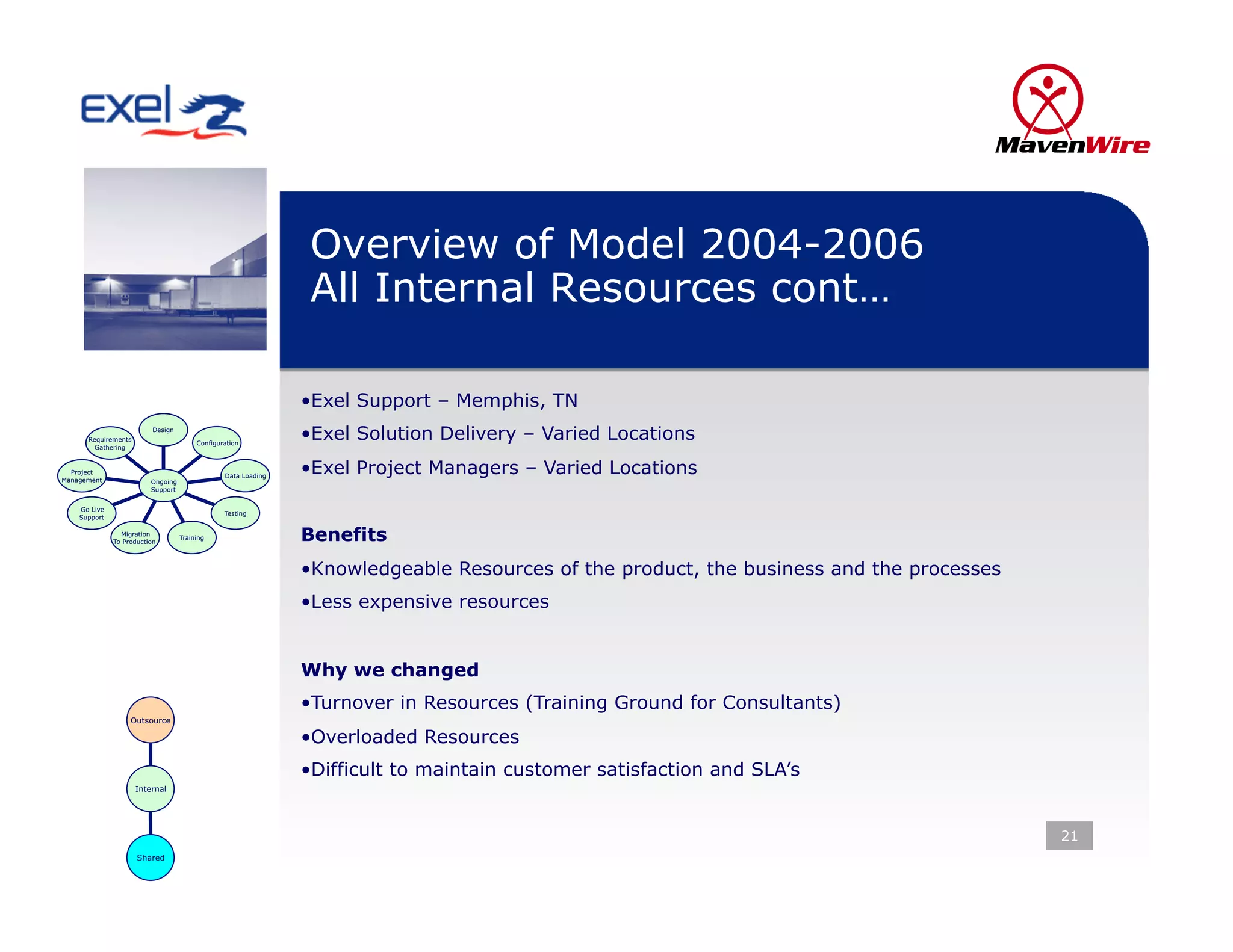

Overview of Model 2004-2006
                                                                All Internal Resources cont…

                                                               • Exel Support – Memphis, TN
      Requirements
                          Design

                                        Configuration
                                                               • Exel Solution Delivery – Varied Locations
        Gathering

  Project
Management
                                                Data Loading
                                                               • Exel Project Managers – Varied Locations
                         Ongoing
                         Support

    Go Live
                                                Testing
    Support

                Migration
              To Production
                                   Training                    Benefits
                                                               • Knowledgeable Resources of the product, the business and the processes
                                                               • Less expensive resources

                                                               Why we changed
                                                               • Turnover in Resources (Training Ground for Consultants)
                   Outsource

                                                               • Overloaded Resources
                                                               • Difficult to maintain customer satisfaction and SLA’s
                     Internal

                                                                                                                                          21
                     Shared

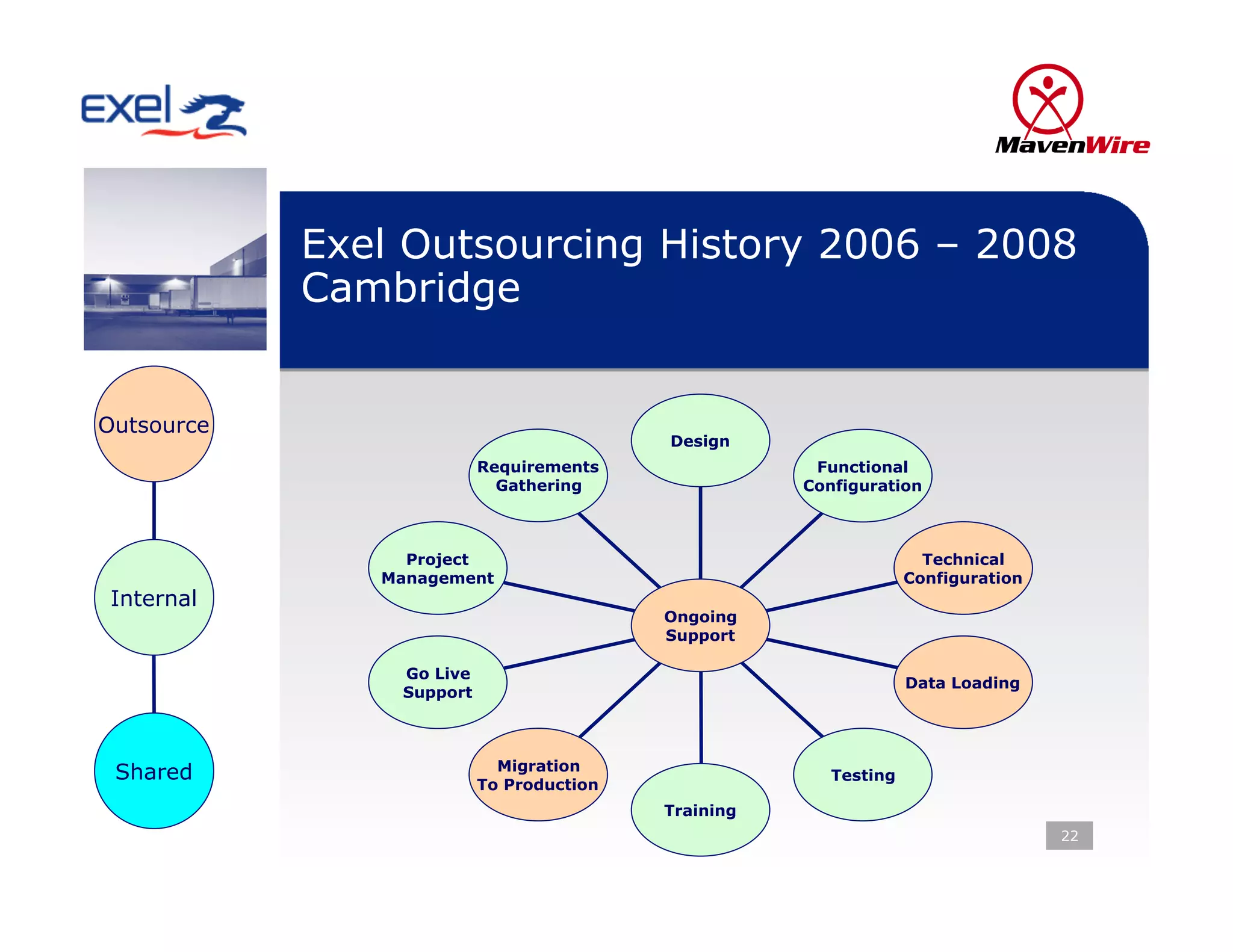

Exel Outsourcing History 2006 – 2008
            Cambridge

Outsource
                                          Design
                          Requirements                Functional
                            Gathering                Configuration

                 Project                                            Technical
               Management                                         Configuration
 Internal
                                          Ongoing
                                          Support

                Go Live
                                                                  Data Loading
                Support

                            Migration
 Shared                   To Production
                                                        Testing

                                          Training
                                                                                  22

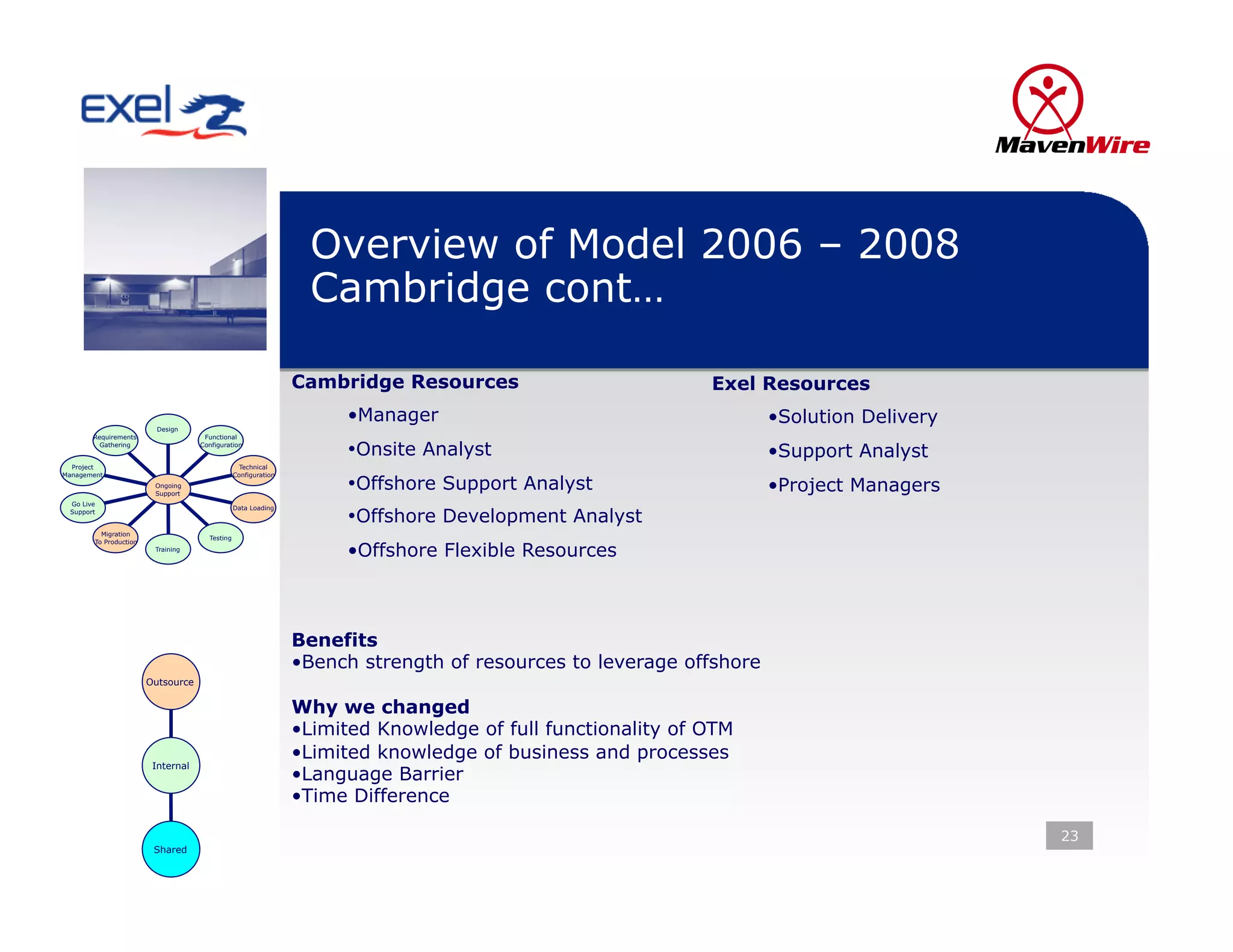

Overview of Model 2006 – 2008
                                                                  Cambridge cont…

                                                                Cambridge Resources                          Exel Resources
                                                                      • Manager                                      • Solution Delivery
                          Design
       Requirements                  Functional
         Gathering                  Configuration
                                                                      • Onsite Analyst                               • Support Analyst
  Project                                        Technical
Management                                      Configuration
                         Ongoing
                         Support
                                                                      • Offshore Support Analyst                     • Project Managers
 Go Live

                                                                      • Offshore Development Analyst
                                                Data Loading
 Support

          Migration
                                      Testing

                                                                      • Offshore Flexible Resources
        To Production
                         Training

                                                                Benefits
                                                                • Bench strength of resources to leverage offshore
                        Outsource

                                                                Why we changed
                                                                • Limited Knowledge of full functionality of OTM
                                                                • Limited knowledge of business and processes
                         Internal
                                                                • Language Barrier
                                                                • Time Difference

                                                                                                                                           23
                         Shared

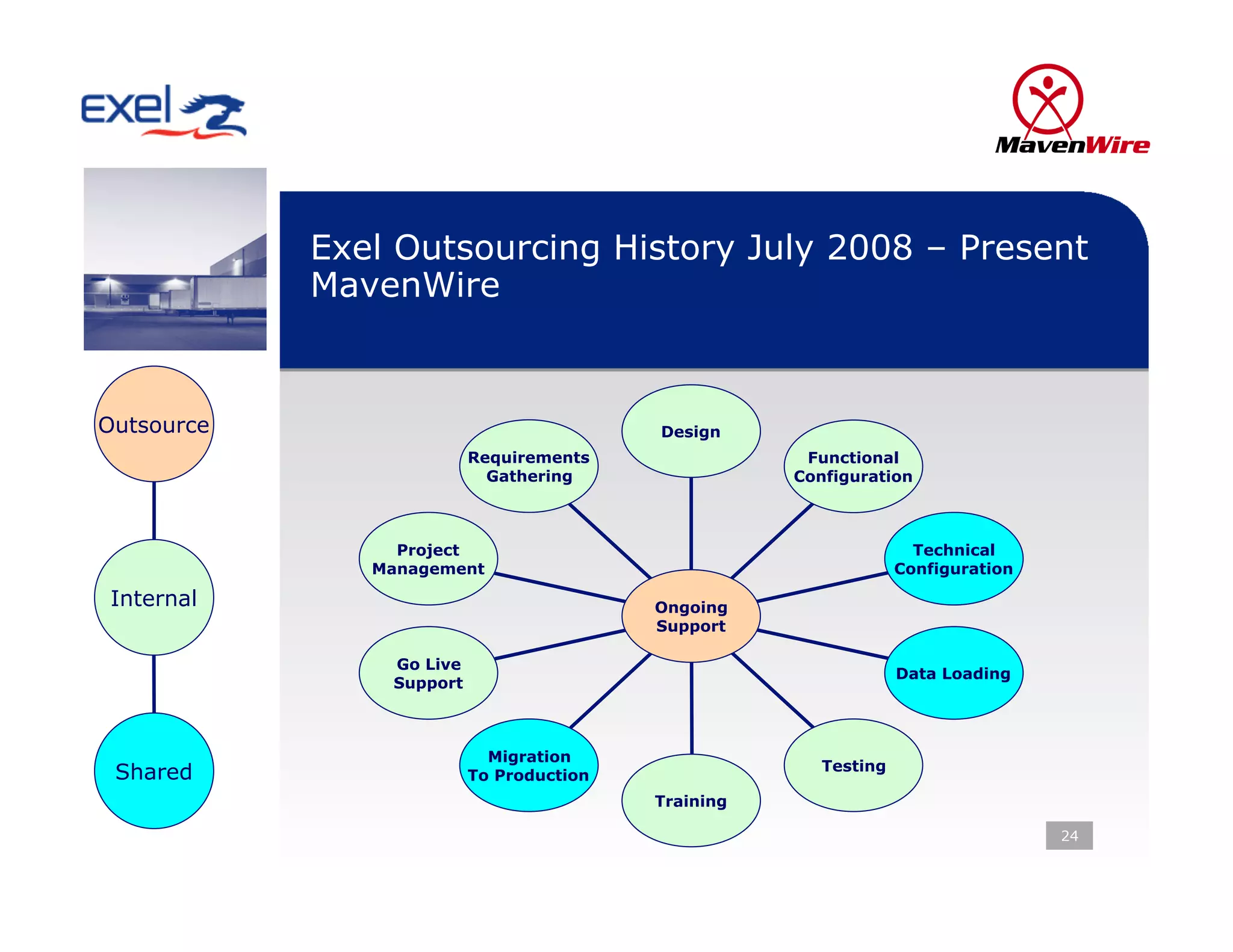

Exel Outsourcing History July 2008 – Present
            MavenWire

Outsource                                 Design
                          Requirements                Functional
                            Gathering                Configuration

                 Project                                            Technical
               Management                                         Configuration

 Internal                                 Ongoing
                                          Support

                Go Live
                                                                  Data Loading
                Support

                            Migration
                                                        Testing
 Shared                   To Production
                                          Training

                                                                                  24

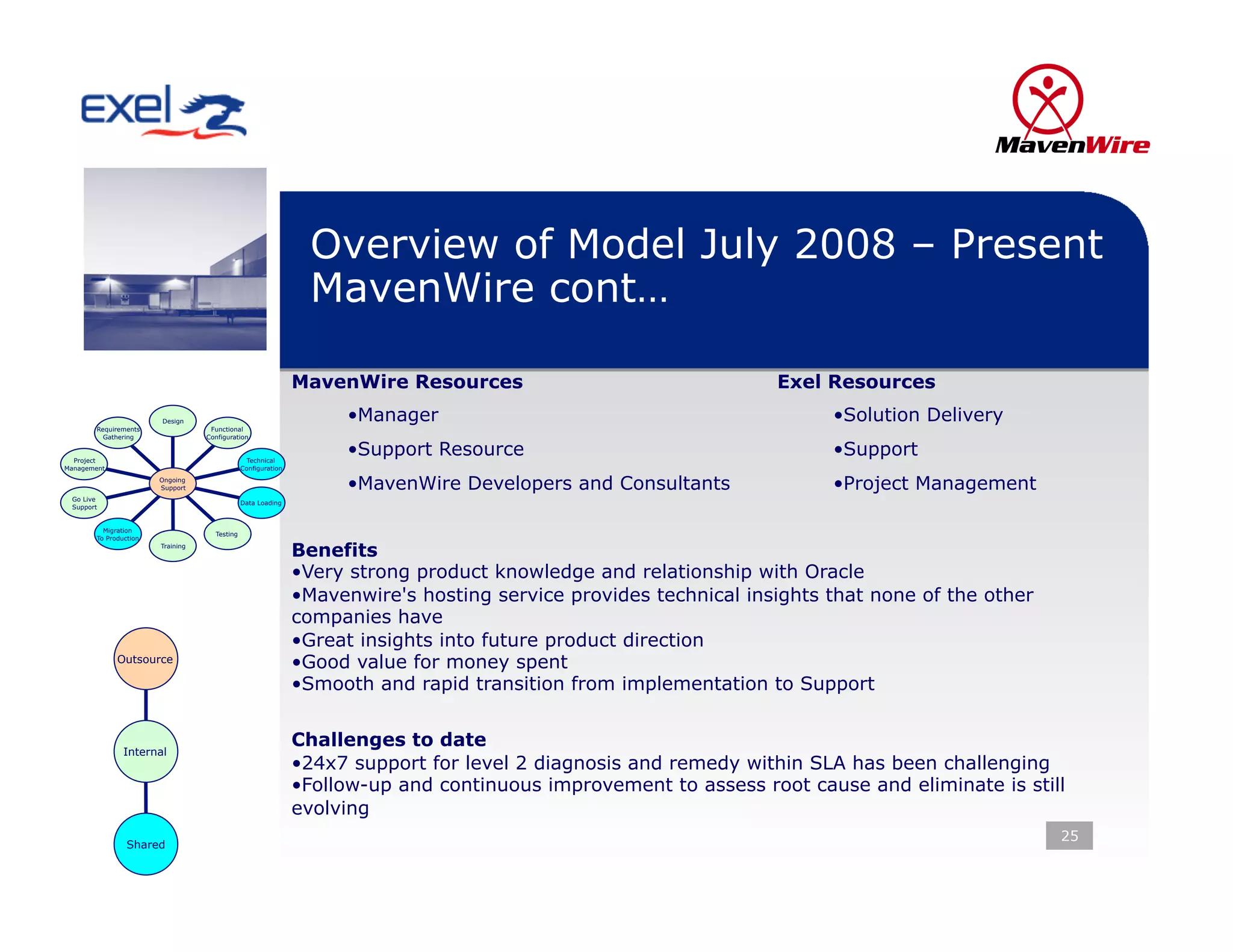

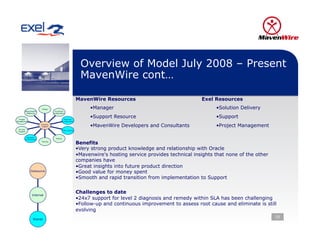

Overview of Model July 2008 – Present
                                                                 MavenWire cont…

                                                               MavenWire Resources                                 Exel Resources
                        Design                                       • Manager                                           • Solution Delivery
        Requirements                Functional
          Gathering                Configuration

  Project                                       Technical
                                                                     • Support Resource                                  • Support
Management                                     Configuration
                        Ongoing
                        Support                                      • MavenWire Developers and Consultants              • Project Management
 Go Live
                                               Data Loading
 Support

          Migration
                                     Testing
        To Production
                        Training
                                                               Benefits
                                                               • Very strong product knowledge and relationship with Oracle
                                                               • Mavenwire's hosting service provides technical insights that none of the other
                                                               companies have
                                                               • Great insights into future product direction
              Outsource                                        • Good value for money spent
                                                               • Smooth and rapid transition from implementation to Support

                                                               Challenges to date
                Internal
                                                               • 24x7 support for level 2 diagnosis and remedy within SLA has been challenging
                                                               • Follow-up and continuous improvement to assess root cause and eliminate is still
                                                               evolving
                                                                                                                                                  25

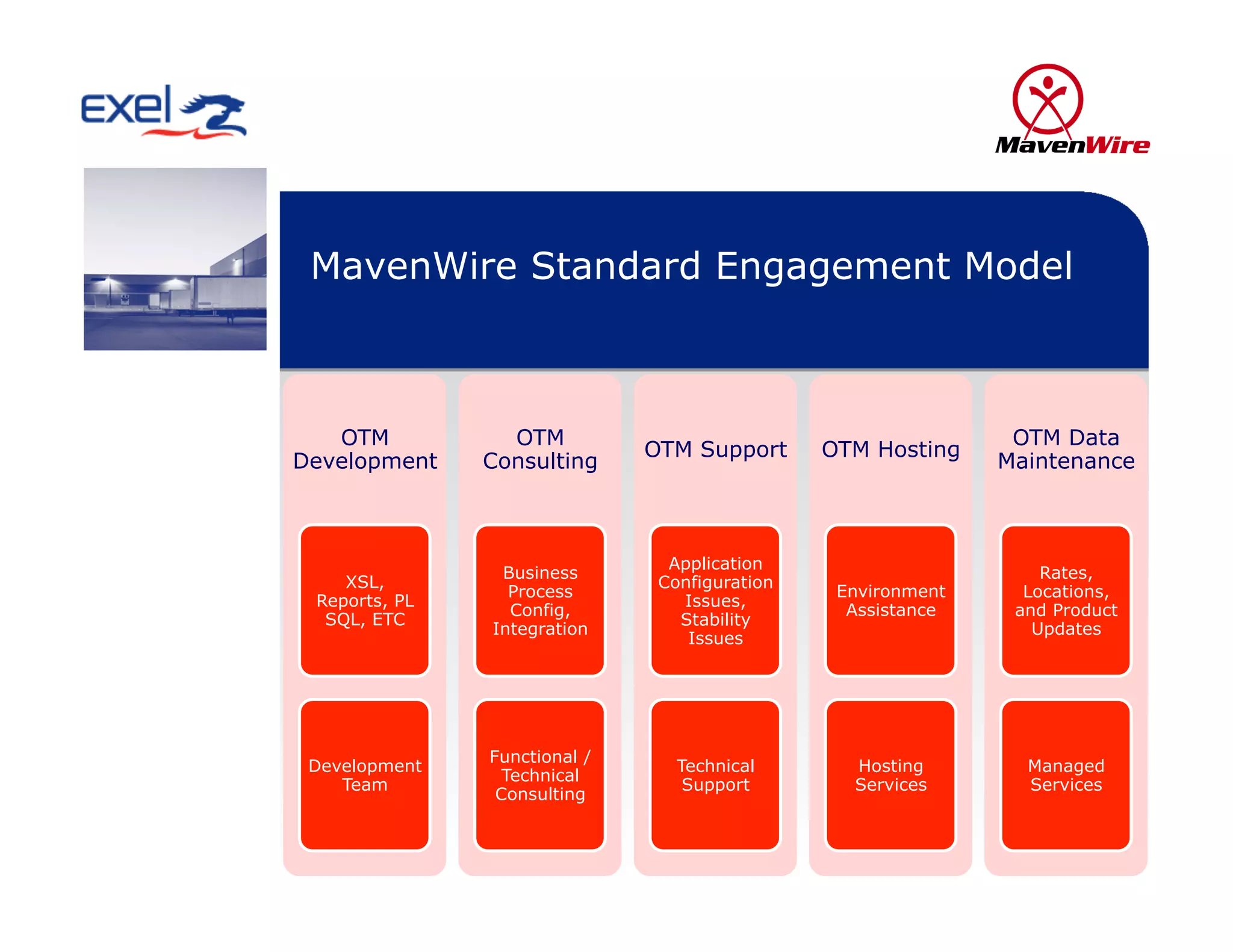

                 Shared
MavenWire Standard Engagement Model

   OTM           OTM                                           OTM Data
                              OTM Support      OTM Hosting
Development    Consulting                                     Maintenance

                                Application
                Business                                          Rates,
    XSL,                       Configuration
                 Process                        Environment     Locations,
 Reports, PL                     Issues,
                 Config,                         Assistance    and Product
  SQL, ETC                       Stability
               Integration                                       Updates
                                  Issues

               Functional /
 Development                     Technical       Hosting        Managed
                 Technical
    Team                          Support        Services       Services
                Consulting

                                                                   26

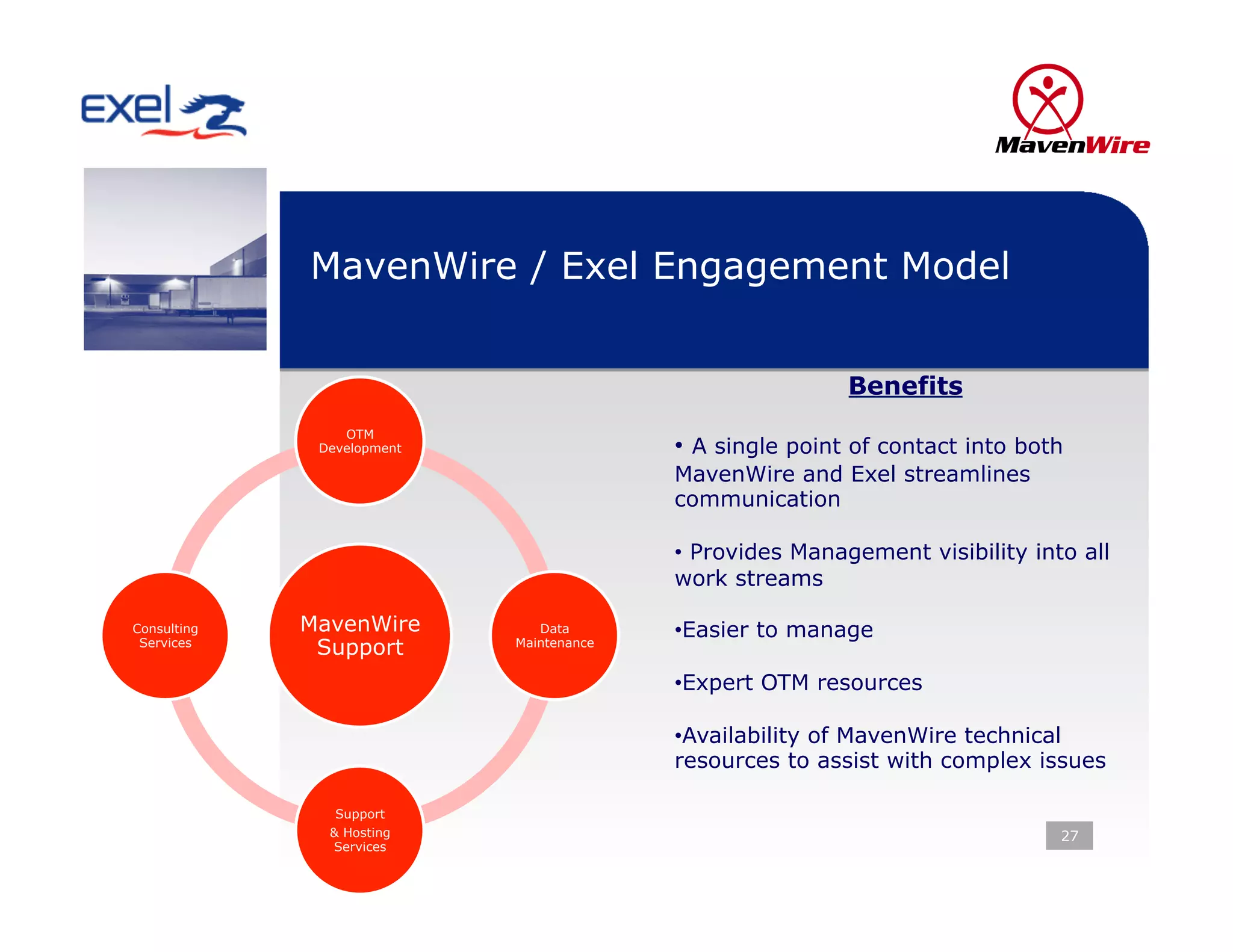

MavenWire / Exel Engagement Model

                                                          Benefits
                 OTM
              Development                 •  A single point of contact into both
                                          MavenWire and Exel streamlines
                                          communication

                                          •  Provides Management visibility into all
                                          work streams

Consulting   MavenWire         Data       • Easier to manage
 Services
              Support       Maintenance

                                          • Expert OTM resources

                                          • Availability of MavenWire technical
                                          resources to assist with complex issues

                Support
               & Hosting                                                       27
               Services

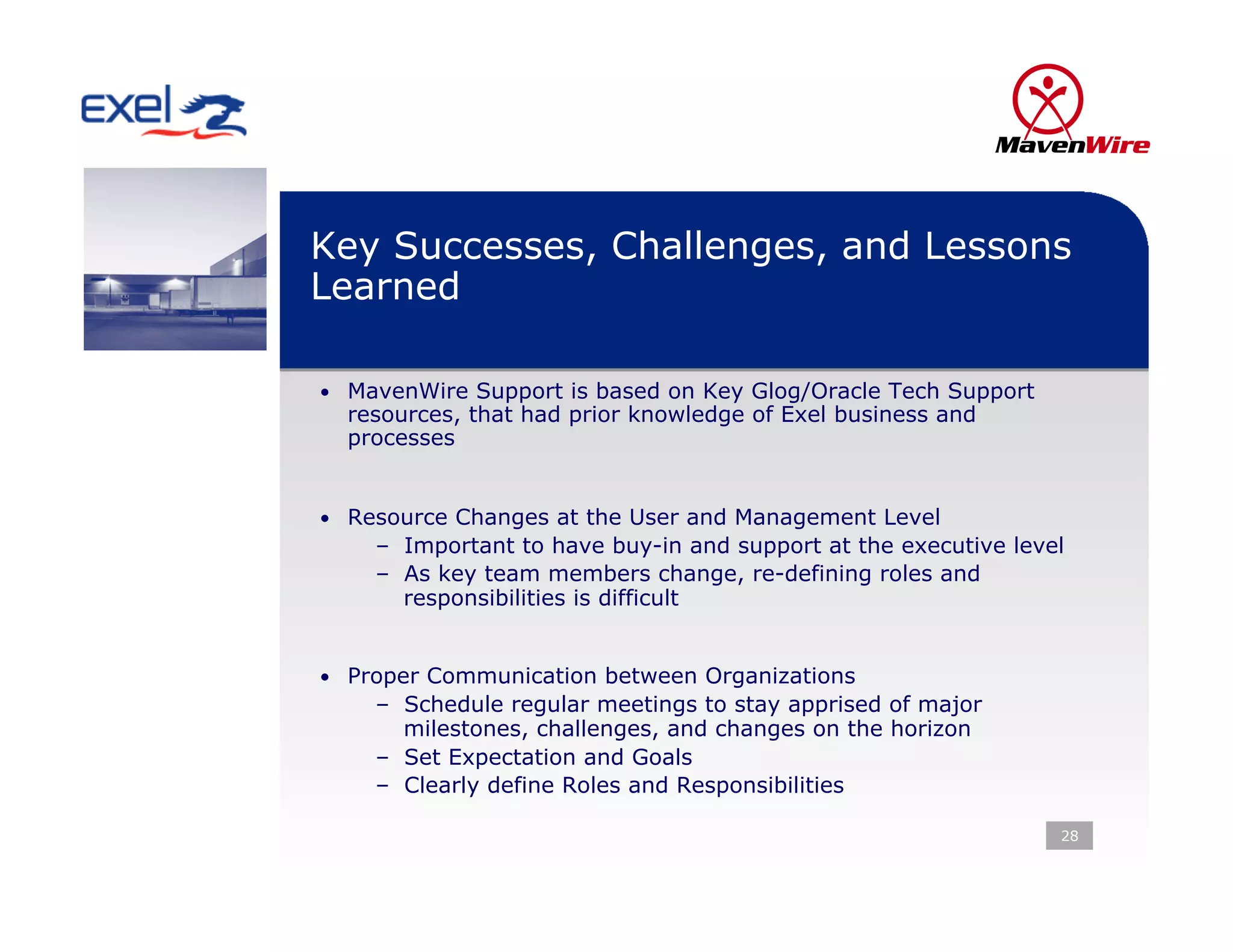

Key Successes, Challenges, and Lessons
Learned

•  MavenWire Support is based on Key Glog/Oracle Tech Support
  resources, that had prior knowledge of Exel business and
  processes

•  Resource Changes at the User and Management Level
    –  Important to have buy-in and support at the executive level
    –  As key team members change, re-defining roles and
       responsibilities is difficult

•  Proper Communication between Organizations
    –  Schedule regular meetings to stay apprised of major
       milestones, challenges, and changes on the horizon
    –  Set Expectation and Goals
    –  Clearly define Roles and Responsibilities

                                                                 28
Thank You!!

              29

The Right Collaboration, Leveraging Outsourcing Services to Focus on Core Competencies

  • 1.
    The Right Collaboration, LeveragingOutsourcing Services to Focus on Core Competencies Presented By Exel and MavenWire Terrell Brown and Samuel Levin June 22, 2009
  • 2.
    Agenda •  Exel Company Overview •  Exel Glog/OTM History •  Customer/Domain Structure Overview •  9 Years of Challenges •  Success Criteria for Deployment of OTM •  Outsourcing History •  MavenWire Model •  MavenWire Key Successes, Challenges, and Lessons Learned 2
  • 3.
    DP DHL A global player with strongly placed divisions... 2008 € 54B Rev € 2.4B EBIT 220 Countries 500K Employees Germany  Delivers mail to about 40mm households Global Business Services (GBS) Finance, Insurance/Risk, Claims Mgt, Legal, HR, Procurement, Real Estate, IT Services, Claims Mgt 3
  • 4.
    Exel Supply Chain Americas  $4.6 billion turnover in 2007   $186 million EBIT in 2007   41,000 employees   Operations focused in six countries   Over 90 million square feet operated   Over 925 tractors, 3325 trailers and 370 straight trucks 4
  • 5.
    Exel Supply ChainAmericas Structure •  Six Industry Verticals: Retail, Consumer, Life Sciences, Auto, Chemical/Industrial, Technology •  Sector Leaders - Responsible for operations and sales in North America and market development in Latin America •  Latin America operations and sales are delivered by country management working with Americas sector leaders •  In addition, there are four product-based business units: •  Exel Transportation – Managed Transportation, Truckload, Intermodal, LTL, and Brokerage •  DHL Global Service Parts – service parts distribution •  Express Logistics – time critical fulfillment •  Exel Direct – an “in home” final mile delivery business 5
  • 6.
    Exel Transportation BusinessSegments & Service Offerings •  Network Brokerage Business –  Network of over 90 Independent Business Owners (IBO’s) with national coverage (plus Canada) –  Nationwide network of 250+ sales representatives –  Ad-Hoc and Contract Customers •  Managed Transportation –  Classic 3PL Transportation Management –  Customer Managed Operations –  Customized solutions within multi-client Transportation Management Centers –  Specialized Logistics (Hospitality Industry) •  Modes –  TL –  LTL, LTL Consolidation and Pool Distribution –  Intermodal –  International •  Canada & Mexico---domestic and cross border •  Rail & Rail Car Management programs 6 •  Temperature Controlled Intermodal Fleet
  • 7.
  • 8.
    Exel Supply ChainAmericas OTM History •  Exel Americas entered relationship with Glog in 2000 •  First Customers implemented in 2001 –  Started on version 2.5 –  Upgraded to 3.1 in 2002 •  OTM recognized as Global Strategic TMS Platform in 2004 –  Upgraded to 4.0 in 2004 •  Developed standard implementation model, processes, tools, and methodology •  Implemented 4.5 for new customers in 2005 •  Upgraded 4.5 to 5.5 in 2007 •  Migrated remaining 4.0 customers to 5.5 in 2008 and 2009 •  Currently running version 5.5 CU3 •  Certification of 5.5 CU5 in progress •  Exel Hosts OTM environment internally •  Exel controls all integration internally 8
  • 9.
    Customer Configurations Implemented •  Customer 1 (Chemical) •  Customer 3 (Consumer) –  Bulk Planning (Buy no Sell) –  Bulk Planning (Buy no Sell) –  Rate Preferences, –  Majority TL and Intermodal some LTL –  Execution, Track & Trace, Milestones –  Rate Preferences –  Actuals –  Execution, Track & Trace, Milestones –  Freight Pay in Process –  Freight Pay Integrated with Outsourced Audit –  Integrated with External WM, Carriers, –  Integrated with External WM, Carriers and and Freight Pay Audit Freight Pay Audit •  Customer 2 (Retail) •  Customer 4 (Chemical) –  Bulk Planning (Buy No Sell) –  Bulk Planning (Buy no Sell) –  Cross-dock Planning –  Outbound, Inbound, Returns –  Schedule based planning –  Dock Scheduling –  LTL Trailer Building (Shipment Groups) –  Rate Preferences –  Integrated with Internal WM –  Execution, Track & Trace, Milestones –  Freight Pay Integrated with Outsourced Audit –  Integrated with External WM, Carriers, and Freight Pay Audit 9
  • 10.
    Customer Configurations Implemented •  Customer 5 (Mexico Chemical) •  Customer 7 (Home Delivery) –  Bulk Planning (Buy and Sell) –  Visibility Only (Shipment as Work SAW) –  Cross-dock Planning –  10+ Customers, 10K+ Shipments/Consignees –  Freight Pay with Internal Audit per month 160K+ Events per month –  Integrated with Internal WM –  VPD Profiles for Multi Customers –  Public Track and Trace (Sign in based on Phone Number and Zip Code no Login) –  Integrated with Internal Home Delivery •  Customer 6 (Mexico Consumer Planning TMS Consolidation) –  Parent/Child/Grandchild Domain Structure 40+ Domains –  Bulk Planning (Buy and Sell) •  Customer 8 (Chemical/Industrial) –  Cross-dock Planning across 40 domains –  No EDI – Manual Order Entry –  8 Cross-dock locations (4 more by end –  BOL Creation and Auto Email of year) –  Custom Dispatch with Drivers License –  Radioactive, Explosives and Hazardous and License Plate verification –  Freight Pay Integrated with Outsourced Audit –  Order Level POD –  Integrated with Internal WM –  VPD Profiles for Planners 10
  • 11.
    9 Years ofChallenges •  Recruiting and retaining resources with: –  OTM technical knowledge –  Transportation Management Knowledge –  Knowledge to translate business requirements into OTM functional design –  Process knowledge to continuously improve •  Implementing a one instance, scalable production environment •  Maintain separate instances for testing current versions while certifying new versions •  Clumsy, error prone process of migrating from test to production - base data, configurations, etc •  Significant work to accommodate a release schedule with frequent updates (CUs) to features and functions 11
  • 12.
    Success Criteria forDeployment of OTM •  Implementation –  Business Process knowledge –  Application expertise –  Design efficiency –  Technical Administration –  Quality Assurance –  Project Management •  Daily User Support Level 1 (answer phone/email) to Level 2 - diagnose/fix problem to Level 3 - Metalink“ –  Detailed process and application knowledge –  Standard application support procedures –  Day to Day user interaction –  Incident Management tools to support SLA’s and provide visibility to workflow and progress of incidents and requests •  Continuous Improvement –  Processes to certify and deploy new releases –  Change Management Effectiveness –  Improvement Action Plans by customer to ensure continuity of solution 12
  • 13.
    Project Types •  NewCustomers •  Migration of existing customers from Legacy TMS (Non-OTM) •  Upgrades to New releases •  Continuous Improvement 13
  • 14.
    Exel’s Objective toOutsourcing •  The following slides will show the changes we’ve made in our implementation and support model throughout the course of 9 years to meet our ultimate objective to –  Maximize our use of the OTM product to support our core competency of Supply Chain Management –  Streamline Implementation timelines –  Improve on-going Support Service Level Agreements –  Keep costs as variable as possible 14
  • 15.
    Project Team The specified roles of a project Project Sponsor team are the areas in which Exel has considered for Outsourcing. Business PM Solution Operations SC3 Support IT PM Carrier Management Financial Owner Delivery Owner Solution Delivery Solution Delivery Implementation Implementation Operations Operations Lead Integration Analyst Integration Mapper Financial Lead Financial Analyst Manager Analyst Systems Analyst Support Systems Analyst Operations Users Integration Mapper 15
  • 16.
    Exel Outsourcing History2000 – 2002 Glog Outsource Design Requirements Functional Gathering Configuration Project Technical Management Configuration Internal Ongoing Support Go Live Data Loading Support Migration Shared To Production Testing Training 16
  • 17.
    Overview of Model2000 – 2002 Glog cont… • Glog Project Manager Design • Glog Systems Consultants Requirements Functional • Exel Business Operations Gathering Configuration Project Technical Management Configuration Ongoing Support Go Live Data Loading Support Migration Benefits Testing To Production • Most knowledgeable Resources of the product Training • Direct communication to Glog developers through our Consultants Why we changed Outsource • Expensive • Resources knowledgeable of product, but not of our business and processes Internal • Resources changed often causing a learning curve of our business • Resources did not always have knowledge and experience in the functionality we use Shared 17
  • 18.
    Exel Outsourcing History2002 – 2004 Glog and CGEY Outsource Design Requirements Functional Gathering Configuration Project Technical Management Configuration Internal Ongoing Support Go Live Data Loading Support Migration Testing Shared To Production Training 18
  • 19.
    Overview of Model2002 – 2004 G-log & CGEY cont… Recap of Outsourced Model Design • CGEY Project Manager Requirements Functional Gathering Configuration Project Technical • Glog Systems Consultants Management Configuration Ongoing Go Live Support Data Loading • CGEY Consultants Support Migration To Production Testing • Exel Business Operations Training • Exel Support Benefits • Most knowledgeable Resources of the product • Direct communication to Glog developers through our Consultants • Experienced Consultants to help drive processes and documentation Outsource Why we changed • Expensive • Resources knowledgeable of product, but not of our business and processes Internal • Resources changed often causing a learning curve of our business • Resources did not always have knowledge and experience in the functionality we use Shared 19
  • 20.
    Exel Outsourcing History2004 – 2006 All Internal Resources Outsource Design Requirements Functional Gathering Configuration Project Technical Management Configuration Internal Ongoing Support Go Live Data Loading Support Migration Shared To Production Testing Training 20
  • 21.
    Overview of Model2004-2006 All Internal Resources cont… • Exel Support – Memphis, TN Requirements Design Configuration • Exel Solution Delivery – Varied Locations Gathering Project Management Data Loading • Exel Project Managers – Varied Locations Ongoing Support Go Live Testing Support Migration To Production Training Benefits • Knowledgeable Resources of the product, the business and the processes • Less expensive resources Why we changed • Turnover in Resources (Training Ground for Consultants) Outsource • Overloaded Resources • Difficult to maintain customer satisfaction and SLA’s Internal 21 Shared
  • 22.
    Exel Outsourcing History2006 – 2008 Cambridge Outsource Design Requirements Functional Gathering Configuration Project Technical Management Configuration Internal Ongoing Support Go Live Data Loading Support Migration Shared To Production Testing Training 22
  • 23.
    Overview of Model2006 – 2008 Cambridge cont… Cambridge Resources Exel Resources • Manager • Solution Delivery Design Requirements Functional Gathering Configuration • Onsite Analyst • Support Analyst Project Technical Management Configuration Ongoing Support • Offshore Support Analyst • Project Managers Go Live • Offshore Development Analyst Data Loading Support Migration Testing • Offshore Flexible Resources To Production Training Benefits • Bench strength of resources to leverage offshore Outsource Why we changed • Limited Knowledge of full functionality of OTM • Limited knowledge of business and processes Internal • Language Barrier • Time Difference 23 Shared
  • 24.
    Exel Outsourcing HistoryJuly 2008 – Present MavenWire Outsource Design Requirements Functional Gathering Configuration Project Technical Management Configuration Internal Ongoing Support Go Live Data Loading Support Migration Testing Shared To Production Training 24
  • 25.
    Overview of ModelJuly 2008 – Present MavenWire cont… MavenWire Resources Exel Resources Design • Manager • Solution Delivery Requirements Functional Gathering Configuration Project Technical • Support Resource • Support Management Configuration Ongoing Support • MavenWire Developers and Consultants • Project Management Go Live Data Loading Support Migration Testing To Production Training Benefits • Very strong product knowledge and relationship with Oracle • Mavenwire's hosting service provides technical insights that none of the other companies have • Great insights into future product direction Outsource • Good value for money spent • Smooth and rapid transition from implementation to Support Challenges to date Internal • 24x7 support for level 2 diagnosis and remedy within SLA has been challenging • Follow-up and continuous improvement to assess root cause and eliminate is still evolving 25 Shared
  • 26.
    MavenWire Standard EngagementModel OTM OTM OTM Data OTM Support OTM Hosting Development Consulting Maintenance Application Business Rates, XSL, Configuration Process Environment Locations, Reports, PL Issues, Config, Assistance and Product SQL, ETC Stability Integration Updates Issues Functional / Development Technical Hosting Managed Technical Team Support Services Services Consulting 26
  • 27.
    MavenWire / ExelEngagement Model Benefits OTM Development •  A single point of contact into both MavenWire and Exel streamlines communication •  Provides Management visibility into all work streams Consulting MavenWire Data • Easier to manage Services Support Maintenance • Expert OTM resources • Availability of MavenWire technical resources to assist with complex issues Support & Hosting 27 Services
  • 28.
    Key Successes, Challenges,and Lessons Learned •  MavenWire Support is based on Key Glog/Oracle Tech Support resources, that had prior knowledge of Exel business and processes •  Resource Changes at the User and Management Level –  Important to have buy-in and support at the executive level –  As key team members change, re-defining roles and responsibilities is difficult •  Proper Communication between Organizations –  Schedule regular meetings to stay apprised of major milestones, challenges, and changes on the horizon –  Set Expectation and Goals –  Clearly define Roles and Responsibilities 28
  • 29.
