City Executive Team Meeting June 20 2011 Waller Creek Update
Current Issues Tunnel Project Schedule Design/Construction Status Cost Management Conservancy Public Outreach

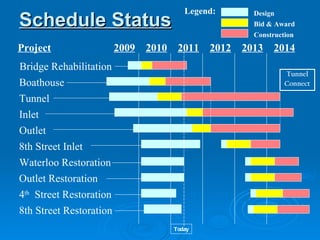

Schedule Status 4 th   Street Restoration Project 2009 2010 2011 2012 2013 2014 Boathouse Bridge Rehabilitation Tunnel Inlet Outlet 8th Street Inlet Outlet Restoration Waterloo Restoration 8th Street Restoration Legend:   Design Bid & Award Construction Today Tunnel Connect

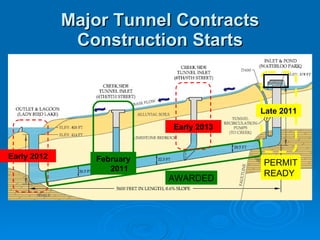

Major Tunnel Contracts Construction Starts Early 2012 Early 2013 Late 2011 February 2011 //////\\\\\\\ PERMIT READY AWARDED

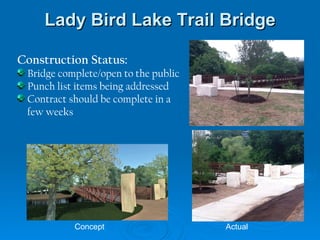

Lady Bird Lake Trail Bridge Construction Status: Bridge complete/open to the public Punch list items being addressed Contract should be complete in a few weeks Concept Actual
PARD Boat Facility Construction Status: Site utilities complete Access road foundation has been placed Boats cleared from storage building Storage Building Demolition scheduled for late June  Four Season’s landscape screening complete HACA landscaping proposal in development
PARD Boat Facility
Tunnel / 4th Street Sub-Project Construction Status: Notice to proceed issued April 11, 2011 Environmental pre-construction complete Several submittals under review
Pathway/Seating Area Lawn POND Overlook Sports Wet pond Inlet Sub-Project Design Status: 1 st  Advertisement in July. Permit process almost complete Notice to Proceed still on track for October-November 2011

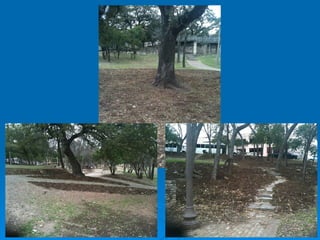

Tree Preventative Maintenance Austin Tree Experts awarded contract http://www.austintreeexperts.com/waterloo.cfm Current Activities : Tree pruning and mulching Web site developed and linked Outlet Heritage trees inspected Next Steps : This process will continue until inlet contractor starts. Permit issues need to be resolved

Outlet Sub-Project Design is 90% complete Permit revision to Boathouse Submitted and under review Council variance required
8 th  Street Creek Side Inlet 8 th  St. - separate bid set 90% submittal due in June Natural looking Eco-Weirs and ponds
Restoration Projects (Outlet Restoration - Waterloo Restoration – 4 th  & 8th St. restoration)  Design is 25- 30% complete. Design is linked to site development but will be constructed in 2013. Current Activities: Design is part of related area project for permitting. Once approved, restoration will be bid as separate packages. Additional detail and coordination: Trellis Solar elements Benches Trails Trees, etc Next Steps: Define scope for construction packages – Late 2011

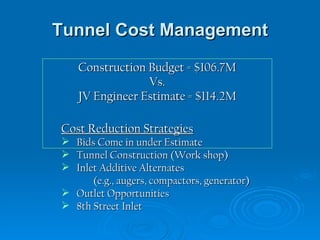

Tunnel Cost Management Construction Budget = $106.7M Vs. JV Engineer Estimate = $114.2M Cost Reduction Strategies Bids Come in under Estimate Tunnel Construction (Work shop) Inlet Additive Alternates (e.g., augers, compactors, generator) Outlet Opportunities 8th Street Inlet
CIP Planning Efforts Tunnel Cost Management Other Tunnel/Trail Funding Sources Available/Anticipated City funds Potential Grant Sources  USACE WRDA EPA STAG CAMPO STP MM Grant
Waller Creek Conservancy   Council recently approved two items  Execution of MOU – Design Competition, Joint Development Agreement Establishment of a Local Govt. Corporation Press Coverage – AAS Article/Editorial Launch of Website – wallercreek.org Design Competition ~ Sept. 2011 to May 2012 Fundraising Target = $60 Million over 5 years
Waller Creek Conservancy Design Competition Phases Pre-competition Planning  Now through August 2011 Competition Kick-off  September 2011 Stage I: Portfolio  Mid-November 2011 Stage II: Teams and Interview  Mid-December 2011 Stage III: Design Concept  December 2011 through May 2012 Post-competition  May 2012 and beyond
Public Outreach Recent Activities  Groundbreaking – resulted in accurate news coverage in the following media:  Fox News, KVUE, YNN, the  Daily Texan , and the  Statesman  Transforming Texas Waterfronts exhibit at the Capitol  Informative signs to be placed at 4th Street, boathouse, and Waterloo Park Coverage in ASCE’s  Civil Engineering Magazine

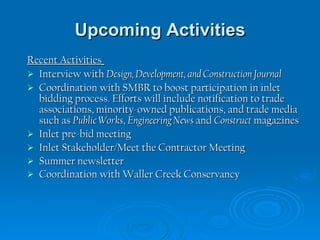

Upcoming Activities Recent Activities   Interview with  Design, Development, and Construction Journal Coordination with SMBR to boost participation in inlet bidding process. Efforts will include notification to trade associations, minority-owned publications, and trade media such as  Public Works ,  Engineering News  and  Construct  magazines Inlet pre-bid meeting Inlet Stakeholder/Meet the Contractor Meeting  Summer newsletter  Coordination with Waller Creek Conservancy

Exec Team Update 6 6 11

  • 1.
    City Executive TeamMeeting June 20 2011 Waller Creek Update
  • 2.
    Current Issues TunnelProject Schedule Design/Construction Status Cost Management Conservancy Public Outreach
  • 3.
    Schedule Status 4th Street Restoration Project 2009 2010 2011 2012 2013 2014 Boathouse Bridge Rehabilitation Tunnel Inlet Outlet 8th Street Inlet Outlet Restoration Waterloo Restoration 8th Street Restoration Legend: Design Bid & Award Construction Today Tunnel Connect
  • 4.
    Major Tunnel ContractsConstruction Starts Early 2012 Early 2013 Late 2011 February 2011 //////\\\\\\\ PERMIT READY AWARDED
  • 5.
    Lady Bird LakeTrail Bridge Construction Status: Bridge complete/open to the public Punch list items being addressed Contract should be complete in a few weeks Concept Actual
  • 6.

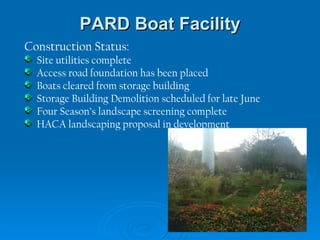

    PARD Boat FacilityConstruction Status: Site utilities complete Access road foundation has been placed Boats cleared from storage building Storage Building Demolition scheduled for late June Four Season’s landscape screening complete HACA landscaping proposal in development
  • 7.
  • 8.

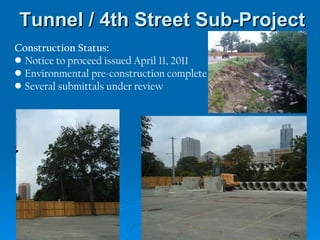

    Tunnel / 4thStreet Sub-Project Construction Status: Notice to proceed issued April 11, 2011 Environmental pre-construction complete Several submittals under review
  • 9.

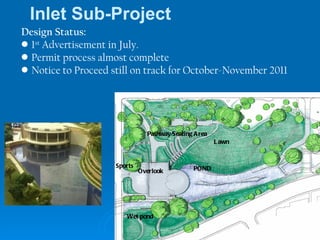

    Pathway/Seating Area LawnPOND Overlook Sports Wet pond Inlet Sub-Project Design Status: 1 st Advertisement in July. Permit process almost complete Notice to Proceed still on track for October-November 2011
  • 10.
    Tree Preventative MaintenanceAustin Tree Experts awarded contract http://www.austintreeexperts.com/waterloo.cfm Current Activities : Tree pruning and mulching Web site developed and linked Outlet Heritage trees inspected Next Steps : This process will continue until inlet contractor starts. Permit issues need to be resolved
  • 11.
  • 12.

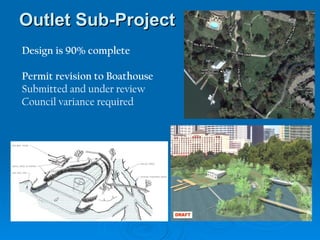

    Outlet Sub-Project Designis 90% complete Permit revision to Boathouse Submitted and under review Council variance required
  • 13.
    8 th Street Creek Side Inlet 8 th St. - separate bid set 90% submittal due in June Natural looking Eco-Weirs and ponds
  • 14.
    Restoration Projects (OutletRestoration - Waterloo Restoration – 4 th & 8th St. restoration) Design is 25- 30% complete. Design is linked to site development but will be constructed in 2013. Current Activities: Design is part of related area project for permitting. Once approved, restoration will be bid as separate packages. Additional detail and coordination: Trellis Solar elements Benches Trails Trees, etc Next Steps: Define scope for construction packages – Late 2011
  • 15.
    Tunnel Cost ManagementConstruction Budget = $106.7M Vs. JV Engineer Estimate = $114.2M Cost Reduction Strategies Bids Come in under Estimate Tunnel Construction (Work shop) Inlet Additive Alternates (e.g., augers, compactors, generator) Outlet Opportunities 8th Street Inlet
  • 16.
    CIP Planning EffortsTunnel Cost Management Other Tunnel/Trail Funding Sources Available/Anticipated City funds Potential Grant Sources USACE WRDA EPA STAG CAMPO STP MM Grant
  • 17.
    Waller Creek Conservancy Council recently approved two items Execution of MOU – Design Competition, Joint Development Agreement Establishment of a Local Govt. Corporation Press Coverage – AAS Article/Editorial Launch of Website – wallercreek.org Design Competition ~ Sept. 2011 to May 2012 Fundraising Target = $60 Million over 5 years
  • 18.
    Waller Creek ConservancyDesign Competition Phases Pre-competition Planning Now through August 2011 Competition Kick-off September 2011 Stage I: Portfolio Mid-November 2011 Stage II: Teams and Interview Mid-December 2011 Stage III: Design Concept December 2011 through May 2012 Post-competition May 2012 and beyond
  • 19.

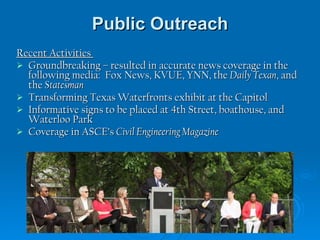

    Public Outreach RecentActivities Groundbreaking – resulted in accurate news coverage in the following media: Fox News, KVUE, YNN, the Daily Texan , and the Statesman Transforming Texas Waterfronts exhibit at the Capitol Informative signs to be placed at 4th Street, boathouse, and Waterloo Park Coverage in ASCE’s Civil Engineering Magazine
  • 20.
    Upcoming Activities RecentActivities Interview with Design, Development, and Construction Journal Coordination with SMBR to boost participation in inlet bidding process. Efforts will include notification to trade associations, minority-owned publications, and trade media such as Public Works , Engineering News and Construct magazines Inlet pre-bid meeting Inlet Stakeholder/Meet the Contractor Meeting Summer newsletter Coordination with Waller Creek Conservancy

Editor's Notes

  • #7 NOTe check they have indicated that Demo will begin week of 13 th . Check on status just prior to presentation.
  • #9 Put in Construction photos
  • #10 Anticipate advertizing week of late June Early July with NTP with Construction Late October early November 20
  • #16 Will get JVs most current Cost Estimate next week
