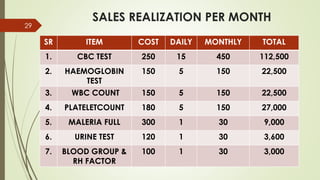

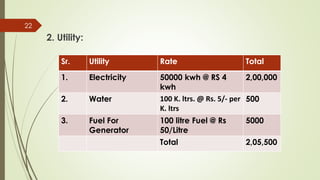

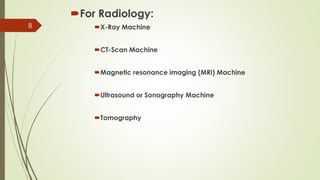

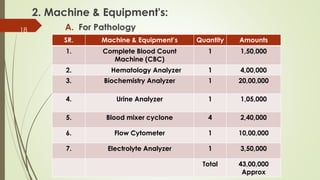

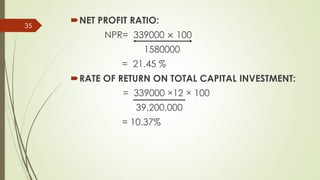

This document provides a feasibility report for opening a diagnostic centre that would offer pathology and radiology services. It analyzes the demand potential, required equipment and their costs, technical requirements, suitable location factors, implementation schedule, operating costs and projected revenues. The total capital investment is estimated at Rs. 39 million to be financed via a bank loan. The diagnostic centre is projected to earn a net monthly profit of Rs. 339,000 with an expected annual return of 10.37% on total capital invested.
