Edan Carignan, Caroline Rashidi, Shane Nath
Enterprise Resource Planning Computer System Upgrade
Sponsor: Mr. Gary Radine
Agenda
❖ Company Summary

❖ Project Summary

❖ Project Constraints

❖ Financing The Project
Using 100% Cash

❖ Maximum Debt
❖ Delayed Completion

❖ Delayed Layoffs

❖ Re-Upgrade of Project

❖ Possible Outcomes

❖ Recommendation

❖ Q&A
Company Summary
❖ Non-profit organization founded in 1954

❖ Largest dental plan system in the US

❖ 39 members covering all 50 states

❖ Enrollment and gross revenues doubled
by CEO Mr. Gary Radine
Project Summary
❖ Best method of implementing ERP system

❖ 35 page report

❖ 5 detailed scenarios

❖ Possible outcomes of each scenario

❖ Recommendation to Delta Dental
Delay of ERP
Implementation
Edan
All Cash Max Debt
Delayed
Layoffs
Shane
Re-Upgrade
Possible
Outcomes
Caroline

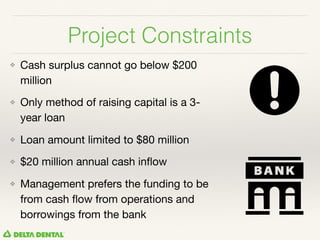

Project Constraints
❖ Cash surplus cannot go below $200
million

❖ Only method of raising capital is a 3-
year loan

❖ Loan amount limited to $80 million

❖ $20 million annual cash inflow

❖ Management prefers the funding to be
from cash flow from operations and
borrowings from the bank

Financing using 100% Cash
❖ Policy to not go below $200
million in cash reserves

❖ $106 million project cost

❖ Risks

❖ Leverage will decrease $75
$150
$225
$300
C
ash
Surplus
ProjectC
ost
Cash Surplus
Project Cost
Cash Reserve Limit

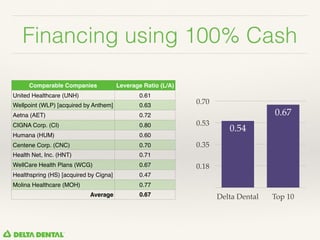

Financing using 100% Cash
Comparable Companies Leverage Ratio (L/A)
United Healthcare (UNH) 0.61
Wellpoint (WLP) [acquired by Anthem] 0.63
Aetna (AET) 0.72
CIGNA Corp. (CI) 0.80
Humana (HUM) 0.60
Centene Corp. (CNC) 0.70
Health Net, Inc. (HNT) 0.71
WellCare Health Plans (WCG) 0.67
Healthspring (HS) [acquired by Cigna] 0.47
Molina Healthcare (MOH) 0.77
Average 0.67
0.18
0.35
0.53
0.70
Delta Dental Top 10
0.67
0.54

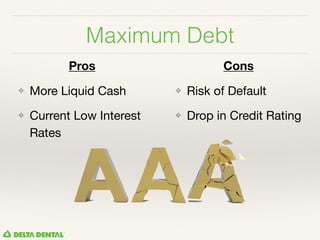

Maximum Debt
Pros
❖ More Liquid Cash

❖ Current Low Interest
Rates

Cons
❖ Risk of Default

❖ Drop in Credit Rating

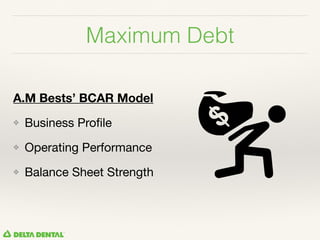

Maximum Debt
A.M Bests’ BCAR Model
❖ Business Profile

❖ Operating Performance

❖ Balance Sheet Strength

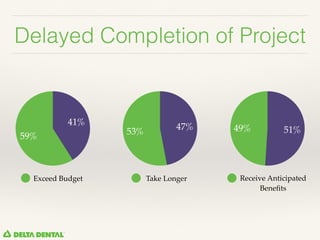

Delayed Completion of Project
59%
41%
Exceed Budget
53%
47%
Take Longer
49% 51%
Receive Anticipated
Benefits
Delayed Completion of Project
ERP Evaluation Team
Poorly Defined
Requirements
Change in Management
During Implementation
Choosing a Vendor Based
Solely On Sales Pitch
Lack of Employee
Training
Reason Solution
Involve more employees
than ERP Evaluation Team
Spend time understanding
your specific needs
Invest in comprehensive
training programs
Delayed Layoffs
Scenario
❖ Originally 400 layoffs in
year 4

❖ Delay of 200 employees
for 2 extra years
Reasons
❖ Project delayed

❖ System is not as efficient

❖ Employee adjustment time
Year 1 Year 2 Year 3 Year 4 Year 5 Year 6
Cash Surplus $300,000 $397,850 $417,850 $369,500 $403,750 $433,250
Cash from Operations $20,000 $20,000 $20,000 $20,000 $20,000 $20,000
Borrowed Capital $33,216 -$33,216
FTE Reductions $9,500 $14,250 $9,500 $4,750
Total $353,216 $417,850 $414,134 $403,750 $433,250 $458,000
Delayed Layoffs
Short Term Effects
❖ Pay extra $28.5 million

Long Term Effects
❖ Fear of layoffs

❖ Employee Morale
Decreases

❖ Workplace Productivity
Decreases
Outcome
❖ Layoffs are necessary

❖ Extra money is spent

❖ Fear within employees is set
$28.5
million

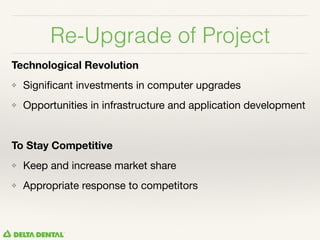

Re-Upgrade of Project
Technological Revolution
❖ Significant investments in computer upgrades

❖ Opportunities in infrastructure and application development

To Stay Competitive
❖ Keep and increase market share

❖ Appropriate response to competitors
Possible Outcomes
❖ Invest in marketing

❖ Invest in mobile platform

❖ Invest in research and risk management

❖ Lower insurance premiums

❖ Invest in money-market securities
Recommendation
❖ Balloon payment and FTE
layoffs happen concurrently

❖ Strict layoff policy

❖ ERP Evaluation Team

❖ After successful project,
Delta Dental should invest
in the previously mentioned
possible outcomes
68%
32%
Debt Cash
Questions?
Thank You

Delta Dental Analysis

  • 1.
    Edan Carignan, CarolineRashidi, Shane Nath Enterprise Resource Planning Computer System Upgrade Sponsor: Mr. Gary Radine
  • 2.
    Agenda ❖ Company Summary ❖Project Summary ❖ Project Constraints ❖ Financing The Project Using 100% Cash ❖ Maximum Debt ❖ Delayed Completion ❖ Delayed Layoffs ❖ Re-Upgrade of Project ❖ Possible Outcomes ❖ Recommendation ❖ Q&A
  • 3.
    Company Summary ❖ Non-profitorganization founded in 1954 ❖ Largest dental plan system in the US ❖ 39 members covering all 50 states ❖ Enrollment and gross revenues doubled by CEO Mr. Gary Radine
  • 4.
    Project Summary ❖ Bestmethod of implementing ERP system ❖ 35 page report ❖ 5 detailed scenarios ❖ Possible outcomes of each scenario ❖ Recommendation to Delta Dental Delay of ERP Implementation Edan All Cash Max Debt Delayed Layoffs Shane Re-Upgrade Possible Outcomes Caroline
  • 5.
    Project Constraints ❖ Cashsurplus cannot go below $200 million ❖ Only method of raising capital is a 3- year loan ❖ Loan amount limited to $80 million ❖ $20 million annual cash inflow ❖ Management prefers the funding to be from cash flow from operations and borrowings from the bank
  • 6.
    Financing using 100%Cash ❖ Policy to not go below $200 million in cash reserves ❖ $106 million project cost ❖ Risks ❖ Leverage will decrease $75 $150 $225 $300 C ash Surplus ProjectC ost Cash Surplus Project Cost Cash Reserve Limit
  • 7.
    Financing using 100%Cash Comparable Companies Leverage Ratio (L/A) United Healthcare (UNH) 0.61 Wellpoint (WLP) [acquired by Anthem] 0.63 Aetna (AET) 0.72 CIGNA Corp. (CI) 0.80 Humana (HUM) 0.60 Centene Corp. (CNC) 0.70 Health Net, Inc. (HNT) 0.71 WellCare Health Plans (WCG) 0.67 Healthspring (HS) [acquired by Cigna] 0.47 Molina Healthcare (MOH) 0.77 Average 0.67 0.18 0.35 0.53 0.70 Delta Dental Top 10 0.67 0.54
  • 8.
    Maximum Debt Pros ❖ MoreLiquid Cash ❖ Current Low Interest Rates Cons ❖ Risk of Default ❖ Drop in Credit Rating
  • 9.
    Maximum Debt A.M Bests’BCAR Model ❖ Business Profile ❖ Operating Performance ❖ Balance Sheet Strength
  • 10.
    Delayed Completion ofProject 59% 41% Exceed Budget 53% 47% Take Longer 49% 51% Receive Anticipated Benefits
  • 11.
    Delayed Completion ofProject ERP Evaluation Team Poorly Defined Requirements Change in Management During Implementation Choosing a Vendor Based Solely On Sales Pitch Lack of Employee Training Reason Solution Involve more employees than ERP Evaluation Team Spend time understanding your specific needs Invest in comprehensive training programs
  • 12.
    Delayed Layoffs Scenario ❖ Originally400 layoffs in year 4 ❖ Delay of 200 employees for 2 extra years Reasons ❖ Project delayed ❖ System is not as efficient ❖ Employee adjustment time Year 1 Year 2 Year 3 Year 4 Year 5 Year 6 Cash Surplus $300,000 $397,850 $417,850 $369,500 $403,750 $433,250 Cash from Operations $20,000 $20,000 $20,000 $20,000 $20,000 $20,000 Borrowed Capital $33,216 -$33,216 FTE Reductions $9,500 $14,250 $9,500 $4,750 Total $353,216 $417,850 $414,134 $403,750 $433,250 $458,000
  • 13.
    Delayed Layoffs Short TermEffects ❖ Pay extra $28.5 million Long Term Effects ❖ Fear of layoffs ❖ Employee Morale Decreases ❖ Workplace Productivity Decreases Outcome ❖ Layoffs are necessary ❖ Extra money is spent ❖ Fear within employees is set $28.5 million
  • 14.
    Re-Upgrade of Project TechnologicalRevolution ❖ Significant investments in computer upgrades ❖ Opportunities in infrastructure and application development To Stay Competitive ❖ Keep and increase market share ❖ Appropriate response to competitors
  • 15.
    Possible Outcomes ❖ Investin marketing ❖ Invest in mobile platform ❖ Invest in research and risk management ❖ Lower insurance premiums ❖ Invest in money-market securities
  • 16.

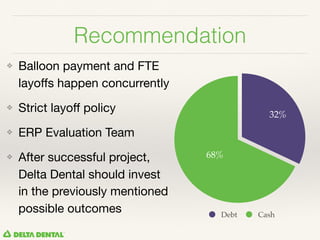

    Recommendation ❖ Balloon paymentand FTE layoffs happen concurrently ❖ Strict layoff policy ❖ ERP Evaluation Team ❖ After successful project, Delta Dental should invest in the previously mentioned possible outcomes 68% 32% Debt Cash
