Shukla shivprakash.J.
Mobile No : +971524783289
Emergency : +918140878314
+919016326561
Email ID : s.j.shukla1986@gmail.com
Objective
To master all the functions of construction of industrial buildings/sheds,
Govt. residential buildings for MES & State Electricity Board, Hospital, Real
Estate building & All type piling works while refining my skills &
capabilities, so as to contribute significantly towards attaining company
objectives, personal growth and job satisfaction.
Synopsis
Qualified 10th+2 & I.T.I Surveyor with over 12th+year of experience in
Civil Construction, Industrial Building, Govt. Residential building,
Hospital Building Civil Piling, Civil Pipe Line, Rail Line, Road, Port,
Construction field.
 Presently I am working Emguard Electro Mechanical & General Cont. L.L.C.
 Previously designated as a Site Civil Supervisor in Welspun Energy LTD.
 Previously designated as “Civil Supervisor” with "Adecco India pvt ltd "Under
(EPIL).
1. I have involved in various IOCL Refinery projects At Paradeep ,
Jagatsinghpur, Orissa.
 Previously designated as “Civil Piling Supervisor” with Essar Const. (i) LTD
1. I have involved in various Steel Plant projects At Hazira,Surat,Gujarat.
2. I have involved in various Power Plant projects At Hazira,Surat,Gujarat.
3. I have involved in various Port & Jetty projects At Hazira,Surat,Gujarat.
 Previously designated as “Surveyor & Civil Supervisor ”with" S.B.Modi
Construction (i) Pvt. LTD.
Professional Experience
1. S.B.Modi Construction (I) pvt.ltd----------------------------------COMPANY
PROFILE
S.B.Modi Construction is a national company and The Hazira Industrial Area
Ltd. is the part of this company. Basically This is a Infrastructure Development
Project handling company which having the main work is like Industrial
Building, Road, Rail line,Water Pipe line, Wastage water Hume Pipe line, LNG
,LPG & CNG Gas Pipe line, HT line ,LT line, New substation (33/11 KV)
installation, etc..
JOB PROFILE :-- Asst. SURVEYOR & Site Supervisor: ------- Date- August
2004 to October 2007
I am including mainly in New sub-station installation with all Civil works (Road,
Culvert, Boundary Wall, Earth Work,) and also doing foundation and installation
of VCB, CT, PT, LA, Take-up structure, and all conductor connections (33
incomer to 11 KV out going). I am doing properly as per the specification. Survey
& lessoning services for the company progress. providing all type of Surveying
Instruments Handling Like.
JOB RESPONSIBILITIES AT SITE :--

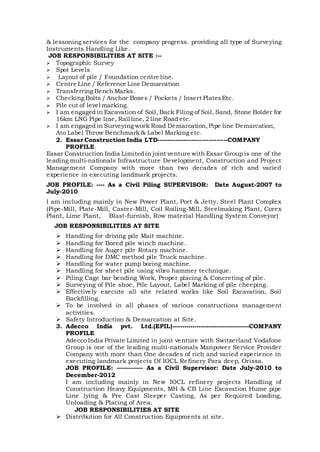

 Topographic Survey
 Spot Levels
 Layout of pile / Foundation centre line.
 Centre Line / Reference Line Demarcation
 Transferring Bench Marks.
 Checking Bolts / Anchor Boxes / Pockets / Insert PlatesEtc.
 Pile cut of level marking.
 I am engaged in Excavation of Soil, Back Filing of Soil, Sand, Stone Bolder for
16km LNG Pipe line, Rail line, 2 line Road etc.
 I am engaged in Surveying work Road Demarcation,Pipe line Demarcation,
Ato Label Throw Benchmark & Label Marking etc.
2. Essar Construction India LTD----------------------------------COMPANY
PROFILE
Essar Construction India Limited in joint venture with Essar Group is one of the
leading multi-nationals Infrastructure Development, Construction and Project
Management Company with more than two decades of rich and varied
experience in executing landmark projects.
JOB PROFILE: ---- As a Civil Piling SUPERVISOR: Date August-2007 to
July-2010
I am including mainly in New Power Plant, Port & Jetty, Steel Plant Complex
(Pipe-Mill, Plate-Mill, Caster-Mill, Coil Roiling-Mill, Steelmaking Plant, Corex
Plant, Lime Plant, Blast-furnish, Row material Handling System Conveyor)
JOB RESPONSIBILITIES AT SITE
 Handling for driving pile Mait machine.
 Handling for Bored pile winch machine.
 Handling for Auger pile Rotary machine.
 Handling for DMC method pile Truck machine.
 Handling for water pump boring machine.
 Handling for sheet pile using vibro hammer technique.
 Piling Cage bar bending Work, Proper placing & Concreting of pile.
 Surveying of Pile shoe, Pile Layout, Label Marking of pile cheeping.
 Effectively execute all site related works like Soil Excavation, Soil
Backfilling.
 To be involved in all phases of various constructions management
activities.
 Safety Introduction & Demarcation at Site.
3. Adecco India pvt. Ltd.(EPIL)--------------------------------------COMPANY
PROFILE
Adecco India Private Limited in joint venture with Switzerland Vodafone
Group is one of the leading multi-nationals Manpower Service Provider
Company with more than One decades of rich and varied experience in
executing landmark projects Of IOCL Refinery Para deep, Orissa.
JOB PROFILE: ------------- As a Civil Supervisor: Date July-2010 to
December-2012
I am including mainly in New IOCL refinery projects Handling of
Construction Heavy Equipments, MH & CB Line Excavation Hume pipe
Line lying & Pre Cast Sleeper Casting, As per Required Loading,
Unloading & Placing of Area.
JOB RESPONSIBILITIES AT SITE
 Distribution for All Construction Equipments at site.
 Earth work and all civil construction projects like concrete structure, tank
foundation, equipment foundations, control buildings, substation
buildings, UG pipe line, Cable trench Drain, Temporary road Heavy
Equipments moment work.
 Responsible for all inspection of civil industrial and commercial
construction work to effectively implement quality workmanship in
accordance with approved plan and specifications.
 Monitoring progress of the Project planning and scheduling.
 Preparing daily and monthly report for management & Sub Contractors
review.
 To be involved in all phases of various constructions management
activities.
 Effectively execute all site related works like Excavation, bar bending &
placing, surveying, Form work, concreting, leveling, backfilling at Site.
 Safety Induction & Demarcations at Site.

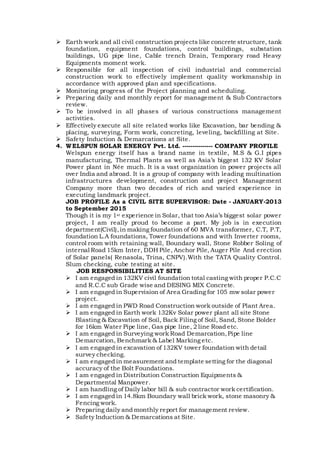

4. WELSPUN SOLAR ENERGY Pvt. Ltd. --------------- COMPANY PROFILE
Welspun energy itself has a brand name in textile, M.S & G.I pipes
manufacturing, Thermal Plants as well as Asia’s biggest 132 KV Solar
Power plant in Née much. It is a vast organization in power projects all
over India and abroad. It is a group of company with leading multination
infrastructures development, construction and project Management
Company more than two decades of rich and varied experience in
executing landmark project.
JOB PROFILE As a CIVIL SITE SUPERVISOR: Date - JANUARY-2013
to September 2015
Though it is my 1st experience in Solar, that too Asia’s biggest solar power
project, I am really proud to become a part. My job is in execution
department(Civil),in making foundation of 60 MVA transformer, C.T, P.T,
foundation L.A foundations, Tower foundations and with Inverter rooms,
control room with retaining wall, Boundary wall, Stone Robber Soling of
internal Road 15km Inter, DDH Pile, Anchor Pile, Auger Pile And erection
of Solar panels( Renasola, Trina, CNPV).With the TATA Quality Control.
Slum checking, cube testing at site.
JOB RESPONSIBILITIES AT SITE
 I am engaged in 132KV civil foundation total casting with proper P.C.C
and R.C.C sub Grade wise and DESING MIX Concrete.
 I am engaged in Supervision of Area Grading for 105 mw solar power
project.
 I am engaged in PWD Road Construction work outside of Plant Area.
 I am engaged in Earth work 132Kv Solar power plant all site Stone
Blasting & Excavation of Soil, Back Filing of Soil, Sand, Stone Bolder
for 16km Water Pipe line, Gas pipe line, 2 line Road etc.
 I am engaged in Surveying work Road Demarcation,Pipe line
Demarcation, Benchmark & Label Marking etc.
 I am engaged in excavation of 132KV tower foundation with detail
survey checking.
 I am engaged in measurement and template setting for the diagonal
accuracy of the Bolt Foundations.
 I am engaged in Distribution Construction Equipments &
Departmental Manpower.
 I am handling of Daily labor bill & sub contractor work certification.
 I am engaged in 14.8km Boundary wall brick work, stone masonry &
Fencing work.
 Preparing daily and monthly report for management review.
 Safety Induction & Demarcations at Site.
5. Emguard Electro Mechanical & General Cont. L.L.C. Abu-Dhabi, U.A.E
Emguard Electro Mechanical & General Cont. L.L.C. in joint venture with
NCC Group is one of the leading multi-nationals Power Energy
Development, Construction and Project Management Company with more
than One decades of rich and varied experience in executing landmark
projects.
JOB PROFILE As a SUPERVISOR Civil : Date – September -2015 to
TILLDATE
I am including mainly in New sub-station installation with all Civil
works(Road, Culvert, Boundary Wall, Earth Work,) and also doing foundation
and structure, and all conductor connections(33 incomer to 11 KV out going). I
am doing properly as per the specification.Supervisor Civil & lessoning services
for the company progress. providing all type of Surveying Instruments Handling
Like.
JOB RESPONSIBILITIES AT SITE:
 I am engaged in Sub-Station Building for Excavation of Soil, Back Filing of
Soil, Sand, Stone Bolder for Home Pipe line, Boundary wall, Internal Road
etc.
 I am engaged in Surveying work Road Demarcation,Pipe line Demarcation,
Ato Label Throw Benchmark & Label Marking, Topographic Survey, Spot
Levels etc.
 I am engaged in Distribution for All Construction Equipments at site.
 I am handling total manpower transportation planning day to day.
 Prepare man-hour estimates, manpower forecasts,schedulesand the man-
power allocation plan.
 I am also involved in manpower planning to get maximum utilization of
manpower and to get maximum output.
 Ensure that the approved procedures and work instructions are adopted and
followed within the project group.
 Preparationsof client billing time (running and extra claimas and when
required) Anchoring on-site construction activities as per the given drawings
to ensure completion of project within the time & cost parameters, quality
and effective resource utilization to maximize the output.
 Execution of all construction activities as per drawing and schedule.
 Planning the works and organize the plants and tools efficiently.
 Responsible for all activitieslike Block Masonry, Plastering,flooring,
Fairfacing,waterproofing, painting, Screeding,etc.
 All these jobs are done with safely and insisting the crew to do all the jobs
safely.
 A pre-job safety meetingis done along with potential hazards review before
doing any job Methodical and logical approach to work.
Operating System : Microsoft Windows.
Languages : PROFESSIONAL.
Software tools : Microsoft Office, Word, Excel
Personal Information

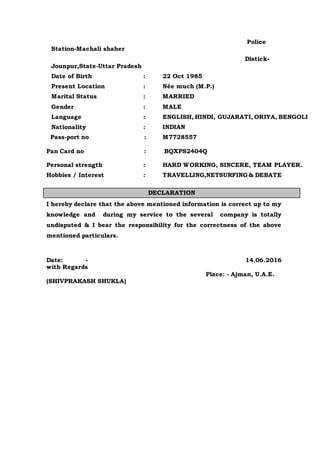

Father’s Name : Mr. JAGATNARAYAN SHUKLA
Permanent Address : Village-DiyawanMahadev-114no:
makan
Post-
Gohaka, Pin-222227
Skill set (Personal and Professional)
Police
Station-Machali shaher
Distick-
Jounpur,State-Uttar Pradesh
Date of Birth : 22 Oct 1985
Present Location : Née much (M.P.)
Marital Status : MARRIED
Gender : MALE
Language : ENGLISH, HINDI, GUJARATI, ORIYA, BENGOLI
Nationality : INDIAN
Pass-port no : M7728557
Pan Card no : BQXPS2404Q
Personal strength : HARD WORKING, SINCERE, TEAM PLAYER.
Hobbies / Interest : TRAVELLING,NETSURFING & DEBATE
I hereby declare that the above mentioned information is correct up to my
knowledge and during my service to the several company is totally
undisputed & I bear the responsibility for the correctness of the above
mentioned particulars.
Date: - 14.06.2016
with Regards
Place: - Ajman, U.A.E.
(SHIVPRAKASH SHUKLA)
DECLARATION

CV Shukla

  • 1.
    Shukla shivprakash.J. Mobile No: +971524783289 Emergency : +918140878314 +919016326561 Email ID : s.j.shukla1986@gmail.com Objective To master all the functions of construction of industrial buildings/sheds, Govt. residential buildings for MES & State Electricity Board, Hospital, Real Estate building & All type piling works while refining my skills & capabilities, so as to contribute significantly towards attaining company objectives, personal growth and job satisfaction. Synopsis Qualified 10th+2 & I.T.I Surveyor with over 12th+year of experience in Civil Construction, Industrial Building, Govt. Residential building, Hospital Building Civil Piling, Civil Pipe Line, Rail Line, Road, Port, Construction field.  Presently I am working Emguard Electro Mechanical & General Cont. L.L.C.  Previously designated as a Site Civil Supervisor in Welspun Energy LTD.  Previously designated as “Civil Supervisor” with "Adecco India pvt ltd "Under (EPIL). 1. I have involved in various IOCL Refinery projects At Paradeep , Jagatsinghpur, Orissa.  Previously designated as “Civil Piling Supervisor” with Essar Const. (i) LTD 1. I have involved in various Steel Plant projects At Hazira,Surat,Gujarat. 2. I have involved in various Power Plant projects At Hazira,Surat,Gujarat. 3. I have involved in various Port & Jetty projects At Hazira,Surat,Gujarat.  Previously designated as “Surveyor & Civil Supervisor ”with" S.B.Modi Construction (i) Pvt. LTD. Professional Experience 1. S.B.Modi Construction (I) pvt.ltd----------------------------------COMPANY PROFILE S.B.Modi Construction is a national company and The Hazira Industrial Area Ltd. is the part of this company. Basically This is a Infrastructure Development Project handling company which having the main work is like Industrial Building, Road, Rail line,Water Pipe line, Wastage water Hume Pipe line, LNG ,LPG & CNG Gas Pipe line, HT line ,LT line, New substation (33/11 KV) installation, etc.. JOB PROFILE :-- Asst. SURVEYOR & Site Supervisor: ------- Date- August 2004 to October 2007 I am including mainly in New sub-station installation with all Civil works (Road, Culvert, Boundary Wall, Earth Work,) and also doing foundation and installation of VCB, CT, PT, LA, Take-up structure, and all conductor connections (33 incomer to 11 KV out going). I am doing properly as per the specification. Survey
  • 2.
    & lessoning servicesfor the company progress. providing all type of Surveying Instruments Handling Like. JOB RESPONSIBILITIES AT SITE :--  Topographic Survey  Spot Levels  Layout of pile / Foundation centre line.  Centre Line / Reference Line Demarcation  Transferring Bench Marks.  Checking Bolts / Anchor Boxes / Pockets / Insert PlatesEtc.  Pile cut of level marking.  I am engaged in Excavation of Soil, Back Filing of Soil, Sand, Stone Bolder for 16km LNG Pipe line, Rail line, 2 line Road etc.  I am engaged in Surveying work Road Demarcation,Pipe line Demarcation, Ato Label Throw Benchmark & Label Marking etc. 2. Essar Construction India LTD----------------------------------COMPANY PROFILE Essar Construction India Limited in joint venture with Essar Group is one of the leading multi-nationals Infrastructure Development, Construction and Project Management Company with more than two decades of rich and varied experience in executing landmark projects. JOB PROFILE: ---- As a Civil Piling SUPERVISOR: Date August-2007 to July-2010 I am including mainly in New Power Plant, Port & Jetty, Steel Plant Complex (Pipe-Mill, Plate-Mill, Caster-Mill, Coil Roiling-Mill, Steelmaking Plant, Corex Plant, Lime Plant, Blast-furnish, Row material Handling System Conveyor) JOB RESPONSIBILITIES AT SITE  Handling for driving pile Mait machine.  Handling for Bored pile winch machine.  Handling for Auger pile Rotary machine.  Handling for DMC method pile Truck machine.  Handling for water pump boring machine.  Handling for sheet pile using vibro hammer technique.  Piling Cage bar bending Work, Proper placing & Concreting of pile.  Surveying of Pile shoe, Pile Layout, Label Marking of pile cheeping.  Effectively execute all site related works like Soil Excavation, Soil Backfilling.  To be involved in all phases of various constructions management activities.  Safety Introduction & Demarcation at Site. 3. Adecco India pvt. Ltd.(EPIL)--------------------------------------COMPANY PROFILE Adecco India Private Limited in joint venture with Switzerland Vodafone Group is one of the leading multi-nationals Manpower Service Provider Company with more than One decades of rich and varied experience in executing landmark projects Of IOCL Refinery Para deep, Orissa. JOB PROFILE: ------------- As a Civil Supervisor: Date July-2010 to December-2012 I am including mainly in New IOCL refinery projects Handling of Construction Heavy Equipments, MH & CB Line Excavation Hume pipe Line lying & Pre Cast Sleeper Casting, As per Required Loading, Unloading & Placing of Area. JOB RESPONSIBILITIES AT SITE  Distribution for All Construction Equipments at site.
  • 3.
     Earth workand all civil construction projects like concrete structure, tank foundation, equipment foundations, control buildings, substation buildings, UG pipe line, Cable trench Drain, Temporary road Heavy Equipments moment work.  Responsible for all inspection of civil industrial and commercial construction work to effectively implement quality workmanship in accordance with approved plan and specifications.  Monitoring progress of the Project planning and scheduling.  Preparing daily and monthly report for management & Sub Contractors review.  To be involved in all phases of various constructions management activities.  Effectively execute all site related works like Excavation, bar bending & placing, surveying, Form work, concreting, leveling, backfilling at Site.  Safety Induction & Demarcations at Site. 4. WELSPUN SOLAR ENERGY Pvt. Ltd. --------------- COMPANY PROFILE Welspun energy itself has a brand name in textile, M.S & G.I pipes manufacturing, Thermal Plants as well as Asia’s biggest 132 KV Solar Power plant in Née much. It is a vast organization in power projects all over India and abroad. It is a group of company with leading multination infrastructures development, construction and project Management Company more than two decades of rich and varied experience in executing landmark project. JOB PROFILE As a CIVIL SITE SUPERVISOR: Date - JANUARY-2013 to September 2015 Though it is my 1st experience in Solar, that too Asia’s biggest solar power project, I am really proud to become a part. My job is in execution department(Civil),in making foundation of 60 MVA transformer, C.T, P.T, foundation L.A foundations, Tower foundations and with Inverter rooms, control room with retaining wall, Boundary wall, Stone Robber Soling of internal Road 15km Inter, DDH Pile, Anchor Pile, Auger Pile And erection of Solar panels( Renasola, Trina, CNPV).With the TATA Quality Control. Slum checking, cube testing at site. JOB RESPONSIBILITIES AT SITE  I am engaged in 132KV civil foundation total casting with proper P.C.C and R.C.C sub Grade wise and DESING MIX Concrete.  I am engaged in Supervision of Area Grading for 105 mw solar power project.  I am engaged in PWD Road Construction work outside of Plant Area.  I am engaged in Earth work 132Kv Solar power plant all site Stone Blasting & Excavation of Soil, Back Filing of Soil, Sand, Stone Bolder for 16km Water Pipe line, Gas pipe line, 2 line Road etc.  I am engaged in Surveying work Road Demarcation,Pipe line Demarcation, Benchmark & Label Marking etc.  I am engaged in excavation of 132KV tower foundation with detail survey checking.  I am engaged in measurement and template setting for the diagonal accuracy of the Bolt Foundations.  I am engaged in Distribution Construction Equipments & Departmental Manpower.  I am handling of Daily labor bill & sub contractor work certification.  I am engaged in 14.8km Boundary wall brick work, stone masonry & Fencing work.  Preparing daily and monthly report for management review.  Safety Induction & Demarcations at Site.
  • 4.
    5. Emguard ElectroMechanical & General Cont. L.L.C. Abu-Dhabi, U.A.E Emguard Electro Mechanical & General Cont. L.L.C. in joint venture with NCC Group is one of the leading multi-nationals Power Energy Development, Construction and Project Management Company with more than One decades of rich and varied experience in executing landmark projects. JOB PROFILE As a SUPERVISOR Civil : Date – September -2015 to TILLDATE I am including mainly in New sub-station installation with all Civil works(Road, Culvert, Boundary Wall, Earth Work,) and also doing foundation and structure, and all conductor connections(33 incomer to 11 KV out going). I am doing properly as per the specification.Supervisor Civil & lessoning services for the company progress. providing all type of Surveying Instruments Handling Like. JOB RESPONSIBILITIES AT SITE:  I am engaged in Sub-Station Building for Excavation of Soil, Back Filing of Soil, Sand, Stone Bolder for Home Pipe line, Boundary wall, Internal Road etc.  I am engaged in Surveying work Road Demarcation,Pipe line Demarcation, Ato Label Throw Benchmark & Label Marking, Topographic Survey, Spot Levels etc.  I am engaged in Distribution for All Construction Equipments at site.  I am handling total manpower transportation planning day to day.  Prepare man-hour estimates, manpower forecasts,schedulesand the man- power allocation plan.  I am also involved in manpower planning to get maximum utilization of manpower and to get maximum output.  Ensure that the approved procedures and work instructions are adopted and followed within the project group.  Preparationsof client billing time (running and extra claimas and when required) Anchoring on-site construction activities as per the given drawings to ensure completion of project within the time & cost parameters, quality and effective resource utilization to maximize the output.  Execution of all construction activities as per drawing and schedule.  Planning the works and organize the plants and tools efficiently.  Responsible for all activitieslike Block Masonry, Plastering,flooring, Fairfacing,waterproofing, painting, Screeding,etc.  All these jobs are done with safely and insisting the crew to do all the jobs safely.  A pre-job safety meetingis done along with potential hazards review before doing any job Methodical and logical approach to work. Operating System : Microsoft Windows. Languages : PROFESSIONAL. Software tools : Microsoft Office, Word, Excel Personal Information Father’s Name : Mr. JAGATNARAYAN SHUKLA Permanent Address : Village-DiyawanMahadev-114no: makan Post- Gohaka, Pin-222227 Skill set (Personal and Professional)
  • 5.
    Police Station-Machali shaher Distick- Jounpur,State-Uttar Pradesh Dateof Birth : 22 Oct 1985 Present Location : Née much (M.P.) Marital Status : MARRIED Gender : MALE Language : ENGLISH, HINDI, GUJARATI, ORIYA, BENGOLI Nationality : INDIAN Pass-port no : M7728557 Pan Card no : BQXPS2404Q Personal strength : HARD WORKING, SINCERE, TEAM PLAYER. Hobbies / Interest : TRAVELLING,NETSURFING & DEBATE I hereby declare that the above mentioned information is correct up to my knowledge and during my service to the several company is totally undisputed & I bear the responsibility for the correctness of the above mentioned particulars. Date: - 14.06.2016 with Regards Place: - Ajman, U.A.E. (SHIVPRAKASH SHUKLA) DECLARATION
