C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organisation
CONTENTS
1.0 ABOUT US
2.0 CAPAB ILITIES
3 .0 OUR TEAM
4.0 PROJECT EXPERIENCE
5.0 LIS T OF CLIEN TS
C.P.CONSULTANTS PVT. LTD.
1.1
An ISO 9001: 2008 certified organization
ABOUT US
C.P.CONSULTANTS PVT. LTD.
1.2
An ISO 9001: 2008 certified organization
INTRODUCTION
C.P. CONSULTANTS Pvt. Ltd. (CPC) is a multidisciplinary consultancy organisation based at New
Delhi. This organisation was nucleated in 1984 and provides consultancy services from “concept
to commissioning” by number of Technocrats and Management personnel under the able
guidance of its Managing Director, Dr. A. Mukherjee.
The project related service generally includes Market Research, Detailed Project Reports,
Preparation of Feasibility Report, Process Design & Engineering, Equipment Procurement
Assistance, and Supervision during Construction, Start-up and Commissioning.
The organisation specializes in undertaking Baseline Surveys, Safety, Health and Environment
research studies including collection and analyses of Environmental Data, Environment Impact
Assessment Studies (Rapid and Comprehensive), Environment Audit, Environment
Management Plan, Consent to Establish, Consent to Operate from State Pollution Control
Board, liaison for local administrative clearances, Safety Audits, (both rapid and
comprehensive), HAZOP Studies, Risk Assessment (Qualitative and Quantitative), Design and
Engineering of Fire Fighting systems as per TAC/ NFPA and Disaster Mitigation/ Management
Plan.
Services provided not only involve own team of experts, collaborating with technical experts or
advisors are also arranged. CPC has an extensive and wide network for obtaining various
primary information services throughout India.
Since its inception the organisation is also providing architectural, structural, mechanical,
electrical and civil engineering all pertaining to the aforesaid industries. CPC also undertakes
trial run studies for evaluation of process parameters for improving or optimizing the total
technology.
C.P.CONSULTANTS PVT. LTD.
1.3
An ISO 9001: 2008 certified organization

CPC is proud to be in professional association with number of service providers like testing
laboratories and equipment fabricators for any kind of industrial needs.
In addition to the above service spectrum, CPC also promotes Propane as an alternate and
clean fuel as a “Marketing Associate” for Indian Oil Petronas Pvt. Ltd. and in providing support
for implementing “Fellingsdam-waste water stabilization ponds” from Jarven Ecotech, Sweden.
CPC has been listed as “approved consultant” by the Ministry of Environment and Forests,
Government of India for carrying out Environmental Impact Assessment Studies.
TARGET SECTORS
1. Industrial/Agro/Fine Chemicals 8. Food processing
2. Hazardous Chemicals 9. Bio-fuels
3. Petrochemicals 10. Ceramics
4. Plastics 11. Paints & Dyes
5. Drugs & Pharmaceuticals 12. Paper
6. Infrastructure/Water Resources 13. Tourism
7. Storage Terminals, Bottling Plants 14. Polymer Composites
SERVICES
MARKET INTELLIGENCE
 Industrial Research  Socio-Economic Research
 Consumer Research  Demand Study
 Product Study  Econometric Modelling
 Macro Level Study  Sample Survey
 Export Potential Studies  Multi Client Study
 Base Line Data Collection  Market Potential Status
C.P.CONSULTANTS PVT. LTD.
1.4
An ISO 9001: 2008 certified organization

PROJECTS AND STUDIES
 Project Identification Studies  Entry Level Studies
 Project profile  Technology Search Studies
 Techno Economic Feasibility Study  Joint Venture Identification Studies
 Detailed Project Report  Data Base Services
 Technology Status Reports  Location Studies
 Plant Revival Studies  Valuation of Assets
 In-plant study for process improvements  Work – In- Progress
 Technology & Raw Material Assessment  Inventory needs and SCM
SAFETY, HEALTH AND ENVIRONMENT
 Safety Audits  Risk Assessment
 Disaster Management Plan  Environment Management Plan
 Environment Impact Assessment  HAZOP Studies
 Safety, Health & Environment
Awareness and Appraisal
 Solid Waste Management Studies
 Plant Health Assessment
 Material and Energy Balance for SSI  Energy Conservation Study/ Audits
ENGINEERING
 Process Engineering  Instrumentation
 Detailed Engineering  Project management Services
 Architectural Civil & Structural
Engineering


Procurement and inspection
Erection supervision
 Mechanical & Piping Engineering  Commissioning.
 Electrical & Air-conditioning  Fire Fighting Systems
 GIS and Mapping 
C.P.CONSULTANTS PVT. LTD.
1.5
An ISO 9001: 2008 certified organization

INTERNATIONAL EXPERIENCE
The consultants have experience in working in international environment with emphasis in
basic engineering, foreign technology collaboration, sourcing and knowledge sharing. In the
past, the organisation had successfully completed a number of projects involving foreign
collaborators.
The consultants have experience in working in various countries like CIS, Taiwan, USA,
Germany, etc. A brief project list involving foreign technology is given below:
 Basic Engineering works for cryogenic LPG storage, for Trachtobel, West Germany
 Engineering consultancy, Indo-Gulf Explosives, and technology sourcing from Gulf Oil, USA
 Orient Ceramics, collaboration with Agrob and Heimsoth, West Germany
 Facility Creation for Pharmaceuticals, Albert David, in collaboration with Upjohn, USA.
 Technology Transfer of Aluminium Technology Cryolite Recovery Plant, Russia for BALCO
o Basic Engineering, Detailed Design Engineering & Trouble shooting
 Technology Transfer of Silk Textile Mills, Kazakhstan prepared for marketing purpose
 Technology Transfer of Food Processing Plant (fruit juices of apple, cherry, apricot),
Samarkand, Uzbekistan prepared for marketing purpose
 Technology Transfer (Basic Engineering) of Beer from Wheat for establishments in CIS
countries
 Thermographic Techniques for predictive maintenance, through initial assistance from
Infra-inspection institute, USA for diagnostic study of power and fertilizer plants,
 Technology Transfer ( Basic Engineering) of Manufacture of abrasives, Taskent prepared for
marketing purpose
 Technical support services for setting up process plants to foreign investors in Uzbekistan
C.P.CONSULTANTS PVT. LTD.
1.6
An ISO 9001: 2008 certified organization
CORPORATE SOCIAL RESPONSIBILITY
CPC believes in extending professional assistance as and when sought by reputed NGOs for
betterment of socio-economic conditions in urban as well as in rural backdrop. Presently, such
activities extend to:
(i) Imparting specialized training and extending advisory services
(ii) Extending technical know-how to the rural workers like artisans, SHGs, etc
(iii) Help sensitizing people about environment
(iv) Assistance for Rural Entrepreneurs
(v) Assisting in project proposal writing
SOCIAL & RURAL DEVELOPMENT
India is still a predominantly agricultural economy, and more than 3/4ths of people still reside
in rural areas. With large human resource capabilities, it presents a huge arena for sustainable
investments. CPC with its social arm “Shristi” has been actively involved in educating, creating
employment opportunities through self help groups and striving for secured financial future for
handicraft artisans through socio-technological & marketing inputs. CPC also supports youth
movement like the Indian Youth Climate Network in spreading awareness about climate change
and preserving biodiversity.
CPC, through its social and rural development arm, provide education & awareness to village
people by means of organizing seminars, door to door campaigns, workshops, marketing
support, etc. The main objective is imparting basic education and arranging for necessary
technology support through existing government mechanisms, public private partnerships, for
better product design and marketability.
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.1
CAPABILITIES
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.1
ENGINEERING SOLUTIONS
A sound engineering always assist projects in
hassle free commissioning and coming in real
terms as per best possible design standards
applicable thus saving time and economics.
Since, it’s inception, the organization has a
steered a number of projects in diverse fields at
various stages till commission. An engineering
team along with experts delivers customized
and viable engineering solutions to its clients.
CPC has in-house capabilities to undertake
project profiles, feasibility reports, basic
engineering in all sectors and detailed design
and engineering in selected sectors. CPC has
successfully assisted entrepreneurs and
corporate in setting up plants based on techno-
commercial viability studies. CPC has pioneered
the commercialization of activated carbon from
bamboo with the help of NMBA as well as IIT
Mumbai.
ENVIRONMENTAL STUDIES
In India, the environment related assignments
are largely governed by the need of a party to
show compliance to existing regulations and by
others as to provide base information on
diverse related subjects that are in a form of
data collection, documentation or simply
putting existing records in one place so as to aid
stakeholders in policy or regulations
framework. CPC has been involved in this field
for the last 15 years, successfully completing a
number of assignments. The organisation has
also been engaged by big corporates for their
projects in India. Also, the organisation has
developed expertise and competence in
workplace/ industrial Safety, Health and
Environment jobs carrying out safety audits, risk
assessment studies, etc. The total worth of
surveys, studies done in this area is around
Rs30.0 million till date.
RISK ASSESSMENT & DISASTER
MANAGEMENT
The increasing need for a methodological
assessment of disasters, both man-made &
natural has been voiced all over the world. In
India, the government and other stakeholders
have been lately working in implementing
necessary regulatory framework and social
infrastructure for better preparedness in times
of emergency. The element of Disaster
Management which is now projected as a
specialized subject and is shown as a separate
chapter in many documents was effectively
covered in feasibility report, design and
engineering documents from the beginning by
our organisation as an added dimension. Hence,
the organisation is well equipped to carry out
any type of safety audits, risk assessment,
onsite & offsite emergency plan, environment
impact assessment.
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.2

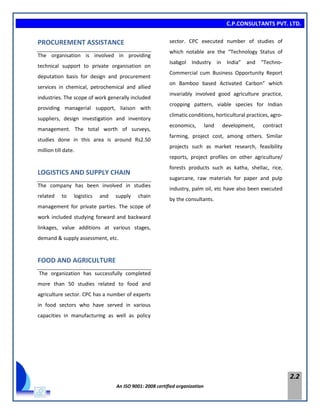

PROCUREMENT ASSISTANCE
The organisation is involved in providing
technical support to private organisation on
deputation basis for design and procurement
services in chemical, petrochemical and allied
industries. The scope of work generally included
providing managerial support, liaison with
suppliers, design investigation and inventory
management. The total worth of surveys,
studies done in this area is around Rs2.50
million till date.
LOGISTICS AND SUPPLY CHAIN
The company has been involved in studies
related to logistics and supply chain
management for private parties. The scope of
work included studying forward and backward
linkages, value additions at various stages,
demand & supply assessment, etc.
FOOD AND AGRICULTURE
The organization has successfully completed
more than 50 studies related to food and
agriculture sector. CPC has a number of experts
in food sectors who have served in various
capacities in manufacturing as well as policy
sector. CPC executed number of studies of
which notable are the “Technology Status of
Isabgol Industry in India” and “Techno-
Commercial cum Business Opportunity Report
on Bamboo based Activated Carbon” which
invariably involved good agriculture practice,
cropping pattern, viable species for Indian
climatic conditions, horticultural practices, agro-
economics, land development, contract
farming, project cost, among others. Similar
projects such as market research, feasibility
reports, project profiles on other agriculture/
forests products such as katha, shellac, rice,
sugarcane, raw materials for paper and pulp
industry, palm oil, etc have also been executed
by the consultants.
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.2
SEMINARS ORGANISED
 Industrial Drying Technology
Venue: Hyatt Regency Hotel, New Delhi
On: 12th
& 13th
January, 1989
Speakers:
Dr. Arun.S.Majumdar, Professor in Chemical Engineering,
Mc Gill University Montreat, Canada.
Mr. S.C.Dhingra, Chemical Engineer Department, I.I.T. Delhi
Dr. Rohit. M. Shah, Vice President (Tech), Mac Neill & Magor Ltd., Bombay
 Risk Assessment in Oil Refinery and Petrochemical Complexes.
Venue: Central Pollution Control Board (C.P.C.B), New Delhi
On: 29th
to 31st
December, 2003
Speakers:
Dr. S.K.Biswas, Advisor, CPC, Safety Health and Environment.
Mr. S.N.Mitra, Advisor, CPC, Safety Health and Environment.
Dr. A.Mukherjee, M.D, C.P.Consultants Pvt. Ltd., New Delhi
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.3
INSTITUTIONAL RECOGNITION AND PROFESSIONAL MEMBERSHIP
INSTITUTIONAL RECOGNITION
C.P. Consultants Pvt. Ltd. shares recognition and approval as consultancy firm from the following
Institutions:
 Ministry of Environment and Forests, Government of India
 Central Pollution Control Board, Ministry of Environment & Forests, Govt. of India
 Consultancy Development Centre (CDC) (Supported by DSIR, Ministry of Science &
Technology
 Industrial Development Bank of India (IDBI)
 Quality council of India (QCI)
 Department of Science and Technology, Ministry of Science & Technology, Government
of India
 Technology Information and Forecasting Assessment Council (TIFAC)
 National Research Development Corporation (NRDC), New Delhi
 National Mission on Bamboo Application, (NMBA), New Delhi
 Punjab National Bank, Chandigarh
 Department of Explosives, Government of India as Competent Person
 Rajasthan State Industrial Development and Investment Corporation Ltd. (RIICO)
 The Pradeshiya Industrial & Investment Corporation of U.P. Ltd. (PICUP)
 Bihar State Pharmaceutical & Chemical Development Corporation Ltd. (BSPCDC), Patna
 Sriram Institute for Industrial Research (SRI), New Delhi
CPC is also registered with Asian Development Bank’s consulting management system
(003955)
PROFESSIONAL MEMBERSHIP
1. Consultancy Development Centre
2. Quality Council of India
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.4

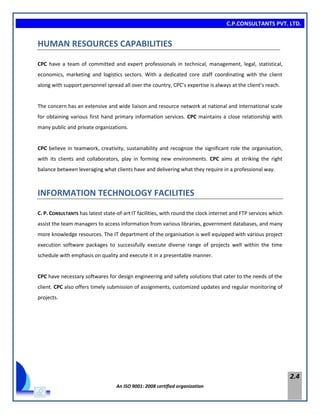

HUMAN RESOURCES CAPABILITIES
CPC have a team of committed and expert professionals in technical, management, legal, statistical,
economics, marketing and logistics sectors. With a dedicated core staff coordinating with the client
along with support personnel spread all over the country, CPC’s expertise is always at the client’s reach.
The concern has an extensive and wide liaison and resource network at national and international scale
for obtaining various first hand primary information services. CPC maintains a close relationship with
many public and private organizations.
CPC believe in teamwork, creativity, sustainability and recognize the significant role the organisation,
with its clients and collaborators, play in forming new environments. CPC aims at striking the right
balance between leveraging what clients have and delivering what they require in a professional way.
INFORMATION TECHNOLOGY FACILITIES
C. P. CONSULTANTS has latest state-of-art IT facilities, with round the clock internet and FTP services which
assist the team managers to access information from various libraries, government databases, and many
more knowledge resources. The IT department of the organisation is well equipped with various project
execution software packages to successfully execute diverse range of projects well within the time
schedule with emphasis on quality and execute it in a presentable manner.
CPC have necessary softwares for design engineering and safety solutions that cater to the needs of the
client. CPC also offers timely submission of assignments, customized updates and regular monitoring of
projects.
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.5

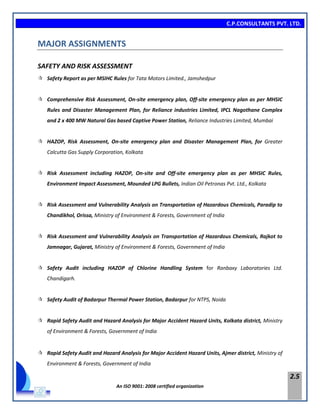

MAJOR ASSIGNMENTS
SAFETY AND RISK ASSESSMENT
 Safety Report as per MSIHC Rules for Tata Motors Limited., Jamshedpur
 Comprehensive Risk Assessment, On-site emergency plan, Off-site emergency plan as per MHSIC
Rules and Disaster Management Plan, for Reliance industries Limited, IPCL Nagothane Complex
and 2 x 400 MW Natural Gas based Captive Power Station, Reliance Industries Limited, Mumbai
 HAZOP, Risk Assessment, On-site emergency plan and Disaster Management Plan, for Greater
Calcutta Gas Supply Corporation, Kolkata
 Risk Assessment including HAZOP, On-site and Off-site emergency plan as per MHSIC Rules,
Environment Impact Assessment, Mounded LPG Bullets, Indian Oil Petronas Pvt. Ltd., Kolkata
 Risk Assessment and Vulnerability Analysis on Transportation of Hazardous Chemicals, Paradip to
Chandikhol, Orissa, Ministry of Environment & Forests, Government of India
 Risk Assessment and Vulnerability Analysis on Transportation of Hazardous Chemicals, Rajkot to
Jamnagar, Gujarat, Ministry of Environment & Forests, Government of India
 Safety Audit including HAZOP of Chlorine Handling System for Ranbaxy Laboratories Ltd.
Chandigarh.
 Safety Audit of Badarpur Thermal Power Station, Badarpur for NTPS, Noida
 Rapid Safety Audit and Hazard Analysis for Major Accident Hazard Units, Kolkata district, Ministry
of Environment & Forests, Government of India
 Rapid Safety Audit and Hazard Analysis for Major Accident Hazard Units, Ajmer district, Ministry of
Environment & Forests, Government of India
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.6
 Safety compliance Audit of Sixteen Major Hazardous Units in the National Capital Region of Delhi
under Central Pollution Control Board (CPCB), Ministry of Environment and Forests Govt. of India.
 Risk consequences & Mitigation Study of hazardous chemical Transportation by Tanker on
National Highway No.8 for Ministry of Environment & Forests, Govt. of India.
 Study on Risk Assessment in Oil Refinery & Petrochemical Complex for Central Pollution Control
Board (CPCB), MOEF Govt. of India.
ENVIRONMENT
 Environmental Impact Assessment and Environment Management Plan for E-Block and W-Block,
GK-II, New Delhi for DLF Universal Limited, Gurgaon.
 Environmental Impact Assessment and Environmental Management Plan for Multilevel Parking
Facility, DLF Universal Limited, Delhi
 Environmental Management Plan for Activated Carbon, M/s AAI Valley Carbon Pvt. Limited, Assam
 Environmental Impact Assessment and Environmental Management Plan for Industrial Estates,
Arrow Infra Limited, Gurgaon
 Environmental Impact Assessment and Environmental Management Plan for Propane Reticulation
System, Indian Oil Petronas Pvt. Ltd., Kolkata
 Environmental Impact Assessment and Environmental Management Plan for Haridwar Greens,
Arrow Infra Limited, Gurgaon
 Environmental Monitoring, Statutory compliances for Hero Realties (formerly Arrow Infra Limited)
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.7

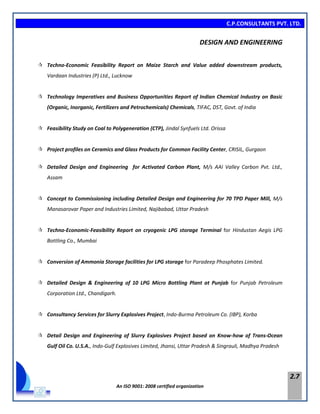

DESIGN AND ENGINEERING
 Techno-Economic Feasibility Report on Maize Starch and Value added downstream products,
Vardaan Industries (P) Ltd., Lucknow
 Technology Imperatives and Business Opportunities Report of Indian Chemical Industry on Basic
(Organic, Inorganic, Fertilizers and Petrochemicals) Chemicals, TIFAC, DST, Govt. of India
 Feasibility Study on Coal to Polygeneration (CTP), Jindal Synfuels Ltd. Orissa
 Project profiles on Ceramics and Glass Products for Common Facility Center, CRISIL, Gurgaon
 Detailed Design and Engineering for Activated Carbon Plant, M/s AAI Valley Carbon Pvt. Ltd.,
Assam
 Concept to Commissioning including Detailed Design and Engineering for 70 TPD Paper Mill, M/s
Manasarovar Paper and Industries Limited, Najibabad, Uttar Pradesh
 Techno-Economic-Feasibility Report on cryogenic LPG storage Terminal for Hindustan Aegis LPG
Bottling Co., Mumbai
 Conversion of Ammonia Storage facilities for LPG storage for Paradeep Phosphates Limited.
 Detailed Design & Engineering of 10 LPG Micro Bottling Plant at Punjab for Punjab Petroleum
Corporation Ltd., Chandigarh.
 Consultancy Services for Slurry Explosives Project, Indo-Burma Petroleum Co. (IBP), Korba
 Detail Design and Engineering of Slurry Explosives Project based on Know-how of Trans-Ocean
Gulf Oil Co. U.S.A., Indo-Gulf Explosives Limited, Jhansi, Uttar Pradesh & Singrauli, Madhya Pradesh
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.8

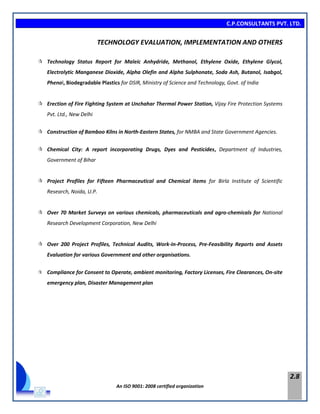

TECHNOLOGY EVALUATION, IMPLEMENTATION AND OTHERS
 Technology Status Report for Maleic Anhydride, Methanol, Ethylene Oxide, Ethylene Glycol,
Electrolytic Manganese Dioxide, Alpha Olefin and Alpha Sulphonate, Soda Ash, Butanol, Isabgol,
Phenol, Biodegradable Plastics for DSIR, Ministry of Science and Technology, Govt. of India
 Erection of Fire Fighting System at Unchahar Thermal Power Station, Vijay Fire Protection Systems
Pvt. Ltd., New Delhi
 Construction of Bamboo Kilns in North-Eastern States, for NMBA and State Government Agencies.
 Chemical City: A report incorporating Drugs, Dyes and Pesticides, Department of Industries,
Government of Bihar
 Project Profiles for Fifteen Pharmaceutical and Chemical items for Birla Institute of Scientific
Research, Noida, U.P.
 Over 70 Market Surveys on various chemicals, pharmaceuticals and agro-chemicals for National
Research Development Corporation, New Delhi
 Over 200 Project Profiles, Technical Audits, Work-In-Process, Pre-Feasibility Reports and Assets
Evaluation for various Government and other organisations.
 Compliance for Consent to Operate, ambient monitoring, Factory Licenses, Fire Clearances, On-site
emergency plan, Disaster Management plan
C.P.CONSULTANTS PVT. LTD.
An ISO 9001: 2008 certified organization
2.9
CONTACT DETAILS
C.P.CONSULTANTS PVT. LTD.
B-223
CHITTARANJAN PARK,
NEW DELHI - 110019,
INDIA
Telephone : 091-011-26276333 / 26276344.
Fax : 091-011-26276363
E-mail : cpcdelhi@yahoo.com
Website : www.cpconline.in
BRANCH OFFICE
C-2, Block A, Sagarika Appartments,
15 Old GT Toad Bally, Howarh,
West Bengal - 711201,
Ph: +91-33-26714729
OUR BANKERS
Oriental Bank of Commerce
Greater Kailash-I Branch
New Delhi – 110048
OUR CHARTERED ACCOUNTANTS
S KETU AND COMPANY
LAXMI NAGAR
NEW DELHI-110092
Professionals
C.P.CONSULTANTS PVT. LTD.3.1
OUR TEAM
Professionals
C.P.CONSULTANTS PVT. LTD.3.2
DR. A. MUKHERJEE
B.Ch.E (Jadavpur)
M.Tech (IIT Mumbai)
Ph.D(Toronto, Canada)
All in Chemical Engineering
: Managing Director
Over 50 years experience in Design & Engineering,
consultancy and project management
Previously in -
i. Calico Chemicals Ltd., Mumbai
ii. Larsen & Tourbro Ltd., Mumbai
iii Hart Chemicals Ltd., (Unilever Group),
Toronto, Canada.
iv Chemical and Metallurgical Design Co
(P) Ltd., New Delhi
v. Escon Consultants (P) Ltd., New Delhi
Member of -
i. Chairman, Indian Institute of Chemical
Engineers, Northern Regional Centre
ii. Indian Pharmaceutical Association
iii. Indian Pulp & Paper Technical Association
iv. Indian Ceramic Society
Technical Paper :
 Oxidation of Tetralin in the liquid phase with
insoluble catalyst. ( J.Am. Phy. Chem,1967)
Key Note Address in Seminars:
 On ‘Design & Engineering Services for Organic
Chemical Industry’. All India Seminar on Organic
Chemical Industry.
 On ‘Potential Industries in Rajasthan’ for Bureau of
Industrial Promotion (BIP), Govt. of Rajasthan.
 Technology Status on various chemicals for DSIR,
Ministry of Science & Technology.
 On ‘Prospect of Biodegradable Plastics in India’ for
Consultancy Development Centre.
 Prevention and Management of Chemical Accidents
with special emphasis on Fertilizer industry, FAI,
KRIBHCO, Hazira
Professionals
C.P.CONSULTANTS PVT. LTD.3.3
Mr. SUDIPTO MUKHERJEE
B.E. (C hem)
: Director
More than 25 years experience in Chemicals and Paper.
Specialize in project identification, market research,
feasibility report and financial analysis besides acting as
project coordinator
Ms. C. MUKHERJEE
B.Sc.
: Director
Over 20 years Experience in coordination and
implementation of Tourism studies, Health Studies,
Handicrafts and cottage sectors, Socio-economic Surveys,
Project Execution.
MR T.N. BANERJEE
M. Tech (Chemical)
: General Manager
More than 50 years of professional experience in the
areas of Process Design, Basic Engineering,
Procurement, Project Management, Start-up,
Commissioning and operation of Heavy Chemical Plant
(Soda Ash, Caustic Soda & Refined Bicarbonate).
More than a dozen of Study Report prepared for
Government and Private Organisation. In addition
involved in business development for the organisation.
Overall technical in-charge of the organisation
MR. S. C. BHARGAVA
MA (Economics)
: Sr. Economist
More than 40 years experience in statistical surveys,
market research, collection of primary data, statistical
analysis, data interpretation, and supervision,
documentation conducting primary and secondary
surveys & Market Research for more than 20 sectors like
automobile, biotechnology, chemicals and
pharmaceuticals.
MR. H. MUKHERJEE
B.Sc (Agriculture)
Member: Indian Paper and
Pulp Technical Association
: Sr. Manager (Business and Strategic
Development)
30 years of experience in paper and allied industry in
various capacities in commercial as well as production. 10
years experience in consultancy, research oriented
studies, finance, marketing & sales, co-ordination,
inventory and Asset valuation, Project development and
management.
Professionals

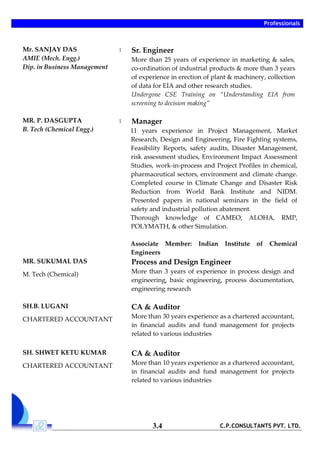

C.P.CONSULTANTS PVT. LTD.3.4
Mr. SANJAY DAS
AMIE (Mech. Engg.)
Dip. in Business Management
: Sr. Engineer
More than 25 years of experience in marketing & sales,
co-ordination of industrial products & more than 3 years
of experience in erection of plant & machinery, collection
of data for EIA and other research studies.
Undergone CSE Training on “Understanding EIA from
screening to decision making”
MR. P. DASGUPTA
B. Tech (Chemical Engg.)
: Manager
11 years experience in Project Management, Market
Research, Design and Engineering, Fire Fighting systems,
Feasibility Reports, safety audits, Disaster Management,
risk assessment studies, Environment Impact Assessment
Studies, work-in-process and Project Profiles in chemical,
pharmaceutical sectors, environment and climate change.
Completed course in Climate Change and Disaster Risk
Reduction from World Bank Institute and NIDM.
Presented papers in national seminars in the field of
safety and industrial pollution abatement.
Thorough knowledge of CAMEO, ALOHA, RMP,
POLYMATH, & other Simulation.
Associate Member: Indian Institute of Chemical
Engineers
MR. SUKUMAL DAS
M. Tech (Chemical)
Process and Design Engineer
More than 3 years of experience in process design and
engineering, basic engineering, process documentation,
engineering research
SH.B. LUGANI
CHARTERED ACCOUNTANT
CA & Auditor
More than 30 years experience as a chartered accountant,
in financial audits and fund management for projects
related to various industries
SH. SHWET KETU KUMAR
CHARTERED ACCOUNTANT
CA & Auditor
More than 10 years experience as a chartered accountant,
in financial audits and fund management for projects
related to various industries

OUR ADVISORS
C.P.CONSULTANTS PVT. LTD.
4.1
PROJECT
EXPERIENCE
C.P.CONSULTANTS PVT. LTD.
4.2
C O N T E N T S
PROJECT TITLE
 Industrial Chemicals
 Paper
 Petrochemicals
 Drugs and Pharmaceuticals
 Disaster Management
 Food and Fermentation
 Paints and Dyes
 Ceramics/Granite/Marble
 Piping
 Plastic and Rubber
 LPG Projects
 Tourism
 Reports/Market Surveys
 Valuation
C.P.CONSULTANTS PVT. LTD.
4.3
S.No Client Assignment Project Cost
(Rs. Lakhs)
A . I N D U S T R I A L C H E M I C A L S
1 TIFAC, New Delhi Technology Imperatives and Business Opportunities
Report of Indian Chemical Industry, (Organic, Inorganic,
Fertilizer and Petrochemicals)
2 JINDAL SYNFUELS Ltd.
Orissa
Feasibility Study on Coal and Polygeneration (CTP)
3 Alfa Petrocoke Ltd
New Delhi
TEFR – Calcined Petroleum Coke
4 Balaji Amines Ltd
Hyderabad
Checking of Detailed Design Engineering Documents for
Ethylamines Project on behalf of IFCI
500.00
5 Department of
Industries Govt. of Bihar
Chemical City A report incorporating Drugs, Dyes &
Pesticides Complex. Drugs included Ibuprofen, VitC,
Rifampicin, Dapsone PAS, Thiabendazole, INH,
Ethambutol and pesticide Endosulfan
6 Department of Scientific
& Industrial Research,
Ministry of Science
& Technology, Govt. of
India
Technological Status Reports for Maleic Anhydride
Methanol Ethylene Oxide & Ethylene Glycol, Electrolytic
Mangannese Dioxide, Alpha Olefin & Alpha Olefin
Sulphonate, Soda Ash, Butanol, Phenol, Biodegradable
Plastics.
7 Diamond Salt Ltd.
Rewari, Haryana
FR on Salt refining & Iodising.
8 Hindustan Lever Ltd.
Orai. U.P.
Basic & Detail Design Engineering of Toilet Soap Plant
9 Indo- Burma Petroleum
Co. (IBP), Korba
Consultancy Services on Slurry Explosives Project
10 Indo-Gulf Explosives
Ltd.
Detailed Design & Engg. of Slurry Explosives Project
based on know- How of Trans-Ocean Gulf Oil Co. U.S.A.
550.00
11 Indo-Gulf Explosives
Ltd. Singrauli. M.P
Detailed Design & Engg. of Slurry Explosives Project 150.00
12 Industrial Finance
Corporation of India
New Delhi.
Revival Plan of Glyoxal Metronidazole &Tinidazole Plant
of Rajasthan Glyoxal Ltd., Udaipur
300.00
13 PICUP, Lucknow TEFR on Monosodium Glutamate.
C.P.CONSULTANTS PVT. LTD.
4.4
S.No Client Assignment Project Cost
(Rs. Lakhs)
14 Rajasthan State
Industrial Development
Corporation (RIICO),
Jaipur.
Market Survey and Pre-feasibility Report of
Lead Acid Storage Batteries
500.00
15 Runeecha Polymar (P)
Ltd. Bhiwadi, Raj
Detailed Design Engineering of PVC / PU
Coated Synthetic Fabric.
875.00
Technology Information Forecasting and Assessment Council
16 (TIFAC) Techno-Commercial Feasibility Report on Activated
Carbon from Bamboo.
17 TIFAC Trial Run to Produce Activated Carbon from Bamboo on
Commercial Scale
18 TIFAC Brick Kilns for production of charcoal from bamboo in
North East States (Manipur, Nagaland, Meghalaya,
Mizoram, Assam and West Bengal, Madhya Pradesh and
Uttar Pradesh
19 ZORAM CARBON Detailed Project Report on 2TPD Activated Carbon
20 ASOM PETROCHEM Feasibility Report on 2 TPD Activated Carbon
21 AAI VALLEY CARBON,
Assam
Detail Design and Engineering of 2 TPD Activated
Carbon from Bamboo Charcoal
22 NRDC Basic Engineering Documents of Mango Based Herbal
Health Drink, Hydrogel, Zinc Based Micronutrient
Fertilizers, Rice Husk Particle Board, Nemagel, Silver
Nano Particles, Equi Herpabort Vaccine
B . P A P E R
1 ABC Papers Ltd. Techno-Economic Feasibility study on Waste Paper
Pulping
2 Continental Papers Ltd Design & Engineering of Bagasse Pulping for 50TPD
Paper Plant with Effluent Treatment.
500.00
3 Howe India Market Survey on Writing and Printing Paper in India
4 Industrial Data Bank
Patna, Bihar
PFR on 20 TPD Duplex Board
5 Khanna Paper Mills Ltd.
Amritsar.
TEFR for debottling of Duplex Board Plant.
C.P.CONSULTANTS PVT. LTD.
4.5
S.No Client Assignment Project Cost
(Rs. Lakhs)
6 Manasarovar Paper &
Industries Ltd.
Najibabad, U.P.
Turnkey Consultancy including detailed design and
engineering for 30 TPD Triplex Coated Board Plant.
1000.00
7 Mansarovar Bottling
Corporation Ltd.
TEFR on Duplex Board Project Expansion of Paper
project to 60 TPD.
8 Mansarovar
Beverages &
Industries Ltd.
Najibabad
Market Report on Triplex Coated Board. Feasibility
Study, Detailed Design Engineering of Paper Plant
9 RIICO Currency Note Paper
10 Viswamitra Paper
Industries Ltd.,
Buxar, Bihar
Turnkey Consultancy Services including Design and
Engineering for 8 TPD Duplex Board Unit
150.00
C . P E T R O C H E M I C A L S
1 Aegis Chemicals
Mumbai
Formaldehyde
2 Albert David Ltd.
Calcutta
Pentraerythritol
3 Alfa Petro-Coke Ltd.
New Delhi
Calcined Petroleum Coke
4 DSIR, New Delhi Alfa-olefin and Alfa-olefin sulfonate, Butanol
5 DSIR, New Delhi Ethylene oxide and Ethylene Glycol
6 DSIR, New Delhi Maleic Anhydride
7 DSIR, New Delhi Methanol and Phenol
D . D R U G S & P H A R M A C E U T I C A L S .
1 Albert David Ltd.
Calcutta
Detail Design & Engineering Service for Bulk Drug
Project.
70.00
2 Albert David Ltd.
Ghaziabad
Detail Design & Engineering for Transfusion Fluids
Project
3 Birla Institute of
Scientific Research
Noida, U.P.
Project Profiles on fifteen Pharmaceutical and Chemical
Items.
C.P.CONSULTANTS PVT. LTD.
4.6
S.No Client Assignment Project Cost
(Rs. Lakhs)
4 BSPCDC., Patna Feasibility Study on Medical Disposable Sets 300.00
5 Curewel (India) Ltd.
Faridabad
Engineering Services Pre-feasibility study 100.00
6 Department of
Scientific & Industrial
Research Ministry of
Science & Technology
Pre-investment feasibility study on Trimethoprim
7 Hamdard (Wakf)
Laboratories,
Gaziabad
Consultancy Services.
8 HPSIDC, Shimla Project profiles for Rifampicin, D-Phenyl Glycine Vitamin
B-6, Novaldiamine, Propranolol Hydro-chloride,
Metronidazole, Ibuprofen
9 IDB, Patna. PFR on Paracetamol, Metronidazole
10 Mesco
Pharmaceutical, New
Delhi.
Project Report on Ciprofloxacin & Norfloxacin
11 Madhu E. Nicholas,
Kerala
Disposable Syringes
12 PICUP, Lucknow TEFR on Quinolones, Terfenadine, Roxythromycin
Ranitidine and Ethambutol
13 Purnima
Pharmaceuticals Pvt.
Ltd. Jaipur
Turnkey Consultancy Services Including Design
Engineering Of Drug Formulation Unit.
75.00
14 RIICO., Jaipur Prefeasibility Report for 3,4,5 TMBA, Trimethoprim &
Anti-TB Drugs Aminophylline, Theophylline, & Cuffeine.
250.00
15 Ranbaxy Laboratories
Ltd.
Safety Audit of Chlorine System
16 RRG Laboratories,
Dehra Dun
Feasibility Study on Transfusion Fluid Project. 110.00
17 Surya
Pharmaceuticals Ltd.
Total Inventory Report
18 Wadera Engineers (P)
Ltd., Patna
Project Report on Paracetamol 125.00
C.P.CONSULTANTS PVT. LTD.
4.7
S. No. Client Assignment Project Cost
(Rs. Lakhs)

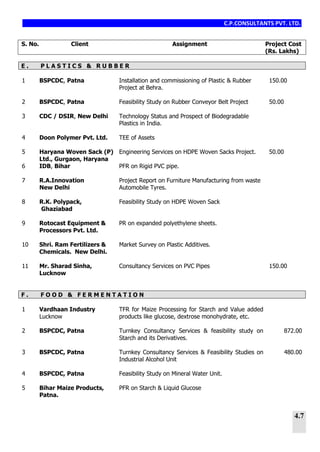

E . P L A S T I C S & R U B B E R
1 BSPCDC, Patna Installation and commissioning of Plastic & Rubber
Project at Behra.
150.00
2 BSPCDC, Patna Feasibility Study on Rubber Conveyor Belt Project 50.00
3 CDC / DSIR, New Delhi Technology Status and Prospect of Biodegradable
Plastics in India.
4 Doon Polymer Pvt. Ltd. TEE of Assets
5 Haryana Woven Sack (P)
Ltd., Gurgaon, Haryana
Engineering Services on HDPE Woven Sacks Project. 50.00
6 IDB, Bihar PFR on Rigid PVC pipe.
7 R.A.Innovation
New Delhi
Project Report on Furniture Manufacturing from waste
Automobile Tyres.
8 R.K. Polypack,
Ghaziabad
Feasibility Study on HDPE Woven Sack
9 Rotocast Equipment &
Processors Pvt. Ltd.
PR on expanded polyethylene sheets.
10 Shri. Ram Fertilizers &
Chemicals. New Delhi.
Market Survey on Plastic Additives.
11 Mr. Sharad Sinha,
Lucknow
Consultancy Services on PVC Pipes 150.00
F . F O O D & F E R M E N T A T I O N
1 Vardhaan Industry
Lucknow
TFR for Maize Processing for Starch and Value added
products like glucose, dextrose monohydrate, etc.
2 BSPCDC, Patna Turnkey Consultancy Services & feasibility study on
Starch and its Derivatives.
872.00
3 BSPCDC, Patna Turnkey Consultancy Services & Feasibility Studies on
Industrial Alcohol Unit
480.00
4 BSPCDC, Patna Feasibility Study on Mineral Water Unit.
5 Bihar Maize Products,
Patna.
PFR on Starch & Liquid Glucose
C.P.CONSULTANTS PVT. LTD.
4.8
S. No. Client Assignment Project Cost
(Rs. Lakhs)
6 Continental
Constructions Ltd., New
Delhi
PR on Edible oil & Vanaspati.
7 Chohan Chemicals Pvt.
Ltd., New Delhi
Feasibility Study for Saccharin Project 65.00
8 HPSIDC, Shimla Pre –feasibility Report for 100 TPD Vansapati project
at Sahibabad
500.00
9 IDB, Patna. PFR on Vanaspati.
10 Indus Valley Trading
Pvt. Ltd., New Delhi.
PFR on 60 TPD Palm oil refining & Vanaspati.
Manufacture
11 Kudos Chemic Ltd.,
Chandigarh
Work-In-Progress Report for Caffeine manufacture.
12 Madyasar (P) Ltd., M.P. Feasibility Study on Industrial Alcohol Unit 275.00
13 National Research
Development
Corporation (NRDC),
New Delhi
Feasibility Report on Invert Sugar, Low calorie Bread
spread
BEDP for Beta Carotine Rich Biscuit, Probiotic Dahi,
Flavoured Milk, Bitter Gourd Drink
14 PICUP Mono-Sodium Glucamate
15 ANJS EXPORTS PVT. LTD Feasibility Report on 5000 LPD Herbal Health Drink
16 DSIR, CDC Technology Status of Isabgol Based Industry
G . P A I N T S & D Y E S
1 B S P C D C TEFR on Authraquinone Vat Dyes.
2 Deepika Extractions (P)
Ltd. , Gurgaon
Project Report for Synthetic Iron Oxide Red &
Yellow
100.00
3 Directorate of Industries
Govt. of Bihar
Feasibility Study on Dyes Project 480.00
4 Golden Pigments Pvt.
Ltd.
PF on Alpha Copper Phthalocyanine Blue / pigment
blue
5 Jenson & Nicholson (I)
Ltd.
Basic Engineering Documents of Paints Project at
Sahibabad
500.00
6 Shirdi Chemicals Dye intermediates.
C.P.CONSULTANTS PVT. LTD.
4.9
S. No. Client Assignment Project Cost
(Rs. Lakhs)
H . C E R A M I C S / G R A N I T E / M A R B L E
1 Department of Scientific
& Industrial Research
Ministry of Science &
Technology
Technology Status & Norms Study on Granite & Marble
2 Chokhani Iron & Steel
works, Jaipur.
PFR on Zirconium silicafe opacifier & Frit / Glaze
Project.
3 RIICO, Jaipur Market Survey on Granite Utilisation of marble dust,
slurry waste Project Profile on Ceramic Colours &
Pigments
4 Rajasthan Udyog. Survey on Marble & Granite & Dimensional Store.
5 Shahid Group of
Industries, New Delhi
PFR on Tableware products.
6 RIICO/CRISIL Project Profiles on Glass and Ceramic Products at
Ghilot, RIICO Complex, CRISIL
I . P I P I N G
1 Chandrapur Thermal
Power Station (MSEB)
Detailed Design and Engineering for GS/LP Piping
System for 210 M.W. Power Station Unit – III
2 Vijay Fire Protection
System Pvt. Ltd., New
Delhi
Erection of Fire Fighting System at Unchahar Thermal
Power Station
J . D I S A S T E R M A N A G E M E N T
1 Central Pollution Control Board Safety compliance Audit of major Hazardous Units in
the NCR of Delhi.
2 Central Pollution Control Board Study on Risk Assessment in Oil Refinery and
petrochemical Complexes.
3 Ministry of Environment &
Forests
Risk, Consequences & Mitigation study of chemical
Tanker Transportation on NH-8
4 Ranbaxy Laboratories Ltd Safety Audit of the Chlorine System
5 Yatindra Paper Industry Risk Analysis of HDS/ FO Transfer Storage
6 National Thermal Power
Corporation
Safety Audit of Badarpur Thermal Power Station
C.P.CONSULTANTS PVT. LTD.
4.10
S. No. Client Assignment Project Cost
(Rs. Lakhs)
7 MOEF Rapid Safety Audit & Hazard Analysis for Kolkata, Ajmer,
Bhavnagar, Bhatinda, Gurgaon, Surat, Kutch, North 24
PGNS, Hooghly, Bokaro, Karimnagar and E. Singhbhum,
Srikakulam Districts
8 MOEF Off-site emergency plan for Bhavnagar, Hooghly, North
24 PGNS, Karimnagar, E.Singhbhum, Gurgaon, Surat,
Kutch, Srikakulam districts
9 MOEF
10 Greater Calcutta Gas
Supply Corporation
Hazard Analysis and Risk Assessment, amendment of
On-site emergency plan as per Schedule XI, MSIHC
Rules
11 Reliance Industries
Limited
Comprehensive Risk Assessment of 2 X 500 MW Gas
based thermal power plant and IPCL, Nagothane, On-
site emergency plan, Off-site emergency plan, Disaster
Management Plan
12 Indian Oil Petronas Pvt.
Ltd.
Risk Assessment of Propane Reticulation Systems along
with associated pipelines, On-site emergency plan,
Dehradun
K . L P G & H A Z A R D O U S C H E M I C A L S P R O J E C T S .
1 Aegis Chemical
Industrial Ltd.,
Mumbai
TEFR on Cryogenic LPG Storage Terminal
2 Eastern India LPG Ltd. Market Survey Report for West Bengal, Bihar, Orissa,
Andhra Pradesh.
3 Hind Polymers Pvt.
Ltd., Kolkata
Ethylene Storage Terminal
4 Hindustan Aegis LPG
Bottling Co. Ltd.,
Mumbai
Consultancy for Cryogenic Storage of LPG & Bottling
Unit
10000.00
5 Hindustan Domestic
Oil & Gas Co Bombay
Ltd
Detailed design and Engineering of 20 LPG Micro
Bottling Plant in U.P. & Rajasthan
6 Hindustan LPG
Bottling Co. Ltd.,
Mumbai
Detailed Design & Engineering of 22500 TPA LPG
Bottling unit at Dombivli
7 Indo-Gulf Industries,
Jhansi
Slurry Explosives
C.P.CONSULTANTS PVT. LTD.
4.11
S. No. Client Assignment Project Cost
(Rs. Lakhs)
8 Kolmark
Petrochemicals Ltd.,
Kolkata
VMC Storage
9 NOCIL, Mumbai Cryogenic Storage Terminal
10 Paradeep Phosphate Conversion of Ammonia Storage Facilities For LPG
11 Parvin Petro Product
Pvt. Ltd.
Mini LPG Bottling Project
12 Punjab Kero & LPG
Pvt. Ltd.
Mini LPG Bottling Project
13 Punjab Petroleum
Corporation Ltd.
Chandigarh
Detail Design & Engineering of 10 Micro Bottling Plants
in Punjab.
14 Trendeastwest LPG
Bottling Co. Ltd.
New Delhi.
Detailed Design and Engineering of 45000 TPA LPG
Bottling Plants in Punjab
15 SGS Petro Organic (P)
Ltd., Chennai
TEFR on LPG handling at Cuddalore Port
16 Western Petroleum &
Trading Pvt. Ltd.,
Mumbai
Port based Storage Terminal survey (including Traffic
Projection)
L . T O U R I S M
1 Inland Water ways
Authority of India,
Ministry of Surface
Transport.
Development of Inland Water Transport in river
Brahamaputra.
2 Ministry of Tourism Impact of Tourism on Socio-economic Development in
Rajasthan & Kerala
M . R E P O R T S / M A R K E T S U R V E Y S
1 Aegis Logistics Ltd.
(Formerly Aegis
Chemical)
Market Survey on Chemical Storage Terminal at
JNPT.
2 Aegis Chemical &
Industries Ltd.
Mumbai
Market Survey on Formaldehyde, Market Survey on
Chemical Storage Terminal at Mumbai Port,
Feasibility Report on Cryogenic LPG Storage Terminal
C.P.CONSULTANTS PVT. LTD.
4.12
S. No. Client Assignment Project Cost
(Rs. Lakhs)
3 Continental
Construction Ltd. New
Delhi.
Project Report for Edible Oil & Vanaspati Complex 2000.00
4 ENCO – Tech.
Consultants Pvt. Ltd.,
New Delhi
Market Survey of Bhutan Particle Board
5 Enpro India Ltd., New
Delhi.
Market Survey on Tableware Products.
6 Hind Polymer (P) Ltd.,
Calcutta
Feasibility Report on Cryogenic Storage Terminal for
Ethylene.
7 Eastern India LPG
Ltd., Mumbai
Primary Market Survey on LPG in four eastern states
8 Kolmak Ptrochem
Ltd., Calcutta
Feasibility Report on Pressured Storage Terminal For
VCM
9 PICUP., Lucknow Pre-feasibility Report on Quinoline drugs,
Monosodium glutamate
10 RIICO., Jaipur Pre-feasibility Report for Security Paper
11 S.G.S. Petro Organic
(P) Ltd., Chennai
Project Report for Port Facilities for LPG
12 National Research
Development
Corporation
New Delhi
Quick Market Survey on Isabgol, Ethyl Methyl
Anthranilate, Invert sugar, Palatable Laxative, Liquid
Glucose, PET Recycling, Low Calorie Bread Spread,
Bakery Margarine, Biodegradable Plastics, Heena
Based Hair Dye Powder, Kattha, Vibratory Stress
Relief Equipment, D-Hydontinise, Maintenance Free
Lead Acid Battery, Plasma Coating, Fluidized Abrasive
Polishing Machine, Jute Stick Particle Board, Rice
Bran Oil, Thioglycolic Acid, Aero-Microbial Filter for
Hospital, Copper Phthaloeyanine Blue, Beta Napthol,
Resorcinol, Natural Dyes, Corrosion Resistance
Coating, Small Scale Biotechnology and
Bioinformatics Companies, Drugs & Pharma Vaccines
and Diagnostics for Cattle, Poultry and Fisheries,
Shellac based Can Coatings, Aleuritic Acid, Herbal
Health Drinks, Herbal Colours, Quick Market Survey
and Pre-Feasibility Reports on PET Recycling,
Processed Poultry Products, Sol-gel technology (Anti-
glare and Anti-reflective) coatings. TB based
diagnostic kits, ELISA kits, Neem seed, Azadirachtin,
Hydrogel, Long Decay Phosphor
C.P.CONSULTANTS PVT. LTD.
4.13
S. No. Client Assignment Project Cost
(Rs. Lakhs)
13 National Research
Development
Corporation
New Delhi
Polymeric Blend based Electric Accessories, White
Grubs, Nema Gel, Trichoderma, Leptospirosic
Detection Kit, Rare Earch, RTV Sillicon,
Cholesterol/Urea & Copper Biosensos, DNA Vaccine,
Potassium Humate, Halwa from Pumpkin, Dehydration
of Apple & Apricot, Karela Dot-Elisa Kit, Sero-Diagnosis
of IBDIV, Supportive Therapy,Cultured Epithelial
Autograft cultivated, Mosquito Larvicidal, Fluidised
Abrassive Polishing Machine, Recombinant IGM Elisa
Kit, Ayush-A, Products for Antenatal & Postnatal care,
Ayush QOL-2C, Low Cost Plant Tissue, Polyhydroxy
Butyrate, Rhizobia, Safranal Nanoemulsion, Dried
Flower, Development of Oligonuceleotides.
14 Shriram Fertilizers &
Chemicals
Market Survey on Chlorine based Chemical: Aluminum
Chloride, Calcium Chloride, Ferric Chloride, Para Chloro
Toulene, and ortho Chloro Toulene, Polyaluminum
Chloride, Stable Bleaching Powder
15 Shriram Institute for
Industrial Research,
New Delhi
Market Survey on Polythiols
16 Hindustan Aegis Bottling
Ltd, Mumbai
Feasibility Report on Cryogenic LPG Storage Facility.
N . V A L U A T I O N .
1 Amrit Banaspati Ltd Valuation of Assets
2 Aulluck & Co. (P) Ltd. Techno-economic Evaluation of Assets.
3 Balaji Amines Third Party Technical evaluation.
4 Bhusan Alloys &
Castings Ltd.
Techno-economic Evaluation of Assets
5 Casco Narain (India)
Ltd.
Techno-economic Evaluation of Assets.
6 Cepham Organics
Kundli
Technical Audit
7 Doon Polymers Ltd. Techno-economic Evaluation of Assets.
8 Golden Proteins Ltd. Techno-economic Evaluation of Assets.
9 Himalaya International
Ltd.
Valuation of Assets (IDBI)
C.P.CONSULTANTS PVT. LTD.
4.14
S. No. Client Assignment Project Cost
(Rs. Lakhs)
10 Hindustan Adhesives
Ltd.
Valuation of Assets (IDBI)
11
12 Flex Chemicals Valuation of Assets
13 Indo-American
Chemicals
Techno-economic Evaluation of Assets.
14 Kudos Chemie Ltd.
(Punjab)
Valuation of work – in – progress of Caffeine Plant
15 Laxmi Polymers Ltd. Techno-economic Evaluation of Assets.
16 Partap Steel Ltd. Valuation of Assets assigned by IDBI.
17 Rajasthan Glyoxal.,
Udaipur
Revival and Diversification study (Under BIFR)
18 Raj Cement Co. Ltd. Techno-economic Evaluation of Assets
19 Rattan Vanaspati Ltd Techno-economic Viability
20 Rattan Vanaspati Ltd Valuation of Assets
21 Saharanpur Cement
Ltd.
Techno-economic Evaluation of Assets.
22 Shree Shyam Pulp &
Board Mills Ltd.
Valuation of Assets
23 Sintered Separators
Ltd.
Techno-economic Evaluation of Assets.
24 Sidharth Pharma Techno-economic Evaluation of Assets.
25 Surya Pharmaceuticals
Ltd.
Inventory Verification assigned by PNB.
26 IFCI Valuation and Business Revival Project, Mukerian
Paper Mills, Mukerian
27 IFCI Valuation of Assets of M/s Shiva Paper Mills, Rampur
28 IFCI Valuation of Moradabad Suntex Limited

CPC_PROFILE_COMPLETE

  • 2.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organisation CONTENTS 1.0 ABOUT US 2.0 CAPAB ILITIES 3 .0 OUR TEAM 4.0 PROJECT EXPERIENCE 5.0 LIS T OF CLIEN TS
  • 3.
    C.P.CONSULTANTS PVT. LTD. 1.1 AnISO 9001: 2008 certified organization ABOUT US
  • 4.
    C.P.CONSULTANTS PVT. LTD. 1.2 AnISO 9001: 2008 certified organization INTRODUCTION C.P. CONSULTANTS Pvt. Ltd. (CPC) is a multidisciplinary consultancy organisation based at New Delhi. This organisation was nucleated in 1984 and provides consultancy services from “concept to commissioning” by number of Technocrats and Management personnel under the able guidance of its Managing Director, Dr. A. Mukherjee. The project related service generally includes Market Research, Detailed Project Reports, Preparation of Feasibility Report, Process Design & Engineering, Equipment Procurement Assistance, and Supervision during Construction, Start-up and Commissioning. The organisation specializes in undertaking Baseline Surveys, Safety, Health and Environment research studies including collection and analyses of Environmental Data, Environment Impact Assessment Studies (Rapid and Comprehensive), Environment Audit, Environment Management Plan, Consent to Establish, Consent to Operate from State Pollution Control Board, liaison for local administrative clearances, Safety Audits, (both rapid and comprehensive), HAZOP Studies, Risk Assessment (Qualitative and Quantitative), Design and Engineering of Fire Fighting systems as per TAC/ NFPA and Disaster Mitigation/ Management Plan. Services provided not only involve own team of experts, collaborating with technical experts or advisors are also arranged. CPC has an extensive and wide network for obtaining various primary information services throughout India. Since its inception the organisation is also providing architectural, structural, mechanical, electrical and civil engineering all pertaining to the aforesaid industries. CPC also undertakes trial run studies for evaluation of process parameters for improving or optimizing the total technology.
  • 5.
    C.P.CONSULTANTS PVT. LTD. 1.3 AnISO 9001: 2008 certified organization CPC is proud to be in professional association with number of service providers like testing laboratories and equipment fabricators for any kind of industrial needs. In addition to the above service spectrum, CPC also promotes Propane as an alternate and clean fuel as a “Marketing Associate” for Indian Oil Petronas Pvt. Ltd. and in providing support for implementing “Fellingsdam-waste water stabilization ponds” from Jarven Ecotech, Sweden. CPC has been listed as “approved consultant” by the Ministry of Environment and Forests, Government of India for carrying out Environmental Impact Assessment Studies. TARGET SECTORS 1. Industrial/Agro/Fine Chemicals 8. Food processing 2. Hazardous Chemicals 9. Bio-fuels 3. Petrochemicals 10. Ceramics 4. Plastics 11. Paints & Dyes 5. Drugs & Pharmaceuticals 12. Paper 6. Infrastructure/Water Resources 13. Tourism 7. Storage Terminals, Bottling Plants 14. Polymer Composites SERVICES MARKET INTELLIGENCE  Industrial Research  Socio-Economic Research  Consumer Research  Demand Study  Product Study  Econometric Modelling  Macro Level Study  Sample Survey  Export Potential Studies  Multi Client Study  Base Line Data Collection  Market Potential Status
  • 6.
    C.P.CONSULTANTS PVT. LTD. 1.4 AnISO 9001: 2008 certified organization PROJECTS AND STUDIES  Project Identification Studies  Entry Level Studies  Project profile  Technology Search Studies  Techno Economic Feasibility Study  Joint Venture Identification Studies  Detailed Project Report  Data Base Services  Technology Status Reports  Location Studies  Plant Revival Studies  Valuation of Assets  In-plant study for process improvements  Work – In- Progress  Technology & Raw Material Assessment  Inventory needs and SCM SAFETY, HEALTH AND ENVIRONMENT  Safety Audits  Risk Assessment  Disaster Management Plan  Environment Management Plan  Environment Impact Assessment  HAZOP Studies  Safety, Health & Environment Awareness and Appraisal  Solid Waste Management Studies  Plant Health Assessment  Material and Energy Balance for SSI  Energy Conservation Study/ Audits ENGINEERING  Process Engineering  Instrumentation  Detailed Engineering  Project management Services  Architectural Civil & Structural Engineering   Procurement and inspection Erection supervision  Mechanical & Piping Engineering  Commissioning.  Electrical & Air-conditioning  Fire Fighting Systems  GIS and Mapping 
  • 7.
    C.P.CONSULTANTS PVT. LTD. 1.5 AnISO 9001: 2008 certified organization INTERNATIONAL EXPERIENCE The consultants have experience in working in international environment with emphasis in basic engineering, foreign technology collaboration, sourcing and knowledge sharing. In the past, the organisation had successfully completed a number of projects involving foreign collaborators. The consultants have experience in working in various countries like CIS, Taiwan, USA, Germany, etc. A brief project list involving foreign technology is given below:  Basic Engineering works for cryogenic LPG storage, for Trachtobel, West Germany  Engineering consultancy, Indo-Gulf Explosives, and technology sourcing from Gulf Oil, USA  Orient Ceramics, collaboration with Agrob and Heimsoth, West Germany  Facility Creation for Pharmaceuticals, Albert David, in collaboration with Upjohn, USA.  Technology Transfer of Aluminium Technology Cryolite Recovery Plant, Russia for BALCO o Basic Engineering, Detailed Design Engineering & Trouble shooting  Technology Transfer of Silk Textile Mills, Kazakhstan prepared for marketing purpose  Technology Transfer of Food Processing Plant (fruit juices of apple, cherry, apricot), Samarkand, Uzbekistan prepared for marketing purpose  Technology Transfer (Basic Engineering) of Beer from Wheat for establishments in CIS countries  Thermographic Techniques for predictive maintenance, through initial assistance from Infra-inspection institute, USA for diagnostic study of power and fertilizer plants,  Technology Transfer ( Basic Engineering) of Manufacture of abrasives, Taskent prepared for marketing purpose  Technical support services for setting up process plants to foreign investors in Uzbekistan
  • 8.
    C.P.CONSULTANTS PVT. LTD. 1.6 AnISO 9001: 2008 certified organization CORPORATE SOCIAL RESPONSIBILITY CPC believes in extending professional assistance as and when sought by reputed NGOs for betterment of socio-economic conditions in urban as well as in rural backdrop. Presently, such activities extend to: (i) Imparting specialized training and extending advisory services (ii) Extending technical know-how to the rural workers like artisans, SHGs, etc (iii) Help sensitizing people about environment (iv) Assistance for Rural Entrepreneurs (v) Assisting in project proposal writing SOCIAL & RURAL DEVELOPMENT India is still a predominantly agricultural economy, and more than 3/4ths of people still reside in rural areas. With large human resource capabilities, it presents a huge arena for sustainable investments. CPC with its social arm “Shristi” has been actively involved in educating, creating employment opportunities through self help groups and striving for secured financial future for handicraft artisans through socio-technological & marketing inputs. CPC also supports youth movement like the Indian Youth Climate Network in spreading awareness about climate change and preserving biodiversity. CPC, through its social and rural development arm, provide education & awareness to village people by means of organizing seminars, door to door campaigns, workshops, marketing support, etc. The main objective is imparting basic education and arranging for necessary technology support through existing government mechanisms, public private partnerships, for better product design and marketability.
  • 9.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.1 CAPABILITIES
  • 10.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.1 ENGINEERING SOLUTIONS A sound engineering always assist projects in hassle free commissioning and coming in real terms as per best possible design standards applicable thus saving time and economics. Since, it’s inception, the organization has a steered a number of projects in diverse fields at various stages till commission. An engineering team along with experts delivers customized and viable engineering solutions to its clients. CPC has in-house capabilities to undertake project profiles, feasibility reports, basic engineering in all sectors and detailed design and engineering in selected sectors. CPC has successfully assisted entrepreneurs and corporate in setting up plants based on techno- commercial viability studies. CPC has pioneered the commercialization of activated carbon from bamboo with the help of NMBA as well as IIT Mumbai. ENVIRONMENTAL STUDIES In India, the environment related assignments are largely governed by the need of a party to show compliance to existing regulations and by others as to provide base information on diverse related subjects that are in a form of data collection, documentation or simply putting existing records in one place so as to aid stakeholders in policy or regulations framework. CPC has been involved in this field for the last 15 years, successfully completing a number of assignments. The organisation has also been engaged by big corporates for their projects in India. Also, the organisation has developed expertise and competence in workplace/ industrial Safety, Health and Environment jobs carrying out safety audits, risk assessment studies, etc. The total worth of surveys, studies done in this area is around Rs30.0 million till date. RISK ASSESSMENT & DISASTER MANAGEMENT The increasing need for a methodological assessment of disasters, both man-made & natural has been voiced all over the world. In India, the government and other stakeholders have been lately working in implementing necessary regulatory framework and social infrastructure for better preparedness in times of emergency. The element of Disaster Management which is now projected as a specialized subject and is shown as a separate chapter in many documents was effectively covered in feasibility report, design and engineering documents from the beginning by our organisation as an added dimension. Hence, the organisation is well equipped to carry out any type of safety audits, risk assessment, onsite & offsite emergency plan, environment impact assessment.
  • 11.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.2 PROCUREMENT ASSISTANCE The organisation is involved in providing technical support to private organisation on deputation basis for design and procurement services in chemical, petrochemical and allied industries. The scope of work generally included providing managerial support, liaison with suppliers, design investigation and inventory management. The total worth of surveys, studies done in this area is around Rs2.50 million till date. LOGISTICS AND SUPPLY CHAIN The company has been involved in studies related to logistics and supply chain management for private parties. The scope of work included studying forward and backward linkages, value additions at various stages, demand & supply assessment, etc. FOOD AND AGRICULTURE The organization has successfully completed more than 50 studies related to food and agriculture sector. CPC has a number of experts in food sectors who have served in various capacities in manufacturing as well as policy sector. CPC executed number of studies of which notable are the “Technology Status of Isabgol Industry in India” and “Techno- Commercial cum Business Opportunity Report on Bamboo based Activated Carbon” which invariably involved good agriculture practice, cropping pattern, viable species for Indian climatic conditions, horticultural practices, agro- economics, land development, contract farming, project cost, among others. Similar projects such as market research, feasibility reports, project profiles on other agriculture/ forests products such as katha, shellac, rice, sugarcane, raw materials for paper and pulp industry, palm oil, etc have also been executed by the consultants.
  • 12.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.2 SEMINARS ORGANISED  Industrial Drying Technology Venue: Hyatt Regency Hotel, New Delhi On: 12th & 13th January, 1989 Speakers: Dr. Arun.S.Majumdar, Professor in Chemical Engineering, Mc Gill University Montreat, Canada. Mr. S.C.Dhingra, Chemical Engineer Department, I.I.T. Delhi Dr. Rohit. M. Shah, Vice President (Tech), Mac Neill & Magor Ltd., Bombay  Risk Assessment in Oil Refinery and Petrochemical Complexes. Venue: Central Pollution Control Board (C.P.C.B), New Delhi On: 29th to 31st December, 2003 Speakers: Dr. S.K.Biswas, Advisor, CPC, Safety Health and Environment. Mr. S.N.Mitra, Advisor, CPC, Safety Health and Environment. Dr. A.Mukherjee, M.D, C.P.Consultants Pvt. Ltd., New Delhi
  • 13.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.3 INSTITUTIONAL RECOGNITION AND PROFESSIONAL MEMBERSHIP INSTITUTIONAL RECOGNITION C.P. Consultants Pvt. Ltd. shares recognition and approval as consultancy firm from the following Institutions:  Ministry of Environment and Forests, Government of India  Central Pollution Control Board, Ministry of Environment & Forests, Govt. of India  Consultancy Development Centre (CDC) (Supported by DSIR, Ministry of Science & Technology  Industrial Development Bank of India (IDBI)  Quality council of India (QCI)  Department of Science and Technology, Ministry of Science & Technology, Government of India  Technology Information and Forecasting Assessment Council (TIFAC)  National Research Development Corporation (NRDC), New Delhi  National Mission on Bamboo Application, (NMBA), New Delhi  Punjab National Bank, Chandigarh  Department of Explosives, Government of India as Competent Person  Rajasthan State Industrial Development and Investment Corporation Ltd. (RIICO)  The Pradeshiya Industrial & Investment Corporation of U.P. Ltd. (PICUP)  Bihar State Pharmaceutical & Chemical Development Corporation Ltd. (BSPCDC), Patna  Sriram Institute for Industrial Research (SRI), New Delhi CPC is also registered with Asian Development Bank’s consulting management system (003955) PROFESSIONAL MEMBERSHIP 1. Consultancy Development Centre 2. Quality Council of India
  • 14.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.4 HUMAN RESOURCES CAPABILITIES CPC have a team of committed and expert professionals in technical, management, legal, statistical, economics, marketing and logistics sectors. With a dedicated core staff coordinating with the client along with support personnel spread all over the country, CPC’s expertise is always at the client’s reach. The concern has an extensive and wide liaison and resource network at national and international scale for obtaining various first hand primary information services. CPC maintains a close relationship with many public and private organizations. CPC believe in teamwork, creativity, sustainability and recognize the significant role the organisation, with its clients and collaborators, play in forming new environments. CPC aims at striking the right balance between leveraging what clients have and delivering what they require in a professional way. INFORMATION TECHNOLOGY FACILITIES C. P. CONSULTANTS has latest state-of-art IT facilities, with round the clock internet and FTP services which assist the team managers to access information from various libraries, government databases, and many more knowledge resources. The IT department of the organisation is well equipped with various project execution software packages to successfully execute diverse range of projects well within the time schedule with emphasis on quality and execute it in a presentable manner. CPC have necessary softwares for design engineering and safety solutions that cater to the needs of the client. CPC also offers timely submission of assignments, customized updates and regular monitoring of projects.
  • 15.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.5 MAJOR ASSIGNMENTS SAFETY AND RISK ASSESSMENT  Safety Report as per MSIHC Rules for Tata Motors Limited., Jamshedpur  Comprehensive Risk Assessment, On-site emergency plan, Off-site emergency plan as per MHSIC Rules and Disaster Management Plan, for Reliance industries Limited, IPCL Nagothane Complex and 2 x 400 MW Natural Gas based Captive Power Station, Reliance Industries Limited, Mumbai  HAZOP, Risk Assessment, On-site emergency plan and Disaster Management Plan, for Greater Calcutta Gas Supply Corporation, Kolkata  Risk Assessment including HAZOP, On-site and Off-site emergency plan as per MHSIC Rules, Environment Impact Assessment, Mounded LPG Bullets, Indian Oil Petronas Pvt. Ltd., Kolkata  Risk Assessment and Vulnerability Analysis on Transportation of Hazardous Chemicals, Paradip to Chandikhol, Orissa, Ministry of Environment & Forests, Government of India  Risk Assessment and Vulnerability Analysis on Transportation of Hazardous Chemicals, Rajkot to Jamnagar, Gujarat, Ministry of Environment & Forests, Government of India  Safety Audit including HAZOP of Chlorine Handling System for Ranbaxy Laboratories Ltd. Chandigarh.  Safety Audit of Badarpur Thermal Power Station, Badarpur for NTPS, Noida  Rapid Safety Audit and Hazard Analysis for Major Accident Hazard Units, Kolkata district, Ministry of Environment & Forests, Government of India  Rapid Safety Audit and Hazard Analysis for Major Accident Hazard Units, Ajmer district, Ministry of Environment & Forests, Government of India
  • 16.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.6  Safety compliance Audit of Sixteen Major Hazardous Units in the National Capital Region of Delhi under Central Pollution Control Board (CPCB), Ministry of Environment and Forests Govt. of India.  Risk consequences & Mitigation Study of hazardous chemical Transportation by Tanker on National Highway No.8 for Ministry of Environment & Forests, Govt. of India.  Study on Risk Assessment in Oil Refinery & Petrochemical Complex for Central Pollution Control Board (CPCB), MOEF Govt. of India. ENVIRONMENT  Environmental Impact Assessment and Environment Management Plan for E-Block and W-Block, GK-II, New Delhi for DLF Universal Limited, Gurgaon.  Environmental Impact Assessment and Environmental Management Plan for Multilevel Parking Facility, DLF Universal Limited, Delhi  Environmental Management Plan for Activated Carbon, M/s AAI Valley Carbon Pvt. Limited, Assam  Environmental Impact Assessment and Environmental Management Plan for Industrial Estates, Arrow Infra Limited, Gurgaon  Environmental Impact Assessment and Environmental Management Plan for Propane Reticulation System, Indian Oil Petronas Pvt. Ltd., Kolkata  Environmental Impact Assessment and Environmental Management Plan for Haridwar Greens, Arrow Infra Limited, Gurgaon  Environmental Monitoring, Statutory compliances for Hero Realties (formerly Arrow Infra Limited)
  • 17.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.7 DESIGN AND ENGINEERING  Techno-Economic Feasibility Report on Maize Starch and Value added downstream products, Vardaan Industries (P) Ltd., Lucknow  Technology Imperatives and Business Opportunities Report of Indian Chemical Industry on Basic (Organic, Inorganic, Fertilizers and Petrochemicals) Chemicals, TIFAC, DST, Govt. of India  Feasibility Study on Coal to Polygeneration (CTP), Jindal Synfuels Ltd. Orissa  Project profiles on Ceramics and Glass Products for Common Facility Center, CRISIL, Gurgaon  Detailed Design and Engineering for Activated Carbon Plant, M/s AAI Valley Carbon Pvt. Ltd., Assam  Concept to Commissioning including Detailed Design and Engineering for 70 TPD Paper Mill, M/s Manasarovar Paper and Industries Limited, Najibabad, Uttar Pradesh  Techno-Economic-Feasibility Report on cryogenic LPG storage Terminal for Hindustan Aegis LPG Bottling Co., Mumbai  Conversion of Ammonia Storage facilities for LPG storage for Paradeep Phosphates Limited.  Detailed Design & Engineering of 10 LPG Micro Bottling Plant at Punjab for Punjab Petroleum Corporation Ltd., Chandigarh.  Consultancy Services for Slurry Explosives Project, Indo-Burma Petroleum Co. (IBP), Korba  Detail Design and Engineering of Slurry Explosives Project based on Know-how of Trans-Ocean Gulf Oil Co. U.S.A., Indo-Gulf Explosives Limited, Jhansi, Uttar Pradesh & Singrauli, Madhya Pradesh
  • 18.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.8 TECHNOLOGY EVALUATION, IMPLEMENTATION AND OTHERS  Technology Status Report for Maleic Anhydride, Methanol, Ethylene Oxide, Ethylene Glycol, Electrolytic Manganese Dioxide, Alpha Olefin and Alpha Sulphonate, Soda Ash, Butanol, Isabgol, Phenol, Biodegradable Plastics for DSIR, Ministry of Science and Technology, Govt. of India  Erection of Fire Fighting System at Unchahar Thermal Power Station, Vijay Fire Protection Systems Pvt. Ltd., New Delhi  Construction of Bamboo Kilns in North-Eastern States, for NMBA and State Government Agencies.  Chemical City: A report incorporating Drugs, Dyes and Pesticides, Department of Industries, Government of Bihar  Project Profiles for Fifteen Pharmaceutical and Chemical items for Birla Institute of Scientific Research, Noida, U.P.  Over 70 Market Surveys on various chemicals, pharmaceuticals and agro-chemicals for National Research Development Corporation, New Delhi  Over 200 Project Profiles, Technical Audits, Work-In-Process, Pre-Feasibility Reports and Assets Evaluation for various Government and other organisations.  Compliance for Consent to Operate, ambient monitoring, Factory Licenses, Fire Clearances, On-site emergency plan, Disaster Management plan
  • 19.
    C.P.CONSULTANTS PVT. LTD. AnISO 9001: 2008 certified organization 2.9 CONTACT DETAILS C.P.CONSULTANTS PVT. LTD. B-223 CHITTARANJAN PARK, NEW DELHI - 110019, INDIA Telephone : 091-011-26276333 / 26276344. Fax : 091-011-26276363 E-mail : cpcdelhi@yahoo.com Website : www.cpconline.in BRANCH OFFICE C-2, Block A, Sagarika Appartments, 15 Old GT Toad Bally, Howarh, West Bengal - 711201, Ph: +91-33-26714729 OUR BANKERS Oriental Bank of Commerce Greater Kailash-I Branch New Delhi – 110048 OUR CHARTERED ACCOUNTANTS S KETU AND COMPANY LAXMI NAGAR NEW DELHI-110092
  • 20.
  • 21.
    Professionals C.P.CONSULTANTS PVT. LTD.3.2 DR.A. MUKHERJEE B.Ch.E (Jadavpur) M.Tech (IIT Mumbai) Ph.D(Toronto, Canada) All in Chemical Engineering : Managing Director Over 50 years experience in Design & Engineering, consultancy and project management Previously in - i. Calico Chemicals Ltd., Mumbai ii. Larsen & Tourbro Ltd., Mumbai iii Hart Chemicals Ltd., (Unilever Group), Toronto, Canada. iv Chemical and Metallurgical Design Co (P) Ltd., New Delhi v. Escon Consultants (P) Ltd., New Delhi Member of - i. Chairman, Indian Institute of Chemical Engineers, Northern Regional Centre ii. Indian Pharmaceutical Association iii. Indian Pulp & Paper Technical Association iv. Indian Ceramic Society Technical Paper :  Oxidation of Tetralin in the liquid phase with insoluble catalyst. ( J.Am. Phy. Chem,1967) Key Note Address in Seminars:  On ‘Design & Engineering Services for Organic Chemical Industry’. All India Seminar on Organic Chemical Industry.  On ‘Potential Industries in Rajasthan’ for Bureau of Industrial Promotion (BIP), Govt. of Rajasthan.  Technology Status on various chemicals for DSIR, Ministry of Science & Technology.  On ‘Prospect of Biodegradable Plastics in India’ for Consultancy Development Centre.  Prevention and Management of Chemical Accidents with special emphasis on Fertilizer industry, FAI, KRIBHCO, Hazira
  • 22.
    Professionals C.P.CONSULTANTS PVT. LTD.3.3 Mr.SUDIPTO MUKHERJEE B.E. (C hem) : Director More than 25 years experience in Chemicals and Paper. Specialize in project identification, market research, feasibility report and financial analysis besides acting as project coordinator Ms. C. MUKHERJEE B.Sc. : Director Over 20 years Experience in coordination and implementation of Tourism studies, Health Studies, Handicrafts and cottage sectors, Socio-economic Surveys, Project Execution. MR T.N. BANERJEE M. Tech (Chemical) : General Manager More than 50 years of professional experience in the areas of Process Design, Basic Engineering, Procurement, Project Management, Start-up, Commissioning and operation of Heavy Chemical Plant (Soda Ash, Caustic Soda & Refined Bicarbonate). More than a dozen of Study Report prepared for Government and Private Organisation. In addition involved in business development for the organisation. Overall technical in-charge of the organisation MR. S. C. BHARGAVA MA (Economics) : Sr. Economist More than 40 years experience in statistical surveys, market research, collection of primary data, statistical analysis, data interpretation, and supervision, documentation conducting primary and secondary surveys & Market Research for more than 20 sectors like automobile, biotechnology, chemicals and pharmaceuticals. MR. H. MUKHERJEE B.Sc (Agriculture) Member: Indian Paper and Pulp Technical Association : Sr. Manager (Business and Strategic Development) 30 years of experience in paper and allied industry in various capacities in commercial as well as production. 10 years experience in consultancy, research oriented studies, finance, marketing & sales, co-ordination, inventory and Asset valuation, Project development and management.
  • 23.
    Professionals C.P.CONSULTANTS PVT. LTD.3.4 Mr.SANJAY DAS AMIE (Mech. Engg.) Dip. in Business Management : Sr. Engineer More than 25 years of experience in marketing & sales, co-ordination of industrial products & more than 3 years of experience in erection of plant & machinery, collection of data for EIA and other research studies. Undergone CSE Training on “Understanding EIA from screening to decision making” MR. P. DASGUPTA B. Tech (Chemical Engg.) : Manager 11 years experience in Project Management, Market Research, Design and Engineering, Fire Fighting systems, Feasibility Reports, safety audits, Disaster Management, risk assessment studies, Environment Impact Assessment Studies, work-in-process and Project Profiles in chemical, pharmaceutical sectors, environment and climate change. Completed course in Climate Change and Disaster Risk Reduction from World Bank Institute and NIDM. Presented papers in national seminars in the field of safety and industrial pollution abatement. Thorough knowledge of CAMEO, ALOHA, RMP, POLYMATH, & other Simulation. Associate Member: Indian Institute of Chemical Engineers MR. SUKUMAL DAS M. Tech (Chemical) Process and Design Engineer More than 3 years of experience in process design and engineering, basic engineering, process documentation, engineering research SH.B. LUGANI CHARTERED ACCOUNTANT CA & Auditor More than 30 years experience as a chartered accountant, in financial audits and fund management for projects related to various industries SH. SHWET KETU KUMAR CHARTERED ACCOUNTANT CA & Auditor More than 10 years experience as a chartered accountant, in financial audits and fund management for projects related to various industries
  • 24.
  • 28.
  • 29.
    C.P.CONSULTANTS PVT. LTD. 4.2 CO N T E N T S PROJECT TITLE  Industrial Chemicals  Paper  Petrochemicals  Drugs and Pharmaceuticals  Disaster Management  Food and Fermentation  Paints and Dyes  Ceramics/Granite/Marble  Piping  Plastic and Rubber  LPG Projects  Tourism  Reports/Market Surveys  Valuation
  • 30.
    C.P.CONSULTANTS PVT. LTD. 4.3 S.NoClient Assignment Project Cost (Rs. Lakhs) A . I N D U S T R I A L C H E M I C A L S 1 TIFAC, New Delhi Technology Imperatives and Business Opportunities Report of Indian Chemical Industry, (Organic, Inorganic, Fertilizer and Petrochemicals) 2 JINDAL SYNFUELS Ltd. Orissa Feasibility Study on Coal and Polygeneration (CTP) 3 Alfa Petrocoke Ltd New Delhi TEFR – Calcined Petroleum Coke 4 Balaji Amines Ltd Hyderabad Checking of Detailed Design Engineering Documents for Ethylamines Project on behalf of IFCI 500.00 5 Department of Industries Govt. of Bihar Chemical City A report incorporating Drugs, Dyes & Pesticides Complex. Drugs included Ibuprofen, VitC, Rifampicin, Dapsone PAS, Thiabendazole, INH, Ethambutol and pesticide Endosulfan 6 Department of Scientific & Industrial Research, Ministry of Science & Technology, Govt. of India Technological Status Reports for Maleic Anhydride Methanol Ethylene Oxide & Ethylene Glycol, Electrolytic Mangannese Dioxide, Alpha Olefin & Alpha Olefin Sulphonate, Soda Ash, Butanol, Phenol, Biodegradable Plastics. 7 Diamond Salt Ltd. Rewari, Haryana FR on Salt refining & Iodising. 8 Hindustan Lever Ltd. Orai. U.P. Basic & Detail Design Engineering of Toilet Soap Plant 9 Indo- Burma Petroleum Co. (IBP), Korba Consultancy Services on Slurry Explosives Project 10 Indo-Gulf Explosives Ltd. Detailed Design & Engg. of Slurry Explosives Project based on know- How of Trans-Ocean Gulf Oil Co. U.S.A. 550.00 11 Indo-Gulf Explosives Ltd. Singrauli. M.P Detailed Design & Engg. of Slurry Explosives Project 150.00 12 Industrial Finance Corporation of India New Delhi. Revival Plan of Glyoxal Metronidazole &Tinidazole Plant of Rajasthan Glyoxal Ltd., Udaipur 300.00 13 PICUP, Lucknow TEFR on Monosodium Glutamate.
  • 31.
    C.P.CONSULTANTS PVT. LTD. 4.4 S.NoClient Assignment Project Cost (Rs. Lakhs) 14 Rajasthan State Industrial Development Corporation (RIICO), Jaipur. Market Survey and Pre-feasibility Report of Lead Acid Storage Batteries 500.00 15 Runeecha Polymar (P) Ltd. Bhiwadi, Raj Detailed Design Engineering of PVC / PU Coated Synthetic Fabric. 875.00 Technology Information Forecasting and Assessment Council 16 (TIFAC) Techno-Commercial Feasibility Report on Activated Carbon from Bamboo. 17 TIFAC Trial Run to Produce Activated Carbon from Bamboo on Commercial Scale 18 TIFAC Brick Kilns for production of charcoal from bamboo in North East States (Manipur, Nagaland, Meghalaya, Mizoram, Assam and West Bengal, Madhya Pradesh and Uttar Pradesh 19 ZORAM CARBON Detailed Project Report on 2TPD Activated Carbon 20 ASOM PETROCHEM Feasibility Report on 2 TPD Activated Carbon 21 AAI VALLEY CARBON, Assam Detail Design and Engineering of 2 TPD Activated Carbon from Bamboo Charcoal 22 NRDC Basic Engineering Documents of Mango Based Herbal Health Drink, Hydrogel, Zinc Based Micronutrient Fertilizers, Rice Husk Particle Board, Nemagel, Silver Nano Particles, Equi Herpabort Vaccine B . P A P E R 1 ABC Papers Ltd. Techno-Economic Feasibility study on Waste Paper Pulping 2 Continental Papers Ltd Design & Engineering of Bagasse Pulping for 50TPD Paper Plant with Effluent Treatment. 500.00 3 Howe India Market Survey on Writing and Printing Paper in India 4 Industrial Data Bank Patna, Bihar PFR on 20 TPD Duplex Board 5 Khanna Paper Mills Ltd. Amritsar. TEFR for debottling of Duplex Board Plant.
  • 32.
    C.P.CONSULTANTS PVT. LTD. 4.5 S.NoClient Assignment Project Cost (Rs. Lakhs) 6 Manasarovar Paper & Industries Ltd. Najibabad, U.P. Turnkey Consultancy including detailed design and engineering for 30 TPD Triplex Coated Board Plant. 1000.00 7 Mansarovar Bottling Corporation Ltd. TEFR on Duplex Board Project Expansion of Paper project to 60 TPD. 8 Mansarovar Beverages & Industries Ltd. Najibabad Market Report on Triplex Coated Board. Feasibility Study, Detailed Design Engineering of Paper Plant 9 RIICO Currency Note Paper 10 Viswamitra Paper Industries Ltd., Buxar, Bihar Turnkey Consultancy Services including Design and Engineering for 8 TPD Duplex Board Unit 150.00 C . P E T R O C H E M I C A L S 1 Aegis Chemicals Mumbai Formaldehyde 2 Albert David Ltd. Calcutta Pentraerythritol 3 Alfa Petro-Coke Ltd. New Delhi Calcined Petroleum Coke 4 DSIR, New Delhi Alfa-olefin and Alfa-olefin sulfonate, Butanol 5 DSIR, New Delhi Ethylene oxide and Ethylene Glycol 6 DSIR, New Delhi Maleic Anhydride 7 DSIR, New Delhi Methanol and Phenol D . D R U G S & P H A R M A C E U T I C A L S . 1 Albert David Ltd. Calcutta Detail Design & Engineering Service for Bulk Drug Project. 70.00 2 Albert David Ltd. Ghaziabad Detail Design & Engineering for Transfusion Fluids Project 3 Birla Institute of Scientific Research Noida, U.P. Project Profiles on fifteen Pharmaceutical and Chemical Items.
  • 33.
    C.P.CONSULTANTS PVT. LTD. 4.6 S.NoClient Assignment Project Cost (Rs. Lakhs) 4 BSPCDC., Patna Feasibility Study on Medical Disposable Sets 300.00 5 Curewel (India) Ltd. Faridabad Engineering Services Pre-feasibility study 100.00 6 Department of Scientific & Industrial Research Ministry of Science & Technology Pre-investment feasibility study on Trimethoprim 7 Hamdard (Wakf) Laboratories, Gaziabad Consultancy Services. 8 HPSIDC, Shimla Project profiles for Rifampicin, D-Phenyl Glycine Vitamin B-6, Novaldiamine, Propranolol Hydro-chloride, Metronidazole, Ibuprofen 9 IDB, Patna. PFR on Paracetamol, Metronidazole 10 Mesco Pharmaceutical, New Delhi. Project Report on Ciprofloxacin & Norfloxacin 11 Madhu E. Nicholas, Kerala Disposable Syringes 12 PICUP, Lucknow TEFR on Quinolones, Terfenadine, Roxythromycin Ranitidine and Ethambutol 13 Purnima Pharmaceuticals Pvt. Ltd. Jaipur Turnkey Consultancy Services Including Design Engineering Of Drug Formulation Unit. 75.00 14 RIICO., Jaipur Prefeasibility Report for 3,4,5 TMBA, Trimethoprim & Anti-TB Drugs Aminophylline, Theophylline, & Cuffeine. 250.00 15 Ranbaxy Laboratories Ltd. Safety Audit of Chlorine System 16 RRG Laboratories, Dehra Dun Feasibility Study on Transfusion Fluid Project. 110.00 17 Surya Pharmaceuticals Ltd. Total Inventory Report 18 Wadera Engineers (P) Ltd., Patna Project Report on Paracetamol 125.00
  • 34.
    C.P.CONSULTANTS PVT. LTD. 4.7 S.No. Client Assignment Project Cost (Rs. Lakhs) E . P L A S T I C S & R U B B E R 1 BSPCDC, Patna Installation and commissioning of Plastic & Rubber Project at Behra. 150.00 2 BSPCDC, Patna Feasibility Study on Rubber Conveyor Belt Project 50.00 3 CDC / DSIR, New Delhi Technology Status and Prospect of Biodegradable Plastics in India. 4 Doon Polymer Pvt. Ltd. TEE of Assets 5 Haryana Woven Sack (P) Ltd., Gurgaon, Haryana Engineering Services on HDPE Woven Sacks Project. 50.00 6 IDB, Bihar PFR on Rigid PVC pipe. 7 R.A.Innovation New Delhi Project Report on Furniture Manufacturing from waste Automobile Tyres. 8 R.K. Polypack, Ghaziabad Feasibility Study on HDPE Woven Sack 9 Rotocast Equipment & Processors Pvt. Ltd. PR on expanded polyethylene sheets. 10 Shri. Ram Fertilizers & Chemicals. New Delhi. Market Survey on Plastic Additives. 11 Mr. Sharad Sinha, Lucknow Consultancy Services on PVC Pipes 150.00 F . F O O D & F E R M E N T A T I O N 1 Vardhaan Industry Lucknow TFR for Maize Processing for Starch and Value added products like glucose, dextrose monohydrate, etc. 2 BSPCDC, Patna Turnkey Consultancy Services & feasibility study on Starch and its Derivatives. 872.00 3 BSPCDC, Patna Turnkey Consultancy Services & Feasibility Studies on Industrial Alcohol Unit 480.00 4 BSPCDC, Patna Feasibility Study on Mineral Water Unit. 5 Bihar Maize Products, Patna. PFR on Starch & Liquid Glucose
  • 35.
    C.P.CONSULTANTS PVT. LTD. 4.8 S.No. Client Assignment Project Cost (Rs. Lakhs) 6 Continental Constructions Ltd., New Delhi PR on Edible oil & Vanaspati. 7 Chohan Chemicals Pvt. Ltd., New Delhi Feasibility Study for Saccharin Project 65.00 8 HPSIDC, Shimla Pre –feasibility Report for 100 TPD Vansapati project at Sahibabad 500.00 9 IDB, Patna. PFR on Vanaspati. 10 Indus Valley Trading Pvt. Ltd., New Delhi. PFR on 60 TPD Palm oil refining & Vanaspati. Manufacture 11 Kudos Chemic Ltd., Chandigarh Work-In-Progress Report for Caffeine manufacture. 12 Madyasar (P) Ltd., M.P. Feasibility Study on Industrial Alcohol Unit 275.00 13 National Research Development Corporation (NRDC), New Delhi Feasibility Report on Invert Sugar, Low calorie Bread spread BEDP for Beta Carotine Rich Biscuit, Probiotic Dahi, Flavoured Milk, Bitter Gourd Drink 14 PICUP Mono-Sodium Glucamate 15 ANJS EXPORTS PVT. LTD Feasibility Report on 5000 LPD Herbal Health Drink 16 DSIR, CDC Technology Status of Isabgol Based Industry G . P A I N T S & D Y E S 1 B S P C D C TEFR on Authraquinone Vat Dyes. 2 Deepika Extractions (P) Ltd. , Gurgaon Project Report for Synthetic Iron Oxide Red & Yellow 100.00 3 Directorate of Industries Govt. of Bihar Feasibility Study on Dyes Project 480.00 4 Golden Pigments Pvt. Ltd. PF on Alpha Copper Phthalocyanine Blue / pigment blue 5 Jenson & Nicholson (I) Ltd. Basic Engineering Documents of Paints Project at Sahibabad 500.00 6 Shirdi Chemicals Dye intermediates.
  • 36.
    C.P.CONSULTANTS PVT. LTD. 4.9 S.No. Client Assignment Project Cost (Rs. Lakhs) H . C E R A M I C S / G R A N I T E / M A R B L E 1 Department of Scientific & Industrial Research Ministry of Science & Technology Technology Status & Norms Study on Granite & Marble 2 Chokhani Iron & Steel works, Jaipur. PFR on Zirconium silicafe opacifier & Frit / Glaze Project. 3 RIICO, Jaipur Market Survey on Granite Utilisation of marble dust, slurry waste Project Profile on Ceramic Colours & Pigments 4 Rajasthan Udyog. Survey on Marble & Granite & Dimensional Store. 5 Shahid Group of Industries, New Delhi PFR on Tableware products. 6 RIICO/CRISIL Project Profiles on Glass and Ceramic Products at Ghilot, RIICO Complex, CRISIL I . P I P I N G 1 Chandrapur Thermal Power Station (MSEB) Detailed Design and Engineering for GS/LP Piping System for 210 M.W. Power Station Unit – III 2 Vijay Fire Protection System Pvt. Ltd., New Delhi Erection of Fire Fighting System at Unchahar Thermal Power Station J . D I S A S T E R M A N A G E M E N T 1 Central Pollution Control Board Safety compliance Audit of major Hazardous Units in the NCR of Delhi. 2 Central Pollution Control Board Study on Risk Assessment in Oil Refinery and petrochemical Complexes. 3 Ministry of Environment & Forests Risk, Consequences & Mitigation study of chemical Tanker Transportation on NH-8 4 Ranbaxy Laboratories Ltd Safety Audit of the Chlorine System 5 Yatindra Paper Industry Risk Analysis of HDS/ FO Transfer Storage 6 National Thermal Power Corporation Safety Audit of Badarpur Thermal Power Station
  • 37.
    C.P.CONSULTANTS PVT. LTD. 4.10 S.No. Client Assignment Project Cost (Rs. Lakhs) 7 MOEF Rapid Safety Audit & Hazard Analysis for Kolkata, Ajmer, Bhavnagar, Bhatinda, Gurgaon, Surat, Kutch, North 24 PGNS, Hooghly, Bokaro, Karimnagar and E. Singhbhum, Srikakulam Districts 8 MOEF Off-site emergency plan for Bhavnagar, Hooghly, North 24 PGNS, Karimnagar, E.Singhbhum, Gurgaon, Surat, Kutch, Srikakulam districts 9 MOEF 10 Greater Calcutta Gas Supply Corporation Hazard Analysis and Risk Assessment, amendment of On-site emergency plan as per Schedule XI, MSIHC Rules 11 Reliance Industries Limited Comprehensive Risk Assessment of 2 X 500 MW Gas based thermal power plant and IPCL, Nagothane, On- site emergency plan, Off-site emergency plan, Disaster Management Plan 12 Indian Oil Petronas Pvt. Ltd. Risk Assessment of Propane Reticulation Systems along with associated pipelines, On-site emergency plan, Dehradun K . L P G & H A Z A R D O U S C H E M I C A L S P R O J E C T S . 1 Aegis Chemical Industrial Ltd., Mumbai TEFR on Cryogenic LPG Storage Terminal 2 Eastern India LPG Ltd. Market Survey Report for West Bengal, Bihar, Orissa, Andhra Pradesh. 3 Hind Polymers Pvt. Ltd., Kolkata Ethylene Storage Terminal 4 Hindustan Aegis LPG Bottling Co. Ltd., Mumbai Consultancy for Cryogenic Storage of LPG & Bottling Unit 10000.00 5 Hindustan Domestic Oil & Gas Co Bombay Ltd Detailed design and Engineering of 20 LPG Micro Bottling Plant in U.P. & Rajasthan 6 Hindustan LPG Bottling Co. Ltd., Mumbai Detailed Design & Engineering of 22500 TPA LPG Bottling unit at Dombivli 7 Indo-Gulf Industries, Jhansi Slurry Explosives
  • 38.
    C.P.CONSULTANTS PVT. LTD. 4.11 S.No. Client Assignment Project Cost (Rs. Lakhs) 8 Kolmark Petrochemicals Ltd., Kolkata VMC Storage 9 NOCIL, Mumbai Cryogenic Storage Terminal 10 Paradeep Phosphate Conversion of Ammonia Storage Facilities For LPG 11 Parvin Petro Product Pvt. Ltd. Mini LPG Bottling Project 12 Punjab Kero & LPG Pvt. Ltd. Mini LPG Bottling Project 13 Punjab Petroleum Corporation Ltd. Chandigarh Detail Design & Engineering of 10 Micro Bottling Plants in Punjab. 14 Trendeastwest LPG Bottling Co. Ltd. New Delhi. Detailed Design and Engineering of 45000 TPA LPG Bottling Plants in Punjab 15 SGS Petro Organic (P) Ltd., Chennai TEFR on LPG handling at Cuddalore Port 16 Western Petroleum & Trading Pvt. Ltd., Mumbai Port based Storage Terminal survey (including Traffic Projection) L . T O U R I S M 1 Inland Water ways Authority of India, Ministry of Surface Transport. Development of Inland Water Transport in river Brahamaputra. 2 Ministry of Tourism Impact of Tourism on Socio-economic Development in Rajasthan & Kerala M . R E P O R T S / M A R K E T S U R V E Y S 1 Aegis Logistics Ltd. (Formerly Aegis Chemical) Market Survey on Chemical Storage Terminal at JNPT. 2 Aegis Chemical & Industries Ltd. Mumbai Market Survey on Formaldehyde, Market Survey on Chemical Storage Terminal at Mumbai Port, Feasibility Report on Cryogenic LPG Storage Terminal
  • 39.
    C.P.CONSULTANTS PVT. LTD. 4.12 S.No. Client Assignment Project Cost (Rs. Lakhs) 3 Continental Construction Ltd. New Delhi. Project Report for Edible Oil & Vanaspati Complex 2000.00 4 ENCO – Tech. Consultants Pvt. Ltd., New Delhi Market Survey of Bhutan Particle Board 5 Enpro India Ltd., New Delhi. Market Survey on Tableware Products. 6 Hind Polymer (P) Ltd., Calcutta Feasibility Report on Cryogenic Storage Terminal for Ethylene. 7 Eastern India LPG Ltd., Mumbai Primary Market Survey on LPG in four eastern states 8 Kolmak Ptrochem Ltd., Calcutta Feasibility Report on Pressured Storage Terminal For VCM 9 PICUP., Lucknow Pre-feasibility Report on Quinoline drugs, Monosodium glutamate 10 RIICO., Jaipur Pre-feasibility Report for Security Paper 11 S.G.S. Petro Organic (P) Ltd., Chennai Project Report for Port Facilities for LPG 12 National Research Development Corporation New Delhi Quick Market Survey on Isabgol, Ethyl Methyl Anthranilate, Invert sugar, Palatable Laxative, Liquid Glucose, PET Recycling, Low Calorie Bread Spread, Bakery Margarine, Biodegradable Plastics, Heena Based Hair Dye Powder, Kattha, Vibratory Stress Relief Equipment, D-Hydontinise, Maintenance Free Lead Acid Battery, Plasma Coating, Fluidized Abrasive Polishing Machine, Jute Stick Particle Board, Rice Bran Oil, Thioglycolic Acid, Aero-Microbial Filter for Hospital, Copper Phthaloeyanine Blue, Beta Napthol, Resorcinol, Natural Dyes, Corrosion Resistance Coating, Small Scale Biotechnology and Bioinformatics Companies, Drugs & Pharma Vaccines and Diagnostics for Cattle, Poultry and Fisheries, Shellac based Can Coatings, Aleuritic Acid, Herbal Health Drinks, Herbal Colours, Quick Market Survey and Pre-Feasibility Reports on PET Recycling, Processed Poultry Products, Sol-gel technology (Anti- glare and Anti-reflective) coatings. TB based diagnostic kits, ELISA kits, Neem seed, Azadirachtin, Hydrogel, Long Decay Phosphor
  • 40.
    C.P.CONSULTANTS PVT. LTD. 4.13 S.No. Client Assignment Project Cost (Rs. Lakhs) 13 National Research Development Corporation New Delhi Polymeric Blend based Electric Accessories, White Grubs, Nema Gel, Trichoderma, Leptospirosic Detection Kit, Rare Earch, RTV Sillicon, Cholesterol/Urea & Copper Biosensos, DNA Vaccine, Potassium Humate, Halwa from Pumpkin, Dehydration of Apple & Apricot, Karela Dot-Elisa Kit, Sero-Diagnosis of IBDIV, Supportive Therapy,Cultured Epithelial Autograft cultivated, Mosquito Larvicidal, Fluidised Abrassive Polishing Machine, Recombinant IGM Elisa Kit, Ayush-A, Products for Antenatal & Postnatal care, Ayush QOL-2C, Low Cost Plant Tissue, Polyhydroxy Butyrate, Rhizobia, Safranal Nanoemulsion, Dried Flower, Development of Oligonuceleotides. 14 Shriram Fertilizers & Chemicals Market Survey on Chlorine based Chemical: Aluminum Chloride, Calcium Chloride, Ferric Chloride, Para Chloro Toulene, and ortho Chloro Toulene, Polyaluminum Chloride, Stable Bleaching Powder 15 Shriram Institute for Industrial Research, New Delhi Market Survey on Polythiols 16 Hindustan Aegis Bottling Ltd, Mumbai Feasibility Report on Cryogenic LPG Storage Facility. N . V A L U A T I O N . 1 Amrit Banaspati Ltd Valuation of Assets 2 Aulluck & Co. (P) Ltd. Techno-economic Evaluation of Assets. 3 Balaji Amines Third Party Technical evaluation. 4 Bhusan Alloys & Castings Ltd. Techno-economic Evaluation of Assets 5 Casco Narain (India) Ltd. Techno-economic Evaluation of Assets. 6 Cepham Organics Kundli Technical Audit 7 Doon Polymers Ltd. Techno-economic Evaluation of Assets. 8 Golden Proteins Ltd. Techno-economic Evaluation of Assets. 9 Himalaya International Ltd. Valuation of Assets (IDBI)
  • 41.
    C.P.CONSULTANTS PVT. LTD. 4.14 S.No. Client Assignment Project Cost (Rs. Lakhs) 10 Hindustan Adhesives Ltd. Valuation of Assets (IDBI) 11 12 Flex Chemicals Valuation of Assets 13 Indo-American Chemicals Techno-economic Evaluation of Assets. 14 Kudos Chemie Ltd. (Punjab) Valuation of work – in – progress of Caffeine Plant 15 Laxmi Polymers Ltd. Techno-economic Evaluation of Assets. 16 Partap Steel Ltd. Valuation of Assets assigned by IDBI. 17 Rajasthan Glyoxal., Udaipur Revival and Diversification study (Under BIFR) 18 Raj Cement Co. Ltd. Techno-economic Evaluation of Assets 19 Rattan Vanaspati Ltd Techno-economic Viability 20 Rattan Vanaspati Ltd Valuation of Assets 21 Saharanpur Cement Ltd. Techno-economic Evaluation of Assets. 22 Shree Shyam Pulp & Board Mills Ltd. Valuation of Assets 23 Sintered Separators Ltd. Techno-economic Evaluation of Assets. 24 Sidharth Pharma Techno-economic Evaluation of Assets. 25 Surya Pharmaceuticals Ltd. Inventory Verification assigned by PNB. 26 IFCI Valuation and Business Revival Project, Mukerian Paper Mills, Mukerian 27 IFCI Valuation of Assets of M/s Shiva Paper Mills, Rampur 28 IFCI Valuation of Moradabad Suntex Limited
