SlideShare a Scribd company logo
1 of 32
Mark L. Simon II
Phase - 5 / Individual Assignment IP5
IT425-1403B-04
Systems Design, Analysis and Integration
Professor: Ihssan Alkadi
17 September, 2014
Colorado Technical University
City Hall - The Project Case Study
City Design 1
Table of Contents
Chapter 1 – SDLC Overview & Requirements............................................................................... 2
Executive Summary Analysis ..................................................................................................... 2
Preliminary Analysis/ Requirements/Current System Design .................................................... 3
Chapter (2) – Design & Development ............................................................................................ 5
Develop a Use Case..................................................................................................................... 5
Vision Statement ......................................................................................................................... 6
Functional Decomposition Graphs.............................................................................................. 8
Data Flow Diagram..................................................................................................................... 9
A Sequence Diagram................................................................................................................. 10
The Storyboard Graph............................................................................................................... 12
Conclusion................................................................................................................................. 13
Chapter 3 – Test & Quality Assurance ......................................................................................... 15
Introduction to SQA.................................................................................................................. 15
Unit Testing............................................................................................................................... 15
Systems Testing......................................................................................................................... 17
Acceptance Testing ................................................................................................................... 18
Conclusion................................................................................................................................. 20
Chapter 4 – Development Strategies & Acquisition..................................................................... 22
Introduction............................................................................................................................... 22
In-Sourcing................................................................................................................................ 22
Insourcing and Outsourcing Combined..................................................................................... 24
Outsourcing............................................................................................................................... 25
Conclusion................................................................................................................................. 27
Chapter 5 – System Integration & Deployment............................................................................ 28
Introduction............................................................................................................................... 28
The Work Breakdown Structure ............................................................................................... 28
Conclusion................................................................................................................................. 31
City Design 2

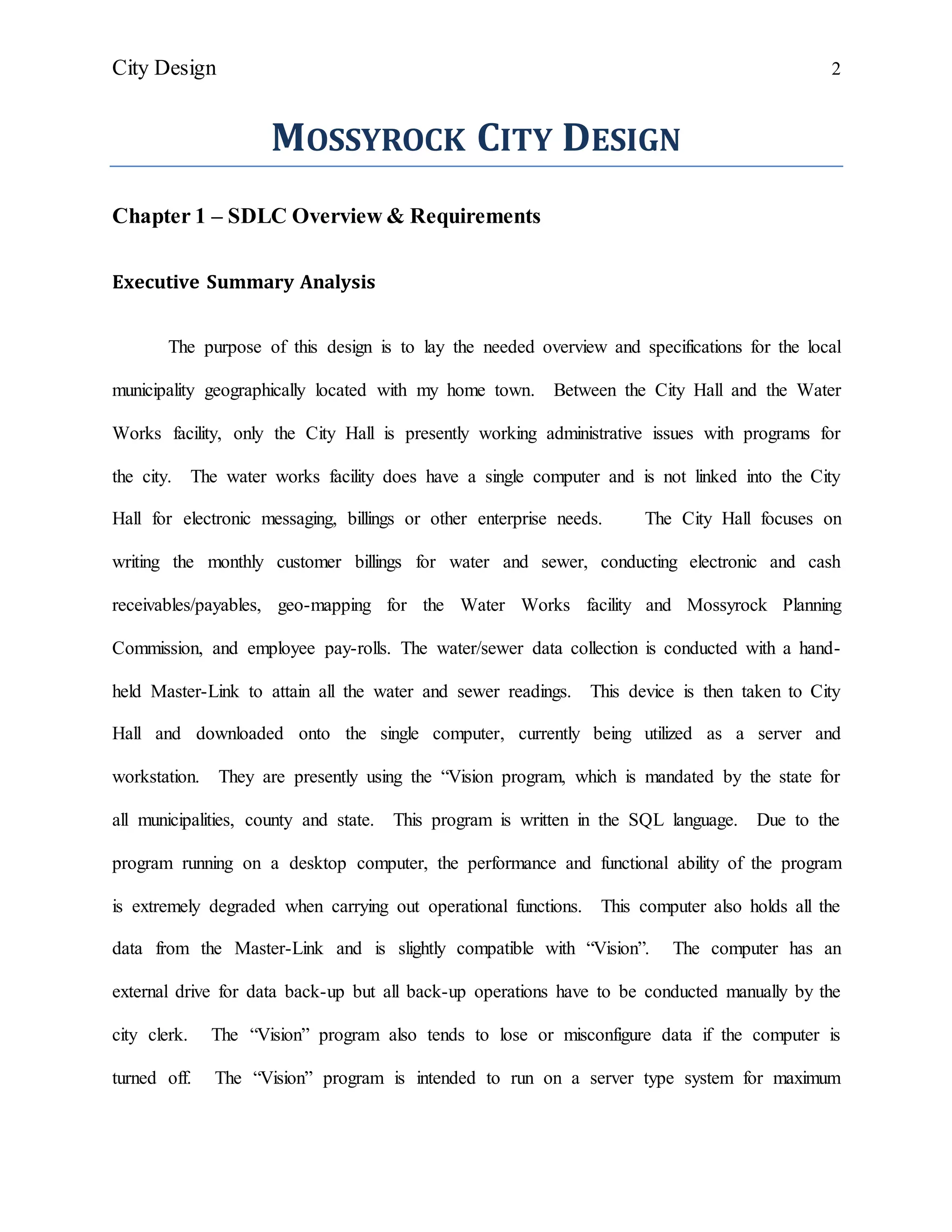

MOSSYROCK CITY DESIGN
Chapter 1 – SDLC Overview & Requirements
Executive Summary Analysis
The purpose of this design is to lay the needed overview and specifications for the local
municipality geographically located with my home town. Between the City Hall and the Water
Works facility, only the City Hall is presently working administrative issues with programs for
the city. The water works facility does have a single computer and is not linked into the City
Hall for electronic messaging, billings or other enterprise needs. The City Hall focuses on
writing the monthly customer billings for water and sewer, conducting electronic and cash
receivables/payables, geo-mapping for the Water Works facility and Mossyrock Planning
Commission, and employee pay-rolls. The water/sewer data collection is conducted with a hand-
held Master-Link to attain all the water and sewer readings. This device is then taken to City
Hall and downloaded onto the single computer, currently being utilized as a server and
workstation. They are presently using the “Vision program, which is mandated by the state for
all municipalities, county and state. This program is written in the SQL language. Due to the
program running on a desktop computer, the performance and functional ability of the program
is extremely degraded when carrying out operational functions. This computer also holds all the
data from the Master-Link and is slightly compatible with “Vision”. The computer has an
external drive for data back-up but all back-up operations have to be conducted manually by the
city clerk. The “Vision” program also tends to lose or misconfigure data if the computer is
turned off. The “Vision” program is intended to run on a server type system for maximum
City Design 3
efficiency where it is not presently being utilized. The current machine is presently utilizing an
A8 (AMD) Advanced Micro Designs quad core processor with 6 Gig of memory to handle all
cached information.
Preliminary Analysis/ Requirements/Current System Design
Currently, there are three computers in City Hall and one is being utilized as the server
and work station. By assessing the base line requirements of the system, within the current state,
the system is only rated at 30% of maximum efficiency. The “Vision” software company
utilizes a schematics requirement (pdf) document to establish base line hardware requirements
dependent upon the number of work stations in existence. In this report, it is recommended that
all servers operating this software are highly recommend to run a server with Windows Small
Business Server 2012, Intel-i5 enterprise processor, 8 Gig of DDR3 memory and additional
SATA/HD drives in RAID 1 or 5 configuration, as a minimum. The server may be utilized, in
its current configuration, to handle up to 5 functional workstations for smooth and proficient
network operations. A single desktop running with this software is ONLY recommended if the
computer is a self-contained system with no other nodes within a network. The software is not
compatible with AMD or Cyrix type hardware systems and should use Intel exclusive reliant
hardware. The “Vision” software has the abilities of interacting between cash management
account, customer water and sewer billings and electronic funds management. It also, completes
pay-roll functions for the city workers yet the system is constantly dropping data within these
systems in “Vision”. An auto-back up is desired in the RAID (Random Array of Independent
Disks), to be functionally installed within the Server. Currently, with no auto backup, the city
clerk has to conduct this operation manually. The “Vision” technical support has not been able
City Design 4
to circumvent these problem areas of data loss and automatic back up operations. A support
patch may be applied to foster prevention of data loss and auto backup.
City Design 5
Chapter (2) – Design & Development
Develop a Use Case
The purpose of this section is to better understand the scope of implementing an overall
“case use” study of the overall City Hall system by looking at the general area of the system and
sighting where each sub-system of the network is utilized. This may then be broken down into
further sub categories as we progress. Once the “use case” study has been accomplished we will
be able to incorporate the functional decomposition diagram portion. Even though functional
decomposition diagrams do not show sequential events, they do show a descending hierarchical
organization of the business functions that comprise the business operation. The functional
decomposition diagrams main function is to simplify and break down complex business
operations into manageable chunks. The decomposition function facilitates a better
understanding of the business and hence is useful in being a good analysis and design type tool.
Functional decomposition is instrumental in determining the functional solutions in the
requirements documents. This decomposition function is intrinsic in breaking down larger or
complex functions prior to developing a process flow diagram.
Within the City Hall we know they have many operations running on a redundant and
antiquated type computer network. The software running on these systems has already been
purported as software that should be running on a bigger capacity network. So, why is this
system not adequately standardized with matching hardware? This is where the functional
decomposition will come to fruition. Let’s view the data dictionary/repository diagram below
for an insight into a “use case” study of the City Hall and the functions within.
City Design 6
Use Case Component Functions Desiredor Needed
Electronic
Funds
Employees Pay
Category
1) Weekly tracking table.
2) Bi-Weekly tracking table.
3) Monthly tracking table.
Fuels Payments
Category
Variable monthly fuel payment for city vehicles
tracking table.
Administration Funds Monthly administrative costs tracking table
Operational Funds
Category
Bills receivable and funds payable.
Elect. Funds
Mngmt.
State Direct deposits from state for reimbursements
County Direct deposits from county for reimbursements
LGIP Investments Direct deposits from LGIP investments
Billing Sewer Billing Initial Connection fee and flat rate = $10 and $60
Water Billing Initial Connection fee and flat rate = $10 and $60
New Water/Sewer
Connections
Depends on hookup being new connection
($6,000) or existing connection re-hook ($10)
City/Committee
Projects
Municipal Planning
Commission
Create data base for minutes and quick search
directory
Geographical
Mapping
Mapping Search
Directory
Utilize map embedded with city lines with section
and location searchSewer Line Mapping Database with streets and line positioning’s.
Water Line Mapping Database with streets and line positioning’s.
Cash
Management
Cash Receivable 1) Traffic Tickets
2) Sewer & water
3) Business License,
4) Community Center Rental, utility taxes,
5) Miscellaneous
Figure (2-1)
Vision Statement
The vision statement, which is addressed in figure 2.2 represents the vision of the City
Hall and the overall workable structure being desired form the present state. It can also be known
as the high use case objective. As part of the project Development Company or contractor, it is
your primary responsibility to insert this analytical study at the very beginning as it will dictate
the time needed and areas to break down while development is in its life cycle. Party of this
City Design 7
vision is the company realizing the faults in the current system and applying them to the new
vision expectancy.
Figure (2-2)
Contractor
Design &
Integration
City Hall Vision
Mediate with
customer Strengths,
Weaknesses,
Opportunities,
Threats
Preparation
Evaluate old
verses new and
establish Vision
with proposed
Gather
ideals from
Design & Development
ProcessSte
ps
Outputs
Transfer
ideas into
Revise
initial theme
with City
Material for
first draft
Initial
Vision
Working
Statement
Review
themes with
Review
themes with
Create
shortlist for
discussion
Suggestions
for revision
First draft
for Vision
Communicate
final version to
City Hall
Application
Develop road
map, blueprint
and plan
Review and
refresh Vision
City Design 8

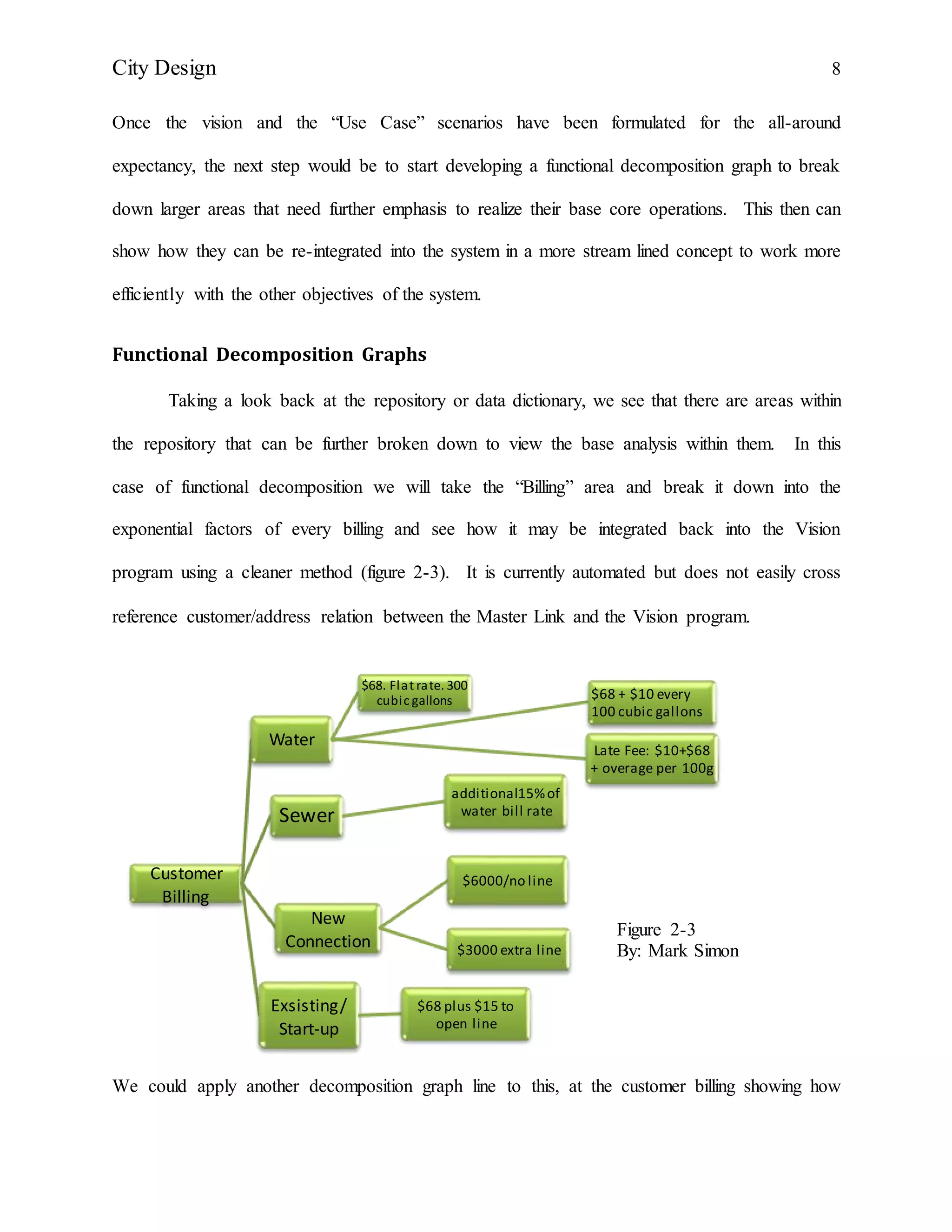

Customer
Billing
Water
$68 + $10 every
100 cubic gallons
$68. Flat rate. 300
cubic gallons
Late Fee: $10+$68
+ overage per 100g
Sewer
additional15%of
water bill rate
New
Connection
$6000/no line
$3000 extra line
Exsisting/
Start-up
$68 plus $15 to
open line
Once the vision and the “Use Case” scenarios have been formulated for the all-around
expectancy, the next step would be to start developing a functional decomposition graph to break
down larger areas that need further emphasis to realize their base core operations. This then can
show how they can be re-integrated into the system in a more stream lined concept to work more
efficiently with the other objectives of the system.
Functional Decomposition Graphs
Taking a look back at the repository or data dictionary, we see that there are areas within
the repository that can be further broken down to view the base analysis within them. In this
case of functional decomposition we will take the “Billing” area and break it down into the
exponential factors of every billing and see how it may be integrated back into the Vision
program using a cleaner method (figure 2-3). It is currently automated but does not easily cross
reference customer/address relation between the Master Link and the Vision program.
We could apply another decomposition graph line to this, at the customer billing showing how
Figure 2-3
By: Mark Simon
City Design 9
the Master-Link program hooks to the customer billing and relays the information from the city
area field gathering. It would better relate to the full structure of the decomposition. All-in-all
decomposition is an intrinsic part of analyzing the programs fully to see how they and the user
utilize it all to perform proper data and everyday functions.
Data Flow Diagram
The data flow diagram (Figure 2-4), as seen above is the function of data being
downloaded or “input” into the system to begin a function within that very system. The billing
portion of the data dictionary has been able to be worked into the flowchart to see exactly what
happens from beginning to end or output. This will be used as a preliminary step to create and
Vision App
Interconnect
w ith Vision
Data dow load
City Hall/ City
ClerkDow nload
Water Sew er
monthly use
to computer
Cycle
information
through
vision to
match
Separate to
accountsAdd base
$68.30 to all
accounts.
Add
Accounts
All Accounts
return input
Cycle rate of
function and
return billings
Account
Status
"Good". Paid
Data Flow Model Diagram
Master Link
Sew er/Water
Scan
Separate to
accountsAdd base
$68.30 to all
accounts.
.Add
Cycle
information
through
vision to
Separate to
accountsAdd 15%
additional of
w ater rate bill
depending on
Calculate Base
+Late + New
+percentage
Account
status
"Defunct".
Loop Limit 90
days till w ater
shut off
Generate
Customer
Billing
New
connectivity of
existing w ater
Cycle
information
through
vision to
Send to
customers
Terminate
Figure 2-
4
City Design 10
overview of the system. This can later be elaborated for both software and hardware functional
performance and base lining. We won’t be able to see if it can be sequential or run in parallel
function and neither can it show the proficiency or speed. It is only to follow the path of data
and see if it can integrate with new hardware with more proficiency and function. Sequential
diagrams run pretty much on the same analogy as you will see in the next section
A Sequence Diagram
In a sequence diagram, there are a few parameters to completing one of these. Keep in
mind that they must show external sources factoring in on the formulation. These external
factors must provide messages for the sequence to basically chew on and formulate. They
should show any indication of loops in the sequence that might have to be hammered out. When
it does present iterative information, return values may be shown from the previous calculations.
One other thing to keep in mind about the sequential diagram is that is used as a partial picture to
look at a particular scenario with in the “use case dictionary. This sequence can be utilized in
performing the function on any given area given that it has an actual performing input/out
function. Below is my drawing of the billing system in sequential form (Figure 2-5). This
model incorporates the need of the Sewer and Water. It applies the requested service, use of
service and the need for such a service. This is then all calculated in using the Master Link
information to input into the sequence to perform the needed operations to accurately perform
the billing for the city’s customers. All given prices are added in and there is also a loop area
showing a countdown to water shut off if a customer decides to forgo paying for the service over
90 days. It then spans back to conduct final calculations and send the billing to the customer via
mail or by electronic means. Most of the town’s people usually just go with the regular snail
City Design 11
mail in this case. Once we have accomplished the sequential diagram, it’s on to the next
storyboard.
Figure 2-
5
City Design 12
The Storyboard Graph
In this section, storyboards will be shown to understand the dynamics of their utilization.
Storyboards are primarily used to understand the requirements of how the user interfaces with
the system and the usability requirements associated with this system. The storyboard may
incorporate how the user interfaces with the system before it is prototyped, created, and
integrated. The story board is part of the boundary-class use cases. They rely on dynamic
relationships applying to links, associations and aggressions, as seen in (Figure2-6).
Each class of the boundary is in relation to a high-level representation for a presentation or
similar construct for the user interface. There are benefits to following the storyboard approach.
(Figure 2-
6)
City Design 13
First, it provides a trace to a specific use case, thereby providing a seamless integration with a
use-case-driven approach for software engineering. As a result, the user interface will be driven
by the use cases that the system is required to provide, and by the actors' (users) roles in, and
expectations of, these use cases. The graph provides a high-level view of dynamic window
relationships such as window navigation paths and other navigation paths between objects in the
user interface. It provides a way of capturing the requirements of each window or similar
construct in the user interface, by describing a corresponding boundary class. This is because
each boundary class defines responsibilities, attributes, relationships, etc. that have a
straightforward mapping to the corresponding construct in the user interface. Finally, It provides
a high-level view of static window relationships such as window containment hierarchies and
other associations between objects in the user interface (N.A., 2002). Overall, a story board
should clarify the use case itself, keep action statements brief, avoid sequences and nodes, and
be consistent in the used case.
Conclusion
In this segment, we have taken a look at the “use case” method and drawn out a
dictionary of requirements for City Hall. An overall vision statement was added to clarify the
overall requirements with guidance on its use. We then broke off the “Billing” segment and
broke it down into a Function decomposition table giving an expanded view of this process. The
“Billing” segment was generated through a flow diagram to see the steps working within the
system and how the system uses the system to generate the billings. It was then generated into a
sequential diagram that could be better understood for coding the sequence of events needed for
the computer to run this function. Finally, I presented a story board that integrated the overall
problem of the City Hall. It doesn’t run hand-in-hand with the billing but gives the reasoning for
City Design 14
the extreme latency of why the billing system cannot generate the need process to adequately
define and operate the function. Designing is always and intrinsic part to your project and will
save you time in the end.
.
City Design 15
Chapter 3 – Test & Quality Assurance
Introduction to SQA
Conducting software quality assurance (SQA) ensures a means for monitoring the
software design, programming processes and methods for ensuring quality of the product. This
is done by utilizing audits of the quality management system from which the software system
was created from. The audits are standardized by standards developed from ISO9000. SQA
covers the whole development process from software design, coding, code reviews, source code
control, and various management levels all the way to release management. The whole process
may include up to 28 different methods before the product is ready for operation by the
stakeholders, company, or users. In this section, we will be reviewing three areas of the process
to better inform the clients in the processes needed to ensure stability, life cycle, proficiency and
performance, mean time before failure and possible maintenance cycles. The areas being
covered in this section will look at unit testing, system testing and acceptance planning measures
to ensure customer satisfaction.
Unit Testing
Unit testing is paramount in the initial building of programming. It entails a lot of
documentation, running and repeating of each segment before the testing and programming can
move forward. Once the units have all been formed together, the project can move into the
systems testing. Unit testing encompasses the smallest part of reviewing an application. In unit
testing, a unit may be testing a function, a procedure, or individual program. The actual
programmers are those, who building the program bit by bit to ensure the performance of each
independent block of coding. Once these units of code are tested and found to be running error-

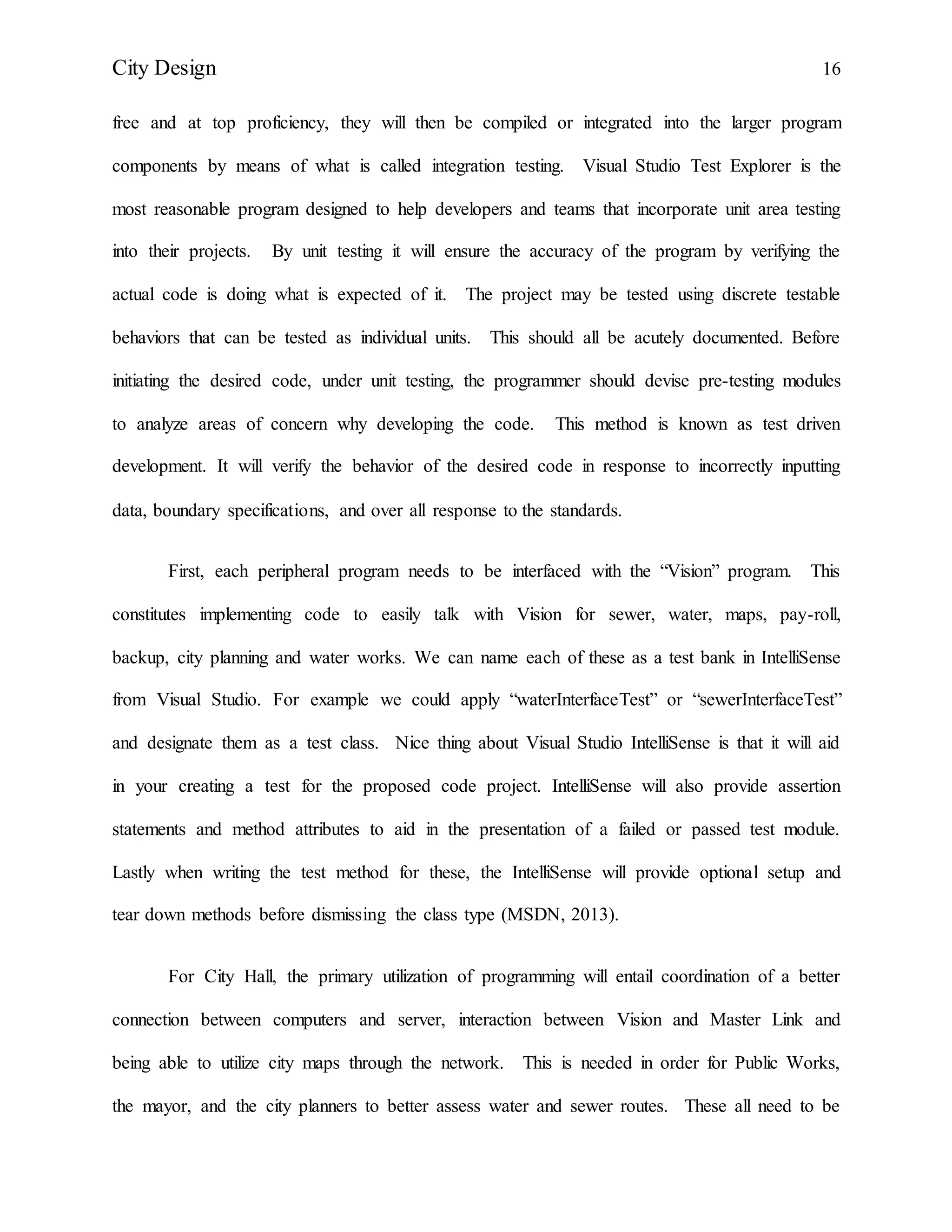

City Design 16
free and at top proficiency, they will then be compiled or integrated into the larger program
components by means of what is called integration testing. Visual Studio Test Explorer is the
most reasonable program designed to help developers and teams that incorporate unit area testing
into their projects. By unit testing it will ensure the accuracy of the program by verifying the
actual code is doing what is expected of it. The project may be tested using discrete testable
behaviors that can be tested as individual units. This should all be acutely documented. Before
initiating the desired code, under unit testing, the programmer should devise pre-testing modules
to analyze areas of concern why developing the code. This method is known as test driven
development. It will verify the behavior of the desired code in response to incorrectly inputting
data, boundary specifications, and over all response to the standards.
First, each peripheral program needs to be interfaced with the “Vision” program. This
constitutes implementing code to easily talk with Vision for sewer, water, maps, pay-roll,
backup, city planning and water works. We can name each of these as a test bank in IntelliSense
from Visual Studio. For example we could apply “waterInterfaceTest” or “sewerInterfaceTest”
and designate them as a test class. Nice thing about Visual Studio IntelliSense is that it will aid
in your creating a test for the proposed code project. IntelliSense will also provide assertion
statements and method attributes to aid in the presentation of a failed or passed test module.
Lastly when writing the test method for these, the IntelliSense will provide optional setup and
tear down methods before dismissing the class type (MSDN, 2013).
For City Hall, the primary utilization of programming will entail coordination of a better
connection between computers and server, interaction between Vision and Master Link and
being able to utilize city maps through the network. This is needed in order for Public Works,
the mayor, and the city planners to better assess water and sewer routes. These all need to be
City Design 17
integrated into a database server and able to interconnect between all three. Cross application
graphics user interfaces need to be established to perform a quick access to all areas using one
module. Further, an automated back-up program needs to be generated to glean new information
into the data bank with having to manually conduct the procedure weekly. Object oriented
security will be implemented ensuring only authorized personnel have access to billings with the
system for water and sew.
Systems Testing
Under the systems testing module, the systems personnel need to generate tests that will validate
booting, graphics user interface, performance, data transfer rates, vulnerabilities, imports and
exports of files, Bit-locker password protection, encryption functions, data retrieval, audio
synchronizing, network connections, drivers and much more. Since all of these programs run on
Windows, we will be testing most of the software to hardware and programming through the
Window’s Hardware Certification Kit (HCK). This kit certifies the devices for the hardware
portion of the programming. It will go through every requirement for the code to integrate into
the hardware. Windows supplies the HCK for Windows and Server 2008, with an HCK product
type test matrix to define the needed drivers, compatible devises and operating systems that may
be integrated using this style of system testing. Microsoft Developers Network also provides
supplemental test content and HCK filters, which enables the systems operator to help integrate
and pass the testing of the system (MSDN, 2013).
As the system is being tested for integration of software, hardware, drivers interconnect,
and program interfacing; it is important to keep a sequential track plan of the tests throughout the
project. Microsoft Developer Network has also created the perfect functional program for
City Design 18

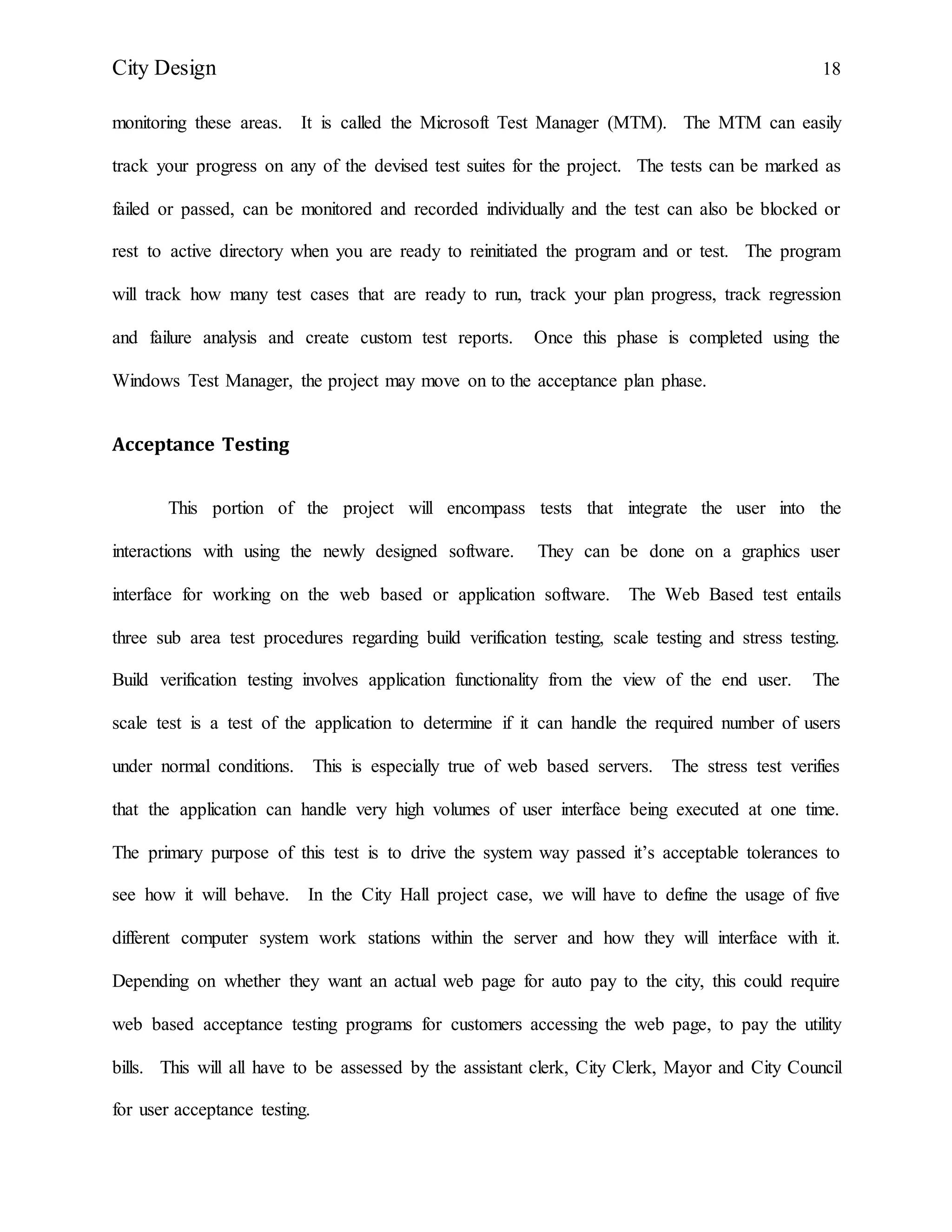

monitoring these areas. It is called the Microsoft Test Manager (MTM). The MTM can easily
track your progress on any of the devised test suites for the project. The tests can be marked as
failed or passed, can be monitored and recorded individually and the test can also be blocked or
rest to active directory when you are ready to reinitiated the program and or test. The program
will track how many test cases that are ready to run, track your plan progress, track regression
and failure analysis and create custom test reports. Once this phase is completed using the
Windows Test Manager, the project may move on to the acceptance plan phase.
Acceptance Testing
This portion of the project will encompass tests that integrate the user into the
interactions with using the newly designed software. They can be done on a graphics user
interface for working on the web based or application software. The Web Based test entails
three sub area test procedures regarding build verification testing, scale testing and stress testing.
Build verification testing involves application functionality from the view of the end user. The
scale test is a test of the application to determine if it can handle the required number of users
under normal conditions. This is especially true of web based servers. The stress test verifies
that the application can handle very high volumes of user interface being executed at one time.
The primary purpose of this test is to drive the system way passed it’s acceptable tolerances to
see how it will behave. In the City Hall project case, we will have to define the usage of five
different computer system work stations within the server and how they will interface with it.
Depending on whether they want an actual web page for auto pay to the city, this could require
web based acceptance testing programs for customers accessing the web page, to pay the utility
bills. This will all have to be assessed by the assistant clerk, City Clerk, Mayor and City Council
for user acceptance testing.
City Design 19
The end user has the primary responsibility for finding the bugs in the system once it has
advanced to this stage. The question is, how will you, as the project coordinator or manager
receive the need information for further project improvement? When I conducted projects in
the military, there were many ways to improve tweaking of our mission requirements. The big
one was running a real-time exercise and monitoring where the problem areas were coming up
short. Each of these would be documented in an after-action report. This way we knew the
shortfalls and could study them to rectify the short falls. It is the same with the client. As the
technician, it is your job to monitor the progress of the program under real-time use. After the
real-time functions have been established in the (wet-run) scenario, there will be bugs and other
things that show up. These should all be documented by either the user, of the technician as the
sequence progresses. This can then be re-base lined, bugs and loops removed, and the process
started again for further disruptions, performance inadequacies, and bugs (MSDN, 2013). Once
the parameters have been set with the above three sections, as the coordinator, it is imperative to
flow a quality assurance program.
Quality Assurance Program
Even from the very start, quality assurance is the backbone of any given project.
Even though testing is being conducted throughout the whole process, it’s the coordinator’s
responsibility to ensure every step is being carried out, as designated throughout the plan. But
how can every step be audited for success? It’s quite easy. Just as we have testers, who are in
the actual testing phases, there should be personnel conducting over site of the phases to ensure
those tests are being conducted accurately and effectively with no cutting of corners. This entails
the use of audits throughout the process. They can be done manually by an oversight coordinator
or by some piece of qualitative monitoring software. The biggest quality assurance comes from
City Design 20
the very clients or customers you are building the system for. They expect that software and
hardware to have reliability, maintainability, manageability, resource efficiency, testability, and
be failure free from defects. In order to have baseline objectives of the software being developed,
there should be objective measurements, software qualitative attributes, and process and software
metrics should be in place. The visual Basic program also has quality assessment tools for
monitoring the quality of the product being constructed. FX-Cop, VS2012Code Analysis, Early
Warning and freeware like Source Monitor are just a few of the audit programs ensuring quality
of the processed product. FX-Cop is a code analyzer that monitors .NET framework managed
assemblies for conformance to the design guidelines. It uses parsing, reflection and calligraphic
analysis to inspect assembly language. Early Warning comes enhanced with VB.NET 2012,
which is a back ground compiler for catching runtime errors when the coder is writing the script.
VS Code Analysis does pretty much the same thing as FX-Cop. This is run in the team version
of Visual Studio 2012. Even a freeware program like Source Monitor is good for monitoring
source code and configures calculations of some metrics. It literally saves checkpoints for
comparison during your projects so that they can be compared to the final script areas. There are
many others for quality assurance. These are just a couple, which monitor certain steps along the
pathway. Others are even more reliable, like “Orcas” and “N-Depend”. These two quality
assurance programs do many audits throughout the task but are fee-based and might not query
well within the budget.
Conclusion
In this section we have covered the unit testing, systems testing, acceptance testing and
quality assurance testing. Throughout the SDLC there are many steps generated before the finish
product is ready for the customer or client. As a Systems Analyst and Designer, each of these
City Design 21
test areas is paramount to the accomplishment of a proper project tasking. You, as the designer
have the ability to follow each of the steps generated or try an circumvent a procedure or two.
However, quality assurance stems itself across the expanse of the project. Therefore, a shabby
project is not feasible. There are too many cyber eyes watching every process.
City Design 22
Chapter 4 – Development Strategies& Acquisition
Introduction
Now that we have developed a design approach using graphs, flowcharts, and conducting
initial assessments, it is time to look at the broad spectrum of network hardware needed within
the system. As was stated in chapter one of this review, the City Hall is composed of three work
areas or stations and is utilizing one of the computers as a workstation and server. Any Network
administrator would most likely be pulling their hair our about now having to create data bases
and operationally function water, sewer, billing, payroll, street maps for water and sewer and a
myriad of other components within this system. This is where we need to present the potential of
system overload and how to prevent it. There are a few options available to alleviate the present
problem within the City Hall under this venue. The city could purchase their own hardware and
software, have it all outsourced to a network vendor, or conduct a combination of both. In this
section we will present an overview of these areas in order to aid the customer in the best overall
choice. There are many factors involved that look at the advantages and disadvantages of all
three concepts. Most businesses to day like the sound of owning their own, but is it really cost
effect?
In-Sourcing
All too often a lot of businesses think that if they are able to maintain their own network systems
and they will also save a smoking bundle of money by doing so. Depending on the size of the
business and the depth of the purse strings, this could be a viable answer. Internal control of a
system may be very beneficial, if the system is capable of being managed, maintained, and
outweighs the overhead costs that comes with the system. Most of the time, small companies
City Design 23
and businesses believe a computer network can run forever, as it is small and doesn’t need much
to keep the network operational. This is a huge fallacy as systems need daily upkeep and
monitoring for vulnerabilities, attacks and expansion of the system. This can be properly
conducted if the business or company has sufficiently trained personnel capable of handling the
business skills, resources and equipment needed to do the job through network management
skills. Luckily, employees should already understand how the system works and this can be
beneficial to internal cost. On the other hand, if the employees are under skilled or
inexperienced in network management, this may be seen as an additional work tasking on the
employee. It may cause them to be stressed out and work less efficiently in their present
responsibilities (Finch, 2014). Cost is the main driving factor for insourcing verses outsourcing.
Most network systems and software have between a three and five year life cycle. I have seen
systems go for a lot longer, but if the proficiency of the system is paramount, and the business or
company is stuck on internal sourcing; the best approach would be to budget for a new system
every five years. Most companies fail to peer into their crystal ball and see an antiquated system
sitting in front of them with no budget forecast. This has become a divergent, systemic,
troubling affect throughout a lot of companies. What is even more frightening is the
implementation of Federal and State Laws emphasizing the higher standards of securities to be
met. Under Washington (RCW) Revised Codes of Washington 19.255.010, state, county and
municipal areas are required to implement strict security prevention and vulnerability tactics to
ensure the safety of personal information for customers within the system. Federal laws execute
the oversight to ensure these laws are enforced by the municipalities. They are “The Sarbanes-
Oxley Act of 2002” (SOX) and the Gramm-Leach-Bliley Act (GLBA), which ensures the safety
of customer’s information from impenetrable means. Failing to do this can result in hefty fines
City Design 24
and law suits from Federal, state and customer venues. City Hall already has all the main
components’ needed to maintain a functional system, minus a server to make it all run smoothly
and efficiently. By current estimates, if the City Hall were to invest in a server system and
hardware firewall at the subscriber line, the performance and security of the overall network
would be within legal as well as efficiency means. For City Hall’s needs, a Dell PowerEdge
T420 would be the ultimate in performance and streamlining for the City Hall. Base price on
one of these is around $1300, but after all required additions are added for a RAID 5 backup and
connections are made throughout the office, the final price could be around $5000. Since the
town is also a municipality, it is authorized to shop for hardware in the Western States
Contracting Alliance for all government municipalities. This is a placed specifically set up for
municipalities to purchase insource networks for their towns. Inevitably, this server and firewall
could also be leased as well and they could still have their permanent workstations they now use.
Insourcing and Outsourcing Combined
Various companies and businesses have found that it is easier to outsource portions of
their network systems, since it’s easier to have professional help and technical assistance 24
hours a day, seven days a week. Most software venders assist in making this happen.
Companies still want control of their hardware make ups, but are realizing it may be cheaper to
outsource software functions to an outside vender. The same can be said for the hardware
application as well. There are downfalls to this escapade in that the software vendors will sale
software to anyone and will give prompt assistance, but they are there to sale software. They
don’t care if the network system is out of date, or isn’t up to performance standards for their
typical software. In their minds, they will make it work as they want the almighty business and
dollar. It’s not exactly the way to do business, but a reputable software vendor will give the
City Design 25
customer the appropriate information concerning hardware to software use and acceptability.
This has been seen by the author on multiple occasions. When partial systems software has
been outsourced, the response of most companies towards outsourcing has brought forth negative
responses. The primary reasons for going back to insourcing entails the lack of quality vender
service, the subject-matter expert doesn’t know squat, poor business communications, and
account management and affordability (McCafferty, 2013). The tables can also be turned using
outsourced hardware and insourced software. Dell and (HP) Hewlett-Packard are both prime
examples of outsourcing that the business owner, company, or organization may rack up a
contract with to enhance their networking experience. Both of these companies will come out,
suggest what you might need for your facilities and write up a contract for total Systems
Development Life Cycle of the hardware. You can apply your own software needs or use
whatever may be provided by the vender to interface all the components. The advantages of
having someone contracting your hardware is that if anything goes awry, its 24 hours a day,
seven days a week, 365 days a year response time, or so they say. The downside to the
outsourcing and insourcing is that when these companies do come and assess the needed
abilities, they may take from 24 to 43 weeks to get it all planned together and operational. This
brings us to the last card in the pile.
Outsourcing
Outsourcing can have benefits but it is also a snake pit of downfalls as well. Some will
tell you that it is the greatest thing in the world. Contact with your venders any hour of the day,
quick response time to everyday and catastrophic failures to a system with plans for easy
backups. Vendors will say that the cost of leasing their equipment far outweighs the cost of
system life cycle and budgeting internally. It also gives the company, business and users ample
City Design 26
time to renegotiate feasible terms for upgrades, so the users will never be left behind in the
digital explosion age. The company also doesn’t have to worry about budgeting for upgrades
every three to five years. It’s now just a rental agreement with one easy, low, monthly
PAYMENT! What they don’t tell you is how it is hard to work with diversities of the user and
the IT vendors, who are not there to monitor system reliability, accessibility, and serviced ability
of the systems, which are required constantly. Many corporations have seen an influx in going
back to insourcing, as outsourcing opens a big cataclysmic channel between vendor and users.
The response times are poor at best, they can never resolve interface issues, and there might be a
cultural wedge between those who service and those who use the equipment. I know most
people have been on the phone with someone from India, fighting about a bill, or credit card or
something of that nature. Imagine having a cultural dialect so strong that it is impossibly
understandable and they are trying to explain the functionality of the server so you can get it
back on line. Most people are on fire around their collar by the end of the phone call and
ultimately the problem was never resolved. Software is one of the other areas where everyone is
renting it for a fee versus buying it. But it can really be financially smart, or so they (the
venders) say. For example, Microsoft Corporation sells its’ Office 365 for $99 a year and that is
for a single user. Multiple licenses have discounts applied. All you documents can now be sent
to THE CLOUD!!!! Ok…so where is this cloud at? Have you ever seen it? Most people
haven’t. It is actually a huge 12 block by five block server system located somewhere in the
United States and that is where all your information is backed up data to. Just think, all this data,
on the cloud all rests with your little own rental. However, you can buy the full version for
$399.00. It doesn’t necessarily have a cloud attached though. What is funny about buying retail
is that the life expectancy of Office 365 is about 4 years anyway. So…do you rent the software
City Design 27
form a vender through outsourcing or do you just buy and own it? At least by buying it, the
customer is able to keep it a while longer before moving on. They just won’t get the updated
advantages of rental software and the almighty cloud service. The choice to outsource ultimately
falls with the customer. In most instances, outsourcing may be beneficial to a business, if it is
small enough and a fair price can be established. As the business grows into a bigger
corporation, it is then that the company needs to review the necessity of doing an in-house
approach towards IT rather than letting it be consummated to outside sources. Overall, size is a
factor in the final outcome.
Conclusion
In this section, we have addressed three ways of integrating a network into the business,
company or corporation. All three ways of integrating a new system, can have advantages over
the others, as well as pitfalls. Finances play a key role as well as the ability for the company’s
ability to work with the diversities of outside vendors. Insourcing puts a little more stress on
employees as they have to step up to be something they never knew existed. WALLA!!!…you
are now a technician in IT. Some employees don’t take kindly to that new job title and prestige.
Maybe it just takes a mix of outsourcing and insourcing to make it all come together. Whatever
the case might be, the owner of the company, business or corporation has the final vote as they
are the one’s footing the bill.
City Design 28
Chapter 5 – System Integration & Deployment
Introduction
Now that the accumulation of the phases have been addressed, it is time to go over the
find details of the overall working break down (WBD) structure to ensure no steps to the project
are missed . In this chapter, we will incorporate the graphs needed to verify our overall WBD
structure is being followed. This will incorporate the preliminary analysis, systems analysis and
requirements definition, systems design, actual planned development, integration and testing,
acceptance, installation, deployment and finally operational support and maintenance. These are
all important aspects as even if one procedure is missed, it can cause stoppage and detrimental
effects in the overall accomplishment of the project being pursued.
The Work Breakdown Structure
All too often when a project is underway, some companies don’t take the time to review
the progression of the project. To nullify this problem, one of the paramount structures needing
addressed is the work breakdown
structure to ensure nothing is
overlooked. It’s like putting the cart
before the horse in laymen’s terms.
On the next page is a graphing of the
City Hall break down to ensure
everything is followed according to
plan. Each area must be fully covered
before moving on to the next scope in the project. (Figure 5-1) shows the overall steps to the
Fig 5-1
City Design 29
WBD and (Figure 5-2) does a more detailed scope of each of the steps. When the systems analyst
has completed the initial assessment of the project, it will then be easily managed using this
diagram to splice the project into manageable segments.
The WBS is also important for cost assessments from bottom on up to the hierarchy in the
executive branches and details possible cost overruns to keep the project on line without the
additional expenditures. The WBD also monitors potential risks within the project that precludes
potential break down from occurring within early segments of the project and causing a ripple
effect later on down the road. The break down risks can be tracked and reviewed as the project
proceeds. These assist in the communication interconnect within the segments of the project.
Thus, it prevents further work stoppages from occurring during the project progression. Subject
City Hall Project
2. Requirements 1. Design 4. Construction 3. Testing
1. Product
Investigation
2. Product
Survey
3. Assess Product
Serviceability
1. Concept
Design
2. Final Design
1. Purchase
Materials
2. Build System
1.Test
Functionality
a. Detailed
Design
b. Drawings
c. Design Review
and Approval
b. Mark Out
Dimensions
a. Routine
Testing
c. Install
Infrastructure
a. Install
Media
Connections
b. Random
Inspections
Fig 5-2
City Design 30
matter experts (SME) should be directly involved during the analysis phase as they bring
expertise from other projects that could be instrumental in solving certain problems within the
current project. To the left is a good example of how a work break down should look step-by-
step. From initial planning all the way
to the final product, everything is
emphasized to ensure proper cost
effectiveness with a fully functional
product at the end. A work structure
break down graph can also be applied to
ensure clarity within each hierarchical
area (University of Wisconsin, 2006).
.
1 Initiate Project
1.1 Develop Project Manual
1.1.1 Define Scope
1.1.2 Define Requirements
1.1.3 Identify High-Level Roles
1.1.4 Develop High-Level Budget
1.1.5 Identify High-Level Control Strategies
1.1.6 Finalize Manual and Gain Approvals
1.1.6.1 Consolidate and Publish Project Charter
1.1.6.2 Hold Review Meeting
1.1.6.3 Revise Project Manual
1.1.6.4 Gain approvals
2 Plan Project
2.1 Develop Work Plan
2.1.1 Develop Work Breakdown Structure
2.1.2 Develop Project Staffing Plan
2.1.3 Develop Project Schedule
2.1.4 Develop Project Budget
2.2 Develop Project Control Plan
2.2.1 Develop Communication Plan
2.2.2 Develop Quality Management Plan
2.3 Finalize Project Plan and Gain Approvals
3 Execute and Control Project
3.1 Design Framework
3.1.1 Define framework stages and activities
3.1.2 Design framework content formats
3.1.3 Design web framework delivery tool
3.2 Build the Framework
3.2.1 Write the framework content
3.2.2 Review framework content for quality
3.2.3 Build web tool prototype
3.3 Test the Framework
3.3.1 Test usability of web tool
3.3.2 Test usability of content
3.3.3 Adjust framework based on user feedback
3.4 Implement Framework
3.4.1 Move framework to production environment
3.4.2 Announce availability of framework
4 Close the Project
4.1 Conduct Post-Project Review
Figure 5 – 3
Work Breakdown Structure Outline
PROJECT NAME
1 Activity
1.1 Task
1.1.1 Sub-Task
2 Activity
2.1 Task
2.1.1 Sub-task
2.1.2 Sub-Task
2.2 Task
2.2.1 Sub-Task
2.2.2 Sub-Task
2.2.3 Sub-Task
3 Activity
3.1 Task
3.1.1 Sub-Task
3.1.2 Sub-Task
3.2 Task
3.2.1 Sub-Task
3.2.2 Sub-Task
3.2.3 Sub-Task
Figure 5-4
City Design 31
Conclusion
Ultimately, we want to ensure that all steps are taken to ensure all phases of the project
are completed on time, within budget and what is considered favorable for the business and
customer. The only way of accomplishing this is through the use a coordinated work break
down to ensure conformity and consistency throughout the project. It is important to keep all
parties in the loop throughout the whole process so that work stoppages and expenditure over
runs, due to stoppages, don’t end up eating the customer’s huge dream into a pile of
uncoordinated night mares. Once it is all done and in, the customer will have a system they can
be proud of and the project company will still have the reputation needed to address another
project.
References
Finch, C. (2014, May 21). Advantages & Disadvantages of Insourcing. Retrieved Sep 10, 2014,
from http://www.ehow.com/info_10015686_advantages-disadvantages-insourcing.html
McCafferty, D. (2013, May 13). Ten Considerations for CIOs Seeking to Insource. Retrieved
Sep 11, 2014, from The Voice of the CIO Community: http://www.cioinsight.com/it-
services/outsourcing/slideshows/ten-considerations-for-cios-seeking-to-insource-10/
MSDN. (2013). Unti Test Basics. Retrieved Sep 04, 2014, from http://msdn.microsoft.com:
http://msdn.microsoft.com/en-us/library/ff798502.aspx
N.A., R. S. (2002, May 25). Guidelines: Use-Case Storyboard, 1.1. (R. S. Corporation,
Producer) Retrieved Aug 29, 2104, from sce.uhcl.edu:
http://sce.uhcl.edu/helm/rationalunifiedprocess/process/modguide/md_ucstb.htm
University of Wisconsin. (2006, Feb 01). Stage 3: Plan the Project, ver 1.0. Retrieved Sep 16,
2014, from Do IT Project Manager Advisor: http://www.pma.doit.wisc.edu/plan/2-
1/print.html
Vision Software. (2014). Computer Sytem Requirements, 1. (Insight Software) Retrieved Aug 22,
2014, from My Vision Express: http://www.myvisionexpress.com/computer-
requirements/

More Related Content

Viewers also liked

City Halls of Germany
City Halls of GermanyCity Halls of Germany
City Halls of GermanyDoctorSequoia

Performance-based Design Considerations for Tsunami Vertical Evacuation Build...
Performance-based Design Considerations for Tsunami Vertical Evacuation Build...Performance-based Design Considerations for Tsunami Vertical Evacuation Build...
Performance-based Design Considerations for Tsunami Vertical Evacuation Build...EERI

Mayor's Office of New Urban Mechanics
Mayor's Office of New Urban MechanicsMayor's Office of New Urban Mechanics
Mayor's Office of New Urban MechanicsBoston City Hall

STS Thesis by Hall 2015
STS Thesis by Hall 2015STS Thesis by Hall 2015
STS Thesis by Hall 2015Hank Lydick

City Hall Action 19 11 09
City Hall Action 19 11 09City Hall Action 19 11 09
City Hall Action 19 11 09citizenschools

London History
London  HistoryLondon  History
London Historyhlwmedia

Chandigarh - planning and its transformation
Chandigarh - planning and its transformation Chandigarh - planning and its transformation
Chandigarh - planning and its transformation Gagan Tanwar

Thesis presentation 2013
Thesis presentation 2013Thesis presentation 2013
Thesis presentation 2013ROHIT SINGLA

ARCHITECTURAL STANDARDS
ARCHITECTURAL STANDARDSARCHITECTURAL STANDARDS
ARCHITECTURAL STANDARDSstuti31

Auditorium Literature Study & Design Considerations
Auditorium Literature Study & Design ConsiderationsAuditorium Literature Study & Design Considerations
Auditorium Literature Study & Design ConsiderationsVartika Sharma


Viewers also liked (20)

norman foster
norman fosternorman foster
norman foster

Norman foster
Norman foster Norman foster
Norman foster

Norman Foster
Norman FosterNorman Foster
Norman Foster

City Halls of Germany
City Halls of GermanyCity Halls of Germany
City Halls of Germany

Performance-based Design Considerations for Tsunami Vertical Evacuation Build...
Performance-based Design Considerations for Tsunami Vertical Evacuation Build...Performance-based Design Considerations for Tsunami Vertical Evacuation Build...
Performance-based Design Considerations for Tsunami Vertical Evacuation Build...

Monum overview new
Monum overview   newMonum overview   new
Monum overview new

Mayor's Office of New Urban Mechanics
Mayor's Office of New Urban MechanicsMayor's Office of New Urban Mechanics
Mayor's Office of New Urban Mechanics

STS Thesis by Hall 2015
STS Thesis by Hall 2015STS Thesis by Hall 2015
STS Thesis by Hall 2015

City Hall Action 19 11 09
City Hall Action 19 11 09City Hall Action 19 11 09
City Hall Action 19 11 09

Cell City
Cell CityCell City
Cell City

City Hall
City HallCity Hall
City Hall

London History
London  HistoryLondon  History
London History

Civic center
Civic centerCivic center
Civic center

Alvar alto
Alvar altoAlvar alto
Alvar alto

Chandigarh - planning and its transformation
Chandigarh - planning and its transformation Chandigarh - planning and its transformation
Chandigarh - planning and its transformation

Thesis presentation 2013
Thesis presentation 2013Thesis presentation 2013
Thesis presentation 2013

ARCHITECTURAL STANDARDS
ARCHITECTURAL STANDARDSARCHITECTURAL STANDARDS
ARCHITECTURAL STANDARDS

Shopping mall.
Shopping mall.Shopping mall.
Shopping mall.

Auditorium Literature Study & Design Considerations
Auditorium Literature Study & Design ConsiderationsAuditorium Literature Study & Design Considerations
Auditorium Literature Study & Design Considerations

Welcome to London
Welcome to LondonWelcome to London
Welcome to London


Similar to City Hall Network Project

Netezza fundamentals-for-developers
Netezza fundamentals-for-developersNetezza fundamentals-for-developers
Netezza fundamentals-for-developersTariq H. Khan

IRJET- ALPYNE - A Grid Computing Framework
IRJET- ALPYNE - A Grid Computing FrameworkIRJET- ALPYNE - A Grid Computing Framework
IRJET- ALPYNE - A Grid Computing FrameworkIRJET Journal

BI Project report
BI Project reportBI Project report
BI Project reporthlel

IRJET - The 3-Level Database Architectural Design for OLAP and OLTP Ops
IRJET - The 3-Level Database Architectural Design for OLAP and OLTP OpsIRJET - The 3-Level Database Architectural Design for OLAP and OLTP Ops
IRJET - The 3-Level Database Architectural Design for OLAP and OLTP OpsIRJET Journal

Mobile store management
Mobile store management Mobile store management
Mobile store management Rupendra Verma

miniprojectreport
miniprojectreportminiprojectreport
miniprojectreportsilpa mohan

Ibm db2 analytics accelerator high availability and disaster recovery
Ibm db2 analytics accelerator  high availability and disaster recoveryIbm db2 analytics accelerator  high availability and disaster recovery
Ibm db2 analytics accelerator high availability and disaster recoverybupbechanhgmail

Logistics Managment Automobile VB6
 Logistics Managment Automobile VB6 Logistics Managment Automobile VB6
Logistics Managment Automobile VB6jawad98

Simplify Data Center Monitoring With a Single-Pane View
Simplify Data Center Monitoring With a Single-Pane ViewSimplify Data Center Monitoring With a Single-Pane View
Simplify Data Center Monitoring With a Single-Pane ViewHitachi Vantara

Planning guide sap business suite 7 2013 landscape implementation
Planning guide sap business suite 7 2013  landscape implementationPlanning guide sap business suite 7 2013  landscape implementation
Planning guide sap business suite 7 2013 landscape implementationLeonardo Parpal Roig

W2 k3 ad_integration-how_to
W2 k3 ad_integration-how_toW2 k3 ad_integration-how_to
W2 k3 ad_integration-how_toMeka SriHari

Netezza fundamentals for developers
Netezza fundamentals for developersNetezza fundamentals for developers
Netezza fundamentals for developersBiju Nair

Data Engine for NoSQL - IBM Power Systems
Data Engine for NoSQL - IBM Power SystemsData Engine for NoSQL - IBM Power Systems
Data Engine for NoSQL - IBM Power SystemsthinkASG

Best Practices for the Most Impactful Oracle Database 18c and 19c Features
Best Practices for the Most Impactful Oracle Database 18c and 19c FeaturesBest Practices for the Most Impactful Oracle Database 18c and 19c Features
Best Practices for the Most Impactful Oracle Database 18c and 19c FeaturesMarkus Michalewicz

Tx2014 Feature and Highlights
Tx2014 Feature and Highlights Tx2014 Feature and Highlights
Tx2014 Feature and Highlights Heath Turner

Performance tuning in sap bi 7.0
Performance tuning in sap bi 7.0Performance tuning in sap bi 7.0
Performance tuning in sap bi 7.0gireesho


Similar to City Hall Network Project (20)

altowebWhitePaper
altowebWhitePaperaltowebWhitePaper
altowebWhitePaper

Netezza fundamentals-for-developers
Netezza fundamentals-for-developersNetezza fundamentals-for-developers
Netezza fundamentals-for-developers

Chaitanya_updated resume
Chaitanya_updated resumeChaitanya_updated resume
Chaitanya_updated resume

Chaitanya_updated resume
Chaitanya_updated resumeChaitanya_updated resume
Chaitanya_updated resume

IRJET- ALPYNE - A Grid Computing Framework
IRJET- ALPYNE - A Grid Computing FrameworkIRJET- ALPYNE - A Grid Computing Framework
IRJET- ALPYNE - A Grid Computing Framework

BI Project report
BI Project reportBI Project report
BI Project report

IRJET - The 3-Level Database Architectural Design for OLAP and OLTP Ops
IRJET - The 3-Level Database Architectural Design for OLAP and OLTP OpsIRJET - The 3-Level Database Architectural Design for OLAP and OLTP Ops
IRJET - The 3-Level Database Architectural Design for OLAP and OLTP Ops

Mobile store management
Mobile store management Mobile store management
Mobile store management

miniprojectreport
miniprojectreportminiprojectreport
miniprojectreport

Ibm db2 analytics accelerator high availability and disaster recovery
Ibm db2 analytics accelerator  high availability and disaster recoveryIbm db2 analytics accelerator  high availability and disaster recovery
Ibm db2 analytics accelerator high availability and disaster recovery

Logistics Managment Automobile VB6
 Logistics Managment Automobile VB6 Logistics Managment Automobile VB6
Logistics Managment Automobile VB6

Simplify Data Center Monitoring With a Single-Pane View
Simplify Data Center Monitoring With a Single-Pane ViewSimplify Data Center Monitoring With a Single-Pane View
Simplify Data Center Monitoring With a Single-Pane View

Planning guide sap business suite 7 2013 landscape implementation
Planning guide sap business suite 7 2013  landscape implementationPlanning guide sap business suite 7 2013  landscape implementation
Planning guide sap business suite 7 2013 landscape implementation

W2 k3 ad_integration-how_to
W2 k3 ad_integration-how_toW2 k3 ad_integration-how_to
W2 k3 ad_integration-how_to

Netezza fundamentals for developers
Netezza fundamentals for developersNetezza fundamentals for developers
Netezza fundamentals for developers

8. 9590 1-pb
8. 9590 1-pb8. 9590 1-pb
8. 9590 1-pb

Data Engine for NoSQL - IBM Power Systems
Data Engine for NoSQL - IBM Power SystemsData Engine for NoSQL - IBM Power Systems
Data Engine for NoSQL - IBM Power Systems

Best Practices for the Most Impactful Oracle Database 18c and 19c Features
Best Practices for the Most Impactful Oracle Database 18c and 19c FeaturesBest Practices for the Most Impactful Oracle Database 18c and 19c Features
Best Practices for the Most Impactful Oracle Database 18c and 19c Features

Tx2014 Feature and Highlights
Tx2014 Feature and Highlights Tx2014 Feature and Highlights
Tx2014 Feature and Highlights

Performance tuning in sap bi 7.0
Performance tuning in sap bi 7.0Performance tuning in sap bi 7.0
Performance tuning in sap bi 7.0


More from Mark Simon

Introduction To Programming IP5
Introduction To Programming IP5Introduction To Programming IP5
Introduction To Programming IP5Mark Simon

CSS-454 information Security Assurance CAPSTONE
CSS-454 information Security Assurance CAPSTONECSS-454 information Security Assurance CAPSTONE
CSS-454 information Security Assurance CAPSTONEMark Simon

IT-106 Pseudo-Coding Wk 5
IT-106 Pseudo-Coding Wk 5IT-106 Pseudo-Coding Wk 5
IT-106 Pseudo-Coding Wk 5Mark Simon

Discrete Math IP4 - Automata Theory
Discrete Math IP4 - Automata TheoryDiscrete Math IP4 - Automata Theory
Discrete Math IP4 - Automata TheoryMark Simon

Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical Trees
Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical TreesPhase 3 IP Discrete Mathematics - Vertexes & Hierarchical Trees
Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical TreesMark Simon

Discrete Mathematics - Matrices & Matrix IP2
Discrete Mathematics - Matrices & Matrix IP2Discrete Mathematics - Matrices & Matrix IP2
Discrete Mathematics - Matrices & Matrix IP2Mark Simon

ENG101- Week 5 Individual Project
ENG101- Week 5 Individual ProjectENG101- Week 5 Individual Project
ENG101- Week 5 Individual ProjectMark Simon

Mark Simon IT 245 Introduction to Network Management
Mark Simon IT 245 Introduction to Network ManagementMark Simon IT 245 Introduction to Network Management
Mark Simon IT 245 Introduction to Network ManagementMark Simon

Greenhouse Effect IP3
Greenhouse Effect IP3Greenhouse Effect IP3
Greenhouse Effect IP3Mark Simon

Materials, Semi-conductors and Micro-Chips
Materials, Semi-conductors and Micro-ChipsMaterials, Semi-conductors and Micro-Chips
Materials, Semi-conductors and Micro-ChipsMark Simon

What you eat phase 1
What you eat   phase 1What you eat   phase 1
What you eat phase 1Mark Simon

Ip 5 discrete mathematics
Ip 5 discrete mathematicsIp 5 discrete mathematics
Ip 5 discrete mathematicsMark Simon


More from Mark Simon (13)

Introduction To Programming IP5
Introduction To Programming IP5Introduction To Programming IP5
Introduction To Programming IP5

CSS-454 information Security Assurance CAPSTONE
CSS-454 information Security Assurance CAPSTONECSS-454 information Security Assurance CAPSTONE
CSS-454 information Security Assurance CAPSTONE

IT-106 Pseudo-Coding Wk 5
IT-106 Pseudo-Coding Wk 5IT-106 Pseudo-Coding Wk 5
IT-106 Pseudo-Coding Wk 5

Discrete Math IP4 - Automata Theory
Discrete Math IP4 - Automata TheoryDiscrete Math IP4 - Automata Theory
Discrete Math IP4 - Automata Theory

Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical Trees
Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical TreesPhase 3 IP Discrete Mathematics - Vertexes & Hierarchical Trees
Phase 3 IP Discrete Mathematics - Vertexes & Hierarchical Trees

Discrete Mathematics - Matrices & Matrix IP2
Discrete Mathematics - Matrices & Matrix IP2Discrete Mathematics - Matrices & Matrix IP2
Discrete Mathematics - Matrices & Matrix IP2

Phase 1 ip
Phase 1 ipPhase 1 ip
Phase 1 ip

ENG101- Week 5 Individual Project
ENG101- Week 5 Individual ProjectENG101- Week 5 Individual Project
ENG101- Week 5 Individual Project

Mark Simon IT 245 Introduction to Network Management
Mark Simon IT 245 Introduction to Network ManagementMark Simon IT 245 Introduction to Network Management
Mark Simon IT 245 Introduction to Network Management

Greenhouse Effect IP3
Greenhouse Effect IP3Greenhouse Effect IP3
Greenhouse Effect IP3

Materials, Semi-conductors and Micro-Chips
Materials, Semi-conductors and Micro-ChipsMaterials, Semi-conductors and Micro-Chips
Materials, Semi-conductors and Micro-Chips

What you eat phase 1
What you eat   phase 1What you eat   phase 1
What you eat phase 1

Ip 5 discrete mathematics
Ip 5 discrete mathematicsIp 5 discrete mathematics
Ip 5 discrete mathematics


Recently uploaded

Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365
Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365
Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 3652toLead Limited

The Codex of Business Writing Software for Real-World Solutions 2.pptx
The Codex of Business Writing Software for Real-World Solutions 2.pptxThe Codex of Business Writing Software for Real-World Solutions 2.pptx
The Codex of Business Writing Software for Real-World Solutions 2.pptxMalak Abu Hammad

08448380779 Call Girls In Diplomatic Enclave Women Seeking Men
08448380779 Call Girls In Diplomatic Enclave Women Seeking Men08448380779 Call Girls In Diplomatic Enclave Women Seeking Men
08448380779 Call Girls In Diplomatic Enclave Women Seeking MenDelhi Call girls

FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhi
FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | DelhiFULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhi
FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhisoniya singh

SQL Database Design For Developers at php[tek] 2024
SQL Database Design For Developers at php[tek] 2024SQL Database Design For Developers at php[tek] 2024
SQL Database Design For Developers at php[tek] 2024Scott Keck-Warren

08448380779 Call Girls In Civil Lines Women Seeking Men
08448380779 Call Girls In Civil Lines Women Seeking Men08448380779 Call Girls In Civil Lines Women Seeking Men
08448380779 Call Girls In Civil Lines Women Seeking MenDelhi Call girls

Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...
Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...
Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...Neo4j

Artificial intelligence in the post-deep learning era
Artificial intelligence in the post-deep learning eraArtificial intelligence in the post-deep learning era
Artificial intelligence in the post-deep learning eraDeakin University

Breaking the Kubernetes Kill Chain: Host Path Mount
Breaking the Kubernetes Kill Chain: Host Path MountBreaking the Kubernetes Kill Chain: Host Path Mount
Breaking the Kubernetes Kill Chain: Host Path MountPuma Security, LLC

Advanced Test Driven-Development @ php[tek] 2024
Advanced Test Driven-Development @ php[tek] 2024Advanced Test Driven-Development @ php[tek] 2024
Advanced Test Driven-Development @ php[tek] 2024Scott Keck-Warren

#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024BookNet Canada

WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure service
WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure serviceWhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure service
WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure servicePooja Nehwal

Maximizing Board Effectiveness 2024 Webinar.pptx
Maximizing Board Effectiveness 2024 Webinar.pptxMaximizing Board Effectiveness 2024 Webinar.pptx
Maximizing Board Effectiveness 2024 Webinar.pptxOnBoard

AI as an Interface for Commercial Buildings
AI as an Interface for Commercial BuildingsAI as an Interface for Commercial Buildings
AI as an Interface for Commercial BuildingsMemoori

Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024BookNet Canada

My Hashitalk Indonesia April 2024 Presentation
My Hashitalk Indonesia April 2024 PresentationMy Hashitalk Indonesia April 2024 Presentation
My Hashitalk Indonesia April 2024 PresentationRidwan Fadjar

SIEMENS: RAPUNZEL – A Tale About Knowledge Graph
SIEMENS: RAPUNZEL – A Tale About Knowledge GraphSIEMENS: RAPUNZEL – A Tale About Knowledge Graph
SIEMENS: RAPUNZEL – A Tale About Knowledge GraphNeo4j

Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your Budget
Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your BudgetHyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your Budget
Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your BudgetEnjoy Anytime

Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...
Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...
Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...shyamraj55


Recently uploaded (20)

Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365
Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365
Tech-Forward - Achieving Business Readiness For Copilot in Microsoft 365

The Codex of Business Writing Software for Real-World Solutions 2.pptx
The Codex of Business Writing Software for Real-World Solutions 2.pptxThe Codex of Business Writing Software for Real-World Solutions 2.pptx
The Codex of Business Writing Software for Real-World Solutions 2.pptx

08448380779 Call Girls In Diplomatic Enclave Women Seeking Men
08448380779 Call Girls In Diplomatic Enclave Women Seeking Men08448380779 Call Girls In Diplomatic Enclave Women Seeking Men
08448380779 Call Girls In Diplomatic Enclave Women Seeking Men

FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhi
FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | DelhiFULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhi
FULL ENJOY 🔝 8264348440 🔝 Call Girls in Diplomatic Enclave | Delhi

SQL Database Design For Developers at php[tek] 2024
SQL Database Design For Developers at php[tek] 2024SQL Database Design For Developers at php[tek] 2024
SQL Database Design For Developers at php[tek] 2024

08448380779 Call Girls In Civil Lines Women Seeking Men
08448380779 Call Girls In Civil Lines Women Seeking Men08448380779 Call Girls In Civil Lines Women Seeking Men
08448380779 Call Girls In Civil Lines Women Seeking Men

Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...
Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...
Neo4j - How KGs are shaping the future of Generative AI at AWS Summit London ...

Artificial intelligence in the post-deep learning era
Artificial intelligence in the post-deep learning eraArtificial intelligence in the post-deep learning era
Artificial intelligence in the post-deep learning era

Breaking the Kubernetes Kill Chain: Host Path Mount
Breaking the Kubernetes Kill Chain: Host Path MountBreaking the Kubernetes Kill Chain: Host Path Mount
Breaking the Kubernetes Kill Chain: Host Path Mount

Advanced Test Driven-Development @ php[tek] 2024
Advanced Test Driven-Development @ php[tek] 2024Advanced Test Driven-Development @ php[tek] 2024
Advanced Test Driven-Development @ php[tek] 2024

#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
#StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024

Vulnerability_Management_GRC_by Sohang Sengupta.pptx
Vulnerability_Management_GRC_by Sohang Sengupta.pptxVulnerability_Management_GRC_by Sohang Sengupta.pptx
Vulnerability_Management_GRC_by Sohang Sengupta.pptx

WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure service
WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure serviceWhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure service
WhatsApp 9892124323 ✓Call Girls In Kalyan ( Mumbai ) secure service

Maximizing Board Effectiveness 2024 Webinar.pptx
Maximizing Board Effectiveness 2024 Webinar.pptxMaximizing Board Effectiveness 2024 Webinar.pptx
Maximizing Board Effectiveness 2024 Webinar.pptx

AI as an Interface for Commercial Buildings
AI as an Interface for Commercial BuildingsAI as an Interface for Commercial Buildings
AI as an Interface for Commercial Buildings

Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024
Transcript: #StandardsGoals for 2024: What’s new for BISAC - Tech Forum 2024

My Hashitalk Indonesia April 2024 Presentation
My Hashitalk Indonesia April 2024 PresentationMy Hashitalk Indonesia April 2024 Presentation
My Hashitalk Indonesia April 2024 Presentation

SIEMENS: RAPUNZEL – A Tale About Knowledge Graph
SIEMENS: RAPUNZEL – A Tale About Knowledge GraphSIEMENS: RAPUNZEL – A Tale About Knowledge Graph
SIEMENS: RAPUNZEL – A Tale About Knowledge Graph

Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your Budget
Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your BudgetHyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your Budget
Hyderabad Call Girls Khairatabad ✨ 7001305949 ✨ Cheap Price Your Budget

Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...
Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...
Automating Business Process via MuleSoft Composer | Bangalore MuleSoft Meetup...


City Hall Network Project

  • 1. Mark L. Simon II Phase - 5 / Individual Assignment IP5 IT425-1403B-04 Systems Design, Analysis and Integration Professor: Ihssan Alkadi 17 September, 2014 Colorado Technical University City Hall - The Project Case Study
  • 2. City Design 1 Table of Contents Chapter 1 – SDLC Overview & Requirements............................................................................... 2 Executive Summary Analysis ..................................................................................................... 2 Preliminary Analysis/ Requirements/Current System Design .................................................... 3 Chapter (2) – Design & Development ............................................................................................ 5 Develop a Use Case..................................................................................................................... 5 Vision Statement ......................................................................................................................... 6 Functional Decomposition Graphs.............................................................................................. 8 Data Flow Diagram..................................................................................................................... 9 A Sequence Diagram................................................................................................................. 10 The Storyboard Graph............................................................................................................... 12 Conclusion................................................................................................................................. 13 Chapter 3 – Test & Quality Assurance ......................................................................................... 15 Introduction to SQA.................................................................................................................. 15 Unit Testing............................................................................................................................... 15 Systems Testing......................................................................................................................... 17 Acceptance Testing ................................................................................................................... 18 Conclusion................................................................................................................................. 20 Chapter 4 – Development Strategies & Acquisition..................................................................... 22 Introduction............................................................................................................................... 22 In-Sourcing................................................................................................................................ 22 Insourcing and Outsourcing Combined..................................................................................... 24 Outsourcing............................................................................................................................... 25 Conclusion................................................................................................................................. 27 Chapter 5 – System Integration & Deployment............................................................................ 28 Introduction............................................................................................................................... 28 The Work Breakdown Structure ............................................................................................... 28 Conclusion................................................................................................................................. 31
  • 3. City Design 2 MOSSYROCK CITY DESIGN Chapter 1 – SDLC Overview & Requirements Executive Summary Analysis The purpose of this design is to lay the needed overview and specifications for the local municipality geographically located with my home town. Between the City Hall and the Water Works facility, only the City Hall is presently working administrative issues with programs for the city. The water works facility does have a single computer and is not linked into the City Hall for electronic messaging, billings or other enterprise needs. The City Hall focuses on writing the monthly customer billings for water and sewer, conducting electronic and cash receivables/payables, geo-mapping for the Water Works facility and Mossyrock Planning Commission, and employee pay-rolls. The water/sewer data collection is conducted with a hand- held Master-Link to attain all the water and sewer readings. This device is then taken to City Hall and downloaded onto the single computer, currently being utilized as a server and workstation. They are presently using the “Vision program, which is mandated by the state for all municipalities, county and state. This program is written in the SQL language. Due to the program running on a desktop computer, the performance and functional ability of the program is extremely degraded when carrying out operational functions. This computer also holds all the data from the Master-Link and is slightly compatible with “Vision”. The computer has an external drive for data back-up but all back-up operations have to be conducted manually by the city clerk. The “Vision” program also tends to lose or misconfigure data if the computer is turned off. The “Vision” program is intended to run on a server type system for maximum
  • 4. City Design 3 efficiency where it is not presently being utilized. The current machine is presently utilizing an A8 (AMD) Advanced Micro Designs quad core processor with 6 Gig of memory to handle all cached information. Preliminary Analysis/ Requirements/Current System Design Currently, there are three computers in City Hall and one is being utilized as the server and work station. By assessing the base line requirements of the system, within the current state, the system is only rated at 30% of maximum efficiency. The “Vision” software company utilizes a schematics requirement (pdf) document to establish base line hardware requirements dependent upon the number of work stations in existence. In this report, it is recommended that all servers operating this software are highly recommend to run a server with Windows Small Business Server 2012, Intel-i5 enterprise processor, 8 Gig of DDR3 memory and additional SATA/HD drives in RAID 1 or 5 configuration, as a minimum. The server may be utilized, in its current configuration, to handle up to 5 functional workstations for smooth and proficient network operations. A single desktop running with this software is ONLY recommended if the computer is a self-contained system with no other nodes within a network. The software is not compatible with AMD or Cyrix type hardware systems and should use Intel exclusive reliant hardware. The “Vision” software has the abilities of interacting between cash management account, customer water and sewer billings and electronic funds management. It also, completes pay-roll functions for the city workers yet the system is constantly dropping data within these systems in “Vision”. An auto-back up is desired in the RAID (Random Array of Independent Disks), to be functionally installed within the Server. Currently, with no auto backup, the city clerk has to conduct this operation manually. The “Vision” technical support has not been able
  • 5. City Design 4 to circumvent these problem areas of data loss and automatic back up operations. A support patch may be applied to foster prevention of data loss and auto backup.
  • 6. City Design 5 Chapter (2) – Design & Development Develop a Use Case The purpose of this section is to better understand the scope of implementing an overall “case use” study of the overall City Hall system by looking at the general area of the system and sighting where each sub-system of the network is utilized. This may then be broken down into further sub categories as we progress. Once the “use case” study has been accomplished we will be able to incorporate the functional decomposition diagram portion. Even though functional decomposition diagrams do not show sequential events, they do show a descending hierarchical organization of the business functions that comprise the business operation. The functional decomposition diagrams main function is to simplify and break down complex business operations into manageable chunks. The decomposition function facilitates a better understanding of the business and hence is useful in being a good analysis and design type tool. Functional decomposition is instrumental in determining the functional solutions in the requirements documents. This decomposition function is intrinsic in breaking down larger or complex functions prior to developing a process flow diagram. Within the City Hall we know they have many operations running on a redundant and antiquated type computer network. The software running on these systems has already been purported as software that should be running on a bigger capacity network. So, why is this system not adequately standardized with matching hardware? This is where the functional decomposition will come to fruition. Let’s view the data dictionary/repository diagram below for an insight into a “use case” study of the City Hall and the functions within.
  • 7. City Design 6 Use Case Component Functions Desiredor Needed Electronic Funds Employees Pay Category 1) Weekly tracking table. 2) Bi-Weekly tracking table. 3) Monthly tracking table. Fuels Payments Category Variable monthly fuel payment for city vehicles tracking table. Administration Funds Monthly administrative costs tracking table Operational Funds Category Bills receivable and funds payable. Elect. Funds Mngmt. State Direct deposits from state for reimbursements County Direct deposits from county for reimbursements LGIP Investments Direct deposits from LGIP investments Billing Sewer Billing Initial Connection fee and flat rate = $10 and $60 Water Billing Initial Connection fee and flat rate = $10 and $60 New Water/Sewer Connections Depends on hookup being new connection ($6,000) or existing connection re-hook ($10) City/Committee Projects Municipal Planning Commission Create data base for minutes and quick search directory Geographical Mapping Mapping Search Directory Utilize map embedded with city lines with section and location searchSewer Line Mapping Database with streets and line positioning’s. Water Line Mapping Database with streets and line positioning’s. Cash Management Cash Receivable 1) Traffic Tickets 2) Sewer & water 3) Business License, 4) Community Center Rental, utility taxes, 5) Miscellaneous Figure (2-1) Vision Statement The vision statement, which is addressed in figure 2.2 represents the vision of the City Hall and the overall workable structure being desired form the present state. It can also be known as the high use case objective. As part of the project Development Company or contractor, it is your primary responsibility to insert this analytical study at the very beginning as it will dictate the time needed and areas to break down while development is in its life cycle. Party of this
  • 8. City Design 7 vision is the company realizing the faults in the current system and applying them to the new vision expectancy. Figure (2-2) Contractor Design & Integration City Hall Vision Mediate with customer Strengths, Weaknesses, Opportunities, Threats Preparation Evaluate old verses new and establish Vision with proposed Gather ideals from Design & Development ProcessSte ps Outputs Transfer ideas into Revise initial theme with City Material for first draft Initial Vision Working Statement Review themes with Review themes with Create shortlist for discussion Suggestions for revision First draft for Vision Communicate final version to City Hall Application Develop road map, blueprint and plan Review and refresh Vision
  • 9. City Design 8 Customer Billing Water $68 + $10 every 100 cubic gallons $68. Flat rate. 300 cubic gallons Late Fee: $10+$68 + overage per 100g Sewer additional15%of water bill rate New Connection $6000/no line $3000 extra line Exsisting/ Start-up $68 plus $15 to open line Once the vision and the “Use Case” scenarios have been formulated for the all-around expectancy, the next step would be to start developing a functional decomposition graph to break down larger areas that need further emphasis to realize their base core operations. This then can show how they can be re-integrated into the system in a more stream lined concept to work more efficiently with the other objectives of the system. Functional Decomposition Graphs Taking a look back at the repository or data dictionary, we see that there are areas within the repository that can be further broken down to view the base analysis within them. In this case of functional decomposition we will take the “Billing” area and break it down into the exponential factors of every billing and see how it may be integrated back into the Vision program using a cleaner method (figure 2-3). It is currently automated but does not easily cross reference customer/address relation between the Master Link and the Vision program. We could apply another decomposition graph line to this, at the customer billing showing how Figure 2-3 By: Mark Simon
  • 10. City Design 9 the Master-Link program hooks to the customer billing and relays the information from the city area field gathering. It would better relate to the full structure of the decomposition. All-in-all decomposition is an intrinsic part of analyzing the programs fully to see how they and the user utilize it all to perform proper data and everyday functions. Data Flow Diagram The data flow diagram (Figure 2-4), as seen above is the function of data being downloaded or “input” into the system to begin a function within that very system. The billing portion of the data dictionary has been able to be worked into the flowchart to see exactly what happens from beginning to end or output. This will be used as a preliminary step to create and Vision App Interconnect w ith Vision Data dow load City Hall/ City ClerkDow nload Water Sew er monthly use to computer Cycle information through vision to match Separate to accountsAdd base $68.30 to all accounts. Add Accounts All Accounts return input Cycle rate of function and return billings Account Status "Good". Paid Data Flow Model Diagram Master Link Sew er/Water Scan Separate to accountsAdd base $68.30 to all accounts. .Add Cycle information through vision to Separate to accountsAdd 15% additional of w ater rate bill depending on Calculate Base +Late + New +percentage Account status "Defunct". Loop Limit 90 days till w ater shut off Generate Customer Billing New connectivity of existing w ater Cycle information through vision to Send to customers Terminate Figure 2- 4
  • 11. City Design 10 overview of the system. This can later be elaborated for both software and hardware functional performance and base lining. We won’t be able to see if it can be sequential or run in parallel function and neither can it show the proficiency or speed. It is only to follow the path of data and see if it can integrate with new hardware with more proficiency and function. Sequential diagrams run pretty much on the same analogy as you will see in the next section A Sequence Diagram In a sequence diagram, there are a few parameters to completing one of these. Keep in mind that they must show external sources factoring in on the formulation. These external factors must provide messages for the sequence to basically chew on and formulate. They should show any indication of loops in the sequence that might have to be hammered out. When it does present iterative information, return values may be shown from the previous calculations. One other thing to keep in mind about the sequential diagram is that is used as a partial picture to look at a particular scenario with in the “use case dictionary. This sequence can be utilized in performing the function on any given area given that it has an actual performing input/out function. Below is my drawing of the billing system in sequential form (Figure 2-5). This model incorporates the need of the Sewer and Water. It applies the requested service, use of service and the need for such a service. This is then all calculated in using the Master Link information to input into the sequence to perform the needed operations to accurately perform the billing for the city’s customers. All given prices are added in and there is also a loop area showing a countdown to water shut off if a customer decides to forgo paying for the service over 90 days. It then spans back to conduct final calculations and send the billing to the customer via mail or by electronic means. Most of the town’s people usually just go with the regular snail
  • 12. City Design 11 mail in this case. Once we have accomplished the sequential diagram, it’s on to the next storyboard. Figure 2- 5
  • 13. City Design 12 The Storyboard Graph In this section, storyboards will be shown to understand the dynamics of their utilization. Storyboards are primarily used to understand the requirements of how the user interfaces with the system and the usability requirements associated with this system. The storyboard may incorporate how the user interfaces with the system before it is prototyped, created, and integrated. The story board is part of the boundary-class use cases. They rely on dynamic relationships applying to links, associations and aggressions, as seen in (Figure2-6). Each class of the boundary is in relation to a high-level representation for a presentation or similar construct for the user interface. There are benefits to following the storyboard approach. (Figure 2- 6)
  • 14. City Design 13 First, it provides a trace to a specific use case, thereby providing a seamless integration with a use-case-driven approach for software engineering. As a result, the user interface will be driven by the use cases that the system is required to provide, and by the actors' (users) roles in, and expectations of, these use cases. The graph provides a high-level view of dynamic window relationships such as window navigation paths and other navigation paths between objects in the user interface. It provides a way of capturing the requirements of each window or similar construct in the user interface, by describing a corresponding boundary class. This is because each boundary class defines responsibilities, attributes, relationships, etc. that have a straightforward mapping to the corresponding construct in the user interface. Finally, It provides a high-level view of static window relationships such as window containment hierarchies and other associations between objects in the user interface (N.A., 2002). Overall, a story board should clarify the use case itself, keep action statements brief, avoid sequences and nodes, and be consistent in the used case. Conclusion In this segment, we have taken a look at the “use case” method and drawn out a dictionary of requirements for City Hall. An overall vision statement was added to clarify the overall requirements with guidance on its use. We then broke off the “Billing” segment and broke it down into a Function decomposition table giving an expanded view of this process. The “Billing” segment was generated through a flow diagram to see the steps working within the system and how the system uses the system to generate the billings. It was then generated into a sequential diagram that could be better understood for coding the sequence of events needed for the computer to run this function. Finally, I presented a story board that integrated the overall problem of the City Hall. It doesn’t run hand-in-hand with the billing but gives the reasoning for
  • 15. City Design 14 the extreme latency of why the billing system cannot generate the need process to adequately define and operate the function. Designing is always and intrinsic part to your project and will save you time in the end. .
  • 16. City Design 15 Chapter 3 – Test & Quality Assurance Introduction to SQA Conducting software quality assurance (SQA) ensures a means for monitoring the software design, programming processes and methods for ensuring quality of the product. This is done by utilizing audits of the quality management system from which the software system was created from. The audits are standardized by standards developed from ISO9000. SQA covers the whole development process from software design, coding, code reviews, source code control, and various management levels all the way to release management. The whole process may include up to 28 different methods before the product is ready for operation by the stakeholders, company, or users. In this section, we will be reviewing three areas of the process to better inform the clients in the processes needed to ensure stability, life cycle, proficiency and performance, mean time before failure and possible maintenance cycles. The areas being covered in this section will look at unit testing, system testing and acceptance planning measures to ensure customer satisfaction. Unit Testing Unit testing is paramount in the initial building of programming. It entails a lot of documentation, running and repeating of each segment before the testing and programming can move forward. Once the units have all been formed together, the project can move into the systems testing. Unit testing encompasses the smallest part of reviewing an application. In unit testing, a unit may be testing a function, a procedure, or individual program. The actual programmers are those, who building the program bit by bit to ensure the performance of each independent block of coding. Once these units of code are tested and found to be running error-
  • 17. City Design 16 free and at top proficiency, they will then be compiled or integrated into the larger program components by means of what is called integration testing. Visual Studio Test Explorer is the most reasonable program designed to help developers and teams that incorporate unit area testing into their projects. By unit testing it will ensure the accuracy of the program by verifying the actual code is doing what is expected of it. The project may be tested using discrete testable behaviors that can be tested as individual units. This should all be acutely documented. Before initiating the desired code, under unit testing, the programmer should devise pre-testing modules to analyze areas of concern why developing the code. This method is known as test driven development. It will verify the behavior of the desired code in response to incorrectly inputting data, boundary specifications, and over all response to the standards. First, each peripheral program needs to be interfaced with the “Vision” program. This constitutes implementing code to easily talk with Vision for sewer, water, maps, pay-roll, backup, city planning and water works. We can name each of these as a test bank in IntelliSense from Visual Studio. For example we could apply “waterInterfaceTest” or “sewerInterfaceTest” and designate them as a test class. Nice thing about Visual Studio IntelliSense is that it will aid in your creating a test for the proposed code project. IntelliSense will also provide assertion statements and method attributes to aid in the presentation of a failed or passed test module. Lastly when writing the test method for these, the IntelliSense will provide optional setup and tear down methods before dismissing the class type (MSDN, 2013). For City Hall, the primary utilization of programming will entail coordination of a better connection between computers and server, interaction between Vision and Master Link and being able to utilize city maps through the network. This is needed in order for Public Works, the mayor, and the city planners to better assess water and sewer routes. These all need to be
  • 18. City Design 17 integrated into a database server and able to interconnect between all three. Cross application graphics user interfaces need to be established to perform a quick access to all areas using one module. Further, an automated back-up program needs to be generated to glean new information into the data bank with having to manually conduct the procedure weekly. Object oriented security will be implemented ensuring only authorized personnel have access to billings with the system for water and sew. Systems Testing Under the systems testing module, the systems personnel need to generate tests that will validate booting, graphics user interface, performance, data transfer rates, vulnerabilities, imports and exports of files, Bit-locker password protection, encryption functions, data retrieval, audio synchronizing, network connections, drivers and much more. Since all of these programs run on Windows, we will be testing most of the software to hardware and programming through the Window’s Hardware Certification Kit (HCK). This kit certifies the devices for the hardware portion of the programming. It will go through every requirement for the code to integrate into the hardware. Windows supplies the HCK for Windows and Server 2008, with an HCK product type test matrix to define the needed drivers, compatible devises and operating systems that may be integrated using this style of system testing. Microsoft Developers Network also provides supplemental test content and HCK filters, which enables the systems operator to help integrate and pass the testing of the system (MSDN, 2013). As the system is being tested for integration of software, hardware, drivers interconnect, and program interfacing; it is important to keep a sequential track plan of the tests throughout the project. Microsoft Developer Network has also created the perfect functional program for
  • 19. City Design 18 monitoring these areas. It is called the Microsoft Test Manager (MTM). The MTM can easily track your progress on any of the devised test suites for the project. The tests can be marked as failed or passed, can be monitored and recorded individually and the test can also be blocked or rest to active directory when you are ready to reinitiated the program and or test. The program will track how many test cases that are ready to run, track your plan progress, track regression and failure analysis and create custom test reports. Once this phase is completed using the Windows Test Manager, the project may move on to the acceptance plan phase. Acceptance Testing This portion of the project will encompass tests that integrate the user into the interactions with using the newly designed software. They can be done on a graphics user interface for working on the web based or application software. The Web Based test entails three sub area test procedures regarding build verification testing, scale testing and stress testing. Build verification testing involves application functionality from the view of the end user. The scale test is a test of the application to determine if it can handle the required number of users under normal conditions. This is especially true of web based servers. The stress test verifies that the application can handle very high volumes of user interface being executed at one time. The primary purpose of this test is to drive the system way passed it’s acceptable tolerances to see how it will behave. In the City Hall project case, we will have to define the usage of five different computer system work stations within the server and how they will interface with it. Depending on whether they want an actual web page for auto pay to the city, this could require web based acceptance testing programs for customers accessing the web page, to pay the utility bills. This will all have to be assessed by the assistant clerk, City Clerk, Mayor and City Council for user acceptance testing.
  • 20. City Design 19 The end user has the primary responsibility for finding the bugs in the system once it has advanced to this stage. The question is, how will you, as the project coordinator or manager receive the need information for further project improvement? When I conducted projects in the military, there were many ways to improve tweaking of our mission requirements. The big one was running a real-time exercise and monitoring where the problem areas were coming up short. Each of these would be documented in an after-action report. This way we knew the shortfalls and could study them to rectify the short falls. It is the same with the client. As the technician, it is your job to monitor the progress of the program under real-time use. After the real-time functions have been established in the (wet-run) scenario, there will be bugs and other things that show up. These should all be documented by either the user, of the technician as the sequence progresses. This can then be re-base lined, bugs and loops removed, and the process started again for further disruptions, performance inadequacies, and bugs (MSDN, 2013). Once the parameters have been set with the above three sections, as the coordinator, it is imperative to flow a quality assurance program. Quality Assurance Program Even from the very start, quality assurance is the backbone of any given project. Even though testing is being conducted throughout the whole process, it’s the coordinator’s responsibility to ensure every step is being carried out, as designated throughout the plan. But how can every step be audited for success? It’s quite easy. Just as we have testers, who are in the actual testing phases, there should be personnel conducting over site of the phases to ensure those tests are being conducted accurately and effectively with no cutting of corners. This entails the use of audits throughout the process. They can be done manually by an oversight coordinator or by some piece of qualitative monitoring software. The biggest quality assurance comes from
  • 21. City Design 20 the very clients or customers you are building the system for. They expect that software and hardware to have reliability, maintainability, manageability, resource efficiency, testability, and be failure free from defects. In order to have baseline objectives of the software being developed, there should be objective measurements, software qualitative attributes, and process and software metrics should be in place. The visual Basic program also has quality assessment tools for monitoring the quality of the product being constructed. FX-Cop, VS2012Code Analysis, Early Warning and freeware like Source Monitor are just a few of the audit programs ensuring quality of the processed product. FX-Cop is a code analyzer that monitors .NET framework managed assemblies for conformance to the design guidelines. It uses parsing, reflection and calligraphic analysis to inspect assembly language. Early Warning comes enhanced with VB.NET 2012, which is a back ground compiler for catching runtime errors when the coder is writing the script. VS Code Analysis does pretty much the same thing as FX-Cop. This is run in the team version of Visual Studio 2012. Even a freeware program like Source Monitor is good for monitoring source code and configures calculations of some metrics. It literally saves checkpoints for comparison during your projects so that they can be compared to the final script areas. There are many others for quality assurance. These are just a couple, which monitor certain steps along the pathway. Others are even more reliable, like “Orcas” and “N-Depend”. These two quality assurance programs do many audits throughout the task but are fee-based and might not query well within the budget. Conclusion In this section we have covered the unit testing, systems testing, acceptance testing and quality assurance testing. Throughout the SDLC there are many steps generated before the finish product is ready for the customer or client. As a Systems Analyst and Designer, each of these
  • 22. City Design 21 test areas is paramount to the accomplishment of a proper project tasking. You, as the designer have the ability to follow each of the steps generated or try an circumvent a procedure or two. However, quality assurance stems itself across the expanse of the project. Therefore, a shabby project is not feasible. There are too many cyber eyes watching every process.
  • 23. City Design 22 Chapter 4 – Development Strategies& Acquisition Introduction Now that we have developed a design approach using graphs, flowcharts, and conducting initial assessments, it is time to look at the broad spectrum of network hardware needed within the system. As was stated in chapter one of this review, the City Hall is composed of three work areas or stations and is utilizing one of the computers as a workstation and server. Any Network administrator would most likely be pulling their hair our about now having to create data bases and operationally function water, sewer, billing, payroll, street maps for water and sewer and a myriad of other components within this system. This is where we need to present the potential of system overload and how to prevent it. There are a few options available to alleviate the present problem within the City Hall under this venue. The city could purchase their own hardware and software, have it all outsourced to a network vendor, or conduct a combination of both. In this section we will present an overview of these areas in order to aid the customer in the best overall choice. There are many factors involved that look at the advantages and disadvantages of all three concepts. Most businesses to day like the sound of owning their own, but is it really cost effect? In-Sourcing All too often a lot of businesses think that if they are able to maintain their own network systems and they will also save a smoking bundle of money by doing so. Depending on the size of the business and the depth of the purse strings, this could be a viable answer. Internal control of a system may be very beneficial, if the system is capable of being managed, maintained, and outweighs the overhead costs that comes with the system. Most of the time, small companies
  • 24. City Design 23 and businesses believe a computer network can run forever, as it is small and doesn’t need much to keep the network operational. This is a huge fallacy as systems need daily upkeep and monitoring for vulnerabilities, attacks and expansion of the system. This can be properly conducted if the business or company has sufficiently trained personnel capable of handling the business skills, resources and equipment needed to do the job through network management skills. Luckily, employees should already understand how the system works and this can be beneficial to internal cost. On the other hand, if the employees are under skilled or inexperienced in network management, this may be seen as an additional work tasking on the employee. It may cause them to be stressed out and work less efficiently in their present responsibilities (Finch, 2014). Cost is the main driving factor for insourcing verses outsourcing. Most network systems and software have between a three and five year life cycle. I have seen systems go for a lot longer, but if the proficiency of the system is paramount, and the business or company is stuck on internal sourcing; the best approach would be to budget for a new system every five years. Most companies fail to peer into their crystal ball and see an antiquated system sitting in front of them with no budget forecast. This has become a divergent, systemic, troubling affect throughout a lot of companies. What is even more frightening is the implementation of Federal and State Laws emphasizing the higher standards of securities to be met. Under Washington (RCW) Revised Codes of Washington 19.255.010, state, county and municipal areas are required to implement strict security prevention and vulnerability tactics to ensure the safety of personal information for customers within the system. Federal laws execute the oversight to ensure these laws are enforced by the municipalities. They are “The Sarbanes- Oxley Act of 2002” (SOX) and the Gramm-Leach-Bliley Act (GLBA), which ensures the safety of customer’s information from impenetrable means. Failing to do this can result in hefty fines
  • 25. City Design 24 and law suits from Federal, state and customer venues. City Hall already has all the main components’ needed to maintain a functional system, minus a server to make it all run smoothly and efficiently. By current estimates, if the City Hall were to invest in a server system and hardware firewall at the subscriber line, the performance and security of the overall network would be within legal as well as efficiency means. For City Hall’s needs, a Dell PowerEdge T420 would be the ultimate in performance and streamlining for the City Hall. Base price on one of these is around $1300, but after all required additions are added for a RAID 5 backup and connections are made throughout the office, the final price could be around $5000. Since the town is also a municipality, it is authorized to shop for hardware in the Western States Contracting Alliance for all government municipalities. This is a placed specifically set up for municipalities to purchase insource networks for their towns. Inevitably, this server and firewall could also be leased as well and they could still have their permanent workstations they now use. Insourcing and Outsourcing Combined Various companies and businesses have found that it is easier to outsource portions of their network systems, since it’s easier to have professional help and technical assistance 24 hours a day, seven days a week. Most software venders assist in making this happen. Companies still want control of their hardware make ups, but are realizing it may be cheaper to outsource software functions to an outside vender. The same can be said for the hardware application as well. There are downfalls to this escapade in that the software vendors will sale software to anyone and will give prompt assistance, but they are there to sale software. They don’t care if the network system is out of date, or isn’t up to performance standards for their typical software. In their minds, they will make it work as they want the almighty business and dollar. It’s not exactly the way to do business, but a reputable software vendor will give the
  • 26. City Design 25 customer the appropriate information concerning hardware to software use and acceptability. This has been seen by the author on multiple occasions. When partial systems software has been outsourced, the response of most companies towards outsourcing has brought forth negative responses. The primary reasons for going back to insourcing entails the lack of quality vender service, the subject-matter expert doesn’t know squat, poor business communications, and account management and affordability (McCafferty, 2013). The tables can also be turned using outsourced hardware and insourced software. Dell and (HP) Hewlett-Packard are both prime examples of outsourcing that the business owner, company, or organization may rack up a contract with to enhance their networking experience. Both of these companies will come out, suggest what you might need for your facilities and write up a contract for total Systems Development Life Cycle of the hardware. You can apply your own software needs or use whatever may be provided by the vender to interface all the components. The advantages of having someone contracting your hardware is that if anything goes awry, its 24 hours a day, seven days a week, 365 days a year response time, or so they say. The downside to the outsourcing and insourcing is that when these companies do come and assess the needed abilities, they may take from 24 to 43 weeks to get it all planned together and operational. This brings us to the last card in the pile. Outsourcing Outsourcing can have benefits but it is also a snake pit of downfalls as well. Some will tell you that it is the greatest thing in the world. Contact with your venders any hour of the day, quick response time to everyday and catastrophic failures to a system with plans for easy backups. Vendors will say that the cost of leasing their equipment far outweighs the cost of system life cycle and budgeting internally. It also gives the company, business and users ample
  • 27. City Design 26 time to renegotiate feasible terms for upgrades, so the users will never be left behind in the digital explosion age. The company also doesn’t have to worry about budgeting for upgrades every three to five years. It’s now just a rental agreement with one easy, low, monthly PAYMENT! What they don’t tell you is how it is hard to work with diversities of the user and the IT vendors, who are not there to monitor system reliability, accessibility, and serviced ability of the systems, which are required constantly. Many corporations have seen an influx in going back to insourcing, as outsourcing opens a big cataclysmic channel between vendor and users. The response times are poor at best, they can never resolve interface issues, and there might be a cultural wedge between those who service and those who use the equipment. I know most people have been on the phone with someone from India, fighting about a bill, or credit card or something of that nature. Imagine having a cultural dialect so strong that it is impossibly understandable and they are trying to explain the functionality of the server so you can get it back on line. Most people are on fire around their collar by the end of the phone call and ultimately the problem was never resolved. Software is one of the other areas where everyone is renting it for a fee versus buying it. But it can really be financially smart, or so they (the venders) say. For example, Microsoft Corporation sells its’ Office 365 for $99 a year and that is for a single user. Multiple licenses have discounts applied. All you documents can now be sent to THE CLOUD!!!! Ok…so where is this cloud at? Have you ever seen it? Most people haven’t. It is actually a huge 12 block by five block server system located somewhere in the United States and that is where all your information is backed up data to. Just think, all this data, on the cloud all rests with your little own rental. However, you can buy the full version for $399.00. It doesn’t necessarily have a cloud attached though. What is funny about buying retail is that the life expectancy of Office 365 is about 4 years anyway. So…do you rent the software
  • 28. City Design 27 form a vender through outsourcing or do you just buy and own it? At least by buying it, the customer is able to keep it a while longer before moving on. They just won’t get the updated advantages of rental software and the almighty cloud service. The choice to outsource ultimately falls with the customer. In most instances, outsourcing may be beneficial to a business, if it is small enough and a fair price can be established. As the business grows into a bigger corporation, it is then that the company needs to review the necessity of doing an in-house approach towards IT rather than letting it be consummated to outside sources. Overall, size is a factor in the final outcome. Conclusion In this section, we have addressed three ways of integrating a network into the business, company or corporation. All three ways of integrating a new system, can have advantages over the others, as well as pitfalls. Finances play a key role as well as the ability for the company’s ability to work with the diversities of outside vendors. Insourcing puts a little more stress on employees as they have to step up to be something they never knew existed. WALLA!!!…you are now a technician in IT. Some employees don’t take kindly to that new job title and prestige. Maybe it just takes a mix of outsourcing and insourcing to make it all come together. Whatever the case might be, the owner of the company, business or corporation has the final vote as they are the one’s footing the bill.
  • 29. City Design 28 Chapter 5 – System Integration & Deployment Introduction Now that the accumulation of the phases have been addressed, it is time to go over the find details of the overall working break down (WBD) structure to ensure no steps to the project are missed . In this chapter, we will incorporate the graphs needed to verify our overall WBD structure is being followed. This will incorporate the preliminary analysis, systems analysis and requirements definition, systems design, actual planned development, integration and testing, acceptance, installation, deployment and finally operational support and maintenance. These are all important aspects as even if one procedure is missed, it can cause stoppage and detrimental effects in the overall accomplishment of the project being pursued. The Work Breakdown Structure All too often when a project is underway, some companies don’t take the time to review the progression of the project. To nullify this problem, one of the paramount structures needing addressed is the work breakdown structure to ensure nothing is overlooked. It’s like putting the cart before the horse in laymen’s terms. On the next page is a graphing of the City Hall break down to ensure everything is followed according to plan. Each area must be fully covered before moving on to the next scope in the project. (Figure 5-1) shows the overall steps to the Fig 5-1
  • 30. City Design 29 WBD and (Figure 5-2) does a more detailed scope of each of the steps. When the systems analyst has completed the initial assessment of the project, it will then be easily managed using this diagram to splice the project into manageable segments. The WBS is also important for cost assessments from bottom on up to the hierarchy in the executive branches and details possible cost overruns to keep the project on line without the additional expenditures. The WBD also monitors potential risks within the project that precludes potential break down from occurring within early segments of the project and causing a ripple effect later on down the road. The break down risks can be tracked and reviewed as the project proceeds. These assist in the communication interconnect within the segments of the project. Thus, it prevents further work stoppages from occurring during the project progression. Subject City Hall Project 2. Requirements 1. Design 4. Construction 3. Testing 1. Product Investigation 2. Product Survey 3. Assess Product Serviceability 1. Concept Design 2. Final Design 1. Purchase Materials 2. Build System 1.Test Functionality a. Detailed Design b. Drawings c. Design Review and Approval b. Mark Out Dimensions a. Routine Testing c. Install Infrastructure a. Install Media Connections b. Random Inspections Fig 5-2
  • 31. City Design 30 matter experts (SME) should be directly involved during the analysis phase as they bring expertise from other projects that could be instrumental in solving certain problems within the current project. To the left is a good example of how a work break down should look step-by- step. From initial planning all the way to the final product, everything is emphasized to ensure proper cost effectiveness with a fully functional product at the end. A work structure break down graph can also be applied to ensure clarity within each hierarchical area (University of Wisconsin, 2006). . 1 Initiate Project 1.1 Develop Project Manual 1.1.1 Define Scope 1.1.2 Define Requirements 1.1.3 Identify High-Level Roles 1.1.4 Develop High-Level Budget 1.1.5 Identify High-Level Control Strategies 1.1.6 Finalize Manual and Gain Approvals 1.1.6.1 Consolidate and Publish Project Charter 1.1.6.2 Hold Review Meeting 1.1.6.3 Revise Project Manual 1.1.6.4 Gain approvals 2 Plan Project 2.1 Develop Work Plan 2.1.1 Develop Work Breakdown Structure 2.1.2 Develop Project Staffing Plan 2.1.3 Develop Project Schedule 2.1.4 Develop Project Budget 2.2 Develop Project Control Plan 2.2.1 Develop Communication Plan 2.2.2 Develop Quality Management Plan 2.3 Finalize Project Plan and Gain Approvals 3 Execute and Control Project 3.1 Design Framework 3.1.1 Define framework stages and activities 3.1.2 Design framework content formats 3.1.3 Design web framework delivery tool 3.2 Build the Framework 3.2.1 Write the framework content 3.2.2 Review framework content for quality 3.2.3 Build web tool prototype 3.3 Test the Framework 3.3.1 Test usability of web tool 3.3.2 Test usability of content 3.3.3 Adjust framework based on user feedback 3.4 Implement Framework 3.4.1 Move framework to production environment 3.4.2 Announce availability of framework 4 Close the Project 4.1 Conduct Post-Project Review Figure 5 – 3 Work Breakdown Structure Outline PROJECT NAME 1 Activity 1.1 Task 1.1.1 Sub-Task 2 Activity 2.1 Task 2.1.1 Sub-task 2.1.2 Sub-Task 2.2 Task 2.2.1 Sub-Task 2.2.2 Sub-Task 2.2.3 Sub-Task 3 Activity 3.1 Task 3.1.1 Sub-Task 3.1.2 Sub-Task 3.2 Task 3.2.1 Sub-Task 3.2.2 Sub-Task 3.2.3 Sub-Task Figure 5-4
  • 32. City Design 31 Conclusion Ultimately, we want to ensure that all steps are taken to ensure all phases of the project are completed on time, within budget and what is considered favorable for the business and customer. The only way of accomplishing this is through the use a coordinated work break down to ensure conformity and consistency throughout the project. It is important to keep all parties in the loop throughout the whole process so that work stoppages and expenditure over runs, due to stoppages, don’t end up eating the customer’s huge dream into a pile of uncoordinated night mares. Once it is all done and in, the customer will have a system they can be proud of and the project company will still have the reputation needed to address another project. References Finch, C. (2014, May 21). Advantages & Disadvantages of Insourcing. Retrieved Sep 10, 2014, from http://www.ehow.com/info_10015686_advantages-disadvantages-insourcing.html McCafferty, D. (2013, May 13). Ten Considerations for CIOs Seeking to Insource. Retrieved Sep 11, 2014, from The Voice of the CIO Community: http://www.cioinsight.com/it- services/outsourcing/slideshows/ten-considerations-for-cios-seeking-to-insource-10/ MSDN. (2013). Unti Test Basics. Retrieved Sep 04, 2014, from http://msdn.microsoft.com: http://msdn.microsoft.com/en-us/library/ff798502.aspx N.A., R. S. (2002, May 25). Guidelines: Use-Case Storyboard, 1.1. (R. S. Corporation, Producer) Retrieved Aug 29, 2104, from sce.uhcl.edu: http://sce.uhcl.edu/helm/rationalunifiedprocess/process/modguide/md_ucstb.htm University of Wisconsin. (2006, Feb 01). Stage 3: Plan the Project, ver 1.0. Retrieved Sep 16, 2014, from Do IT Project Manager Advisor: http://www.pma.doit.wisc.edu/plan/2- 1/print.html Vision Software. (2014). Computer Sytem Requirements, 1. (Insight Software) Retrieved Aug 22, 2014, from My Vision Express: http://www.myvisionexpress.com/computer- requirements/
