Benefit Realisation Management
Bruce Levitan
Head of Business Improvement
MMU
Agenda
• Building Benefit maps
Benefit mapping
• Using BRM in projects
Stakeholder Analysis
Risk identification
Business Case
Prioritisation
Product Catalogues
Building a benefit map 1
You start by identifying the main objective (a benefit in itself)
If there is more than one objective, you will need one benefit map for each one
You then identify contributing benefits working right to left
For example, here are four benefit maps that were done for MMU’s EQAL
programme
3

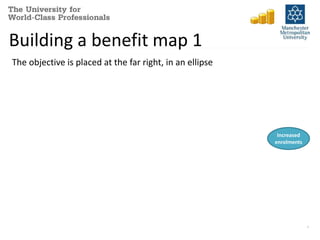

Building a benefit map 1
The objective is placed at the far right, in an ellipse
4
Increased
enrolments
Building a benefit map 2
Identify the main supporting benefits
Benefits should always be written in the form:
[improvement + object] e.g. “increased revenue”
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
PM-BRM 5
More
focused
advice
Increased
enrolments
Building a benefit map 3
Working from right to left, identify supporting benefits for one “area”
Less
applicant
frustration
Better
customer
service
Improved
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
enrolments
Fewer errors
Friday, November 21, 2014 PM-BRM 6

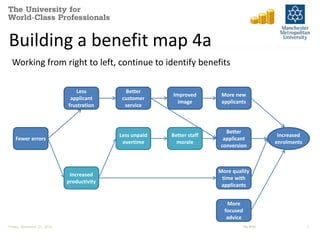

Building a benefit map 4a
Working from right to left, continue to identify benefits
Fewer errors
Less
applicant
frustration
Increased
productivity
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
enrolments
Friday, November 21, 2014 PM-BRM 7

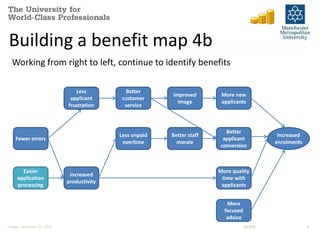

Building a benefit map 4b
Working from right to left, continue to identify benefits
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
enrolments
Friday, November 21, 2014 PM-BRM 8
Building a benefit map 4c
Working from right to left, continue to identify benefits
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
enrolments
Friday, November 21, 2014 PM-BRM 9
Building a benefit map 5
The next stage is to identify the activities that will deliver the benefits
These are called “enablers” and “business changes”
Typical enablers include:
• IT systems
• Physical assets (a lecture theatre, books)
• Activities such as training and documentation
Business changes include:
• Changes to processes
• Policies
• Restructures
Friday, November 21, 2014 PM-BRM 10
The completed map
Fewer errors
Less
applicant
frustration
Provide
training
Revise enrolments
process
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
Upgrade
system
Reporting
Business
change
Enabler
Friday, November 21, 2014 11

Areas where BRM helps PM
Stakeholder Analysis
Risk identification
Business Case
Prioritisation
Product Catalogues
Friday, November 21, 2014 PM-BRM 12
Stakeholder Analysis
1. Helps identify stakeholders by asking the question “who will be
impacted by this benefit?”
Management reporting: SPMI,
Executive
Corporate risk: SPMI
Retention: students, Finance,
Faculties
Satisfaction: students, academic
staff, non-academic staff
Friday, November 21, 2014 PM-BRM 13

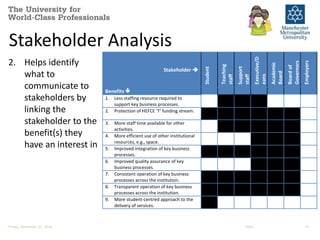

Stakeholder Analysis
2. Helps identify
what to
communicate to
stakeholders by
linking the
stakeholder to the
benefit(s) they
have an interest in
Stakeholder 
Student
Teaching
staff
Support
staff
Executive/D
eans
Academic
Board
Board of
Governors
Employers
Benefits 
1. Less staffing resource required to
support key business processes.
2. Protection of HEFCE ‘T’ funding stream.
3. More staff time available for other
activities.
4. More efficient use of other institutional
resources, e.g., space.
5. Improved integration of key business
processes.
6. Improved quality assurance of key
business processes.
7. Consistent operation of key business
processes across the institution.
8. Transparent operation of key business
processes across the institution.
9. More student-centred approach to the
delivery of services.
10. Ability to deliver key external
requirements, e.g., the HEAR.
11. Improved personalisation of timetabling
Friday, November 21, 2014 ESRA 14
information.
12. Better information on changes to

Risk identification
For each benefit on the benefit map, ask the questions:
1. What could prevent this benefit from being realised?
2. How many other benefits are affected?
The answer to (1) is the risk, and the answer to (2) helps to give a measure
of impact.
If your benefit mapping uses weighting scores (which we’ll come to later),
then you can add up the weights of the impacted benefits in (2) to get a
better measure of impact.
Friday, November 21, 2014 PM-BRM

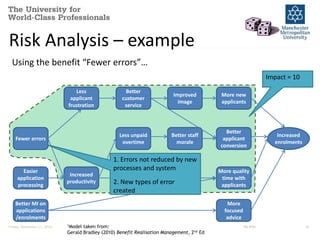

Risk Analysis – example
Using the benefit “Fewer errors”…
Friday, November 21, 2014 1Model taken from: PM-BRM 16
Gerald Bradley (2010) Benefit Realisation Management, 2nd Ed
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Less unpaid
overtime
Better staff
morale
Better
customer
service
Improved
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
enrolments
1. Errors not reduced by new
processes and system
2. New types of error
created
Impact = 10

Business Case
• Use the matrix to sort out which
benefits are Tangible /
Intangible, and for the tangibles,
which are Financial / Non-financial.
• Financial benefits should then
be worked on to estimate what
income they will generate – to
be used in the return on
investment part of the financial
analysis.
• Non-financial benefits are used
in the business case to show
benefit beyond mere cost &
income.
Friday, November 21, 2014
Business Case
Item Cost / Income (£ ) Recurring cost / Income (£)
COSTS:
Timetabling system 350,000 35,000
VLE (Moodle) 500,000 40,000
Timetabling staff 250,000
E-Learning Support Officers 250,000
Total costs: 850,000 575,000
SAVINGS:
Timetabling savings 35,000
Fewer learning resources 20,000
Fewer assessments/units 150,000
Total savings 205,000
Overall cost: 850,000 370,000
Friday, November 21, 2014
Business Case
Benefit Measure
Increase retention of Students Produce baseline numbers and monitor increase
Value to the Student Monitoring students who are re-engaged who complete and are
Friday, November 21, 2014
successful in Award
Maintain Income Retaining 62 full time paying students would generate return on
investment of Project costs. Any number above this would ensure
income targets are retained
Please see Return on Investment breakdown below.
Provide more qualitative time to
Academic to enable intervention
and follow up actions
Increase in Student Retention due to interventions and support
provided
Provide additional information on
course health
Quantity of Unit Leaders and Programme Leaders accessing and
reviewing via CMI system
Provide clarity of Roles and
Responsibilities
Responsibilities are progressed in timely fashion
Greater institutional oversight of
students who require support
Immediate access to meaningful and timely data
Be pro-active with internal and
external demands for engagement
data
Timing comparison to provide requested data
Prioritisation
Two approaches:
• Simpler approach is to assess which changes enable most benefits –
this is done by adding business change requirements and enablers to a
benefit map.
• More complex example is to add weighting scores to benefits, and then
by association to business changes and their enablers: this will give a
numerical score that can be used to prioritise changes (and enablers).
Friday, November 21, 2014 PM-BRM

Prioritisation (simple)
Fewer errors
Less
applicant
frustration
Provide
training
Revise enrolments
process
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applicants
Better
applicant
conversion
More quality
time with
applicants
More
focused
advice
Increased
Upgrade
system
Reporting
Business
change
Enabler
Friday, November 21, 2014 21

Prioritisation (weighted - 1)
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applications
Better
application
conversion
More quality
time with
applicants
More
focused
advice
Provide
training
Revise
process
Upgrade
system
Reporting
Business
change
Enabler
Increased
enrolments
(1000)
Start with an overall
weighting score
Friday, November 21, 2014 22
Prioritisation (weighted - 2)
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
More new
applications
(400)
Better
application
conversion
(300)
More quality
time with
applicants
(200)
More
focused
advice(100)
Provide
training
Revise
process
Upgrade
system
Reporting
Business
change
Enabler
40%
30%
Increased
enrolments
20%
(1000)
10%
Add % contribution &
add appropriate score
to supporting benefits
Friday, November 21, 2014 23

Prioritisation (weighted - 3)
Fewer errors
Less
applicant
frustration
Increased
productivity
Easier
application
processing
Better MI on
applications
/enrolments
Better
customer
service
Less unpaid
overtime
Improved
Better staff
morale
100%
More new
applications
(400)
60%
Better
application
conversion
(300)
More quality
time with
applicants
(200)
More
focused
advice(100)
Provide
training
Revise
process
Upgrade
system
Reporting
Business
change
Enabler
40%
30%
Increased
enrolments
20%
(1000)
10%
40%
80%
20%
100%
Continue to work
back from right to left
Friday, November 21, 2014 24
Prioritisation (weighted - 4)
Fewer errors
(540)
Less
applicant
frustration
(400)
100%
100%
50%
Increased
productivity
(280)
30%
Easier
application
processing
(140)
Better MI on
applications
/enrolments
(140)
100% 100% 100%
Better
customer
service (580)
Less unpaid
overtime
(120)
Improved
image (400)
Better staff
morale (120)
More new
applications
(400)
60%
Better
application
conversion
(300)
More quality
time with
applicants
(200)
More
focused
advice(100)
Provide
training (108)
Revise
process (300)
Upgrade
system (218)
Reporting
(194)
50%
Business
change
Enabler
40%
30%
Increased
enrolments
20%
(1000)
10%
40%
100%
80%
20%
100%
10%
20%
40%
60%
40%
100%
Friday, November 21, 2014 25
Prioritisation
Two approaches:
• Using the “simple approach”:
– Provide training = 11 benefits supported
– Revise process = 12 benefits supported
– Upgrade system = 12 benefits supported
– Reporting = 13 benefits supported
• Using the “weighted approach”:
– Provide training = 108
– Revise process = 300
– Upgrade system = 218
– Reporting = 194
• So they both have the same “least” option, but differ on the “most”!
Which is best? Neither – they are basis for discussion!
Friday, November 21, 2014 PM-BRM
Product Catalogues
• Product (and requirement) catalogues can be linked to benefits via the
benefit map, and these can help inform acceptance criteria and user
tests.
• For example “Reporting” is linked to “Fewer errors” and “Better MI on
customers and sales”, so acceptance criteria can include Reports on :
– error rates
– types of error
– source of error
– applicants (broken down by demographics, age, ethnicity, etc.)
– enrolments (broken down by demographics, location, A levels, etc.)
• Exercise:
– Identify some acceptance criteria for the remaining enabler and one of the
business changes
Friday, November 21, 2014 PM-BRM
The end
• Contact details:
Bruce Levitan: b.levitan@mmu.ac.uk
Friday, November 21, 2014 PM-BRM

Benefit Realisation Management

  • 1.
    Benefit Realisation Management Bruce Levitan Head of Business Improvement MMU
  • 2.
    Agenda • BuildingBenefit maps Benefit mapping • Using BRM in projects Stakeholder Analysis Risk identification Business Case Prioritisation Product Catalogues
  • 3.
    Building a benefitmap 1 You start by identifying the main objective (a benefit in itself) If there is more than one objective, you will need one benefit map for each one You then identify contributing benefits working right to left For example, here are four benefit maps that were done for MMU’s EQAL programme 3
  • 4.
    Building a benefitmap 1 The objective is placed at the far right, in an ellipse 4 Increased enrolments
  • 5.
    Building a benefitmap 2 Identify the main supporting benefits Benefits should always be written in the form: [improvement + object] e.g. “increased revenue” More new applicants Better applicant conversion More quality time with applicants PM-BRM 5 More focused advice Increased enrolments
  • 6.
    Building a benefitmap 3 Working from right to left, identify supporting benefits for one “area” Less applicant frustration Better customer service Improved image More new applicants Better applicant conversion More quality time with applicants More focused advice Increased enrolments Fewer errors Friday, November 21, 2014 PM-BRM 6
  • 7.
    Building a benefitmap 4a Working from right to left, continue to identify benefits Fewer errors Less applicant frustration Increased productivity Better customer service Less unpaid overtime Improved image Better staff morale More new applicants Better applicant conversion More quality time with applicants More focused advice Increased enrolments Friday, November 21, 2014 PM-BRM 7
  • 8.
    Building a benefitmap 4b Working from right to left, continue to identify benefits Fewer errors Less applicant frustration Increased productivity Easier application processing Better customer service Less unpaid overtime Improved image Better staff morale More new applicants Better applicant conversion More quality time with applicants More focused advice Increased enrolments Friday, November 21, 2014 PM-BRM 8
  • 9.
    Building a benefitmap 4c Working from right to left, continue to identify benefits Fewer errors Less applicant frustration Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale More new applicants Better applicant conversion More quality time with applicants More focused advice Increased enrolments Friday, November 21, 2014 PM-BRM 9
  • 10.
    Building a benefitmap 5 The next stage is to identify the activities that will deliver the benefits These are called “enablers” and “business changes” Typical enablers include: • IT systems • Physical assets (a lecture theatre, books) • Activities such as training and documentation Business changes include: • Changes to processes • Policies • Restructures Friday, November 21, 2014 PM-BRM 10
  • 11.
    The completed map Fewer errors Less applicant frustration Provide training Revise enrolments process Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale More new applicants Better applicant conversion More quality time with applicants More focused advice Increased Upgrade system Reporting Business change Enabler Friday, November 21, 2014 11
  • 12.
    Areas where BRMhelps PM Stakeholder Analysis Risk identification Business Case Prioritisation Product Catalogues Friday, November 21, 2014 PM-BRM 12
  • 13.
    Stakeholder Analysis 1.Helps identify stakeholders by asking the question “who will be impacted by this benefit?” Management reporting: SPMI, Executive Corporate risk: SPMI Retention: students, Finance, Faculties Satisfaction: students, academic staff, non-academic staff Friday, November 21, 2014 PM-BRM 13
  • 14.
    Stakeholder Analysis 2.Helps identify what to communicate to stakeholders by linking the stakeholder to the benefit(s) they have an interest in Stakeholder  Student Teaching staff Support staff Executive/D eans Academic Board Board of Governors Employers Benefits  1. Less staffing resource required to support key business processes. 2. Protection of HEFCE ‘T’ funding stream. 3. More staff time available for other activities. 4. More efficient use of other institutional resources, e.g., space. 5. Improved integration of key business processes. 6. Improved quality assurance of key business processes. 7. Consistent operation of key business processes across the institution. 8. Transparent operation of key business processes across the institution. 9. More student-centred approach to the delivery of services. 10. Ability to deliver key external requirements, e.g., the HEAR. 11. Improved personalisation of timetabling Friday, November 21, 2014 ESRA 14 information. 12. Better information on changes to
  • 15.
    Risk identification Foreach benefit on the benefit map, ask the questions: 1. What could prevent this benefit from being realised? 2. How many other benefits are affected? The answer to (1) is the risk, and the answer to (2) helps to give a measure of impact. If your benefit mapping uses weighting scores (which we’ll come to later), then you can add up the weights of the impacted benefits in (2) to get a better measure of impact. Friday, November 21, 2014 PM-BRM
  • 16.
    Risk Analysis –example Using the benefit “Fewer errors”… Friday, November 21, 2014 1Model taken from: PM-BRM 16 Gerald Bradley (2010) Benefit Realisation Management, 2nd Ed Fewer errors Less applicant frustration Increased productivity Easier application processing Better MI on applications /enrolments Less unpaid overtime Better staff morale Better customer service Improved image More new applicants Better applicant conversion More quality time with applicants More focused advice Increased enrolments 1. Errors not reduced by new processes and system 2. New types of error created Impact = 10
  • 17.
    Business Case •Use the matrix to sort out which benefits are Tangible / Intangible, and for the tangibles, which are Financial / Non-financial. • Financial benefits should then be worked on to estimate what income they will generate – to be used in the return on investment part of the financial analysis. • Non-financial benefits are used in the business case to show benefit beyond mere cost & income. Friday, November 21, 2014
  • 18.
    Business Case ItemCost / Income (£ ) Recurring cost / Income (£) COSTS: Timetabling system 350,000 35,000 VLE (Moodle) 500,000 40,000 Timetabling staff 250,000 E-Learning Support Officers 250,000 Total costs: 850,000 575,000 SAVINGS: Timetabling savings 35,000 Fewer learning resources 20,000 Fewer assessments/units 150,000 Total savings 205,000 Overall cost: 850,000 370,000 Friday, November 21, 2014
  • 19.
    Business Case BenefitMeasure Increase retention of Students Produce baseline numbers and monitor increase Value to the Student Monitoring students who are re-engaged who complete and are Friday, November 21, 2014 successful in Award Maintain Income Retaining 62 full time paying students would generate return on investment of Project costs. Any number above this would ensure income targets are retained Please see Return on Investment breakdown below. Provide more qualitative time to Academic to enable intervention and follow up actions Increase in Student Retention due to interventions and support provided Provide additional information on course health Quantity of Unit Leaders and Programme Leaders accessing and reviewing via CMI system Provide clarity of Roles and Responsibilities Responsibilities are progressed in timely fashion Greater institutional oversight of students who require support Immediate access to meaningful and timely data Be pro-active with internal and external demands for engagement data Timing comparison to provide requested data
  • 20.
    Prioritisation Two approaches: • Simpler approach is to assess which changes enable most benefits – this is done by adding business change requirements and enablers to a benefit map. • More complex example is to add weighting scores to benefits, and then by association to business changes and their enablers: this will give a numerical score that can be used to prioritise changes (and enablers). Friday, November 21, 2014 PM-BRM
  • 21.
    Prioritisation (simple) Fewererrors Less applicant frustration Provide training Revise enrolments process Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale More new applicants Better applicant conversion More quality time with applicants More focused advice Increased Upgrade system Reporting Business change Enabler Friday, November 21, 2014 21
  • 22.
    Prioritisation (weighted -1) Fewer errors Less applicant frustration Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale More new applications Better application conversion More quality time with applicants More focused advice Provide training Revise process Upgrade system Reporting Business change Enabler Increased enrolments (1000) Start with an overall weighting score Friday, November 21, 2014 22
  • 23.
    Prioritisation (weighted -2) Fewer errors Less applicant frustration Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale More new applications (400) Better application conversion (300) More quality time with applicants (200) More focused advice(100) Provide training Revise process Upgrade system Reporting Business change Enabler 40% 30% Increased enrolments 20% (1000) 10% Add % contribution & add appropriate score to supporting benefits Friday, November 21, 2014 23
  • 24.
    Prioritisation (weighted -3) Fewer errors Less applicant frustration Increased productivity Easier application processing Better MI on applications /enrolments Better customer service Less unpaid overtime Improved image Better staff morale 100% More new applications (400) 60% Better application conversion (300) More quality time with applicants (200) More focused advice(100) Provide training Revise process Upgrade system Reporting Business change Enabler 40% 30% Increased enrolments 20% (1000) 10% 40% 80% 20% 100% Continue to work back from right to left Friday, November 21, 2014 24
  • 25.
    Prioritisation (weighted -4) Fewer errors (540) Less applicant frustration (400) 100% 100% 50% Increased productivity (280) 30% Easier application processing (140) Better MI on applications /enrolments (140) 100% 100% 100% Better customer service (580) Less unpaid overtime (120) Improved image (400) Better staff morale (120) More new applications (400) 60% Better application conversion (300) More quality time with applicants (200) More focused advice(100) Provide training (108) Revise process (300) Upgrade system (218) Reporting (194) 50% Business change Enabler 40% 30% Increased enrolments 20% (1000) 10% 40% 100% 80% 20% 100% 10% 20% 40% 60% 40% 100% Friday, November 21, 2014 25
  • 26.
    Prioritisation Two approaches: • Using the “simple approach”: – Provide training = 11 benefits supported – Revise process = 12 benefits supported – Upgrade system = 12 benefits supported – Reporting = 13 benefits supported • Using the “weighted approach”: – Provide training = 108 – Revise process = 300 – Upgrade system = 218 – Reporting = 194 • So they both have the same “least” option, but differ on the “most”! Which is best? Neither – they are basis for discussion! Friday, November 21, 2014 PM-BRM
  • 27.
    Product Catalogues •Product (and requirement) catalogues can be linked to benefits via the benefit map, and these can help inform acceptance criteria and user tests. • For example “Reporting” is linked to “Fewer errors” and “Better MI on customers and sales”, so acceptance criteria can include Reports on : – error rates – types of error – source of error – applicants (broken down by demographics, age, ethnicity, etc.) – enrolments (broken down by demographics, location, A levels, etc.) • Exercise: – Identify some acceptance criteria for the remaining enabler and one of the business changes Friday, November 21, 2014 PM-BRM
  • 28.
    The end •Contact details: Bruce Levitan: b.levitan@mmu.ac.uk Friday, November 21, 2014 PM-BRM

Editor's Notes

  • #15 and success – i.e. the second of the three areas outlined on the previous slide
