Agile retrospectives: Why, What and How

Dmitriy Viktorov
AgileDays’10, St.Petersburg, September 17th 2010

Protecting the irreplaceable | f-secure.com
Postmortems in pre-Agile days

2   21 September,
3
When

4
How to make retrospective successful

5
Preparation
    •   Place
    •   Participants
    •   Agenda / goals
    •   Toolbox

6
Conducting the retrospective
    • Check in (warm-up)
    • Collecting feedback
    • Facilitation techniques
    • Lead people, time, yourself

7
Check-in & Warm-up
• Get participants in the right mood
• Code of conduct
• Make agenda and goals visible
• Share context, display data,
  timeline

8

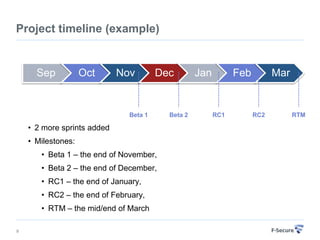

Project timeline (example)

      Sep           Oct      Nov        Dec        Jan         Feb         Mar

                               Beta 1     Beta 2         RC1         RC2         RTM

    • 2 more sprints added
    • Milestones:
       • Beta 1 – the end of November,
       • Beta 2 – the end of December,
       • RC1 – the end of January,
       • RC2 – the end of February,
       • RTM – the mid/end of March

9

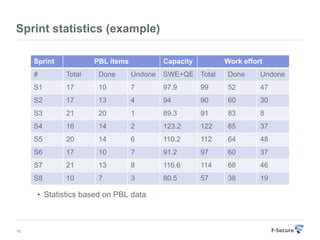

Sprint statistics (example)

     Sprint           PBL items            Capacity         Work effort
     #        Total    Done       Undone   SWE+QE Total     Done      Undone
     S1       17       10         7        97.9       99    52        47
     S2       17       13         4        94         90    60        30
     S3       21       20         1        89.3       91    83        8
     S4       16       14         2        123.2      122   85        37
     S5       20       14         6        110.2      112   64        48
     S6       17       10         7        91.2       97    60        37
     S7       21       13         8        116.6      114   68        46
     S8       10       7          3        80.5       57    38        19

      • Statistics based on PBL data

10

Bug trend report (example)

11
How to gather feedback
• Classic Scrum
• Starfish
• Keep, Drop, Fix, Try
• 3L’s (4L’s)
• Checklist

12

Assessment form (example)

     Sprint 2

                            Sprint 7

13
Leading the retrospective
• Time
     • Start and finish on time
     • Timebox activities
     • Have breaks
• People
     • Personalities (quiet, overbeating, passive, aggressive)
     • Introverts vs. extroverts
• You
     • Facilitator vs. team member
     • Let others talk

14
Analyze feedback
     • Group similar items
     • Separate team and company level items
     • Root cause analysis
     • Select top 3/5/10 items to work on
     • Discuss actions, owners and schedule

15
Group and separate items

16
Group and separate items

      Group 1         Group 2   Group 3

     Group 4          Group 5   Group 6

17
Group and separate items

               TEAM          COMPANY
     Group 1      Group 3         Group 2

     Group 4       Group 6        Group 5

18

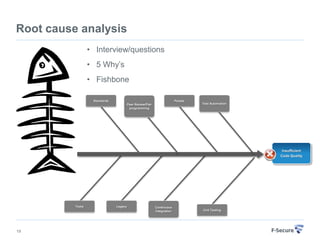

Root cause analysis
            • Interview/questions
            • 5 Why’s
            • Fishbone

19
Decide what, who and when
• Identify things that make difference
• Owner is not always the one who will do it
• Start with near-term improvements
• Get support for long-term improvements

20
Closing the retrospective
     • End in positive way
     • Appreciation
     • Celebrate (cake, champagne, fireworks)

21
Follow up
     • Share retrospective results
     • Make comments and actions visible
     • Add user stories, tasks to sprint/product backlog
     • Check the status regularly
     • Review on next retrospective

22
Smells
         • Reporting to management
         • Offline retrospective (by email)
         • Only a few participants
         • Everybody is happy
         • Blame game
         • Nobody talks about elephant
         • Looking for silver bullets
         • Retrospective in the team room
         • Too short retrospective meeting
         • Facilitator doesn’t facilitate
