Agile, IT, and the Business Community

                       Presented by:

                     William F. Nazzaro
                      Vice President
                   Process Synergy, LLC
                  bill@ProcessSynergy.com
                        (610) 831-1151
                                            Version 1.00
Process Synergy Background

           A Philadelphia-based consultancy dedicated to the highest-quality
           delivery of project mentoring, training and organizational transformation
           Full lifecycle consulting, coaching and mentoring
             –    Requirements – Use Cases, User-Stories, IIBA
             –    Process – Agile (XP, TDD), Unified Process, CMMi
             –    Project Management – Scrum, Iterative, PMI
             –    Architecture – Service-Oriented Architecture
             –    Organizational Change Management and Improvement
             –    Delivered On-Site, Globally
           Full lifecycle software training curriculum
             – Highly differentiated offerings
             – Experiential approach and skills building
             – Virtual and on-site
           Multi-tool vendor expertise
             – IBM Rational, Microsoft, Borland, HP Mercury, BluePrint, VersionOne, RallyDev

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                   Page - 2
Presenter’s Background

           Twenty years of success in delivering enterprise software solutions for Fortune
           100 companies, he has provided unparalleled services in project mentoring, use
           case and user story training and modeling, agile SCRUM, XP, TDD, service-
           oriented architecture, Unified Process and CMMi adoption, Java, C++, C, and
           Smalltalk programming languages, and technical curriculum development and
           delivery.

           His pragmatic emphasis on project execution and process improvement has
           benefited major insurance, health-care, human resources, stock market
           organizations and Department of Defense where he has enabled the transformation
           of their corporate development processes and development teams of diverse skill-
           levels.

           He has provided in-depth talks on Agility, Use Case Modeling, Service-Oriented
           Architecture, Unified Process, Object Technology and Data Modeling.

           He has extensive background in project management, and has successfully led
           teams on multi-million dollar projects to provide the highest-quality technical
           solutions in the most efficient and effective manner.

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |               Page - 3
Premise

           IT projects are failing at a rate of 25%, and 45% of our projects are
           challenged for being late, over-budget, or providing less than
           required features and functions

           Unfortunately this has been a habitual problem for IT and more
           importantly it has been a source of conflict and contention
           between IT and the business community we serve

           Our business community, more than ever, demands speed and
           flexibility in taking products to market.

           As a result, approximately 35% of IT organizations have adopted
           or are in some form of adoption of agile practices and agile
           software development

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |     Page - 4
Agenda

           Common Agile Misconceptions

           Why Should the CIO or CTO Care About Agile?

           What Does the Business Community Need to Know About Agile?

           Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 5

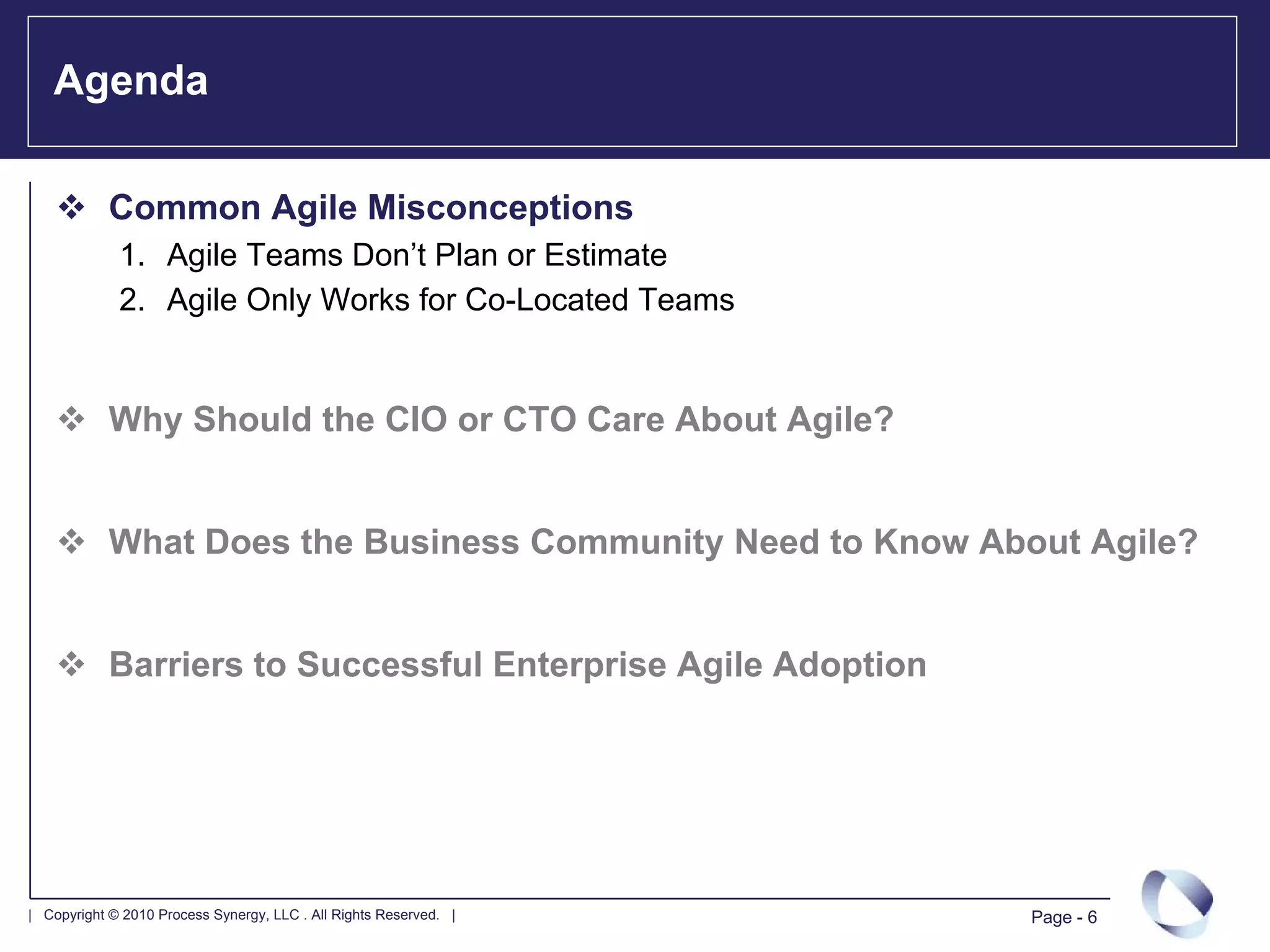

Agenda

            Common Agile Misconceptions
             1. Agile Teams Don’t Plan or Estimate
             2. Agile Only Works for Co-Located Teams

            Why Should the CIO or CTO Care About Agile?

            What Does the Business Community Need to Know About Agile?

            Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 6

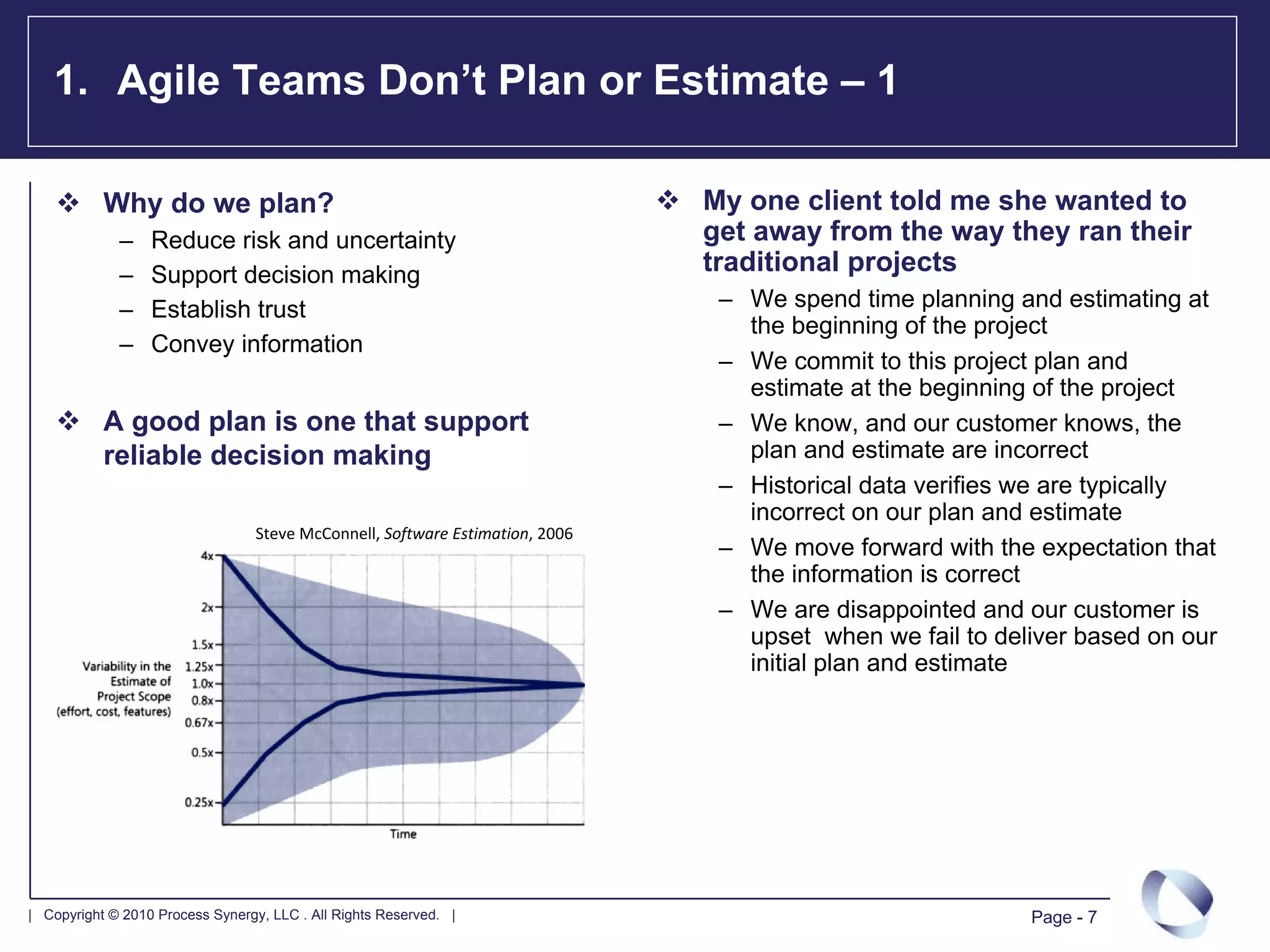

1. Agile Teams Don’t Plan or Estimate – 1

           Why do we plan?                                                     My one client told me she wanted to
             –    Reduce risk and uncertainty                                  get away from the way they ran their
             –    Support decision making                                      traditional projects
             –    Establish trust                                               – We spend time planning and estimating at
                                                                                  the beginning of the project
             –    Convey information
                                                                                – We commit to this project plan and
                                                                                  estimate at the beginning of the project
           A good plan is one that support                                      – We know, and our customer knows, the
           reliable decision making                                               plan and estimate are incorrect
                                                                                – Historical data verifies we are typically
                                                                                  incorrect on our plan and estimate
                                  Steve McConnell, Software Estimation, 2006
                                                                                – We move forward with the expectation that
                                                                                  the information is correct
                                                                                – We are disappointed and our customer is
                                                                                  upset when we fail to deliver based on our
                                                                                  initial plan and estimate

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                           Page - 7

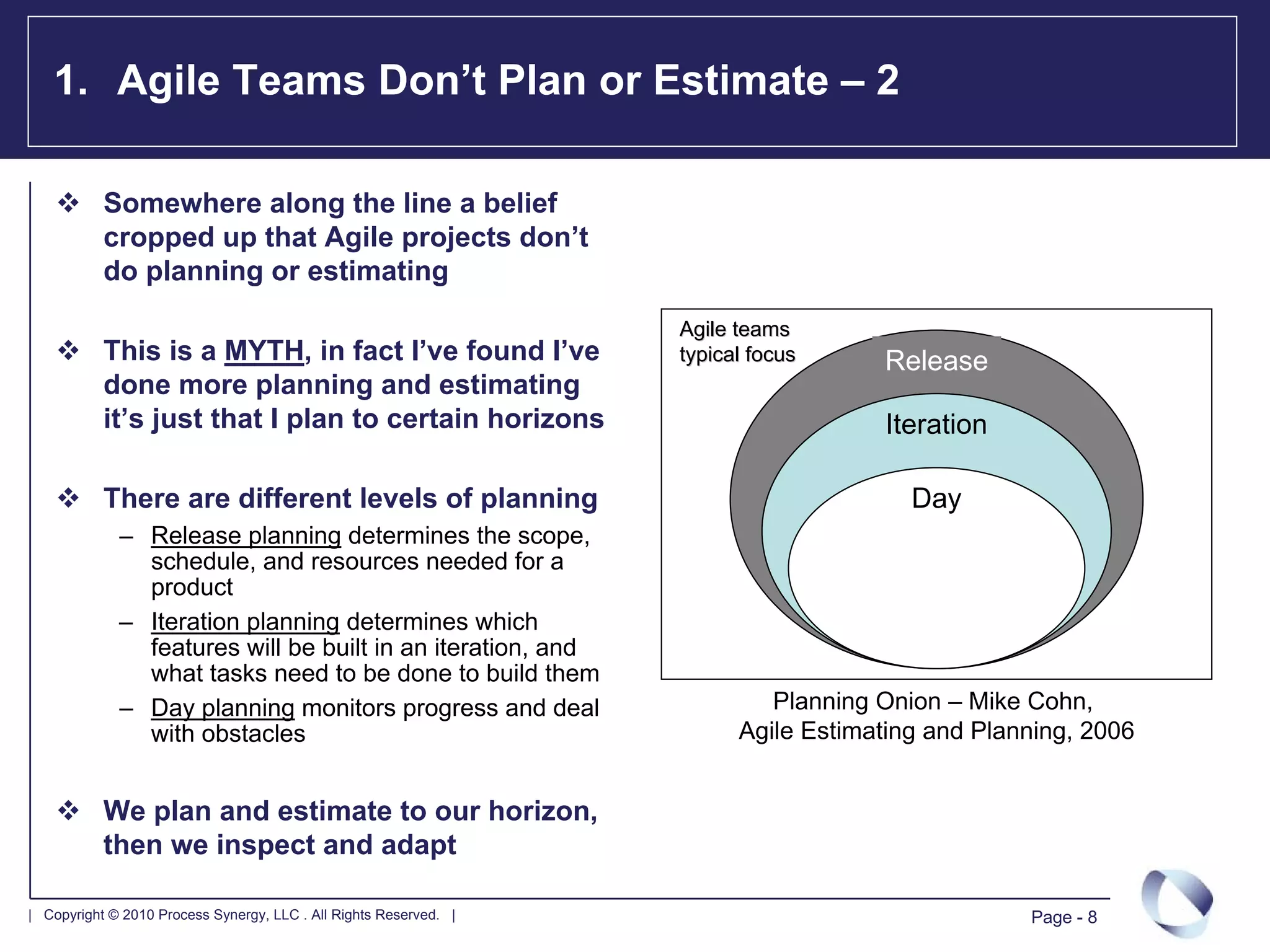

1. Agile Teams Don’t Plan or Estimate – 2

           Somewhere along the line a belief
           cropped up that Agile projects don’t
           do planning or estimating
                                                                   Agile teams
           This is a MYTH, in fact I’ve found I’ve                 typical focus     Release
           done more planning and estimating
           it’s just that I plan to certain horizons                                 Iteration

           There are different levels of planning                                       Day
             – Release planning determines the scope,
               schedule, and resources needed for a
               product
             – Iteration planning determines which
               features will be built in an iteration, and
               what tasks need to be done to build them
             – Day planning monitors progress and deal                      Planning Onion – Mike Cohn,
               with obstacles                                            Agile Estimating and Planning, 2006

           We plan and estimate to our horizon,
           then we inspect and adapt

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                  Page - 8
2. Agile Only Works for Co-Located Teams – 1

            To be truthful, agility can be more
            difficult for teams that aren’t co-
            located because of the expectation to
            communicate more

            So how can we over come this?

            We have to be more creative
             –      Shifting of hours or work schedules to
                    create an opportunity for overlap
             –      Leveraging a variety of communication
                    tools (e.g., GoogleTalk, IM, Wikis, virtual
                    team rooms, digital cameras, etc.)

            Strive for purpose and value-driven
            communication

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 9
2. Agile Only Works for Co-Located Teams – 2

            When hiring team members stress their
            ability to be able to communicate

            Communication is more than just
            talking, it can also be
             –      How to express an idea (i.e., Textual, UML,
                    Architecturally, code)
             –      Do they seek to be understood or to
                    understand
             –      How do they listen?

            Ironically, teams that don’t
            communicate very well that are co-
            located are the first to mention that
            agile won’t work for teams that aren’t
            co-located

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 10
Agenda

            Common Agile Misconceptions

            Why Should the CIO or CTO Care About Agile?
             1. Traditional vs. Agile Processes
             2. Traditional vs. Agile Budgeting
             3. Some Numbers to Consider

    1. What Does the Business Community Need to Know About Agile?

    2. Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 11

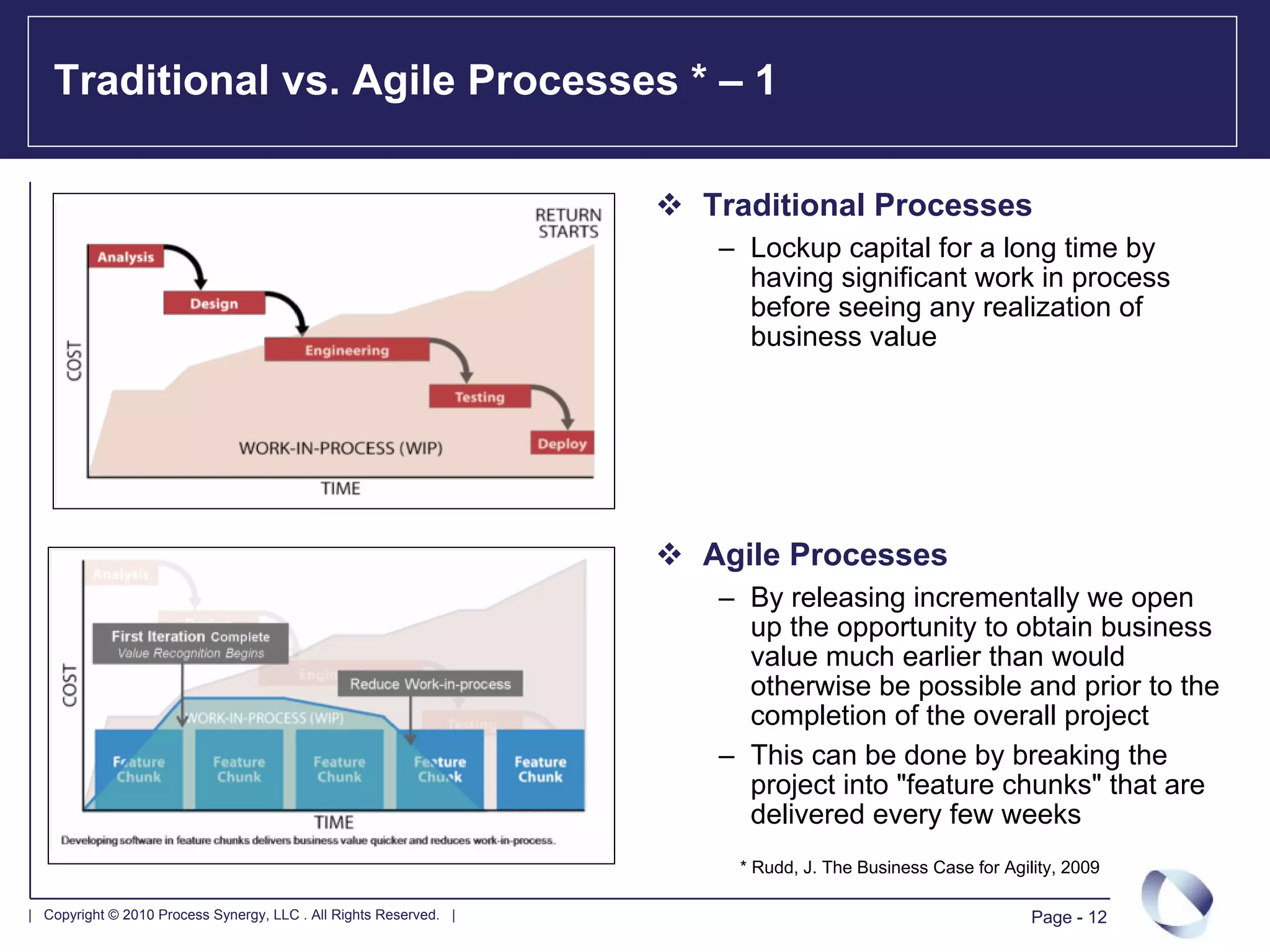

Traditional vs. Agile Processes * – 1

                                                                   Traditional Processes
                                                                    – Lockup capital for a long time by
                                                                      having significant work in process
                                                                      before seeing any realization of
                                                                      business value

                                                                   Agile Processes
                                                                    – By releasing incrementally we open
                                                                      up the opportunity to obtain business
                                                                      value much earlier than would
                                                                      otherwise be possible and prior to the
                                                                      completion of the overall project
                                                                    – This can be done by breaking the
                                                                      project into "feature chunks" that are
                                                                      delivered every few weeks
                                                                     * Rudd, J. The Business Case for Agility, 2009

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                          Page - 12

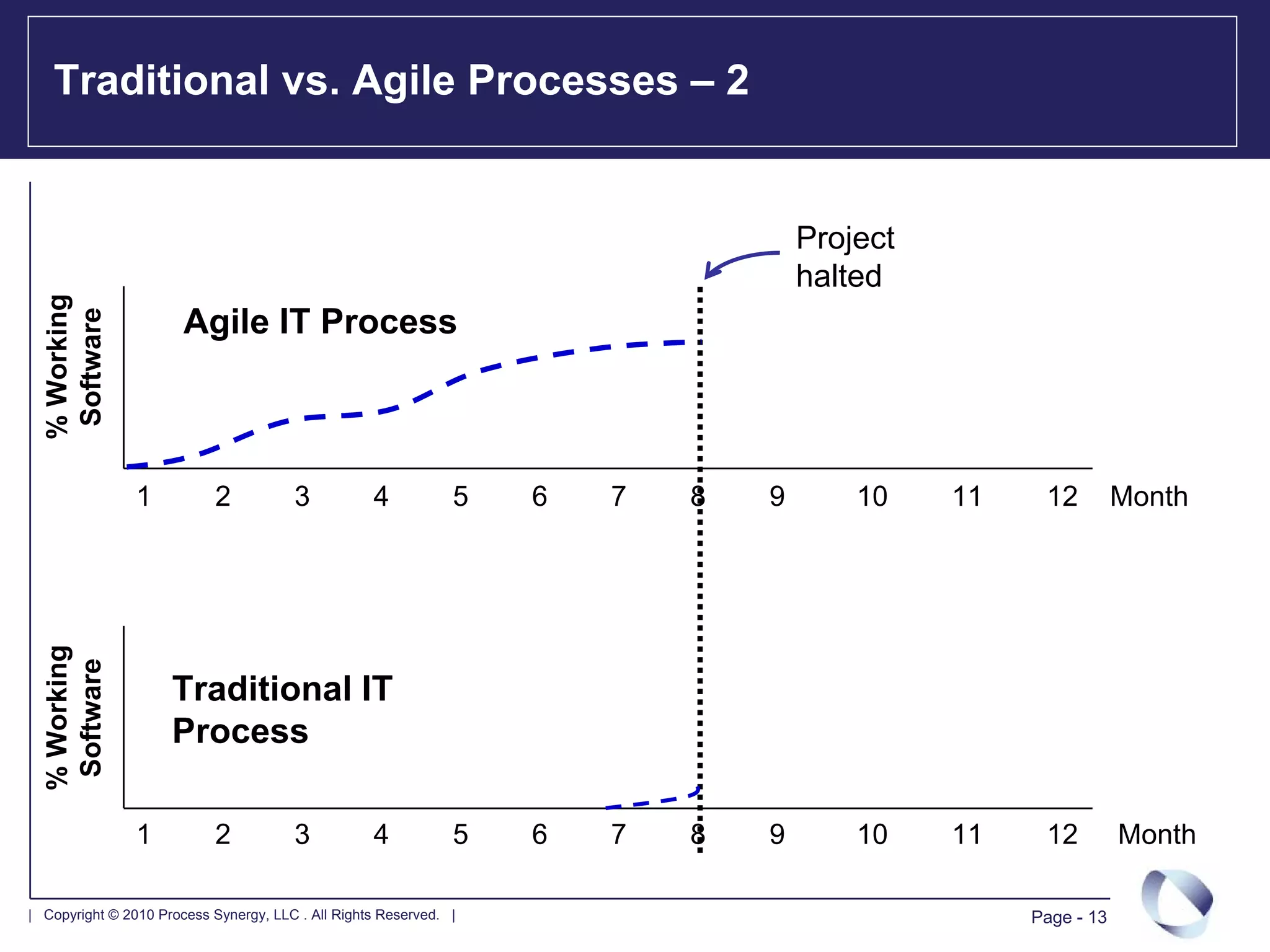

Traditional vs. Agile Processes – 2

                                                                                   Project
                                                                                   halted
  % Working
   Software

                       Agile IT Process

                1           2          3           4           5   6   7   8   9       10    11    12         Month
  % Working
   Software

                     Traditional IT
                     Process

                1           2          3           4           5   6   7   8   9       10    11    12         Month

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                  Page - 13

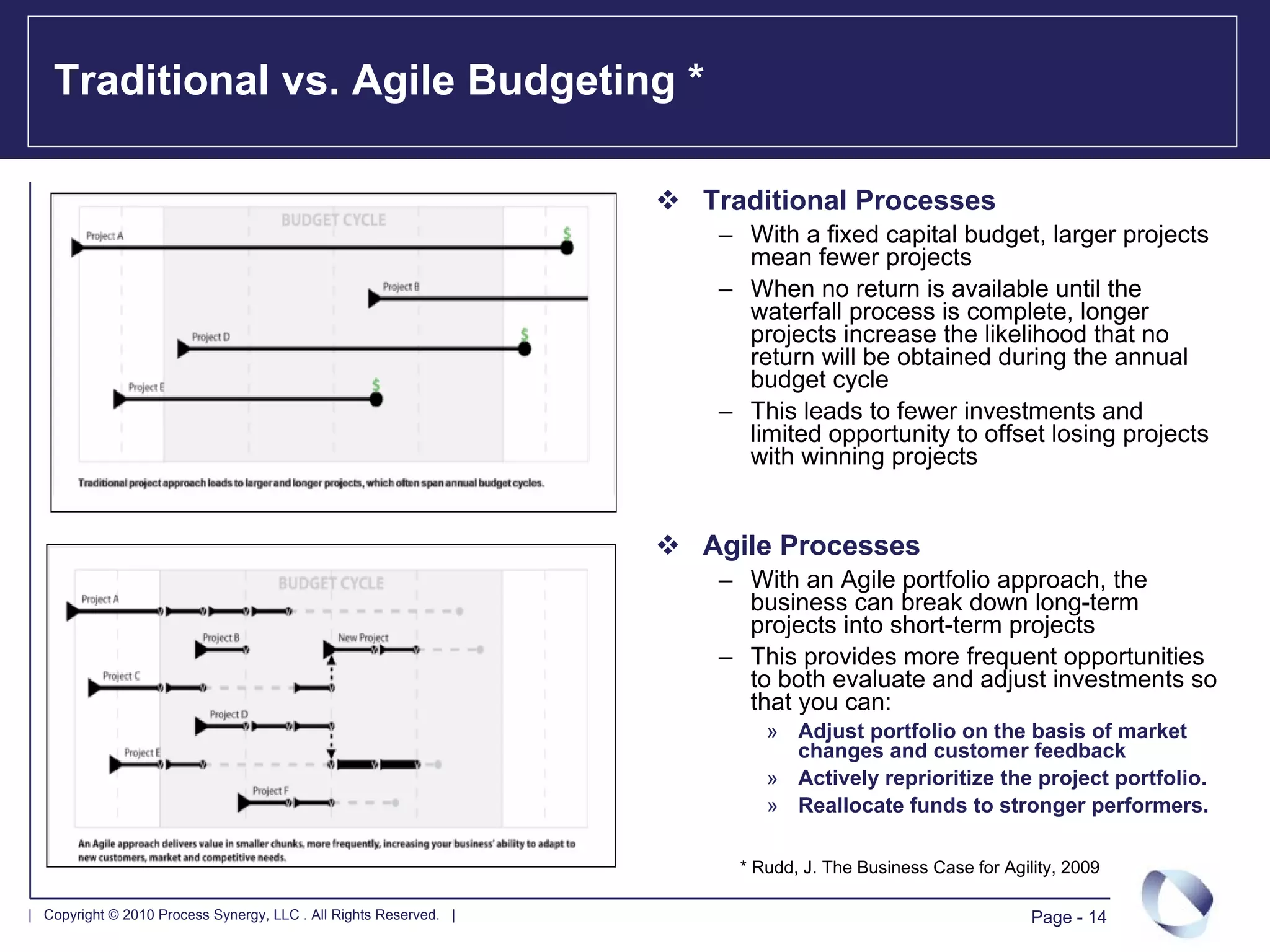

Traditional vs. Agile Budgeting *

                                                                   Traditional Processes
                                                                    – With a fixed capital budget, larger projects
                                                                      mean fewer projects
                                                                    – When no return is available until the
                                                                      waterfall process is complete, longer
                                                                      projects increase the likelihood that no
                                                                      return will be obtained during the annual
                                                                      budget cycle
                                                                    – This leads to fewer investments and
                                                                      limited opportunity to offset losing projects
                                                                      with winning projects

                                                                   Agile Processes
                                                                    – With an Agile portfolio approach, the
                                                                      business can break down long-term
                                                                      projects into short-term projects
                                                                    – This provides more frequent opportunities
                                                                      to both evaluate and adjust investments so
                                                                      that you can:
                                                                         » Adjust portfolio on the basis of market
                                                                           changes and customer feedback
                                                                         » Actively reprioritize the project portfolio.
                                                                         » Reallocate funds to stronger performers.

                                                                      * Rudd, J. The Business Case for Agility, 2009

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                           Page - 14
Some Numbers To Consider *

           93% increased productivity 1
           88% increased quality 1
           83% improved stakeholder
           satisfaction 1
           49% reduced costs 1
           66% three-year, risk-adjusted return
           on investment 2

           Reasons for Agile adoption include:
             – 47% to better manage project scope 3
             – 45% to create clear business
               requirements 3                                      1 “Agile Methodologies: Survey Results”, Shine Technologies, 2003
                                                                   2 Forrester Research, 2004
             – 40% to speed or better predict time to              3 “Agile 2006 Survey Results and Analysis”, Digital Focus, 2005
               market 3

                                                                                       * Source: http://www.rallydev.com

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                               Page - 15

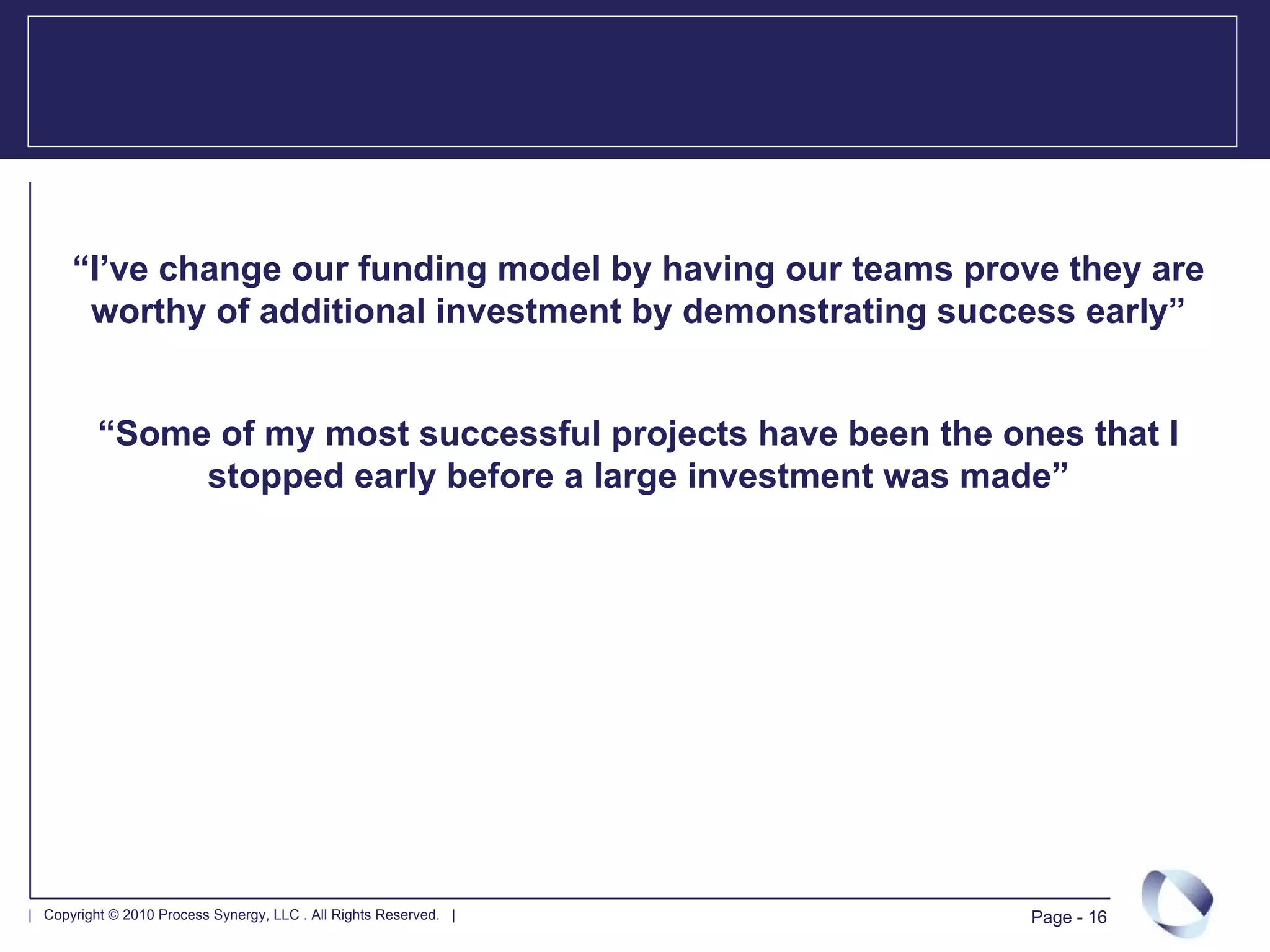

“I’ve change our funding model by having our teams prove they are
       worthy of additional investment by demonstrating success early”

          “Some of my most successful projects have been the ones that I
               stopped early before a large investment was made”

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 16

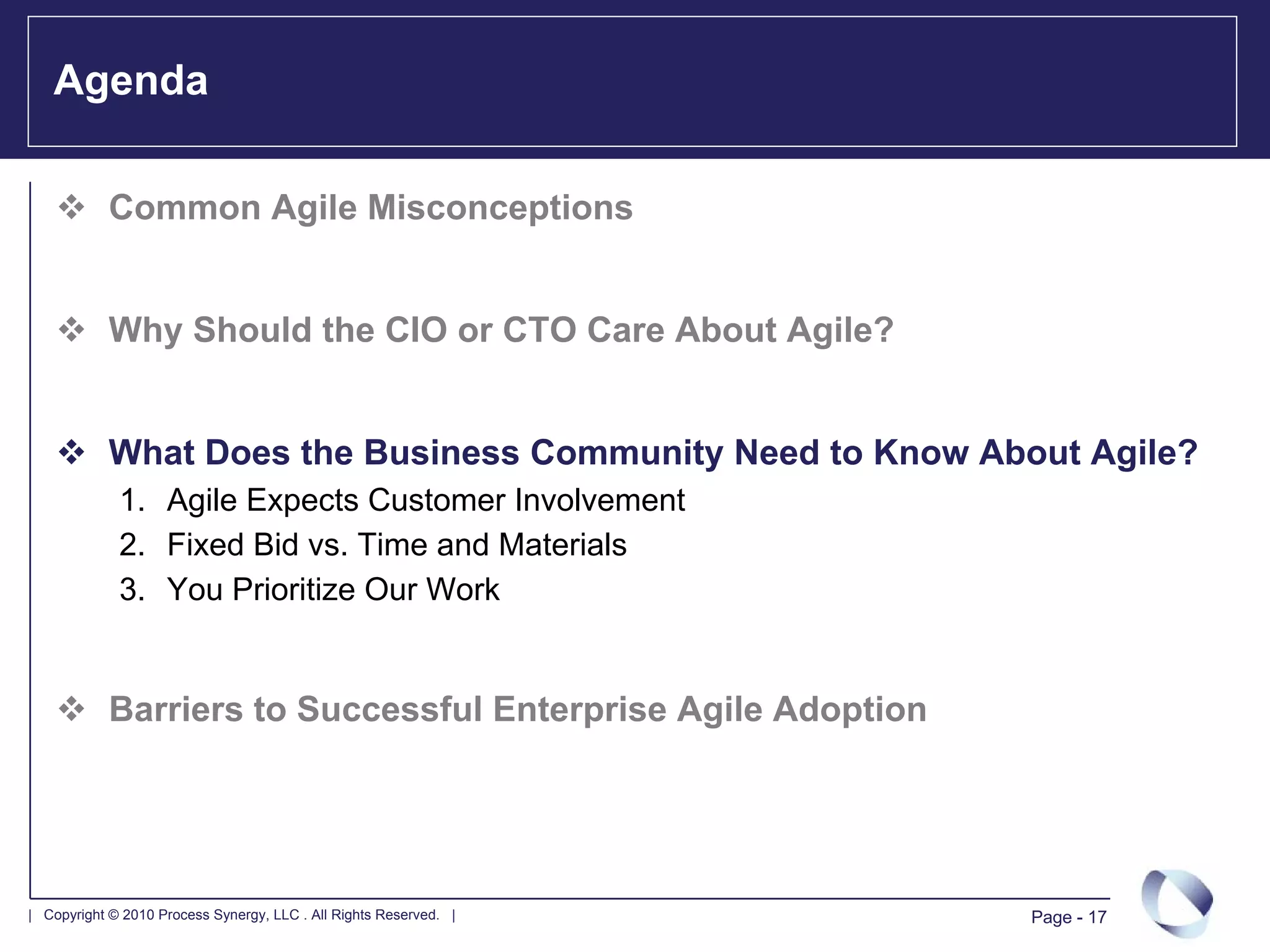

Agenda

            Common Agile Misconceptions

            Why Should the CIO or CTO Care About Agile?

            What Does the Business Community Need to Know About Agile?
             1. Agile Expects Customer Involvement
             2. Fixed Bid vs. Time and Materials

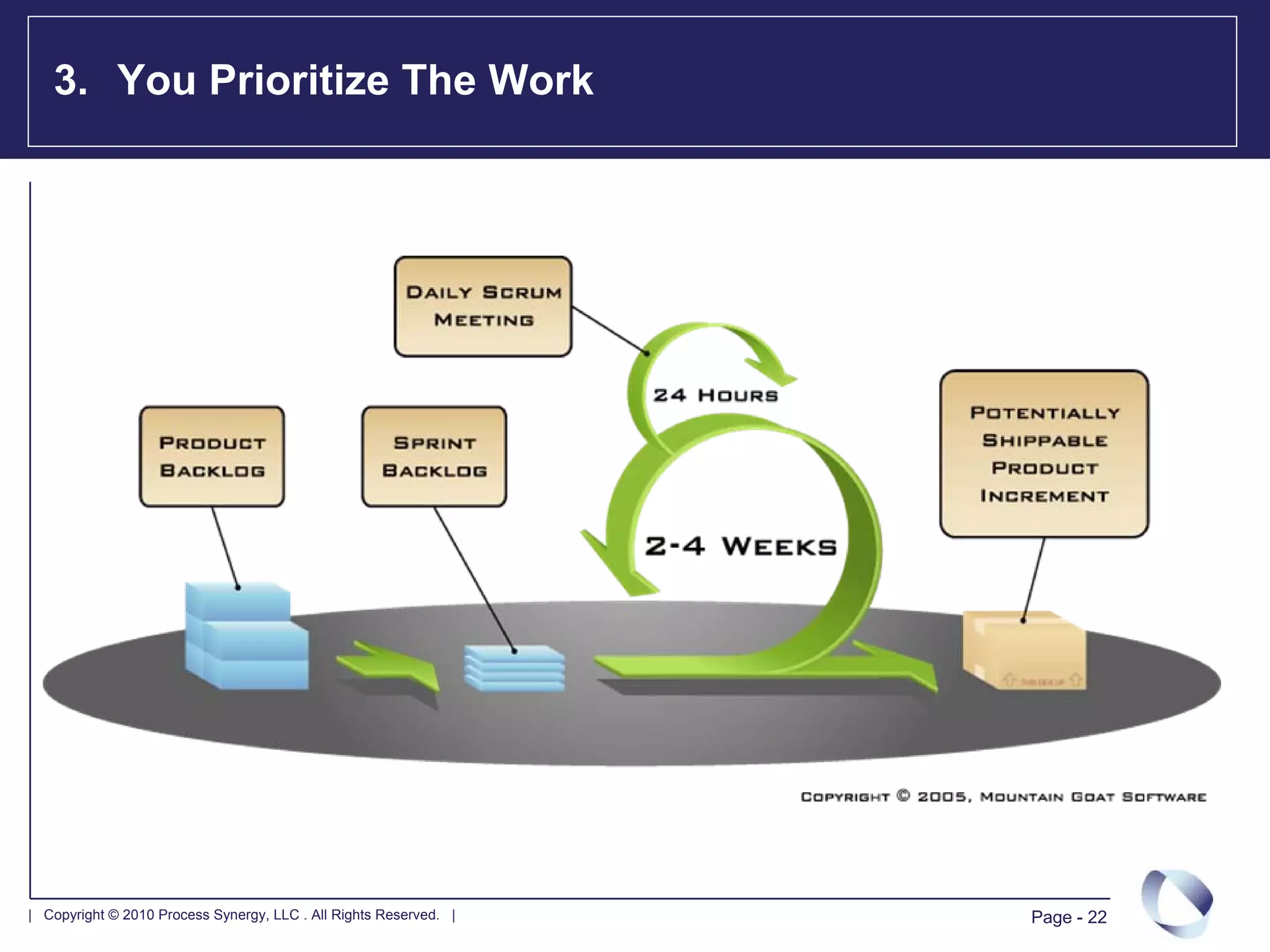

             3. You Prioritize Our Work

            Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 17
1. Agile Expects Customer Involvement

           Expect the customer or Product
           Owner to be involved with the team

           Ideally the product owner should be
           thought of as part of the team

           Scenario: Customer may say,
             – “Perfect, I really want to get this done”
                    » On this project, we physically co-located
                      the product owner with the team
             – “I want to be engaged but I don’t have
               enough time”
                    » On this project, the product owner
                      established “office hours” and the team
                      knew they could call on him during those
                      times
             – “Working with you isn’t my day job”
                    » On this project, the product owner was
                      unavailable with the exception of
                      possibly 30 minutes at the beginning or
                      end of day

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 18
1. Agile Expects Customer Involvement (cont.)

           Regardless of the scenario we need
           to be prepared to let our customer
           know our expectations for their time
           and the amount of involvement we
           will require of them

           We can let them know we will
           require them for
             – Product Backlog
             – Release & Sprint Planning
             – Review and Retrospective

           We can be creative with their
           involvement and work with them

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 19

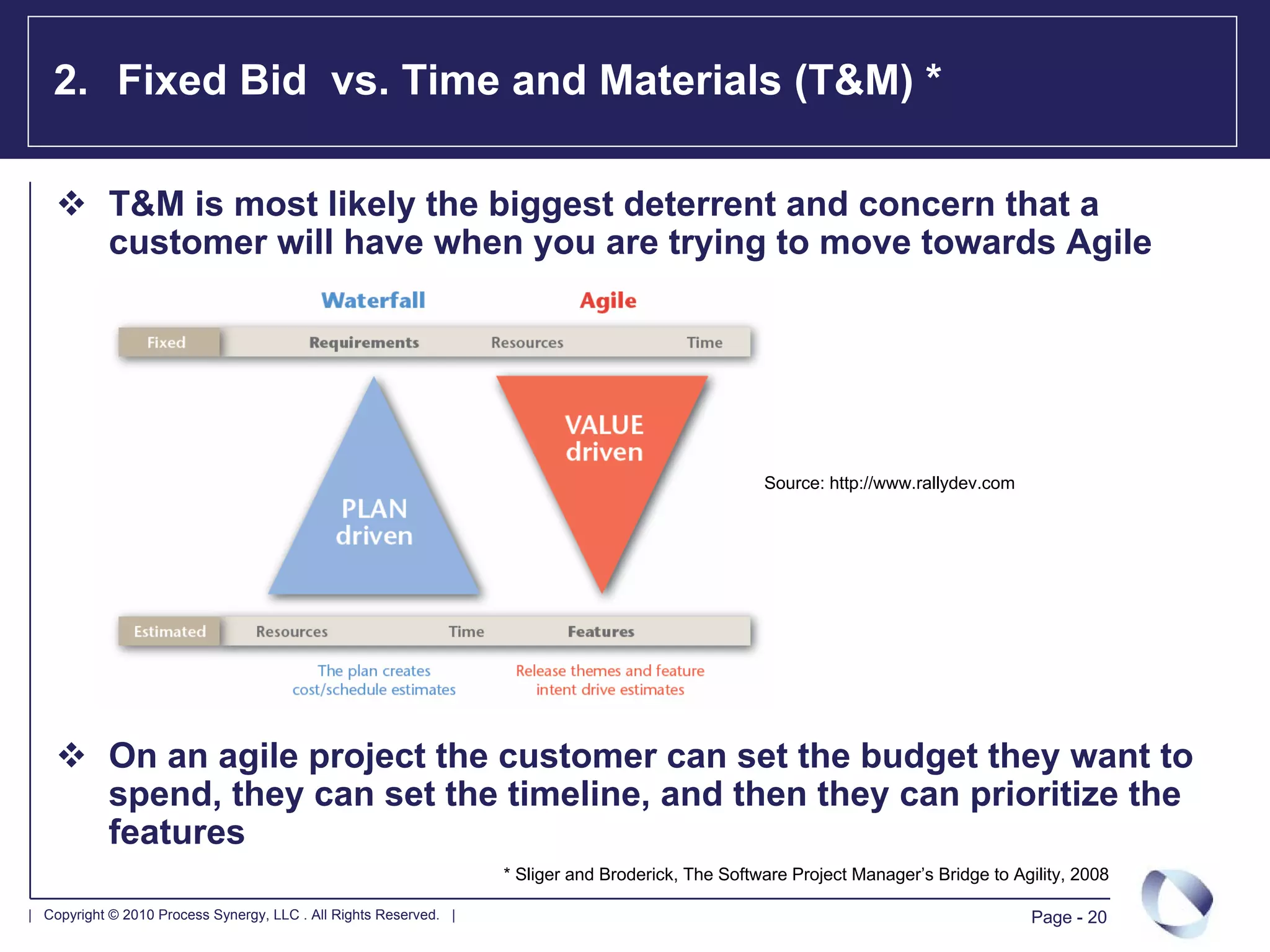

2. Fixed Bid vs. Time and Materials (T&M) *

            T&M is most likely the biggest deterrent and concern that a
            customer will have when you are trying to move towards Agile

                                                                                                    Source: http://www.rallydev.com

            On an agile project the customer can set the budget they want to
            spend, they can set the timeline, and then they can prioritize the
            features
                                                                   * Sliger and Broderick, The Software Project Manager’s Bridge to Agility, 2008

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                                                      Page - 20

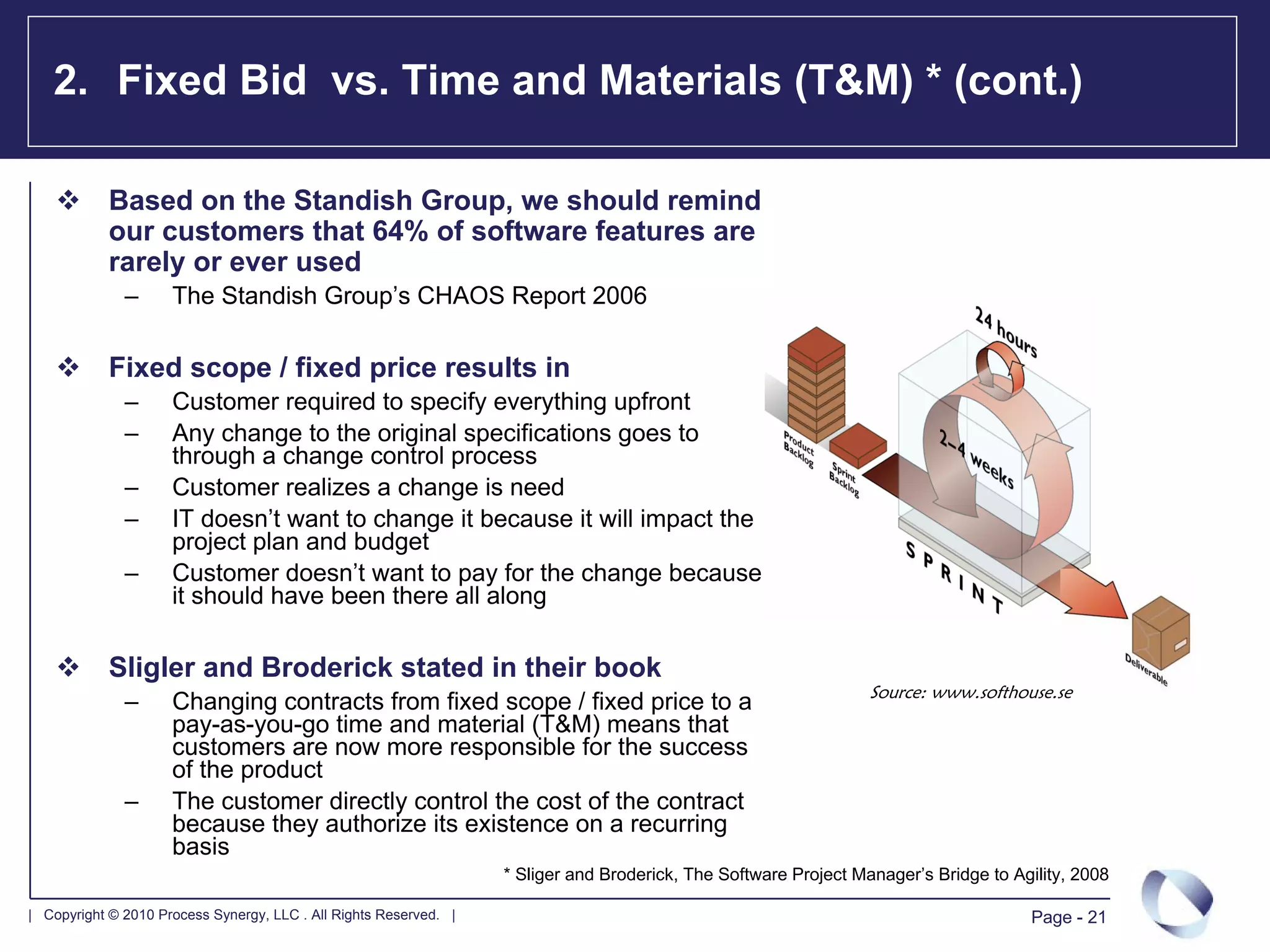

2. Fixed Bid vs. Time and Materials (T&M) * (cont.)

            Based on the Standish Group, we should remind
            our customers that 64% of software features are
            rarely or ever used
              –      The Standish Group’s CHAOS Report 2006

            Fixed scope / fixed price results in
              –      Customer required to specify everything upfront
              –      Any change to the original specifications goes to
                     through a change control process
              –      Customer realizes a change is need
              –      IT doesn’t want to change it because it will impact the
                     project plan and budget
              –      Customer doesn’t want to pay for the change because
                     it should have been there all along

            Sligler and Broderick stated in their book
                                                                                                                  Source: www.softhouse.se
              –      Changing contracts from fixed scope / fixed price to a
                     pay-as-you-go time and material (T&M) means that
                     customers are now more responsible for the success
                     of the product
              –      The customer directly control the cost of the contract
                     because they authorize its existence on a recurring
                     basis
                                                                   * Sliger and Broderick, The Software Project Manager’s Bridge to Agility, 2008

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                                                      Page - 21
3. You Prioritize The Work

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 22

You Prioritize The Work (cont.)

                      Product Backlog                              Sprint Backlog

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |              Page - 23
Agenda

           Common Agile Misconceptions

           Why Should the CIO or CTO Care About Agile?

           What Does the Business Community Need to Know About Agile?

           Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 24

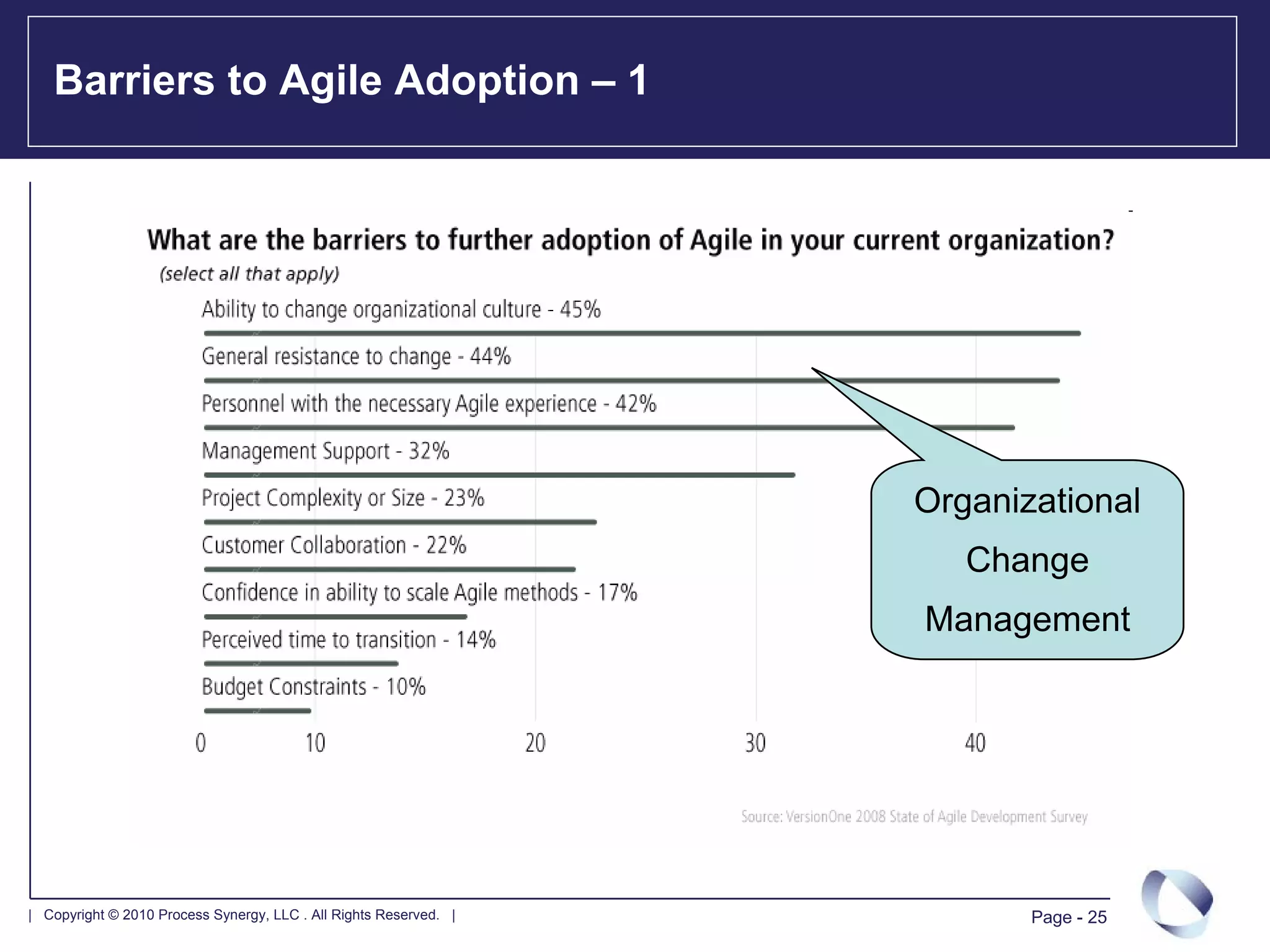

Barriers to Agile Adoption – 1

                                                                   Organizational
                                                                      Change
                                                                   Management

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |          Page - 25

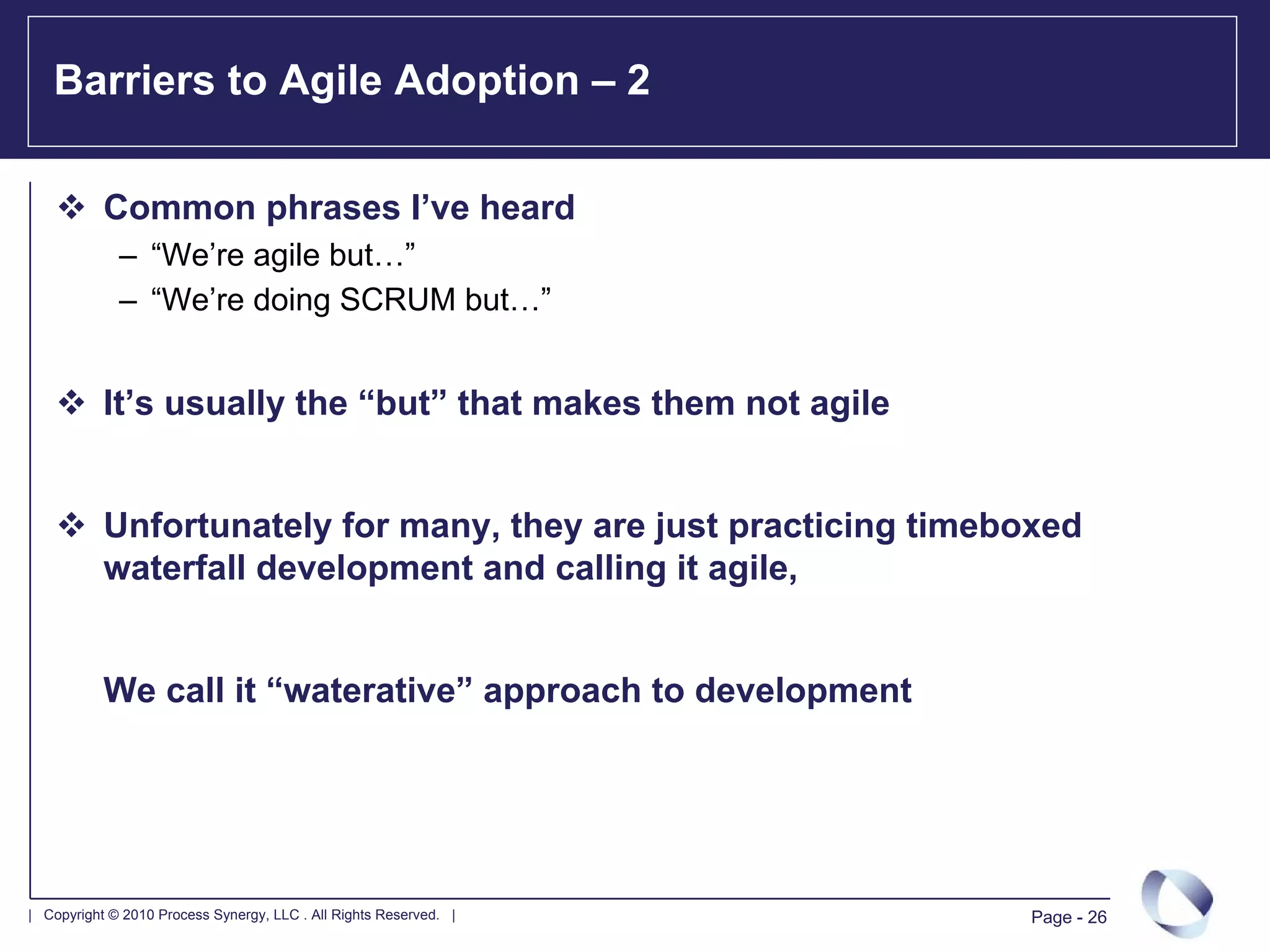

Barriers to Agile Adoption – 2

           Common phrases I’ve heard
             – “We’re agile but…”
             – “We’re doing SCRUM but…”

           It’s usually the “but” that makes them not agile

           Unfortunately for many, they are just practicing timeboxed
           waterfall development and calling it agile,

           We call it “waterative” approach to development

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 26
Agenda

           Common Agile Misconceptions

           Why Should the CIO or CTO Care About Agile?

           What Does the Business Community Need to Know About Agile?

           Barriers to Successful Enterprise Agile Adoption

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 27
For More Information

           If you have questions, or would like more information about our
           consulting, coaching, and agile training curriculum:

             – Please call 1.610.831.1151

             – Email: bill@ProcessSynergy.com

             – http://www.ProcessSynergy.com

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 28
In Closing…

                            “Whether you think that you can, or that you can't,
                                  you are usually right” – Henry Ford

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |             Page - 29
Agile, IT, and the Business Community

                       Presented by:

                     William F. Nazzaro
                      Vice President
                   Process Synergy, LLC
                  bill@ProcessSynergy.com
                        (610) 831-1151
                                            Version 1.00
Additional Supporting Material

                                 Version 1.00
Agile Manifesto *

        "We are uncovering better ways of developing software by doing it
        and helping others do it. Through this work we have come to value:

                         Individuals and interactions over processes and tools
                         Working software over comprehensive documentation
                         Customer collaboration over contract negotiation
                         Responding to change over following a plan

        That is, while there is value in the items on the right, we value items
        on the left more."
                                                                                       * www.agilemanifesto.org

                      The Agile Manifesto, created in 2001 by a group of software methodologists,
                       produced the agile revolution that has significantly impacted the software
                                  development industry in a very short period of time

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                        Page - 32

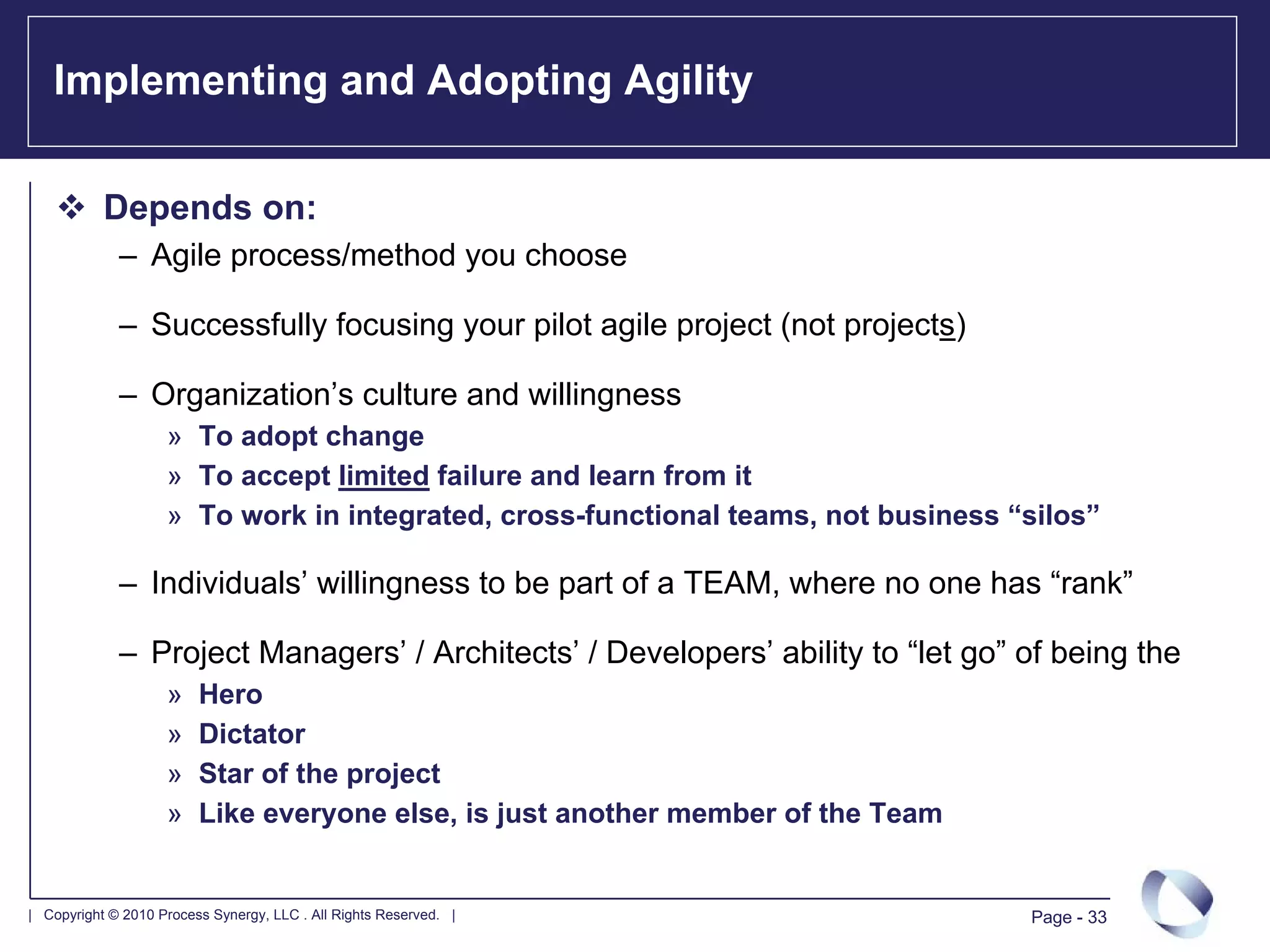

Implementing and Adopting Agility

           Depends on:
             – Agile process/method you choose

             – Successfully focusing your pilot agile project (not projects)

             – Organization’s culture and willingness
                    » To adopt change
                    » To accept limited failure and learn from it
                    » To work in integrated, cross-functional teams, not business “silos”

             – Individuals’ willingness to be part of a TEAM, where no one has “rank”

             – Project Managers’ / Architects’ / Developers’ ability to “let go” of being the
                    »    Hero
                    »    Dictator
                    »    Star of the project
                    »    Like everyone else, is just another member of the Team

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                   Page - 33

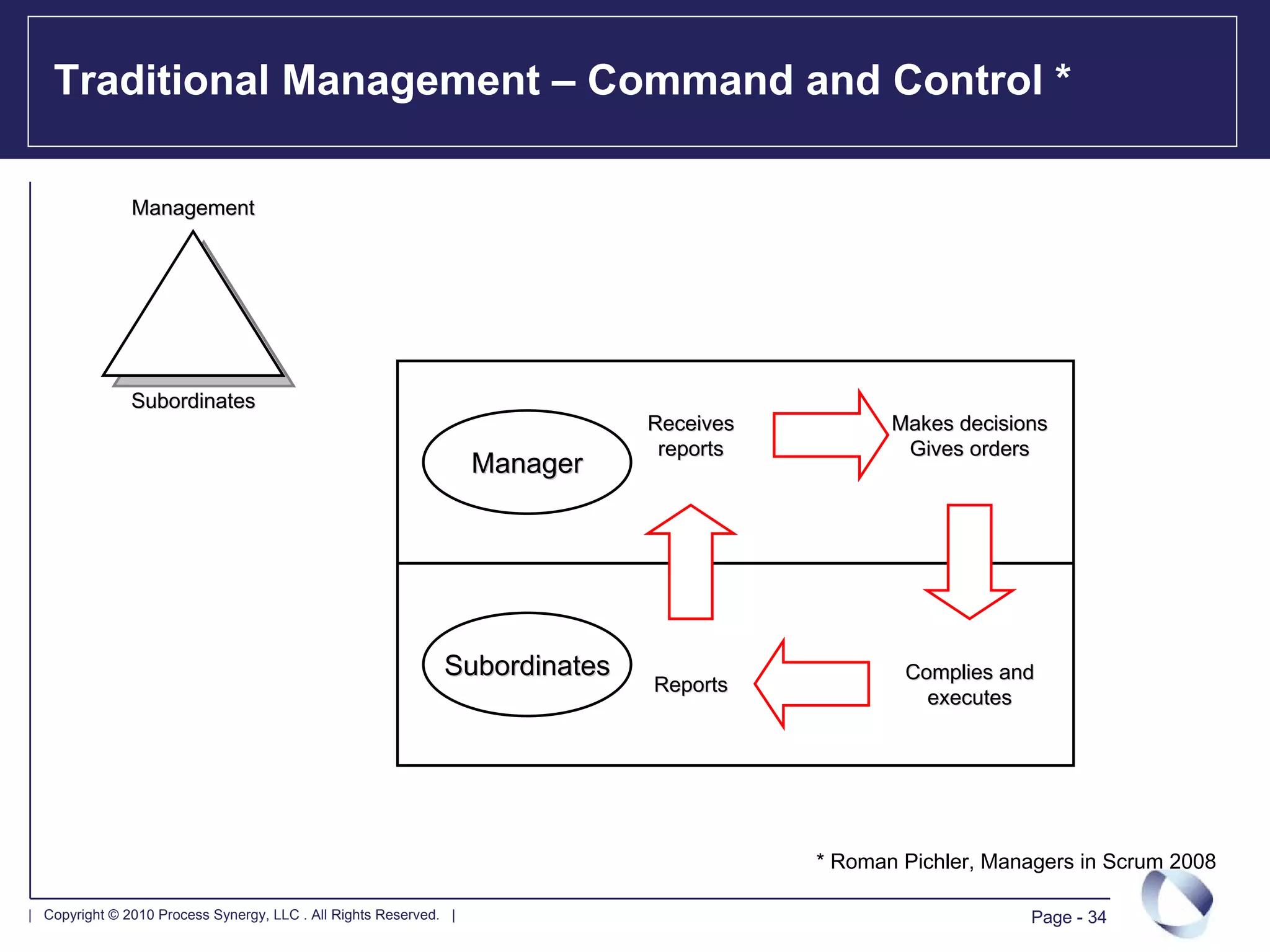

Traditional Management – Command and Control *

               Management

               Subordinates
                                                                             Receives          Makes decisions
                                                                              reports           Gives orders
                                                                   Manager

                                                              Subordinates                      Complies and
                                                                             Reports
                                                                                                  executes

                                                                                        * Roman Pichler, Managers in Scrum 2008

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                            Page - 34
Agile Management – Agile Leadership Principles *

                    Team

                                                                       Servant-
                                                                      Servant-
                                                                      Leadership
                                                                     Leadership

               Management                          Empirical
                                                  Empirical                                Empowerment
                                                                                          Empowerment
                                                 Management
                                                 Management

                                                       Quality-
                                                       Quality-                              Continuous
                                                                                            Continuous
                                                         First
                                                        First                               Improvement
                                                                                           Improvement

                                                                    Standardisation
                                                                   Standardisation

                                                                                   * Roman Pichler, Managers in Scrum 2008

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                       Page - 35
Agile Doesn’t Work For Matrixed Teams Or Organizations – 1

           Matrixed teams are created by pulling a variety of
           different resources from resource managers and
           these resources are allocated to a project manager
           while working on that project

           I’m actually fine with this concept of matrixed if
           that’s all we did and Agile does work if that’s all we
           did

           However, we usually go way beyond this

           We’ve mutated the concept of matrix into time-
           slicing to gain maximum efficiency of resources
             – Bill and Patty are each allocated 50% to project A and
               50% to production support
                                          – OR –
             – Rick is allocated to four projects and each project is
               expecting that he is available to work 35% on their project
               (OK, who’s checking the math here?)

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |             Page - 36
Agile Doesn’t Work For Matrixed Teams Or Organizations – 2

           What’s an interruption?
             1. To break the continuity,
             2. To hinder or stop the action of (someone) by breaking in on,
             3. To break in on an action

           Why am I not a fan of time-slicing?
             – If you're being interrupted while working on a task you’re losing time
             – For a simple IM or telephone call Microsoft 1 found it took their workers 15
               minutes to get back into the task whenever they were interrupted
             – The impact of changing projects is even greater, every time you're have a
               context switch, it takes even longer to remember not just the task but why
               you were working on the task
             – Studies have shown that productivity can be hindered by as much as 40% 2

                                                                   1 Microsoft – “The Grand Seduction of Multitasking”
                                                                   2   Mike Cohn – “The Dark Side of Multi-Tasking

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |                                          Page - 37
Agile Doesn’t Work For Non Co-located Teams – 1

            To be truthful, agility can be more
            difficult for teams that aren’t co-
            located because of the expectation to
            communicate more

            So how can we over come this?

            We have to be more creative
             –      Shifting of hours or work schedules to
                    create an opportunity for overlap
             –      Leveraging a variety of communication
                    tools (e.g., GoogleTalk, IM, Wikis, virtual
                    team rooms, digital cameras, etc.)

            Strive for purpose and value-driven
            communication

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 38
Agile Doesn’t Work For Non Co-located Teams – 2

            When hiring team members stress their
            ability to be able to communicate

            Communication is more than just
            talking, it can also be
             –      How to express an idea (i.e., Textual, UML,
                    Architecturally, code)
             –      Do they seek to be understood or to
                    understand
             –      How do they listen?

            Ironically, teams that don’t
            communicate very well that are co-
            located are the first to mention that
            agile won’t work for teams that aren’t
            co-located

| Copyright © 2010 Process Synergy, LLC . All Rights Reserved. |   Page - 39

Agile, IT and the Business Community

  • 1.
    Agile, IT, andthe Business Community Presented by: William F. Nazzaro Vice President Process Synergy, LLC bill@ProcessSynergy.com (610) 831-1151 Version 1.00
  • 2.
    Process Synergy Background A Philadelphia-based consultancy dedicated to the highest-quality delivery of project mentoring, training and organizational transformation Full lifecycle consulting, coaching and mentoring – Requirements – Use Cases, User-Stories, IIBA – Process – Agile (XP, TDD), Unified Process, CMMi – Project Management – Scrum, Iterative, PMI – Architecture – Service-Oriented Architecture – Organizational Change Management and Improvement – Delivered On-Site, Globally Full lifecycle software training curriculum – Highly differentiated offerings – Experiential approach and skills building – Virtual and on-site Multi-tool vendor expertise – IBM Rational, Microsoft, Borland, HP Mercury, BluePrint, VersionOne, RallyDev | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 2
  • 3.
    Presenter’s Background Twenty years of success in delivering enterprise software solutions for Fortune 100 companies, he has provided unparalleled services in project mentoring, use case and user story training and modeling, agile SCRUM, XP, TDD, service- oriented architecture, Unified Process and CMMi adoption, Java, C++, C, and Smalltalk programming languages, and technical curriculum development and delivery. His pragmatic emphasis on project execution and process improvement has benefited major insurance, health-care, human resources, stock market organizations and Department of Defense where he has enabled the transformation of their corporate development processes and development teams of diverse skill- levels. He has provided in-depth talks on Agility, Use Case Modeling, Service-Oriented Architecture, Unified Process, Object Technology and Data Modeling. He has extensive background in project management, and has successfully led teams on multi-million dollar projects to provide the highest-quality technical solutions in the most efficient and effective manner. | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 3
  • 4.
    Premise IT projects are failing at a rate of 25%, and 45% of our projects are challenged for being late, over-budget, or providing less than required features and functions Unfortunately this has been a habitual problem for IT and more importantly it has been a source of conflict and contention between IT and the business community we serve Our business community, more than ever, demands speed and flexibility in taking products to market. As a result, approximately 35% of IT organizations have adopted or are in some form of adoption of agile practices and agile software development | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 4
  • 5.
    Agenda Common Agile Misconceptions Why Should the CIO or CTO Care About Agile? What Does the Business Community Need to Know About Agile? Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 5
  • 6.
    Agenda Common Agile Misconceptions 1. Agile Teams Don’t Plan or Estimate 2. Agile Only Works for Co-Located Teams Why Should the CIO or CTO Care About Agile? What Does the Business Community Need to Know About Agile? Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 6
  • 7.
    1. Agile TeamsDon’t Plan or Estimate – 1 Why do we plan? My one client told me she wanted to – Reduce risk and uncertainty get away from the way they ran their – Support decision making traditional projects – Establish trust – We spend time planning and estimating at the beginning of the project – Convey information – We commit to this project plan and estimate at the beginning of the project A good plan is one that support – We know, and our customer knows, the reliable decision making plan and estimate are incorrect – Historical data verifies we are typically incorrect on our plan and estimate Steve McConnell, Software Estimation, 2006 – We move forward with the expectation that the information is correct – We are disappointed and our customer is upset when we fail to deliver based on our initial plan and estimate | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 7
  • 8.
    1. Agile TeamsDon’t Plan or Estimate – 2 Somewhere along the line a belief cropped up that Agile projects don’t do planning or estimating Agile teams This is a MYTH, in fact I’ve found I’ve typical focus Release done more planning and estimating it’s just that I plan to certain horizons Iteration There are different levels of planning Day – Release planning determines the scope, schedule, and resources needed for a product – Iteration planning determines which features will be built in an iteration, and what tasks need to be done to build them – Day planning monitors progress and deal Planning Onion – Mike Cohn, with obstacles Agile Estimating and Planning, 2006 We plan and estimate to our horizon, then we inspect and adapt | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 8
  • 9.
    2. Agile OnlyWorks for Co-Located Teams – 1 To be truthful, agility can be more difficult for teams that aren’t co- located because of the expectation to communicate more So how can we over come this? We have to be more creative – Shifting of hours or work schedules to create an opportunity for overlap – Leveraging a variety of communication tools (e.g., GoogleTalk, IM, Wikis, virtual team rooms, digital cameras, etc.) Strive for purpose and value-driven communication | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 9
  • 10.
    2. Agile OnlyWorks for Co-Located Teams – 2 When hiring team members stress their ability to be able to communicate Communication is more than just talking, it can also be – How to express an idea (i.e., Textual, UML, Architecturally, code) – Do they seek to be understood or to understand – How do they listen? Ironically, teams that don’t communicate very well that are co- located are the first to mention that agile won’t work for teams that aren’t co-located | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 10
  • 11.
    Agenda Common Agile Misconceptions Why Should the CIO or CTO Care About Agile? 1. Traditional vs. Agile Processes 2. Traditional vs. Agile Budgeting 3. Some Numbers to Consider 1. What Does the Business Community Need to Know About Agile? 2. Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 11
  • 12.
    Traditional vs. AgileProcesses * – 1 Traditional Processes – Lockup capital for a long time by having significant work in process before seeing any realization of business value Agile Processes – By releasing incrementally we open up the opportunity to obtain business value much earlier than would otherwise be possible and prior to the completion of the overall project – This can be done by breaking the project into "feature chunks" that are delivered every few weeks * Rudd, J. The Business Case for Agility, 2009 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 12
  • 13.
    Traditional vs. AgileProcesses – 2 Project halted % Working Software Agile IT Process 1 2 3 4 5 6 7 8 9 10 11 12 Month % Working Software Traditional IT Process 1 2 3 4 5 6 7 8 9 10 11 12 Month | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 13
  • 14.
    Traditional vs. AgileBudgeting * Traditional Processes – With a fixed capital budget, larger projects mean fewer projects – When no return is available until the waterfall process is complete, longer projects increase the likelihood that no return will be obtained during the annual budget cycle – This leads to fewer investments and limited opportunity to offset losing projects with winning projects Agile Processes – With an Agile portfolio approach, the business can break down long-term projects into short-term projects – This provides more frequent opportunities to both evaluate and adjust investments so that you can: » Adjust portfolio on the basis of market changes and customer feedback » Actively reprioritize the project portfolio. » Reallocate funds to stronger performers. * Rudd, J. The Business Case for Agility, 2009 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 14
  • 15.
    Some Numbers ToConsider * 93% increased productivity 1 88% increased quality 1 83% improved stakeholder satisfaction 1 49% reduced costs 1 66% three-year, risk-adjusted return on investment 2 Reasons for Agile adoption include: – 47% to better manage project scope 3 – 45% to create clear business requirements 3 1 “Agile Methodologies: Survey Results”, Shine Technologies, 2003 2 Forrester Research, 2004 – 40% to speed or better predict time to 3 “Agile 2006 Survey Results and Analysis”, Digital Focus, 2005 market 3 * Source: http://www.rallydev.com | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 15
  • 16.
    “I’ve change ourfunding model by having our teams prove they are worthy of additional investment by demonstrating success early” “Some of my most successful projects have been the ones that I stopped early before a large investment was made” | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 16
  • 17.
    Agenda Common Agile Misconceptions Why Should the CIO or CTO Care About Agile? What Does the Business Community Need to Know About Agile? 1. Agile Expects Customer Involvement 2. Fixed Bid vs. Time and Materials 3. You Prioritize Our Work Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 17
  • 18.
    1. Agile ExpectsCustomer Involvement Expect the customer or Product Owner to be involved with the team Ideally the product owner should be thought of as part of the team Scenario: Customer may say, – “Perfect, I really want to get this done” » On this project, we physically co-located the product owner with the team – “I want to be engaged but I don’t have enough time” » On this project, the product owner established “office hours” and the team knew they could call on him during those times – “Working with you isn’t my day job” » On this project, the product owner was unavailable with the exception of possibly 30 minutes at the beginning or end of day | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 18
  • 19.
    1. Agile ExpectsCustomer Involvement (cont.) Regardless of the scenario we need to be prepared to let our customer know our expectations for their time and the amount of involvement we will require of them We can let them know we will require them for – Product Backlog – Release & Sprint Planning – Review and Retrospective We can be creative with their involvement and work with them | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 19
  • 20.
    2. Fixed Bidvs. Time and Materials (T&M) * T&M is most likely the biggest deterrent and concern that a customer will have when you are trying to move towards Agile Source: http://www.rallydev.com On an agile project the customer can set the budget they want to spend, they can set the timeline, and then they can prioritize the features * Sliger and Broderick, The Software Project Manager’s Bridge to Agility, 2008 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 20
  • 21.
    2. Fixed Bidvs. Time and Materials (T&M) * (cont.) Based on the Standish Group, we should remind our customers that 64% of software features are rarely or ever used – The Standish Group’s CHAOS Report 2006 Fixed scope / fixed price results in – Customer required to specify everything upfront – Any change to the original specifications goes to through a change control process – Customer realizes a change is need – IT doesn’t want to change it because it will impact the project plan and budget – Customer doesn’t want to pay for the change because it should have been there all along Sligler and Broderick stated in their book Source: www.softhouse.se – Changing contracts from fixed scope / fixed price to a pay-as-you-go time and material (T&M) means that customers are now more responsible for the success of the product – The customer directly control the cost of the contract because they authorize its existence on a recurring basis * Sliger and Broderick, The Software Project Manager’s Bridge to Agility, 2008 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 21
  • 22.
    3. You PrioritizeThe Work | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 22
  • 23.
    You Prioritize TheWork (cont.) Product Backlog Sprint Backlog | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 23
  • 24.
    Agenda Common Agile Misconceptions Why Should the CIO or CTO Care About Agile? What Does the Business Community Need to Know About Agile? Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 24
  • 25.
    Barriers to AgileAdoption – 1 Organizational Change Management | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 25
  • 26.
    Barriers to AgileAdoption – 2 Common phrases I’ve heard – “We’re agile but…” – “We’re doing SCRUM but…” It’s usually the “but” that makes them not agile Unfortunately for many, they are just practicing timeboxed waterfall development and calling it agile, We call it “waterative” approach to development | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 26
  • 27.
    Agenda Common Agile Misconceptions Why Should the CIO or CTO Care About Agile? What Does the Business Community Need to Know About Agile? Barriers to Successful Enterprise Agile Adoption | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 27
  • 28.
    For More Information If you have questions, or would like more information about our consulting, coaching, and agile training curriculum: – Please call 1.610.831.1151 – Email: bill@ProcessSynergy.com – http://www.ProcessSynergy.com | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 28
  • 29.
    In Closing… “Whether you think that you can, or that you can't, you are usually right” – Henry Ford | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 29
  • 30.
    Agile, IT, andthe Business Community Presented by: William F. Nazzaro Vice President Process Synergy, LLC bill@ProcessSynergy.com (610) 831-1151 Version 1.00
  • 31.
  • 32.
    Agile Manifesto * "We are uncovering better ways of developing software by doing it and helping others do it. Through this work we have come to value: Individuals and interactions over processes and tools Working software over comprehensive documentation Customer collaboration over contract negotiation Responding to change over following a plan That is, while there is value in the items on the right, we value items on the left more." * www.agilemanifesto.org The Agile Manifesto, created in 2001 by a group of software methodologists, produced the agile revolution that has significantly impacted the software development industry in a very short period of time | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 32
  • 33.
    Implementing and AdoptingAgility Depends on: – Agile process/method you choose – Successfully focusing your pilot agile project (not projects) – Organization’s culture and willingness » To adopt change » To accept limited failure and learn from it » To work in integrated, cross-functional teams, not business “silos” – Individuals’ willingness to be part of a TEAM, where no one has “rank” – Project Managers’ / Architects’ / Developers’ ability to “let go” of being the » Hero » Dictator » Star of the project » Like everyone else, is just another member of the Team | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 33
  • 34.
    Traditional Management –Command and Control * Management Subordinates Receives Makes decisions reports Gives orders Manager Subordinates Complies and Reports executes * Roman Pichler, Managers in Scrum 2008 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 34
  • 35.
    Agile Management –Agile Leadership Principles * Team Servant- Servant- Leadership Leadership Management Empirical Empirical Empowerment Empowerment Management Management Quality- Quality- Continuous Continuous First First Improvement Improvement Standardisation Standardisation * Roman Pichler, Managers in Scrum 2008 | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 35
  • 36.
    Agile Doesn’t WorkFor Matrixed Teams Or Organizations – 1 Matrixed teams are created by pulling a variety of different resources from resource managers and these resources are allocated to a project manager while working on that project I’m actually fine with this concept of matrixed if that’s all we did and Agile does work if that’s all we did However, we usually go way beyond this We’ve mutated the concept of matrix into time- slicing to gain maximum efficiency of resources – Bill and Patty are each allocated 50% to project A and 50% to production support – OR – – Rick is allocated to four projects and each project is expecting that he is available to work 35% on their project (OK, who’s checking the math here?) | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 36
  • 37.
    Agile Doesn’t WorkFor Matrixed Teams Or Organizations – 2 What’s an interruption? 1. To break the continuity, 2. To hinder or stop the action of (someone) by breaking in on, 3. To break in on an action Why am I not a fan of time-slicing? – If you're being interrupted while working on a task you’re losing time – For a simple IM or telephone call Microsoft 1 found it took their workers 15 minutes to get back into the task whenever they were interrupted – The impact of changing projects is even greater, every time you're have a context switch, it takes even longer to remember not just the task but why you were working on the task – Studies have shown that productivity can be hindered by as much as 40% 2 1 Microsoft – “The Grand Seduction of Multitasking” 2 Mike Cohn – “The Dark Side of Multi-Tasking | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 37
  • 38.
    Agile Doesn’t WorkFor Non Co-located Teams – 1 To be truthful, agility can be more difficult for teams that aren’t co- located because of the expectation to communicate more So how can we over come this? We have to be more creative – Shifting of hours or work schedules to create an opportunity for overlap – Leveraging a variety of communication tools (e.g., GoogleTalk, IM, Wikis, virtual team rooms, digital cameras, etc.) Strive for purpose and value-driven communication | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 38
  • 39.
    Agile Doesn’t WorkFor Non Co-located Teams – 2 When hiring team members stress their ability to be able to communicate Communication is more than just talking, it can also be – How to express an idea (i.e., Textual, UML, Architecturally, code) – Do they seek to be understood or to understand – How do they listen? Ironically, teams that don’t communicate very well that are co- located are the first to mention that agile won’t work for teams that aren’t co-located | Copyright © 2010 Process Synergy, LLC . All Rights Reserved. | Page - 39
