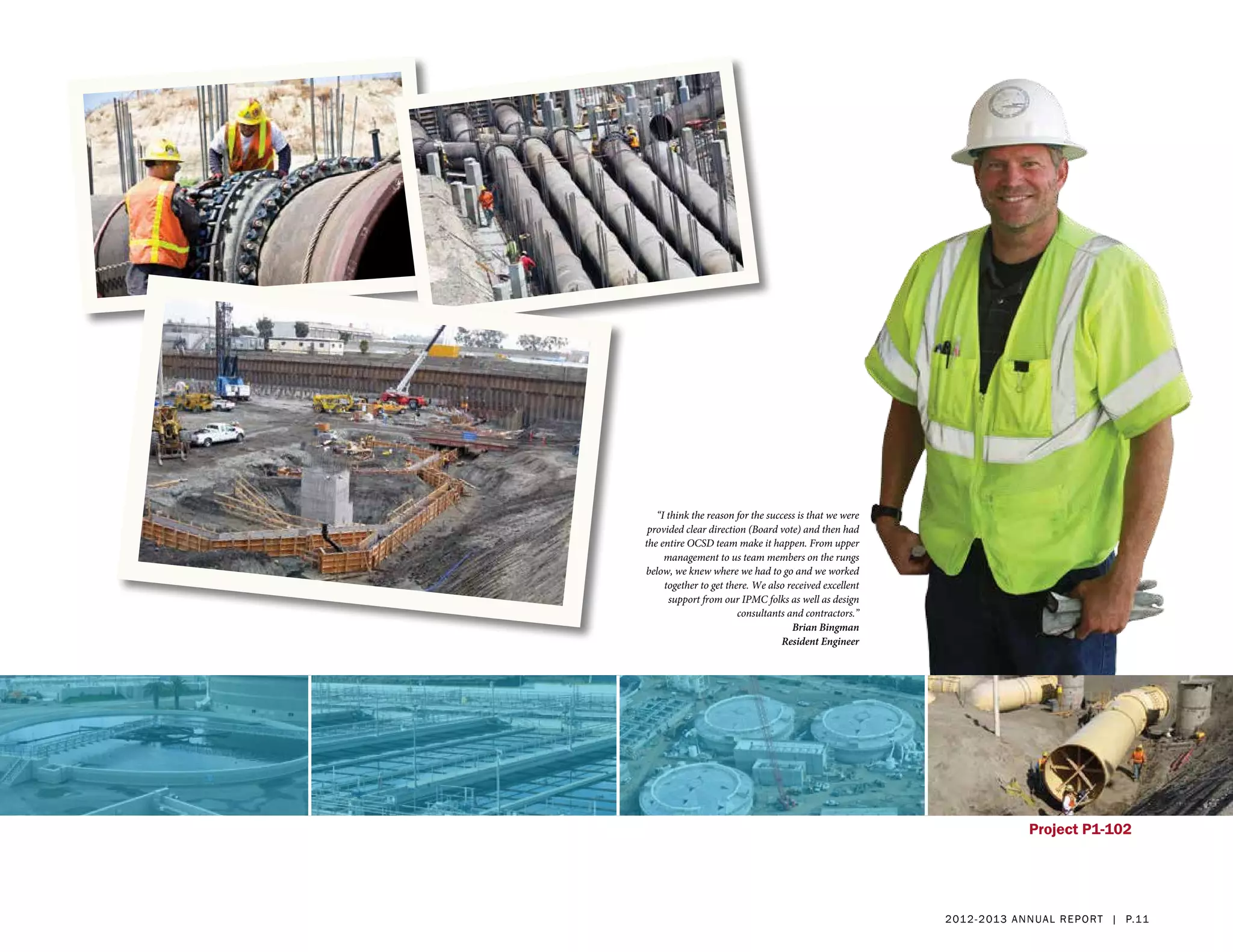

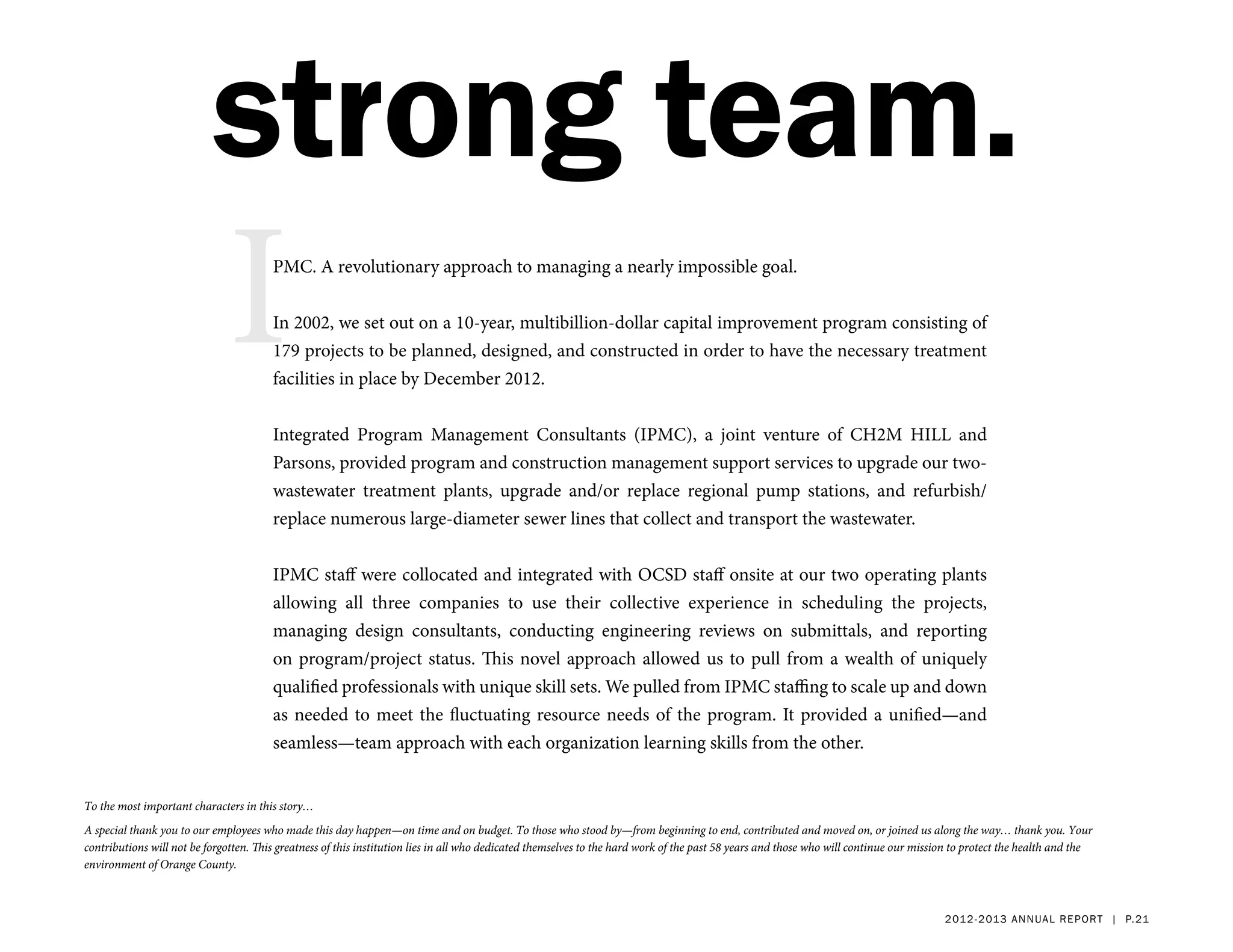

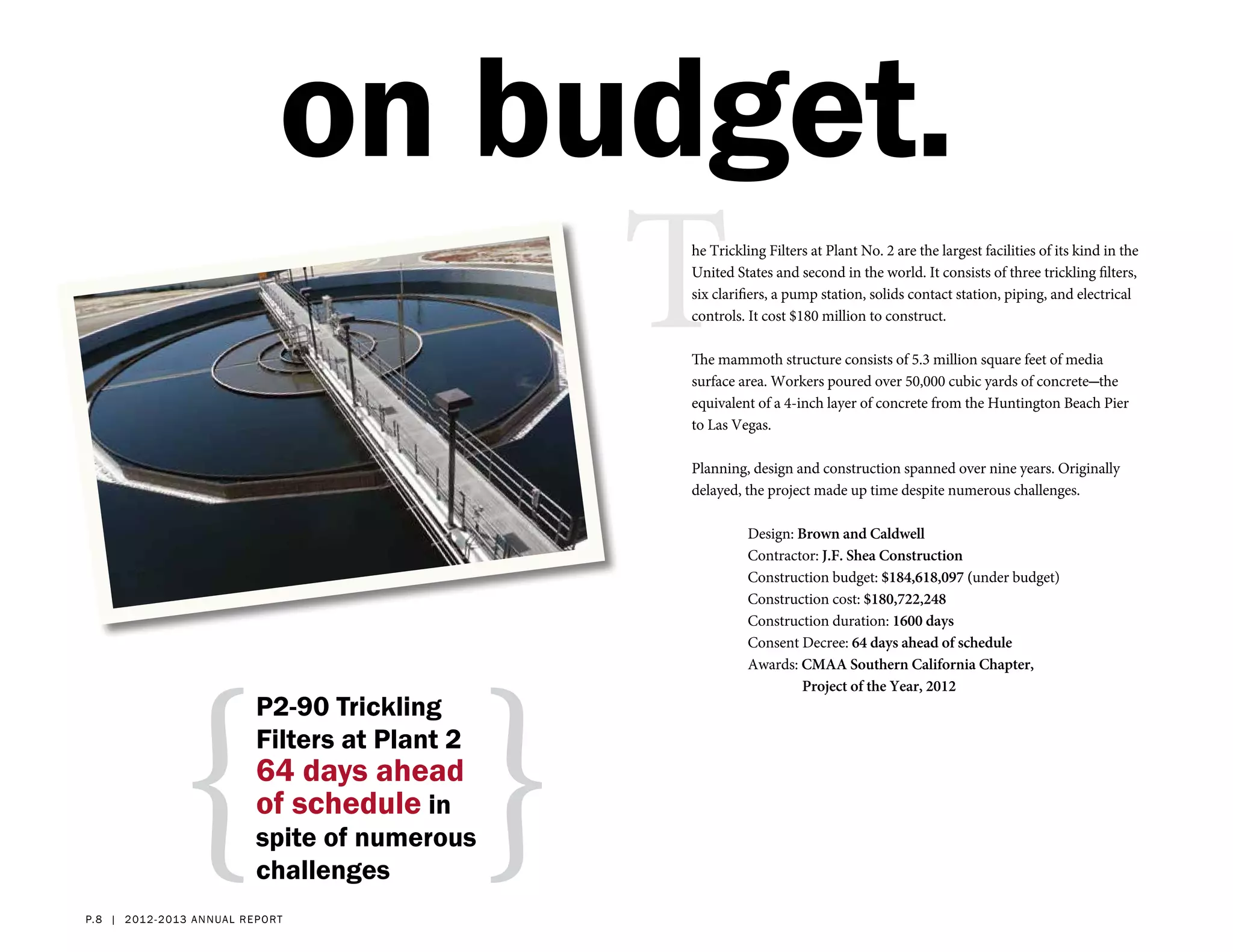

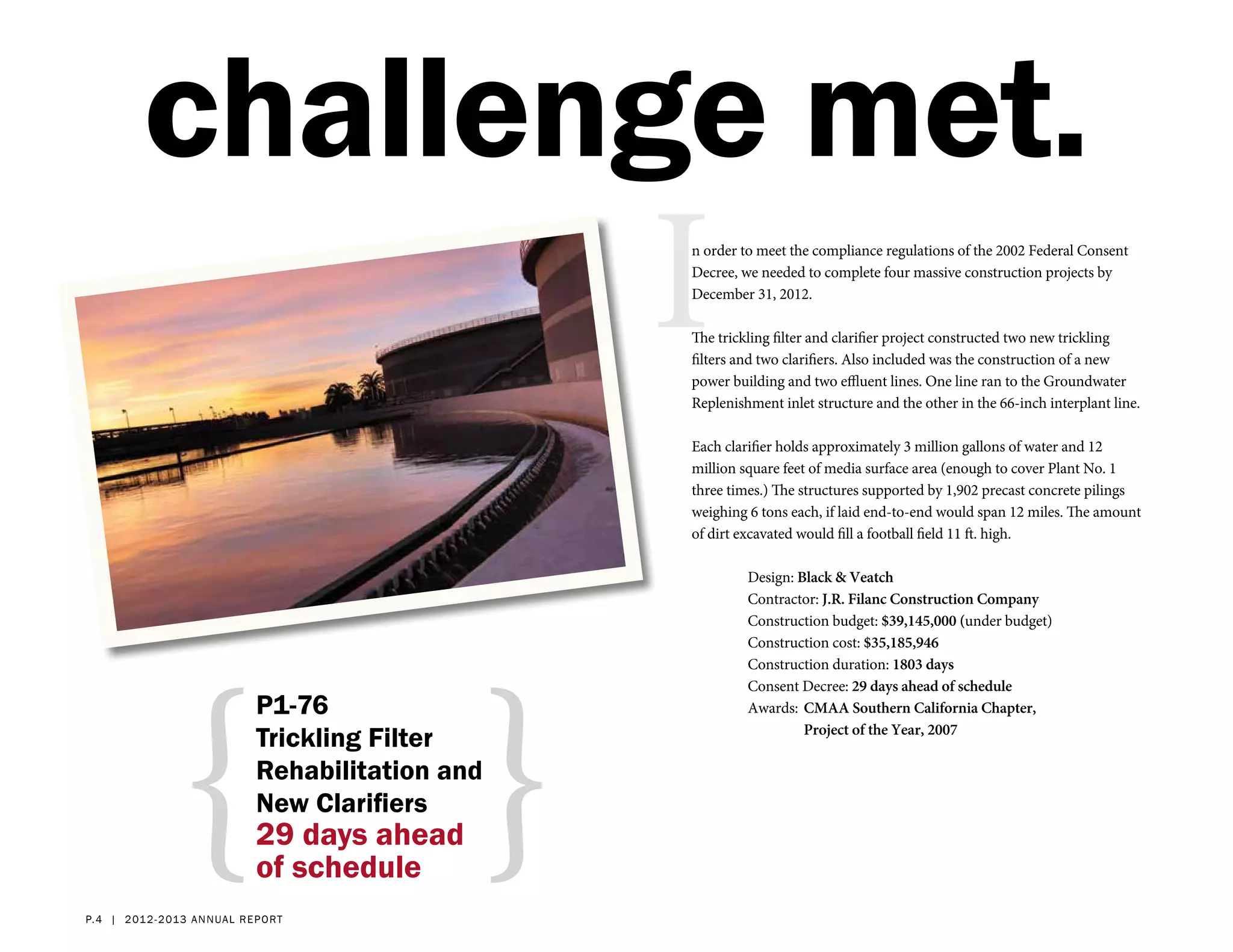

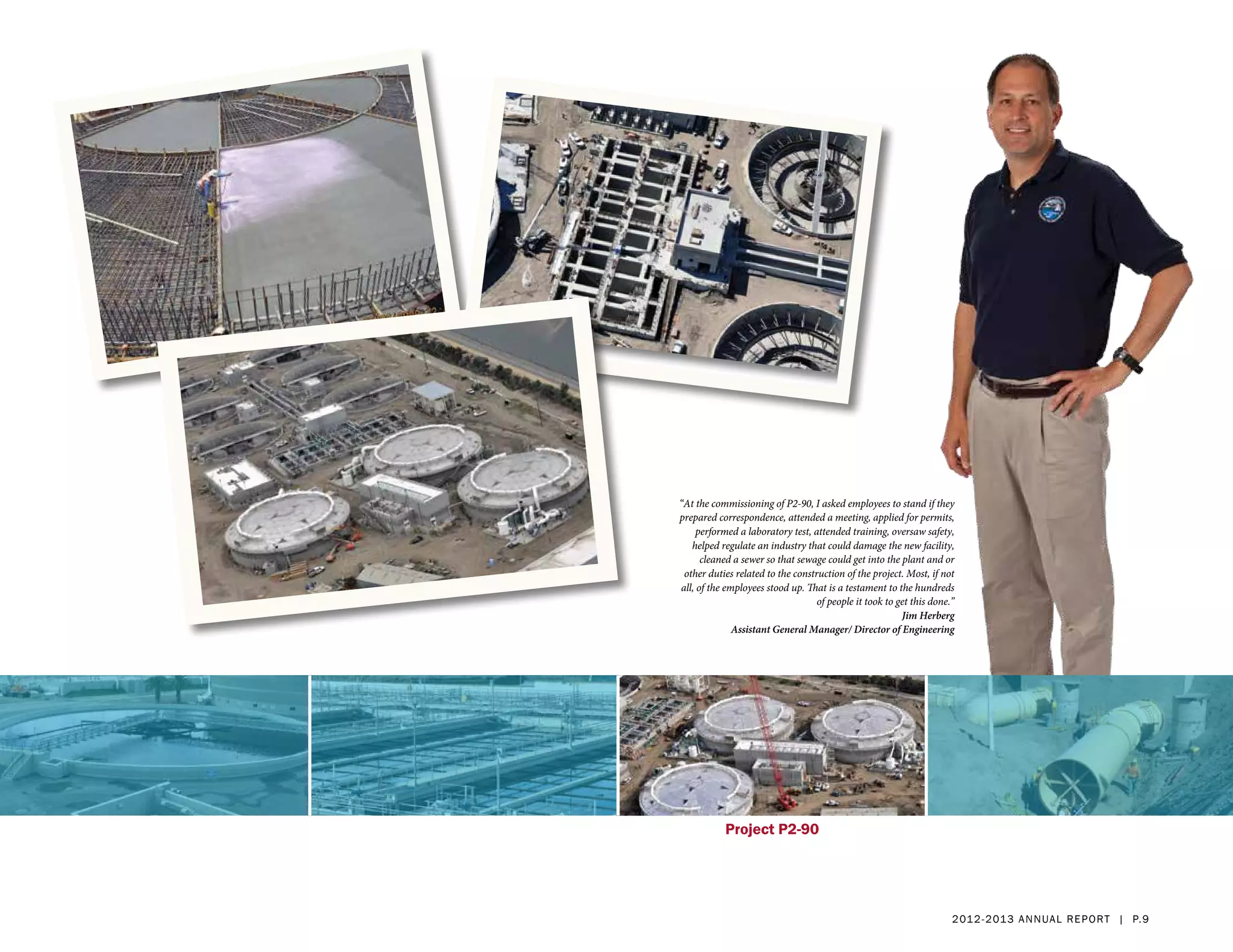

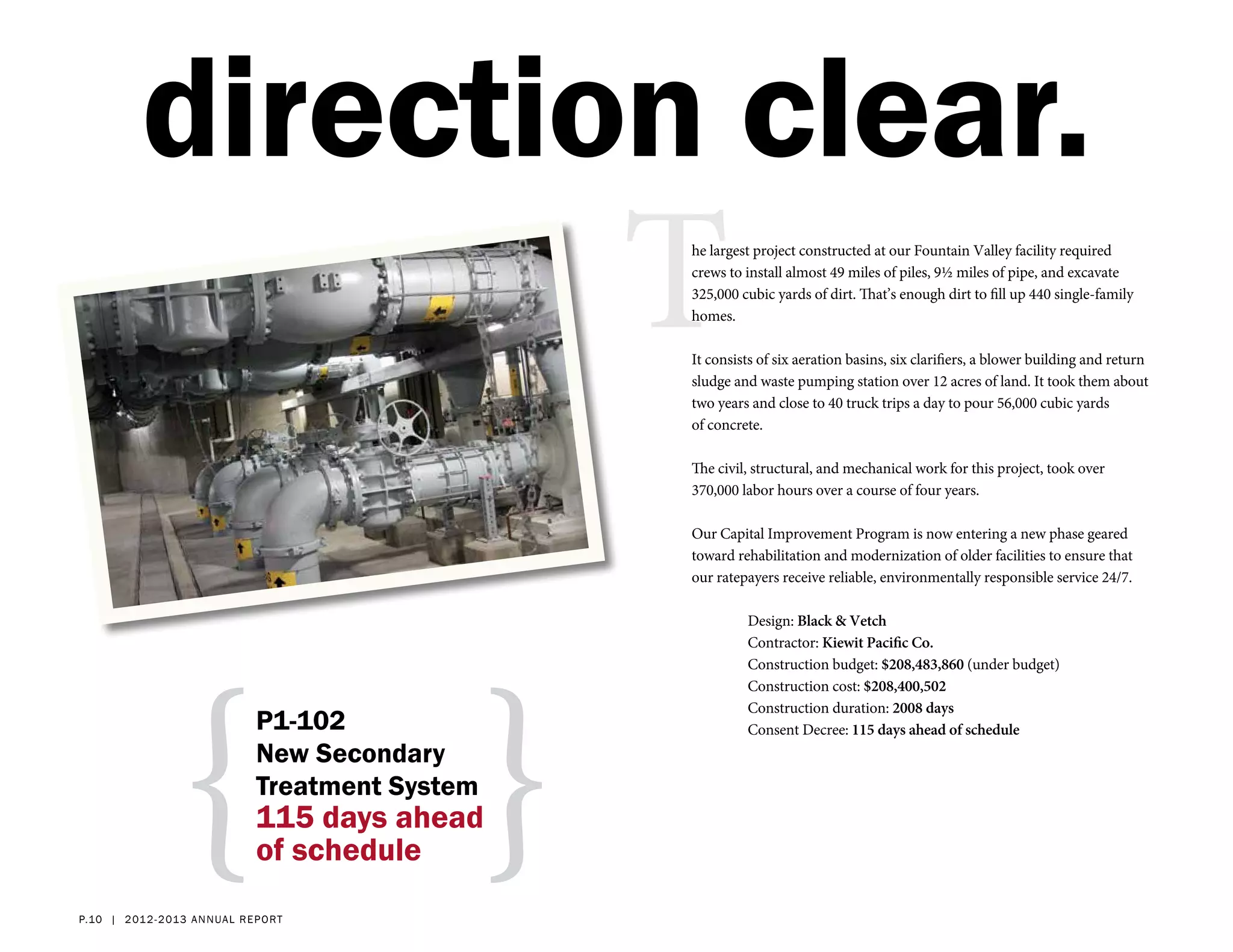

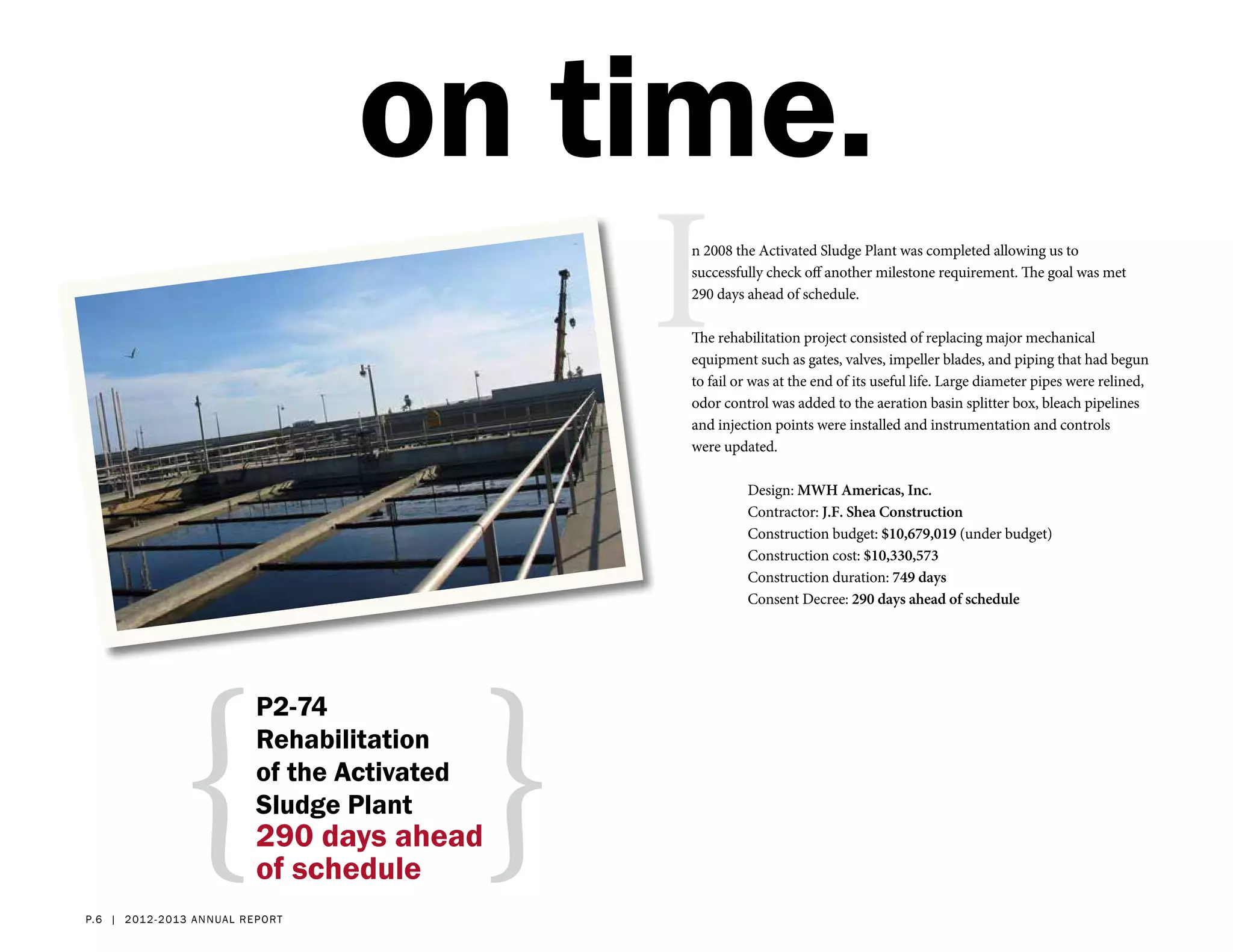

On July 17, 2002, the Orange County Sanitation District Board of Directors voted to change course and provide full secondary treatment of wastewater by December 31, 2012. Over the next 10 years, the District completed four massive construction projects on time and under budget to meet this goal. By the end of 2012, the District had kept its promise to taxpayers by upgrading all of its treatment facilities to provide full secondary treatment.
