Affinion Group: increasing ROI by extending
HP Project and Portfolio Management Center
across all business units
Affinion Group – Patrick Figliola

Results Positive – Jon Furner, President

1   ©2010 Hewlett-Packard Development Company, L.P. The information contained herein is subject to change without notice

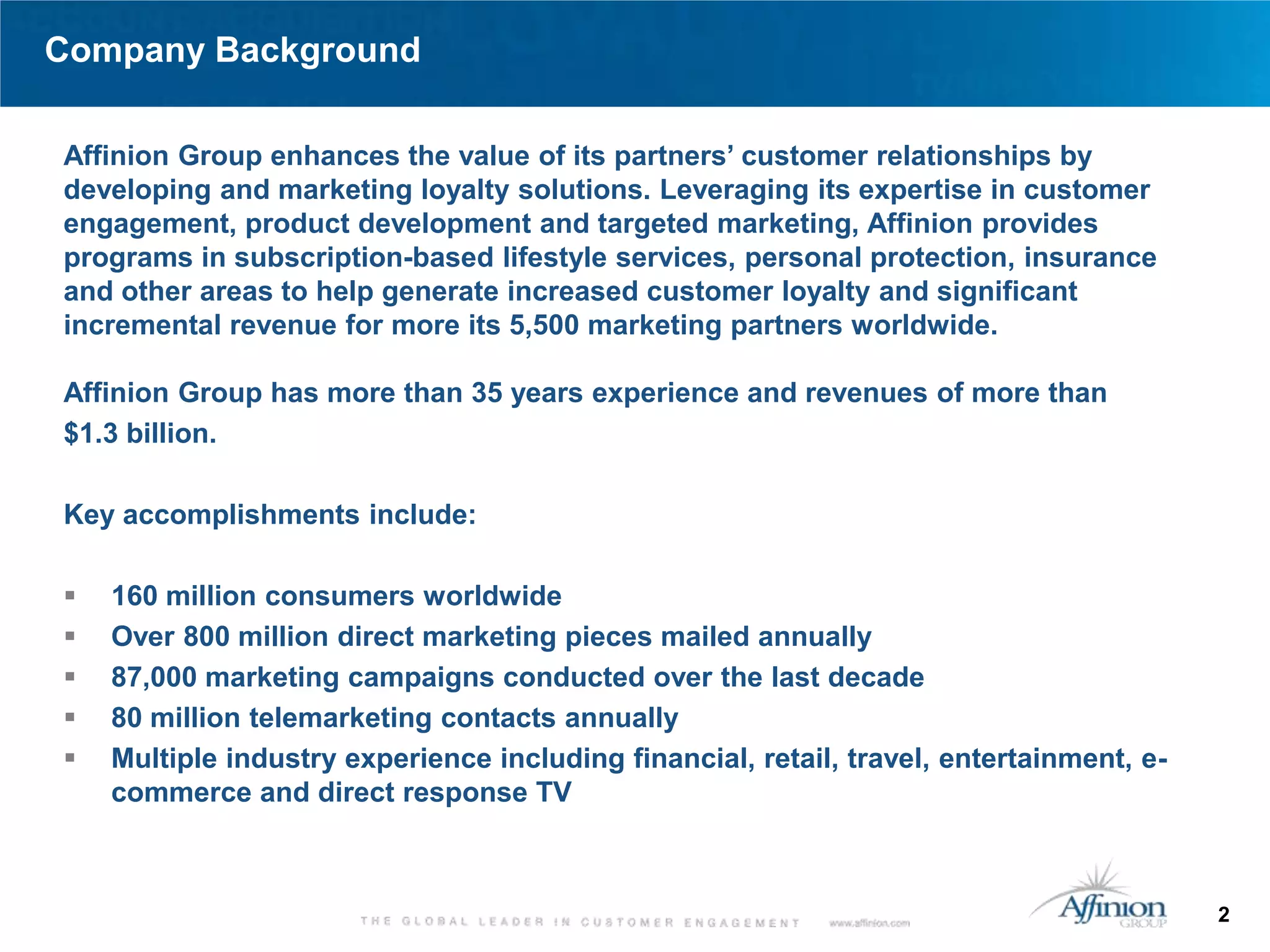

Company Background

Affinion Group enhances the value of its partners’ customer relationships by
developing and marketing loyalty solutions. Leveraging its expertise in customer
engagement, product development and targeted marketing, Affinion provides
programs in subscription-based lifestyle services, personal protection, insurance
and other areas to help generate increased customer loyalty and significant
incremental revenue for more its 5,500 marketing partners worldwide.

Affinion Group has more than 35 years experience and revenues of more than
$1.3 billion.

Key accomplishments include:

   160 million consumers worldwide
   Over 800 million direct marketing pieces mailed annually
   87,000 marketing campaigns conducted over the last decade
   80 million telemarketing contacts annually
   Multiple industry experience including financial, retail, travel, entertainment, e-
    commerce and direct response TV

                                                                                          2

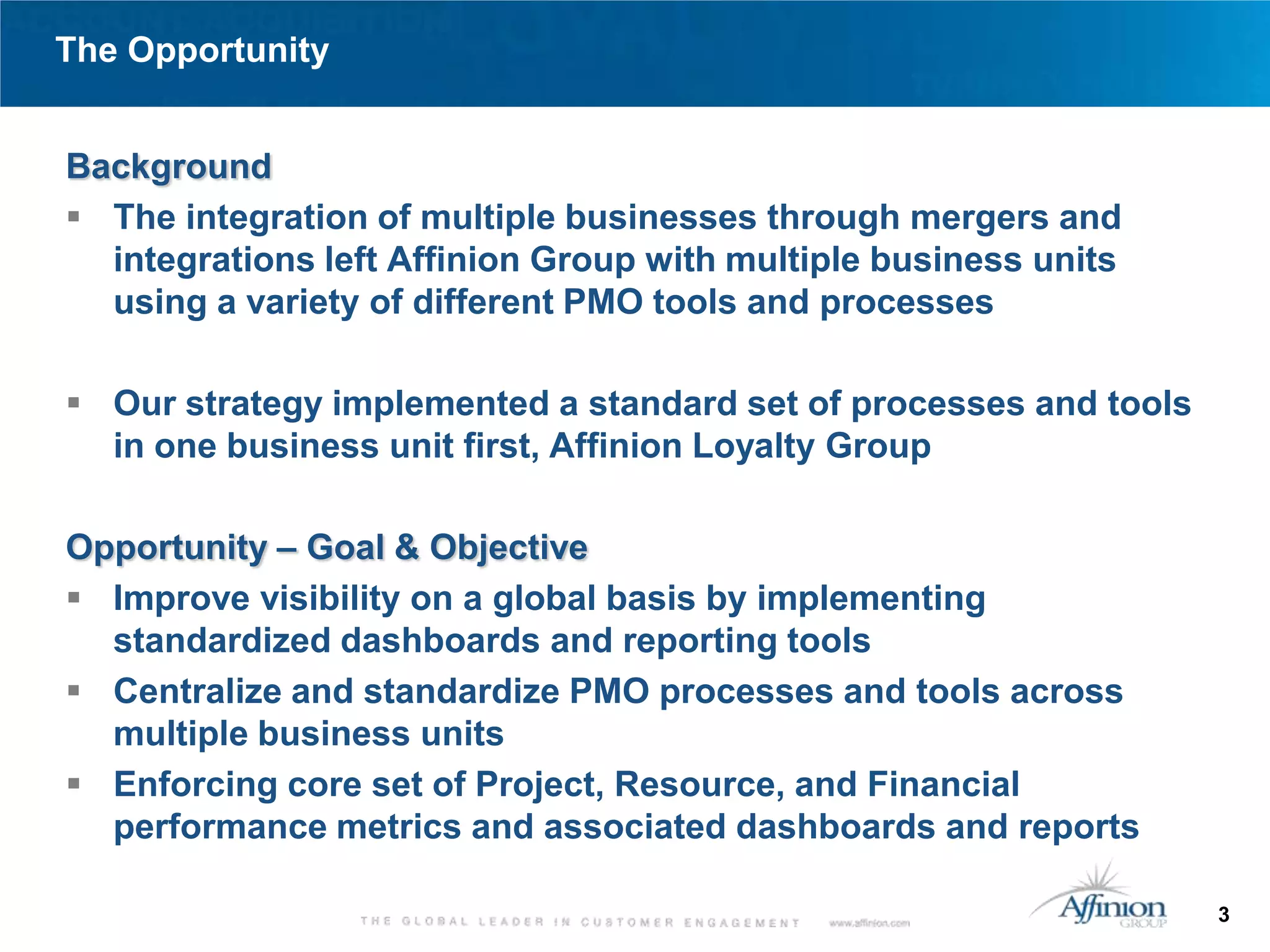

The Opportunity

Background
 The integration of multiple businesses through mergers and
  integrations left Affinion Group with multiple business units
  using a variety of different PMO tools and processes

 Our strategy implemented a standard set of processes and tools
  in one business unit first, Affinion Loyalty Group

Opportunity – Goal & Objective
 Improve visibility on a global basis by implementing
  standardized dashboards and reporting tools
 Centralize and standardize PMO processes and tools across
  multiple business units
 Enforcing core set of Project, Resource, and Financial
  performance metrics and associated dashboards and reports

                                                                   3

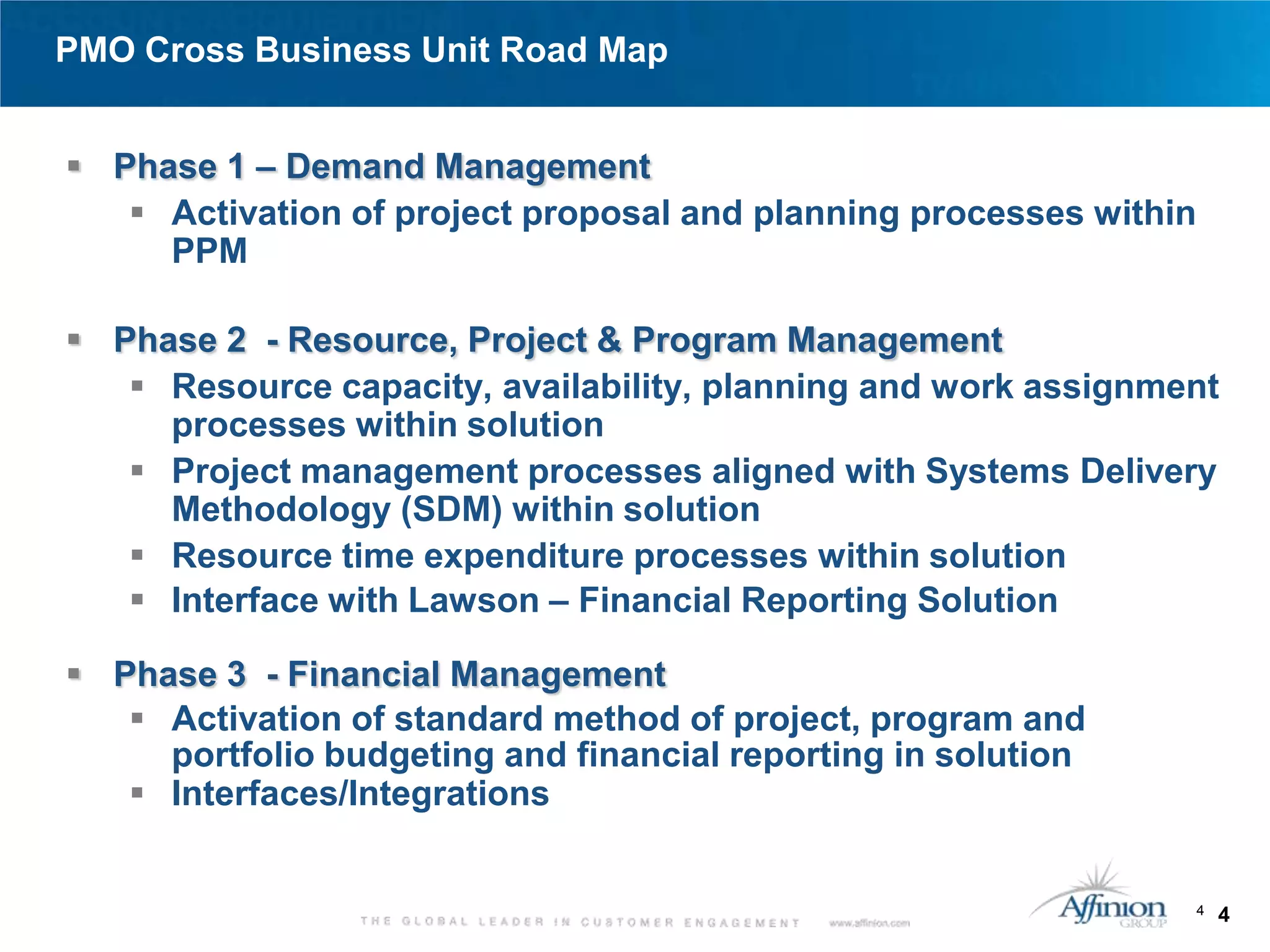

PMO Cross Business Unit Road Map

 Phase 1 – Demand Management
    Activation of project proposal and planning processes within
     PPM

 Phase 2 - Resource, Project & Program Management
    Resource capacity, availability, planning and work assignment
     processes within solution
    Project management processes aligned with Systems Delivery
     Methodology (SDM) within solution
    Resource time expenditure processes within solution
    Interface with Lawson – Financial Reporting Solution

 Phase 3 - Financial Management
    Activation of standard method of project, program and
     portfolio budgeting and financial reporting in solution
    Interfaces/Integrations

                                                                    4   4

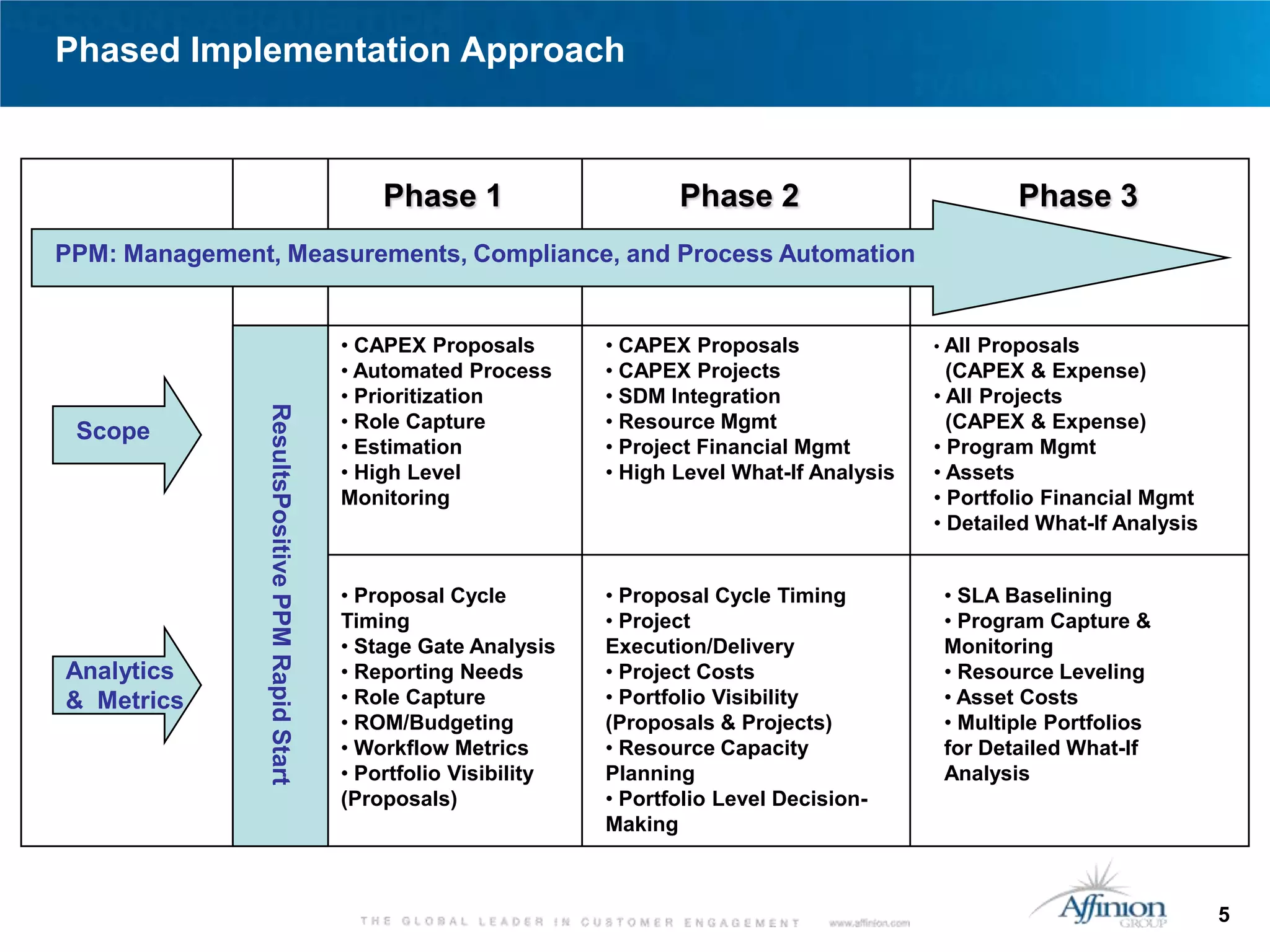

Phased Implementation Approach

                                                      Phase 1                     Phase 2                          Phase 3
PPM: Management, Measurements, Compliance, and Process Automation

                                                  • CAPEX Proposals        • CAPEX Proposals               • All Proposals
                                                  • Automated Process      • CAPEX Projects                  (CAPEX & Expense)
                                                  • Prioritization         • SDM Integration               • All Projects
                ResultsPositive PPM Rapid Start

                                                  • Role Capture           • Resource Mgmt                   (CAPEX & Expense)
 Scope
                                                  • Estimation             • Project Financial Mgmt        • Program Mgmt
                                                  • High Level             • High Level What-If Analysis   • Assets
                                                  Monitoring                                               • Portfolio Financial Mgmt
                                                                                                           • Detailed What-If Analysis

                                                  • Proposal Cycle         • Proposal Cycle Timing          • SLA Baselining
                                                  Timing                   • Project                        • Program Capture &
                                                  • Stage Gate Analysis    Execution/Delivery               Monitoring
Analytics                                         • Reporting Needs        • Project Costs                  • Resource Leveling
& Metrics                                         • Role Capture           • Portfolio Visibility           • Asset Costs
                                                  • ROM/Budgeting          (Proposals & Projects)           • Multiple Portfolios
                                                  • Workflow Metrics       • Resource Capacity              for Detailed What-If
                                                  • Portfolio Visibility   Planning                         Analysis
                                                  (Proposals)              • Portfolio Level Decision-
                                                                           Making

                                                                                                                                         5
Phase I - Opportunities

 Centralize and Standardize PMO / PPM Solutions across BU’s

  ResultsPositive PPM Rapid Start Implementation
     Standardize PMO / project proposal lifecycle across all
      business units
     Implement PPM across all business units

  Standardized Proposal prioritization and approval
     Established standard set of prioritization criteria across
      business units
     Consistent and repeatable proposal development and
      approval process

  Cross business unit visibility
     Portfolio visibility of project proposals across business
      units
     Usage of initial set of role-based dashboards

                                                                   6
Phase I Solution Overview: Portfolio Management

                         Performance Measurement & Reporting

                  Portfolio Management

                   Investment Review Committee
                     Review      Approve projects
                   prioritized   based on benefits
                  capital and     and budget and
                    expense           resource
                   proposalsPMO Office
                                     availability

                     Present       Analyze and rank
               prioritized project proposals by value
                   proposals        and risk ratings

                                                               7

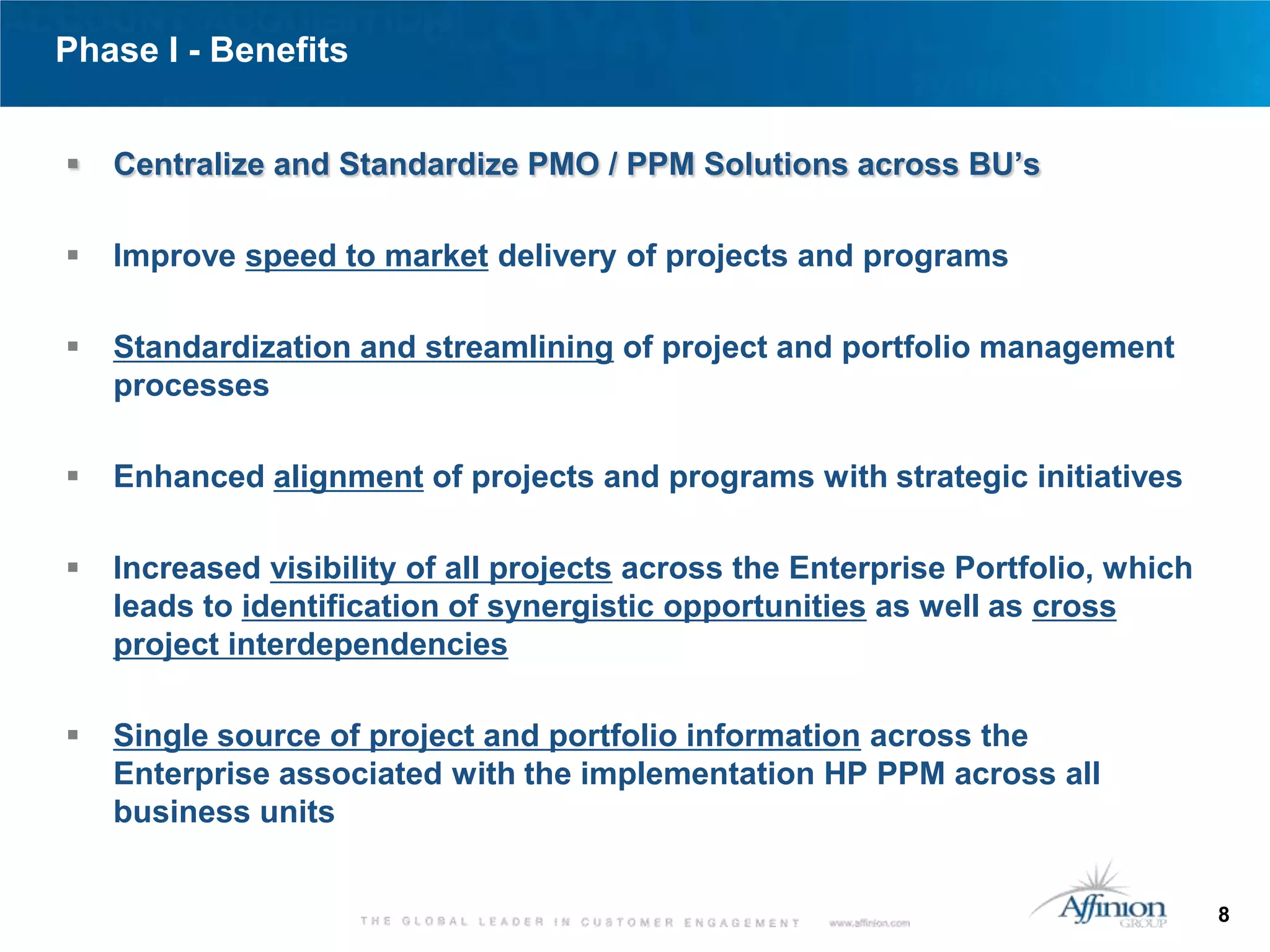

Phase I - Benefits

   Centralize and Standardize PMO / PPM Solutions across BU’s

   Improve speed to market delivery of projects and programs

   Standardization and streamlining of project and portfolio management
    processes

   Enhanced alignment of projects and programs with strategic initiatives

   Increased visibility of all projects across the Enterprise Portfolio, which
    leads to identification of synergistic opportunities as well as cross
    project interdependencies

   Single source of project and portfolio information across the
    Enterprise associated with the implementation HP PPM across all
    business units

                                                                                  8

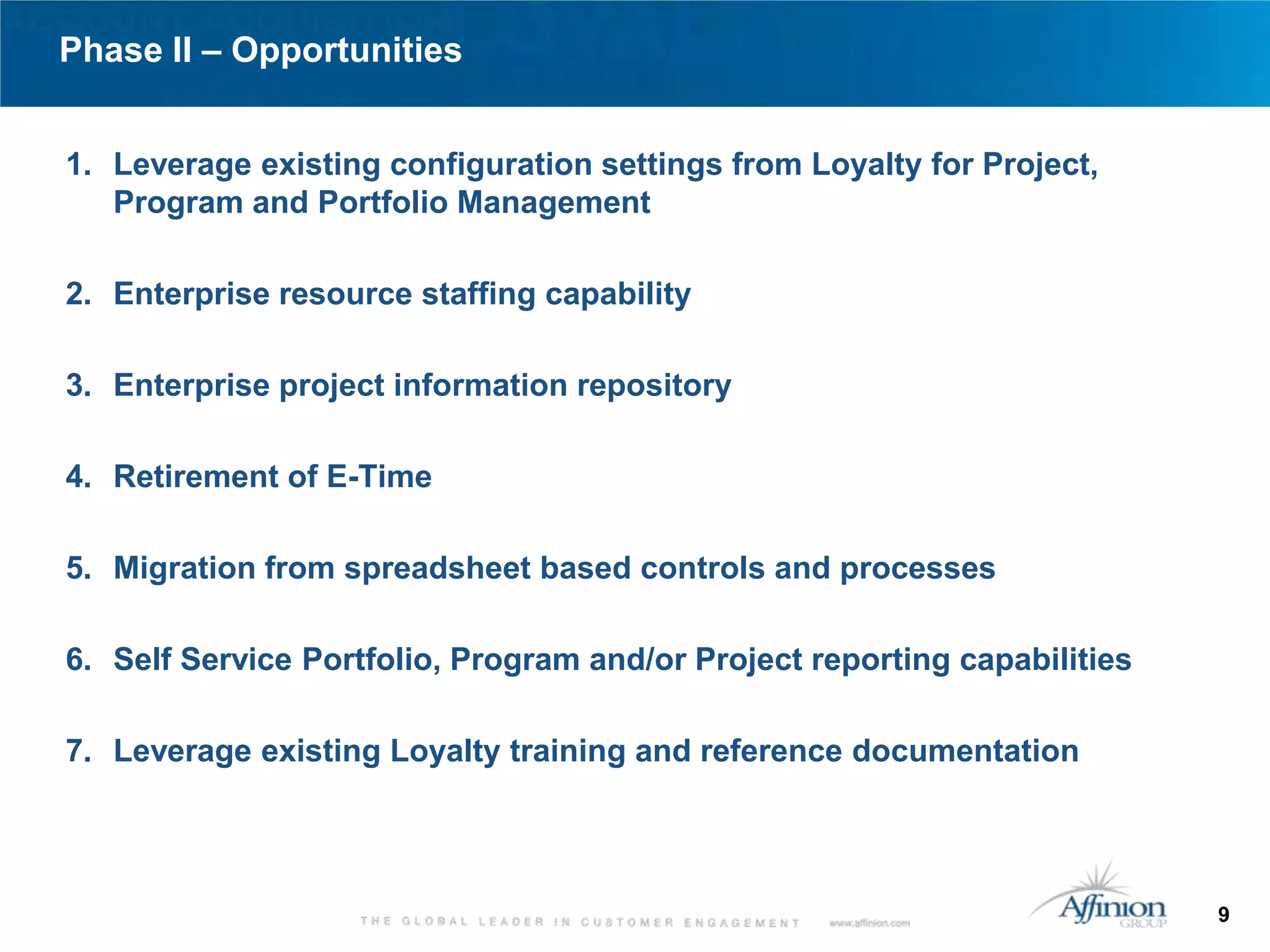

Phase II – Opportunities

1. Leverage existing configuration settings from Loyalty for Project,
   Program and Portfolio Management

2. Enterprise resource staffing capability

3. Enterprise project information repository

4. Retirement of E-Time

5. Migration from spreadsheet based controls and processes

6. Self Service Portfolio, Program and/or Project reporting capabilities

7. Leverage existing Loyalty training and reference documentation

                                                                           9

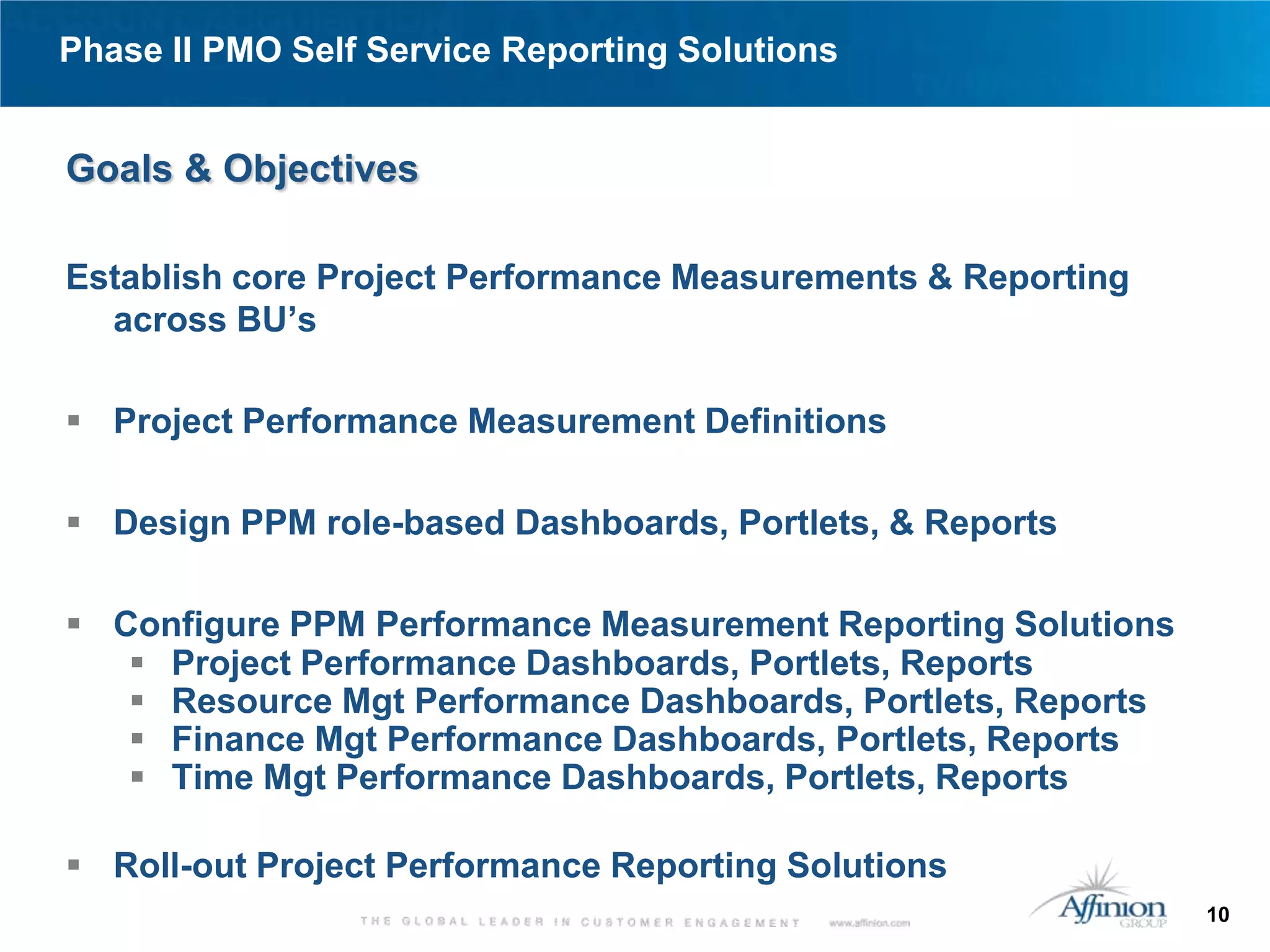

Phase II PMO Self Service Reporting Solutions

Goals & Objectives

Establish core Project Performance Measurements & Reporting
  across BU’s

 Project Performance Measurement Definitions

 Design PPM role-based Dashboards, Portlets, & Reports

 Configure PPM Performance Measurement Reporting Solutions
    Project Performance Dashboards, Portlets, Reports
    Resource Mgt Performance Dashboards, Portlets, Reports
    Finance Mgt Performance Dashboards, Portlets, Reports
    Time Mgt Performance Dashboards, Portlets, Reports

 Roll-out Project Performance Reporting Solutions
                                                              10

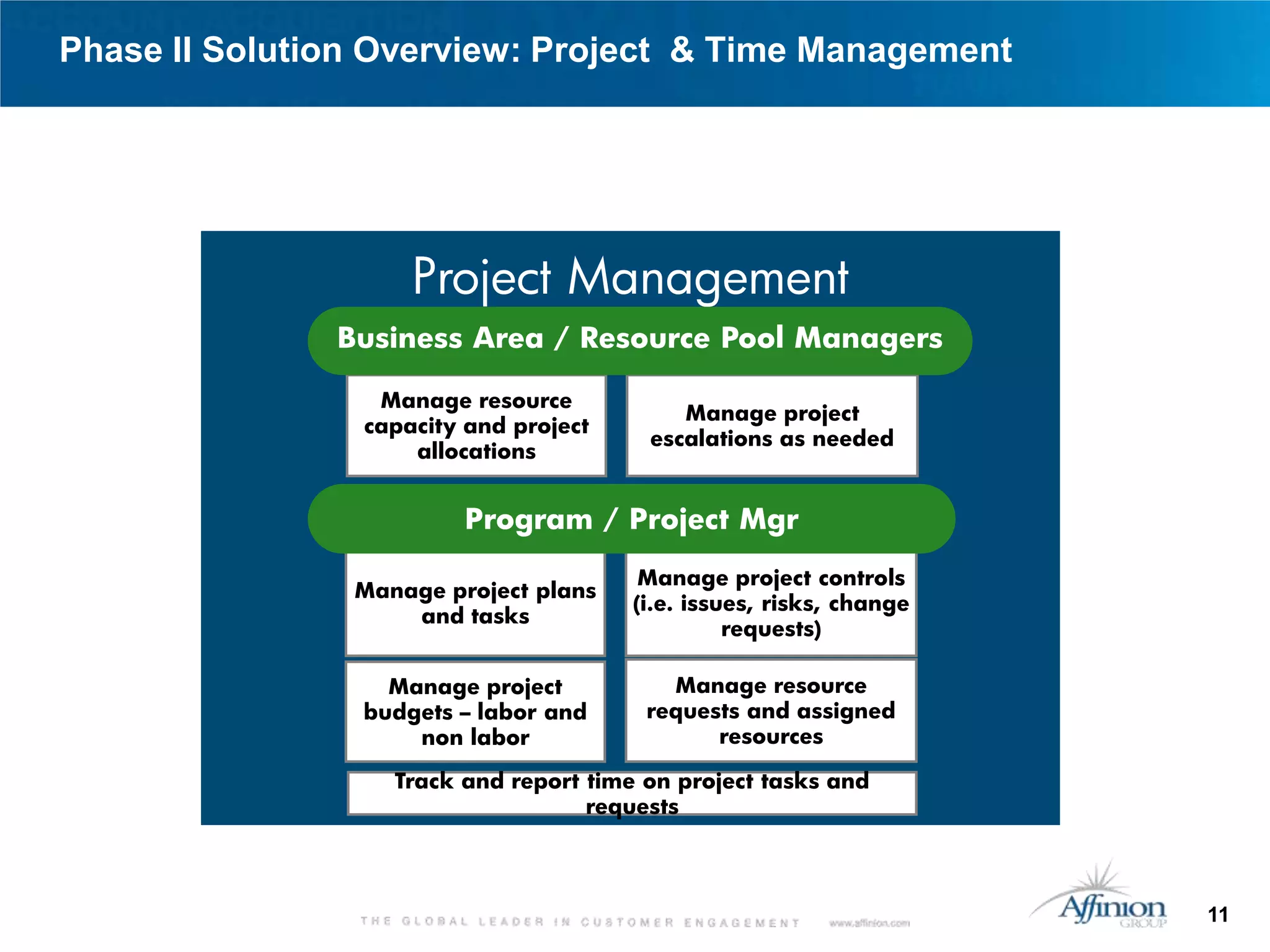

Phase II Solution Overview: Project & Time Management

                           Performance Measurement Reporting

                    Project Management
               Business Area / Resource Pool Managers

                 Manage resource
                                            Manage project
                capacity and project
                                         escalations as needed
                    allocations

                         Program / Project Mgr

                                         Manage project controls
                Manage project plans
                                        (i.e. issues, risks, change
                    and tasks
                                                  requests)

                  Manage project           Manage resource
                budgets – labor and      requests and assigned
                    non labor                  resources

                   Track and report time on project tasks and
                                    requests

                                                                      11
Phase II - Benefits

1. Resource availability, capacity and what-if capability provides ‘missing link’ in
   Annual / Quarterly / Monthly Project planning and Steering Committee prioritization.
     Alignment of IT organization with business

2. Intrinsic/automated link between Projects, Resources and Time for financial tracking
   and reporting
     Strong resource and financial control within Time Management down to the
      Project task level

3. Real-time access to enterprise wide program and project performance metrics

4. Elimination of manual forms and process steps within the Project Management will:
     Improve timely submission of required documents
     Enable Project Managers to focus more of their time collaborating with their
       business counterparts on programs and strategic planning not administrative
       updates
     Meet Project Manager needs for automated Project, Resource and Time
       Management tools

                                                                                      12

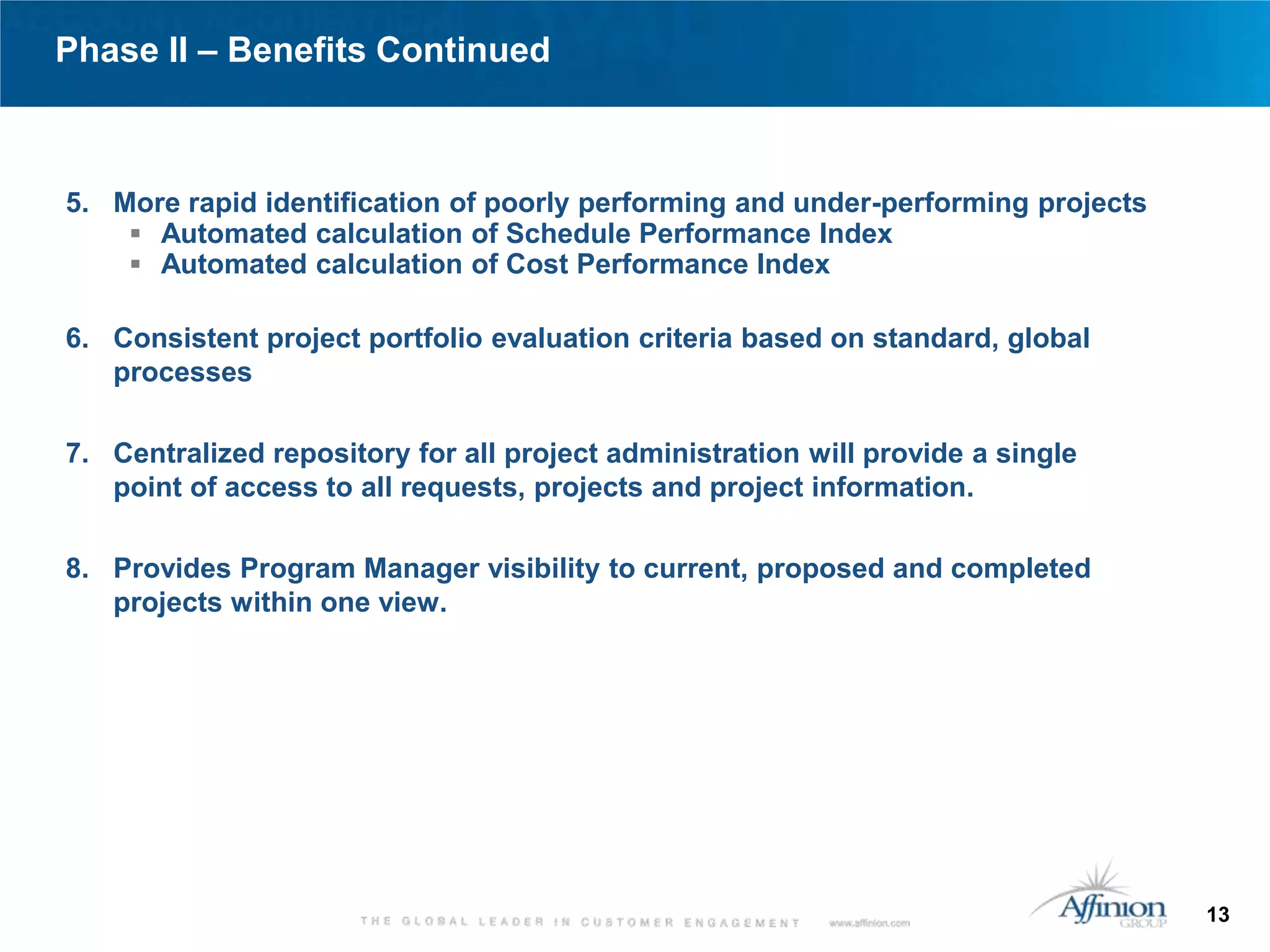

Phase II – Benefits Continued

5. More rapid identification of poorly performing and under-performing projects
     Automated calculation of Schedule Performance Index
     Automated calculation of Cost Performance Index

6. Consistent project portfolio evaluation criteria based on standard, global
   processes

7. Centralized repository for all project administration will provide a single
   point of access to all requests, projects and project information.

8. Provides Program Manager visibility to current, proposed and completed
   projects within one view.

                                                                                  13
Self Service Performance Measurement Reporting

               Project1          Project Mgr1
               Project2          Project Mgr2

               Project 3         Project Mg3

               Project4          Project Mgr4
               Project5          Project Mgr5

               Project6          Project Mgr6
               Project7          Project Mgr7

   Project1                Project Mgr1

   Project2                Project Mgr2

   Project 3               Project Mg3

   Project4                Project Mgr4
   Project5                Project Mgr5

   Project6                Project Mgr6
   Project7                Project Mgr7

                                                 14
Project Proposal and Lifecycle Process Reporting

   Proposal1    Project Mg1

   Proposal2    Project Mgr2

   Proposal3    Project Mgr3

   Proposal4    Project Mgr4
   Proposal5    Project Mgr5

   Proposal6    Project Mgr6

   Proposal7    Project Mgr7

               Project Mgr 8

                                                   15

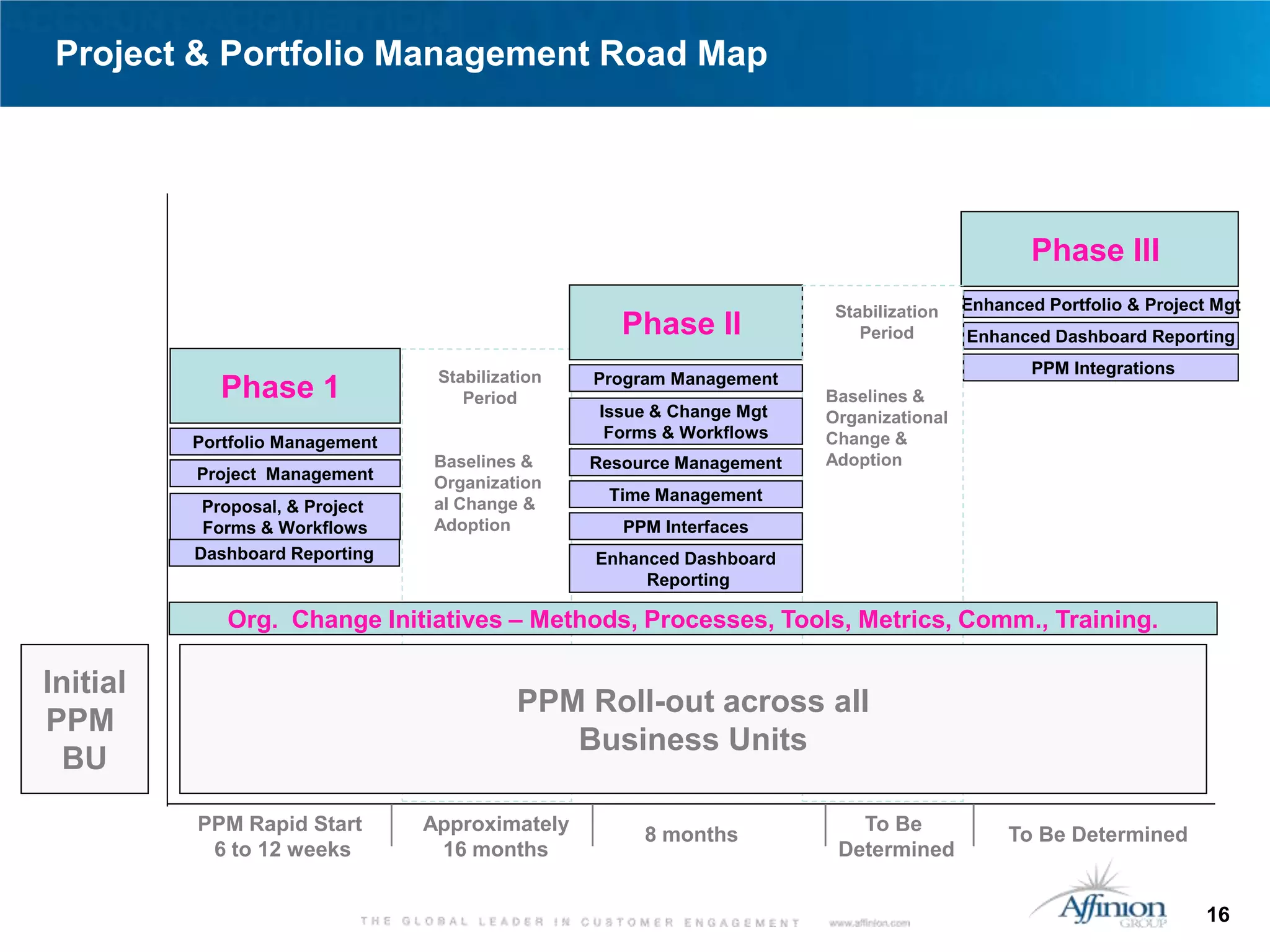

Project & Portfolio Management Road Map

                                                                                                 Phase III
                                                                         Stabilization   Enhanced Portfolio & Project Mgt
                                                     Phase II               Period       Enhanced Dashboard Reporting

                                  Stabilization                                                  PPM Integrations
                                                  Program Management
             Phase 1                 Period                             Baselines &
                                                  Issue & Change Mgt    Organizational
                                                   Forms & Workflows    Change &
          Portfolio Management
                                 Baselines &      Resource Management   Adoption
          Project Management     Organization
                                                   Time Management
           Proposal, & Project   al Change &
           Forms & Workflows     Adoption            PPM Interfaces
          Dashboard Reporting                     Enhanced Dashboard
                                                       Reporting

             Org. Change Initiatives – Methods, Processes, Tools, Metrics, Comm., Training.

Initial
                                           PPM Roll-out across all
PPM
                                              Business Units
  BU
          PPM Rapid Start        Approximately                             To Be
                                                       8 months                               To Be Determined
           6 to 12 weeks          16 months                              Determined

                                                                                                                     16

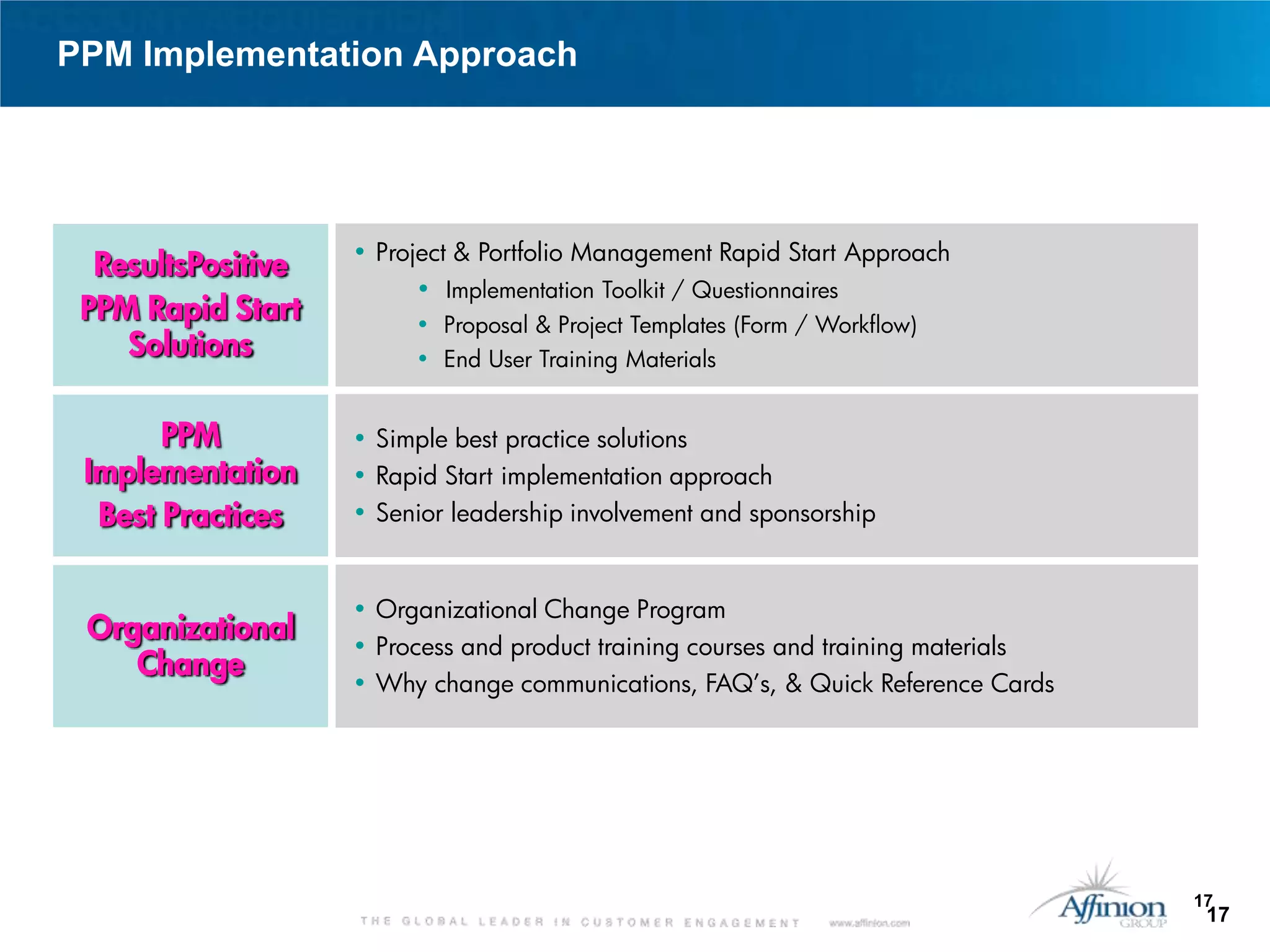

PPM Implementation Approach

                    • Project & Portfolio Management Rapid Start Approach
  ResultsPositive
                          • Implementation Toolkit / Questionnaires
 PPM Rapid Start         • Proposal & Project Templates (Form / Workflow)
    Solutions            • End User Training Materials

       PPM          • Simple best practice solutions
 Implementation     • Rapid Start implementation approach
  Best Practices    • Senior leadership involvement and sponsorship

                    • Organizational Change Program
 Organizational
                    • Process and product training courses and training materials
    Change
                    • Why change communications, FAQ’s, & Quick Reference Cards

                                                                                    17
                                                                                     17

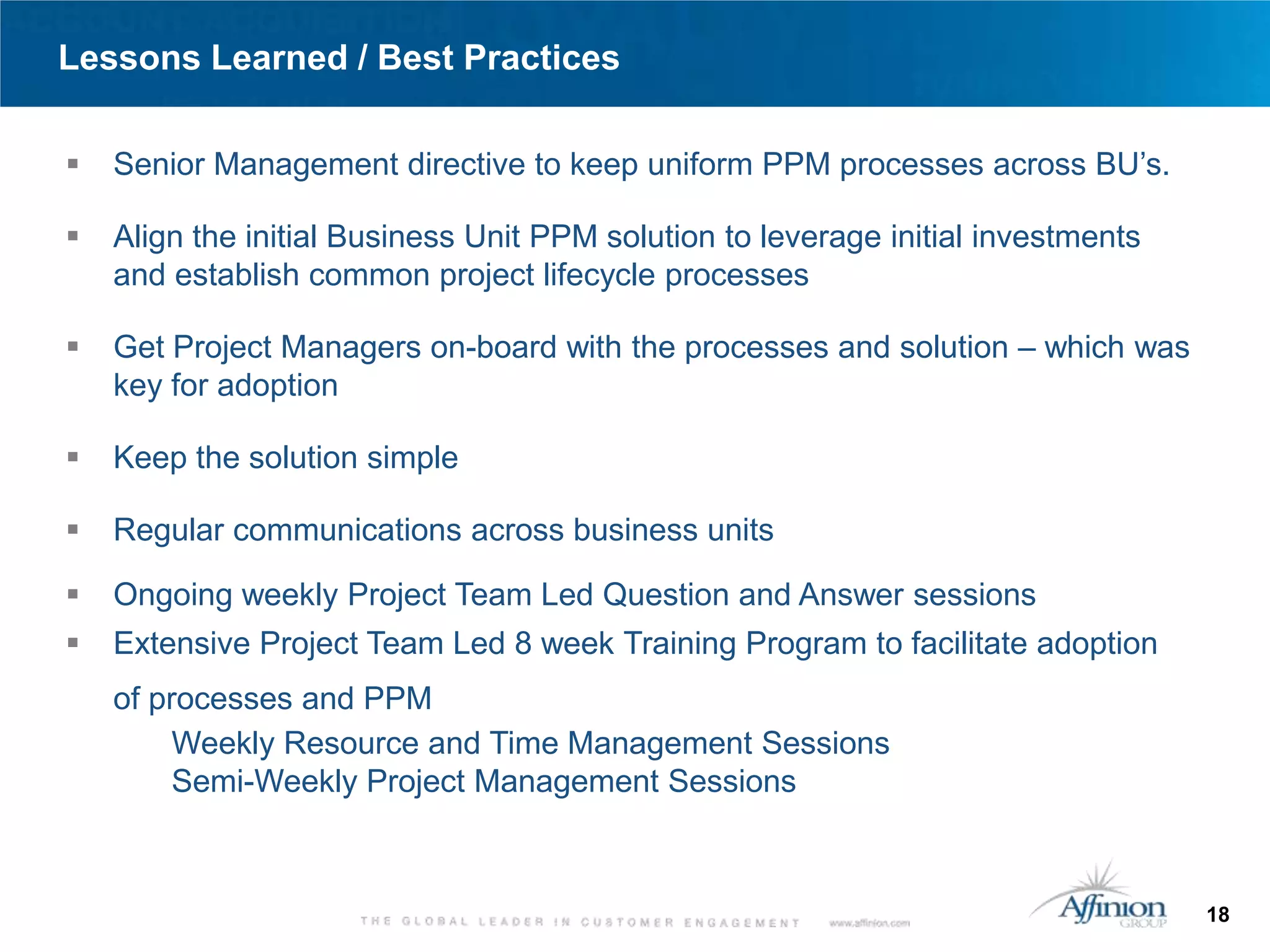

Lessons Learned / Best Practices

   Senior Management directive to keep uniform PPM processes across BU’s.

   Align the initial Business Unit PPM solution to leverage initial investments
    and establish common project lifecycle processes

   Get Project Managers on-board with the processes and solution – which was
    key for adoption

   Keep the solution simple

   Regular communications across business units

   Ongoing weekly Project Team Led Question and Answer sessions
   Extensive Project Team Led 8 week Training Program to facilitate adoption
    of processes and PPM
         Weekly Resource and Time Management Sessions
         Semi-Weekly Project Management Sessions

                                                                                   18
Contact Information

   Patrick Figliola, PMP, PMO Director,
    Affinion Group
       Phone: 203 956 8779
       Email: pfigliola@affiniongroup.com

   Jon Furner, President, ResultsPositive
       Phone: 480 – 415 – 6419
       Email: jfurner@resultspositive.com

                                             19
QUESTIONS?

             20
To learn more on this topic, and to connect with your peers after
   the conference, visit the HP Software Solutions Community:

             www.hp.com/go/swcommunity
21 ©2010 Hewlett-Packard Development Company, L.P.
22

1844final 100811113357 Phpapp01

  • 1.
    Affinion Group: increasingROI by extending HP Project and Portfolio Management Center across all business units Affinion Group – Patrick Figliola Results Positive – Jon Furner, President 1 ©2010 Hewlett-Packard Development Company, L.P. The information contained herein is subject to change without notice
  • 2.
    Company Background Affinion Groupenhances the value of its partners’ customer relationships by developing and marketing loyalty solutions. Leveraging its expertise in customer engagement, product development and targeted marketing, Affinion provides programs in subscription-based lifestyle services, personal protection, insurance and other areas to help generate increased customer loyalty and significant incremental revenue for more its 5,500 marketing partners worldwide. Affinion Group has more than 35 years experience and revenues of more than $1.3 billion. Key accomplishments include:  160 million consumers worldwide  Over 800 million direct marketing pieces mailed annually  87,000 marketing campaigns conducted over the last decade  80 million telemarketing contacts annually  Multiple industry experience including financial, retail, travel, entertainment, e- commerce and direct response TV 2
  • 3.
    The Opportunity Background  Theintegration of multiple businesses through mergers and integrations left Affinion Group with multiple business units using a variety of different PMO tools and processes  Our strategy implemented a standard set of processes and tools in one business unit first, Affinion Loyalty Group Opportunity – Goal & Objective  Improve visibility on a global basis by implementing standardized dashboards and reporting tools  Centralize and standardize PMO processes and tools across multiple business units  Enforcing core set of Project, Resource, and Financial performance metrics and associated dashboards and reports 3
  • 4.
    PMO Cross BusinessUnit Road Map  Phase 1 – Demand Management  Activation of project proposal and planning processes within PPM  Phase 2 - Resource, Project & Program Management  Resource capacity, availability, planning and work assignment processes within solution  Project management processes aligned with Systems Delivery Methodology (SDM) within solution  Resource time expenditure processes within solution  Interface with Lawson – Financial Reporting Solution  Phase 3 - Financial Management  Activation of standard method of project, program and portfolio budgeting and financial reporting in solution  Interfaces/Integrations 4 4
  • 5.
    Phased Implementation Approach Phase 1 Phase 2 Phase 3 PPM: Management, Measurements, Compliance, and Process Automation • CAPEX Proposals • CAPEX Proposals • All Proposals • Automated Process • CAPEX Projects (CAPEX & Expense) • Prioritization • SDM Integration • All Projects ResultsPositive PPM Rapid Start • Role Capture • Resource Mgmt (CAPEX & Expense) Scope • Estimation • Project Financial Mgmt • Program Mgmt • High Level • High Level What-If Analysis • Assets Monitoring • Portfolio Financial Mgmt • Detailed What-If Analysis • Proposal Cycle • Proposal Cycle Timing • SLA Baselining Timing • Project • Program Capture & • Stage Gate Analysis Execution/Delivery Monitoring Analytics • Reporting Needs • Project Costs • Resource Leveling & Metrics • Role Capture • Portfolio Visibility • Asset Costs • ROM/Budgeting (Proposals & Projects) • Multiple Portfolios • Workflow Metrics • Resource Capacity for Detailed What-If • Portfolio Visibility Planning Analysis (Proposals) • Portfolio Level Decision- Making 5
  • 6.
    Phase I -Opportunities Centralize and Standardize PMO / PPM Solutions across BU’s  ResultsPositive PPM Rapid Start Implementation  Standardize PMO / project proposal lifecycle across all business units  Implement PPM across all business units  Standardized Proposal prioritization and approval  Established standard set of prioritization criteria across business units  Consistent and repeatable proposal development and approval process  Cross business unit visibility  Portfolio visibility of project proposals across business units  Usage of initial set of role-based dashboards 6
  • 7.
    Phase I SolutionOverview: Portfolio Management Performance Measurement & Reporting Portfolio Management Investment Review Committee Review Approve projects prioritized based on benefits capital and and budget and expense resource proposalsPMO Office availability Present Analyze and rank prioritized project proposals by value proposals and risk ratings 7
  • 8.
    Phase I -Benefits  Centralize and Standardize PMO / PPM Solutions across BU’s  Improve speed to market delivery of projects and programs  Standardization and streamlining of project and portfolio management processes  Enhanced alignment of projects and programs with strategic initiatives  Increased visibility of all projects across the Enterprise Portfolio, which leads to identification of synergistic opportunities as well as cross project interdependencies  Single source of project and portfolio information across the Enterprise associated with the implementation HP PPM across all business units 8
  • 9.
    Phase II –Opportunities 1. Leverage existing configuration settings from Loyalty for Project, Program and Portfolio Management 2. Enterprise resource staffing capability 3. Enterprise project information repository 4. Retirement of E-Time 5. Migration from spreadsheet based controls and processes 6. Self Service Portfolio, Program and/or Project reporting capabilities 7. Leverage existing Loyalty training and reference documentation 9
  • 10.
    Phase II PMOSelf Service Reporting Solutions Goals & Objectives Establish core Project Performance Measurements & Reporting across BU’s  Project Performance Measurement Definitions  Design PPM role-based Dashboards, Portlets, & Reports  Configure PPM Performance Measurement Reporting Solutions  Project Performance Dashboards, Portlets, Reports  Resource Mgt Performance Dashboards, Portlets, Reports  Finance Mgt Performance Dashboards, Portlets, Reports  Time Mgt Performance Dashboards, Portlets, Reports  Roll-out Project Performance Reporting Solutions 10
  • 11.
    Phase II SolutionOverview: Project & Time Management Performance Measurement Reporting Project Management Business Area / Resource Pool Managers Manage resource Manage project capacity and project escalations as needed allocations Program / Project Mgr Manage project controls Manage project plans (i.e. issues, risks, change and tasks requests) Manage project Manage resource budgets – labor and requests and assigned non labor resources Track and report time on project tasks and requests 11
  • 12.
    Phase II -Benefits 1. Resource availability, capacity and what-if capability provides ‘missing link’ in Annual / Quarterly / Monthly Project planning and Steering Committee prioritization.  Alignment of IT organization with business 2. Intrinsic/automated link between Projects, Resources and Time for financial tracking and reporting  Strong resource and financial control within Time Management down to the Project task level 3. Real-time access to enterprise wide program and project performance metrics 4. Elimination of manual forms and process steps within the Project Management will:  Improve timely submission of required documents  Enable Project Managers to focus more of their time collaborating with their business counterparts on programs and strategic planning not administrative updates  Meet Project Manager needs for automated Project, Resource and Time Management tools 12
  • 13.
    Phase II –Benefits Continued 5. More rapid identification of poorly performing and under-performing projects  Automated calculation of Schedule Performance Index  Automated calculation of Cost Performance Index 6. Consistent project portfolio evaluation criteria based on standard, global processes 7. Centralized repository for all project administration will provide a single point of access to all requests, projects and project information. 8. Provides Program Manager visibility to current, proposed and completed projects within one view. 13
  • 14.
    Self Service PerformanceMeasurement Reporting Project1 Project Mgr1 Project2 Project Mgr2 Project 3 Project Mg3 Project4 Project Mgr4 Project5 Project Mgr5 Project6 Project Mgr6 Project7 Project Mgr7 Project1 Project Mgr1 Project2 Project Mgr2 Project 3 Project Mg3 Project4 Project Mgr4 Project5 Project Mgr5 Project6 Project Mgr6 Project7 Project Mgr7 14
  • 15.
    Project Proposal andLifecycle Process Reporting Proposal1 Project Mg1 Proposal2 Project Mgr2 Proposal3 Project Mgr3 Proposal4 Project Mgr4 Proposal5 Project Mgr5 Proposal6 Project Mgr6 Proposal7 Project Mgr7 Project Mgr 8 15
  • 16.
    Project & PortfolioManagement Road Map Phase III Stabilization Enhanced Portfolio & Project Mgt Phase II Period Enhanced Dashboard Reporting Stabilization PPM Integrations Program Management Phase 1 Period Baselines & Issue & Change Mgt Organizational Forms & Workflows Change & Portfolio Management Baselines & Resource Management Adoption Project Management Organization Time Management Proposal, & Project al Change & Forms & Workflows Adoption PPM Interfaces Dashboard Reporting Enhanced Dashboard Reporting Org. Change Initiatives – Methods, Processes, Tools, Metrics, Comm., Training. Initial PPM Roll-out across all PPM Business Units BU PPM Rapid Start Approximately To Be 8 months To Be Determined 6 to 12 weeks 16 months Determined 16
  • 17.
    PPM Implementation Approach • Project & Portfolio Management Rapid Start Approach ResultsPositive • Implementation Toolkit / Questionnaires PPM Rapid Start • Proposal & Project Templates (Form / Workflow) Solutions • End User Training Materials PPM • Simple best practice solutions Implementation • Rapid Start implementation approach Best Practices • Senior leadership involvement and sponsorship • Organizational Change Program Organizational • Process and product training courses and training materials Change • Why change communications, FAQ’s, & Quick Reference Cards 17 17
  • 18.
    Lessons Learned /Best Practices  Senior Management directive to keep uniform PPM processes across BU’s.  Align the initial Business Unit PPM solution to leverage initial investments and establish common project lifecycle processes  Get Project Managers on-board with the processes and solution – which was key for adoption  Keep the solution simple  Regular communications across business units  Ongoing weekly Project Team Led Question and Answer sessions  Extensive Project Team Led 8 week Training Program to facilitate adoption of processes and PPM Weekly Resource and Time Management Sessions Semi-Weekly Project Management Sessions 18
  • 19.
    Contact Information  Patrick Figliola, PMP, PMO Director, Affinion Group  Phone: 203 956 8779  Email: pfigliola@affiniongroup.com  Jon Furner, President, ResultsPositive  Phone: 480 – 415 – 6419  Email: jfurner@resultspositive.com 19
  • 20.
  • 21.
    To learn moreon this topic, and to connect with your peers after the conference, visit the HP Software Solutions Community: www.hp.com/go/swcommunity 21 ©2010 Hewlett-Packard Development Company, L.P.
  • 22.
