17603-2019-Winter-model-answer-paper[Msbte study resources].pdf
1. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 1 / 27
Sub. Code: 17603
Important Instructions to examiners:
1) The Answer should be examined by key words and not as word-to-word as given in the model answer
scheme.
2) The model answer and the answer written by candidate may vary but the examiner may try to assess the
understanding level of the candidate.
3) The language errors such as grammatical, spelling errors should not be given more importance. (Not
applicable for subject English and Communication Skills.)
4) While assessing figures, examiner may give credit for principal components indicated in the figure. The
figures drawn by the candidate and those in the model answer may vary. The examiner may give credit
for any equivalent figure drawn.
5) Credits may be given step wise for numerical problems. In some cases, the assumed constant values may
vary and there may be some difference in the candidate‟s Answer and the model answer.
6) In case of some questions credit may be given by judgment on part of examiner of relevant answer based
on candidate‟s understanding.
7) For programming language papers, credit may be given to any other program based on
equivalent concept.
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1 a)
(i)
Ans.
Attempt any THREE of the following :
State any four method used in PWD for execution of work.
Explain any one in brief.
The following are the various methods for executing a work by
P.W.D.
i. Rate list method
ii. Piece work method
iii. Day‟s work method
iv. Employing labour on daily wages
i. Rate list method:
1. This method is suitable for petty work when the cost is small.
Hence various contracting firms are not interested in carrying out
work and advertisement in newspaper is not justified for work of
small magnitude.
2. For such petty work list of petty workers are kept in the office of
executive engineer.
3. Cost of any individual work to be executed does not exceed
Rs.3000/-
4. The petty workers will quote rate and lowest offer is accepted.
OR
ii. Piece work method:
1. This method is suitable for maintenance and repair work.
2. Piece work is the agreement which involves the payment for work
done at agreed rate without reference to total quantity of work to be
done or time of completion.
3. Agreement contains only description of item to be executed.
4. Form shall be invited from piece worker. The agreement is made on
A1 form for percentage basis and A2 form for item rate basis.
5. The piece worker has to arrange all material and labour required for
carrying out work.
½
each
2
12
4
2. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 2 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1 a)
(i)
(ii)
Ans.
OR
iii. Day’s work method:
1. There are certain works of special nature which can not be
measured hence their valuation is made on basis of actual material
and labour used. For e.g. decorative plaster work
2. In such cases day work method is adopted for valuation of above
items on basis of actual material used and number and class of
labour employed and tools and plants required for work.
3. In this method contractor has to maintain day to day account of
material consumed, the labour, types of labour,the hours for which
each labour is employed is filled in day work sheet.
4. Contractor is paid on the basis of net cost of various material
required and wages paid to the labour plus 20- 25 % as his profit
OR
iv. Employing labour on daily wages:
1. In this method department purchase material directly from supplier
and engage labour on daily wages on muster as and when required.
2. The material is supplied by department or can be purchased directly
from market.
3. The attendance of total number of labour employed is maintained in
muster roll form No.21 by Junior engineer and it is checked by
assistant engineer. The payment is made weekly, fortnightly or
monthly as per requirement.
4. When muster roll is closed for payment it is necessary to measure
the work during that period and enter it in measurement book.
State any four requirements of valid contract.
1. Contract in writing: Contract should be in writing and should be
signed by both the parties i.e. owner and contractor
2. Subject matter: The subject matter of agreement must be legal
and definite. It should be easy to understand not too complex to
understand and execute.
3. Can be enforced in court of law: All terms, conditions words
should be according to law.
4. Parties must be competent: The parties signing the contract
should be competent enough to carry out work.
5. Free consent of parties: Both parties must give their free
consent to do the work as per agreement contract.
6. Attested by witness: Contract should be attested by responsible
person or officer.
1
each
(any
four)
4
3. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 3 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1 (iii)
Ans.
List any four types of contract. Explain percentage rate contract.
Following are different types of contract:
1. Lump sum contract.
2. Item rate contract.
3. Percentage rate contract.
a. Cost plus percentage rate contract.
b. Cost plus fixed fee contract.
c. Cost plus variable fee contract.
d. Cost plus variable percentage.
4. Labour contract.
5. Demolition contract.
6. Fee contract.
7. Target contract.
8. Negotiated contract.
9. Material supply contract.
Percentage rate Contract:
In this method bill of quantities consist of description of item as per
sanctioned estimate with their quantities, rates, unit and amount.
Contractor is asked to quote only percentage above or below the rates
shown in schedule.
Advantages:
1.Suitable for private work
2.It allows extra items.
3.Due to assurance of profit better quality of work is assured.
4.Scrutiny of tender is simple.
5.Overwriting and erasing of rates can be eliminated.
6.Comparative statement can easily be prepared.
7.No Scope for contractor to submit unbalanced tender.
Disadvantages:
1.Final cost of work is not known till completion of work.
2.Two or more contractor can quote same percentage this increases
trouble during allotment of tender.
3.Uncertain and unworkable rates can be quoted by contractor.
4. Tenderers can easily form ring.
½
each
(any
four)
2
4
4. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 4 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1 (iv)
Ans.
(v)
Ans.
List out any eight points to be included while drafting tender
notice.
Following points should be included while drafting a tender notice:
1. Name of the authority inviting tender
2. Name of work and its location
3. Estimated cost
4. Time limit of completion
5. Earnest money required along with tender
6. The availability of data and forms
7. The last date, place and time of receipt of tender
8. The right to reject the tender.
Define
1. Earnest Money Deposit
2. Security Money Deposit
3. NMR
4. Cash Book
1. Earnest Money Deposit:
It is the initial deposit paid with the tender in order to show the earnest
desire of the contractor to take up the work if awarded. An amount
equal to 1% to 2% of the estimated cost is taken as EMD.
2. Security Money Deposit:
It is the amount of money deposited as a security of work by the
contractor for certain period of time. Usually the % of security deposit
is 10%.
3. NMR:
The muster roll which is maintained to keep the record of works being
done by a labour employed on each day, is called as Nominal Muster
Roll.
4. Cash Book:
The form in which all cash transactions taking place day to day are
strictly entered in order of occurrence is called as cash book.
½
each
1
each
4
4
5. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 5 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1 b)
(i)
Ans.
(ii)
Ans.
Attempt any ONE of the following:
Explain Piece work method used in PWD.
Piece Work Method :
This method is suitable for maintenance and repair work Piece work is
the agreement which involves the payment for work done at agreed
rate without reference to total quantity of work to be done or time of
completion. Agreement contains only description of item to be
executed.
The tender notice is displayed on notice board of the office of
executive engineer without mentioning the quantities of work to be
done.
Item rate quoted either in A1 and A2 form.
Form shall be invited from piece worker. The agreement is made on
A1 form for percentage basis and A2 form for item rate basis.
The piece worker has to arrange for all material and labour required
for carrying out work.
Advantages :
1. Small works can be effectively executed.
2. Rapid completion of work.
Disadvantages :
1. No penalty clause.
2. Piecework is not valid contract and hence can be terminated at
any time.
3. Lack of co-ordination.

Draw standard form of
1) Measurement Book
2) Nominal muster roll
1) Measurement Book
Form 23, Measurement Book (M.B)
Particulars Details of Actual
measurement
Contents of area
No. L B D
4
1
1
3
6
6
6. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 6 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.1
(ii) 2) Nominal muster roll-
FORM – 21 : MUSTER ROLL
Cash Book Voucher No. ……….………..…
Date …………………..
Name of work
…………………………………..
Part I – Nominal Roll
Designation
Description
No.
(Sr.
No.)
Name
grouped
according
to classes
Father‟s
Name
Dates
.Month
TotalRate
Rs.P
Amount
Rs.P.
Dated
initial
of
paying
officer
Daily Total ….. ….. …..
Initial of person marking daily
attendance …..
Initial of Inspecting Officer …..
Passed for Rs. ……………….…… (Rupees ………………….)
Signature
……………… Rank ………………….
Rs. P.
Grand total of this muster roll ….. ….. ….. …..
Deduct – Payment not made as per details transferred to
Register of arrears ….. ….. ….. ….. …..
Total amount paid in words Rupees….. ….. ….. ….. …..
Date ……………………… Signature
………………………. Rank
………………………………
3
6
7. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 7 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.2
a)
Ans.
b)
Ans.
c)
Ans.
Attempt any FOUR of the following:
State any four functions of Executive Engineer of PWD.
Function of Executive engineer (EE):
(1) Inspect sub divisional office once in a year.
(2) Execution of work under him.
(3) Ensures all tools plants and machinery are properly maintained.
(4) Invite tender for work valued within his power.
(5) Maintenance of accounts.
(6) He is responsible for preparation of project design, estimate etc.
(7) Keep close watch on expenditure.
Explain in brief Technical Sanction and Administrative Approval.
Technical Sanction:
Technical sanction means the sanction of the detailed estimate, design,
rates and cost of work. It is sanctioned by competent authority. The
work is taken for the execution only after the technical sanction. If the
estimated amount exceed 10% of administratively approved amount
technical sanction is granted only after obtaining revised
administrative approval for work technical sanction once given
remains valid for 5 years.
Administrative Approval: For any work, it is necessary to take
formal acceptance with respect to cost and work is called as
administrative approval. For this the department sends a proposal to
government for taking up the work. After considering all aspects like
feasibility of project, financial aspect, government accepts proposal is
called administrative approval.
Define contract. State its objects.
Contract: Contract is an undertaking by person or firm to do work
under certain terms and condition.
Objects of Contract:
1. To execute the work by experienced persons.
2. To execute work with most competitive rate.
3. To do work as per specification.
4. To use latest machineries and techniques.
5. To have free hand for a supervisor to check the work done by
contractor without interference.
1
each
(any
four)
2
2
1
1
each
(any
three)
16
4
4
4
8. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 8 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.2 d)
Ans.
e)
Ans.
Explain Lumpsum Contract.
In lump sum contract the complete work as per plan and specification
is carried out by contractor for certain fixed amount as per agreement.
The owner provides required information and contractor charges
certain amount. This contract is suitable when the number of items are
limited or when it is possible to work out exact quantities or work to
be executed. The detailed specification of all items of work, plans and
detail drawings, security deposit, penalty, progress and other condition
of contract are included in agreement.
Through it is lump sum contract contractor will be paid at regular
interval of 2-3 months as per progress of work on the basis of
certificate issued by engineer incharge. A schedule of rate is included
in agreement for making payment of extra items.
Advantages of lumpsum contract:
1. Total cost of project is known before completion of work.
2. Progress of work is fast.
3. Owner need not require to appoint staff to maintain accounts.
4. Contractor can derive more profit by proper planning.
5. Detailed measurement of work is not required except in case of
addition and alteration.
Disadvantages of lumpsum contract:
1. This method is suitable for small work.
2. For extra items contractor may demand higher rates.
3. Extra item can be cause of dispute between owner and contractor.
4. Quality of work is not assured.
5. Contractor may quote higher rate and thus higher tendering is
possible.
List any eight forms used in PWD. Explain any one.
The various forms used in PWD :
1. Form 24 : First and final bill.
2. Form 25 : White – Running Account Bill A.
3. Form 26 : White – Running Account Bill B.
4. Form 26 : Yellow – Final Bill B.
5. Form 27 : White – Running Account Bill C.
6. Form 27 : Yellow – Final Bill C.
7. Form 27 A : Running Account Bill D.
8. Form 27 B : Final Bill.
9. Measurement Book – Form No. 23.
10. Nominal Muster Roll – Form No. 21.
11. Imprest Cash – Form No. 2.
12. Cash Book – Form No. 7.
2
½
each
(any
two)
½
each
(any
two)
3
4
9. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 9 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.2 e) 1. Form 24 : First and Final Bill :
For a single payment, form 24 is used for making payment to the
contractor both for works and supplies.
Or
2. Form 25 : White-Running Account Bill A :
For advance payment without any measurement, this form is
used for the works only but not for supply.
Or
3. Form 26 : White-Running Account Bill B :
This type of form is used so as to secure the advance payment
for works only and it can also be used for running payment
partly for secured advance, partly for measured works and partly
for to advance.
Or
4. Form 26 : Yellow – Final Bill B :
In case if the recovery of secured advance payment is done
already, then form 26-Yellow is used for payment of final bill
for adjustment. If the advance is already recovered then in such
case final bill is prepared on final bill C (i.e. Form 27 Yellow).
Or
5. Form 27 : White – Running Account Bill C :
This type of form is used for the payment of measured works or
supplies. Note that if there is an advance outstanding against the
contractor, then this type of form is not used.
Or
6. Form 27 : Yellow – Final Bill C :
When there is no advance outstanding against the contractor and
intermediate payment is to be made, then in such case, this type
of form is used.
Or
7. Form 27 A : Running Account Bill D :
When the account payment is to be made to the contractors on
lump-sum basis or lump-sum contract, then in such case, this
type of form is used.
Or
8. Form 27 B : Final Bill :
This type of form is used for making the final payment to the
contractors on lump-sum basis. Hence above mentioned forms
are the standard forms of bills used for making the account
payment to the contractors or supplies in various cases like
secured advanced payment, partly payment, lump-sum contract
etc.
1
4
10. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 10 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.2 f)
Ans.
Define interim payment and state purpose of interim payment.
Interim Payment :
A partial payment given to the contractor monthly for works in
progress or supply in progress under the terms of contract is called as
interim payment.
Note that interim payment is not be considered as final acceptance of
the work upto that level. Powers are given to the engineer to hold the
interim payment under special circumstances.
The interim payment are necessary due to following reasons:
1. In case of large project, the contractor has to invest the large
amount for a longer duration and this is not suitable or possible to
the contractor. Progress of project work may affect due to lack of
funds with the contractor. In such case, the interim payment is made
to the contractor so as to continue the progress of project without
any break.
2. The interim payments also indicate the approximate value of work
done by contractor.
3. If the bills are paid to the contractor at interval, there will be the
check over the progress of the project work. Hence the progress of
the work must be in proportion to the duration of the project.
1
1
each
4
11. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 11 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.3
a)
Ans.
b)
Ans.
Attempt any FOUR of the following:
Define Arbitrator. State qualities of arbitrator.
This process of setting the dispute between owner and contractor is
called as arbitration.
Qualities of arbitrator :
1. The arbitrator should be a person having experience of work
2. He should have in depth knowledge of work, rules, procedure and
law.
3. He should be impartial and acceptable to both parties.
Explain in brief ‘Schedule A’ and ‘Schedule B’ .
Schedule A
Sr.
No.
Particulars
of materials
Approximate
quantity
Rates Unit Place of
delivery
In
Figure
In
words
Sign of contractor Signature of
Owner/EE
Date
Purpose of schedule A
Schedule A is statement showing details of materials supplied to
contractor by PWD store, and the rate at which materials are to be
charged
Schedule ‘B’
List of items of work to executed.
Item
No.
Description
of item
Estimated
Qty.
Tender Rate Per Amount
in
figures
in
words
Note :
1. ______________________________________
2. ______________________________________
3. ______________________________________
Signature of Contractor Signature of
Date : Owner / Executive Engineer
1
1
each
1
1
1
16
4
12. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 12 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.3 b)
c)
Ans.
d)
Ans.
Purpose of schedule B:
Schedule „B‟ consist of description of each item, approximate
estimate quantity, rate per unit, the amount of each item and total
amount of all the items.
A contractor has to insert his rates on schedule „B‟ only.
Explain any four situations when contract is terminated.
The contract can be terminated by competent authority the contract
may be terminated under following conditions.
1. If contractor does not fulfill terms and conditions of contract.
2. If contractor does not maintain progress of work.
3. If contractor sublets his contract.
4. Contractor fails to complete work within stipulated period.
5. Bankruptcy of contractor.
6. Mutual agreement between the parties to terminate the contract.
Differentiate between item rate contract and percentage rate
contract.
Sr.
No.
Item rate contract Percentage rate contract
1 In this contract, the
contractor agrees to work as
per the rates quoted by him
for each item.
In this contract, the
contractor agrees to carry
out the work at a certain
percentage below or above
the estimated cost.
2 This is useful when the
quality of work is required
and also quantities of work
to be executed are not
known previously.
This is useful for the work
of all nature with no item-
wise rates.
3 Suitable for most of public
works executed by
government departments.
Suitable for all type of
government as well as
private.
4 It is difficult to prepare
comparative statement.
It is easy to prepare
comparative statement.
1
1
each
(any
four)
1
each
4
4
4
13. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 13 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.3 e)
Ans.
Explain BOT projects with respect to objectives, advantages and
disadvantages.
B.O.T.
B.O.T. is a form of project where government grants permission to
private firm to construct and administrate certain public infrastructure
by financing and authorizing them to pay off loans reclaim investment
by allowing them to collect tools, fees, rent as stated in contract and
after concession period is over, ownership is transferred back to
government.
Objects of B.O.T.
1. To encourage private investment.
2. To promote foreign investment, techniques and technology in
country.
Advantages of B.O.T.
1. Use of private sector financing to provide new source of
capital.
2. Accelerate the development of project.
3. Use of latest techniques and machineries for fast completion of
projects.
Disadvantages of B.O.T.
1. Not suitable for Small works.
2. Transaction cost is high.
3. The success of BOT project depends upon successful raising
of necessary finance.
1
1
½
each
(any
two)
½
each
(any
two)
4
14. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 14 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.4 a)
(i)
Ans.
Attempt any THREE of the following:

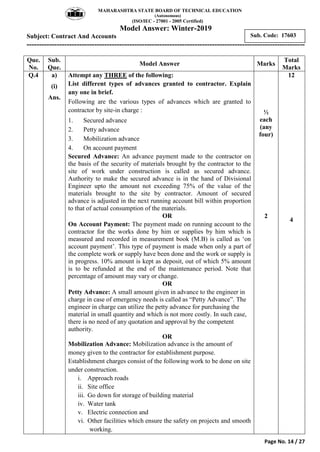

List different types of advances granted to contractor. Explain
any one in brief.
Following are the various types of advances which are granted to
contractor by site-in charge :
1. Secured advance
2. Petty advance
3. Mobilization advance
4. On account payment
Secured Advance: An advance payment made to the contractor on
the basis of the security of materials brought by the contractor to the
site of work under construction is called as secured advance.
Authority to make the secured advance is in the hand of Divisional
Engineer upto the amount not exceeding 75% of the value of the
materials brought to the site by contractor. Amount of secured
advance is adjusted in the next running account bill within proportion
to that of actual consumption of the materials.
OR
On Account Payment: The payment made on running account to the
contractor for the works done by him or supplies by him which is
measured and recorded in measurement book (M.B) is called as „on
account payment‟. This type of payment is made when only a part of
the complete work or supply have been done and the work or supply is
in progress. 10% amount is kept as deposit, out of which 5% amount
is to be refunded at the end of the maintenance period. Note that
percentage of amount may vary or change.
OR
Petty Advance: A small amount given in advance to the engineer in
charge in case of emergency needs is called as “Petty Advance”. The
engineer in charge can utilize the petty advance for purchasing the
material in small quantity and which is not more costly. In such case,
there is no need of any quotation and approval by the competent
authority.
OR
Mobilization Advance: Mobilization advance is the amount of
money given to the contractor for establishment purpose.
Establishment charges consist of the following work to be done on site
under construction.
i. Approach roads
ii. Site office
iii. Go down for storage of building material
iv. Water tank
v. Electric connection and
vi. Other facilities which ensure the safety on projects and smooth
working.
½
each
(any
four)
2
12
4
15. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 15 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.4 (ii)
Ans.
(iii)
Ans.

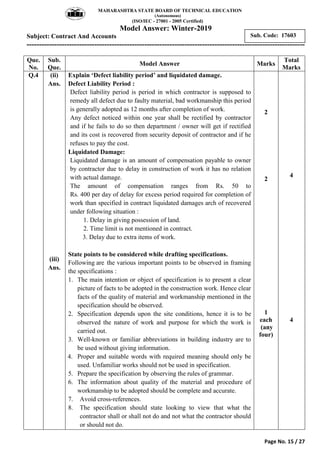

Explain ‘Defect liability period’ and liquidated damage.
Defect Liability Period :
Defect liability period is period in which contractor is supposed to
remedy all defect due to faulty material, bad workmanship this period
is generally adopted as 12 months after completion of work.
Any defect noticed within one year shall be rectified by contractor
and if he fails to do so then department / owner will get if rectified
and its cost is recovered from security deposit of contractor and if he
refuses to pay the cost.
Liquidated Damage:
Liquidated damage is an amount of compensation payable to owner
by contractor due to delay in construction of work it has no relation
with actual damage.
The amount of compensation ranges from Rs. 50 to
Rs. 400 per day of delay for excess period required for completion of
work than specified in contract liquidated damages arch of recovered
under following situation :
1. Delay in giving possession of land.
2. Time limit is not mentioned in contract.
3. Delay due to extra items of work.
State points to be considered while drafting specifications.
Following are the various important points to be observed in framing
the specifications :
1. The main intention or object of specification is to present a clear
picture of facts to be adopted in the construction work. Hence clear
facts of the quality of material and workmanship mentioned in the
specification should be observed.
2. Specification depends upon the site conditions, hence it is to be
observed the nature of work and purpose for which the work is
carried out.
3. Well-known or familiar abbreviations in building industry are to
be used without giving information.
4. Proper and suitable words with required meaning should only be
used. Unfamiliar works should not be used in specification.
5. Prepare the specification by observing the rules of grammar.
6. The information about quality of the material and procedure of
workmanship to be adopted should be complete and accurate.
7. Avoid cross-references.
8. The specification should state looking to view that what the
contractor shall or shall not do and not what the contractor should
or should not do.
2
2
1
each
(any
four)
4
4
16. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 16 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.4 (iii)
(iv)
Ans.
9. The subject matter mentioned in the specification should relate to
the information required when the contract is given to the
contractor.
10. Unfair specifications are not desirable, meaning that throwing all
the possible risks on the shoulders of contractors is unfair and
hence such specification should not be mentioned.
11. The sentences of the specification should be simple and short so as
to avoid the risk of legal difficulties and allegations.
12. Specifications of various items should be framed by keeping the
practical limitations of materials and workmanship in mind.

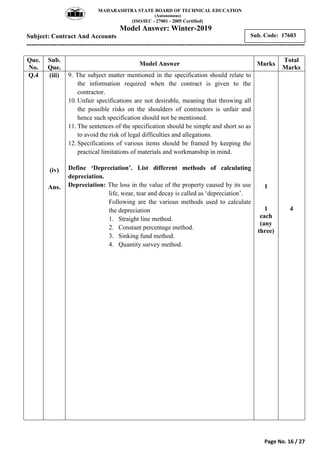

Define ‘Depreciation’. List different methods of calculating
depreciation.
Depreciation: The loss in the value of the property caused by its use
life, wear, tear and decay is called as „depreciation‟.
Following are the various methods used to calculate
the depreciation
1. Straight line method.
2. Constant percentage method.
3. Sinking fund method.
4. Quantity survey method.
1
1
each
(any
three)
4
17. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 17 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.4 b)
(i)
Ans.
(ii)
Ans.
Attempt any ONE of the following:
Explain demolition contract in detail.
This type of contract includes the demolition and the removal of
structure and its component parts and disposal of demolished material.
This is the simplest type of contract in which the owner invites tender
for demolition of an existing structure so that the particular land can
be developed in any manner. It is different from construction contract
due to following reasons:
i. The contract is given to contractor who quotes higher amount, and
contractor has to pay full amount before demolishing the existing
structure.
ii. The contract must clearly state the contractor is responsible for
making necessary arrangements for cutting off existing service
connections of water supply drainage and electricity
iii. The contractor should be asked
State six precautions to be taken while making entries in
measurement book.
Following precautions to be taken while making entries in
Measurement Book:
1. Entries are made by J.E. and certified by S.D.O or A.E.
2. All entries are recorded in ink directly in M.B.
3. No entry is allowed to be erased.
4. If any correction is required, it must be initialed by the officer
who made the measurement.
5. Measurements are taken in the presence of contractor, and his
signature is taken in M.B.
6. Entries should be recorded continuously and no blank pages
left or turn off. Any pages left blank should be cancelled by
diagonal lines and signed by authority.
7. The M.B. contains name of work, name of contractor, date of
measurement, location, date of work order, and number of
measurements.
3
1
each
1
each
(any
six)
6
6
6
18. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 18 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.5
a)
Ans.
Attempt any TWO of the following:

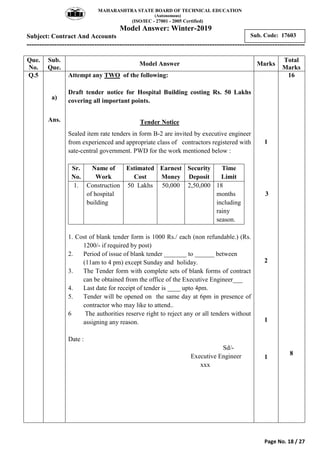

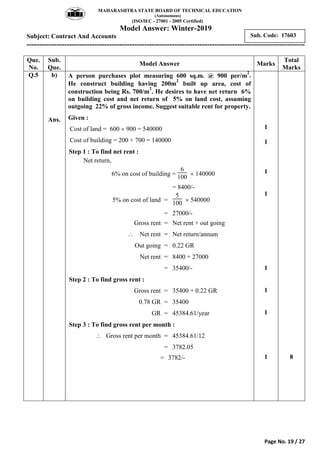

Draft tender notice for Hospital Building costing Rs. 50 Lakhs
covering all important points.
Tender Notice
Sealed item rate tenders in form B-2 are invited by executive engineer
from experienced and appropriate class of contractors registered with
sate-central government. PWD for the work mentioned below :
Sr.
No.
Name of
Work
Estimated
Cost
Earnest
Money
Security
Deposit
Time
Limit
1. Construction
of hospital
building
50 Lakhs 50,000 2,50,000 18
months
including
rainy
season.
1. Cost of blank tender form is 1000 Rs./ each (non refundable.) (Rs.
1200/- if required by post)
2. Period of issue of blank tender _______ to ______ between
(11am to 4 pm) except Sunday and holiday.
3. The Tender form with complete sets of blank forms of contract
can be obtained from the office of the Executive Engineer___
4. Last date for receipt of tender is ____ upto 4pm.
5. Tender will be opened on the same day at 6pm in presence of
contractor who may like to attend..
6 The authorities reserve right to reject any or all tenders without
assigning any reason.
Date :
Sd/-
Executive Engineer
xxx
1
3
2
1
1
16
8
19. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 19 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.5 b)
Ans.
A person purchases plot measuring 600 sq.m. @ 900 per/m
2
.
He construct building having 200m
2
built up area, cost of
construction being Rs. 700/m
2
. He desires to have net return 6%
on building cost and net return of 5% on land cost, assuming
outgoing 22% of gross income. Suggest suitable rent for property.
Given :
Cost of land = 600 900 = 540000 = 540,000
Cost of building = 200 × 700 = 140000 = 140,000
Step 1 : To find net rent :
Net return,
6% on cost of building =
6
100
140000
= 8400/-
5% on cost of land =
5
100
540000
= 27000/-
Gross rent = Net rent + out going
Net rent = Net return/annum
Out going = 0.22 GR
Net rent = 8400 + 27000
= 35400/-
Step 2 : To find gross rent :
Gross rent = 35400 + 0.22 GR
0.78 GR = 35400
GR = 45384.61/year
Step 3 : To find gross rent per month :
Gross rent per month = 45384.61/12
= 3782.05
= 3782/-
1
1
1
1
1
1
1
1 8
20. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 20 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks

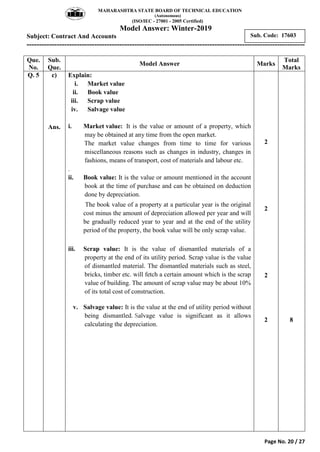

Q. 5 c)
Ans.
Explain:
i. Market value
ii. Book value
iii. Scrap value
iv. Salvage value
i. Market value: It is the value or amount of a property, which
may be obtained at any time from the open market.
The market value changes from time to time for various
miscellaneous reasons such as changes in industry, changes in
fashions, means of transport, cost of materials and labour etc.
.
ii. Book value: It is the value or amount mentioned in the account
book at the time of purchase and can be obtained on deduction
done by depreciation.
The book value of a property at a particular year is the original
cost minus the amount of depreciation allowed per year and will
be gradually reduced year to year and at the end of the utility
period of the property, the book value will be only scrap value.
iii. Scrap value: It is the value of dismantled materials of a
property at the end of its utility period. Scrap value is the value
of dismantled material. The dismantled materials such as steel,
bricks, timber etc. will fetch a certain amount which is the scrap
value of building. The amount of scrap value may be about 10%
of its total cost of construction.
v. Salvage value: It is the value at the end of utility period without
being dismantled. Salvage value is significant as it allows
calculating the depreciation.
2
2
2
2 8
21. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 21 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.6
a)
Ans.
Attempt any FOUR of the following:

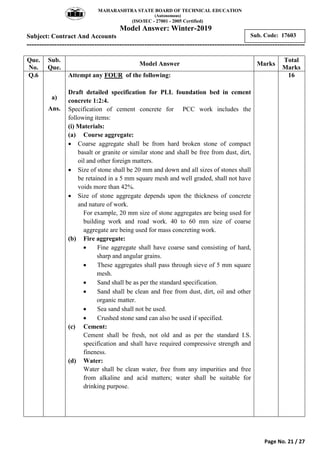

Draft detailed specification for PLL foundation bed in cement
concrete 1:2:4.
Specification of cement concrete for PCC work includes the
following items:
(i) Materials:
(a) Course aggregate:
Coarse aggregate shall be from hard broken stone of compact
basalt or granite or similar stone and shall be free from dust, dirt,
oil and other foreign matters.
Size of stone shall be 20 mm and down and all sizes of stones shall
be retained in a 5 mm square mesh and well graded, shall not have
voids more than 42%.
Size of stone aggregate depends upon the thickness of concrete
and nature of work.
For example, 20 mm size of stone aggregates are being used for
building work and road work. 40 to 60 mm size of coarse
aggregate are being used for mass concreting work.
(b) Fire aggregate:
Fine aggregate shall have coarse sand consisting of hard,
sharp and angular grains.
These aggregates shall pass through sieve of 5 mm square
mesh.
Sand shall be as per the standard specification.
Sand shall be clean and free from dust, dirt, oil and other
organic matter.
Sea sand shall not be used.
Crushed stone sand can also be used if specified.
(c) Cement:
Cement shall be fresh, not old and as per the standard I.S.
specification and shall have required compressive strength and
fineness.
(d) Water:
Water shall be clean water, free from any impurities and free
from alkaline and acid matters; water shall be suitable for
drinking purpose.
16
22. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 22 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks

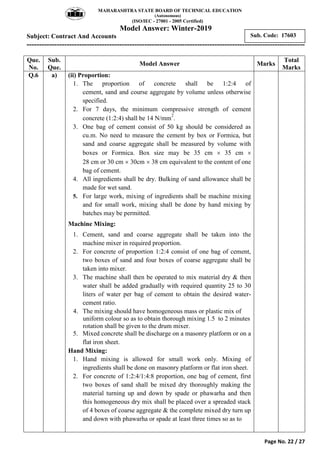

Q.6 a) (ii) Proportion:
1. The proportion of concrete shall be 1:2:4 of
cement, sand and course aggregate by volume unless otherwise
specified.
2. For 7 days, the minimum compressive strength of cement
concrete (1:2:4) shall be 14 N/mm
2
.
3. One bag of cement consist of 50 kg should be considered as
cu.m. No need to measure the cement by box or Formica, but
sand and coarse aggregate shall be measured by volume with
boxes or Formica. Box size may be 35 cm 35 cm
28 cm or 30 cm 30cm 38 cm equivalent to the content of one
bag of cement.
4. All ingredients shall be dry. Bulking of sand allowance shall be
made for wet sand.
5. For large work, mixing of ingredients shall be machine mixing
and for small work, mixing shall be done by hand mixing by
batches may be permitted.
Machine Mixing:
1. Cement, sand and coarse aggregate shall be taken into the
machine mixer in required proportion.
2. For concrete of proportion 1:2:4 consist of one bag of cement,
two boxes of sand and four boxes of coarse aggregate shall be
taken into mixer.
3. The machine shall then be operated to mix material dry & then
water shall be added gradually with required quantity 25 to 30
liters of water per bag of cement to obtain the desired water-
cement ratio.
4. The mixing should have homogeneous mass or plastic mix of
uniform colour so as to obtain thorough mixing 1.5 to 2 minutes
rotation shall be given to the drum mixer.
5. Mixed concrete shall be discharge on a masonry platform or on a
flat iron sheet.
Hand Mixing:
1. Hand mixing is allowed for small work only. Mixing of
ingredients shall be done on masonry platform or flat iron sheet.
2. For concrete of 1:2:4/1:4:8 proportion, one bag of cement, first
two boxes of sand shall be mixed dry thoroughly making the
material turning up and down by spade or phawarha and then
this homogeneous dry mix shall be placed over a spreaded stack
of 4 boxes of coarse aggregate & the complete mixed dry turn up
and down with phawarha or spade at least three times so as to

23. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 23 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.6 a) obtain uniform mix. Then water shall be added slowly and gradually
and then turning the mix up and down at least three times by spade
till to obtain a plastic mix of the required workability and water –
cement ratio.
3. Water quantity shall be of 25 to 30 liters per bag of cement.
(iii) Slump test:
Regular slump test shall be carried out so as to check the
workability of concrete mix and to control the addition of water.
For building work, a slump of 75 mm to 100 mm may be
permitted and for road work, 30 mm to 40 mm may be allowed.
(iv) Form work:
Form work and centering shall be used as per the standard
specifications‟
Internal surface of formwork shall be applied by oil so as to
avoid sticking of concrete during removal of the formwork.
The base of formwork shall be watered before laying the
concrete on it.
Forms at the bottom surface in case of beam and slab shall not be
removed before 14 days in general and sides of form shall be
removed after 3 days.
Form work shall be removed slowly and with care and not to
disturb and damage the concrete.
(v) Laying of concrete:
Concrete shall be laid gently in layers not exceeding 150 mm
and compacted with rods & tamping with wooden tampers or
with mechanical vibrating machine until a dense concrete is
obtained.
Immersion type vibrators or needle vibrators shall be used for
thick concrete or mass concrete. Surface vibrators or form
vibrators shall be used for thin concrete. There shall not be over
vibration.
Concrete shall be laid continuously. If laying of concrete is
suspended for rest or on next day
the end of concrete shall be slope with an angle of 30 and its
surface shall be made rough for proper joining.
If the concreting work is resumed, the previous sloped portion
shall be made rough, clean, watered and a grout of neat cement
shall be applied and fresh concrete shall be laid in successive
layer in such way that the upper layer shall be laid before the
lower layer is set.
4
4
24. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 24 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.6 a)
b)
Ans.
c)
Ans.
(vi) Curing:
When concrete is on the point of hardening, after and about two
hours laying, then it shall be kept wet by covering with wet
gummy bags for 24 hours and then cured by flooding with water.
Making mud wall 75 mm high or by covering with wet sand
continuously for 15 days.
In case of flat concrete work like slabs, the ponding method of
curing shall be used.
Measurement:
The measurement shall be taken as per the dewing or as per
instruction of the engineer.
Explain in brief legal aspect of specification.
i. Specification of various items becomes the important documents
as per as legal aspect like contract and agreements are concerned.
Hence the drawing and specifications are two important contract
documents considered as a legal documents.
ii. The tender documents and agreements towards legal aspect are
incomplete and invalid without specifications.
iii. Specifications have more legal strength and hence most of the
contract state that in case of discrepancy between the drawings and
specifications, the specification act as a legal proof.
iv. In case of disputes between the owner and the contractor,
specifications act as a useful legal documents to solve the problem
in between two party.
Enlist types of specifications and explain any one in brief.
Following are the various types of specifications :
a. Brief specification
b. Detailed specification
c. Standard specification
d. Manufacturers specification
a. Brief specification :
i. The general specification used for estimating the project are the
brief specifications.
ii. General information for the quantities of materials, nature and
class of work is short and not with the lengthy detailed
specification. Note that brief specification do not form the part of
the contract document.
iii. Though the information is short and not lengthy but the general
information should be known and understand.
OR
1
each
½
each
2
4
4
25. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 25 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks

Q.6 c) 2. Detailed specification :
The specification in which detailed information of the various
quantities of materials, procedure of workmanship to be adopted,
nature and class of work is mentioned.
Hence detailed specification form a part of contract document.
Detailed specification for a particular item specify the following
information :
i. Qualities of material
ii. Quantities of material and their proportions
iii. Method of doing work or procedure of work.
iv. Test required on the constructional material or on the
finished items.
v. Type of equipments and machinery used.
vi. Special tools and plants used.
vii.Method of operations of special tools and plants.
In short, without the detailed specification for a particular item, the
tender documents and contract are incomplete and considered as
invalid.
OR
3. Standard specification :
Detailed specifications for various works are drawn up by an
engineering department and these specifications are printed and
used as a standard specification. Hence most of the items in works
are made to standardized specifications.
Standard specification play a vital role that it work as guide and
also refer in the specification part of a tender documents and thus
avoids writing lengthy specification.
Note that whenever the standard specifications are accepted for a
particular work, then it should be observed carefully and suitable
modifications or necessary corrections are made accordingly.
Standard specifications must be periodically revised so as to
include some changes in techniques.
Specifications of items such as stone work, brickwork, plastering,
pointing, excavation, earthwork concreting etc. becomes common
in writing particulars of such items and hence it is not required to
write such common specification again and again.
Standard specifications are mostly referred because it saves the
time and there is no possibility of doing mistakes.
OR
26. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 26 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.6 c)
d)
Ans.
e)
Ans.
4. Manufacturers specifications :
This type of specifications in which the properties of products
such as strength, thickness, depth, elasticity, chemical
composition etc. are mentioned.
Specifications of the products of the manufacturer like steel, mild
steel, tor steel, plain steel, cement, paints, valves etc. are included
under head of manufacturer‟s specification.
Define value of property. State factors affecting value.
The corresponding exchange of one commodity to any other
commodity is termed as value. In case of civil engineering value of
the property is expressed in terms of money. Value of the property
means its worth or utility.
The value of the property depend upon, the following various factors:
1.Structure of the property
2.Life of the property
3.Location of the property
4.Maintenance of the property
5.Legal control of the property
6.Demand/supply ratio
7.Purpose for which valuation is done for the property.
8.Inflation of property
9.Returns from the property.
10. Facilities and amenities available (such as water supply line,
drainage line) ; electric supply; market, etc.

Explain various types of outgoings.
1. Municipal taxes:
a. The taxes which are paid to the local authority for services
like water supply; sanitation etc.
b. Such taxes are calculated at certain percentage of rateable
value of the property.
2. Government taxes:
The taxes which are paid to the government land tax, education
taxes are to be paid to the government authority.
3. Annual repairs and maintenance:
The amount spent on the repairs and maintenance depends upon
a) Age of building
b) Condition of the building
c) Use of the building
d) Climatic conditions or weathering effects to which
1
½
each
(any
six)
4
27. MAHARASHTRA STATE BOARD OF TECHNICAL EDUCATION
(Autonomous)
(ISO/IEC - 27001 - 2005 Certified)
Model Answer: Winter-2019
Subject: Contract And Accounts
---------------------------------------------------------------------------------------------------------------
Page No. 27 / 27
Sub. Code: 17603
Que.
No.
Sub.
Que.
Model Answer Marks
Total
Marks
Q.6 e) building is subjected to.
e) Number of tenants occupying the building.
1% to 1.5% of the total cost of construction is considered for
annual repairs and maintenance.
4. Insurance:
a) Insurance is the premium paid by the owner of the property.
b) It depends upon sum assured.
5. Management and collection:
1. Management and collection are the charges which consists of
the expenses on watchman, liftman, sweeper, rent collector etc.
2. These charges are generally taken 5 to 10% of the gross rent.
6. Sinking fund:
Fund created by regular periodic payments which accumulate at
the compound interest is a sinking fund. Amount of sinking fund
is used at the end of utility period of the structure.
1
each
(any
four)
4
