Xcelience Overview
       2013
Core Principles



 We are all in the business of improving
       the quality of human lives.

 Each of us is joined in the commitment to
   reach critical milestones faster, deliver
clinical materials on time, control costs, and
          above all to ensure quality.

At Xcelience, we commit to hold ourselves to
  ever-increasing high standards of quality,
service performance, and drug development
 expertise that in turn enable our clients to
overcome drug development challenges and
  improve chances for compound success.

We are early drug development made easy
                 – at last.
Xcelience is a premier provider of preformulation,
 analytical, formulation development, manufacturing and
clinical packaging solutions with an established reputation
              for accelerating project timelines.




 2012 Regulatory Recognition           Top 10 CMO in 2012

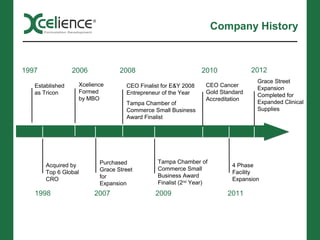

Company History



1997             2006           2008                          2010             2012
                                                                                Grace Street
   Established    Xcelience       CEO Finalist for E&Y 2008    CEO Cancer
                                                                                Expansion
   as Tricon      Formed          Entrepreneur of the Year     Gold Standard
                                                                                Completed for
                  by MBO                                       Accreditation
                                  Tampa Chamber of                              Expanded Clinical
                                  Commerce Small Business                       Supplies
                                  Award Finalist




                         Purchased           Tampa Chamber of
       Acquired by                                                      4 Phase
                         Grace Street        Commerce Small
       Top 6 Global                                                     Facility
                         for                 Business Award
       CRO                                                              Expansion
                         Expansion           Finalist (2nd Year)
   1998                 2007                2009                      2011
Convenient Location

cGMP Compliant Tampa, Florida Location
•   Laurel Facility (24,000 ft2)
•   Grace Facility (24,000 ft2)

FDA Inspected
•   2008, December (PAI)
•   2006, June (General Systems)
•   2003, August (General Systems)



DEA Schedule License
•   I to V Analytical–DEA Inspected 2012, January
•   II to V Manufacturing–DEA Inspected 2010, January
•   I to V Analytical–DEA Inspected 2009, December

Florida Dept. of Health Audit
•   State of Florida Inspected 2010, September

European Union Requirements
•   Multiple Qualified Person (QP) Audits
Core Competencies


 Preformulation Services
     >   Polymorph Screening, Salt Selection,
         Drug Product Characterization
 Analytical Services
     >   Method Development and Validation,
         Waters and Agilent Instrumentation
 Formulation Development
     >   Solids, Semi-solids, Oral Liquids
 Manufacturing, Packaging and Labeling
     >   Solids, Semi-solids, Oral Liquids
     >   Direct Fill API into Capsules
     >   Matching placebo formulation
     >   Blinded reference product
     >   Bottling or Blister Packaging
 Stability Program Management
     Broad variety of temperature and humidity
         conditions
Preformulation Services

Solid and Solution Characterization
Drug substance characterization can be conducted using the
   following equipment (tests):
    –   Thermal evaluation (DSC, TGA and/or Hot Stage)
    –   Particle Size
    –   FTIR
    –   XRD
    –   Morphology analysis (polarized microscope)
    –   pKa determination (calculated or experimental)
    –   log P / log D determination
    –   Moisture content (Karl Fischer)
    –   Moisture sorption profile (VSA)
    –   pH solubility profiles
    –   Solubility studies (visual, HPLC and/or UV)
Analytical Services



 Method Development,
  Qualification, and Validation
 Technical Packages for Drug
  Substances
 HPLC/Dissolution Testing
 Residual Solvent Analysis
 Raw Material Testing
 Stability Sample Analysis
 Chiral Determination
 Cleaning Evaluations
 Stability Program Mgmt and
  Sample Analysis
Analytical Instrumentation



•   Equipment
     – HPLC: 30 instruments, Waters and Agilent
     – UPLC: 2
     – GC w/ Headspace
     – Dissolution Stations w/ autosamplers: 9 instruments,
       Vankel and Distek
       (apparatus 1 & 2 - bath and bathless)
    – UV/Vis
    – FTIR
    – Karl Fischer: Coulometric and Volumetric
    – Brookfield Viscometer
Formulation Services


 Solids
   > Tablets, capsules, sustained release, coatings
 Semi-Solids
   > Ointments, creams/emulsions, gels
 Dispersed Systems
   > SEDDS/SMEDDS, suspensions
 Liquids
   > Orals
   > Parenterals (tox only)
Formulation Development for
                                   Poorly Soluble Compounds


Conventional Formulations/Processes              Alternate Processing

 Use water soluble excipients           Add drug to aqueous granulating
 Micronize the API                       solution containing wetting/solubilizing
                                          agent
 pH modifiers
                                         Dissolve API in hydroalcoholic/
    > citric acid, succinic acid etc
                                          alcoholic granulating solution
 Solubilizing/wetting agents
                                             > May alter API characteristics
    > sodium laurel sulfate, Tween 80
                                         Form Solid dispersion/solution in hot
                                          melt process using CFS1200™
                                         Complexing agents (Cyclodextrins)
                                         Liquid fill hard gelatin capsule
Manufacturing



 Manufacturing                 Additional Expertise
   > Tablets and capsules          > Creation of matching placebo
       • Sustained release           formulation
       • Coatings                  > Creation and qualification of
   > API in a capsule                blinded reference product
   > Liquids in a capsule          > Process qualification
       • Suspensions               > Technology transfer
       • Emulsions                 > Process definition optimization
   > Semi-solids
   > Non-sterile liquid
 Reference Product Blinding
 Packaging and Labeling
Partnering Advantage


                                                           Partnering with Xcelience can reduce
                                                          product risk and accelerate timelines for
                                                              early phase drug development


API in Capsule                                                                                                                 Week
                                                          1       2       3            4        5           6        7        8    9                10        11       12        13       14         15        16
API Characterization                                      1       2       3            4        5           6        7        8    9                10        11       12
Analytical - API Method Evaluation / Dev                  1                                     1           2        3        4    5                6          7       8
Analytical - DP Evaluation / Method Dev                                                                                       1    2                3          4       5         6         7         8
Feasibility Study - Capsule Compatibility                                                                                     1    2                3          4
Create and Approve GMP Batch Records                                                                                                                           1                                                                                       13 Weeks
Manufacture GMP Batches                                                                                                                                                 1        2
Release Testing of GMP Material                                                                                                                                                            1         2
Initiate ICH Stability Study                                                                                                                                                                                   1

Traditional Formulation                                                                                                                                                                             Week
                                                              1       2       3            4        5           6        7        8            9     10 11 12                    13        14         15       16            17    18   19   20   21    22   23   24   25   26   27   28   29
API Characterization                                      1       2       3            4        5           6        7        8            9        10 11 12
Exipient Compatibility                                                                                                                              1   2  3                     4         5         6         7         8         9    10   11   12   13    14
Formulation Development / Selection                                                                                                                                              1         2         3         4         5         6     7   8
Analytical - DP Evaluation / Method Dev                                                                                                                                                    1         2         3         4         5     6   7    8
Prototype Stability                                                                                                                                                                                                                1     2   3    4     5    6    7    8    9    10   11   12
Create /Approve GMP Batch Records                                                                                                                                                                                                                                 1
Manufacture of GMP Batches                                                                                                                                                                                                                                             1    2
Release Testing of GMP Material                                                                                                                                                                                                                                                  1    2
Initiate ICH Stability Study                                                                                                                                                                                                                                                               1




                                                                                                Week
                                      1   2   3   4   5       6   7   8   9       10       11   12 13       14      15   16   17      18       19   20   21    22      23   24   25   26       27    28   29    30      31    32   33


       Accelerate Timelines. Conserve API. Minimize Downstream Problems.
API Characterization                  1   2   3   4   5       6   7   8   9       10       11   12
Excipient Compatibility                                                           1        2    3       4       5   6    7    8       9        10   11   12    13      14
DevDevelopment                                                            1       2        3    4       5       6
Formulation Development / Selection                                                                                           1       2        3    4     5        6    7    8
Analytical - DP Eval./ Method Dev                                                                                                     1        2    3    4     5       6    7    8
Prototype Stability                                                                                                                                            1       2    3    4    5         6     7    8        9   10    11   12
Market Leadership


Powder-in-Capsule
 > Faster time to FIH studies
 > Market leading experience
        > 100 APIs, >130 batches
 > Defined programs, proven results
        API into capsule projects are on average
         completed 45% faster than traditional
         formulation development efforts, shave
         13-17 weeks from total development time
 > Greater global capacity
        Three dedicated Xcelodose® systems
        3 NA, 1 EU
        Xcelodose® systems in the experimental
         area enable clients to use laboratory
         grade material for dispensing head
         selection, filling process evaluation,
         capsule compatibility, or to fill powder into
         capsule (PIC) for preclinical studies.
Stability



• ICH conditions
• Protocol design
• Report generation
• Stability software management system
• Sample analysis
• Secure storage area
Enhanced Expertise,
                                        Improved Production Times

 Expanded Roller Compaction Capabilities
    > Micromeritics AccuPyc II 1340 Gas Pycnometer
    > Micromeritics GeoPyc 1360 Envelope and T.A.P. Density Analyzer


 Expanded Encapsulation Capabilities
    >   MG Futura – capsule filling for powder and pellets
    >   LCI multi-granulator MG-55 (extruder)
    >   QJ-230T marumerizer (spheronizer)
    >   Wurster insert (bottom spray) for Glatt GPCG-3 fluid bed processor

 New Fully-Automated Packaging Line (including ink-jet coding)
    > For primary bottling of tablets and capsules
Clinical Packaging Services

 Primary packaging
      Filling of API into bottles (AIB)
      Filling of API into capsules (AIC)
      Powder filling into sachet/pouch
      Blister packaging including cold form aluminum blisters
      Card/wallet sealing
      Bottle packaging
 Labeling and assembly services
      Multi-language booklet labeling
      Open label / double blind labeling, disclosure envelopes
      Randomization services
      Patient kit assembly
 Warehousing and distribution
      cGMP warehousing of clinical supplies
      Storage and handling of schedule II-V products
      Global site distribution and tracking
 Package engineering and design
      Tooling, card/wallet (CR) and patient kits
 Global procurement of comparator medications
      Supported with product pedigree documents
Four Phase Facility Expansion


Phase 1: Laurel Expansion – Complete
  > Expands formulation development capacity, Increases speed
Phase 2: Laurel Expansion – Complete
  > Expands analytical and formulation development capacity,
    Increases speed
  > Expands manufacturing and packaging capabilities
Phase 3: Laurel Expansion – Complete
  > Renovation and expansion of the existing cGMP
    manufacturing/packaging area
Phase 4: Grace Facility Expansion – Complete
  > Purpose-built expansion of new primary and secondary clinical
    packaging facility
Download Scientific Content




Scan the QR code, or visit
www.xceliencexpertise.com
to access free scientific
content
Unique Advantage


  Market Leading             Performance                   Sound
    Expertise                  Culture                   Management

Recognized formulation   Scheduling flexibility,     Conservative financial
development expertise    FTE programs                management

Proven expertise with    Disciplined project         Diversified client mix
low dose formulations    management
                                                Minimal employee
Streamlined equipment    No double-booking,     turnover, retained
from experimental to     99% on-time completion project knowledge
GMP                      record
                                                Ability to attract and
API sparing strategies   Quality systems ensure retain top talent
minimize waste           safe handling of
                         cytotoxic / potent
                         compounds
Choose Xcelience




Quality-First Focus. Expertise. Flexibility.
                Partnership
Thank you!



For more information please contact:


Sharon Burgess
   Email:   sharon.burgess@xcelience.com
   Phone: 603-226-4060
   Cell:  603-731-3691
   Fax:   603-415-3330

Xcelience linked in2013

  • 1.
  • 2.
    Core Principles Weare all in the business of improving the quality of human lives. Each of us is joined in the commitment to reach critical milestones faster, deliver clinical materials on time, control costs, and above all to ensure quality. At Xcelience, we commit to hold ourselves to ever-increasing high standards of quality, service performance, and drug development expertise that in turn enable our clients to overcome drug development challenges and improve chances for compound success. We are early drug development made easy – at last.
  • 3.
    Xcelience is apremier provider of preformulation, analytical, formulation development, manufacturing and clinical packaging solutions with an established reputation for accelerating project timelines. 2012 Regulatory Recognition Top 10 CMO in 2012
  • 4.
    Company History 1997 2006 2008 2010 2012 Grace Street Established Xcelience CEO Finalist for E&Y 2008 CEO Cancer Expansion as Tricon Formed Entrepreneur of the Year Gold Standard Completed for by MBO Accreditation Tampa Chamber of Expanded Clinical Commerce Small Business Supplies Award Finalist Purchased Tampa Chamber of Acquired by 4 Phase Grace Street Commerce Small Top 6 Global Facility for Business Award CRO Expansion Expansion Finalist (2nd Year) 1998 2007 2009 2011
  • 5.
    Convenient Location cGMP CompliantTampa, Florida Location • Laurel Facility (24,000 ft2) • Grace Facility (24,000 ft2) FDA Inspected • 2008, December (PAI) • 2006, June (General Systems) • 2003, August (General Systems) DEA Schedule License • I to V Analytical–DEA Inspected 2012, January • II to V Manufacturing–DEA Inspected 2010, January • I to V Analytical–DEA Inspected 2009, December Florida Dept. of Health Audit • State of Florida Inspected 2010, September European Union Requirements • Multiple Qualified Person (QP) Audits
  • 6.
    Core Competencies  PreformulationServices > Polymorph Screening, Salt Selection, Drug Product Characterization  Analytical Services > Method Development and Validation, Waters and Agilent Instrumentation  Formulation Development > Solids, Semi-solids, Oral Liquids  Manufacturing, Packaging and Labeling > Solids, Semi-solids, Oral Liquids > Direct Fill API into Capsules > Matching placebo formulation > Blinded reference product > Bottling or Blister Packaging  Stability Program Management Broad variety of temperature and humidity conditions
  • 7.
    Preformulation Services Solid andSolution Characterization Drug substance characterization can be conducted using the following equipment (tests): – Thermal evaluation (DSC, TGA and/or Hot Stage) – Particle Size – FTIR – XRD – Morphology analysis (polarized microscope) – pKa determination (calculated or experimental) – log P / log D determination – Moisture content (Karl Fischer) – Moisture sorption profile (VSA) – pH solubility profiles – Solubility studies (visual, HPLC and/or UV)
  • 8.
    Analytical Services  MethodDevelopment, Qualification, and Validation  Technical Packages for Drug Substances  HPLC/Dissolution Testing  Residual Solvent Analysis  Raw Material Testing  Stability Sample Analysis  Chiral Determination  Cleaning Evaluations  Stability Program Mgmt and Sample Analysis
  • 9.
    Analytical Instrumentation • Equipment – HPLC: 30 instruments, Waters and Agilent – UPLC: 2 – GC w/ Headspace – Dissolution Stations w/ autosamplers: 9 instruments, Vankel and Distek (apparatus 1 & 2 - bath and bathless) – UV/Vis – FTIR – Karl Fischer: Coulometric and Volumetric – Brookfield Viscometer
  • 10.
    Formulation Services  Solids > Tablets, capsules, sustained release, coatings  Semi-Solids > Ointments, creams/emulsions, gels  Dispersed Systems > SEDDS/SMEDDS, suspensions  Liquids > Orals > Parenterals (tox only)
  • 11.
    Formulation Development for Poorly Soluble Compounds Conventional Formulations/Processes Alternate Processing  Use water soluble excipients  Add drug to aqueous granulating  Micronize the API solution containing wetting/solubilizing agent  pH modifiers  Dissolve API in hydroalcoholic/ > citric acid, succinic acid etc alcoholic granulating solution  Solubilizing/wetting agents > May alter API characteristics > sodium laurel sulfate, Tween 80  Form Solid dispersion/solution in hot melt process using CFS1200™  Complexing agents (Cyclodextrins)  Liquid fill hard gelatin capsule
  • 12.
    Manufacturing  Manufacturing  Additional Expertise > Tablets and capsules > Creation of matching placebo • Sustained release formulation • Coatings > Creation and qualification of > API in a capsule blinded reference product > Liquids in a capsule > Process qualification • Suspensions > Technology transfer • Emulsions > Process definition optimization > Semi-solids > Non-sterile liquid  Reference Product Blinding  Packaging and Labeling
  • 13.
    Partnering Advantage Partnering with Xcelience can reduce product risk and accelerate timelines for early phase drug development API in Capsule Week 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 API Characterization 1 2 3 4 5 6 7 8 9 10 11 12 Analytical - API Method Evaluation / Dev 1 1 2 3 4 5 6 7 8 Analytical - DP Evaluation / Method Dev 1 2 3 4 5 6 7 8 Feasibility Study - Capsule Compatibility 1 2 3 4 Create and Approve GMP Batch Records 1 13 Weeks Manufacture GMP Batches 1 2 Release Testing of GMP Material 1 2 Initiate ICH Stability Study 1 Traditional Formulation Week 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 API Characterization 1 2 3 4 5 6 7 8 9 10 11 12 Exipient Compatibility 1 2 3 4 5 6 7 8 9 10 11 12 13 14 Formulation Development / Selection 1 2 3 4 5 6 7 8 Analytical - DP Evaluation / Method Dev 1 2 3 4 5 6 7 8 Prototype Stability 1 2 3 4 5 6 7 8 9 10 11 12 Create /Approve GMP Batch Records 1 Manufacture of GMP Batches 1 2 Release Testing of GMP Material 1 2 Initiate ICH Stability Study 1 Week 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 Accelerate Timelines. Conserve API. Minimize Downstream Problems. API Characterization 1 2 3 4 5 6 7 8 9 10 11 12 Excipient Compatibility 1 2 3 4 5 6 7 8 9 10 11 12 13 14 DevDevelopment 1 2 3 4 5 6 Formulation Development / Selection 1 2 3 4 5 6 7 8 Analytical - DP Eval./ Method Dev 1 2 3 4 5 6 7 8 Prototype Stability 1 2 3 4 5 6 7 8 9 10 11 12
  • 14.
    Market Leadership Powder-in-Capsule >Faster time to FIH studies > Market leading experience  > 100 APIs, >130 batches > Defined programs, proven results  API into capsule projects are on average completed 45% faster than traditional formulation development efforts, shave 13-17 weeks from total development time > Greater global capacity  Three dedicated Xcelodose® systems  3 NA, 1 EU  Xcelodose® systems in the experimental area enable clients to use laboratory grade material for dispensing head selection, filling process evaluation, capsule compatibility, or to fill powder into capsule (PIC) for preclinical studies.
  • 15.
    Stability • ICH conditions •Protocol design • Report generation • Stability software management system • Sample analysis • Secure storage area
  • 16.
    Enhanced Expertise, Improved Production Times  Expanded Roller Compaction Capabilities > Micromeritics AccuPyc II 1340 Gas Pycnometer > Micromeritics GeoPyc 1360 Envelope and T.A.P. Density Analyzer  Expanded Encapsulation Capabilities > MG Futura – capsule filling for powder and pellets > LCI multi-granulator MG-55 (extruder) > QJ-230T marumerizer (spheronizer) > Wurster insert (bottom spray) for Glatt GPCG-3 fluid bed processor  New Fully-Automated Packaging Line (including ink-jet coding) > For primary bottling of tablets and capsules
  • 17.
    Clinical Packaging Services Primary packaging  Filling of API into bottles (AIB)  Filling of API into capsules (AIC)  Powder filling into sachet/pouch  Blister packaging including cold form aluminum blisters  Card/wallet sealing  Bottle packaging  Labeling and assembly services  Multi-language booklet labeling  Open label / double blind labeling, disclosure envelopes  Randomization services  Patient kit assembly  Warehousing and distribution  cGMP warehousing of clinical supplies  Storage and handling of schedule II-V products  Global site distribution and tracking  Package engineering and design  Tooling, card/wallet (CR) and patient kits  Global procurement of comparator medications  Supported with product pedigree documents
  • 18.
    Four Phase FacilityExpansion Phase 1: Laurel Expansion – Complete > Expands formulation development capacity, Increases speed Phase 2: Laurel Expansion – Complete > Expands analytical and formulation development capacity, Increases speed > Expands manufacturing and packaging capabilities Phase 3: Laurel Expansion – Complete > Renovation and expansion of the existing cGMP manufacturing/packaging area Phase 4: Grace Facility Expansion – Complete > Purpose-built expansion of new primary and secondary clinical packaging facility
  • 19.
    Download Scientific Content Scanthe QR code, or visit www.xceliencexpertise.com to access free scientific content
  • 21.
    Unique Advantage Market Leading Performance Sound Expertise Culture Management Recognized formulation Scheduling flexibility, Conservative financial development expertise FTE programs management Proven expertise with Disciplined project Diversified client mix low dose formulations management Minimal employee Streamlined equipment No double-booking, turnover, retained from experimental to 99% on-time completion project knowledge GMP record Ability to attract and API sparing strategies Quality systems ensure retain top talent minimize waste safe handling of cytotoxic / potent compounds
  • 22.
    Choose Xcelience Quality-First Focus.Expertise. Flexibility. Partnership
  • 23.
    Thank you! For moreinformation please contact: Sharon Burgess Email: sharon.burgess@xcelience.com Phone: 603-226-4060 Cell: 603-731-3691 Fax: 603-415-3330
