The document provides specifications for three construction projects:

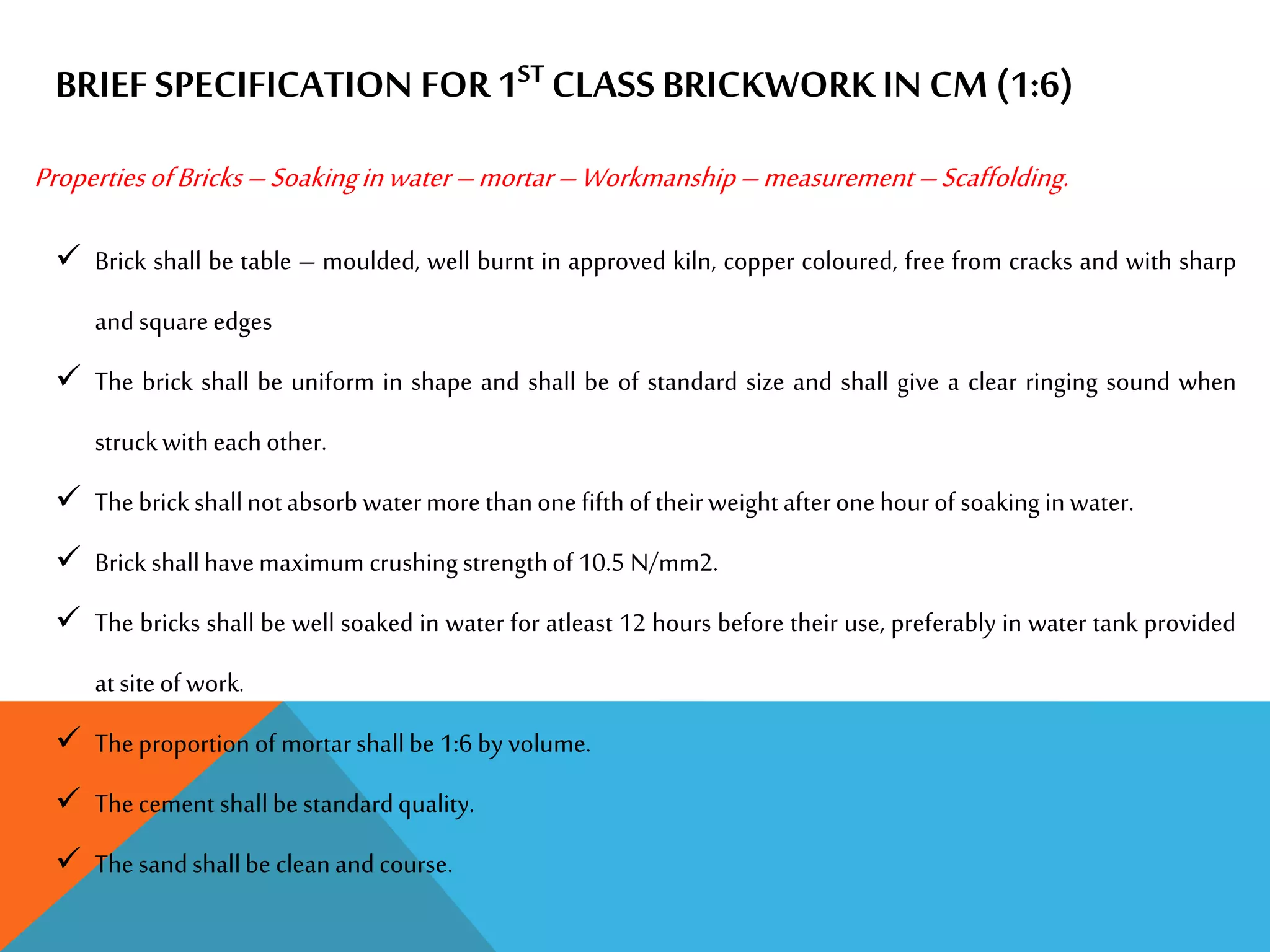

1) 1st class brickwork in cement mortar (1:6), requiring soaked bricks laid with mortar and skilled masons over 15 days.

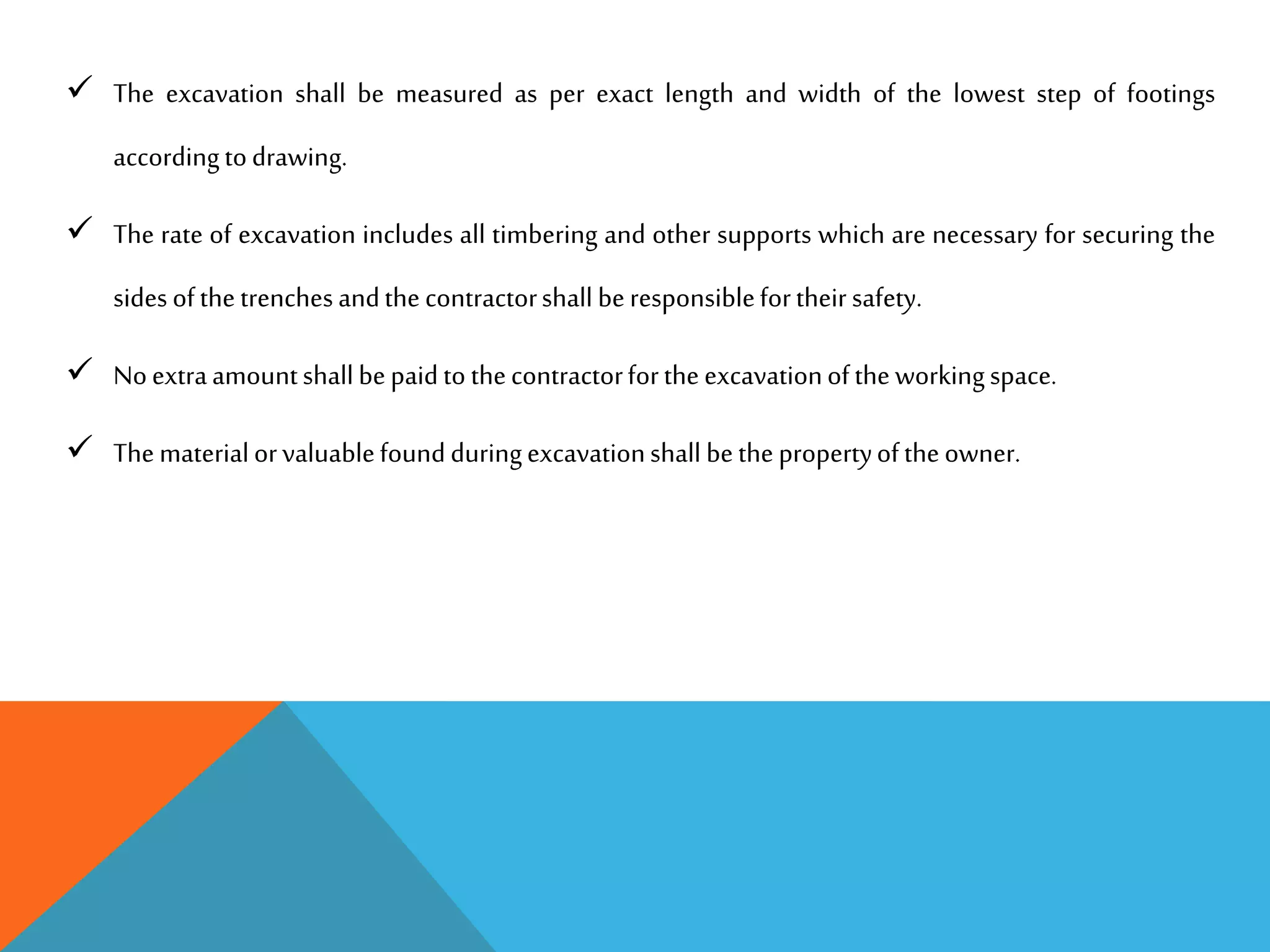

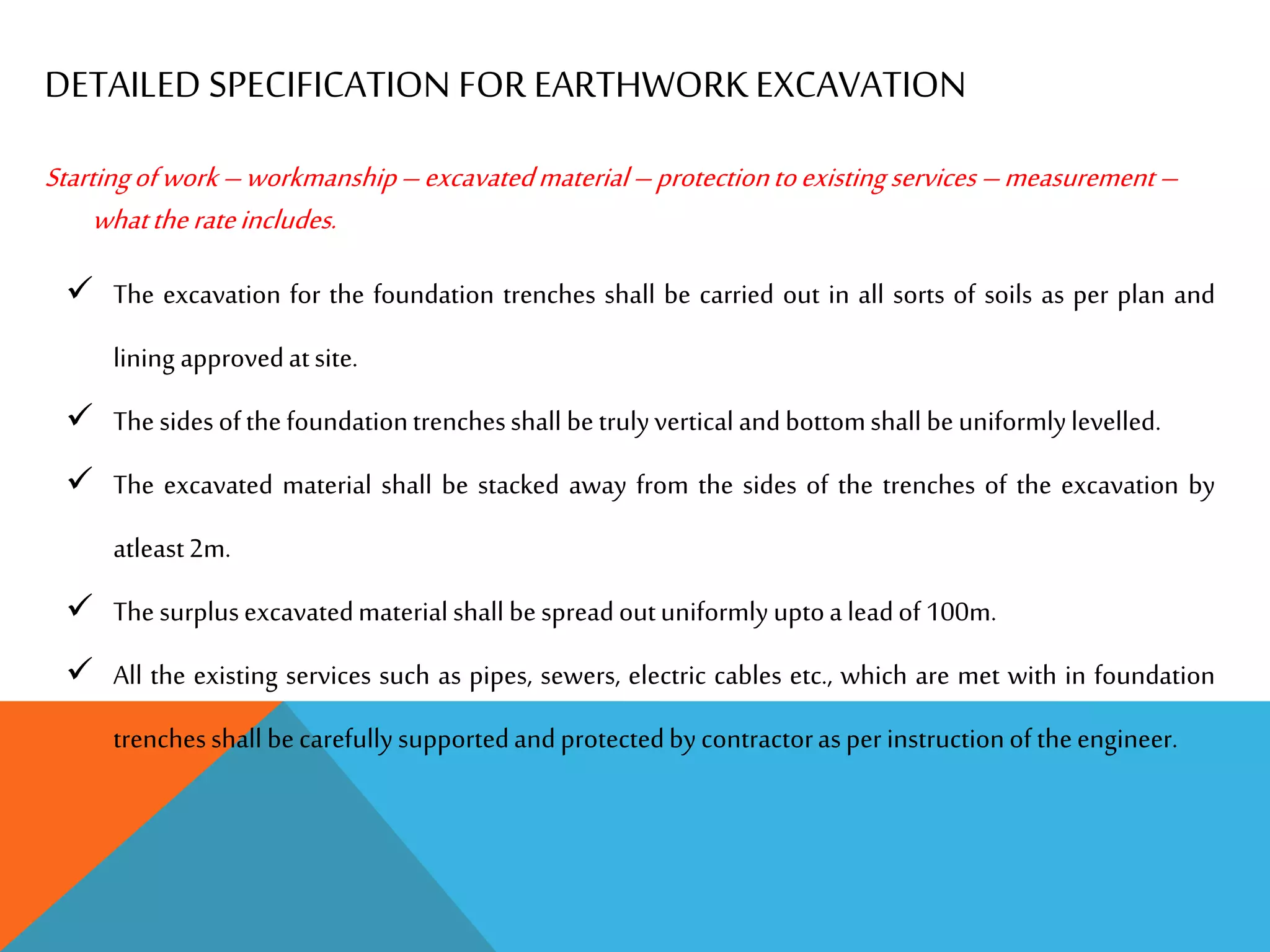

2) Earthwork excavation for foundations, with vertical trenches and protected existing services.

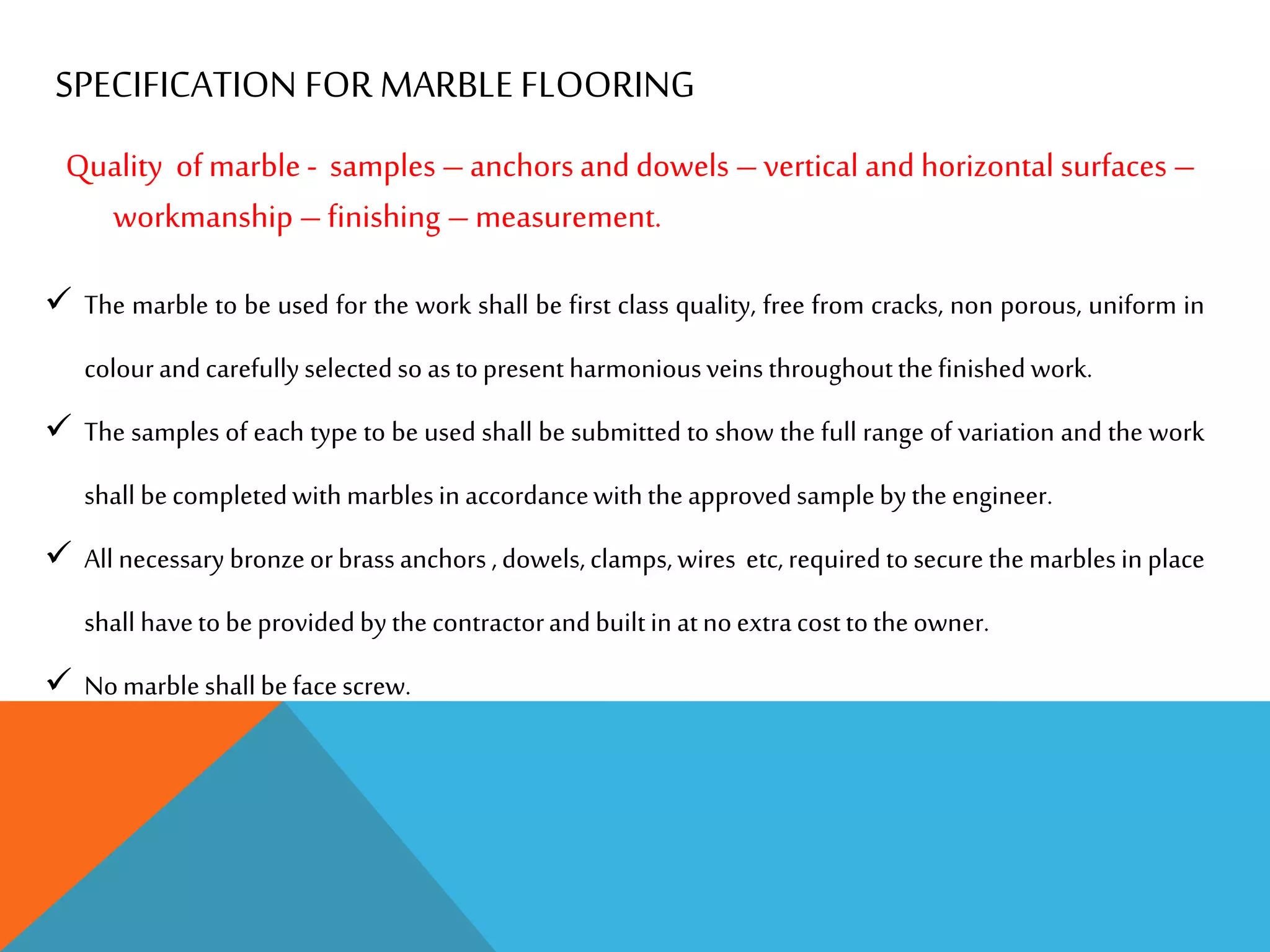

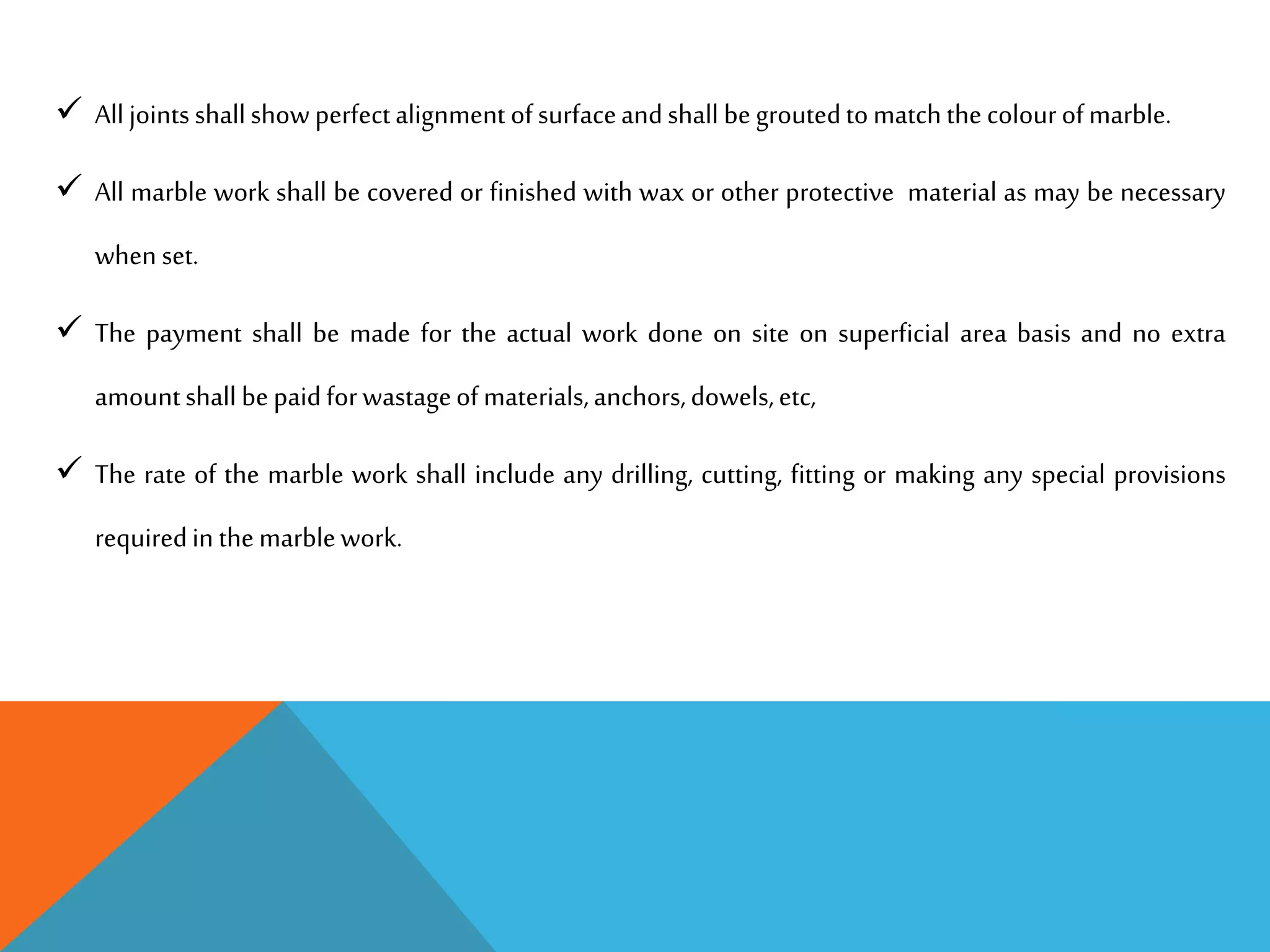

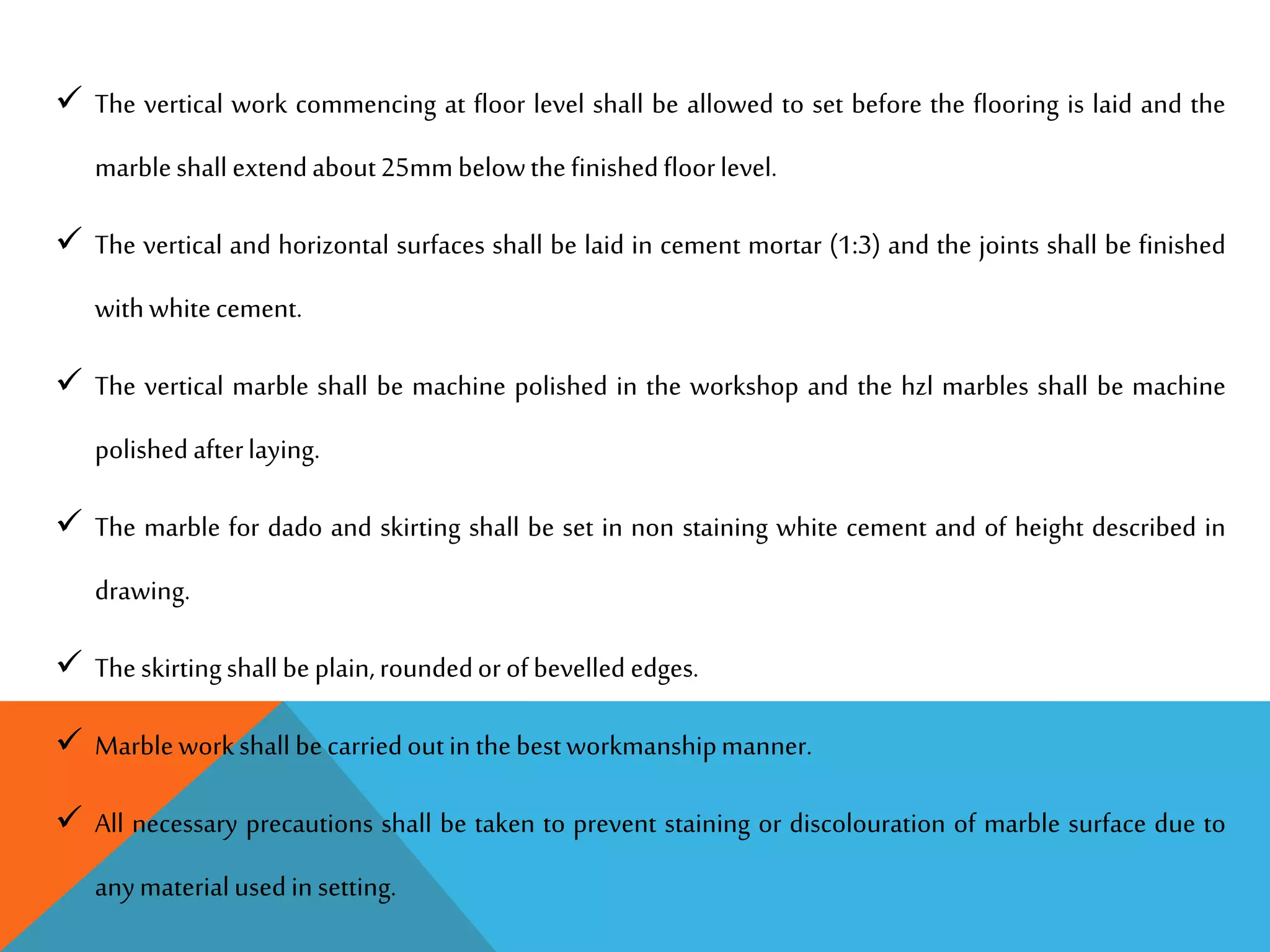

3) Marble flooring using first quality marble set with anchors and polished vertically and horizontally.
