 Objectives of Planning
 Use of Internal Audit
 Factors affecting Planning Process
 Scope of Planning
 Factors affecting scope of Internal Audit.

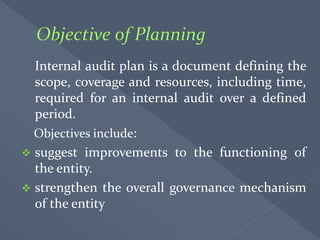

 Planning process
Internal audit plan is a document defining the
scope, coverage and resources, including time,
required for an internal audit over a defined
period.

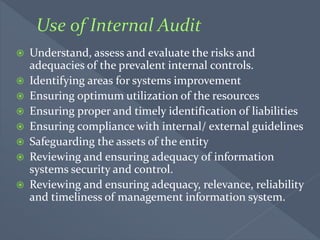

Objectives include:
 suggest improvements to the functioning of
the entity.
 strengthen the overall governance mechanism
of the entity
 Understand, assess and evaluate the risks and
adequacies of the prevalent internal controls.
 Identifying areas for systems improvement
 Ensuring optimum utilization of the resources
 Ensuring proper and timely identification of liabilities
 Ensuring compliance with internal/ external guidelines
 Safeguarding the assets of the entity
 Reviewing and ensuring adequacy of information
systems security and control.
 Reviewing and ensuring adequacy, relevance, reliability
and timeliness of management information system.
 Objectives of the activity and significant risks
associated with the same.
 The risk management and internal control
system instituted in the organization.
 Selection of engagement team.
 Business/Industry developments.
 Changes in the financial reporting framework

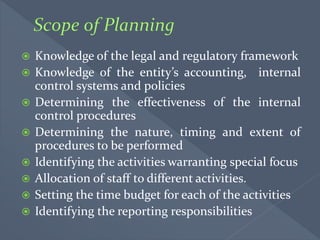

 Knowledge of the legal and regulatory framework
 Knowledge of the entity’s accounting, internal
control systems and policies
 Determining the effectiveness of the internal
control procedures
 Determining the nature, timing and extent of
procedures to be performed
 Identifying the activities warranting special focus
 Allocation of staff to different activities.
 Setting the time budget for each of the activities
 Identifying the reporting responsibilities
 Terms of the engagement
 Nature of accounting system and Accounting policies adopted.
 Nature of information technology system used by the client
 Authorization and delegation of authority in the systems
environment
 The nature of management information system in vogue and
Expected audit coverage
 Materiality thresholds established in respect of various areas of
audit
 Nature and extent of audit evidence to be obtained
 Experience and skills of the staff
 Requirements of the applicable pronouncements of the ICAI.
 Statutory or regulatory framework in which the entity operates
 Obtaining Knowledge of the Business
 Establishing the Audit Universe
 Establishing the Objectives of the Engagement
 Establishing the Scope of the Engagement
 Deciding the Resource Allocation
 Preparation of Audit Programme

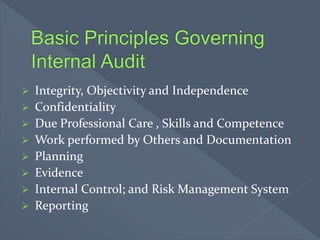

 Integrity, Objectivity and Independence
 Confidentiality
 Due Professional Care , Skills and Competence
 Work performed by Others and Documentation
 Planning
 Evidence
 Internal Control; and Risk Management System
 Reporting
 Straightforward, honest and sincere in his approach
to his professional work
 Maintain an impartial attitude
 Immediately bring any actual or apparent conflict
of interest to the attention of the appropriate level
of management
 Maintain the confidentiality of the information
acquired in the course of his work
Due professional Care to be applied:
 In Deciding the extent of work required to
achieve the objectives of the engagement.
 In assessment of risk management
 Control and governance processes and
 Cost benefit analysis.
 Obtain skills and competence through general
education, technical knowledge through study
and formal courses.

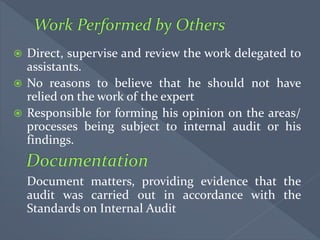

 Direct, supervise and review the work delegated to
assistants.
 No reasons to believe that he should not have
relied on the work of the expert
 Responsible for forming his opinion on the areas/
processes being subject to internal audit or his
findings.
Document matters, providing evidence that the
audit was carried out in accordance with the
Standards on Internal Audit

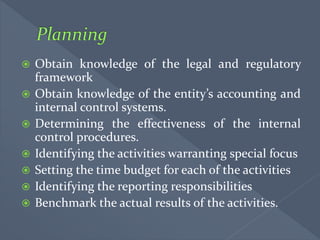

 Obtain knowledge of the legal and regulatory
framework
 Obtain knowledge of the entity’s accounting and
internal control systems.
 Determining the effectiveness of the internal
control procedures.
 Identifying the activities warranting special focus
 Setting the time budget for each of the activities
 Identifying the reporting responsibilities

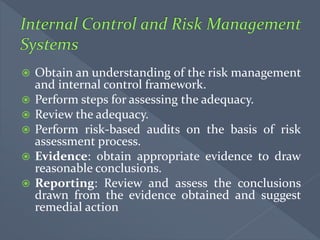

 Benchmark the actual results of the activities.
 Obtain an understanding of the risk management
and internal control framework.
 Perform steps for assessing the adequacy.
 Review the adequacy.
 Perform risk-based audits on the basis of risk
assessment process.
 Evidence: obtain appropriate evidence to draw
reasonable conclusions.
 Reporting: Review and assess the conclusions
drawn from the evidence obtained and suggest
remedial action

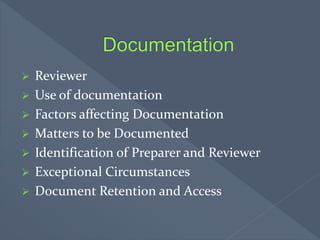

 Reviewer
 Use of documentation
 Factors affecting Documentation
 Matters to be Documented
 Identification of Preparer and Reviewer
 Exceptional Circumstances
 Document Retention and Access

Reviewer means an Individual who has:
 reasonable knowledge and experience of
internal audit processes
 reasonable knowledge of SIAs, other relevant
pronouncements of the Institute.
 reasonable understanding of the business
environment in which the entity operates
 reasonable understanding of internal audit
issues relevant to the entity’s industry
Enables an experienced internal auditor, having no
previous connection with the internal audit to
understand:
 The nature, timing and extent of the audit
procedures performed.
 The results of the audit procedures and the audit
evidence obtained.
 Significant matters arising during the audit and the
conclusions reached thereon.
 Terms and conditions of an internal audit
engagement, scope of work, reporting requirements,
any other special conditions, affecting the internal
audit.
 The nature and extent of the audit procedures to
be performed
 The identified risks of material misstatement
 The extent of judgment required in performing
the work.
 The significance of the audit evidence obtained.
 The nature and extent of exceptions identified.
 The need to document a conclusion or the basis
for a conclusion.
 The audit methodology and tools used.

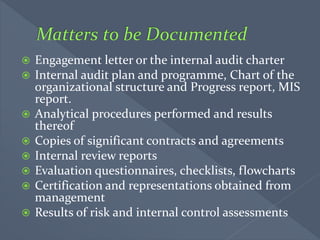

 Engagement letter or the internal audit charter
 Internal audit plan and programme, Chart of the
organizational structure and Progress report, MIS
report.
 Analytical procedures performed and results
thereof
 Copies of significant contracts and agreements
 Internal review reports
 Evaluation questionnaires, checklists, flowcharts
 Certification and representations obtained from
management
 Results of risk and internal control assessments

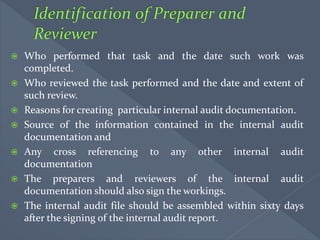

 Who performed that task and the date such work was
completed.
 Who reviewed the task performed and the date and extent of
such review.
 Reasons for creating particular internal audit documentation.
 Source of the information contained in the internal audit
documentation and
 Any cross referencing to any other internal audit
documentation
 The preparers and reviewers of the internal audit
documentation should also sign the workings.
 The internal audit file should be assembled within sixty days
after the signing of the internal audit report.
 The details of circumstances encountered
along with the documentary evidence.
 The new or additional audit procedures
performed, audit evidence obtained, and
conclusions reached and
 When and by whom the resulting changes to
the audit documentation were made, and
reviewed.
 Formulate policies for custody and retention.
 Ownership of audit documents.
 Access to Third party.
 Retention of Documents.
Contents of the SIA
 Introduction
 Basic Elements of Internal Audit Report
 Communication to Management
 Limitation on Scope
 Restriction on Usage and Report Circulation
Otherwise Than to the List of Intended
Recipients

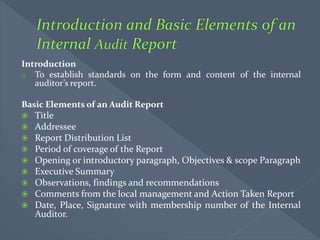

Introduction
o To establish standards on the form and content of the internal
auditor’s report.
Basic Elements of an Audit Report
 Title
 Addressee
 Report Distribution List
 Period of coverage of the Report
 Opening or introductory paragraph, Objectives & scope Paragraph
 Executive Summary
 Observations, findings and recommendations
 Comments from the local management and Action Taken Report
 Date, Place, Signature with membership number of the Internal
Auditor.

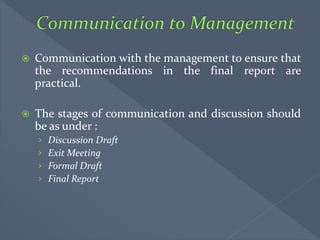

 Communication with the management to ensure that
the recommendations in the final report are
practical.
 The stages of communication and discussion should
be as under :
› Discussion Draft
› Exit Meeting
› Formal Draft
› Final Report

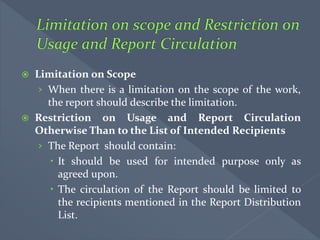

 Limitation on Scope
› When there is a limitation on the scope of the work,
the report should describe the limitation.
 Restriction on Usage and Report Circulation
Otherwise Than to the List of Intended Recipients
› The Report should contain:
 It should be used for intended purpose only as
agreed upon.
 The circulation of the Report should be limited to
the recipients mentioned in the Report Distribution
List.

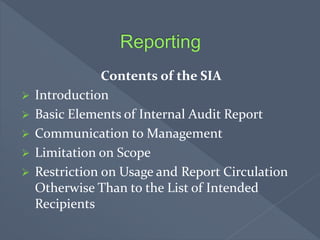

Contents of the SIA
 Introduction
 Definitions
 Use of Sampling in Risk Assessment Procedures and
Tests of Controls
 Design of the Sample
 Sample Size
 Statistical and Non-Statistical Approaches
 Selection of the Sample
 Evaluation of Sample Results
 Documentation
 Introduction
To establish standards on the design and selection of an audit sample and
provide guidance on the use of audit sampling.
 The SIA defines the following
› Audit Sampling
› Error
› Population
› Sampling Risk
› Sampling Unit
› Statistical Sampling
› Tolerable Error
 Use of sampling in Risk Assessment and tests of control
 To obtain an understanding of the entity, business and its environment, and
its internal control.
 Sampling of tests of controls is appropriate when application of the control
leaves audit evidence of performance
 Risk can be reduced by increasing sample size for both tests of controls and
tests of details.

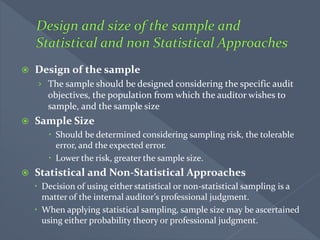

 Design of the sample
› The sample should be designed considering the specific audit
objectives, the population from which the auditor wishes to
sample, and the sample size
 Sample Size
 Should be determined considering sampling risk, the tolerable
error, and the expected error.
 Lower the risk, greater the sample size.
 Statistical and Non-Statistical Approaches
 Decision of using either statistical or non-statistical sampling is a
matter of the internal auditor’s professional judgment.
 When applying statistical sampling, sample size may be ascertained
using either probability theory or professional judgment.

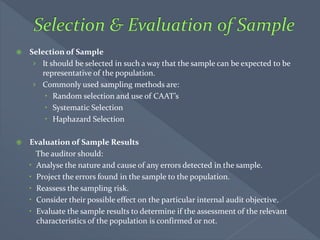

 Selection of Sample
› It should be selected in such a way that the sample can be expected to be
representative of the population.
› Commonly used sampling methods are:
 Random selection and use of CAAT’s
 Systematic Selection
 Haphazard Selection
 Evaluation of Sample Results
The auditor should:
 Analyse the nature and cause of any errors detected in the sample.
 Project the errors found in the sample to the population.
 Reassess the sampling risk.
 Consider their possible effect on the particular internal audit objective.
 Evaluate the sample results to determine if the assessment of the relevant
characteristics of the population is confirmed or not.
 The documentation includes:
› Relationship between the design of the sample and specific
audit objectives.
› Assessment of the expected rate of error in the population to
be tested.
› Assessment of the sampling risk and the tolerable error
› Assessment of the nature and cause of errors.
› Rationale for using a particular sampling technique and
results thereof.
› Analysis of the nature an cause of any errors detected in the
sample.
› Projection of the errors found in the sample to the
population
› Reassessment of sampling risk, where appropriate
› Effect of the sample results on the internal audit’s objective.
Contents of the SIA
 Introduction.
 Nature and Purpose.
 Analytical Procedures as Risk Assessment
Procedures and in Planning the Internal Audit.
 Analytical Procedures as Substantive Procedures.
 Analytical Procedures in the Overall Review at
the End of the Internal Audit.
 Extent of Reliance on Analytical Procedures
 Investigating Unusual Items or Trends.
Introduction
 To apply analytical procedures as the risk assessment procedures at the
planning and overall review stages of the internal audit.
 Nature and Purpose
 Analytical procedures include the consideration of comparisons of the entity's
financial and non-financial information.
 In determining the extent to which the analytical procedures should be used,
the following factors have to be considered
› Significance of the area being examined.
› Adequacy of the system of internal control.
› Availability and reliability of financial and non-financial information.
› Precision with which the results of analytical procedures can be predicted.
› Availability and comparability of information regarding the industry in
which the organization operates.
› Extent to which other auditing procedures provide support for audit
results.
 Analytical Procedures as Risk Assessment Procedures and
in Planning the Internal Audit.
› To obtain an understanding of the business, the entity and
its environment and in identifying areas of potential risk.
› Planning the internal audit for use both financial and non-
financial information
 Analytical Procedures as Substantive Procedures
› To reduce detection risk relating to specific financial
statement assertions and assertions relating to process.
› Inquire with the management as to the availability and
reliability of information needed to apply analytical
procedures.
Analytical procedure should be applied at or near the end
of the internal audit when forming an overall conclusion.
 Extent of Reliance on Analytical Procedures is based on the
following factors
› Materiality of the items involved.
› Internal audit procedures directed toward the same internal audit
objectives.
› Accuracy with which the expected results of analytical procedures can
be predicted.
› Assessments of inherent and control risks.
 Investigating Unusual Items or Trends
 When analytical procedures identify significant fluctuations or
 When relationships that are inconsistent with other relevant
information or
 Data that deviate from predicted amounts.
The internal auditor should investigate and obtain adequate explanations
and appropriate corroborative evidence.
 Introduction
 Scope and Objective
 In House Internal Audit
 Quality Review
 Independent management function.
 Continuous and critical appraisal of the entity
 Suggest improvements and strengthen the
overall governance mechanism of the entity.
 Provides assurance that there is transparency
in reporting, as a part of good governance.
Scope:
 Applicable whenever an internal audit is
carried.
 Whether by internal audit department or
external firm of Professional accountants.
Objective:
 To Establish standards and provide guidance
 To Ensure Compliance with professional
standards, regulatory and legal requirements.
 To Improve functionalities of the
organization, Transparency in reporting and
good governance.
 Leadership responsibilities for quality in
internal audit
 Ethical requirements
 Acceptance and continuance of client
relationship and specific engagement
 Human resources
 Engagement performance
 Monitoring
 Internal Quality Reviews
 Internal Quality Reviewer
 Communicating the results of Internal
Quality Reviews
 External Quality Reviews
 External Quality Reviewer
 Communicating the results of External
Quality Reviews
 Introduction
 Elements of Terms of Engagement
 Withdrawal from Engagement
 Agree on the terms of the engagement before
commencement of Audit.
 The agreed terms would need to be recorded
in an engagement letter.
 The responsibility of the internal auditor to
prepare the engagement letter.
 To be signed both by the internal auditors as
well as the auditee.
 Approval by Board of Directors/ Audit
Committee.
 Periodic review and modification of Terms of
Engagement.
 Scope
 Responsibility
 Authority
 Confidentiality
 Limitations
 Reporting
 Compensation
 Compliance with Standards
 If unable to agree to any change in the terms
or is not permitted to continue as per the
original terms, then auditor should withdraw
from the engagement.
 Consider whether there is an obligation,
contractual or otherwise, to report the
withdrawal to other parties.
 Introduction
 Matters to be communicated.
 Communication Process
 Documentation
 Provides a framework for matters to be
communicated with the management.
Internal auditor should consider the
following:
 Communicate clearly the responsibilities,
scope and timing of Audit.
 Obtain relevant Information
 Provide timely observations
 Promote effective two way communication.
1. Planned scope and Timing of Internal Audit
2. Significant findings from the Internal Audit
Stages of Communication:
a) Discussion Draft
b) Exit Meeting
c) Formal Draft
d) Final Report
 Establishing the communication Process
 Forms of Communication
 Timing of Communication
 Adequacy of the Communication Process
 In case of Oral communication the internal
auditor shall document, when and to whom
they were communicated.
 In case of Written communication the auditor
shall retain a copy of the communication as
part of the internal audit documentation.
 Introduction and Objective
 Audit Evidence
 Categories of Documentary Evidence
 Modes of obtaining Audit Evidence
 Scope and coverage are much broader than
Statutory Audit.
 Covers comments on internal control systems,
risk management, propriety aspect of
transactions.
 This Standard deals with the qualitative and
quantitative aspects of evidence in internal
audit.
 Internal audit evidence is persuasive rather
than conclusive in nature
 The internal auditor may obtain evidence on a
selective basis by way of judgmental or
statistical sampling procedures
The internal auditor’s judgement is usually
influenced by:
› The materiality of the item.
› The type of information available.
› Degree of risk of misstatement.
 Documentary evidence originating from and
held by third parties.
 Documentary evidence originating from third
parties and held by the entity.
 Documentary evidence originating from the
entity and held by third parties and
 Documentary evidence originating from and
held by entity.
 Inspection
 Observation
 Inquiry and confirmation
 Computation
 Analytical review
 Introduction
 Objectives of Internal Control System
 Elements of Internal Control System
 Responsibilities of Internal Auditor
 Fraud is defined as an intentional act by one
or more individuals among management,
those charged with governance, or third
parties, involving the use of deception to
obtain unjust or illegal advantage.
 The primary responsibility for prevention and
detection of frauds rests with management
and those charged with governance
Internal control refers to the process designed,
implemented and maintained by the management
of the entity to ensure accomplishment of its
following objectives:
 Reliability of financial reporting.
 Efficiency and effectiveness in operations.
 Compliance with applicable laws and regulations.
 Safeguarding of assets.
 The control environment.
 Entity’s risk assessment process.
 Information system and communication.
 Control activities.
 Monitoring of controls.
 Control Environment
 Risk Assessment
 Information system and communication
 Control Activities
 Monitoring
 Communication of Fraud
 Documentation
 Introduction
 Factors reflected in the Control Environment
 Inherent Limitations of Internal Controls
 Role of Internal Auditor
 Areas to be Reviewed by Internal Auditor.
 Areas of Evaluation
 Controls present in a System Driven Environment
 Tests of Control
 Communication of Internal Control Weakness
 Disclosure
 Establish Standards and provide guidance on
procedures to be followed by Internal Auditor
 Communication of weakness in Internal
control.
 Internal control system consists of
interrelated components such as Risk
assessment, Control (or Operating)
environment, Monitoring, etc.
Factors reflected in the control Environment:
 Entity organization Structure
 Functioning of BOD/ Governing Body.
 Management's philosophy and operating style
 Management's control system.
 Integrity and ethical values
 Commitment to competence
 Human resource policies and practices
 Cost benefit Analysis
 Potentiality for Human Error
 Circumvention of Internal controls by
parties within/ outside the entity.
 Misuse of Power
 Manipulations by Management.
 Evaluation of the efficiency and effectiveness
of controls
 Recommending new controls where needed –
or discontinuing unnecessary controls
 Using control frameworks
 Developing control self-assessment
 Mission, vision, ethical and organizational value-system of
the entity
 Personnel allocation, appraisal system, and development
policies
 Accounting and financial reporting policies and compliance
with applicable legal and regulatory standards
 Objective of measurement and key performance indicators
 Documentation standards
 Risk management structure
 Operational framework
 Processes and procedures followed
 Degree of management supervision
 Information systems, communication channels
 Business Continuity and Disaster Recovery Procedures
 Verify mission statement and written goals
and objectives.
 Assessing risks at the entity level.
 Assessing risks at the activity (or process)
level.
 Prepare Business Control Worksheet.
 Ensure all risks to the entity are identified.
 Ascertain those risks for which no controls
exist or existing controls are inadequate.
Determine whether the entity uses:
 Encryption tools, protocols to protect
confidential or sensitive information.
 Back-up and restore features to reduce the risk
of permanent loss of data.
 Virus protection software and
 Passwords that restrict user access to
networks, data and applications.
Performed to obtain effectiveness of the:
 Design of the internal control systems.
 Operation of the internal controls throughout
the period.
 Cost Benefit analysis.
 Includes Inspection of Documents,
Inquiries and Observation, Re-performance ,
Reconciliations and Testing of Internal
Controls.
In case of continuing internal control
weaknesses, consider whether:
 Management has increased supervision and
monitoring;
 Additional or compensating controls have
been instituted; and/or
 Management accepts the risk inherent with
the control weakness.
 The internal auditor in his report to the
management, should provide:
 A description of the significant deficiency or
material weakness in internal control.
 His opinion on the possible effect of such
weakness on the entity’s control environment.
 Introduction
 Process of ERM and Internal Audit
 Scope
 Maturity of ERM structure
 Disclosure
ERM enables management:
 To effectively deal with risk
 Associated uncertainty and enhancing the
capacity to build value to the entity
Types of Risks:
 Strategic
 Operational
 Financial and
 Knowledge
 Enterprise Risk Management is a structured,
consistent and continuous process of
measuring or assessing risk and developing
strategies to manage risk within the risk
appetite.
 Process consists of Risk identification,
prioritization and reporting, Risk mitigation,
Risk monitoring and assurance.
 Risk maturity level
 Compliance with the risk management policy
In case of the risks covered by the internal
audit plan:
 Assess the efficiency and effectiveness of the
risk response.
 Assess whether the score of the residual risk is
within the risk appetite
 Protects the enterprise against surprises
 Stabilizes overall performance with less
volatile earnings
 Operates within established risk appetite
 Protects ability of the enterprise to attend to
its core business and
 Creates a system to proactively manage risks.
 Assurance rating (segregated into High,
Medium or Low) as a result of the review
 Tests conducted
 Samples covered and
 Observations and recommendations.
 Matters to Consider
 Planning
 Nature of Risks
 Reliability of ICS
 Review of IT Environment
 The extent to which the IT environment is
used
 The flow of authorised, correct and
complete data to the processing centre.
 •The processing, analysis and reporting
tasks undertaken in the installation and
 •The impact of computer-based accounting
system on the audit trail.
 Information Technology Infrastructure
 Significance and complexity of
computerised processing
 Determination of the organisational
structure.
 Determination of the availability of data
 Lack of transaction trails
 Uniform processing of transactions
 Lack of segregation of functions
 Potential for errors and irregularities
 Initiation or execution of transactions
 Dependence of other controls over computer
processing
 Potential for increased management supervision
 Potential for the use of CAAT.
 Authorised, correct and complete data is
made available for processing.
 Timely detection and correction of errors
 Interruption in the working of the IT
environment .
 Accuracy and completeness of output.
 Adequate data security
 Unauthorised amendments to the programs
 Safe custody of source code of application
software and data files.
 System Audit reports
 Reports of system breaches
 Reports of network failures/ virus attacks
and threats to perimeter security.
 General controls
 Application controls
 Business Continuity Planning, Crisis
Management, Disaster Recovery Procedures.
 Introduction
 Acquiring Knowledge of the Entity
 Source of Information
 Using the Knowledge
 What constitutes the knowledge of an entity’s
business.
 Importance to the various phases of an
internal audit engagement .
 Techniques to be adopted in acquiring such
knowledge.
 Identify appropriate, reliable and useful
information
 Relevant industry, regulatory, and other
external factors.
 Nature of the entity and its Business
operations.
 Investment, Financing activities and Financial
reporting.
 Accounting policies, Business risk,
objectives and strategies of the entity.
 Previous engagement experience
 Business plan/organisational structure and
Internal documentation produced by the
entity.
 Incorporation documents and Visits to the
entity premises.
 Discussion with key management persons,
statutory auditors, Suppliers, customers and
third party agencies.
 Publications related to the industry.
 Assessing risks and identifying key focus
areas.
 Planning and performing the internal audit
effectively and efficiently.
 Evaluating audit evidence.
 Providing better quality of service to the client
 The information obtained should be
adequately documented.
 Introduction
 Need to use work of Expert
 Skills and Competence of Expert
 Evaluating the work of an Expert
 Disclosure
 An expert is a person, firm or other
association of persons possessing special skill,
expertise, knowledge and experience in a
particular field.
 Use expert if internal Audit Team does not
possess the required knowledge.
 If Expert is engaged by the senior
management or those charged with
governance.
Factors to be Considered:
 Materiality of the item being examined.
 Nature and complexity of the transaction.
 Risk of error.
 Extent of Internal audit evidence available.
 The expert’s professional qualifications or
membership in an appropriate professional
body.
 The reputation of the expert in the relevant
discipline.
 The knowledge and specific experience of
the expert in the industry to which the
auditee entity operates.
 The objectives and scope of the work
 Access to records, personnel and physical
properties.
 The ownership and custody of engagement
documentation and working papers.
 Confidentiality of the expert's work
 Expert’s relationship with the auditee
 Confidentiality of the auditee’s information
used by the expert.
 Verify the source data used, assumptions made
and methods used in obtaining the result.
 Normally work of an expert is not required to
be disclosed.
 Disclose the work if it is beneficial to the
reader after obtaining Prior consent of Expert.
 Outline the assumptions, broad
methodology and conclusions of the expert.
 Scope and Objective.
 Responsibility of Management
 Responsibility of Internal Auditor
 Types of Laws and Regulations
 Compliance with Laws and Regulations.
 Audit procedures in case of Non Compliance
identified.
 Reporting of non compliance
 To consider laws and regulations when
performing an internal audit.
 To test and report on compliance with specific
laws or regulations.
 Non compliance- Acts of omission or
commission by the entity, either intentional
or unintentional, which are contrary to the
prevailing laws or regulations.
 Non-compliance does not include personal
misconduct by those charged with
governance, management or employees of the
entity.
 To obtain sufficient appropriate audit
evidence
 To perform specified audit procedures
 To respond appropriately to non-compliance
or suspected non-compliance
 To ensure compliance with the provisions of
laws and regulations
 This can be achieved by assigning appropriate
responsibilities to the following:
 • A compliance committee
 A audit committee.
 Should not assume any accountability for
risk management decisions taken by the
management.
Inherent limitations on the internal auditor’s
ability to detect non-compliance:
 To many laws and regulations
 Non-compliance may involve conduct
designed to conceal it
 Legal determination by a court of law.
Laws and regulations having direct effect on
Financial Statements:
 Obtain sufficient appropriate audit evidence
to ensure compliance.
Laws and regulations having no direct effect on
Financial Statements:
 Undertake specified audit procedures to
identify non-compliance.
 May have a significant impact on the functioning
of the entity.
 Obtaining an Understanding of the Legal and
Regulatory Framework
 Laws and Regulations having Direct Effect on
Financials.
 Procedures to Identify Instances of Non-
Compliance.
 Non-Compliance brought to the Internal Auditor’s
Attention through Other Audit Procedures
 Written Representations
 Internal Audit Procedures When Non-Compliance is
Not Identified or
 Suspected
 Indications of Non-Compliance with Laws and
Regulations
 Matters Relevant to the Internal Auditor’s Evaluation
 Evaluating the Implications of Non-Compliance
 Reporting Non-Compliance to those Charged with
Governance
 Reporting Non-Compliance in the Internal Auditor’s
Report
 If precluded from obtaining sufficient appropriate
audit evidence then Report the same.
 If unable to determine whether non-compliance is
due to limitations imposed by the circumstances /
management then evaluate the observations and
findings in accordance with SIA 4.

Standards of Internal Audit

  • 2.
     Objectives ofPlanning  Use of Internal Audit  Factors affecting Planning Process  Scope of Planning  Factors affecting scope of Internal Audit.  Planning process
  • 3.
    Internal audit planis a document defining the scope, coverage and resources, including time, required for an internal audit over a defined period. Objectives include:  suggest improvements to the functioning of the entity.  strengthen the overall governance mechanism of the entity
  • 4.
     Understand, assessand evaluate the risks and adequacies of the prevalent internal controls.  Identifying areas for systems improvement  Ensuring optimum utilization of the resources  Ensuring proper and timely identification of liabilities  Ensuring compliance with internal/ external guidelines  Safeguarding the assets of the entity  Reviewing and ensuring adequacy of information systems security and control.  Reviewing and ensuring adequacy, relevance, reliability and timeliness of management information system.
  • 5.
     Objectives ofthe activity and significant risks associated with the same.  The risk management and internal control system instituted in the organization.  Selection of engagement team.  Business/Industry developments.  Changes in the financial reporting framework
  • 6.
     Knowledge ofthe legal and regulatory framework  Knowledge of the entity’s accounting, internal control systems and policies  Determining the effectiveness of the internal control procedures  Determining the nature, timing and extent of procedures to be performed  Identifying the activities warranting special focus  Allocation of staff to different activities.  Setting the time budget for each of the activities  Identifying the reporting responsibilities
  • 7.
     Terms ofthe engagement  Nature of accounting system and Accounting policies adopted.  Nature of information technology system used by the client  Authorization and delegation of authority in the systems environment  The nature of management information system in vogue and Expected audit coverage  Materiality thresholds established in respect of various areas of audit  Nature and extent of audit evidence to be obtained  Experience and skills of the staff  Requirements of the applicable pronouncements of the ICAI.  Statutory or regulatory framework in which the entity operates
  • 8.
     Obtaining Knowledgeof the Business  Establishing the Audit Universe  Establishing the Objectives of the Engagement  Establishing the Scope of the Engagement  Deciding the Resource Allocation  Preparation of Audit Programme
  • 10.
     Integrity, Objectivityand Independence  Confidentiality  Due Professional Care , Skills and Competence  Work performed by Others and Documentation  Planning  Evidence  Internal Control; and Risk Management System  Reporting
  • 11.
     Straightforward, honestand sincere in his approach to his professional work  Maintain an impartial attitude  Immediately bring any actual or apparent conflict of interest to the attention of the appropriate level of management  Maintain the confidentiality of the information acquired in the course of his work
  • 12.
    Due professional Careto be applied:  In Deciding the extent of work required to achieve the objectives of the engagement.  In assessment of risk management  Control and governance processes and  Cost benefit analysis.  Obtain skills and competence through general education, technical knowledge through study and formal courses.
  • 13.
     Direct, superviseand review the work delegated to assistants.  No reasons to believe that he should not have relied on the work of the expert  Responsible for forming his opinion on the areas/ processes being subject to internal audit or his findings. Document matters, providing evidence that the audit was carried out in accordance with the Standards on Internal Audit
  • 14.
     Obtain knowledgeof the legal and regulatory framework  Obtain knowledge of the entity’s accounting and internal control systems.  Determining the effectiveness of the internal control procedures.  Identifying the activities warranting special focus  Setting the time budget for each of the activities  Identifying the reporting responsibilities  Benchmark the actual results of the activities.
  • 15.
     Obtain anunderstanding of the risk management and internal control framework.  Perform steps for assessing the adequacy.  Review the adequacy.  Perform risk-based audits on the basis of risk assessment process.  Evidence: obtain appropriate evidence to draw reasonable conclusions.  Reporting: Review and assess the conclusions drawn from the evidence obtained and suggest remedial action
  • 17.
     Reviewer  Useof documentation  Factors affecting Documentation  Matters to be Documented  Identification of Preparer and Reviewer  Exceptional Circumstances  Document Retention and Access
  • 18.
    Reviewer means anIndividual who has:  reasonable knowledge and experience of internal audit processes  reasonable knowledge of SIAs, other relevant pronouncements of the Institute.  reasonable understanding of the business environment in which the entity operates  reasonable understanding of internal audit issues relevant to the entity’s industry
  • 19.
    Enables an experiencedinternal auditor, having no previous connection with the internal audit to understand:  The nature, timing and extent of the audit procedures performed.  The results of the audit procedures and the audit evidence obtained.  Significant matters arising during the audit and the conclusions reached thereon.  Terms and conditions of an internal audit engagement, scope of work, reporting requirements, any other special conditions, affecting the internal audit.
  • 20.
     The natureand extent of the audit procedures to be performed  The identified risks of material misstatement  The extent of judgment required in performing the work.  The significance of the audit evidence obtained.  The nature and extent of exceptions identified.  The need to document a conclusion or the basis for a conclusion.  The audit methodology and tools used.
  • 21.
     Engagement letteror the internal audit charter  Internal audit plan and programme, Chart of the organizational structure and Progress report, MIS report.  Analytical procedures performed and results thereof  Copies of significant contracts and agreements  Internal review reports  Evaluation questionnaires, checklists, flowcharts  Certification and representations obtained from management  Results of risk and internal control assessments
  • 22.
     Who performedthat task and the date such work was completed.  Who reviewed the task performed and the date and extent of such review.  Reasons for creating particular internal audit documentation.  Source of the information contained in the internal audit documentation and  Any cross referencing to any other internal audit documentation  The preparers and reviewers of the internal audit documentation should also sign the workings.  The internal audit file should be assembled within sixty days after the signing of the internal audit report.
  • 23.
     The detailsof circumstances encountered along with the documentary evidence.  The new or additional audit procedures performed, audit evidence obtained, and conclusions reached and  When and by whom the resulting changes to the audit documentation were made, and reviewed.
  • 24.
     Formulate policiesfor custody and retention.  Ownership of audit documents.  Access to Third party.  Retention of Documents.
  • 26.
    Contents of theSIA  Introduction  Basic Elements of Internal Audit Report  Communication to Management  Limitation on Scope  Restriction on Usage and Report Circulation Otherwise Than to the List of Intended Recipients
  • 27.
    Introduction o To establishstandards on the form and content of the internal auditor’s report. Basic Elements of an Audit Report  Title  Addressee  Report Distribution List  Period of coverage of the Report  Opening or introductory paragraph, Objectives & scope Paragraph  Executive Summary  Observations, findings and recommendations  Comments from the local management and Action Taken Report  Date, Place, Signature with membership number of the Internal Auditor.
  • 28.
     Communication withthe management to ensure that the recommendations in the final report are practical.  The stages of communication and discussion should be as under : › Discussion Draft › Exit Meeting › Formal Draft › Final Report
  • 29.
     Limitation onScope › When there is a limitation on the scope of the work, the report should describe the limitation.  Restriction on Usage and Report Circulation Otherwise Than to the List of Intended Recipients › The Report should contain:  It should be used for intended purpose only as agreed upon.  The circulation of the Report should be limited to the recipients mentioned in the Report Distribution List.
  • 31.
    Contents of theSIA  Introduction  Definitions  Use of Sampling in Risk Assessment Procedures and Tests of Controls  Design of the Sample  Sample Size  Statistical and Non-Statistical Approaches  Selection of the Sample  Evaluation of Sample Results  Documentation
  • 32.
     Introduction To establishstandards on the design and selection of an audit sample and provide guidance on the use of audit sampling.  The SIA defines the following › Audit Sampling › Error › Population › Sampling Risk › Sampling Unit › Statistical Sampling › Tolerable Error  Use of sampling in Risk Assessment and tests of control  To obtain an understanding of the entity, business and its environment, and its internal control.  Sampling of tests of controls is appropriate when application of the control leaves audit evidence of performance  Risk can be reduced by increasing sample size for both tests of controls and tests of details.
  • 33.
     Design ofthe sample › The sample should be designed considering the specific audit objectives, the population from which the auditor wishes to sample, and the sample size  Sample Size  Should be determined considering sampling risk, the tolerable error, and the expected error.  Lower the risk, greater the sample size.  Statistical and Non-Statistical Approaches  Decision of using either statistical or non-statistical sampling is a matter of the internal auditor’s professional judgment.  When applying statistical sampling, sample size may be ascertained using either probability theory or professional judgment.
  • 34.
     Selection ofSample › It should be selected in such a way that the sample can be expected to be representative of the population. › Commonly used sampling methods are:  Random selection and use of CAAT’s  Systematic Selection  Haphazard Selection  Evaluation of Sample Results The auditor should:  Analyse the nature and cause of any errors detected in the sample.  Project the errors found in the sample to the population.  Reassess the sampling risk.  Consider their possible effect on the particular internal audit objective.  Evaluate the sample results to determine if the assessment of the relevant characteristics of the population is confirmed or not.
  • 35.
     The documentationincludes: › Relationship between the design of the sample and specific audit objectives. › Assessment of the expected rate of error in the population to be tested. › Assessment of the sampling risk and the tolerable error › Assessment of the nature and cause of errors. › Rationale for using a particular sampling technique and results thereof. › Analysis of the nature an cause of any errors detected in the sample. › Projection of the errors found in the sample to the population › Reassessment of sampling risk, where appropriate › Effect of the sample results on the internal audit’s objective.
  • 37.
    Contents of theSIA  Introduction.  Nature and Purpose.  Analytical Procedures as Risk Assessment Procedures and in Planning the Internal Audit.  Analytical Procedures as Substantive Procedures.  Analytical Procedures in the Overall Review at the End of the Internal Audit.  Extent of Reliance on Analytical Procedures  Investigating Unusual Items or Trends.
  • 38.
    Introduction  To applyanalytical procedures as the risk assessment procedures at the planning and overall review stages of the internal audit.  Nature and Purpose  Analytical procedures include the consideration of comparisons of the entity's financial and non-financial information.  In determining the extent to which the analytical procedures should be used, the following factors have to be considered › Significance of the area being examined. › Adequacy of the system of internal control. › Availability and reliability of financial and non-financial information. › Precision with which the results of analytical procedures can be predicted. › Availability and comparability of information regarding the industry in which the organization operates. › Extent to which other auditing procedures provide support for audit results.
  • 39.
     Analytical Proceduresas Risk Assessment Procedures and in Planning the Internal Audit. › To obtain an understanding of the business, the entity and its environment and in identifying areas of potential risk. › Planning the internal audit for use both financial and non- financial information  Analytical Procedures as Substantive Procedures › To reduce detection risk relating to specific financial statement assertions and assertions relating to process. › Inquire with the management as to the availability and reliability of information needed to apply analytical procedures.
  • 40.
    Analytical procedure shouldbe applied at or near the end of the internal audit when forming an overall conclusion.  Extent of Reliance on Analytical Procedures is based on the following factors › Materiality of the items involved. › Internal audit procedures directed toward the same internal audit objectives. › Accuracy with which the expected results of analytical procedures can be predicted. › Assessments of inherent and control risks.  Investigating Unusual Items or Trends  When analytical procedures identify significant fluctuations or  When relationships that are inconsistent with other relevant information or  Data that deviate from predicted amounts. The internal auditor should investigate and obtain adequate explanations and appropriate corroborative evidence.
  • 42.
     Introduction  Scopeand Objective  In House Internal Audit  Quality Review
  • 43.
     Independent managementfunction.  Continuous and critical appraisal of the entity  Suggest improvements and strengthen the overall governance mechanism of the entity.  Provides assurance that there is transparency in reporting, as a part of good governance.
  • 44.
    Scope:  Applicable wheneveran internal audit is carried.  Whether by internal audit department or external firm of Professional accountants. Objective:  To Establish standards and provide guidance  To Ensure Compliance with professional standards, regulatory and legal requirements.  To Improve functionalities of the organization, Transparency in reporting and good governance.
  • 45.
     Leadership responsibilitiesfor quality in internal audit  Ethical requirements  Acceptance and continuance of client relationship and specific engagement  Human resources  Engagement performance  Monitoring
  • 46.
     Internal QualityReviews  Internal Quality Reviewer  Communicating the results of Internal Quality Reviews  External Quality Reviews  External Quality Reviewer  Communicating the results of External Quality Reviews
  • 48.
     Introduction  Elementsof Terms of Engagement  Withdrawal from Engagement
  • 49.
     Agree onthe terms of the engagement before commencement of Audit.  The agreed terms would need to be recorded in an engagement letter.  The responsibility of the internal auditor to prepare the engagement letter.  To be signed both by the internal auditors as well as the auditee.  Approval by Board of Directors/ Audit Committee.  Periodic review and modification of Terms of Engagement.
  • 50.
     Scope  Responsibility Authority  Confidentiality  Limitations  Reporting  Compensation  Compliance with Standards
  • 51.
     If unableto agree to any change in the terms or is not permitted to continue as per the original terms, then auditor should withdraw from the engagement.  Consider whether there is an obligation, contractual or otherwise, to report the withdrawal to other parties.
  • 53.
     Introduction  Mattersto be communicated.  Communication Process  Documentation
  • 54.
     Provides aframework for matters to be communicated with the management. Internal auditor should consider the following:  Communicate clearly the responsibilities, scope and timing of Audit.  Obtain relevant Information  Provide timely observations  Promote effective two way communication.
  • 55.
    1. Planned scopeand Timing of Internal Audit 2. Significant findings from the Internal Audit Stages of Communication: a) Discussion Draft b) Exit Meeting c) Formal Draft d) Final Report
  • 56.
     Establishing thecommunication Process  Forms of Communication  Timing of Communication  Adequacy of the Communication Process
  • 57.
     In caseof Oral communication the internal auditor shall document, when and to whom they were communicated.  In case of Written communication the auditor shall retain a copy of the communication as part of the internal audit documentation.
  • 59.
     Introduction andObjective  Audit Evidence  Categories of Documentary Evidence  Modes of obtaining Audit Evidence
  • 60.
     Scope andcoverage are much broader than Statutory Audit.  Covers comments on internal control systems, risk management, propriety aspect of transactions.  This Standard deals with the qualitative and quantitative aspects of evidence in internal audit.
  • 61.
     Internal auditevidence is persuasive rather than conclusive in nature  The internal auditor may obtain evidence on a selective basis by way of judgmental or statistical sampling procedures The internal auditor’s judgement is usually influenced by: › The materiality of the item. › The type of information available. › Degree of risk of misstatement.
  • 62.
     Documentary evidenceoriginating from and held by third parties.  Documentary evidence originating from third parties and held by the entity.  Documentary evidence originating from the entity and held by third parties and  Documentary evidence originating from and held by entity.
  • 63.
     Inspection  Observation Inquiry and confirmation  Computation  Analytical review
  • 65.
     Introduction  Objectivesof Internal Control System  Elements of Internal Control System  Responsibilities of Internal Auditor
  • 66.
     Fraud isdefined as an intentional act by one or more individuals among management, those charged with governance, or third parties, involving the use of deception to obtain unjust or illegal advantage.  The primary responsibility for prevention and detection of frauds rests with management and those charged with governance
  • 67.
    Internal control refersto the process designed, implemented and maintained by the management of the entity to ensure accomplishment of its following objectives:  Reliability of financial reporting.  Efficiency and effectiveness in operations.  Compliance with applicable laws and regulations.  Safeguarding of assets.
  • 68.
     The controlenvironment.  Entity’s risk assessment process.  Information system and communication.  Control activities.  Monitoring of controls.
  • 69.
     Control Environment Risk Assessment  Information system and communication  Control Activities  Monitoring  Communication of Fraud  Documentation
  • 71.
     Introduction  Factorsreflected in the Control Environment  Inherent Limitations of Internal Controls  Role of Internal Auditor  Areas to be Reviewed by Internal Auditor.  Areas of Evaluation  Controls present in a System Driven Environment  Tests of Control  Communication of Internal Control Weakness  Disclosure
  • 72.
     Establish Standardsand provide guidance on procedures to be followed by Internal Auditor  Communication of weakness in Internal control.  Internal control system consists of interrelated components such as Risk assessment, Control (or Operating) environment, Monitoring, etc.
  • 73.
    Factors reflected inthe control Environment:  Entity organization Structure  Functioning of BOD/ Governing Body.  Management's philosophy and operating style  Management's control system.  Integrity and ethical values  Commitment to competence  Human resource policies and practices
  • 74.
     Cost benefitAnalysis  Potentiality for Human Error  Circumvention of Internal controls by parties within/ outside the entity.  Misuse of Power  Manipulations by Management.
  • 75.
     Evaluation ofthe efficiency and effectiveness of controls  Recommending new controls where needed – or discontinuing unnecessary controls  Using control frameworks  Developing control self-assessment
  • 76.
     Mission, vision,ethical and organizational value-system of the entity  Personnel allocation, appraisal system, and development policies  Accounting and financial reporting policies and compliance with applicable legal and regulatory standards  Objective of measurement and key performance indicators  Documentation standards  Risk management structure  Operational framework  Processes and procedures followed  Degree of management supervision  Information systems, communication channels  Business Continuity and Disaster Recovery Procedures
  • 77.
     Verify missionstatement and written goals and objectives.  Assessing risks at the entity level.  Assessing risks at the activity (or process) level.  Prepare Business Control Worksheet.  Ensure all risks to the entity are identified.  Ascertain those risks for which no controls exist or existing controls are inadequate.
  • 78.
    Determine whether theentity uses:  Encryption tools, protocols to protect confidential or sensitive information.  Back-up and restore features to reduce the risk of permanent loss of data.  Virus protection software and  Passwords that restrict user access to networks, data and applications.
  • 79.
    Performed to obtaineffectiveness of the:  Design of the internal control systems.  Operation of the internal controls throughout the period.  Cost Benefit analysis.  Includes Inspection of Documents, Inquiries and Observation, Re-performance , Reconciliations and Testing of Internal Controls.
  • 80.
    In case ofcontinuing internal control weaknesses, consider whether:  Management has increased supervision and monitoring;  Additional or compensating controls have been instituted; and/or  Management accepts the risk inherent with the control weakness.
  • 81.
     The internalauditor in his report to the management, should provide:  A description of the significant deficiency or material weakness in internal control.  His opinion on the possible effect of such weakness on the entity’s control environment.
  • 83.
     Introduction  Processof ERM and Internal Audit  Scope  Maturity of ERM structure  Disclosure
  • 84.
    ERM enables management: To effectively deal with risk  Associated uncertainty and enhancing the capacity to build value to the entity Types of Risks:  Strategic  Operational  Financial and  Knowledge
  • 85.
     Enterprise RiskManagement is a structured, consistent and continuous process of measuring or assessing risk and developing strategies to manage risk within the risk appetite.  Process consists of Risk identification, prioritization and reporting, Risk mitigation, Risk monitoring and assurance.
  • 86.
     Risk maturitylevel  Compliance with the risk management policy In case of the risks covered by the internal audit plan:  Assess the efficiency and effectiveness of the risk response.  Assess whether the score of the residual risk is within the risk appetite
  • 87.
     Protects theenterprise against surprises  Stabilizes overall performance with less volatile earnings  Operates within established risk appetite  Protects ability of the enterprise to attend to its core business and  Creates a system to proactively manage risks.
  • 88.
     Assurance rating(segregated into High, Medium or Low) as a result of the review  Tests conducted  Samples covered and  Observations and recommendations.
  • 90.
     Matters toConsider  Planning  Nature of Risks  Reliability of ICS  Review of IT Environment
  • 91.
     The extentto which the IT environment is used  The flow of authorised, correct and complete data to the processing centre.  •The processing, analysis and reporting tasks undertaken in the installation and  •The impact of computer-based accounting system on the audit trail.
  • 92.
     Information TechnologyInfrastructure  Significance and complexity of computerised processing  Determination of the organisational structure.  Determination of the availability of data
  • 93.
     Lack oftransaction trails  Uniform processing of transactions  Lack of segregation of functions  Potential for errors and irregularities  Initiation or execution of transactions  Dependence of other controls over computer processing  Potential for increased management supervision  Potential for the use of CAAT.
  • 94.
     Authorised, correctand complete data is made available for processing.  Timely detection and correction of errors  Interruption in the working of the IT environment .  Accuracy and completeness of output.  Adequate data security  Unauthorised amendments to the programs  Safe custody of source code of application software and data files.
  • 95.
     System Auditreports  Reports of system breaches  Reports of network failures/ virus attacks and threats to perimeter security.  General controls  Application controls  Business Continuity Planning, Crisis Management, Disaster Recovery Procedures.
  • 97.
     Introduction  AcquiringKnowledge of the Entity  Source of Information  Using the Knowledge
  • 98.
     What constitutesthe knowledge of an entity’s business.  Importance to the various phases of an internal audit engagement .  Techniques to be adopted in acquiring such knowledge.  Identify appropriate, reliable and useful information
  • 99.
     Relevant industry,regulatory, and other external factors.  Nature of the entity and its Business operations.  Investment, Financing activities and Financial reporting.  Accounting policies, Business risk, objectives and strategies of the entity.
  • 100.
     Previous engagementexperience  Business plan/organisational structure and Internal documentation produced by the entity.  Incorporation documents and Visits to the entity premises.  Discussion with key management persons, statutory auditors, Suppliers, customers and third party agencies.  Publications related to the industry.
  • 101.
     Assessing risksand identifying key focus areas.  Planning and performing the internal audit effectively and efficiently.  Evaluating audit evidence.  Providing better quality of service to the client  The information obtained should be adequately documented.
  • 103.
     Introduction  Needto use work of Expert  Skills and Competence of Expert  Evaluating the work of an Expert  Disclosure
  • 104.
     An expertis a person, firm or other association of persons possessing special skill, expertise, knowledge and experience in a particular field.  Use expert if internal Audit Team does not possess the required knowledge.  If Expert is engaged by the senior management or those charged with governance.
  • 105.
    Factors to beConsidered:  Materiality of the item being examined.  Nature and complexity of the transaction.  Risk of error.  Extent of Internal audit evidence available.
  • 106.
     The expert’sprofessional qualifications or membership in an appropriate professional body.  The reputation of the expert in the relevant discipline.  The knowledge and specific experience of the expert in the industry to which the auditee entity operates.
  • 107.
     The objectivesand scope of the work  Access to records, personnel and physical properties.  The ownership and custody of engagement documentation and working papers.  Confidentiality of the expert's work  Expert’s relationship with the auditee  Confidentiality of the auditee’s information used by the expert.  Verify the source data used, assumptions made and methods used in obtaining the result.
  • 108.
     Normally workof an expert is not required to be disclosed.  Disclose the work if it is beneficial to the reader after obtaining Prior consent of Expert.  Outline the assumptions, broad methodology and conclusions of the expert.
  • 110.
     Scope andObjective.  Responsibility of Management  Responsibility of Internal Auditor  Types of Laws and Regulations  Compliance with Laws and Regulations.  Audit procedures in case of Non Compliance identified.  Reporting of non compliance
  • 111.
     To considerlaws and regulations when performing an internal audit.  To test and report on compliance with specific laws or regulations.  Non compliance- Acts of omission or commission by the entity, either intentional or unintentional, which are contrary to the prevailing laws or regulations.  Non-compliance does not include personal misconduct by those charged with governance, management or employees of the entity.
  • 112.
     To obtainsufficient appropriate audit evidence  To perform specified audit procedures  To respond appropriately to non-compliance or suspected non-compliance
  • 113.
     To ensurecompliance with the provisions of laws and regulations  This can be achieved by assigning appropriate responsibilities to the following:  • A compliance committee  A audit committee.
  • 114.
     Should notassume any accountability for risk management decisions taken by the management. Inherent limitations on the internal auditor’s ability to detect non-compliance:  To many laws and regulations  Non-compliance may involve conduct designed to conceal it  Legal determination by a court of law.
  • 115.
    Laws and regulationshaving direct effect on Financial Statements:  Obtain sufficient appropriate audit evidence to ensure compliance. Laws and regulations having no direct effect on Financial Statements:  Undertake specified audit procedures to identify non-compliance.  May have a significant impact on the functioning of the entity.
  • 116.
     Obtaining anUnderstanding of the Legal and Regulatory Framework  Laws and Regulations having Direct Effect on Financials.  Procedures to Identify Instances of Non- Compliance.  Non-Compliance brought to the Internal Auditor’s Attention through Other Audit Procedures  Written Representations  Internal Audit Procedures When Non-Compliance is Not Identified or  Suspected
  • 117.
     Indications ofNon-Compliance with Laws and Regulations  Matters Relevant to the Internal Auditor’s Evaluation  Evaluating the Implications of Non-Compliance
  • 118.
     Reporting Non-Complianceto those Charged with Governance  Reporting Non-Compliance in the Internal Auditor’s Report  If precluded from obtaining sufficient appropriate audit evidence then Report the same.  If unable to determine whether non-compliance is due to limitations imposed by the circumstances / management then evaluate the observations and findings in accordance with SIA 4.
