SOFTWARE CONFIGURATION
           MANAGEMENT
What is configuration
management?
• “SCM is the control of the evolution of complex
  systems,…, for the purpose to contribute to
  satisfying quality and delay constraints.”
                            – Jacky Estublier

• “SCM provides the capabilities of
  identification, control, status accounting, audit and
  review, manufacture, process management, and
  teamwork.”
                                   – Susan Dart

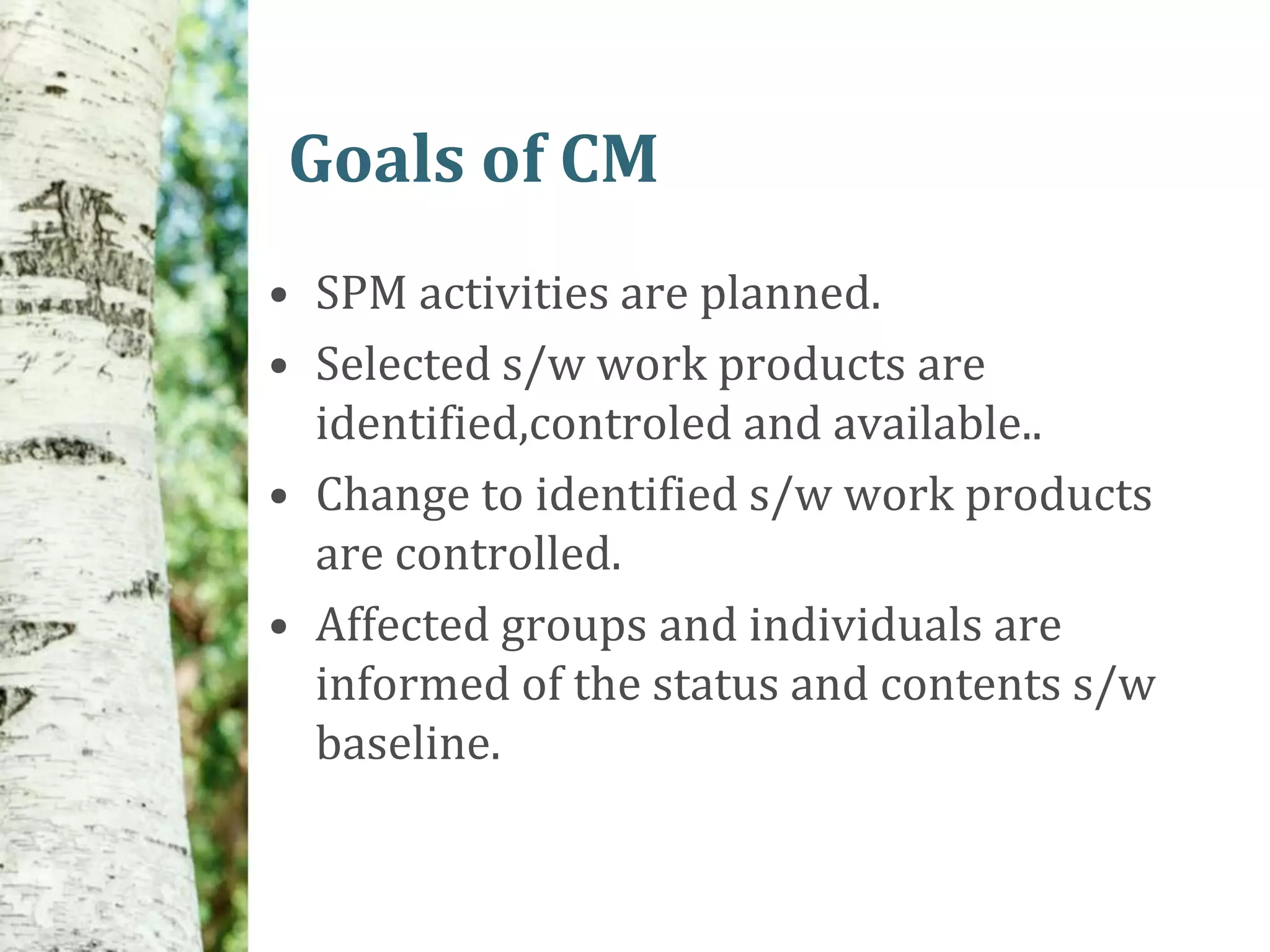

Goals of CM
• SPM activities are planned.
• Selected s/w work products are
  identified,controled and available..
• Change to identified s/w work products
  are controlled.
• Affected groups and individuals are
  informed of the status and contents s/w
  baseline.
Objectives of CM
•   Remote system administration.
•   Reduced user down-time.
•   Reliable data backup.
•   Easy worstation set up.
•   Multi user support.
•   Remote s/w installation.
Configuration Management

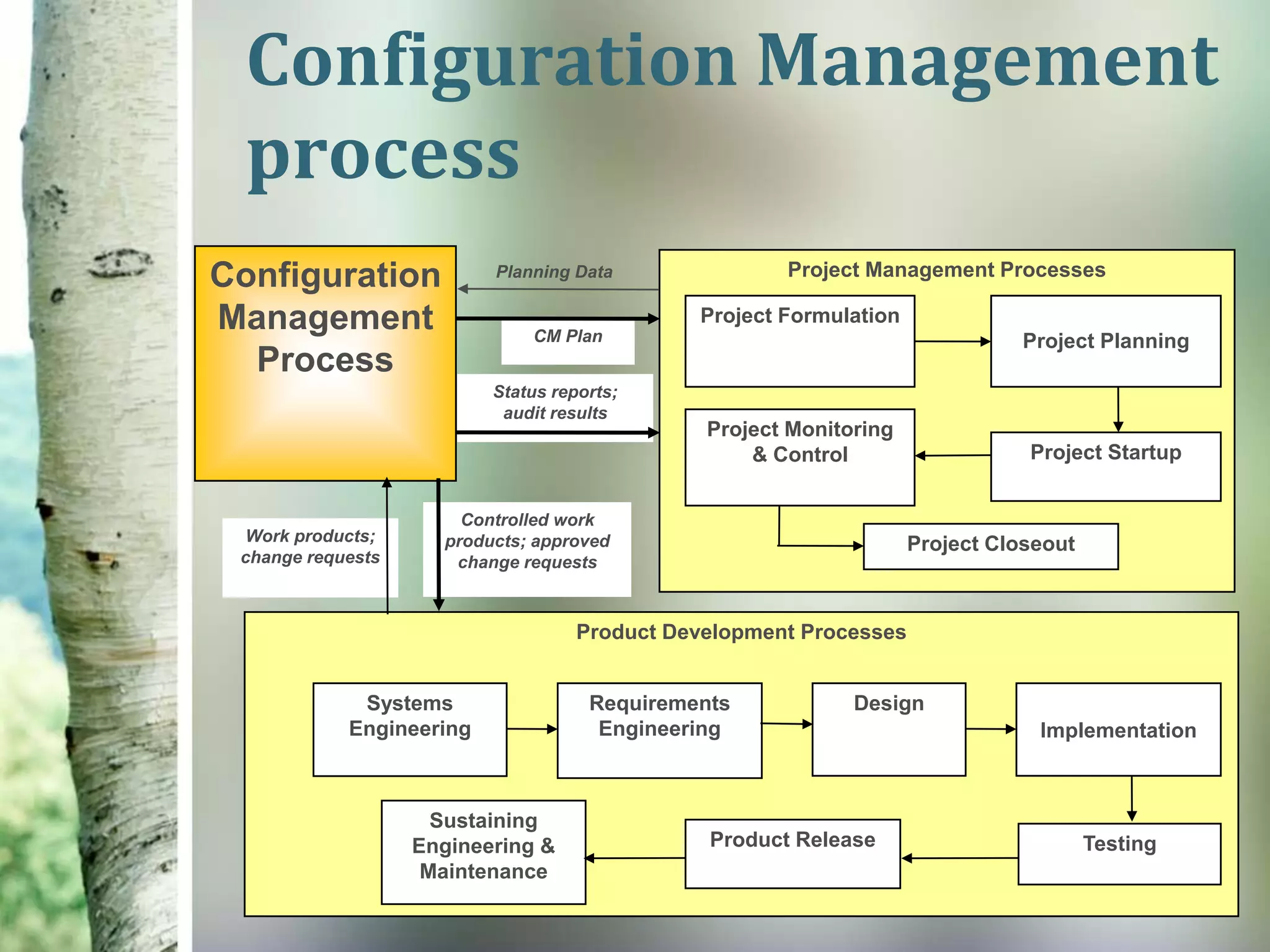

  process
Configuration             Planning Data               Project Management Processes

Management                    CM Plan
                                              Project Formulation
                                                                               Project Planning
  Process
                          Status reports;
                           audit results
                                               Project Monitoring
                                                   & Control                   Project Startup

                       Controlled work
 Work products;      products; approved                             Project Closeout
 change requests      change requests

                                    Product Development Processes

             Systems                 Requirements            Design
            Engineering               Engineering                               Implementation

                     Sustaining
                   Engineering &               Product Release                         Testing
                    Maintenance

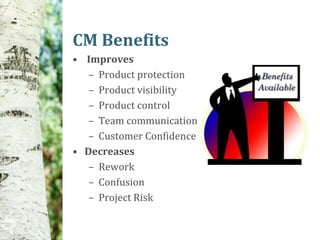

CM Benefits
• Improves
   – Product protection
   – Product visibility
   – Product control
   – Team communication
   – Customer Confidence
• Decreases
   – Rework
   – Confusion
   – Project Risk
BASELINE
•    “A specification or product that has been formally
    reviewed and agreed to by responsible
    management, that thereafter serves as the basis
    for further development, and can be changed only
    through formal change control procedures.”

Examples:
    Baseline A: The API of a program is completely defined;
      the bodies of the methods are empty.
    Baseline B: All data access methods are implemented and
      tested; programming of the GUI can start.
    Baseline C: GUI is implemented, test-phase can start.

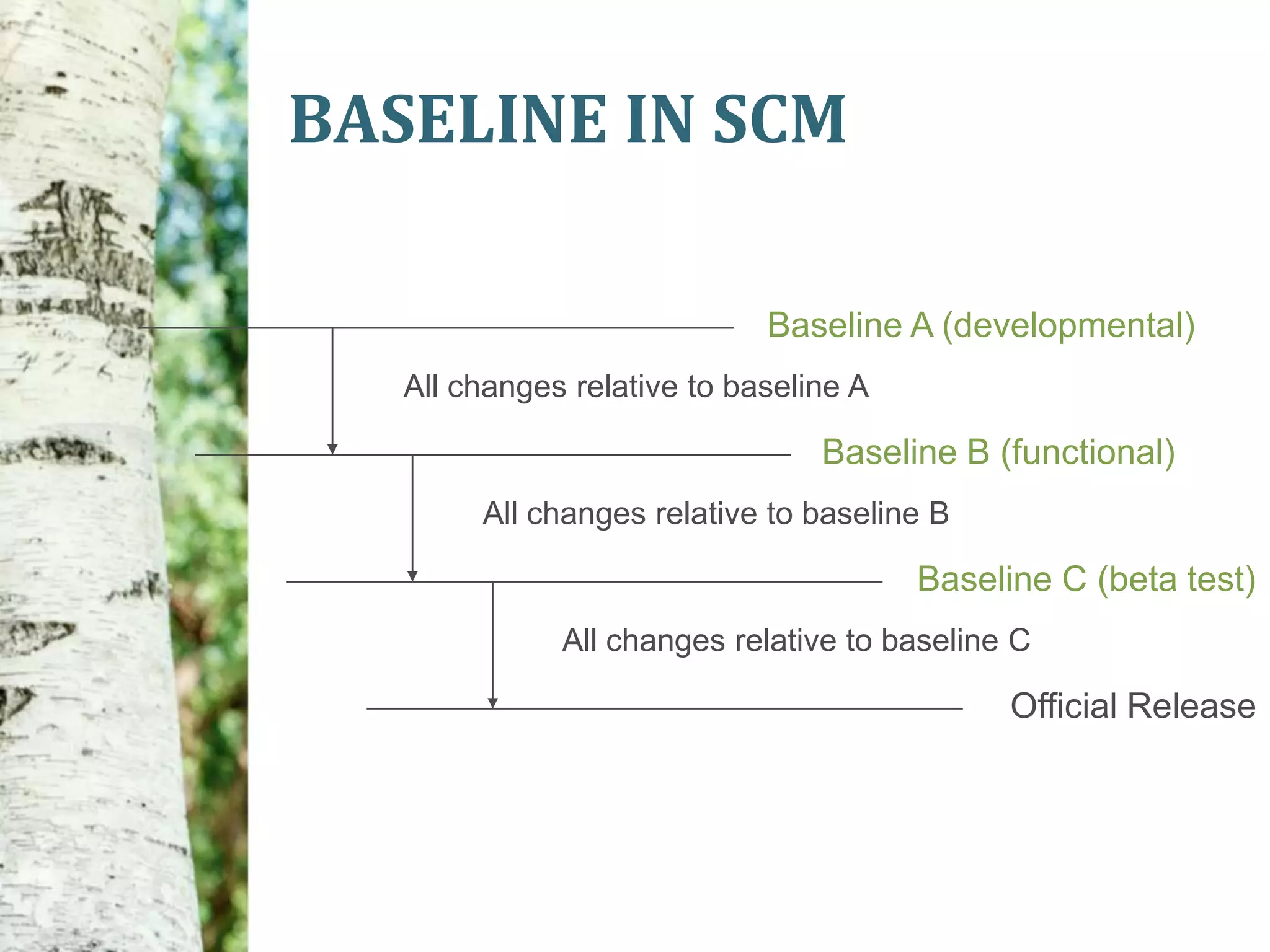

BASELINE IN SCM

                             Baseline A (developmental)
   All changes relative to baseline A

                                 Baseline B (functional)
        All changes relative to baseline B

                                        Baseline C (beta test)
              All changes relative to baseline C

                                              Official Release
What is Change ?
• Change is defined as anything
  hardware, software, system
  components, services, documents, or
  processes that is deliberately introduced
  into the production environment and which
  may affect a Service Level
  Management(SLA) or otherwise affect the
  functioning of the environment or one of its
  components.

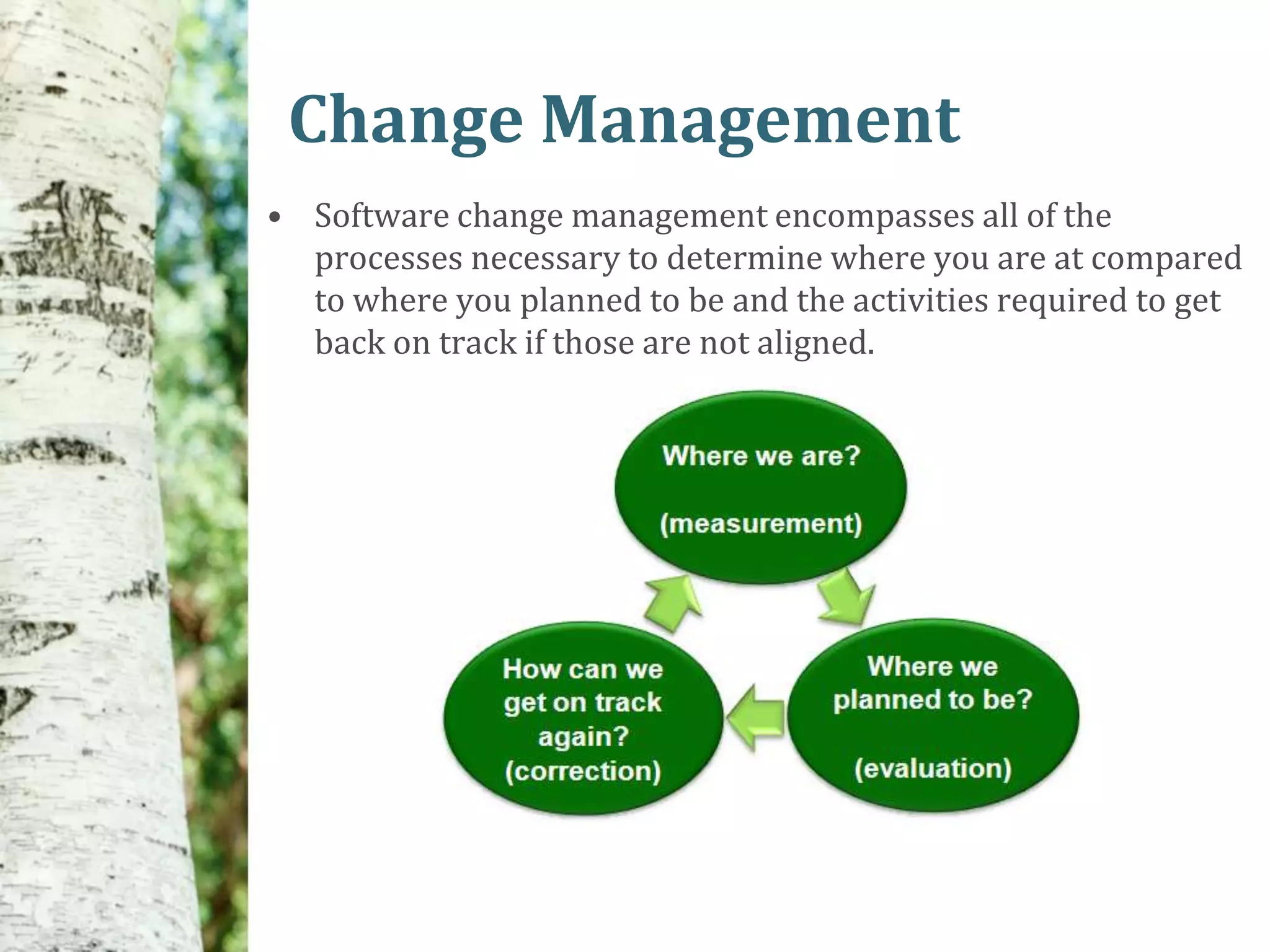

Change Management
• Software change management encompasses all of the
  processes necessary to determine where you are at compared
  to where you planned to be and the activities required to get
  back on track if those are not aligned.

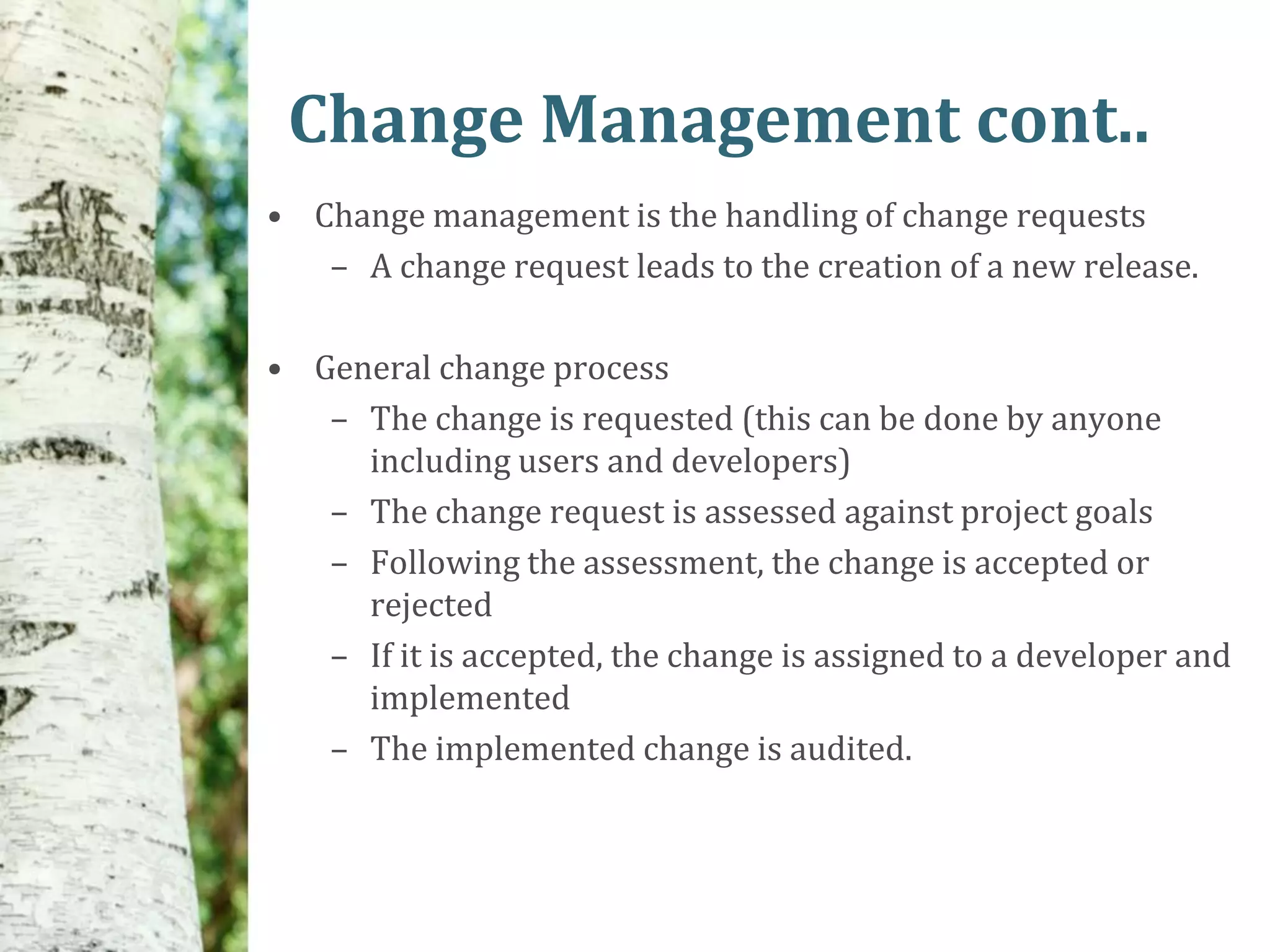

Change Management cont..
• Change management is the handling of change requests
   – A change request leads to the creation of a new release.

• General change process
   – The change is requested (this can be done by anyone
     including users and developers)
   – The change request is assessed against project goals
   – Following the assessment, the change is accepted or
     rejected
   – If it is accepted, the change is assigned to a developer and
     implemented
   – The implemented change is audited.

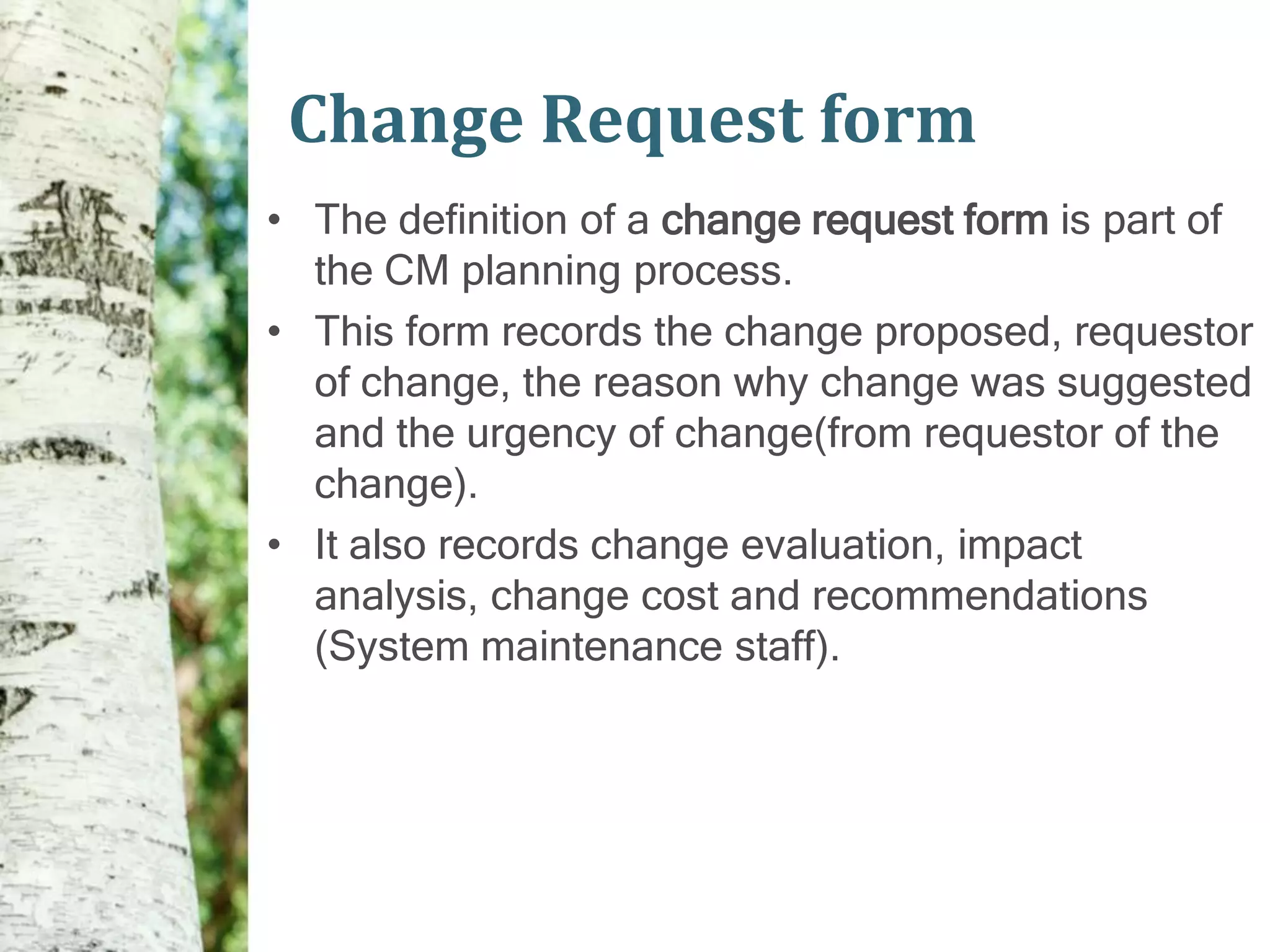

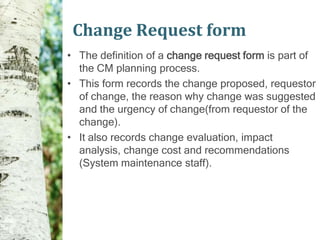

Change Request form
• The definition of a change request form is part of
  the CM planning process.
• This form records the change proposed, requestor
  of change, the reason why change was suggested
  and the urgency of change(from requestor of the
  change).
• It also records change evaluation, impact
  analysis, change cost and recommendations
  (System maintenance staff).

Change Request form

Chan ge Reques t Form

Project: Prot eus/PCL-T lsoo                          Numbe r: 23 /0 2
Chan ge r ques ter:I. So mmerv ille
         e                                            Date: 1/12 /0 2
Requested change: Whena component isselectedfrom thestructu display
                                                           re,
t he name of t he file wh ere it is sto red.

Chan ge ana ly ser: Dean
                  G.                         Ana lys is date: /1 2/02
                                                             10
Compo nents affe cted:
                     Disp lay-Ico n.Select , Disp lay-Ico n.Display

As socia ted compo nents:
                        FileTable
Chan ge as ses smen t: Relatively simp le t o implemen t as a file name t able is
availab Requ the desig and implementation of a display field No chan
       le.  ires     n                                      .       ges
t o associated co mpon ent s are required.

Chan ge prio ri ty: w
                  Lo

Chan ge imple me nta ti on:
Es ti mated effo rt:0.5 days
Date to CCB:15 /1 2/02                              CCB decis io n date:     1/2/03
CCB decis io n:
              Accep t ch ange. Chan ge t o be implement ed in Release 2 .1 .
Chan ge imple me nto r:                             Date of chan ge:
Date su bmitte d to Q A:                            Q A decis io n:
Date su bmitte d to CM:
Comments

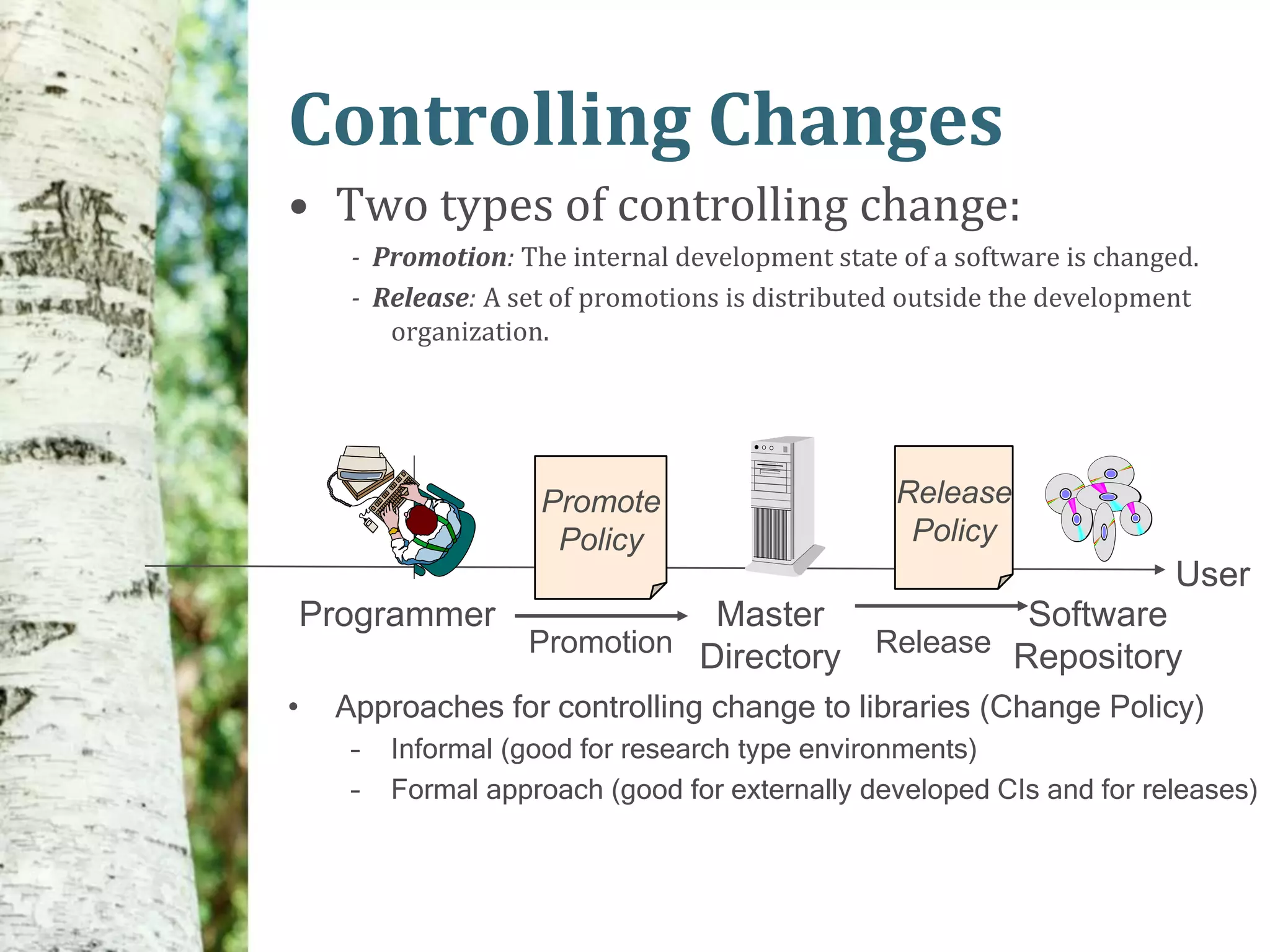

Controlling Changes
• Two types of controlling change:
      - Promotion: The internal development state of a software is changed.
      - Release: A set of promotions is distributed outside the development
         organization.

                     Promote                      Release
                      Policy                       Policy
                                                                         User
    Programmer                 Master            Software
                    Promotion Directory Release Repository

•    Approaches for controlling change to libraries (Change Policy)
      –   Informal (good for research type environments)
      –   Formal approach (good for externally developed CIs and for releases)
Change Tracking Tools
• A major problem in change management is tracking
  change status.
• Change tracking tools keep track the status of each
  change request and automatically ensure that
  change requests are sent to the right people at the
  right time.
• Integrated with E-mail systems allowing
  electronic change request distribution.

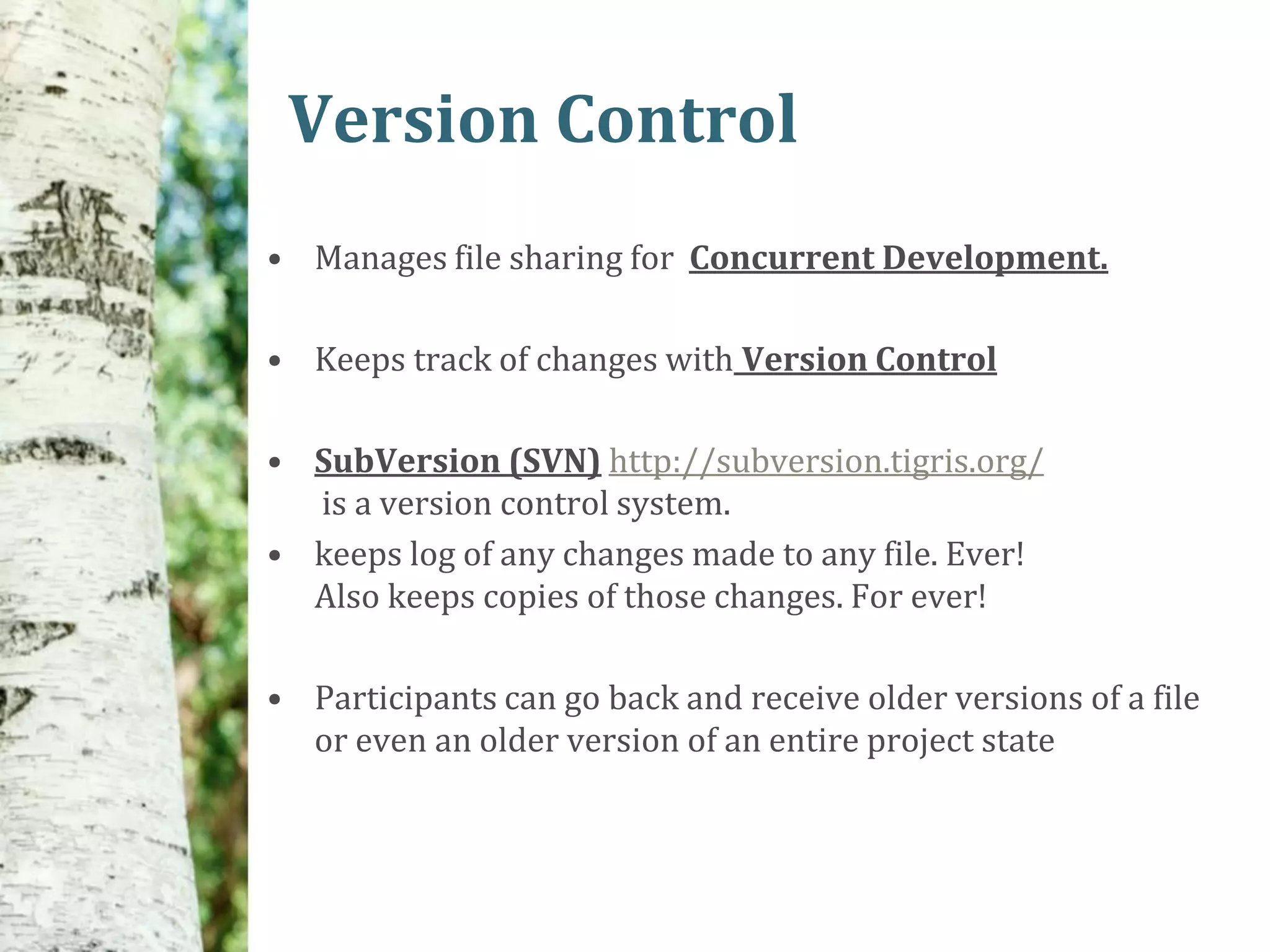

Version Control
• Manages file sharing for Concurrent Development.

• Keeps track of changes with Version Control

• SubVersion (SVN) http://subversion.tigris.org/
  is a version control system.
• keeps log of any changes made to any file. Ever!
  Also keeps copies of those changes. For ever!

• Participants can go back and receive older versions of a file
  or even an older version of an entire project state
