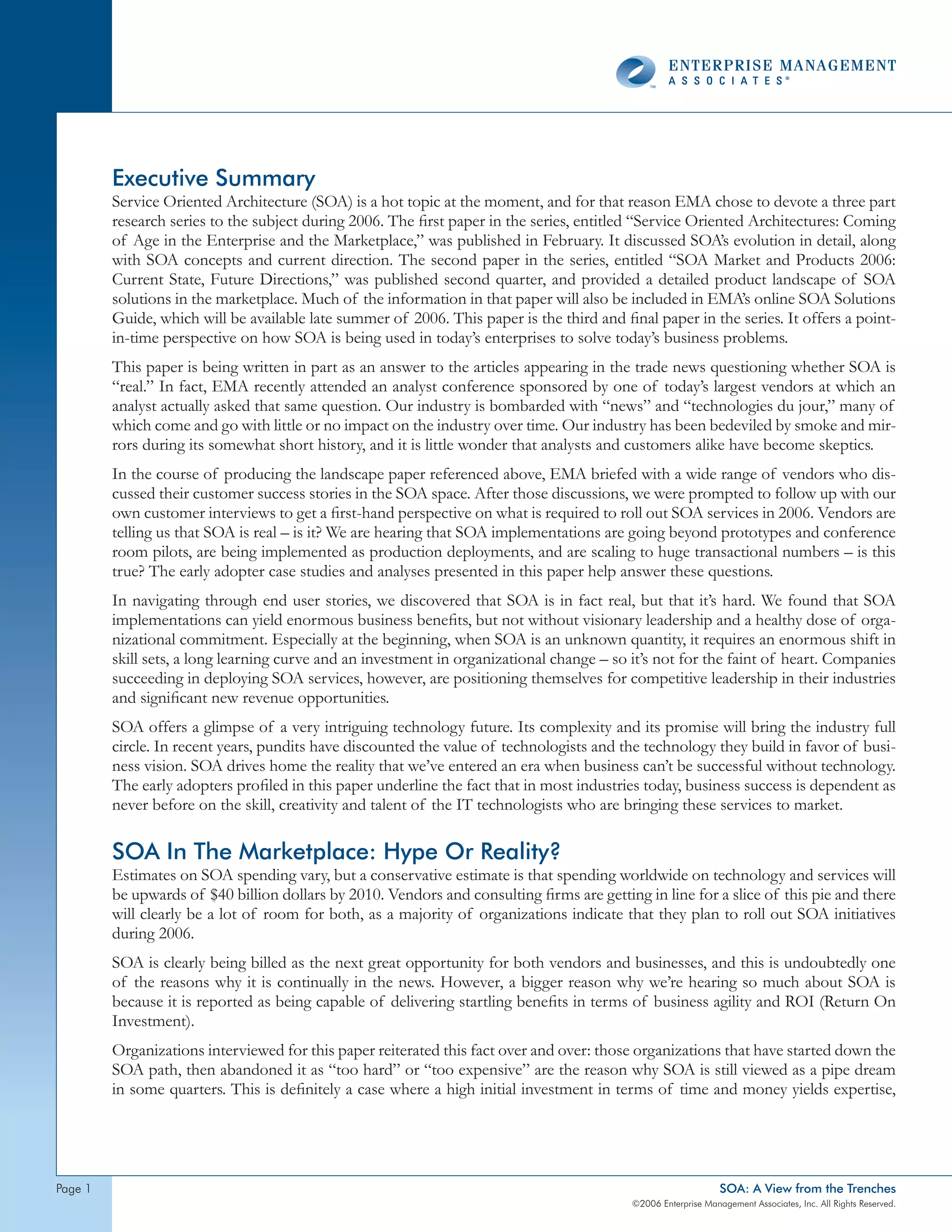

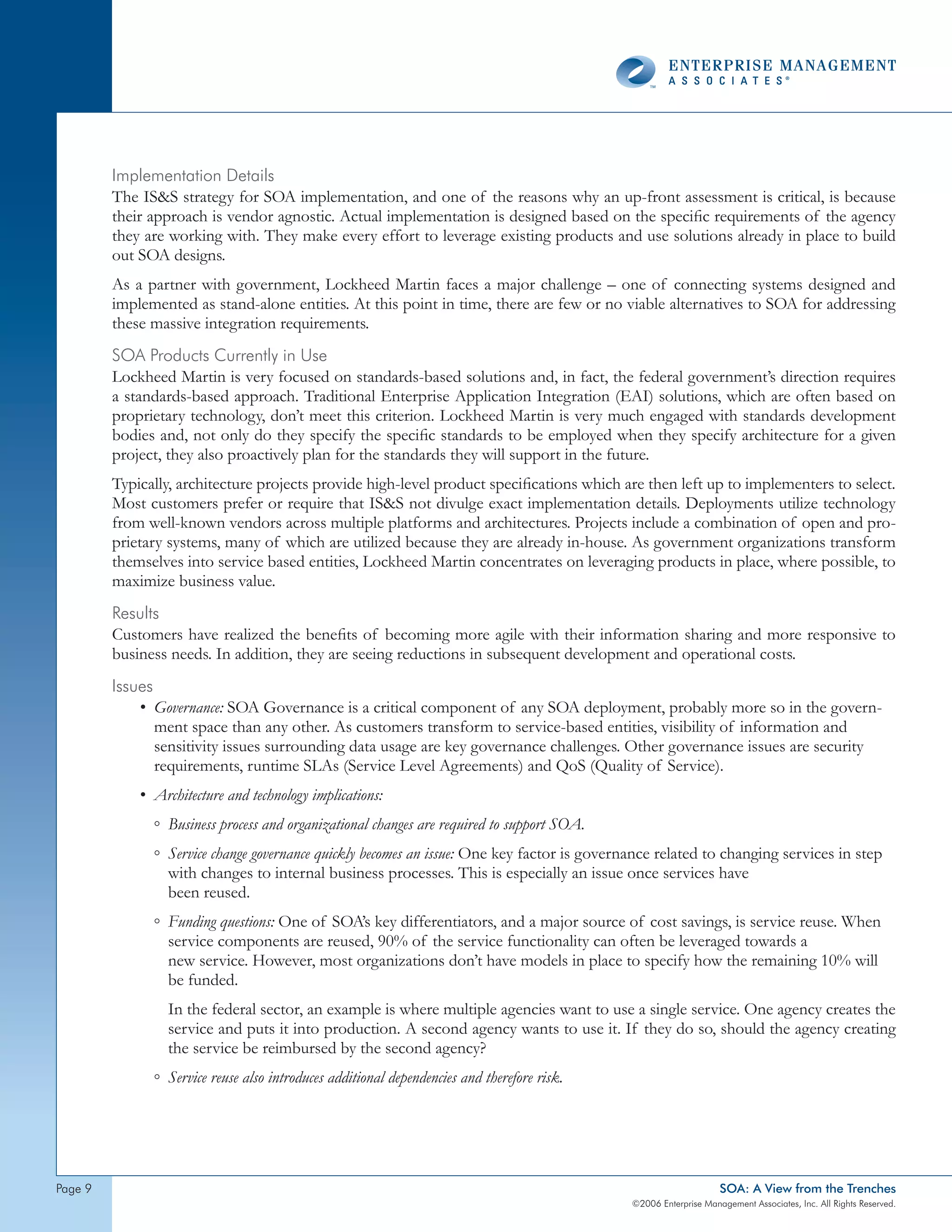

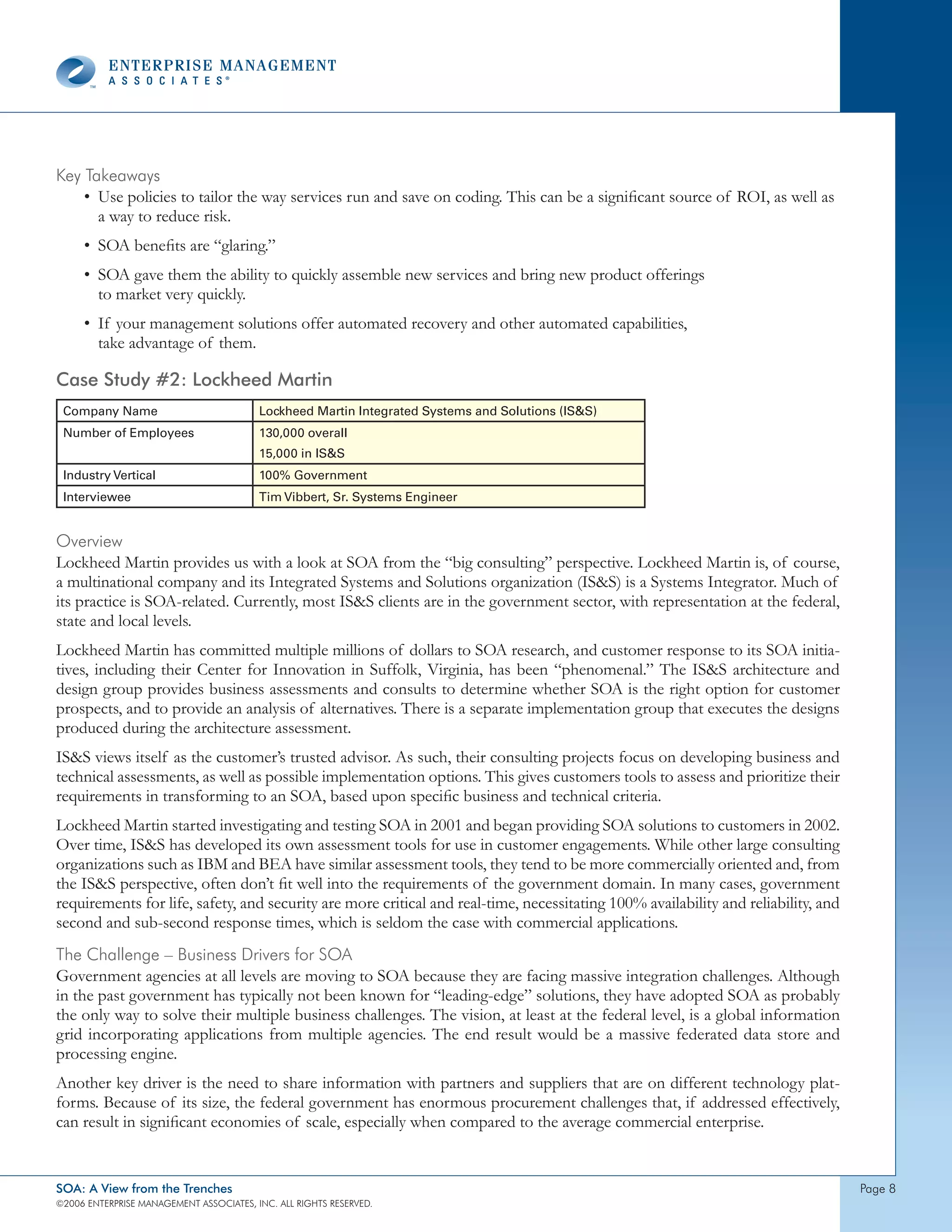

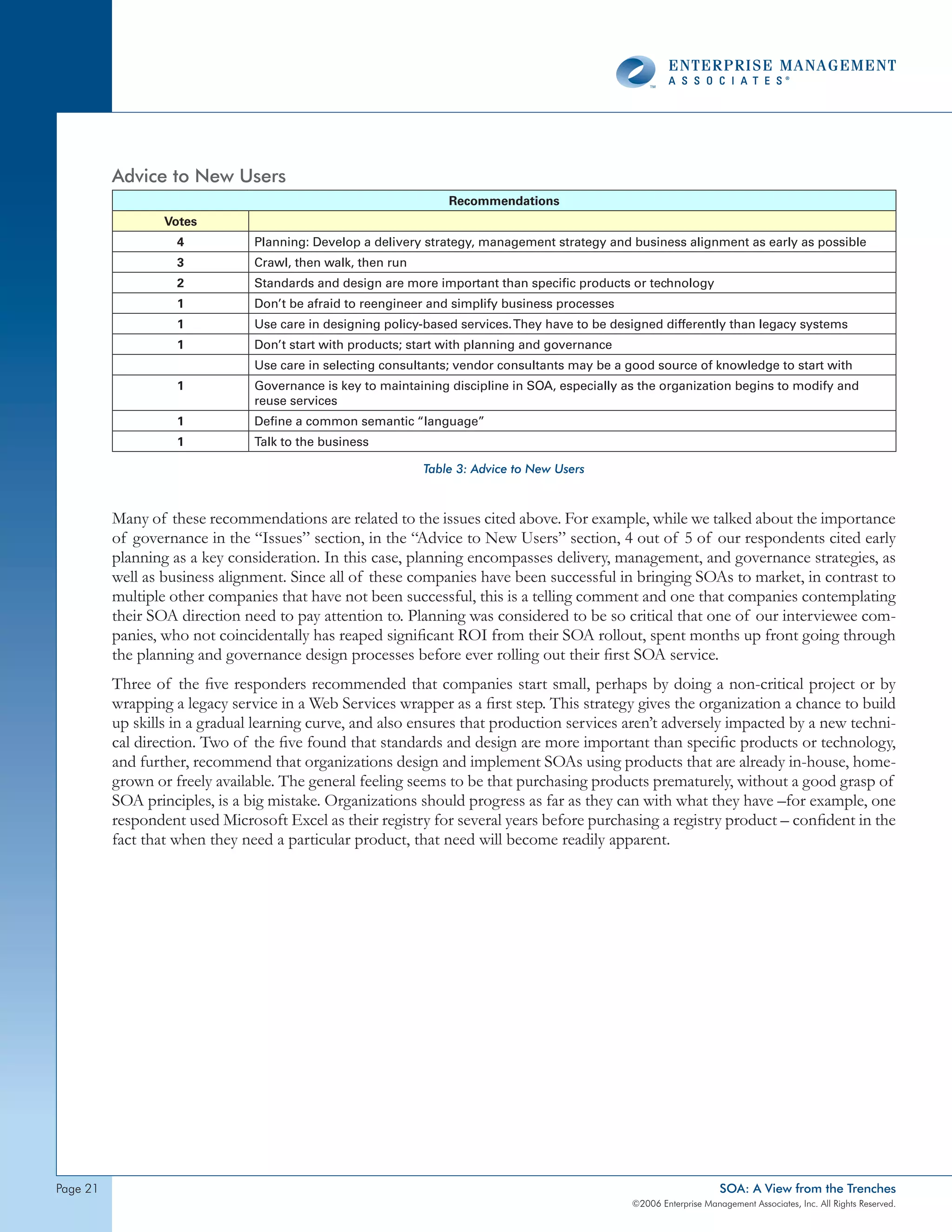

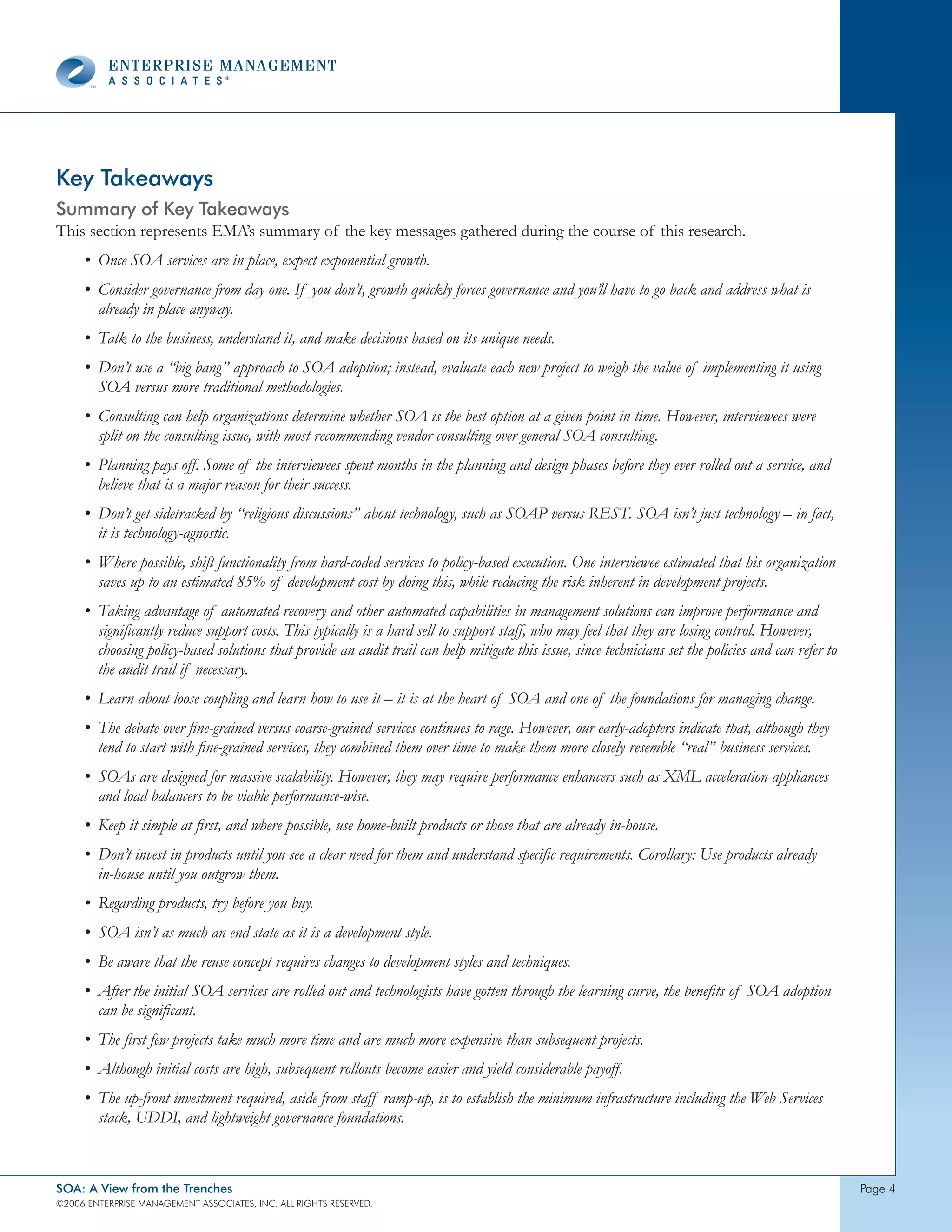

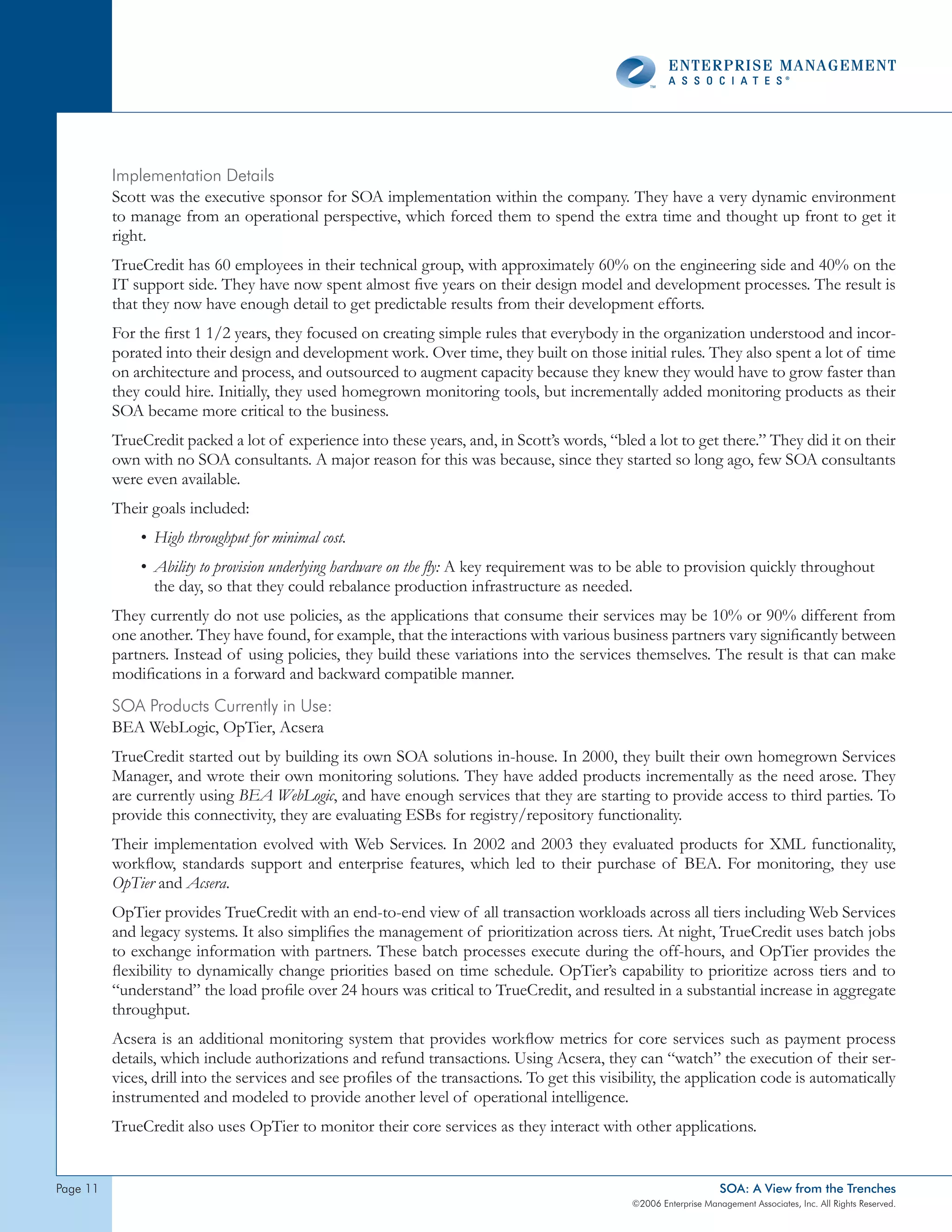

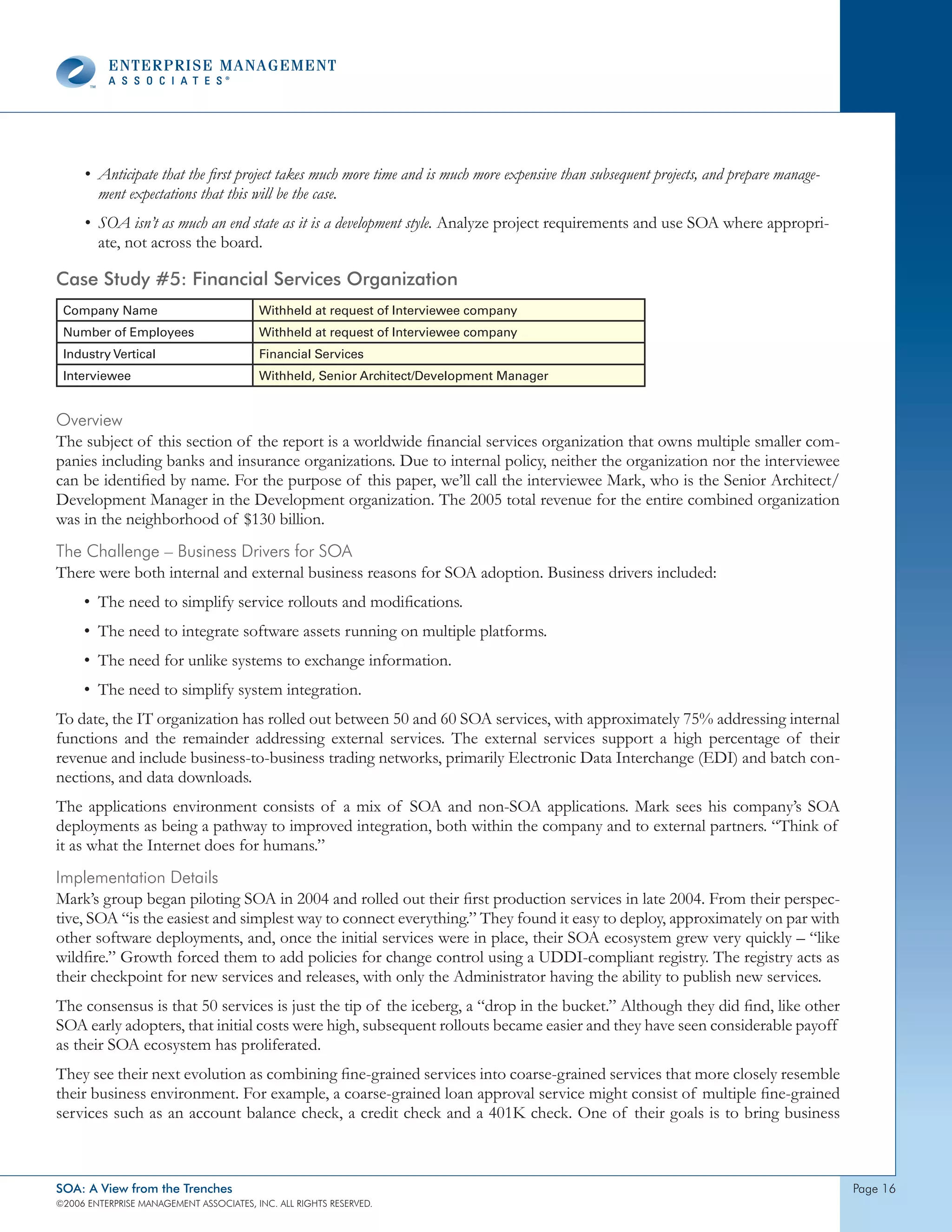

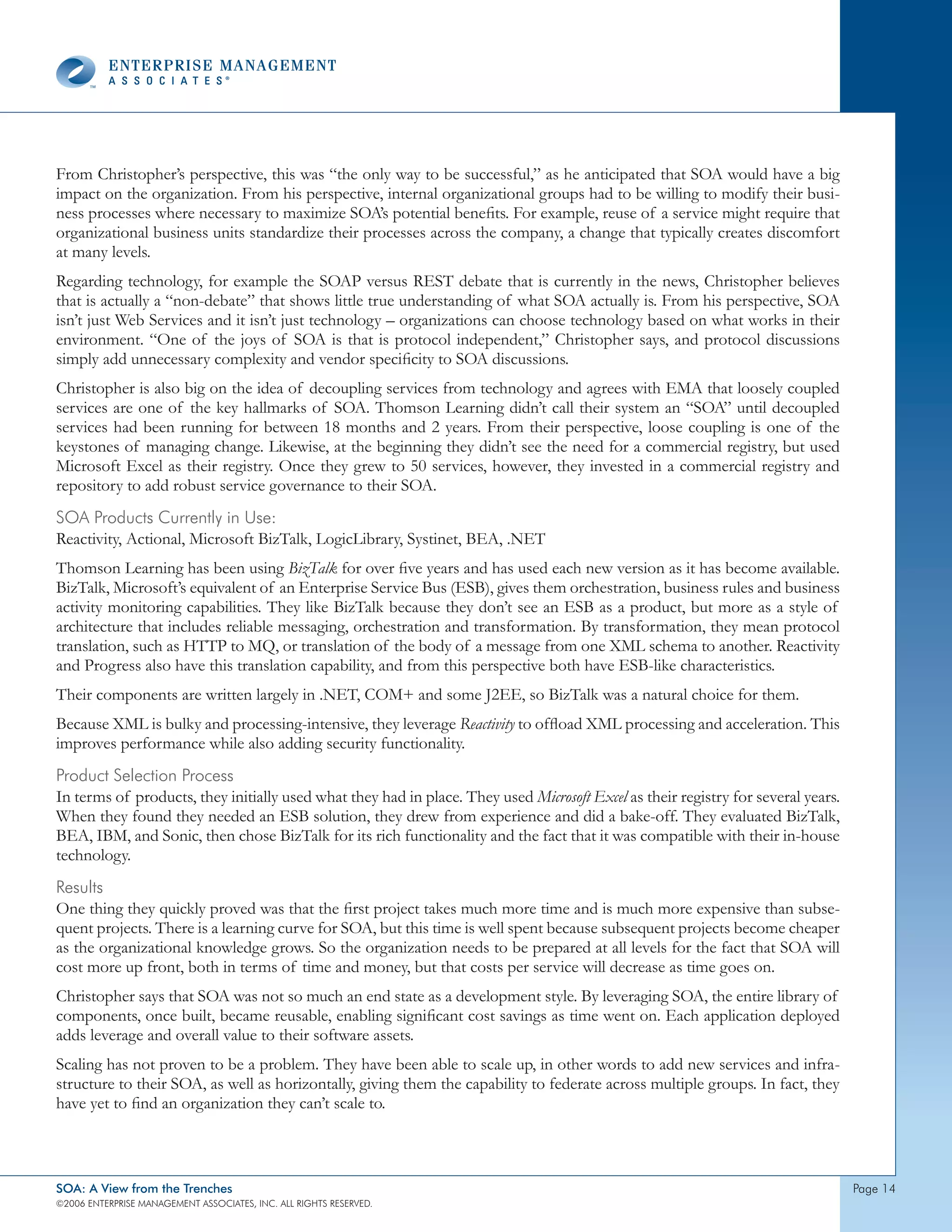

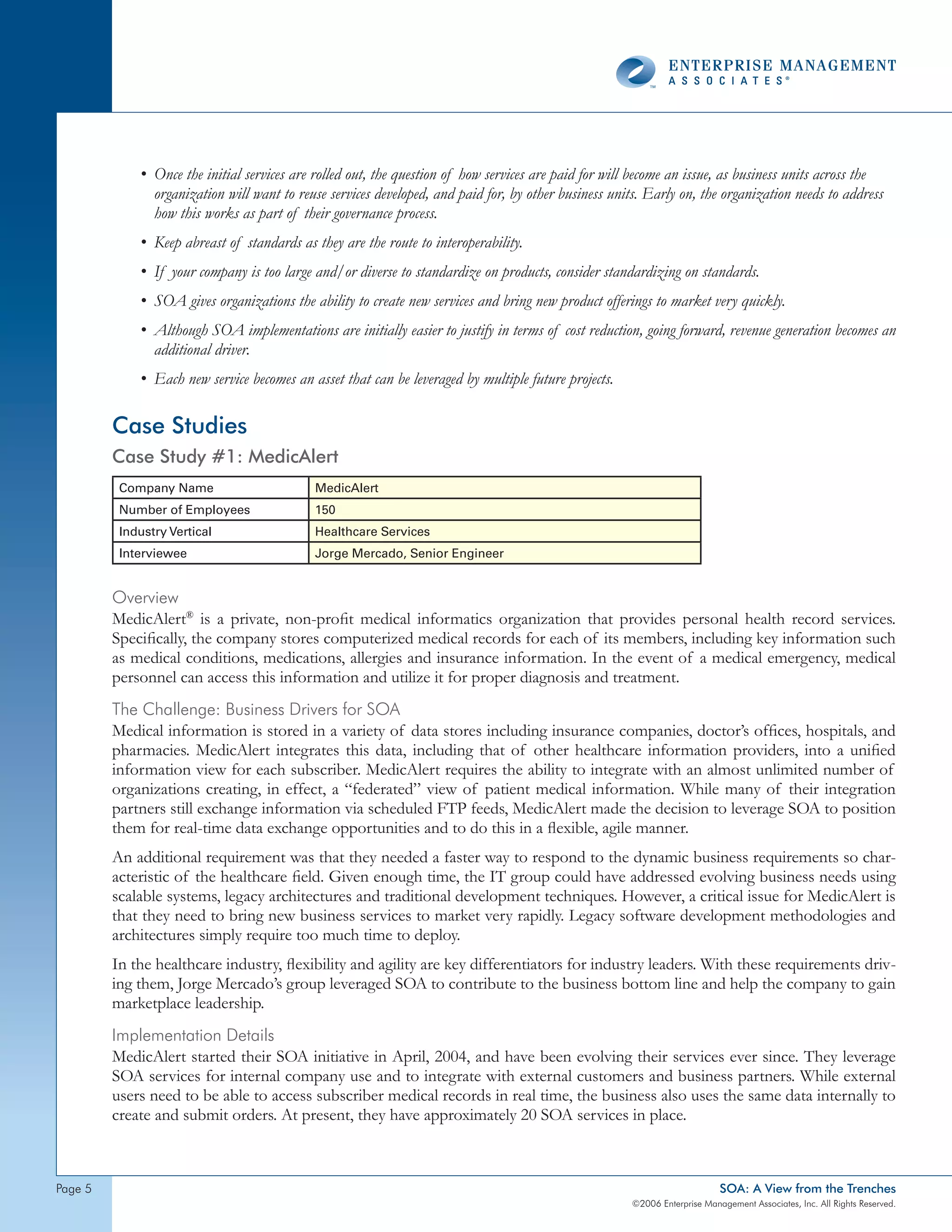

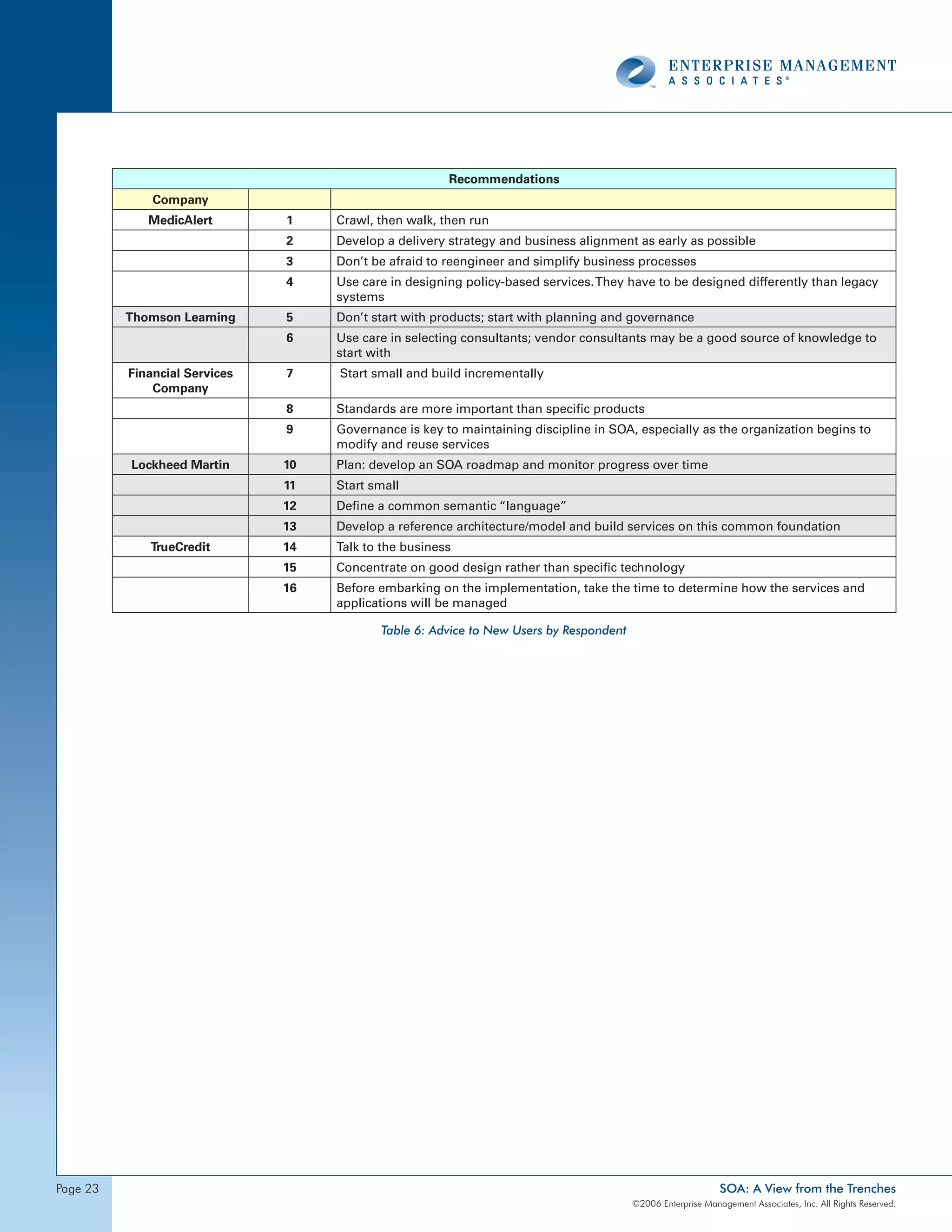

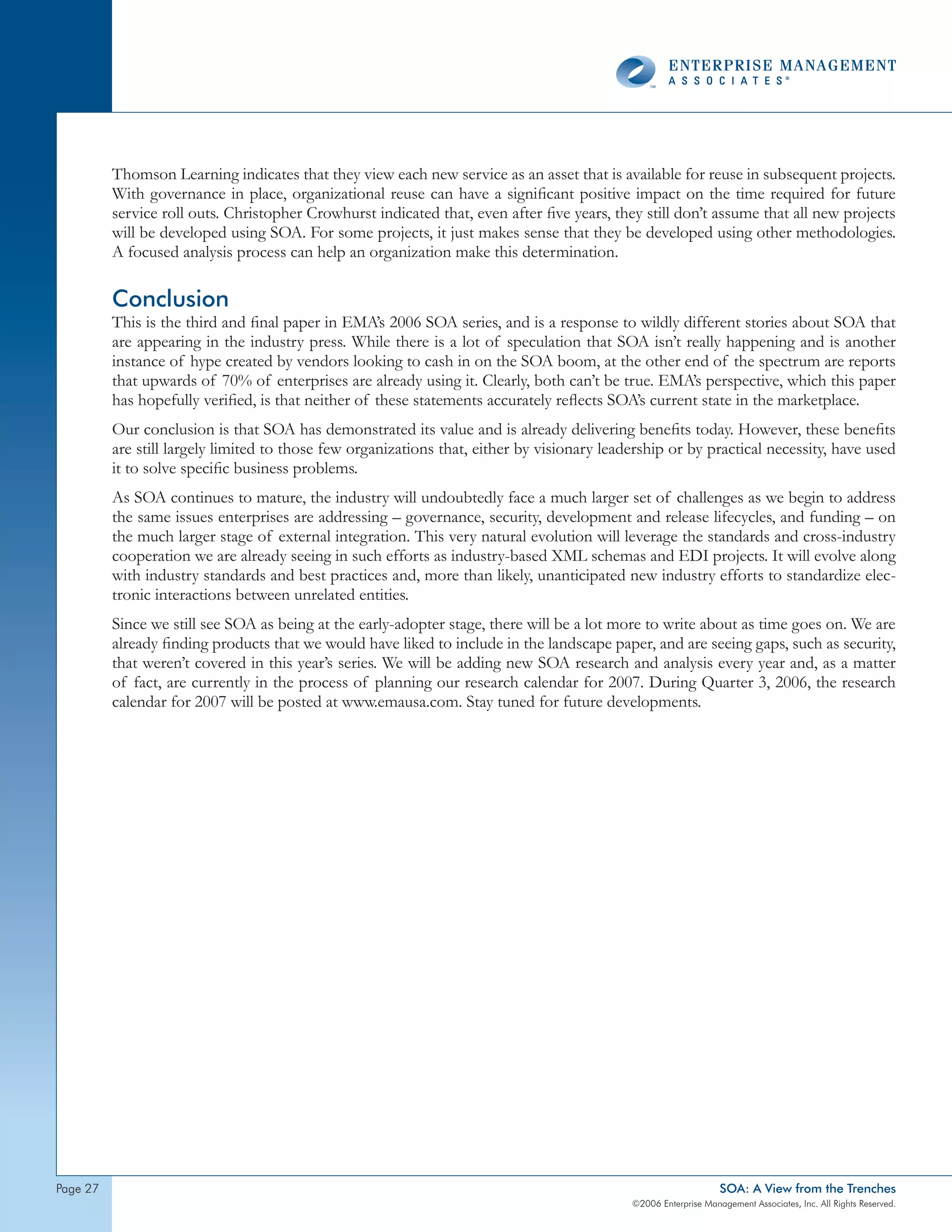

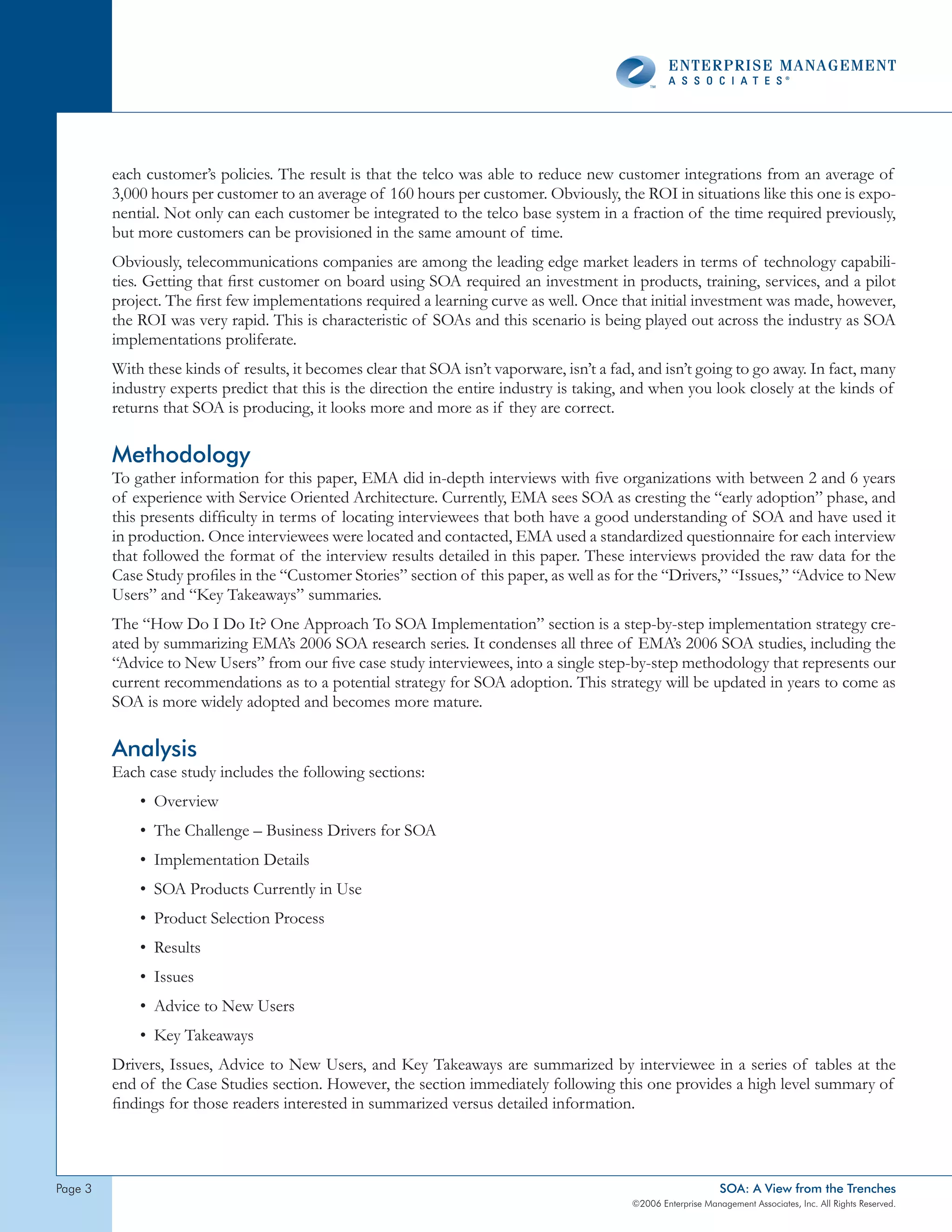

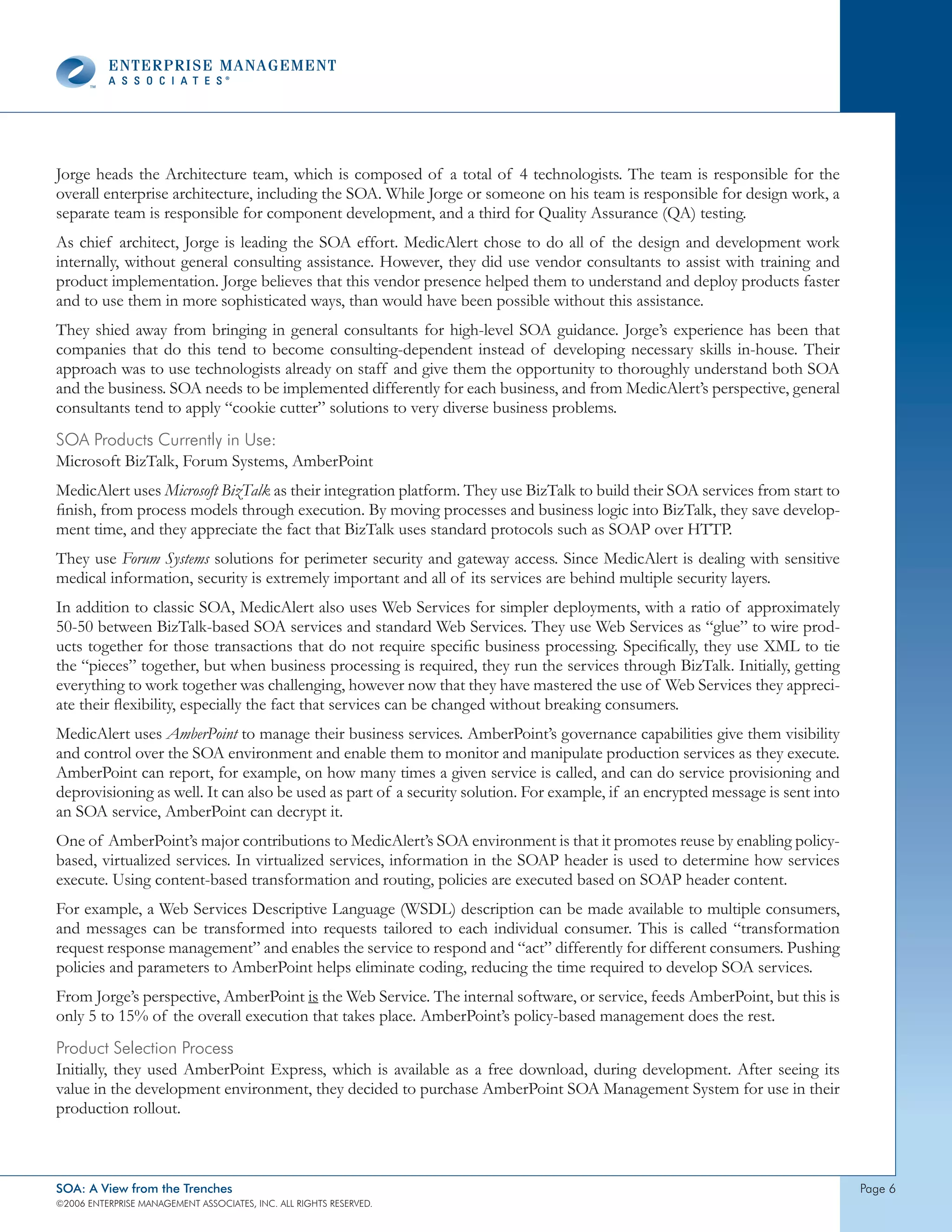

The document summarizes key findings from interviews with five organizations that have implemented SOA in production environments. The organizations ranged from 2-6 years of experience with SOA. Case studies of each organization provided details on their business drivers for SOA, implementation approach, products used, results and lessons learned. Common themes across organizations included exponential growth once initial SOA services are established, importance of governance, value of consulting, benefits of planning, and importance of loose coupling. SOA implementations yielded benefits like reduced integration costs but also challenges like significant investment required.
