SHAMIANA Project
 Software Project Management Project
           Abhinav Kamal 2010007
           Debashish Bagg 2010298

            Under the guidance of

                Prof. H. Halve

                                       Page1

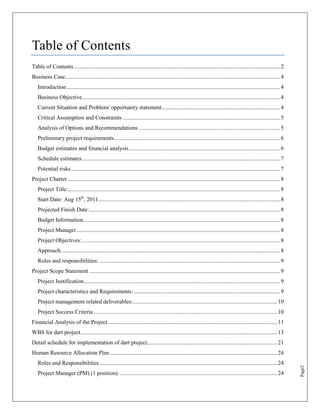

Table of Contents
Table of Contents ............................................................................................................................................... 2
Business Case..................................................................................................................................................... 4
   Introduction .................................................................................................................................................... 4
   Business Objective ......................................................................................................................................... 4
   Current Situation and Problem/ opportunity statement .................................................................................. 4
   Critical Assumption and Constraints ............................................................................................................. 5
   Analysis of Options and Recommendations .................................................................................................. 5
   Preliminary project requirements ................................................................................................................... 6
   Budget estimates and financial analysis......................................................................................................... 6
   Schedule estimates ......................................................................................................................................... 7
   Potential risks ................................................................................................................................................. 7
Project Charter ................................................................................................................................................... 8
   Project Title:................................................................................................................................................... 8
   Start Date: Aug 15th, 2011.............................................................................................................................. 8
   Projected Finish Date: .................................................................................................................................... 8
   Budget Information ........................................................................................................................................ 8
   Project Manager ............................................................................................................................................. 8
   Project Objectives: ......................................................................................................................................... 8
   Approach:....................................................................................................................................................... 8
   Roles and responsibilities: ............................................................................................................................. 9
Project Scope Statement .................................................................................................................................... 9
   Project Justification........................................................................................................................................ 9
   Project characteristics and Requirements: ..................................................................................................... 9

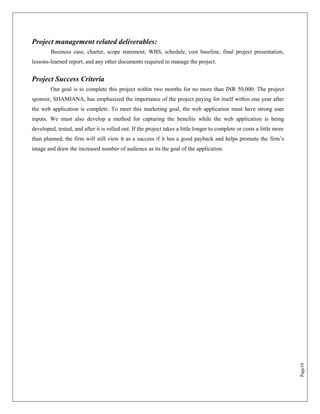

   Project management related deliverables:.................................................................................................... 10
   Project Success Criteria ............................................................................................................................... 10
Financial Analysis of the Project ..................................................................................................................... 11
WBS for dart project ........................................................................................................................................ 13

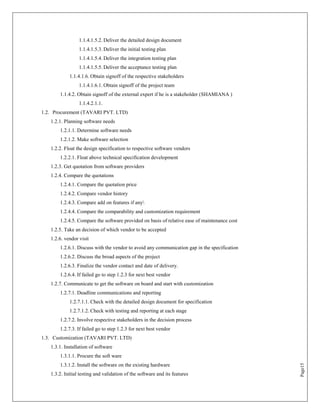

Detail schedule for implementation of dart project.......................................................................................... 21
Human Resource Allocation Plan .................................................................................................................... 24
   Roles and Responsibilities ........................................................................................................................... 24
                                                                                                                                                                         Page2

   Project Manager (PM) (1 position): ............................................................................................................. 24
Design Engineer (DE) (1 position): ............................................................................................................. 24
   Implementation Manager (IM) (1 position): ................................................................................................ 24
Risk Management ............................................................................................................................................ 26
   Risk Identification........................................................................................................................................ 26
   Qualitative Risk Analysis ............................................................................................................................ 26

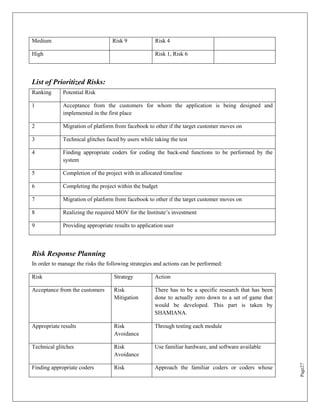

   List of Prioritized Risks: .............................................................................................................................. 27
   Risk Response Planning ............................................................................................................................... 27
   Risk Monitoring and Control ....................................................................................................................... 28

                                                                                                                                                                    Page3
Business Case
Introduction
        SHAMIANA – The Short Film Club is a part of „Two Plus Productions‟ has been in the forefront in
the business of short film exhibition and distribution for the last nine years and is now actively producing
short films. SHAMIANA is a very unique initiative that has gathered a huge following for itself in a short
span. With over 3 million people (and growing) across various countries following the club, it‟s soon
becoming into a cult. They are into business of screening some of the best award-winning short films ever
produced including Oscar winners, National Award winners, Golden Globe winners, Cannes winners,
Berlinale winners, etc. They have showcased approximately 1000 films in the last 3 years.

        SHAMIANA is on its way to becoming the biggest brand in the alternative space of short films and
with the way the film club has taken off in the last ONE YEAR (reaching out to over 3 million across the
country). SHAMIANA has already attracted some powerful associations like, MICROMAX MOBILES,
ZYDUS WELLNESS, CLEARTRIP.COM, and other tie-ups across the country including Times Card,
Radio Mirchi, etc.

Business Objective
        SHAMIANA has been growing for the last few years phenomenally. To expand its reach and imprint
its existence in the essence of customers SHAMIANA has to take leaps into the business of marketing itself
which it has not done so actively. SHAMIANA has been active on the front of marketing through its
facebook page and its own webpage.

        To actively involve customers who visit its web pages SHAMIANA looks to create a few web based
gamming applications. A few though of applications were developing of a web based Dart application or in
animated movie application that would captivate the customer‟s application and also allow the spread the
knowhow of SHAMIANA to other friend and users connected to present customer on facebook.

        Facebook is chose to be the base of launch of this application as its perceived to be most cheapest
and booming platform to communicate with customers from the point of view of SHAMIANA.

Current Situation and Problem/ opportunity statement
        With the advent of information technology and world moving to a internet dependent
communication platform there has been many web based marketing platform that has been available in the
market today. Facebook is one of the communication platforms for marketing.
                                                                                                               Page4
SHAMIANA is one of the initiatives that have a very short reach of 9 cities in the whole country.
There cities span Delhi, Bangalore, Mumbai, Ahmadabad, Pune, Baroda, Goa etc. Each of these expansion
and knowhow lets SHAMIANA to expand to a new customer base and hence to a different territory of
customers and hence allowing growth in number of customers.

        SHAMIANA has found that facebook a very ardent platform of communicating and captivating the
customer‟s attention. This project if successful would provide a gamut of benefits as follows:

      1. Free promotion: This application if successful would help in achieving free promotion.
      2. Exponential spread of knowledge about the firm: As the application is basically targeted to be
          launched on facebook as a platform, with the help of data sharing features that facebook allows it
          can be easily passed on to from one friend to another and hence improve the overall knowledge
          about SHAMIANA.
      3. Market survey: This if successful would also help in launching different region based market
          survey such that it can be expanded into different geographic location across the country.
      4. Easily accessible.
      5. Increase of visibility of SHAMIANA
      6. Customer engagement: These applications will allow to have a direct engagement of customer.

Critical Assumption and Constraints
        The proposed dart application must be a valuable asset for SHAMIANA in terms of increasing its
visibility and reach into customer base. It also needs to be able to perform customer engagement on a
positive note. It should not adversely affect the customer base in terms of depleting the existing base of its
customers. The most deathly constraint that SHAMIANA faces being only 3 years old is that of financing the
present development. The funds that has been allocated by SHAMIANA for the current development is
50,000 INR.

Analysis of Options and Recommendations
        There are three options for addressing this opportunity:

        1. Do nothing. SHAMIANA is doing well, and might be able to continue to operate without this
new project. The rate at which number of customers has been growing is phenomenon at the present stage.
This project is based on the fact that facebook is a vast platform of promotional activity and helps to rope in
new customers if they are made to be involved into some application. (i.e. the application on facebook are
easy ways to rope in the customer involvement)
                                                                                                                  Page5
2. Purchase of external software: There are many off shelf facebook and flash application like
angry birds and lord of Ultimatum etc. that are available for free and some for a minimal cost. But
SHAMIANA‟s motto to build application is not only to get customers involved with it but to drag them into
knowing and getting involved with SHAMIANA as a whole. So these off shelf application either will not
help or will need to be highly customized to suit for the same.

        3. Design and implement by Vendor: The new intranet based application could be outsourced to an
external vendor who would then code and develop the front end of the project. Hardware required for the
project would be outsourced initially to some server hosting client. In accordance to the changes in the future
scenario of success of the software these might be a server buying decision.

        Based on discussions with SHAMIANA, we believe that option 3 is the best option to work on
though the costing seems to be on a bit higher end.

Preliminary project requirements
        The main features of the facebook based application include the following:

    1. Eye catching graphics to catch customer‟s attention immediately.
    2. Allow upload of photograph or brown photo on web to serve as the basis of Dart application
        developed.
    3. Application needs to be easy and light to be loaded on computer with basic requirement.
    4. Also needs to have records and display personalized records on global basis.

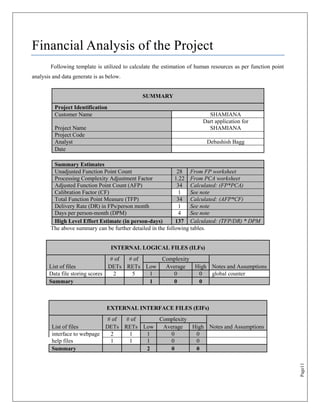

Budget estimates and financial analysis
                          Actual heading                    Cost Estimation

                          Cost of leasing hardware          5000-6000 INR /annum

                          Cost of code development          20,000-25,000 INR

                          Cost of front end development 25,000 INR

                          Maintenance cost                  2000 INR/ month

        The project has a potential to fetch in customer from varied background and varied taste and
preferences. Hence the amount of intangible branding that the application can develop is huge. In terms of
adding the number of customers on an average of 400/ month and if the conversion of customers on
facebook to real life is approximately 10% that gives be 40 customs/ month. i.e. approximately 500
customers per year that is a huge potential of growth. All these values are just data that are found from a
                                                                                                                  Page6
survey that is circulated internal in many Google and facebook group and hence the data could be higher than
denoted value.

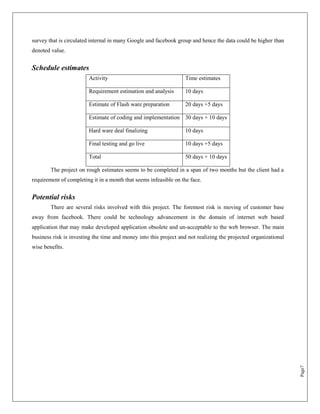

Schedule estimates
                        Activity                                   Time estimates

                        Requirement estimation and analysis        10 days

                        Estimate of Flash ware preparation         20 days +5 days

                        Estimate of coding and implementation 30 days + 10 days

                        Hard ware deal finalizing                  10 days

                        Final testing and go live                  10 days +5 days

                        Total                                      50 days + 10 days

        The project on rough estimates seems to be completed in a span of two months but the client had a
requirement of completing it in a month that seems infeasible on the face.

Potential risks
        There are several risks involved with this project. The foremost risk is moving of customer base
away from facebook. There could be technology advancement in the domain of internet web based
application that may make developed application obsolete and un-acceptable to the web browser. The main
business risk is investing the time and money into this project and not realizing the projected organizational
wise benefits.

                                                                                                                 Page7

Project Charter
Project Title:
        Dart application for SHAMIANA

Start Date: Aug 15th, 2011.

Projected Finish Date:
        Initial launch of this project is going to be within 2 months of start date.

Budget Information
        The organization needs to allocate 50,000 INR for this project. The majority of costs for this project
will be payment to vendors developing different parts of the project. The amount mentioned above does not
include cost like server space leasing cost and also regular maintenance and update cost. An initial estimate
provides a total of 60 days of work will be needed for completion of the project.

Project Manager
        Debashish Bagg and Abhinav Kamal will share this responsibility.

Project Objectives:
        Develop a new facebook based / web based application that would help customers to connect to the
work done by SHAMIANA more effectively. The web application will be a basic dart on to which you can
upload specific photos or browse from friends thus playing a interactive application that involves the
customer. It also has potential of capturing the customer responses that would give ques about continuing or
scraping the present application development going further.

Approach:
        1. Develop a survey to determine critical features of the web based dart that needs to be developed
            and the respective application linkages that are needed.
        2. Research software to provide features needed along with the hardware that would support the
            same.
        3. Develop a dart application soliciting a great deal of user feedback
        4. Determine a way to measure the value of application and the value that is added by the
            application to SHAMIANA.
                                                                                                                 Page8

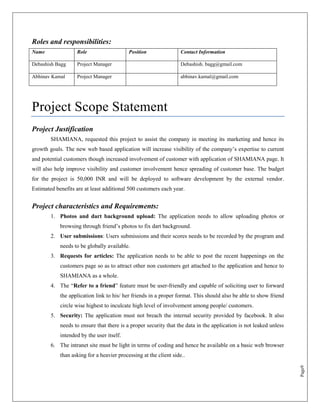

Roles and responsibilities:
Name               Role                    Position                Contact Information

Debashish Bagg     Project Manager                                 Debashish. bagg@gmail.com

Abhinav Kamal      Project Manager                                 abhinav.kamal@gmail.com

Project Scope Statement
Project Justification
        SHAMIANA, requested this project to assist the company in meeting its marketing and hence its
growth goals. The new web based application will increase visibility of the company‟s expertise to current
and potential customers though increased involvement of customer with application of SHAMIANA page. It
will also help improve visibility and customer involvement hence spreading of customer base. The budget
for the project is 50,000 INR and will be deployed to software development by the external vendor.
Estimated benefits are at least additional 500 customers each year.

Project characteristics and Requirements:
        1. Photos and dart background upload: The application needs to allow uploading photos or
            browsing through friend‟s photos to fix dart background.
        2. User submissions: Users submissions and their scores needs to be recorded by the program and
            needs to be globally available.
        3. Requests for articles: The application needs to be able to post the recent happenings on the
            customers page so as to attract other non customers get attached to the application and hence to
            SHAMIANA as a whole.
        4. The “Refer to a friend” feature must be user-friendly and capable of soliciting user to forward
            the application link to his/ her friends in a proper format. This should also be able to show friend
            circle wise highest to inculcate high level of involvement among people/ customers.
        5. Security: The application must not breach the internal security provided by facebook. It also
            needs to ensure that there is a proper security that the data in the application is not leaked unless
            intended by the user itself.
        6. The intranet site must be light in terms of coding and hence be available on a basic web browser
            than asking for a heavier processing at the client side..
                                                                                                                    Page9

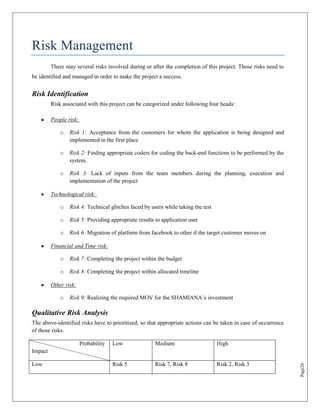

Project management related deliverables:
        Business case, charter, scope statement, WBS, schedule, cost baseline, final project presentation,
lessons-learned report, and any other documents required to manage the project.

Project Success Criteria
        Our goal is to complete this project within two months for no more than INR 50,000. The project
sponsor, SHAMIANA, has emphasized the importance of the project paying for itself within one year after
the web application is complete. To meet this marketing goal, the web application must have strong user
inputs. We must also develop a method for capturing the benefits while the web application is being
developed, tested, and after it is rolled out. If the project takes a little longer to complete or costs a little more
than planned, the firm will still view it as a success if it has a good payback and helps promote the firm‟s
image and draw the increased number of audience as its the goal of the application.

                                                                                                                         Page10
Financial Analysis of the Project
        Following template is utilized to calculate the estimation of human resources as per function point
analysis and data generate is as below.

                                               SUMMARY
          Project Identification
          Customer Name                                                   SHAMIANA
                                                                        Dart application for
          Project Name                                                    SHAMIANA
          Project Code
          Analyst                                                         Debashish Bagg
          Date

         Summary Estimates
         Unadjusted Function Point Count                      28 From FP worksheet
         Processing Complexity Adjustment Factor             1.22 From PCA worksheet
         Adjusted Function Point Count (AFP)                  34 Calculated: (FP*PCA)
         Calibration Factor (CF)                               1   See note
         Total Function Point Measure (TFP)                   34 Calculated: (AFP*CF)
         Delivery Rate (DR) in FPs/person month                1   See note
         Days per person-month (DPM)                           4   See note
         High Level Effort Estimate (in person-days)         137 Calculated: (TFP/DR) * DPM
        The above summary can be further detailed in the following tables.

                                   INTERNAL LOGICAL FILES (ILFs)
                                 # of # of    Complexity
       List of files            DETs RETs Low  Average   High Notes and Assumptions
       Data file storing scores   2    5   1      0       0   global counter
       Summary                             1      0       0

                                EXTERNAL INTERFACE FILES (EIFs)
                              # of # of    Complexity
        List of files        DETs RETs Low  Average   High Notes and Assumptions
        interface to webpage   2    1   1      0       0
        help files             1    1   1      0       0
        Summary                         2      0       0
                                                                                                              Page11
EXTERNAL INPUTS (EIs)
                              # of # of    Complexity
            List of inputs   DETs FTRs Low  Average   High Notes and Assumptions
            User name          2    1   1      0       0
            User friend list   1    30  0      1       0   Tagged
            Summary                     1      1       0

                          UNADJUSTED FUNCTION POINT COUNT (FP)

Function Type                   Functional Complexity Count Weight Function Points (FPs) FP %
Internal Logical Files (ILFs)           Low             1     7              7
                                       Average          0    10              0
                                        High            0    15              0            25%
External Interface Files (EIFs)         Low             2     5             10
                                       Average          0     7              0
                                        High            0    10              0            36%
External Inputs (EIs)                   Low             1     3              3
                                       Average          1     4              4
                                        High            0     6              0            25%
External Outputs (EOs)                  Low             1     4              4
                                       Average          0     5              0
                                        High            0     7              0            14%
External Queries (EQs)                  Low             0     3              0
                                       Average          0     4              0
                                        High            0     6              0             0%
                Total Unadjusted Function Point Count                       28           100%

                                VALUE ADJUSTMENT FACTOR (VAF)
                                             Degree
                                                of
       General Systems Characteristics                               Description
                                            Influence
                                              (0-5)
       1.          Data Communications          5     The application is online
       2.          Distributed Processing       4     It has to be distributed calculation
       3.          Performance                  3
                   Heavily Used
       4.          Configuration                3
       5.          Transaction Rates            4
       6.          Online Data Entry            5
                   Design for End User
                                                                                                Page12

       7.          Efficiency                   4
       8.          Online Update                5      update is online
9.         Complex Processing                        4        average on processing complexity
                    Usable in Other                                    has to be reusable to be moved to other
         10.        Applications                              4        coding if needed
         11.        Installation Ease                         3
         12.        Operational Ease                          4
         13.        Multiple Sites                            5        on website and facebook
         14.        Facilitate Change                         4        needs to allow change
         Total Degree of Influence (TDI)
                                                             57        Calculated (sum of the above)
         Value Adjustment Factor (VAF)                      1.22       Calculated ((TDI*0.01)+0.65)

WBS for dart project

1.   Dart project
     1.1. Design of web application Interface (MAAC)
         1.1.1. Interface specification
              1.1.1.1. Functional specification
                    1.1.1.1.1. Interface for web browser
                        1.1.1.1.1.1. Create mock interface for web browser
                        1.1.1.1.1.2. Conduct design review internal to the team
                        1.1.1.1.1.3. Get design reviewed by stakeholders
                             1.1.1.1.1.3.1. Get design reviewed by mock users
                        1.1.1.1.1.4. Take consensus for the design
                        1.1.1.1.1.5. Create a final functional specification
                        1.1.1.1.1.6. Obtain individual signoff
                    1.1.1.1.2. Interface for mobile browser (can run simultaneously with 1.1.1.1.1)
                        1.1.1.1.2.1. Create mock interface for web browser
                        1.1.1.1.2.2. Conduct design review internal to the team
                        1.1.1.1.2.3. Get design reviewed by stakeholders
                             1.1.1.1.2.3.1. Get design reviewed by mock users
                        1.1.1.1.2.4. Take consensus for the design
                        1.1.1.1.2.5. Create a final functional specification
                        1.1.1.1.2.6. Obtain individual signoff
                             1.1.1.1.2.6.1. Signoff for interface from SHAMIANA representative body and mock users
              1.1.1.2. Technical specifications (TAVARI PVT. LTD)
                    1.1.1.2.1. Develop the technical specifications based on the previous signoff document
                    1.1.1.2.2. Review the technical specifications
                                                                                                                     Page13

                    1.1.1.2.3. Obtain signoff from respective stakeholders
                        1.1.1.2.3.1. Signoff of the SHAMIANA representation
1.1.1.2.3.2. Signoff of mock users if required
1.1.2. SQL Database specification (TAVARI PVT. LTD)
    1.1.2.1. Develop technical specifications
    1.1.2.2. Review technical specifications
        1.1.2.2.1. Review by the project team
    1.1.2.3. Review by external expert (SHAMIANA )
    1.1.2.4. Rework technical specification
    1.1.2.5. Obtain team signoff
        1.1.2.5.1. Obtain signoff of the project team
    1.1.2.6. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA )

1.1.3. Interfaces (TAVARI PVT. LTD)
    1.1.3.1. Technical specifications
        1.1.3.1.1. Determine data import/ export elements
        1.1.3.1.2. Design Interface
        1.1.3.1.3. Obtain signoff of the respective stakeholders
             1.1.3.1.3.1. Obtain signoff of the project team
    1.1.3.2. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA )

1.1.4. Reports (TAVARI PVT. LTD)
    1.1.4.1. Functional specification report
        1.1.4.1.1. Collect user requirement data
             1.1.4.1.1.1. Define data elements
                 1.1.4.1.1.1.1. Define null or initial values if any on the screen
                 1.1.4.1.1.1.2. Define relative values for users i.e. any history to be maintained
             1.1.4.1.1.2. Define frequency of use
             1.1.4.1.1.3. Define sessions
        1.1.4.1.2. Design reports
             1.1.4.1.2.1. Design and develop the functional specifications
             1.1.4.1.2.2. Document relationship/ flow from functional specification to technical specification
             1.1.4.1.2.3. Design and develop the detailed design document
             1.1.4.1.2.4. Flow from detailed design specification to test plans
             1.1.4.1.2.5. Design and develop the initial testing plan
             1.1.4.1.2.6. Design and develop the integration testing plan
        1.1.4.1.3. Deliver the acceptance testing plan
        1.1.4.1.4. Review report design with project team
        1.1.4.1.5. Deliver final functional specifications
                                                                                                                 Page14

             1.1.4.1.5.1. Deliver the functional specifications
1.1.4.1.5.2. Deliver the detailed design document
                 1.1.4.1.5.3. Deliver the initial testing plan
                 1.1.4.1.5.4. Deliver the integration testing plan
                 1.1.4.1.5.5. Deliver the acceptance testing plan
            1.1.4.1.6. Obtain signoff of the respective stakeholders
                 1.1.4.1.6.1. Obtain signoff of the project team
       1.1.4.2. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA )
                 1.1.4.2.1.1.
1.2. Procurement (TAVARI PVT. LTD)
   1.2.1. Planning software needs
       1.2.1.1. Determine software needs
       1.2.1.2. Make software selection
   1.2.2. Float the design specification to respective software vendors
       1.2.2.1. Float above technical specification development
   1.2.3. Get quotation from software providers
   1.2.4. Compare the quotations
       1.2.4.1. Compare the quotation price
       1.2.4.2. Compare vendor history
       1.2.4.3. Compare add on features if any
       1.2.4.4. Compare the comparability and customization requirement
       1.2.4.5. Compare the software provided on basis of relative ease of maintenance cost
   1.2.5. Take an decision of which vendor to be accepted
   1.2.6. vendor visit
       1.2.6.1. Discuss with the vendor to avoid any communication gap in the specification
       1.2.6.2. Discuss the broad aspects of the project
       1.2.6.3. Finalize the vendor contact and date of delivery.
       1.2.6.4. If failed go to step 1.2.3 for next best vendor
   1.2.7. Communicate to get the software on board and start with customization
       1.2.7.1. Deadline communications and reporting
            1.2.7.1.1. Check with the detailed design document for specification
            1.2.7.1.2. Check with testing and reporting at each stage
       1.2.7.2. Involve respective stakeholders in the decision process
       1.2.7.3. If failed go to step 1.2.3 for next best vendor
1.3. Customization (TAVARI PVT. LTD)
   1.3.1. Installation of software
       1.3.1.1. Procure the soft ware
       1.3.1.2. Install the software on the existing hardware
                                                                                              Page15

   1.3.2. Initial testing and validation of the software and its features
1.3.2.1. Front end testing
    1.3.2.1.1. Browser front end testing
         1.3.2.1.1.1. Verify design and functionality
         1.3.2.1.1.2. Perform unit testing
         1.3.2.1.1.3. Perform integration testing
         1.3.2.1.1.4. Perform acceptance testing
              1.3.2.1.1.4.1. Perform load testing (if needed)
              1.3.2.1.1.4.2. Perform connectivity testing (if needed)
         1.3.2.1.1.5. Obtain signoff from the testing team and end users
         1.3.2.1.1.6. Note and communicate the customizations needed
         1.3.2.1.1.7. Signoff test plan for vendor
    1.3.2.1.2. Mobile frontend testing
         1.3.2.1.2.1. Verify design and functionality
         1.3.2.1.2.2. Perform unit testing
         1.3.2.1.2.3. Perform integration testing
         1.3.2.1.2.4. Perform acceptance testing
              1.3.2.1.2.4.1. Perform load testing (if needed)
              1.3.2.1.2.4.2. Perform connectivity testing (if needed)
         1.3.2.1.2.5. Obtain signoff from the testing team and end users
         1.3.2.1.2.6. Note and communicate the customizations needed
         1.3.2.1.2.7. Signoff test plan for vendor
1.3.2.2. SQL database testing
    1.3.2.2.1. Verify design/ data elements
    1.3.2.2.2. Verify the relationships
    1.3.2.2.3. Perform integration testing
    1.3.2.2.4. Perform User acceptance testing
         1.3.2.2.4.1. Acceptance testing in terms of load
         1.3.2.2.4.2. Acceptance testing in terms of integrity etc
    1.3.2.2.5. Obtain user signoff
1.3.2.3. Interface
    1.3.2.3.1. Verify design and functionality
    1.3.2.3.2. Perform Integration Testing
    1.3.2.3.3. Perform User Acceptance Testing
    1.3.2.3.4. Obtain signoff from the testing team and end users
    1.3.2.3.5. Note and communicate the customizations needed
    1.3.2.3.6. Signoff test plan for vendor
1.3.2.4. Reports
                                                                           Page16

    1.3.2.4.1. Verify design and functionality
1.3.2.4.2. Perform Integration test
        1.3.2.4.3. Perform User Acceptance Testing
        1.3.2.4.4. Obtain signoff from the testing team and end users
        1.3.2.4.5. Note and communicate the customizations needed
        1.3.2.4.6. Signoff test plan for vendor
1.3.3. Implement the required customization
    1.3.3.1. Front End
        1.3.3.1.1. Mock user front end
             1.3.3.1.1.1. Customize Web pages
             1.3.3.1.1.2. Conduct Unit testing
             1.3.3.1.1.3. Review web page design and functionality
             1.3.3.1.1.4. Get final user to test
             1.3.3.1.1.5. Rework if needed for the same
        1.3.3.1.2. Web front end
             1.3.3.1.2.1. Customize Web pages
             1.3.3.1.2.2. Conduct Unit testing
             1.3.3.1.2.3. Review web page design and functionality
             1.3.3.1.2.4. Get final user to test
             1.3.3.1.2.5. Rework if needed for the same
        1.3.3.1.3. Mobile front end
             1.3.3.1.3.1. Customize Web pages
             1.3.3.1.3.2. Conduct Unit testing
             1.3.3.1.3.3. Review web page design and functionality
             1.3.3.1.3.4. Get final user to test
             1.3.3.1.3.5. Rework if needed for the same
    1.3.3.2. SQL Database
        1.3.3.2.1. Identify the customization in relationships of the tables
        1.3.3.2.2. Build the database schemas
        1.3.3.2.3. Build each data element if needed
        1.3.3.2.4. Build database tables
        1.3.3.2.5. Review tables with project team and external expert
    1.3.3.3. Interface
        1.3.3.3.1. Customize interfaces where ever needed
        1.3.3.3.2. Conduct unit testing of import and export functionality
        1.3.3.3.3. Sign off for interface customization
    1.3.3.4. Reports
        1.3.3.4.1. Code custom reports
                                                                               Page17

        1.3.3.4.2. Test custom reports
1.3.3.4.3. Review
              1.3.3.4.3.1. Review the reports with required stakeholders if needed
              1.3.3.4.3.2. Review the reports with project team
              1.3.3.4.3.3. Rework if there are changes needed
         1.3.3.4.4. Sign off custom reports development
    1.3.3.5. Track customization at every stage through different reporting mechanism
1.3.4. Final testing and validation of the software and its features
    1.3.4.1. Front end testing
         1.3.4.1.1. Browser front end testing
              1.3.4.1.1.1. Verify design and functionality
              1.3.4.1.1.2. Perform unit testing
              1.3.4.1.1.3. Perform integration testing
              1.3.4.1.1.4. Perform acceptance testing
                  1.3.4.1.1.4.1. Perform load testing (if needed)
                  1.3.4.1.1.4.2. Perform connectivity testing (if needed)
              1.3.4.1.1.5. Obtain signoff from the testing team and end users
              1.3.4.1.1.6. Note and communicate the customizations needed
              1.3.4.1.1.7. Signoff test plan for vendor
         1.3.4.1.2. Mobile frontend testing
              1.3.4.1.2.1. Verify design and functionality
              1.3.4.1.2.2. Perform unit testing
              1.3.4.1.2.3. Perform integration testing
              1.3.4.1.2.4. Perform acceptance testing
                  1.3.4.1.2.4.1. Perform load testing (if needed)
                  1.3.4.1.2.4.2. Perform connectivity testing (if needed)
              1.3.4.1.2.5. Obtain signoff from the testing team and end users
              1.3.4.1.2.6. Note and communicate the customizations needed
              1.3.4.1.2.7. Signoff test plan for vendor
    1.3.4.2. SQL database testing
         1.3.4.2.1. Verify design/ data elements
         1.3.4.2.2. Verify the relationships
         1.3.4.2.3. Perform integration testing
         1.3.4.2.4. Perform User acceptance testing
              1.3.4.2.4.1. Acceptance testing in terms of load
              1.3.4.2.4.2. Acceptance testing in terms of integrity etc
         1.3.4.2.5. Obtain user signoff
    1.3.4.3. Interface
                                                                                        Page18

         1.3.4.3.1. Verify design and functionality
1.3.4.3.2. Perform Integration Testing
            1.3.4.3.3. Perform User Acceptance Testing
            1.3.4.3.4. Obtain signoff from the testing team and end users
            1.3.4.3.5. Note and communicate the customizations needed
            1.3.4.3.6. Signoff test plan for vendor
       1.3.4.4. Reports
            1.3.4.4.1. Verify design and functionality
            1.3.4.4.2. Perform Integration test
            1.3.4.4.3. Perform User Acceptance Testing
            1.3.4.4.4. Obtain signoff from the testing team and end users
            1.3.4.4.5. Note and communicate the customizations needed
            1.3.4.4.6. Signoff test plan for vendor
1.4. Test runs (TAVARI PVT. LTD)
   1.4.1. Create system documentation
       1.4.1.1. Assemble functional specification document
       1.4.1.2. Assemble technical specification documents
       1.4.1.3. Develop system flowcharts
       1.4.1.4. Make proper documentation for the source code (in form of comments etc)
       1.4.1.5. Deliver the source code
       1.4.1.6. Complete system documentation manual
       1.4.1.7. Get the document created by respective user and technical expert
       1.4.1.8. Rework and baseline the changes that are suggested in system manual
   1.4.2. Create test run materials
       1.4.2.1. Assemble functional specifications
       1.4.2.2. Develop “As Is” and “To be” documentations
       1.4.2.3. Update business process
            1.4.2.3.1. Write new business process
            1.4.2.3.2. Obtain user signoff
       1.4.2.4. Complete system documentation manual
       1.4.2.5. Get the document created by respective user and technical expert
       1.4.2.6. Rework and baseline the changes that are suggested in system manual
1.5. Project closure (TAVARI PVT. LTD)
   1.5.1. Closure of project
   1.5.2. Closure of contract with the vendor
   1.5.3. Final project backup
   1.5.4. Project review and lessons learnt documented
   1.5.5. Final project signoff
                                                                                          Page19

1.6. Post project (TAVARI PVT. LTD)
1.6.1. Post project maintenance
    1.6.1.1. Verify the project functionality
    1.6.1.2. Verify the acceptance functionality
1.6.2. Regular update/ patches
    1.6.2.1. Verify the project versions of software update
    1.6.2.2. Check and update the software installed
    1.6.2.3. Make changes and update the software
    1.6.2.4. Make required changes to custom code (if necessary) for each update of the software

                                                                                                   Page20
Detail schedule for implementation of dart
project
The timeline for the project and present completion status of the project is as follows:

 Serial No   Task Name             Start Date End Date Days Prev. Task % done Assigned To
             Design of web         08/16/11    08/23/11           6                        100%   debashish bagg
             application
        1    Interface
                Front End          08/16/11    08/17/11           2                        100%
             Interface
        2    specification
                SQL Database       08/18/11    08/19/11           2   2                    100%
        3    specification
        4       Interfaces         08/18/11    08/22/11           3   2, 3FF               100%
        5       Reports            08/23/11    08/23/11           1   2, 4FF +1 day        100%
        6    Procurement           08/26/11    10/27/11          45                         60%   abhinav kamal
                Planning           08/26/11    08/26/11           1   1FS +2 days          100%
        7    software needs
                Float the design   08/29/11    08/31/11           3   7                    100%
             specification to
             respective
        8    software vendors
                Get quotation      09/01/11    09/05/11           3   8FF +3 days          100%
             from software
        9    providers
                Compare the        09/06/11    09/06/11         0.5   9                    100%
       10    quotations
                Take an            09/07/11    09/07/11         0.5   10                   100%
             decision of which
             vendor to be
       11    accepted
       12       vendor visit       09/08/11    09/08/11           1   11                   100%
                Communicate        09/09/11    10/27/11          35   11FS +1 day           50%
             to get the software
             on board and start
             with
       13    customization
       14    Customization         11/01/11    11/03/11           3                               debashish bagg
                Installation of    11/01/11    11/01/11           1   6FS +2 days
       15    software
                Initial testing    11/02/11    11/02/11         1.5   15
             and validation of
             the software and
       16    its features
                Implement the      11/03/11    11/03/11         1.5   16
             required
       17    customization
                Final testing      11/02/11    11/03/11           2   17FF
                                                                                                                   Page21

       18    and validation of
the software and
     its features
19   Test runs            08/24/11   09/09/11   13                   100%   abhinav Kamal
        Create system     08/24/11   08/30/11    5    1              100%
20   documentation
        Create test run   09/05/11   09/09/11    5    20FS +3 days   100%
21   materials
22   Project closure      11/04/11   11/10/11    5                          debashish bagg
        Closure of        11/04/11   11/04/11    1    14
23   project
        Closure of        11/07/11   11/08/11    2    23
     contract with the
24   vendor
        Final project     11/04/11   11/07/11    2    18
25   backup
        Project review    11/09/11   11/09/11   1.5   24, 25
     and lessons learn
26   documented
        Final project     11/10/11   11/10/11    1    26
27   signoff
28   Post project         11/11/11   11/11/11    1                          abhinav kamal
        Post project      11/11/11   11/11/11    1    22
29   maintenance
        Regular update/
30   patches

                                                                                             Page22
Software Project Management   Final Project Report

                                                     23
                                                     Page
Software Project Management                 Final Project Report

Human Resource Allocation Plan
Roles and Responsibilities
        The roles and responsibilities for the Software Upgrade Project are essential to project success. All
team members must clearly understand their roles and responsibilities in order to successfully perform their
portion of the project. For the Software Upgrade Project the following project team roles and responsibilities
have been established:

Project Manager (PM) (1 position):
        PM is responsible for the overall success of the Software DART Project. The PM must authorize
and approve all project expenditures. The PM is also responsible for approving that work activities meet
established acceptability criteria and fall within acceptable variances. The PM will be responsible for
reporting project status in accordance with the communications management plan. The PM will evaluate the
performance of all project team members and communicate their performance to functional managers. The
PM is also responsible for acquiring human resources for the project through coordination with functional
managers. The PM must possess the following skills: leadership/management, budgeting, scheduling, and
effective communication.

Design Engineer (DE) (1 position):
        DE is responsible for gathering coding requirements for the Software DART Project. The DE is
responsible for all upgrade design, coding, and testing of the upgraded software. The DEs will assist the
implementation lead in the distribution and monitoring of the software upgrades throughout the network
infrastructure.   The DE will be responsible for timely status reporting to the PM as required by the
communications management plan. The DEs may not authorize any project expenditures nor allocate any
resources without PM approval.

Implementation Manager (IM) (1 position):
        The IM is responsible for the distribution, implementation, and monitoring of the new software
upgrade. The IM is responsible for working with the DE to ensure all coding on new software conforms
with organizational security regulations. The IM is responsible for coordination outage windows with each
department to facilitate the rollout of the software upgrades with minimal/no disturbance to operations. The
                                                                                                                 24

IM will report status to the PM in accordance with the project‟s communications management plan.
                                                                                                                 Page
The following RACI chart shows the relationship between project tasks and team members. Any
proposed changes to project responsibilities must be reviewed and approved by the project manager.
Changes will be proposed in accordance with the project‟s change control process. As changes are made all
project documents will be updated and redistributed accordingly.

                                             Project Manager Design Engineers Implementation Manager

       Design of web application Interface   A               R                R

       Procurement/ Outsourcing              A               R                C

       Customization                         A               R

       Software Testing                      A               R                C

       Implementation                        A               C                R

       Project Closure                       A               A                C

       Post closure Activities               A               A                I

Key:

R – Responsible for completing the work

A – Accountable for ensuring task completion/sign off

C – Consulted before any decisions are made

I – Informed of when an action/decision has been made

                                                                                                            Page25
Risk Management
         There may several risks involved during or after the completion of this project. Those risks need to
be identified and managed in order to make the project a success.

Risk Identification
         Risk associated with this project can be categorized under following four heads:

         People risk:

             o   Risk 1: Acceptance from the customers for whom the application is being designed and
                 implemented in the first place

             o   Risk 2: Finding appropriate coders for coding the back-end functions to be performed by the
                 system.

             o   Risk 3: Lack of inputs from the team members during the planning, execution and
                 implementation of the project

         Technological risk:

             o   Risk 4: Technical glitches faced by users while taking the test

             o   Risk 5: Providing appropriate results to application user

             o   Risk 6: Migration of platform from facebook to other if the target customer moves on

         Financial and Time risk:

             o   Risk 7: Completing the project within the budget

             o   Risk 8: Completing the project within allocated timeline

         Other risk:

             o   Risk 9: Realizing the required MOV for the SHAMIANA‟s investment

Qualitative Risk Analysis
The above-identified risks have to prioritized, so that appropriate actions can be taken in case of occurrence
of those risks.

                        Probability   Low              Medium                      High
Impact

Low                                   Risk 5           Risk 7, Risk 8              Risk 2, Risk 3
                                                                                                                 Page26
Medium                             Risk 9            Risk 4

High                                                 Risk 1, Risk 6

List of Prioritized Risks:
Ranking      Potential Risk

1            Acceptance from the customers for whom the application is being designed and
             implemented in the first place

2            Migration of platform from facebook to other if the target customer moves on

3            Technical glitches faced by users while taking the test

4            Finding appropriate coders for coding the back-end functions to be performed by the
             system

5            Completion of the project with in allocated timeline

6            Completing the project within the budget

7            Migration of platform from facebook to other if the target customer moves on

8            Realizing the required MOV for the Institute‟s investment

9            Providing appropriate results to application user

Risk Response Planning
In order to manage the risks the following strategies and actions can be performed:

Risk                               Strategy          Action

Acceptance from the customers      Risk              There has to be a specific research that has been
                                   Mitigation        done to actually zero down to a set of game that
                                                     would be developed. This part is taken by
                                                     SHAMIANA.

Appropriate results                Risk              Through testing each module
                                   Avoidance

Technical glitches                 Risk              Use familiar hardware, and software available
                                   Avoidance
                                                                                                         Page27

Finding appropriate coders         Risk              Approach the familiar coders or coders whose
Mitigation       work is known.

Time and cost constraints         Risk             Follow the WBS strictly and keep some slack for
                                  Mitigation       the coding part,

                                                   For cost also estimation is done on task and
                                                   functional point basis .

Realizing the required MOV        Risk             Promote the application as in ways possible
                                  Transference

Risk Monitoring and Control
       The project team should be at all times aware of any of the above-identified risks and should follow
the actions as stated in the previous table. In addition, the team should keep an open mind and keep
identifying any other risks while the execution and or implementation phase of this project. For the newly
identified risks, the team members should follow the complete risk management process.

                                                                                                              Page28

Shamiyana project

  • 1.
    SHAMIANA Project SoftwareProject Management Project Abhinav Kamal 2010007 Debashish Bagg 2010298 Under the guidance of Prof. H. Halve Page1
  • 2.
    Table of Contents Tableof Contents ............................................................................................................................................... 2 Business Case..................................................................................................................................................... 4 Introduction .................................................................................................................................................... 4 Business Objective ......................................................................................................................................... 4 Current Situation and Problem/ opportunity statement .................................................................................. 4 Critical Assumption and Constraints ............................................................................................................. 5 Analysis of Options and Recommendations .................................................................................................. 5 Preliminary project requirements ................................................................................................................... 6 Budget estimates and financial analysis......................................................................................................... 6 Schedule estimates ......................................................................................................................................... 7 Potential risks ................................................................................................................................................. 7 Project Charter ................................................................................................................................................... 8 Project Title:................................................................................................................................................... 8 Start Date: Aug 15th, 2011.............................................................................................................................. 8 Projected Finish Date: .................................................................................................................................... 8 Budget Information ........................................................................................................................................ 8 Project Manager ............................................................................................................................................. 8 Project Objectives: ......................................................................................................................................... 8 Approach:....................................................................................................................................................... 8 Roles and responsibilities: ............................................................................................................................. 9 Project Scope Statement .................................................................................................................................... 9 Project Justification........................................................................................................................................ 9 Project characteristics and Requirements: ..................................................................................................... 9 Project management related deliverables:.................................................................................................... 10 Project Success Criteria ............................................................................................................................... 10 Financial Analysis of the Project ..................................................................................................................... 11 WBS for dart project ........................................................................................................................................ 13 Detail schedule for implementation of dart project.......................................................................................... 21 Human Resource Allocation Plan .................................................................................................................... 24 Roles and Responsibilities ........................................................................................................................... 24 Page2 Project Manager (PM) (1 position): ............................................................................................................. 24
  • 3.
    Design Engineer (DE)(1 position): ............................................................................................................. 24 Implementation Manager (IM) (1 position): ................................................................................................ 24 Risk Management ............................................................................................................................................ 26 Risk Identification........................................................................................................................................ 26 Qualitative Risk Analysis ............................................................................................................................ 26 List of Prioritized Risks: .............................................................................................................................. 27 Risk Response Planning ............................................................................................................................... 27 Risk Monitoring and Control ....................................................................................................................... 28 Page3
  • 4.
    Business Case Introduction SHAMIANA – The Short Film Club is a part of „Two Plus Productions‟ has been in the forefront in the business of short film exhibition and distribution for the last nine years and is now actively producing short films. SHAMIANA is a very unique initiative that has gathered a huge following for itself in a short span. With over 3 million people (and growing) across various countries following the club, it‟s soon becoming into a cult. They are into business of screening some of the best award-winning short films ever produced including Oscar winners, National Award winners, Golden Globe winners, Cannes winners, Berlinale winners, etc. They have showcased approximately 1000 films in the last 3 years. SHAMIANA is on its way to becoming the biggest brand in the alternative space of short films and with the way the film club has taken off in the last ONE YEAR (reaching out to over 3 million across the country). SHAMIANA has already attracted some powerful associations like, MICROMAX MOBILES, ZYDUS WELLNESS, CLEARTRIP.COM, and other tie-ups across the country including Times Card, Radio Mirchi, etc. Business Objective SHAMIANA has been growing for the last few years phenomenally. To expand its reach and imprint its existence in the essence of customers SHAMIANA has to take leaps into the business of marketing itself which it has not done so actively. SHAMIANA has been active on the front of marketing through its facebook page and its own webpage. To actively involve customers who visit its web pages SHAMIANA looks to create a few web based gamming applications. A few though of applications were developing of a web based Dart application or in animated movie application that would captivate the customer‟s application and also allow the spread the knowhow of SHAMIANA to other friend and users connected to present customer on facebook. Facebook is chose to be the base of launch of this application as its perceived to be most cheapest and booming platform to communicate with customers from the point of view of SHAMIANA. Current Situation and Problem/ opportunity statement With the advent of information technology and world moving to a internet dependent communication platform there has been many web based marketing platform that has been available in the market today. Facebook is one of the communication platforms for marketing. Page4
  • 5.
    SHAMIANA is oneof the initiatives that have a very short reach of 9 cities in the whole country. There cities span Delhi, Bangalore, Mumbai, Ahmadabad, Pune, Baroda, Goa etc. Each of these expansion and knowhow lets SHAMIANA to expand to a new customer base and hence to a different territory of customers and hence allowing growth in number of customers. SHAMIANA has found that facebook a very ardent platform of communicating and captivating the customer‟s attention. This project if successful would provide a gamut of benefits as follows: 1. Free promotion: This application if successful would help in achieving free promotion. 2. Exponential spread of knowledge about the firm: As the application is basically targeted to be launched on facebook as a platform, with the help of data sharing features that facebook allows it can be easily passed on to from one friend to another and hence improve the overall knowledge about SHAMIANA. 3. Market survey: This if successful would also help in launching different region based market survey such that it can be expanded into different geographic location across the country. 4. Easily accessible. 5. Increase of visibility of SHAMIANA 6. Customer engagement: These applications will allow to have a direct engagement of customer. Critical Assumption and Constraints The proposed dart application must be a valuable asset for SHAMIANA in terms of increasing its visibility and reach into customer base. It also needs to be able to perform customer engagement on a positive note. It should not adversely affect the customer base in terms of depleting the existing base of its customers. The most deathly constraint that SHAMIANA faces being only 3 years old is that of financing the present development. The funds that has been allocated by SHAMIANA for the current development is 50,000 INR. Analysis of Options and Recommendations There are three options for addressing this opportunity: 1. Do nothing. SHAMIANA is doing well, and might be able to continue to operate without this new project. The rate at which number of customers has been growing is phenomenon at the present stage. This project is based on the fact that facebook is a vast platform of promotional activity and helps to rope in new customers if they are made to be involved into some application. (i.e. the application on facebook are easy ways to rope in the customer involvement) Page5
  • 6.
    2. Purchase ofexternal software: There are many off shelf facebook and flash application like angry birds and lord of Ultimatum etc. that are available for free and some for a minimal cost. But SHAMIANA‟s motto to build application is not only to get customers involved with it but to drag them into knowing and getting involved with SHAMIANA as a whole. So these off shelf application either will not help or will need to be highly customized to suit for the same. 3. Design and implement by Vendor: The new intranet based application could be outsourced to an external vendor who would then code and develop the front end of the project. Hardware required for the project would be outsourced initially to some server hosting client. In accordance to the changes in the future scenario of success of the software these might be a server buying decision. Based on discussions with SHAMIANA, we believe that option 3 is the best option to work on though the costing seems to be on a bit higher end. Preliminary project requirements The main features of the facebook based application include the following: 1. Eye catching graphics to catch customer‟s attention immediately. 2. Allow upload of photograph or brown photo on web to serve as the basis of Dart application developed. 3. Application needs to be easy and light to be loaded on computer with basic requirement. 4. Also needs to have records and display personalized records on global basis. Budget estimates and financial analysis Actual heading Cost Estimation Cost of leasing hardware 5000-6000 INR /annum Cost of code development 20,000-25,000 INR Cost of front end development 25,000 INR Maintenance cost 2000 INR/ month The project has a potential to fetch in customer from varied background and varied taste and preferences. Hence the amount of intangible branding that the application can develop is huge. In terms of adding the number of customers on an average of 400/ month and if the conversion of customers on facebook to real life is approximately 10% that gives be 40 customs/ month. i.e. approximately 500 customers per year that is a huge potential of growth. All these values are just data that are found from a Page6
  • 7.
    survey that iscirculated internal in many Google and facebook group and hence the data could be higher than denoted value. Schedule estimates Activity Time estimates Requirement estimation and analysis 10 days Estimate of Flash ware preparation 20 days +5 days Estimate of coding and implementation 30 days + 10 days Hard ware deal finalizing 10 days Final testing and go live 10 days +5 days Total 50 days + 10 days The project on rough estimates seems to be completed in a span of two months but the client had a requirement of completing it in a month that seems infeasible on the face. Potential risks There are several risks involved with this project. The foremost risk is moving of customer base away from facebook. There could be technology advancement in the domain of internet web based application that may make developed application obsolete and un-acceptable to the web browser. The main business risk is investing the time and money into this project and not realizing the projected organizational wise benefits. Page7
  • 8.
    Project Charter Project Title: Dart application for SHAMIANA Start Date: Aug 15th, 2011. Projected Finish Date: Initial launch of this project is going to be within 2 months of start date. Budget Information The organization needs to allocate 50,000 INR for this project. The majority of costs for this project will be payment to vendors developing different parts of the project. The amount mentioned above does not include cost like server space leasing cost and also regular maintenance and update cost. An initial estimate provides a total of 60 days of work will be needed for completion of the project. Project Manager Debashish Bagg and Abhinav Kamal will share this responsibility. Project Objectives: Develop a new facebook based / web based application that would help customers to connect to the work done by SHAMIANA more effectively. The web application will be a basic dart on to which you can upload specific photos or browse from friends thus playing a interactive application that involves the customer. It also has potential of capturing the customer responses that would give ques about continuing or scraping the present application development going further. Approach: 1. Develop a survey to determine critical features of the web based dart that needs to be developed and the respective application linkages that are needed. 2. Research software to provide features needed along with the hardware that would support the same. 3. Develop a dart application soliciting a great deal of user feedback 4. Determine a way to measure the value of application and the value that is added by the application to SHAMIANA. Page8
  • 9.
    Roles and responsibilities: Name Role Position Contact Information Debashish Bagg Project Manager Debashish. bagg@gmail.com Abhinav Kamal Project Manager abhinav.kamal@gmail.com Project Scope Statement Project Justification SHAMIANA, requested this project to assist the company in meeting its marketing and hence its growth goals. The new web based application will increase visibility of the company‟s expertise to current and potential customers though increased involvement of customer with application of SHAMIANA page. It will also help improve visibility and customer involvement hence spreading of customer base. The budget for the project is 50,000 INR and will be deployed to software development by the external vendor. Estimated benefits are at least additional 500 customers each year. Project characteristics and Requirements: 1. Photos and dart background upload: The application needs to allow uploading photos or browsing through friend‟s photos to fix dart background. 2. User submissions: Users submissions and their scores needs to be recorded by the program and needs to be globally available. 3. Requests for articles: The application needs to be able to post the recent happenings on the customers page so as to attract other non customers get attached to the application and hence to SHAMIANA as a whole. 4. The “Refer to a friend” feature must be user-friendly and capable of soliciting user to forward the application link to his/ her friends in a proper format. This should also be able to show friend circle wise highest to inculcate high level of involvement among people/ customers. 5. Security: The application must not breach the internal security provided by facebook. It also needs to ensure that there is a proper security that the data in the application is not leaked unless intended by the user itself. 6. The intranet site must be light in terms of coding and hence be available on a basic web browser than asking for a heavier processing at the client side.. Page9
  • 10.
    Project management relateddeliverables: Business case, charter, scope statement, WBS, schedule, cost baseline, final project presentation, lessons-learned report, and any other documents required to manage the project. Project Success Criteria Our goal is to complete this project within two months for no more than INR 50,000. The project sponsor, SHAMIANA, has emphasized the importance of the project paying for itself within one year after the web application is complete. To meet this marketing goal, the web application must have strong user inputs. We must also develop a method for capturing the benefits while the web application is being developed, tested, and after it is rolled out. If the project takes a little longer to complete or costs a little more than planned, the firm will still view it as a success if it has a good payback and helps promote the firm‟s image and draw the increased number of audience as its the goal of the application. Page10
  • 11.
    Financial Analysis ofthe Project Following template is utilized to calculate the estimation of human resources as per function point analysis and data generate is as below. SUMMARY Project Identification Customer Name SHAMIANA Dart application for Project Name SHAMIANA Project Code Analyst Debashish Bagg Date Summary Estimates Unadjusted Function Point Count 28 From FP worksheet Processing Complexity Adjustment Factor 1.22 From PCA worksheet Adjusted Function Point Count (AFP) 34 Calculated: (FP*PCA) Calibration Factor (CF) 1 See note Total Function Point Measure (TFP) 34 Calculated: (AFP*CF) Delivery Rate (DR) in FPs/person month 1 See note Days per person-month (DPM) 4 See note High Level Effort Estimate (in person-days) 137 Calculated: (TFP/DR) * DPM The above summary can be further detailed in the following tables. INTERNAL LOGICAL FILES (ILFs) # of # of Complexity List of files DETs RETs Low Average High Notes and Assumptions Data file storing scores 2 5 1 0 0 global counter Summary 1 0 0 EXTERNAL INTERFACE FILES (EIFs) # of # of Complexity List of files DETs RETs Low Average High Notes and Assumptions interface to webpage 2 1 1 0 0 help files 1 1 1 0 0 Summary 2 0 0 Page11
  • 12.
    EXTERNAL INPUTS (EIs) # of # of Complexity List of inputs DETs FTRs Low Average High Notes and Assumptions User name 2 1 1 0 0 User friend list 1 30 0 1 0 Tagged Summary 1 1 0 UNADJUSTED FUNCTION POINT COUNT (FP) Function Type Functional Complexity Count Weight Function Points (FPs) FP % Internal Logical Files (ILFs) Low 1 7 7 Average 0 10 0 High 0 15 0 25% External Interface Files (EIFs) Low 2 5 10 Average 0 7 0 High 0 10 0 36% External Inputs (EIs) Low 1 3 3 Average 1 4 4 High 0 6 0 25% External Outputs (EOs) Low 1 4 4 Average 0 5 0 High 0 7 0 14% External Queries (EQs) Low 0 3 0 Average 0 4 0 High 0 6 0 0% Total Unadjusted Function Point Count 28 100% VALUE ADJUSTMENT FACTOR (VAF) Degree of General Systems Characteristics Description Influence (0-5) 1. Data Communications 5 The application is online 2. Distributed Processing 4 It has to be distributed calculation 3. Performance 3 Heavily Used 4. Configuration 3 5. Transaction Rates 4 6. Online Data Entry 5 Design for End User Page12 7. Efficiency 4 8. Online Update 5 update is online
  • 13.
    9. Complex Processing 4 average on processing complexity Usable in Other has to be reusable to be moved to other 10. Applications 4 coding if needed 11. Installation Ease 3 12. Operational Ease 4 13. Multiple Sites 5 on website and facebook 14. Facilitate Change 4 needs to allow change Total Degree of Influence (TDI) 57 Calculated (sum of the above) Value Adjustment Factor (VAF) 1.22 Calculated ((TDI*0.01)+0.65) WBS for dart project 1. Dart project 1.1. Design of web application Interface (MAAC) 1.1.1. Interface specification 1.1.1.1. Functional specification 1.1.1.1.1. Interface for web browser 1.1.1.1.1.1. Create mock interface for web browser 1.1.1.1.1.2. Conduct design review internal to the team 1.1.1.1.1.3. Get design reviewed by stakeholders 1.1.1.1.1.3.1. Get design reviewed by mock users 1.1.1.1.1.4. Take consensus for the design 1.1.1.1.1.5. Create a final functional specification 1.1.1.1.1.6. Obtain individual signoff 1.1.1.1.2. Interface for mobile browser (can run simultaneously with 1.1.1.1.1) 1.1.1.1.2.1. Create mock interface for web browser 1.1.1.1.2.2. Conduct design review internal to the team 1.1.1.1.2.3. Get design reviewed by stakeholders 1.1.1.1.2.3.1. Get design reviewed by mock users 1.1.1.1.2.4. Take consensus for the design 1.1.1.1.2.5. Create a final functional specification 1.1.1.1.2.6. Obtain individual signoff 1.1.1.1.2.6.1. Signoff for interface from SHAMIANA representative body and mock users 1.1.1.2. Technical specifications (TAVARI PVT. LTD) 1.1.1.2.1. Develop the technical specifications based on the previous signoff document 1.1.1.2.2. Review the technical specifications Page13 1.1.1.2.3. Obtain signoff from respective stakeholders 1.1.1.2.3.1. Signoff of the SHAMIANA representation
  • 14.
    1.1.1.2.3.2. Signoff ofmock users if required 1.1.2. SQL Database specification (TAVARI PVT. LTD) 1.1.2.1. Develop technical specifications 1.1.2.2. Review technical specifications 1.1.2.2.1. Review by the project team 1.1.2.3. Review by external expert (SHAMIANA ) 1.1.2.4. Rework technical specification 1.1.2.5. Obtain team signoff 1.1.2.5.1. Obtain signoff of the project team 1.1.2.6. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA ) 1.1.3. Interfaces (TAVARI PVT. LTD) 1.1.3.1. Technical specifications 1.1.3.1.1. Determine data import/ export elements 1.1.3.1.2. Design Interface 1.1.3.1.3. Obtain signoff of the respective stakeholders 1.1.3.1.3.1. Obtain signoff of the project team 1.1.3.2. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA ) 1.1.4. Reports (TAVARI PVT. LTD) 1.1.4.1. Functional specification report 1.1.4.1.1. Collect user requirement data 1.1.4.1.1.1. Define data elements 1.1.4.1.1.1.1. Define null or initial values if any on the screen 1.1.4.1.1.1.2. Define relative values for users i.e. any history to be maintained 1.1.4.1.1.2. Define frequency of use 1.1.4.1.1.3. Define sessions 1.1.4.1.2. Design reports 1.1.4.1.2.1. Design and develop the functional specifications 1.1.4.1.2.2. Document relationship/ flow from functional specification to technical specification 1.1.4.1.2.3. Design and develop the detailed design document 1.1.4.1.2.4. Flow from detailed design specification to test plans 1.1.4.1.2.5. Design and develop the initial testing plan 1.1.4.1.2.6. Design and develop the integration testing plan 1.1.4.1.3. Deliver the acceptance testing plan 1.1.4.1.4. Review report design with project team 1.1.4.1.5. Deliver final functional specifications Page14 1.1.4.1.5.1. Deliver the functional specifications
  • 15.
    1.1.4.1.5.2. Deliver thedetailed design document 1.1.4.1.5.3. Deliver the initial testing plan 1.1.4.1.5.4. Deliver the integration testing plan 1.1.4.1.5.5. Deliver the acceptance testing plan 1.1.4.1.6. Obtain signoff of the respective stakeholders 1.1.4.1.6.1. Obtain signoff of the project team 1.1.4.2. Obtain signoff of the external expert if he is a stakeholder (SHAMIANA ) 1.1.4.2.1.1. 1.2. Procurement (TAVARI PVT. LTD) 1.2.1. Planning software needs 1.2.1.1. Determine software needs 1.2.1.2. Make software selection 1.2.2. Float the design specification to respective software vendors 1.2.2.1. Float above technical specification development 1.2.3. Get quotation from software providers 1.2.4. Compare the quotations 1.2.4.1. Compare the quotation price 1.2.4.2. Compare vendor history 1.2.4.3. Compare add on features if any 1.2.4.4. Compare the comparability and customization requirement 1.2.4.5. Compare the software provided on basis of relative ease of maintenance cost 1.2.5. Take an decision of which vendor to be accepted 1.2.6. vendor visit 1.2.6.1. Discuss with the vendor to avoid any communication gap in the specification 1.2.6.2. Discuss the broad aspects of the project 1.2.6.3. Finalize the vendor contact and date of delivery. 1.2.6.4. If failed go to step 1.2.3 for next best vendor 1.2.7. Communicate to get the software on board and start with customization 1.2.7.1. Deadline communications and reporting 1.2.7.1.1. Check with the detailed design document for specification 1.2.7.1.2. Check with testing and reporting at each stage 1.2.7.2. Involve respective stakeholders in the decision process 1.2.7.3. If failed go to step 1.2.3 for next best vendor 1.3. Customization (TAVARI PVT. LTD) 1.3.1. Installation of software 1.3.1.1. Procure the soft ware 1.3.1.2. Install the software on the existing hardware Page15 1.3.2. Initial testing and validation of the software and its features
  • 16.
    1.3.2.1. Front endtesting 1.3.2.1.1. Browser front end testing 1.3.2.1.1.1. Verify design and functionality 1.3.2.1.1.2. Perform unit testing 1.3.2.1.1.3. Perform integration testing 1.3.2.1.1.4. Perform acceptance testing 1.3.2.1.1.4.1. Perform load testing (if needed) 1.3.2.1.1.4.2. Perform connectivity testing (if needed) 1.3.2.1.1.5. Obtain signoff from the testing team and end users 1.3.2.1.1.6. Note and communicate the customizations needed 1.3.2.1.1.7. Signoff test plan for vendor 1.3.2.1.2. Mobile frontend testing 1.3.2.1.2.1. Verify design and functionality 1.3.2.1.2.2. Perform unit testing 1.3.2.1.2.3. Perform integration testing 1.3.2.1.2.4. Perform acceptance testing 1.3.2.1.2.4.1. Perform load testing (if needed) 1.3.2.1.2.4.2. Perform connectivity testing (if needed) 1.3.2.1.2.5. Obtain signoff from the testing team and end users 1.3.2.1.2.6. Note and communicate the customizations needed 1.3.2.1.2.7. Signoff test plan for vendor 1.3.2.2. SQL database testing 1.3.2.2.1. Verify design/ data elements 1.3.2.2.2. Verify the relationships 1.3.2.2.3. Perform integration testing 1.3.2.2.4. Perform User acceptance testing 1.3.2.2.4.1. Acceptance testing in terms of load 1.3.2.2.4.2. Acceptance testing in terms of integrity etc 1.3.2.2.5. Obtain user signoff 1.3.2.3. Interface 1.3.2.3.1. Verify design and functionality 1.3.2.3.2. Perform Integration Testing 1.3.2.3.3. Perform User Acceptance Testing 1.3.2.3.4. Obtain signoff from the testing team and end users 1.3.2.3.5. Note and communicate the customizations needed 1.3.2.3.6. Signoff test plan for vendor 1.3.2.4. Reports Page16 1.3.2.4.1. Verify design and functionality
  • 17.
    1.3.2.4.2. Perform Integrationtest 1.3.2.4.3. Perform User Acceptance Testing 1.3.2.4.4. Obtain signoff from the testing team and end users 1.3.2.4.5. Note and communicate the customizations needed 1.3.2.4.6. Signoff test plan for vendor 1.3.3. Implement the required customization 1.3.3.1. Front End 1.3.3.1.1. Mock user front end 1.3.3.1.1.1. Customize Web pages 1.3.3.1.1.2. Conduct Unit testing 1.3.3.1.1.3. Review web page design and functionality 1.3.3.1.1.4. Get final user to test 1.3.3.1.1.5. Rework if needed for the same 1.3.3.1.2. Web front end 1.3.3.1.2.1. Customize Web pages 1.3.3.1.2.2. Conduct Unit testing 1.3.3.1.2.3. Review web page design and functionality 1.3.3.1.2.4. Get final user to test 1.3.3.1.2.5. Rework if needed for the same 1.3.3.1.3. Mobile front end 1.3.3.1.3.1. Customize Web pages 1.3.3.1.3.2. Conduct Unit testing 1.3.3.1.3.3. Review web page design and functionality 1.3.3.1.3.4. Get final user to test 1.3.3.1.3.5. Rework if needed for the same 1.3.3.2. SQL Database 1.3.3.2.1. Identify the customization in relationships of the tables 1.3.3.2.2. Build the database schemas 1.3.3.2.3. Build each data element if needed 1.3.3.2.4. Build database tables 1.3.3.2.5. Review tables with project team and external expert 1.3.3.3. Interface 1.3.3.3.1. Customize interfaces where ever needed 1.3.3.3.2. Conduct unit testing of import and export functionality 1.3.3.3.3. Sign off for interface customization 1.3.3.4. Reports 1.3.3.4.1. Code custom reports Page17 1.3.3.4.2. Test custom reports
  • 18.
    1.3.3.4.3. Review 1.3.3.4.3.1. Review the reports with required stakeholders if needed 1.3.3.4.3.2. Review the reports with project team 1.3.3.4.3.3. Rework if there are changes needed 1.3.3.4.4. Sign off custom reports development 1.3.3.5. Track customization at every stage through different reporting mechanism 1.3.4. Final testing and validation of the software and its features 1.3.4.1. Front end testing 1.3.4.1.1. Browser front end testing 1.3.4.1.1.1. Verify design and functionality 1.3.4.1.1.2. Perform unit testing 1.3.4.1.1.3. Perform integration testing 1.3.4.1.1.4. Perform acceptance testing 1.3.4.1.1.4.1. Perform load testing (if needed) 1.3.4.1.1.4.2. Perform connectivity testing (if needed) 1.3.4.1.1.5. Obtain signoff from the testing team and end users 1.3.4.1.1.6. Note and communicate the customizations needed 1.3.4.1.1.7. Signoff test plan for vendor 1.3.4.1.2. Mobile frontend testing 1.3.4.1.2.1. Verify design and functionality 1.3.4.1.2.2. Perform unit testing 1.3.4.1.2.3. Perform integration testing 1.3.4.1.2.4. Perform acceptance testing 1.3.4.1.2.4.1. Perform load testing (if needed) 1.3.4.1.2.4.2. Perform connectivity testing (if needed) 1.3.4.1.2.5. Obtain signoff from the testing team and end users 1.3.4.1.2.6. Note and communicate the customizations needed 1.3.4.1.2.7. Signoff test plan for vendor 1.3.4.2. SQL database testing 1.3.4.2.1. Verify design/ data elements 1.3.4.2.2. Verify the relationships 1.3.4.2.3. Perform integration testing 1.3.4.2.4. Perform User acceptance testing 1.3.4.2.4.1. Acceptance testing in terms of load 1.3.4.2.4.2. Acceptance testing in terms of integrity etc 1.3.4.2.5. Obtain user signoff 1.3.4.3. Interface Page18 1.3.4.3.1. Verify design and functionality
  • 19.
    1.3.4.3.2. Perform IntegrationTesting 1.3.4.3.3. Perform User Acceptance Testing 1.3.4.3.4. Obtain signoff from the testing team and end users 1.3.4.3.5. Note and communicate the customizations needed 1.3.4.3.6. Signoff test plan for vendor 1.3.4.4. Reports 1.3.4.4.1. Verify design and functionality 1.3.4.4.2. Perform Integration test 1.3.4.4.3. Perform User Acceptance Testing 1.3.4.4.4. Obtain signoff from the testing team and end users 1.3.4.4.5. Note and communicate the customizations needed 1.3.4.4.6. Signoff test plan for vendor 1.4. Test runs (TAVARI PVT. LTD) 1.4.1. Create system documentation 1.4.1.1. Assemble functional specification document 1.4.1.2. Assemble technical specification documents 1.4.1.3. Develop system flowcharts 1.4.1.4. Make proper documentation for the source code (in form of comments etc) 1.4.1.5. Deliver the source code 1.4.1.6. Complete system documentation manual 1.4.1.7. Get the document created by respective user and technical expert 1.4.1.8. Rework and baseline the changes that are suggested in system manual 1.4.2. Create test run materials 1.4.2.1. Assemble functional specifications 1.4.2.2. Develop “As Is” and “To be” documentations 1.4.2.3. Update business process 1.4.2.3.1. Write new business process 1.4.2.3.2. Obtain user signoff 1.4.2.4. Complete system documentation manual 1.4.2.5. Get the document created by respective user and technical expert 1.4.2.6. Rework and baseline the changes that are suggested in system manual 1.5. Project closure (TAVARI PVT. LTD) 1.5.1. Closure of project 1.5.2. Closure of contract with the vendor 1.5.3. Final project backup 1.5.4. Project review and lessons learnt documented 1.5.5. Final project signoff Page19 1.6. Post project (TAVARI PVT. LTD)
  • 20.
    1.6.1. Post projectmaintenance 1.6.1.1. Verify the project functionality 1.6.1.2. Verify the acceptance functionality 1.6.2. Regular update/ patches 1.6.2.1. Verify the project versions of software update 1.6.2.2. Check and update the software installed 1.6.2.3. Make changes and update the software 1.6.2.4. Make required changes to custom code (if necessary) for each update of the software Page20
  • 21.
    Detail schedule forimplementation of dart project The timeline for the project and present completion status of the project is as follows: Serial No Task Name Start Date End Date Days Prev. Task % done Assigned To Design of web 08/16/11 08/23/11 6 100% debashish bagg application 1 Interface Front End 08/16/11 08/17/11 2 100% Interface 2 specification SQL Database 08/18/11 08/19/11 2 2 100% 3 specification 4 Interfaces 08/18/11 08/22/11 3 2, 3FF 100% 5 Reports 08/23/11 08/23/11 1 2, 4FF +1 day 100% 6 Procurement 08/26/11 10/27/11 45 60% abhinav kamal Planning 08/26/11 08/26/11 1 1FS +2 days 100% 7 software needs Float the design 08/29/11 08/31/11 3 7 100% specification to respective 8 software vendors Get quotation 09/01/11 09/05/11 3 8FF +3 days 100% from software 9 providers Compare the 09/06/11 09/06/11 0.5 9 100% 10 quotations Take an 09/07/11 09/07/11 0.5 10 100% decision of which vendor to be 11 accepted 12 vendor visit 09/08/11 09/08/11 1 11 100% Communicate 09/09/11 10/27/11 35 11FS +1 day 50% to get the software on board and start with 13 customization 14 Customization 11/01/11 11/03/11 3 debashish bagg Installation of 11/01/11 11/01/11 1 6FS +2 days 15 software Initial testing 11/02/11 11/02/11 1.5 15 and validation of the software and 16 its features Implement the 11/03/11 11/03/11 1.5 16 required 17 customization Final testing 11/02/11 11/03/11 2 17FF Page21 18 and validation of
  • 22.
    the software and its features 19 Test runs 08/24/11 09/09/11 13 100% abhinav Kamal Create system 08/24/11 08/30/11 5 1 100% 20 documentation Create test run 09/05/11 09/09/11 5 20FS +3 days 100% 21 materials 22 Project closure 11/04/11 11/10/11 5 debashish bagg Closure of 11/04/11 11/04/11 1 14 23 project Closure of 11/07/11 11/08/11 2 23 contract with the 24 vendor Final project 11/04/11 11/07/11 2 18 25 backup Project review 11/09/11 11/09/11 1.5 24, 25 and lessons learn 26 documented Final project 11/10/11 11/10/11 1 26 27 signoff 28 Post project 11/11/11 11/11/11 1 abhinav kamal Post project 11/11/11 11/11/11 1 22 29 maintenance Regular update/ 30 patches Page22
  • 23.
    Software Project Management Final Project Report 23 Page
  • 24.
    Software Project Management Final Project Report Human Resource Allocation Plan Roles and Responsibilities The roles and responsibilities for the Software Upgrade Project are essential to project success. All team members must clearly understand their roles and responsibilities in order to successfully perform their portion of the project. For the Software Upgrade Project the following project team roles and responsibilities have been established: Project Manager (PM) (1 position): PM is responsible for the overall success of the Software DART Project. The PM must authorize and approve all project expenditures. The PM is also responsible for approving that work activities meet established acceptability criteria and fall within acceptable variances. The PM will be responsible for reporting project status in accordance with the communications management plan. The PM will evaluate the performance of all project team members and communicate their performance to functional managers. The PM is also responsible for acquiring human resources for the project through coordination with functional managers. The PM must possess the following skills: leadership/management, budgeting, scheduling, and effective communication. Design Engineer (DE) (1 position): DE is responsible for gathering coding requirements for the Software DART Project. The DE is responsible for all upgrade design, coding, and testing of the upgraded software. The DEs will assist the implementation lead in the distribution and monitoring of the software upgrades throughout the network infrastructure. The DE will be responsible for timely status reporting to the PM as required by the communications management plan. The DEs may not authorize any project expenditures nor allocate any resources without PM approval. Implementation Manager (IM) (1 position): The IM is responsible for the distribution, implementation, and monitoring of the new software upgrade. The IM is responsible for working with the DE to ensure all coding on new software conforms with organizational security regulations. The IM is responsible for coordination outage windows with each department to facilitate the rollout of the software upgrades with minimal/no disturbance to operations. The 24 IM will report status to the PM in accordance with the project‟s communications management plan. Page
  • 25.
    The following RACIchart shows the relationship between project tasks and team members. Any proposed changes to project responsibilities must be reviewed and approved by the project manager. Changes will be proposed in accordance with the project‟s change control process. As changes are made all project documents will be updated and redistributed accordingly. Project Manager Design Engineers Implementation Manager Design of web application Interface A R R Procurement/ Outsourcing A R C Customization A R Software Testing A R C Implementation A C R Project Closure A A C Post closure Activities A A I Key: R – Responsible for completing the work A – Accountable for ensuring task completion/sign off C – Consulted before any decisions are made I – Informed of when an action/decision has been made Page25
  • 26.
    Risk Management There may several risks involved during or after the completion of this project. Those risks need to be identified and managed in order to make the project a success. Risk Identification Risk associated with this project can be categorized under following four heads: People risk: o Risk 1: Acceptance from the customers for whom the application is being designed and implemented in the first place o Risk 2: Finding appropriate coders for coding the back-end functions to be performed by the system. o Risk 3: Lack of inputs from the team members during the planning, execution and implementation of the project Technological risk: o Risk 4: Technical glitches faced by users while taking the test o Risk 5: Providing appropriate results to application user o Risk 6: Migration of platform from facebook to other if the target customer moves on Financial and Time risk: o Risk 7: Completing the project within the budget o Risk 8: Completing the project within allocated timeline Other risk: o Risk 9: Realizing the required MOV for the SHAMIANA‟s investment Qualitative Risk Analysis The above-identified risks have to prioritized, so that appropriate actions can be taken in case of occurrence of those risks. Probability Low Medium High Impact Low Risk 5 Risk 7, Risk 8 Risk 2, Risk 3 Page26
  • 27.
    Medium Risk 9 Risk 4 High Risk 1, Risk 6 List of Prioritized Risks: Ranking Potential Risk 1 Acceptance from the customers for whom the application is being designed and implemented in the first place 2 Migration of platform from facebook to other if the target customer moves on 3 Technical glitches faced by users while taking the test 4 Finding appropriate coders for coding the back-end functions to be performed by the system 5 Completion of the project with in allocated timeline 6 Completing the project within the budget 7 Migration of platform from facebook to other if the target customer moves on 8 Realizing the required MOV for the Institute‟s investment 9 Providing appropriate results to application user Risk Response Planning In order to manage the risks the following strategies and actions can be performed: Risk Strategy Action Acceptance from the customers Risk There has to be a specific research that has been Mitigation done to actually zero down to a set of game that would be developed. This part is taken by SHAMIANA. Appropriate results Risk Through testing each module Avoidance Technical glitches Risk Use familiar hardware, and software available Avoidance Page27 Finding appropriate coders Risk Approach the familiar coders or coders whose
  • 28.
    Mitigation work is known. Time and cost constraints Risk Follow the WBS strictly and keep some slack for Mitigation the coding part, For cost also estimation is done on task and functional point basis . Realizing the required MOV Risk Promote the application as in ways possible Transference Risk Monitoring and Control The project team should be at all times aware of any of the above-identified risks and should follow the actions as stated in the previous table. In addition, the team should keep an open mind and keep identifying any other risks while the execution and or implementation phase of this project. For the newly identified risks, the team members should follow the complete risk management process. Page28
