Scrum@Scale with Hardware
Twice the value in half the time
5 June - Stuttgart, Germany
Paolo Sammicheli – Agile Business Coach

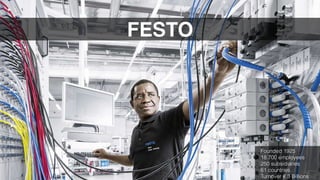

FESTO
Founded 1925
18.700 employees
250 subsidiaries
61 countries
Turnover € 3 Billions
source: http://auto.xprize.org/about/overview
courtesy: Joe Justice
courtesy: Joe Justice
source: http://www.wikispeed.org
courtesy: Joe Justice
Copyright: http://climateheroes.org
Copyright: http://climateheroes.org
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
courtesy: Joe Justice
The birth of a
Community
August 2016

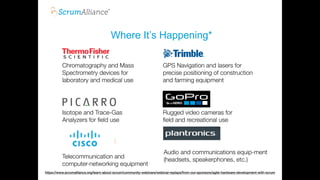

Where It’s Happening*
3
Chromatography and Mass
Spectrometry devices for
laboratory and medical use
GPS Navigation and lasers for
precise positioning of construction
and farming equipment
Isotope and Trace-Gas
Analyzers for field use
Rugged video cameras for
field and recreational use
Telecommunication and
computer-networking equipment
Audio and communications equip-ment
(headsets, speakerphones, etc.)
https://www.scrumalliance.org/learn-about-scrum/community-webinars/webinar-replays/from-our-sponsors/agile-hardware-development-with-scrum
https://www.youtube.com/watch?v=Ws828wk_NDA
GLOBAL SCRUM GATHERING: HARDWARE TRACK
Linköping 24 April 2017

$168 billion over budget, delayed until 2022.
Cost of Navy F-35C grew from $273 million
to $337 million in 1 year.
Source: ScrumInc, Agile in Military Hardware: https://www.scruminc.com/scrum-military-aviation/
https://www.scruminc.com/wp-content/uploads/2015/09/Release-version_Owning-the-Sky-with-Agile.pdf
“How DOD’s $1.5 Trillion F-35 Broke the Air
Force” -FiscalTimes July 2014
“we are presently taking the newest
strategic foundation and analyzing whether
2,443 aircraft is the correct number” Marine
Corps Gen. Joseph Dunford, July 2015
“$30 billion per year is needed to end world
hunger”. https://borgenproject.org/the-
cost-to-end-world-hunger/
1,5 Trillion would be enough to end world
hunger for 50 years!
“The Gripen is the world’s most cost-
effective military aircraft “- Jane’s
Aviation Weekly
“Saab's Gripen E fighter to take on the
F-35: Jet travels at 1,522 mph with
improved sensors, weaponry and range
(and unlike its competitor, it works)” -
http://www.dailymail.co.uk
Gripen operational cost lowest of all
w e s t e r n f i g h t e r s . h t t p : / /
www.stratpost.com
F-35
Cumulative program cost of $15 billion
One airplane costs 43M1 (20% of F-35)
Delivered on time.
JAS 39 GRIPEN

Scrum for Hardware - The Book
Discover the SCRUM for HARDWARE pioneers:
from Wikispeed to the first Scrum for
Hardware Gathering, the Agile Product
Charter and Scrum@Scale. The book is
divided in two parts: the first one made of
stories which introduce the topic in an easy
way, the second one include the description of
the method, the underling values and
principles, the engineering practices, case
studies and many practical examples on how
to adopt it in your company. In the Appendix
you'll find the Scrum and Scrum@Scale guides
and the description of Cynefin and
PopcornFlow. Foreword by Joe Justice.
https://leanpub.com/Scrum-for-Hardware/c/scrumday
Free download, until 30 June 2019
Scrum@Scale for Hardware
Case Study
Originally presented at Agile Business Day,
Venice Italy, 15 September 2018
by Paolo Sammicheli and Giorgio Audisio
VIMAR
Based in Marostica, Vicenza - Italy
1.300 employees
6% of turnover invested in R&D
More than 180 patents
200 Ml of pieces sold
12000 catalog parts
FROM
Eikon, Arké, Idea e Plana
TO
Home & Building automation
• To be able to develop complex functions following the
need of the market which continuously changes.
• To increase the motivation of the developers which see in
short time the results of their job.
• To attract the best engineers providing a modern and up to
date job environment where their skills and professionality
can grow.
Why Agile and Scrum?
Implementation

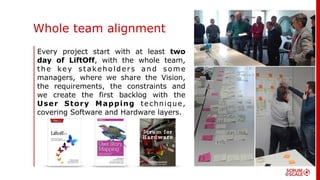

Every project start with at least two
day of LiftOff, with the whole team,
the key stakeholders and some
managers, where we share the Vision,
the requirements, the constraints and
we create the first backlog with the
User Story Mapping technique,
covering Software and Hardware layers.
Whole team alignment

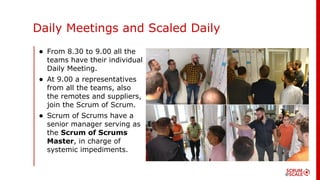

Daily Meetings and Scaled Daily
• From 8.30 to 9.00 all the
teams have their individual
Daily Meeting.
• At 9.00 a representatives
from all the teams, also
the remotes and suppliers,
join the Scrum of Scrum.
• Scrum of Scrums have a
senior manager serving as
the Scrum of Scrums
Master, in charge of
systemic impediments.

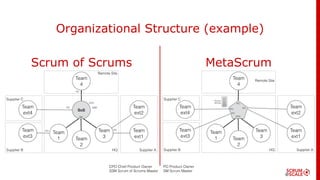

Organizational Structure (example)
MetaScrumScrum of Scrums
CPO Chief Product Owner
SSM Scrum of Scrums Master
PO Product Owner
SM Scrum Master
Product
Backlog

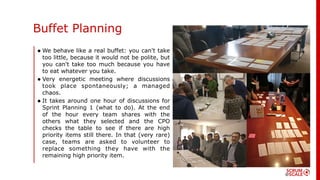

• We behave like a real buffet: you can't take
too little, because it would not be polite, but
you can't take too much because you have
to eat whatever you take.
• Very energetic meeting where discussions
took place spontaneously; a managed
chaos.
• It takes around one hour of discussions for
Sprint Planning 1 (what to do). At the end
of the hour every team shares with the
others what they selected and the CPO
checks the table to see if there are high
priority items still there. In that (very rare)
case, teams are asked to volunteer to
replace something they have with the
remaining high priority item.
Buffet Planning
Deployment / Review
• Teams have dedicated rooms
where integrate and test, very
often during the Sprint, the
products.
• These rooms usually are used also
for the Sprint Review, so they all
have projectors and foldable chairs
to accomodate guests.
• The different products are installed
in several movable panels. They
can also be taken into the team
room during the Sprint for
convenience.
Results

0,00
15,00
30,00
45,00
60,00
Sprint 1 Sprint 4 Sprint 7 Sprint 10 Sprint 13 Sprint 16 Sprint 19 Sprint 22 Sprint 25
Sprint 8 = 6 story points
Sprint 14 = 23 story points
Sprint 26 = 55 story points
In one Year: 9.16 times faster!
Cumulated Yesterday’s Weather of the HQ Teams
Benefits
•Quickest developments with
an increasing productivity.
•More alignment and
effectiveness.
•Higher motivation.

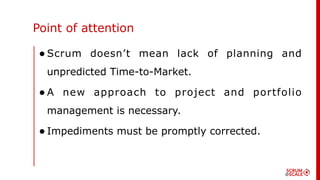

Point of attention
•Scrum doesn’t mean lack of planning and
unpredicted Time-to-Market.
•A new approach to project and portfolio
management is necessary.
•Impediments must be promptly corrected.
THANKS!
Free Copy: https://leanpub.com/Scrum-for-Hardware/c/scrumday
Until 30 Jun 2019

Scrum@Scale with Hardware

  • 1.
    Scrum@Scale with Hardware Twicethe value in half the time 5 June - Stuttgart, Germany
  • 2.
    Paolo Sammicheli –Agile Business Coach
  • 3.
    FESTO Founded 1925 18.700 employees 250subsidiaries 61 countries Turnover € 3 Billions
  • 5.
  • 6.
  • 7.
  • 8.
  • 9.
  • 10.
  • 11.
  • 12.
  • 13.
  • 14.
  • 15.
  • 16.
  • 17.
  • 18.
  • 20.
  • 21.
  • 28.
    The birth ofa Community
  • 29.
    August 2016 Where It’sHappening* 3 Chromatography and Mass Spectrometry devices for laboratory and medical use GPS Navigation and lasers for precise positioning of construction and farming equipment Isotope and Trace-Gas Analyzers for field use Rugged video cameras for field and recreational use Telecommunication and computer-networking equipment Audio and communications equip-ment (headsets, speakerphones, etc.) https://www.scrumalliance.org/learn-about-scrum/community-webinars/webinar-replays/from-our-sponsors/agile-hardware-development-with-scrum
  • 31.
  • 32.
  • 33.
  • 34.
    $168 billion overbudget, delayed until 2022. Cost of Navy F-35C grew from $273 million to $337 million in 1 year. Source: ScrumInc, Agile in Military Hardware: https://www.scruminc.com/scrum-military-aviation/ https://www.scruminc.com/wp-content/uploads/2015/09/Release-version_Owning-the-Sky-with-Agile.pdf “How DOD’s $1.5 Trillion F-35 Broke the Air Force” -FiscalTimes July 2014 “we are presently taking the newest strategic foundation and analyzing whether 2,443 aircraft is the correct number” Marine Corps Gen. Joseph Dunford, July 2015 “$30 billion per year is needed to end world hunger”. https://borgenproject.org/the- cost-to-end-world-hunger/ 1,5 Trillion would be enough to end world hunger for 50 years! “The Gripen is the world’s most cost- effective military aircraft “- Jane’s Aviation Weekly “Saab's Gripen E fighter to take on the F-35: Jet travels at 1,522 mph with improved sensors, weaponry and range (and unlike its competitor, it works)” - http://www.dailymail.co.uk Gripen operational cost lowest of all w e s t e r n f i g h t e r s . h t t p : / / www.stratpost.com F-35 Cumulative program cost of $15 billion One airplane costs 43M1 (20% of F-35) Delivered on time. JAS 39 GRIPEN
  • 35.
    Scrum for Hardware- The Book Discover the SCRUM for HARDWARE pioneers: from Wikispeed to the first Scrum for Hardware Gathering, the Agile Product Charter and Scrum@Scale. The book is divided in two parts: the first one made of stories which introduce the topic in an easy way, the second one include the description of the method, the underling values and principles, the engineering practices, case studies and many practical examples on how to adopt it in your company. In the Appendix you'll find the Scrum and Scrum@Scale guides and the description of Cynefin and PopcornFlow. Foreword by Joe Justice. https://leanpub.com/Scrum-for-Hardware/c/scrumday Free download, until 30 June 2019
  • 36.
    Scrum@Scale for Hardware CaseStudy Originally presented at Agile Business Day, Venice Italy, 15 September 2018 by Paolo Sammicheli and Giorgio Audisio
  • 37.
    VIMAR Based in Marostica,Vicenza - Italy 1.300 employees 6% of turnover invested in R&D More than 180 patents 200 Ml of pieces sold 12000 catalog parts
  • 38.
  • 39.
  • 40.
    • To beable to develop complex functions following the need of the market which continuously changes. • To increase the motivation of the developers which see in short time the results of their job. • To attract the best engineers providing a modern and up to date job environment where their skills and professionality can grow. Why Agile and Scrum?
  • 41.
  • 42.
    Every project startwith at least two day of LiftOff, with the whole team, the key stakeholders and some managers, where we share the Vision, the requirements, the constraints and we create the first backlog with the User Story Mapping technique, covering Software and Hardware layers. Whole team alignment
  • 43.
    Daily Meetings andScaled Daily • From 8.30 to 9.00 all the teams have their individual Daily Meeting. • At 9.00 a representatives from all the teams, also the remotes and suppliers, join the Scrum of Scrum. • Scrum of Scrums have a senior manager serving as the Scrum of Scrums Master, in charge of systemic impediments.
  • 44.
    Organizational Structure (example) MetaScrumScrumof Scrums CPO Chief Product Owner SSM Scrum of Scrums Master PO Product Owner SM Scrum Master Product Backlog
  • 45.
    • We behavelike a real buffet: you can't take too little, because it would not be polite, but you can't take too much because you have to eat whatever you take. • Very energetic meeting where discussions took place spontaneously; a managed chaos. • It takes around one hour of discussions for Sprint Planning 1 (what to do). At the end of the hour every team shares with the others what they selected and the CPO checks the table to see if there are high priority items still there. In that (very rare) case, teams are asked to volunteer to replace something they have with the remaining high priority item. Buffet Planning
  • 46.
    Deployment / Review •Teams have dedicated rooms where integrate and test, very often during the Sprint, the products. • These rooms usually are used also for the Sprint Review, so they all have projectors and foldable chairs to accomodate guests. • The different products are installed in several movable panels. They can also be taken into the team room during the Sprint for convenience.
  • 47.
  • 48.
    0,00 15,00 30,00 45,00 60,00 Sprint 1 Sprint4 Sprint 7 Sprint 10 Sprint 13 Sprint 16 Sprint 19 Sprint 22 Sprint 25 Sprint 8 = 6 story points Sprint 14 = 23 story points Sprint 26 = 55 story points In one Year: 9.16 times faster! Cumulated Yesterday’s Weather of the HQ Teams Benefits •Quickest developments with an increasing productivity. •More alignment and effectiveness. •Higher motivation.
  • 49.
    Point of attention •Scrumdoesn’t mean lack of planning and unpredicted Time-to-Market. •A new approach to project and portfolio management is necessary. •Impediments must be promptly corrected.
