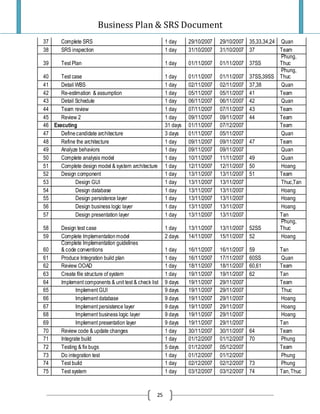

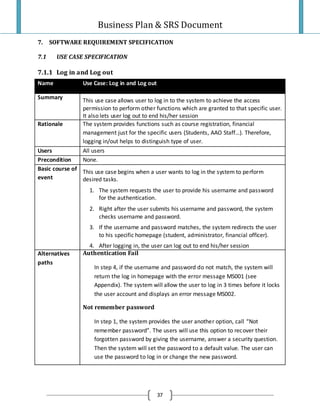

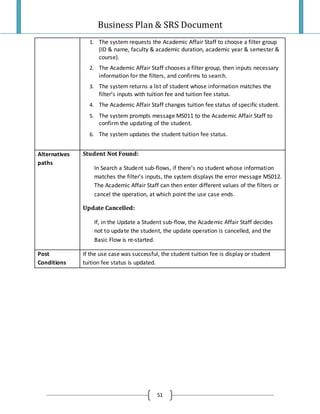

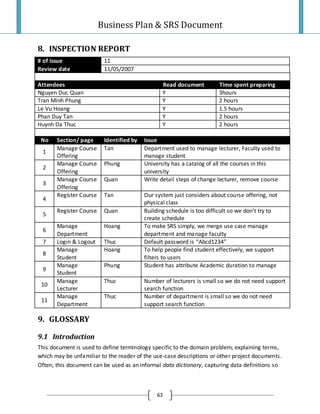

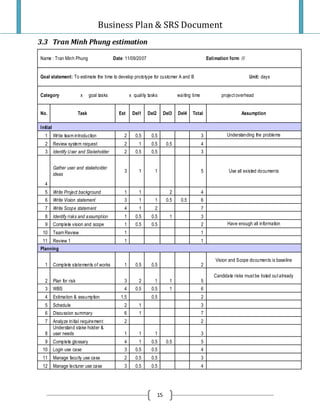

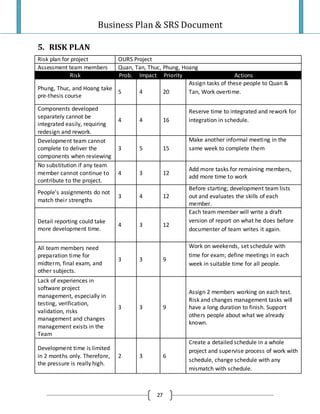

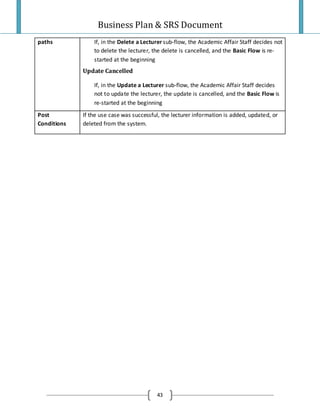

1. The team will spend an estimated 120 days developing the system through initial planning, requirements gathering, design, and testing. 2. Key tasks include writing requirements documents, developing use cases, designing system architecture, and creating test plans and cases. 3. Significant time is allocated for requirements analysis, documentation, reviews, and addressing risks to ensure the system meets stakeholder needs.
