• As per the PMI’s PMBOK 6th edition, a project is a
temporary endeavor to create a unique product,
service, or result. The transient nature of projects
indicates that a project has a definite beginning and end
• Projects can be simple or complex and may be
managed by a single person or a group
• Projects are often broken into small tasks to utilize team
strengths and increase productivity
1 How do you define a project?
2 What is a project charter?

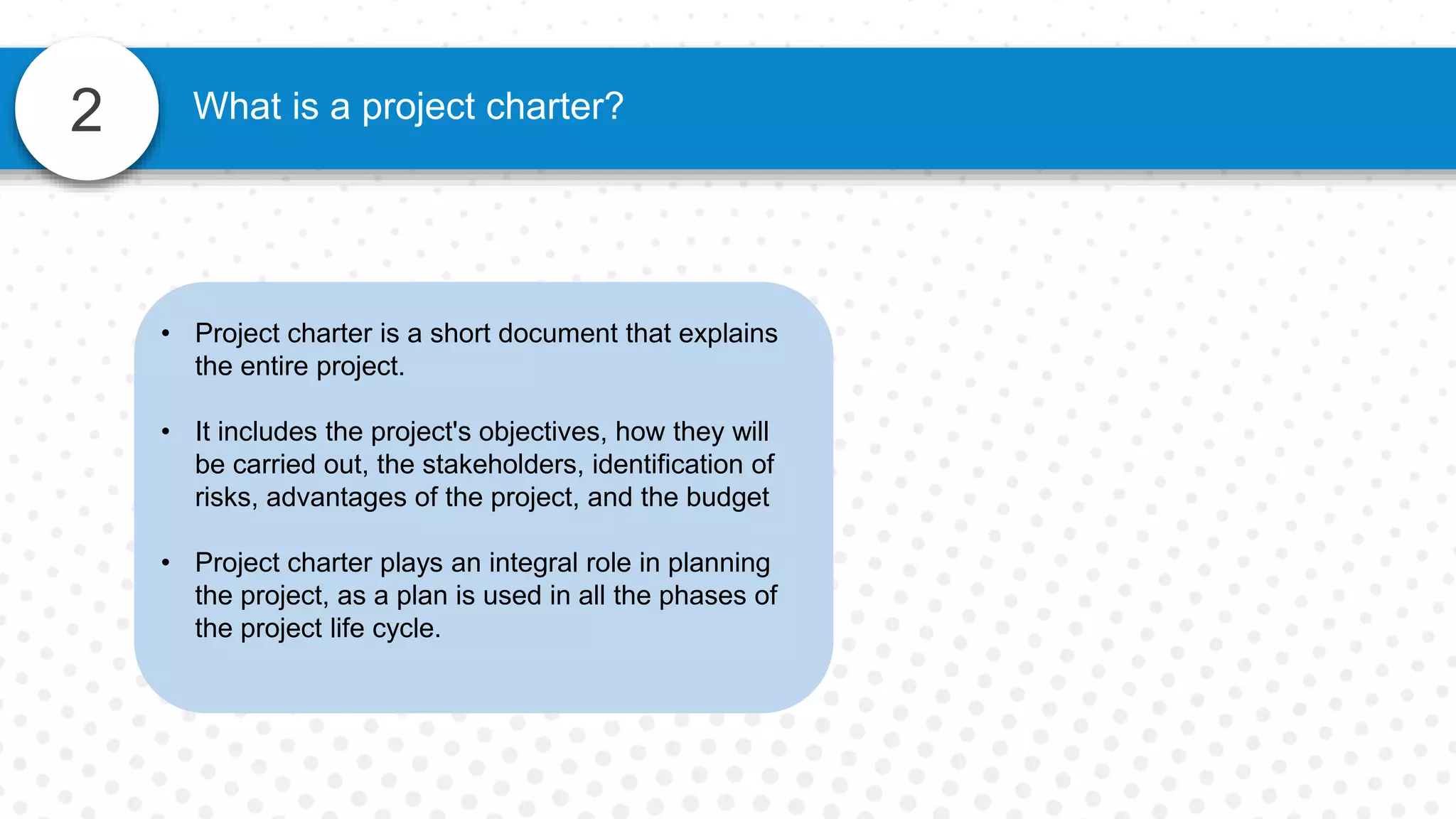

• Project charter is a short document that explains
the entire project.
• It includes the project's objectives, how they will
be carried out, the stakeholders, identification of
risks, advantages of the project, and the budget
• Project charter plays an integral role in planning
the project, as a plan is used in all the phases of
the project life cycle.
Click here to watch the video

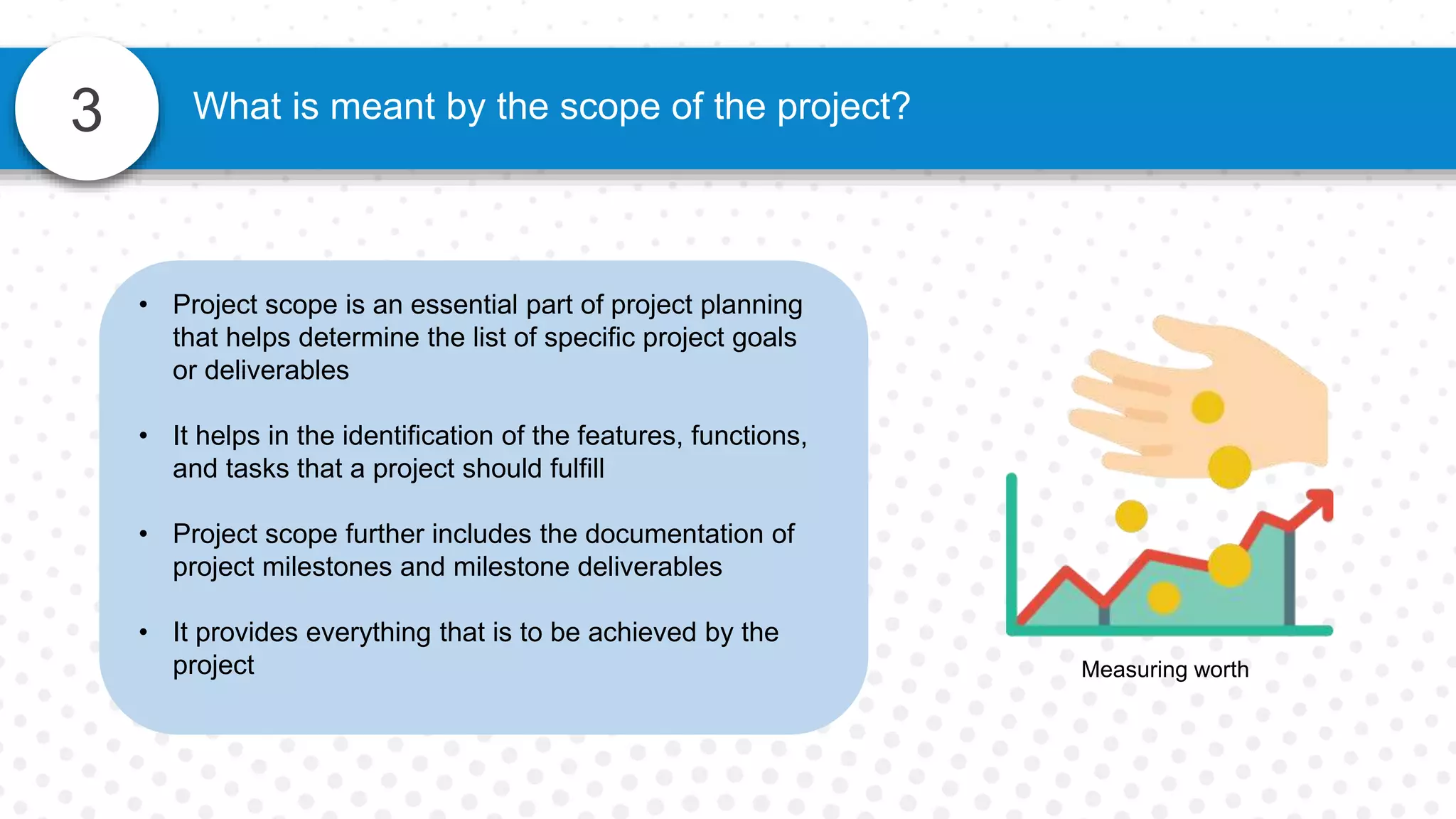

3 What is meant by the scope of the project?
Checking feasibility
• Project scope is an essential part of project planning
that helps determine the list of specific project goals
or deliverables
• It helps in the identification of the features, functions,
and tasks that a project should fulfill
3 What is meant by the scope of the project?
• Project scope is an essential part of project planning
that helps determine the list of specific project goals
or deliverables
• It helps in the identification of the features, functions,
and tasks that a project should fulfill
• Project scope further includes the documentation of
project milestones and milestone deliverables
• It provides everything that is to be achieved by the
project Measuring worth

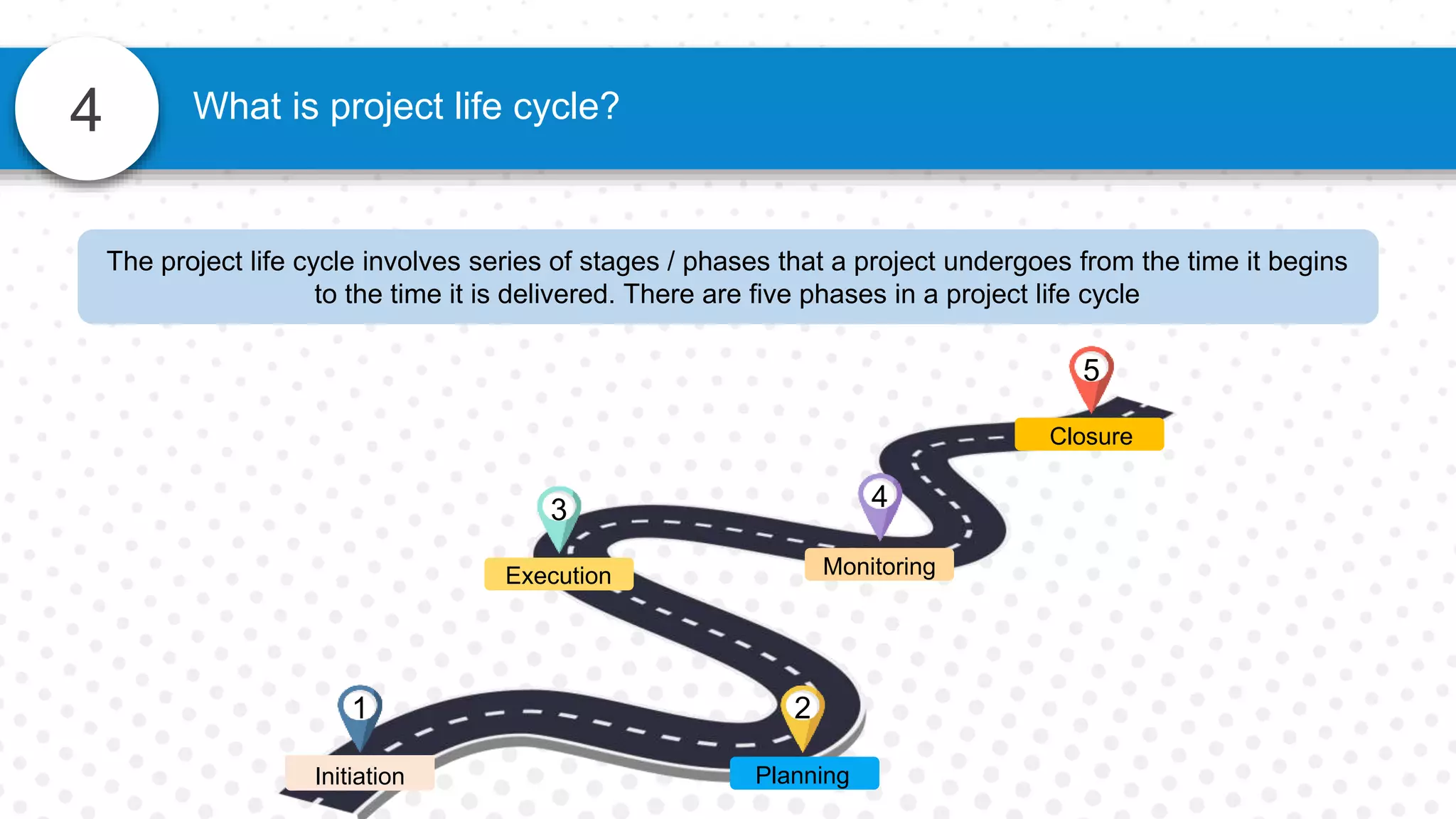

4 What is project life cycle?
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
2
3 4
Planning
Execution Monitoring
Closure
5
1
Initiation
4 What is project life cycle?
2
3 4
Planning
Execution Monitoring
Closure
5
1
Initiation
During the initiation phase, the creation of project charter, the appointment of a project
manager, and identification of key stakeholders will be made. This can be the initiation
of the project as a whole or a stage/phase
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
4 What is project life cycle?
3 4
Execution Monitoring
Closure
5
1
Initiation
The Planning phase involves the processes for creating the plan for achieving the
project’s objectives
2
Planning
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
4 What is project life cycle?
4
Monitoring
Closure
5
1
Initiation
2
Planning

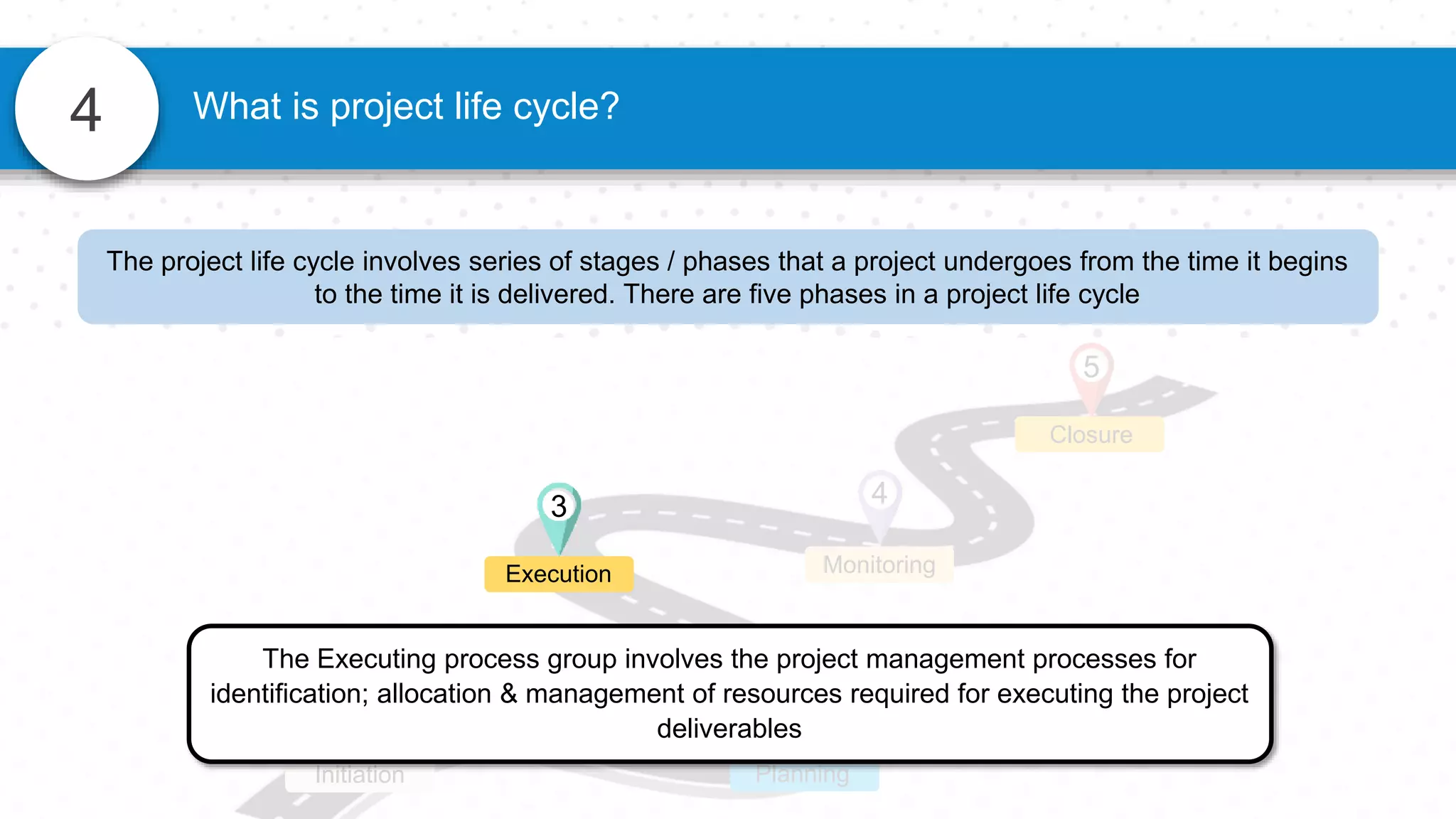

The Executing process group involves the project management processes for
identification; allocation & management of resources required for executing the project
deliverables
3
Execution
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
4 What is project life cycle?
Closure
5
1
Initiation
2
Planning
3
Execution

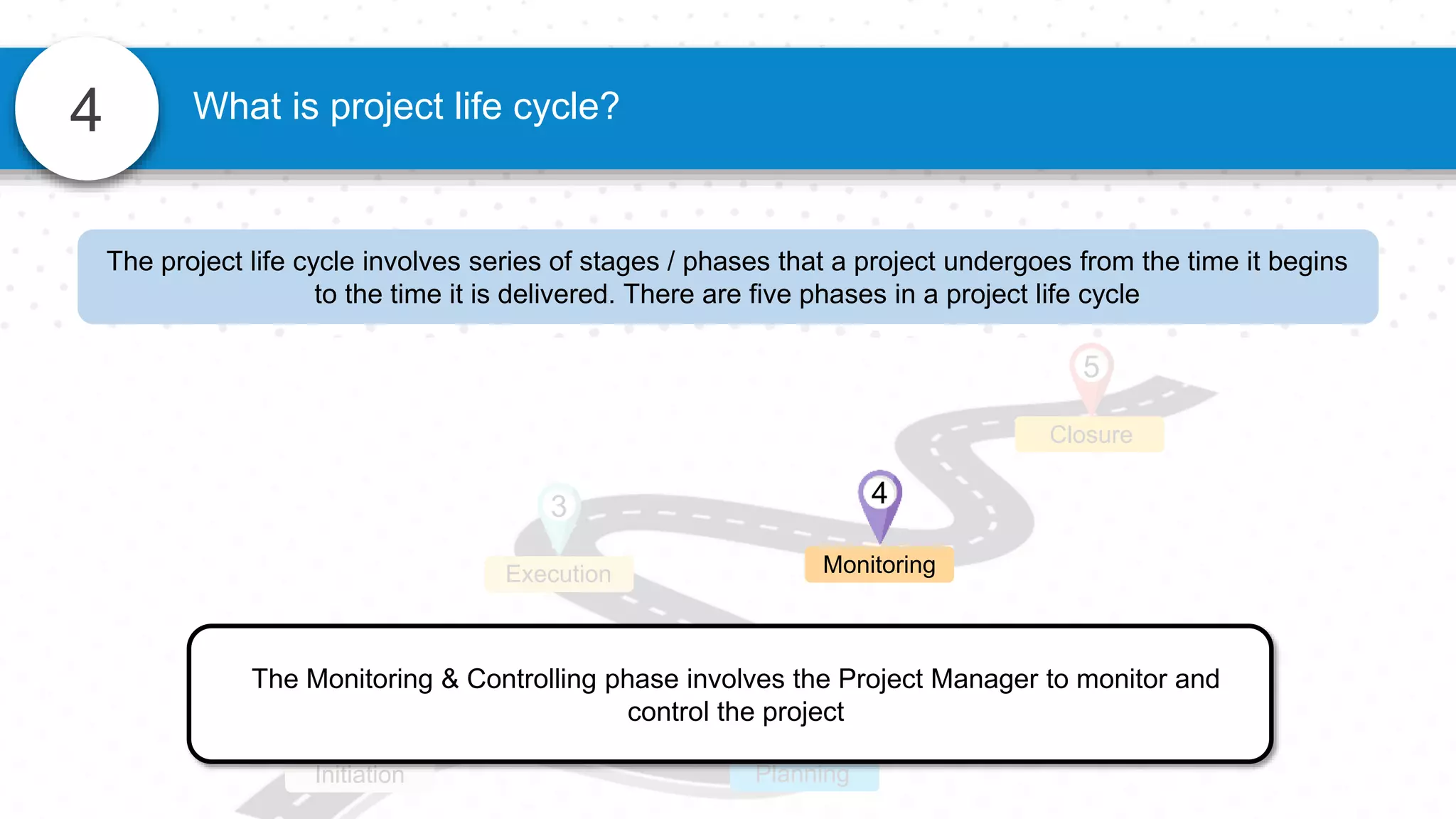

The Monitoring & Controlling phase involves the Project Manager to monitor and
control the project
4
Monitoring
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
4 What is project life cycle?
1
Initiation
2
Planning
3
Execution
4
Monitoring
The closing phase involves the process required for formally closing the project, where
everything, including what went wrong and what went right all through the project is
summed up
Closure
5
The project life cycle involves series of stages / phases that a project undergoes from the time it begins
to the time it is delivered. There are five phases in a project life cycle
5
Process groups are a set of processes that apply to various stages of a project. Each of the methods
has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the
input

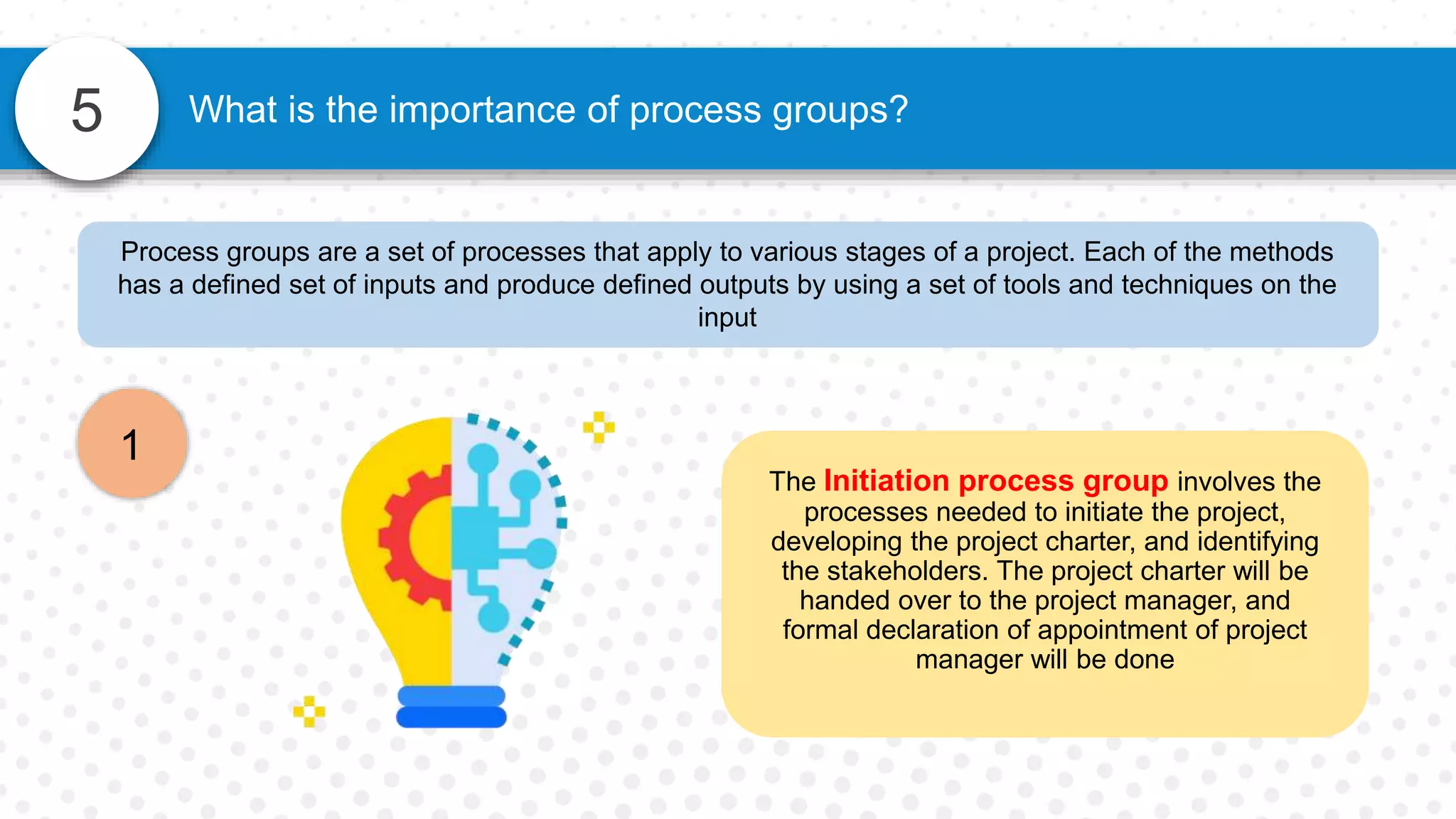

The Initiation process group involves the
processes needed to initiate the project,
developing the project charter, and identifying
the stakeholders. The project charter will be
handed over to the project manager, and
formal declaration of appointment of project
manager will be done
1

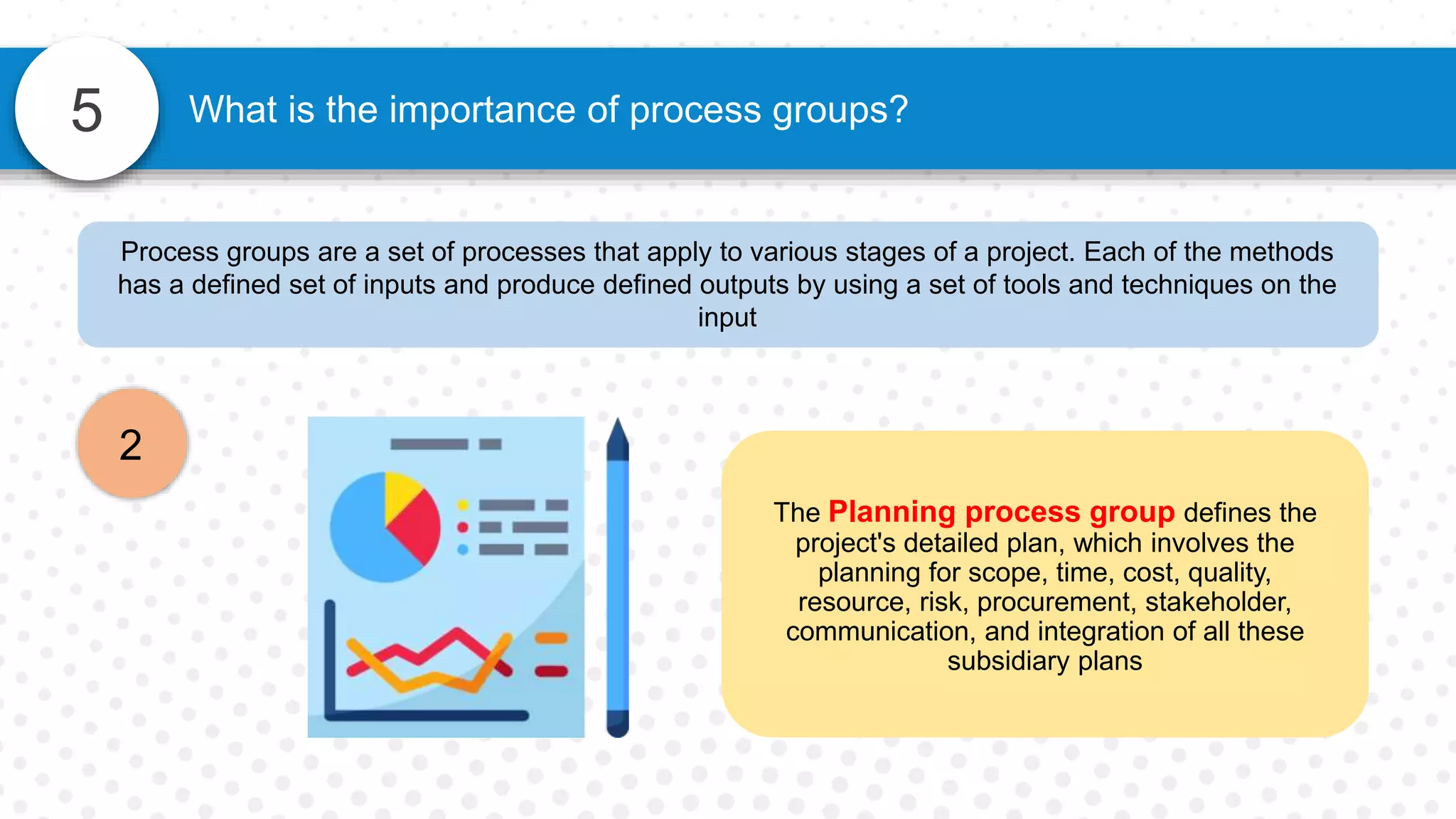

What is the importance of process groups?
5
Process groups are a set of processes that apply to various stages of a project. Each of the methods
has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the
input
2
What is the importance of process groups?
The Planning process group defines the
project's detailed plan, which involves the
planning for scope, time, cost, quality,
resource, risk, procurement, stakeholder,
communication, and integration of all these
subsidiary plans
5
Process groups are a set of processes that apply to various stages of a project. Each of the methods
has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the
input
3
What is the importance of process groups?
The Execution process group involves the
processes to direct and manage the project
works. The team’s active involvement is seen,
performing their tasks to execute the project
works
5 What is the importance of process groups?
Process groups are a set of processes that apply to various stages of a project. Each of the methods
has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the
input
4
The Monitoring and Controlling process
group refers to tracking and reviewing the
progress and performance of the project. The
process of Monitoring and Controlling is
continually performed throughout the project
life cycle
5
Process groups are a set of processes that apply to various stages of a project. Each of the methods
has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the
input
5

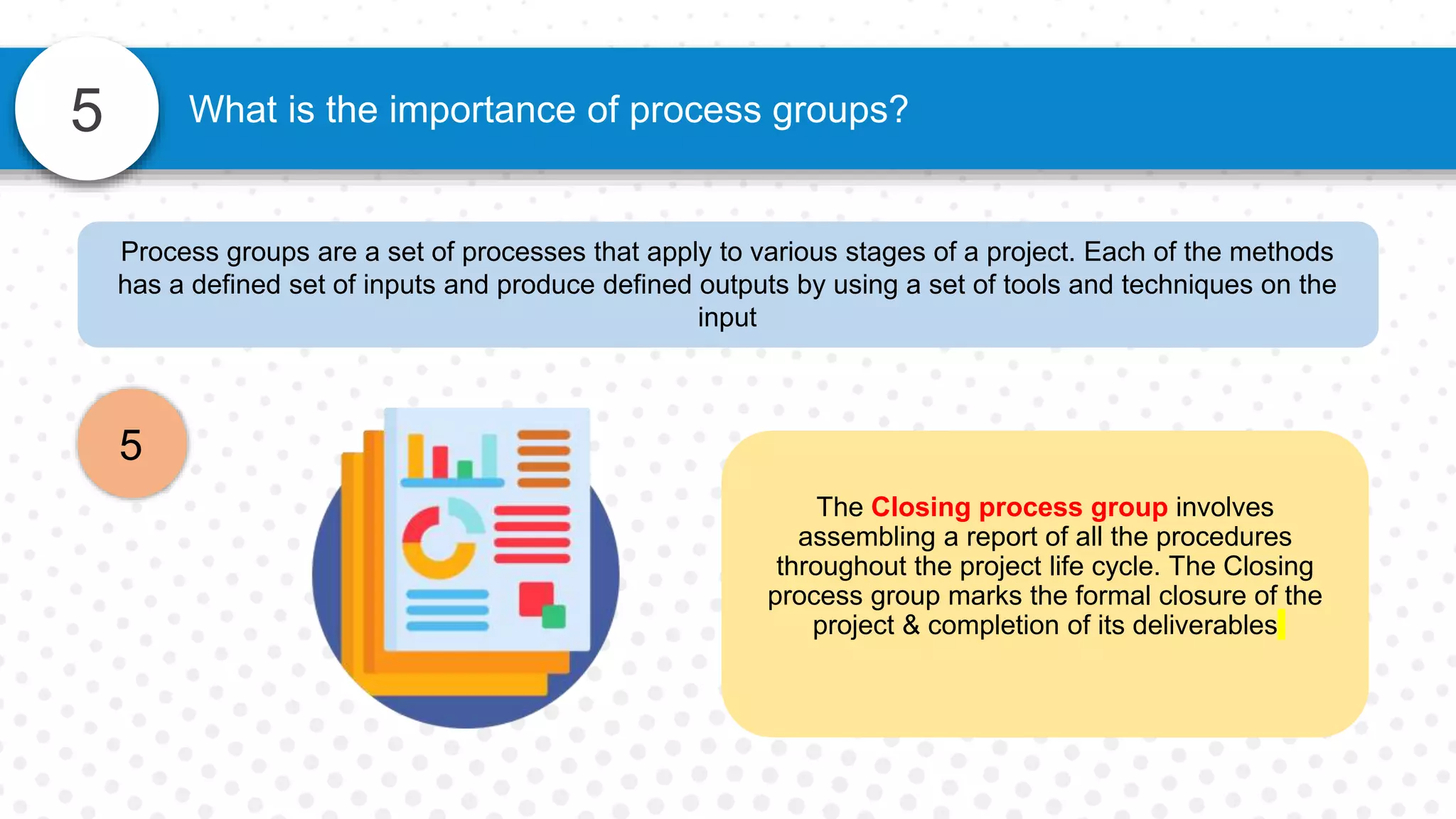

What is the importance of process groups?
The Closing process group involves
assembling a report of all the procedures
throughout the project life cycle. The Closing
process group marks the formal closure of the
project & completion of its deliverables

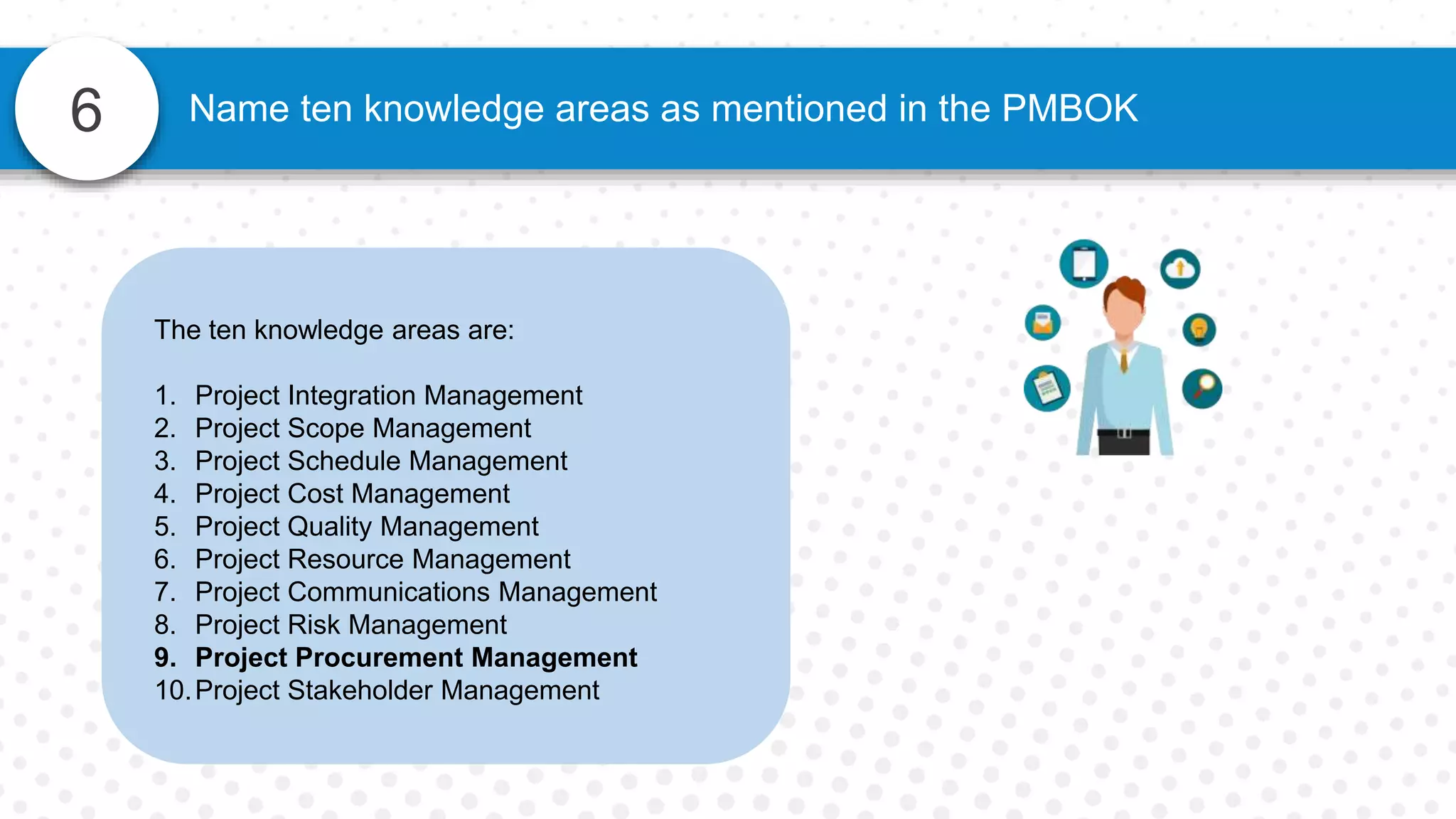

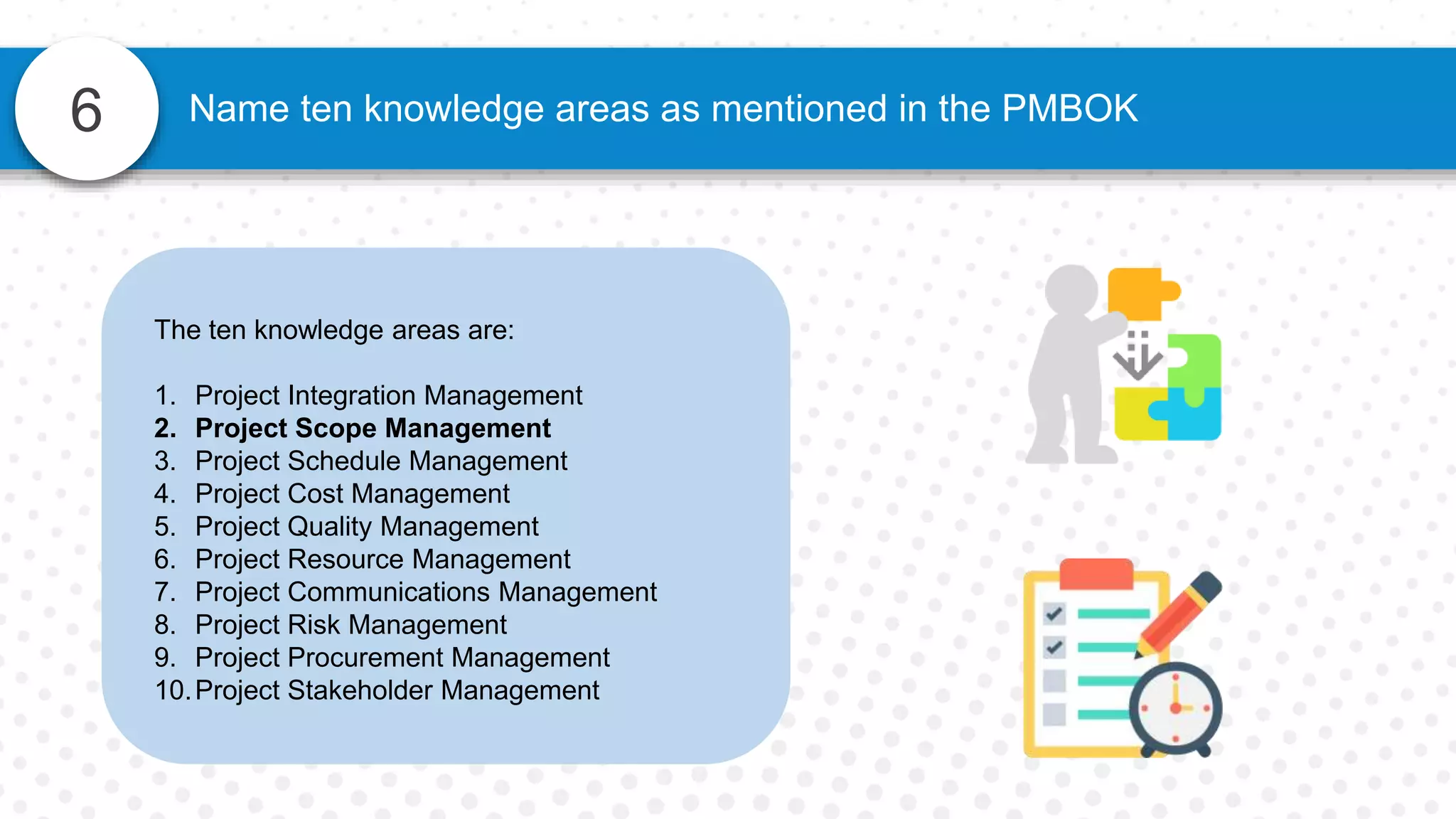

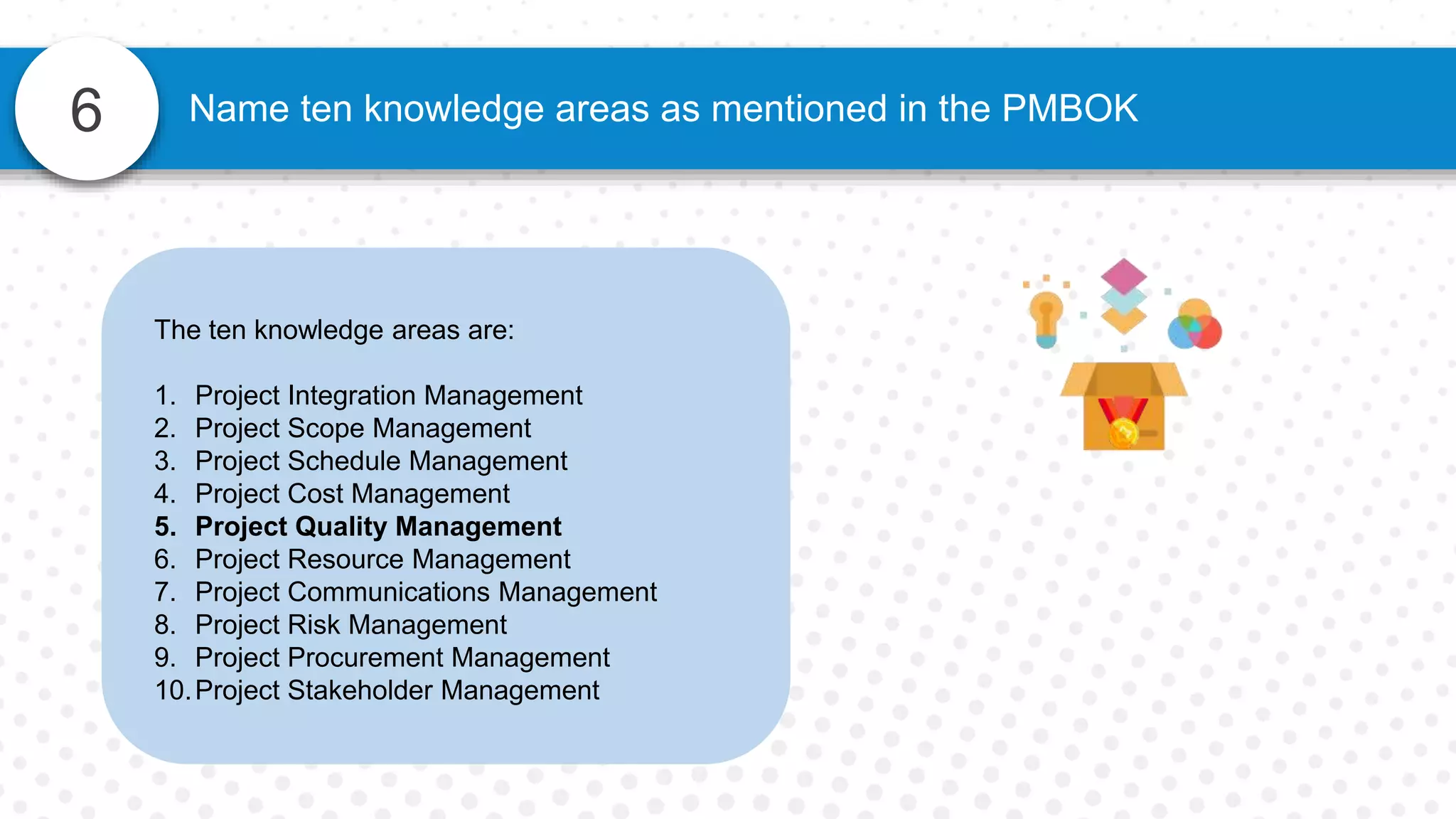

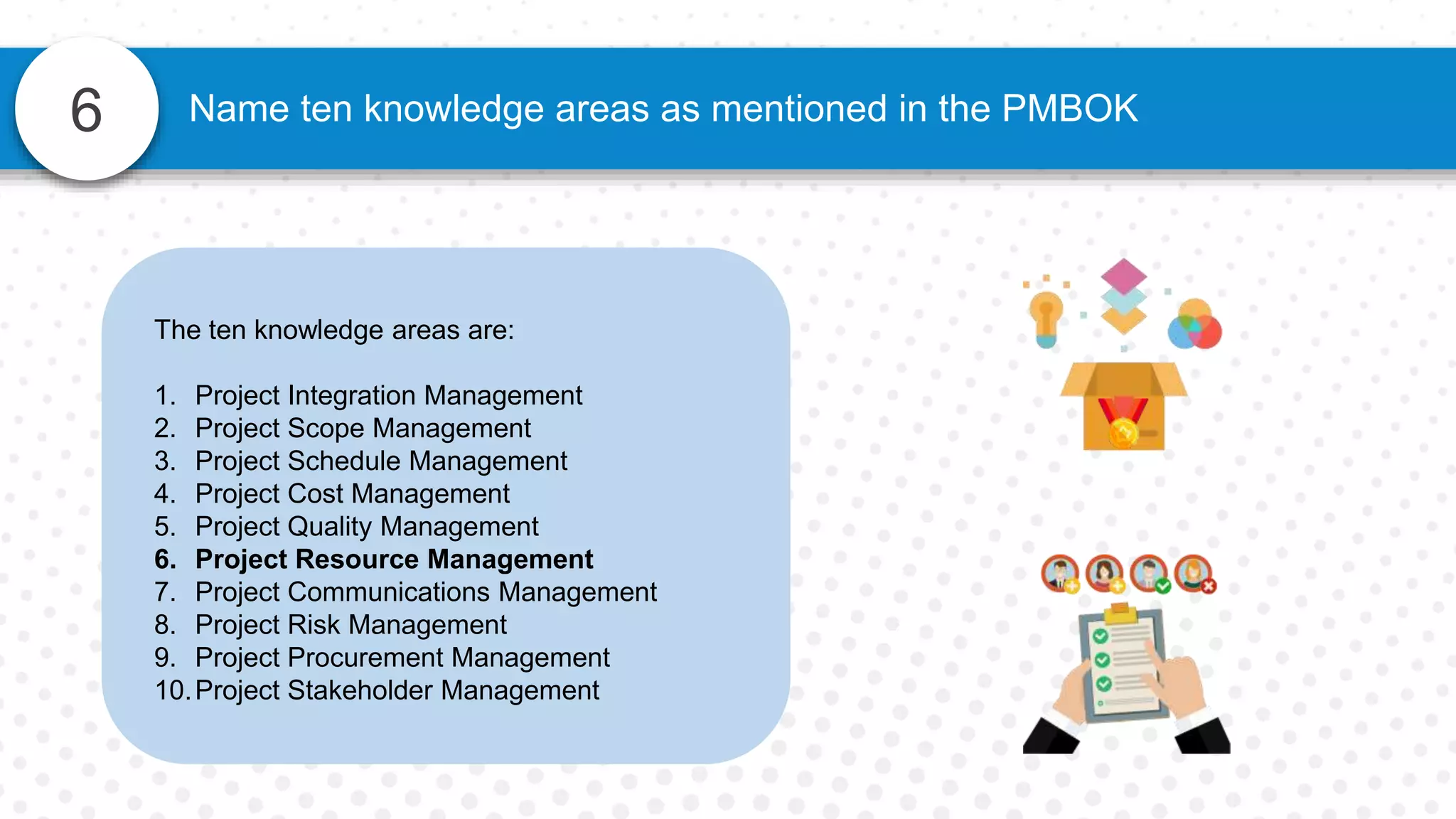

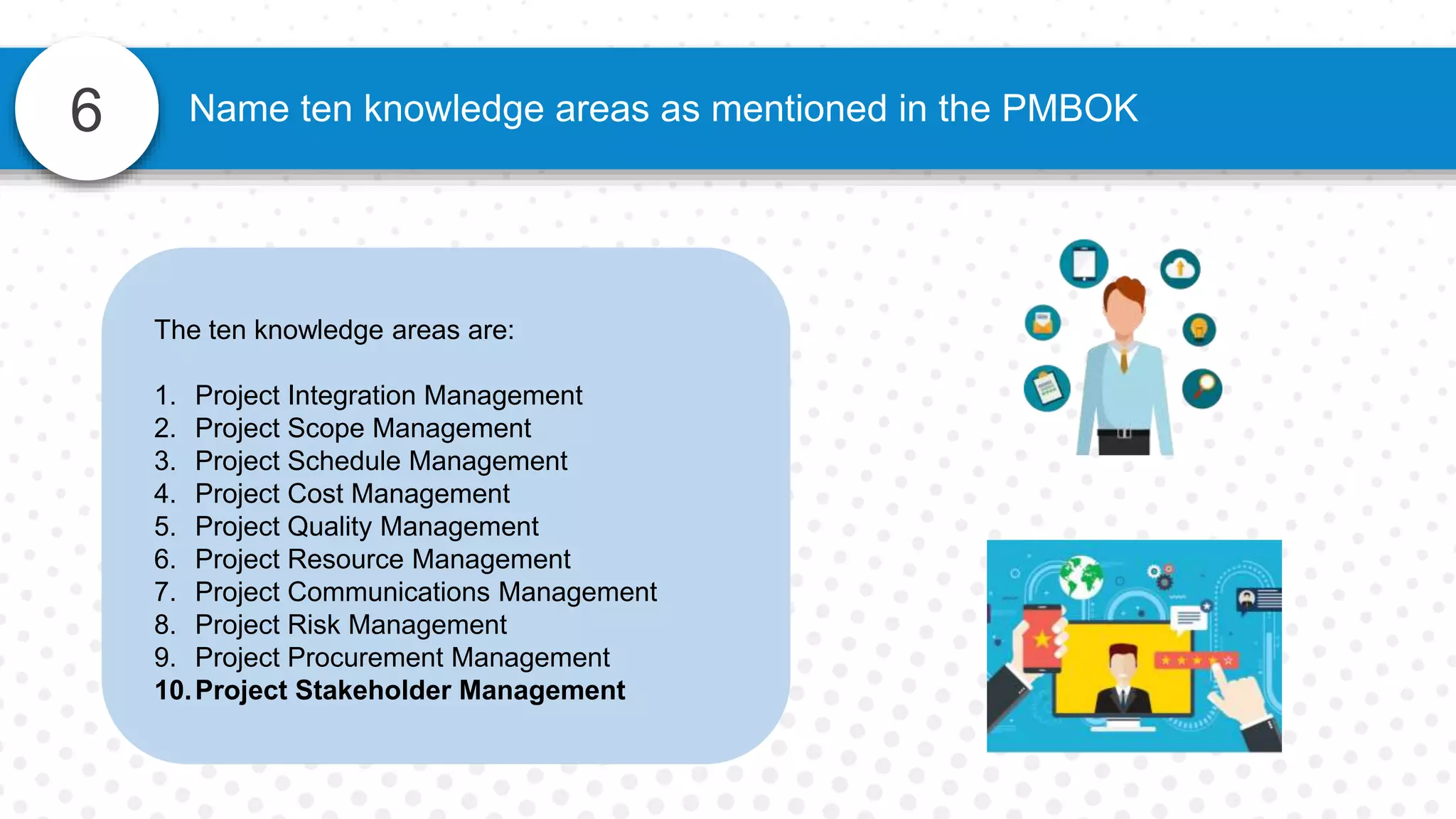

6 Name ten knowledge areas as mentioned in the PMBOK

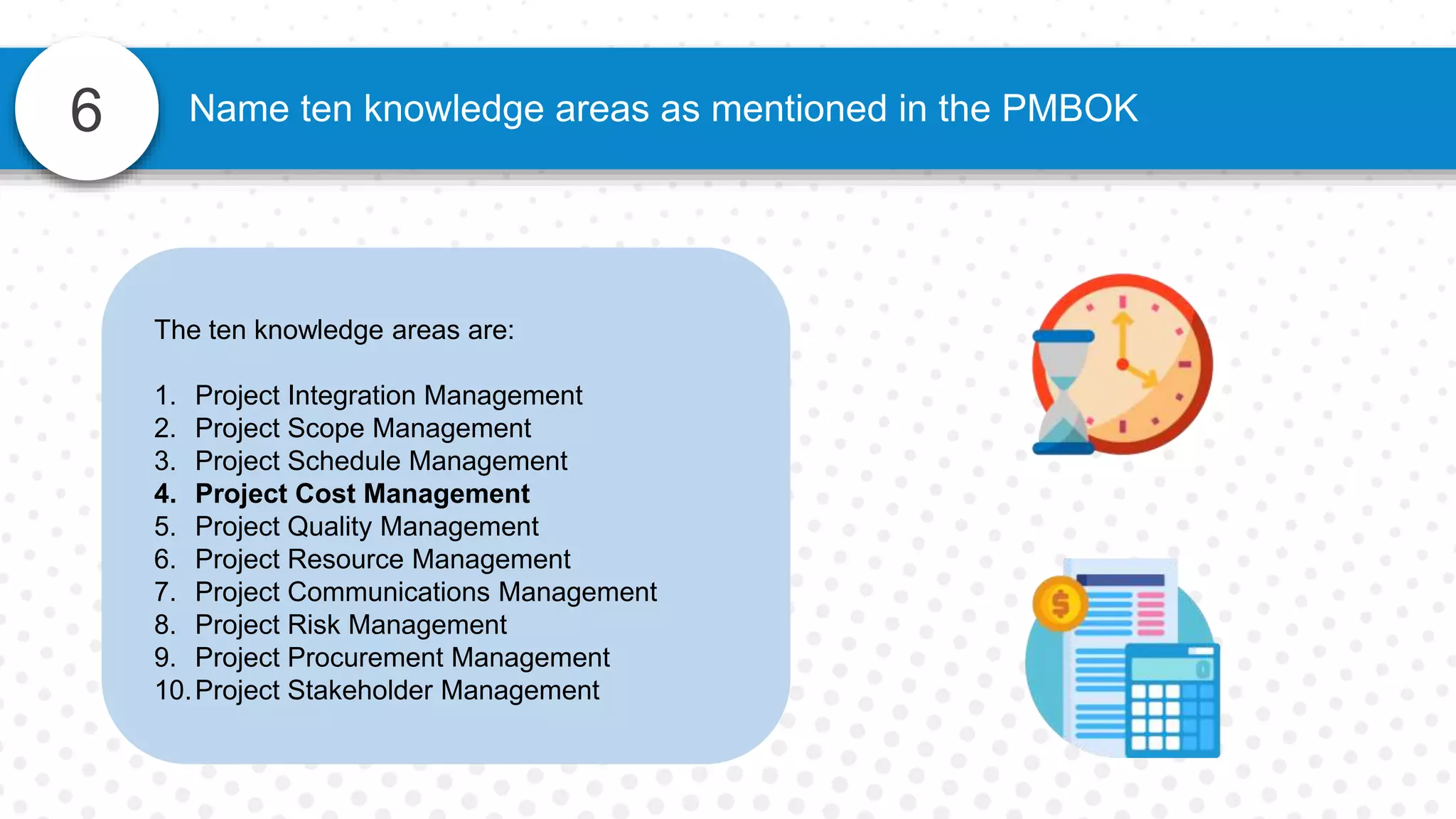

The ten knowledge areas are:
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management
6 Name ten knowledge areas as mentioned in the PMBOK
The ten knowledge areas are:
1. Project Integration Management
2. Project Scope Management
3. Project Schedule Management
4. Project Cost Management
5. Project Quality Management
6. Project Resource Management
7. Project Communications Management
8. Project Risk Management
9. Project Procurement Management
10.Project Stakeholder Management

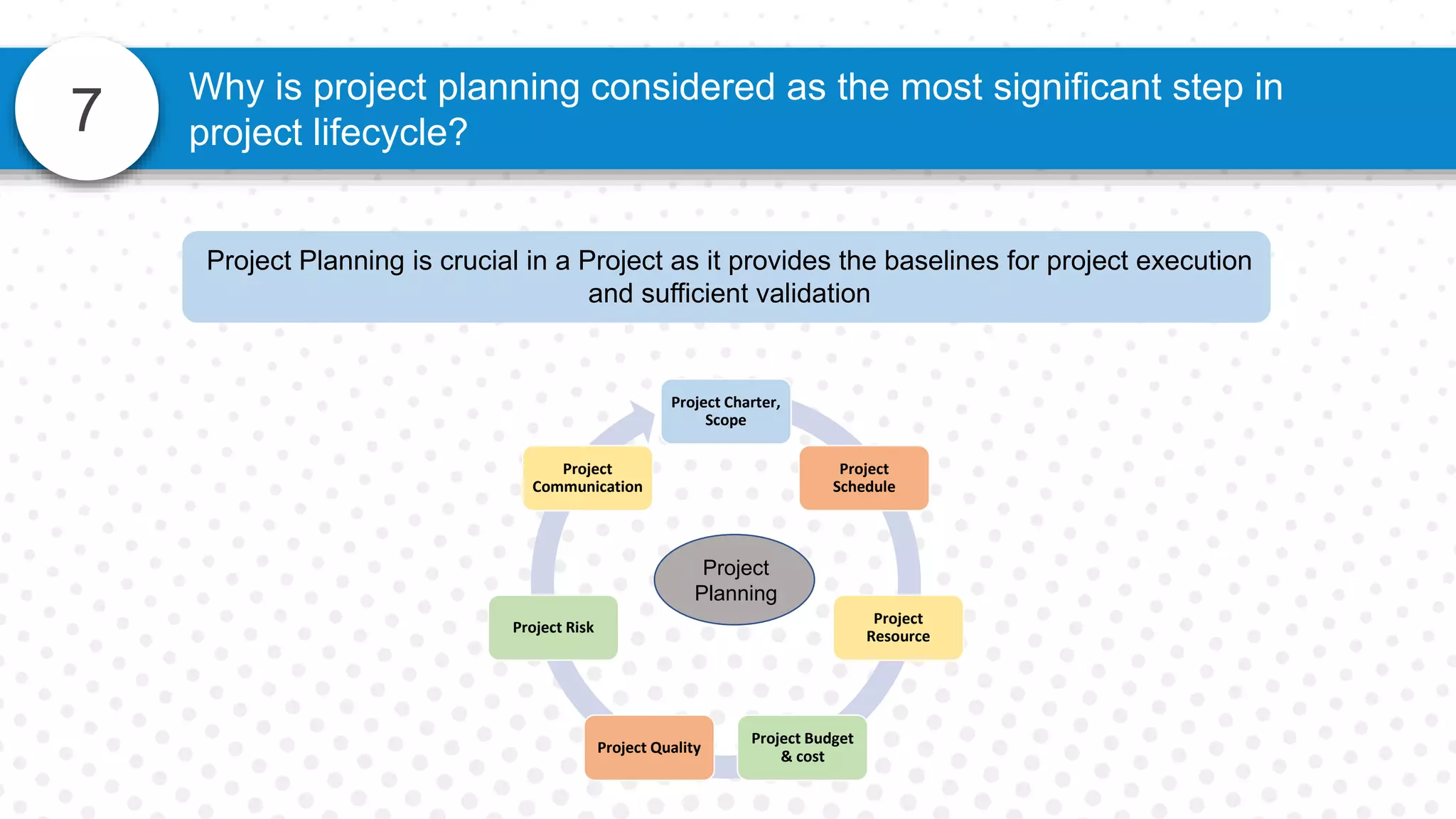

7
Why is project planning considered as the most significant step in
project lifecycle?
Project Planning is crucial in a Project as it provides the baselines for project execution
and sufficient validation
Project Charter,
Scope
Project
Schedule
Project
Resource
Project Budget
& cost
Project Quality
Project Risk
Project
Communication
Project
Planning
7
Why is project planning considered as the most significant step in
project lifecycle?
Project planning is considered the most significant due to the following reasons:

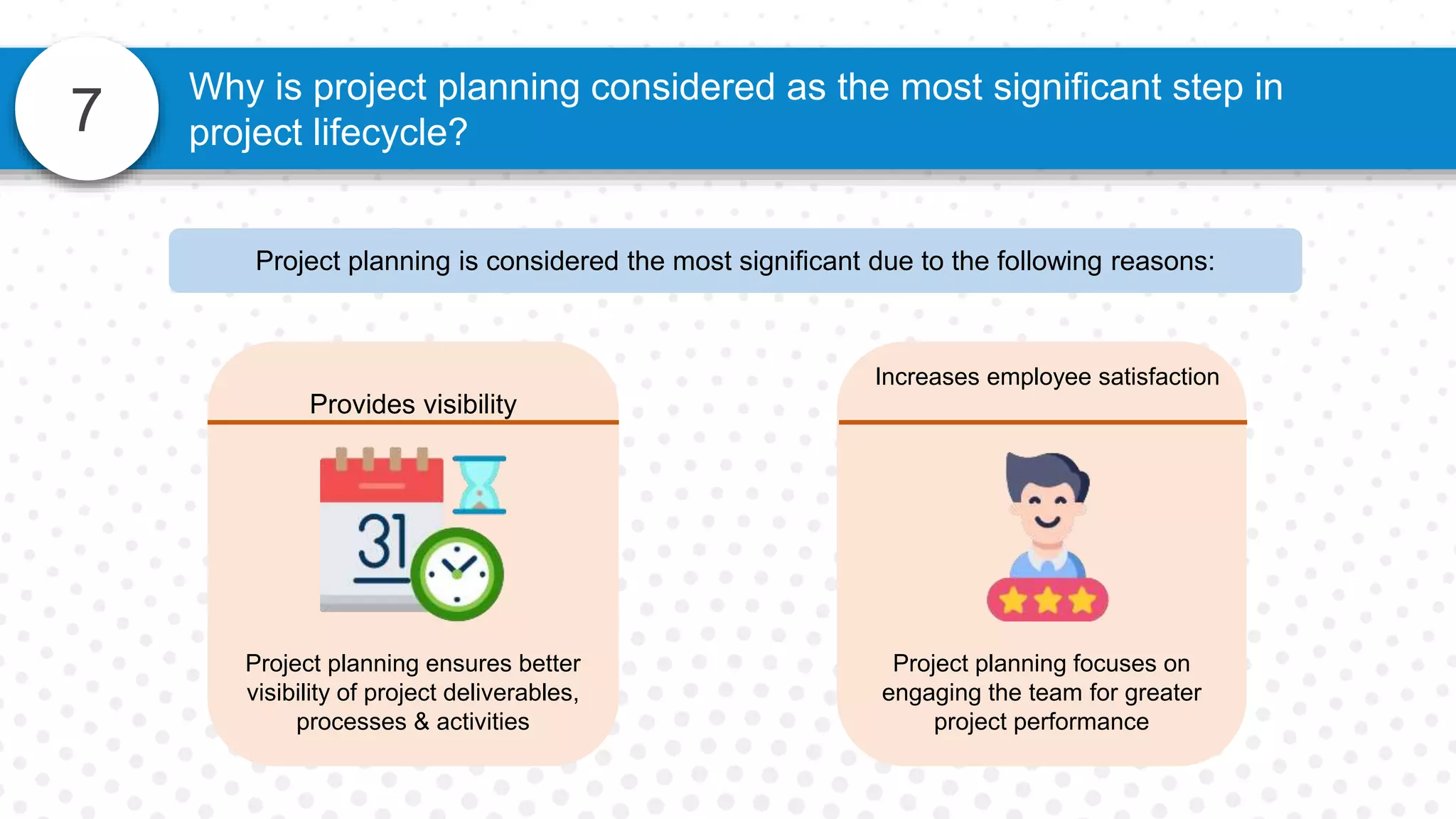

Provides visibility
Project planning ensures better
visibility of project deliverables,
processes & activities
7
Why is project planning considered as the most significant step in
project lifecycle?
Increases employee satisfaction
Project planning focuses on
engaging the team for greater
project performance
Provides visibility
Project planning ensures better
visibility of project deliverables,
processes & activities
Project planning is considered the most significant due to the following reasons:
7
Why is project planning considered as the most significant step in
project lifecycle?
Quality Assurance & control
Project planning considers &
defines, the timely audits & testing
to ensure accomplishing
compliance and deliverables
Project planning is considered the most significant due to the following reasons:
7
Why is project planning considered as the most significant step in
project lifecycle?
Reduces project riskQuality Assurance & control
Project planning considers &
defines, the timely audits & testing
to ensure accomplishing
compliance and deliverables
Project planning helps in analysing,
prioritizing and having an
appropriate plan for all the risks
Project planning is considered the most significant due to the following reasons:
8 When is stakeholder analysis performed?
• Stakeholder maybe anyone who is affected because
of the project. Stakeholder analysis plays an
important role in identifying and analyzing their
needs
8 When is stakeholder analysis performed?
• Stakeholder maybe anyone who is affected because
of the project. Stakeholder analysis plays an
important role in identifying and analyzing their
needs
• The analysis is generally performed whenever there
is a need for any clarification over quantitative and
qualitative data
8 When is stakeholder analysis performed?
• Stakeholder maybe anyone who is affected because
of the project. Stakeholder analysis plays an
important role in identifying and analyzing their
needs
• The analysis is generally performed whenever there
is a need for any clarification over quantitative and
qualitative data.
• The clarification helps in understanding the interests
of the stakeholder, which plays a vital role in the
success of the project
9 What is the role of a stakeholder in project management?
Stakeholders refer to any organization or entity that can have any positive or negative
effect because of the project
Because their interests are the most important,
their positive impacts need to be kept in mind. In
contrast, any adverse effects need to be
minimized while planning or executing any
activity during a project.
10
What are some essential features to keep in mind while choosing a
project management tool?
Let’s have a look at some essential features required
in project management tools:
• Risk management: A great project management
tool should be able to assist with identifying and
managing risks
• Native mobile app: A mobile application would
make it easier track to tasks, milestones, and
deadlines
10
What are some essential features to keep in mind while choosing a
project management tool?
• Dependencies, Milestones, and Critical Path:
The tool needs to have a function to define all the
development stages of a project, providing task
dependencies. Milestones can also be set to mark
specific points in the project, to ensure it’s moving
in the right direction
• Effective time tracking: This feature would
improve how the plan works, proving greater
accuracy and precision
10
What are some essential features to keep in mind while choosing a
project management tool?
• Third party integration: The tool must be able to
take and share data with other applications. The
tool must check on the possibility of integrating with
popular apps like Dropbox, Google Drive, etc.
• Agile workflow system: This function would be
able to increase flexibility and transparency and
help teens to be more productive
10
What are some essential features to keep in mind while choosing a
project management tool?
• Boards to manage projects: This feature would
ensure a steady flow of tasks sequentially,
speeding up task delivery
• Ease of use: The tool must have a minimalistic
design with a simple drag-drop interface. It should
provide easy functionality and smooth maintenance
and support
10
What are some essential features to keep in mind while choosing a
project management tool?
• Customizable workflows: The tool should be able
to adapt to a unique process to track work
progression
• Resource management: A resource management
function in the tool would be able to calculate
expenditures and distribute them among tasks
10
What are some essential features to keep in mind while choosing a
project management tool?
• Collaborate easily: The tool should enable users
to share documents, files, status, timelines, and
tasks with ease and quickly with many people
• Delegate tasks easily: The tool should be able to
delegate tasks, assign roles and ensure they have
access to the right information
11
What do you think is the difference between projects,
programs and a portfolio?
Definition
Project Program Portfolio
It’s a temporary endeavor that
is taken-up to create a unique
product, service or result
A collection of projects
managed as a group to achieve
efficiency
A collection of projects,
programs, and other related
work
11
What do you think is the difference between projects,
programs and a portfolio?
Managers
Project Program Portfolio
Project managers expect
change and implements
processes to manage and
control them
A program manager expects
changes from inside and
outside the program to provide
strategic benefits
A portfolio manager monitors
changes in the overall context
of the strategic plan of the
organization
11
What do you think is the difference between projects,
programs and a portfolio?
Management
Project Program Portfolio
Project managers manage and
co-ordinate the team to ensure
success
The program manager
manages the program staff and
the project manager, providing
leadership and vision
The portfolio manager may co-
ordinate or manage the portfolio
management staff
11
What do you think is the difference between projects,
programs and a portfolio?
Monitoring
Project Program Portfolio
A project manager monitors and
controls tasks to produce the
products, results or services of
the project
A program manager monitors
the progress of the components
to lead the program to success
A portfolio manager manages
the aggregated portfolio
performance and value
indicators
11
What do you think is the difference between projects,
programs and a portfolio?
Planning
Project Program Portfolio
A project manager develops,
monitors and controls project
plans throughout the project
lifecycle
A program manager develops
the program plan and performs
high-level planning to guide
component level planning
A portfolio manager performs
planning at a portfolio level
11
What do you think is the difference between projects,
programs and a portfolio?
Scope
Project Program Portfolio
The scope is developed,
monitored and controlled
throughout the lifecycle of the
project
A program has a wider scope
aimed at meeting the benefits of
the goals of the organization
A portfolio has a scope that
changes with change in the
strategic plan and goals of the
organization
11
What do you think is the difference between projects,
programs and a portfolio?
Success
Project Program Portfolio
The project's success is based
on the time taken to finish the
project, budget, scope, and
customer satisfaction
Success of a program is
measured in terms of the
benefit delivery expected from
the program
The success of the portfolio is
the aggregated performance of
all its components: programs
and projects
12
Effective communication
skills
What are the skills a project manager must possess?
Good leadership skills Strong team management
skills
12
Effective
negotiation skills
What are the skills a project manager must possess?
Critical thinking Risk management skills
13 What will be involved in Project Scope Management?
Project Scope Management ensures that a project includes all the necessary steps to meet the
project objectives
Let’s have a look at the different processes:
• Project scope management: It describes the project scope
and documents how it will be designed, validated and
controlled throughout the project lifecycle
• Collect requirements:
It is the process of defining and documenting the needs of
the stakeholders. The document of collecting requirements is
made in the project planning state
13 What will be involved in Project Scope Management?
Project Scope Management ensures that a project includes all the necessary steps to meet the
project objectives
• Define scope:
In this process, a detailed description of the project and
product is developed. A list is created that includes all the
requirements
• Creating a work breakdown structure:
This is done using a technique called decomposition/
breakdown. Project work and deliverables into smaller, more
manageable components
13 What will be involved in Project Scope Management?
Project Scope Management ensures that a project includes all the necessary steps to meet the
project objectives
• Validate scope:
This process involves reviewing deliverables with the
customer or sponsors to ensure successful completion and
formal acceptance of deliverables
• Control scope:
In this process, the status of the project and product scope is
monitored. Changes to the scope baseline also need to be
managed
14 Tell us about some project management tools
Some of the most common and popular project management tools are:
15
The M & C involves tracking the project’s performance alongside the planned project
management activities
What is the significance of Monitoring and Controlling in the project
lifecycle?
This also focuses on:
• Comparing actual and planned performance
• Ensuring an accurate information base
• Providing information to support status reporting,
measuring progress and forecasting
• Adding forecasts to update cost and current schedule
information
• Making sure approved changes are being implemented
15
The M & C involves tracking the project’s performance alongside the planned project
management activities
What is the significance of Monitoring and Controlling in the project
lifecycle?
Upon successfully performing M & C following are
the possible outcomes:
• Change requests
• Work performance reports
• Project management plan update
• Project document update
16
What’s the key difference in the roles of the project and program
manager?
Program Manager Project Manager
Plans program level activities and the schedule of
projects
Planning a project based on dependencies and the
interfaces given by the project manager
Defines terms of reference for projects Works within the defined TOR
Starts, stops and monitors the progress of constituent
projects
Runs a project, reports to a program manager
Manages program level risks and issues Manages project risks and issues, and escalates
them to program manager if required
Setting up policies and procedures for projects Runs projects according to policies and procedures
Resolving resource conflicts Uses resources assigned to him/ her
Determining program standards Delivers products that satisfy the defined standards
17 What are the types of risks involved in a project?
Some of the common types of project risks are as
follows:
• Cost risk
• Schedule risk
• Performance risk
• Technical risk
• Strategic risk
• Legal risk
• Market risk
• Risks related to external hazards
18
What is the difference between a risk and an issue in context of project
management?
Risk Issue
1. Focused on the future
2. May be positive or negative
3. Response will be in accordance to
the “risk response planning”
4. Documented in “Risk register
1. Focused on the present
2. Always negative
3. Response will be in accordance to
the “issue work - around”
4. Documented in “Issue register
19 How does project scheduling help in project execution?
• Project scheduling makes sure there is a sequence
of how all the tasks will be performed. After the
resources are estimated, and the plan is made, the
schedule plays a very important role.
• The sequence defines what activities must be
carried out first and what should follow.
• The optimized scheduling of tasks provides the best
possible output, with the allocated resources and
within the deadlines
20 What do you understand by quality control?
• Quality control refers to the activities needed to
evaluate if the project meets all the requirements with
respect to the scope of the project planning
• Project managers define the standards that a project
must fulfill to be successful
• Quality control includes validating the deliverables,
satisfying the stakeholders' requirements, identifying
the cause of poor project quality, and taking necessary
actions to eliminate problems
21 Explain the “forming” in team dynamics
• The team forming happens when the team first
meets each other.
• In the first meeting, they get introduces to each
other and get to know their backgrounds,
experience, and area of expertise.
• The team members discuss the project, consider
the project objectives and begin to think about their
role in the project
22
What is Work Breakdown Structure (WBS), and how does it affect the
work estimates of tasks/activities?
• Work Breakdown Structure (WBS) is a hierarchal
replica of all the work in the project
• WBS helps in organizing the team’s work into
manageable sections
• The structure includes additional details that help
define the tasks and helps in more accurate
estimation of time and effort

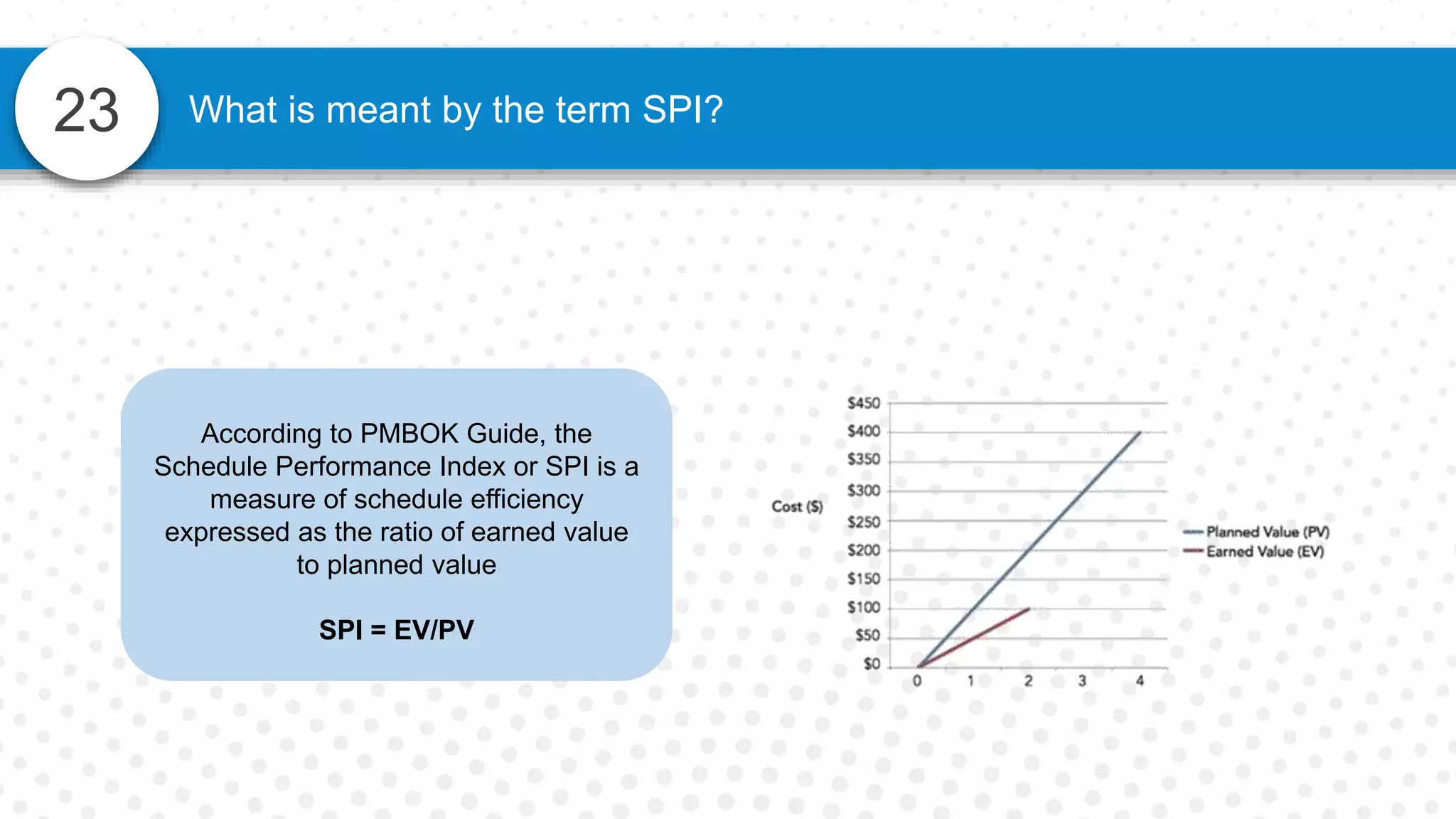

23 What is meant by the term SPI?
According to PMBOK Guide, the
Schedule Performance Index or SPI is a
measure of schedule efficiency
expressed as the ratio of earned value
to planned value
SPI = EV/PV
24 What is the significance of Agile Project Management?
Agile Project Management has been adopted by several types of industries, such as software
companies, product development, marketing campaigns, and even in construction companies
Some of the reasons that encourage
industries to take up the Agile
methodology are:
High product quality
24 What is the significance of Agile Project Management?
Agile Project Management has been adopted by several types of industries, such as software
companies, product development, marketing campaigns, and even in construction companies
Some of the reasons that encourage
industries to take up the Agile
methodology are:
High customer satisfaction
24 What is the significance of Agile Project Management?
Agile Project Management has been adopted by several types of industries, such as software
companies, product development, marketing campaigns, and even in construction companies
Some of the reasons that encourage
industries to take up the Agile
methodology are:
Reduced risk
24 What is the significance of Agile Project Management?
Agile Project Management has been adopted by several types of industries, such as software
companies, product development, marketing campaigns, and even in construction companies
Some of the reasons that encourage
industries to take up the Agile
methodology are:
Better and faster ROI
25 What is the significance of Agile Project Management?
Agile Project Management frameworks involve continuous planning and testing. There are
different frameworks each of them having their own unique qualities
The most popular Agile frameworks are:
Kanban framework
Kanban framework is used to implement agile
software development and requires real-time
communication. Work items are represented on a
Kanban board, allowing team members to see the
state of each work at any time
25 What is the significance of Agile Project Management?
Agile Project Management frameworks involve continuous planning and testing. There are
different frameworks each of them having their own unique qualities
The most popular Agile frameworks are:
Scrum framework
Scrum framework helps in dealing with complex
problems and making it possible to deliver high-
quality products at the same time. It helps in
managing complex, advanced work with a little
emphasis on software development
25 What is the significance of Agile Project Management?
Agile Project Management frameworks involve continuous planning and testing. There are
different frameworks each of them having their own unique qualities
The most popular Agile frameworks are:
Hybrid framework
Hybrid framework is a combination of Agile methods
with non-Agile methods. Hybrid can handle
requirement changes, and it can deliver product in
stages. In hybrid, planning is done using a waterfall
approach, while the agile approach handles
execution and delivery
H
Y
B
R
I
D
25 What is the significance of Agile Project Management?
Agile Project Management frameworks involve continuous planning and testing. There are
different frameworks each of them having their own unique qualities
The most popular Agile frameworks are:
Lean framework
The lean framework works on the concept of
maximizing customer value with fewer resources and
zero waste. Hence, lean focuses on the flow of
products and services instead of focusing on separate
technologies. Companies can act upon with changing
customer needs and requirements
Empower
the team
Deliver
Fast
Optimize
the whole
process
Build
Quality
Defer
Decisions
Amplify
Learnings
Lean
Eliminate
waste
26 Why does a Project Manager need to be proactive?
A proactive project manager is actively
able to determine the several
communication needs of the
stakeholders
A proactive project manager is able to
identify the risks in the early stages of
the project
27 What does a critical path method imply?
• Critical Path Method (CPM) is a crucial
tool for determining the progress of the
project to ensure that the project is on
schedule
• Critical Path Method helps in determining
the essential or critical path by finding out
the longest stretch of dependent tasks
28 What does a critical path method imply?
• Critical Path Method (CPM) is a crucial
tool for determining the progress of the
project to ensure that the project is on
schedule
• Critical Path Method helps in determining
the essential or critical path by finding out
the longest stretch of dependent tasks
28 Define planned value, actual cost and earned value.
Planned Value
• Planned Value is the approved value of the work that
needs to be completed within a period
• It serves as a baseline and needs to be calculated before
work can be started
• It is also known as Budgeted Cost of Work Scheduled
• Formula:
• PV = (Planned percentage of work completed)
x project budget
28 Define planned value, actual cost and earned value.
Actual Cost
• Actual cost is the value of the total expenses that you
have incurred for the work done till date
• It is also knowns as the Actual Cost of Work Performed
• It is used to calculate cost variance and cost
performance index
28 Define planned value, actual cost and earned value.
Earned Value
• Earned Value represents the value produced by a
project
• It is also known as Budgeted Cost of Work Performed
• Formula:
Earned Value = (Percentage of work completed)
x Project budget
29 What is the purpose of a procurement management plan?
• The procurement management plan defines the
procurement requirements and how it can be managed,
from developing a procurement documentation through
to contract closure
• The plan identifies and defines the items that need to be
procured, the contracts that need to be used for
supporting the project, how the contract is approved and
criteria for decisions to be made
29 What is the purpose of a procurement management plan?
• The plan also includes other items including
considerations for procurement risks and procurement
risk management, deciding how costs need to be
determined, standard procurement documentation usage
and constraints to procurement
30
• A project post-mortem or project retrospective refers to a
process that’s performed at the conclusion of a phase (for
a multi-stage project)
• These aim to help identify process improvements that can
prevent future risks and to ensure best practices are
repeated
When is post-mortem analysis performed in project management?
30
• Post-mortems involve a combination of quantitative and
qualitative data.
• It also includes qualitative data like end-user, stakeholder
and team satisfaction, potential for reuse, and the quality
of end-deliverable that is perceived
When is post-mortem analysis performed in project management?
31
• A risk register is tool that is used to document risks, and
the actions taken to handle each one of them.
• The management of risk is an ongoing process that has
the project team raising risks with the risk manager/
project manager, who then logs the risk and determines
an appropriate course of action to handle the risk
What is the purpose of a risk register?
31
• The risk register also needs to reviewed regularly to
ensure the appropriate actions are performed. It could
be reviewed in every project team meeting, or at the
end of each phase of the project lifecycle
What is the purpose of a risk register?
32

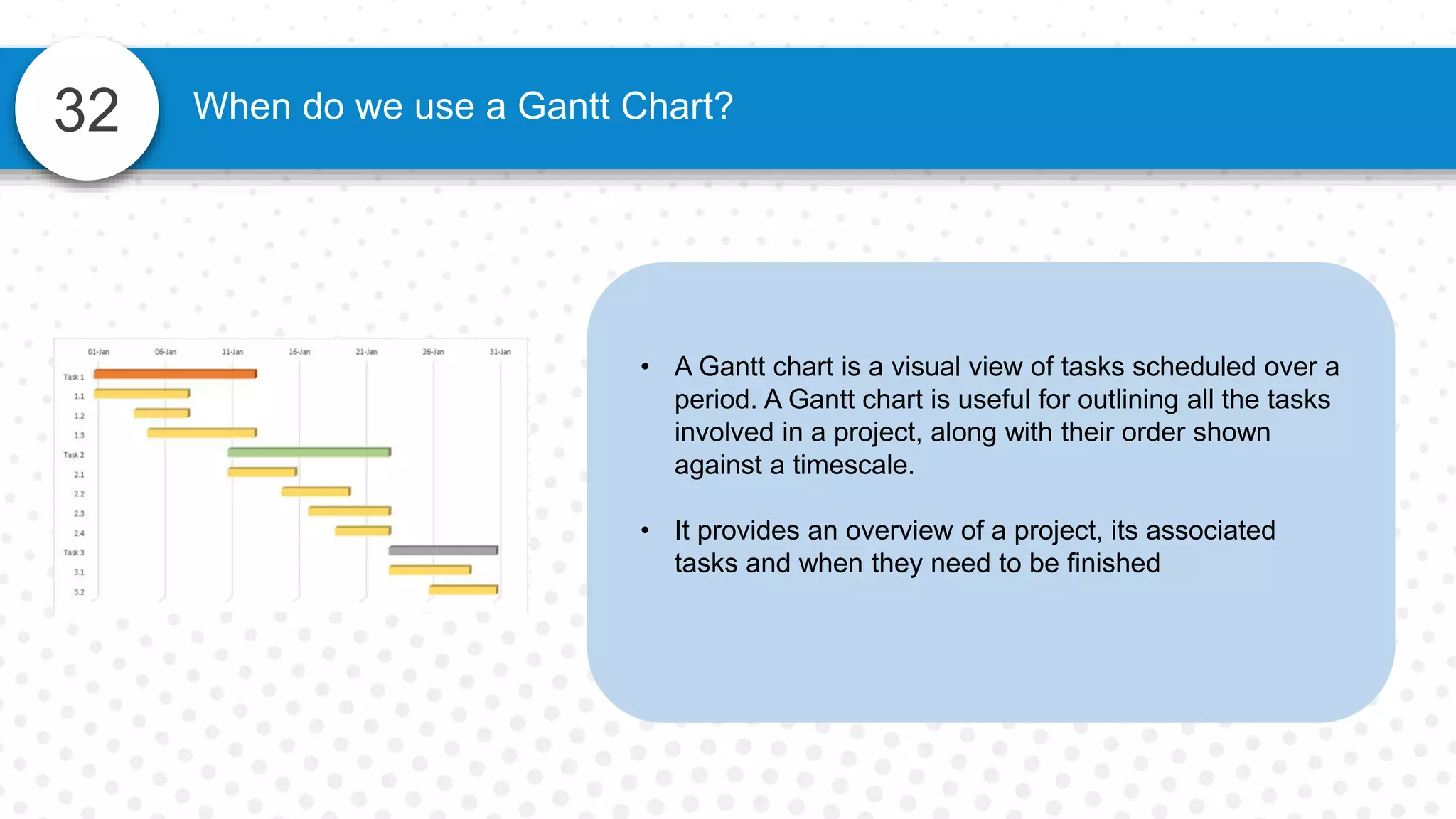

• A Gantt chart is a visual view of tasks scheduled over a
period. A Gantt chart is useful for outlining all the tasks
involved in a project, along with their order shown
against a timescale.
• It provides an overview of a project, its associated
tasks and when they need to be finished
When do we use a Gantt Chart?
32
• A Gantt chart is helpful because:
• It provides a detailed view of all tasks, and
ensures you can create a workable schedule, and
that the right people are assigned to right task
• It can be used to determine the practical aspects
of the project
• It enables you to keep your team and sponsors
informed about your progress
When do we use a Gantt Chart?
33
• CPM or Critical Path Method is a tool that’s used to
schedule project activities
• CPM is used to create a model that includes:
• Tasks required to complete the project
• Dependencies between tasks
• The duration required to complete an activity
• The critical path is the longest path in all the available
paths in a project and the duration of the critical path will
be the minimum time required by the project.
What’s the significance of the critical path method?
34
What are some tools required for arriving at improvement
in processes?
Process improvement comprises a set of actions implemented by a company to enhance
performance, cost reduction, increasing profits, etc.
Here are some tools some companies can use to
implement a successful process improvement
strategy:
• Comparing and baselining a project: With
this we can get an overview of how the
process is performing in comparison to other
similar processes
34
What are some tools required for arriving at improvement
in processes?
Process improvement comprises a set of actions implemented by a company to enhance
performance, cost reduction, increasing profits, etc.
• Flow charting: It helps them segregate the
processes, activities, events, etc.
• Value stream mapping: It helps clearly
understand the workflow and helps
organization identify waste
34
What are some tools required for arriving at improvement
in processes?
Process improvement comprises a set of actions implemented by a company to enhance
performance, cost reduction, increasing profits, etc.
• Cause and effect analysis: These help
organizations determine the root cause of any
problem
• Hypothesis testing: Testing to determine
whether a hypothesis would be favorable to
the organization or not
35 How do you work with the three-point estimation method?
The three-point estimation method is a tool that
can be used to help increase the accuracy of
cost and time estimates.
There are three parts with different estimates:
• Optimistic estimate: It is the amount of time
required to complete the project (assuming it
goes according to plan)
35 How do you work with the three-point estimation method?
• The pessimistic estimate: It’s the worst-case
scenario and is an estimate given if everything
goes wrong
• Most likely estimate: It’s what is most likely to
happen and falls between the pessimistic and
optimistic estimates
36 What do you understand by RAID?
A RAID log is a project management tool that tracks risks, actions, issues and decisions.
It provides a simple way to organize this information
Here are some the main advantages of a RAID
log:
• It enables you to think in an organized and
strategic way
• The RAID log has all the questions that could
be asked by stakeholders
• The data is easily accessible and acts as a
measure for how well your plans are being
carried out
36 What do you understand by RAID?
A RAID log is a project management tool that tracks risks, actions, issues and decisions.
It provides a simple way to organize this information
• The RAID log makes the process of decision-
making more consistent. It provides a place
where all decisions made can be captured
37 What are some techniques used for defining scope?
Here are some tools and techniques to define
scope:
• Expert judgement: It requires you to bring in
experts on the domain
• Product analysis: You need to break down
your final deliverable into smaller components
to ensure all the steps are being taken
37 What are some techniques used for defining scope?
• Alternative generation: You need to brainstorm
for the best and most effective way to created
your product
• Facilitated workshops: These allow different
people with different ideas to find common
ground for a project
38 What is waterfall model?
• Waterfall model is a project management approach
in which a project is completed in several phases
• A big plan is executed linearly expecting there
would not be any changes in the plan
• Waterfall model in contrast to Agile model does not
respond well to frequent changes
39
On what basis would you decide if a particular risk should be avoided or
mitigated?
• The risks which are having high impact (negative) to
the business are avoided by the organizations usually.
• Considering something which will have high negative
impact may not be worthwhile to take up.
• Once the organization considers to take up after
identifying and analysing the risks, then organization
would work on risk responses plan, for the risks
identified
40 What is EVM, earned value management?
• Earned value management (EVM) is a project
management technique that is used to measure the
project progress
• It calculates the project performance and progress
by combining constraints like time, scope, and
costs
41
What is the difference in Product life cycle and Project life cycle?
Project life cycle refers to sequence of
phases that a project undergoes in the from
its initiation to its closure
There five process groups defines the
process to be followed in project life cycle
1. Initiation
2. Planning
3. Execution
4. Monitoring and controlling
5. Closure
Product life cycle includes all the phases
that define the growth of a product
There are four phases:
1. Market Introduction
2. Market Growth
3. Market Maturity
4. Decline and Saturation Stage
42 Define CMM (Capability Maturity Model)
• Capability Maturity Model or CMM is an approach
to improve or refine development processes in an
organization.
• It is an elaborated structure of elements that help in
defining the features of an effective process.
43
What do you know about triple constraint triangle in project
management?
The triple constraint theory in project management
states that each project has certain boundaries of
time, cost, and scope. A change in any of the factor
will affect the other two factors
44
What is a Decision Support System (DSS)?
• Decision support system is an information system
used in decision making activities in an
organization or a business.
• It analyzes data sets and extracts information that
may be used to solve complex problems and take
decisions
45
How many types of DSS are there?
There are several types of DSS:
1. Data-driven
2. Model-driven
3. Knowledge-driven
4. Document-driven
46
Productivity: Units of Input/ Units of output
Actual cost: Total cost per time period x Time
period
Cost variance: Budgeted cost of work – actual
cost of work
What are some general metrics that are used to calculate if a project is
progressing on track?
46
Schedule variance: Budgeted cost of work
performed – budgeted cost of work scheduled
Cost performance Index: Earned value/ actual
costs
What are some general metrics that are used to calculate if a project is
progressing on track?
47
• A project milestone provides a way to observe,
measure and monitor the performance/
progress of a project
• These represent intermediate stages that
need to be fulfilled before getting to the final
objective or goal
• Milestones can provide a basis on which
progress can be monitored
What is meant by a milestone in a project?
47
• They can also proof for explanation while
reporting on the project’s status
• It can be used to provide course corrections
and learning experiences
• It can also be used to maintain accountability
and motivate staff
What is meant by a milestone in a project?
48
• The activity time or duration refers to the
process of evaluating the number of work
periods required to finish individual activities
with the resources available
• These help achieve the project objectives on
set dates and delivery schedules decided by
project management team and key
stakeholders
How can you estimate the “Activity Time” of a project?
48
Here are some tools and techniques to calculate
activity durations:
• Expert judgement
• Analogous estimation
• PERT method
• Three-point estimates
• Parametric estimating
• Alternative analysis
• Published estimating data
• Vendor bid analysis
How can you estimate the “Activity Time” of a project?
49 What do you think about CSF in project management?
CSF or Critical Success Factors are found in the project management plan and can
define what can be defined as success for the project
Some characteristics of CSF:
• Time: Was the project completed within the given
time period?
• Cost: Did it stay within the budgeted cost?
• Quality: Did it meet the specification level?
• Stakeholder: Was the result acceptable by the
end users?
• Project changes: Were scope changes minimal
and/ or agreed upon?
• Performing Organization: Did it effect the
corporate culture?
49 What do you think about CSF in project management?
CSF or Critical Success Factors are found in the project management plan and can
define what can be defined as success for the project
Here are 8 critical success factors:
• Commitment is required from team members,
clients, top management and all stakeholders
• Goals must be SMART (Specific, Measurable,
Attainable, Relevant, Time bound)
• There must be a process for quick identification
and resolution of conflict
• Good project leadership is to be established
• Risk management policies have to be established
49 What do you think about CSF in project management?
CSF or Critical Success Factors are found in the project management plan and can
define what can be defined as success for the project
• There must be proper project planning that needs
to be done
• Best practices need to be applied at all stages
• Proper communication must take place to ensure
information is passed across
50 What do you understand by the term ‘SOW’?
SOW or Statement of Work, is document that includes and defines each aspect of the
project. It is the foundation for the project plan
• Intro
• Purpose
• Scope
• Where
• Tasks
• Milestones
• Deliverable
• Schedule
• Standards
• Success
• Requirements
• Others
• Close
Before planning an executing, the SOW lays down
the entire landscape of the project
A SOW consists of:
50 What do you understand by the term ‘SOW’?
SOW or Statement of Work, is document that includes and defines each aspect of the
project. It is the foundation for the project plan
A SOW can be of 3 categories:
• Design/ Detail
• Level of effort/ time and materials: Defines an
hourly service and the materials required to
perform the tasks
• Performance based:
Focuses on the purpose of the project,
resources and quality expected from the
output
51 What is a fishbone diagram and when is it used?
A fishbone diagram, also called Ishikawa diagram is a visualization tool that’s used to categorize
potential causes (problems) for an issue, to identify their root causes
• It is used in product development and
troubleshooting processes,
• The team brainstorms for potential causes,
and then represents them in the diagram
based on their degrees of importance
Goal/ Problem
51 What is a fishbone diagram and when is it used?
Here’s when the diagram is used:
• To identify the possible causes of an issue
• To develop a product that can address
issues with current market offerings
• To reveal areas of weakness or bottlenecks
in the business process
• To handle reoccurring issues or employees
burning out
• To ensure any correction will resolve the
issue
Goal/ Problem
A fishbone diagram, also called Ishikawa diagram is a visualization tool that’s used to categorize
potential causes (problems) for an issue, to identify their root causes
52 What is the Pareto principle or 80/20 principle?
• The pareto principle states that 80% of consequences
come from 20% of the causes, indicating an unequal
relationships between inputs and outputs
• It can be applied to a range of areas like manufacturing,
management and human resources
• It is usually focused on businesses that are client-based
20
80
52 What is the Pareto principle or 80/20 principle?
• Some of the advantages of the pareto principle are:
• Increase productivity
• Increased profitability
• Identify and fix problems
• Improved customer service
20
80
53 Can you tell us about your past projects?
Discuss the following points:
• Objective of the project
• Project deliverables
• Your roles & responsibilities in the project & what
have you achieved.
• What was accomplished..! (what went well and what
did not)
• Project duration, budget, actual cost
This question is open and generic in nature, while answering such questions following points has
to be considered;
54
If the customer is not happy with the project, what will you do as a
project manager?
One has to ensure:
• Understanding the reason for dissatisfaction
• Are all the requirements fulfilled
• Was customer involved in all decision making
activities etc.,
Note: Before customer is dissatisfied, it is very
important to be with customer to understand the
customer pulse and handling the stakeholder
accordingly.
Customer satisfaction is very important to ensure the success of a project. In the scenario where
customer express their dissatisfaction;
55
What are the different kinds of projects you have
worked upon?
Discuss the following points:
• Domains of the project
• Project deliverables
• Project’s nature & complexity
• Unique challenges in each different type of project
• Project duration, budget, actual cost
This question is open and generic in nature, while answering such questions following points has
to be considered;
56
Did you ever face a situation where the project team was demotivated and
what did you do to bring them back on track?
Following points has to be kept in mind while dealing with
team:
• Team engagement (both formal & informal)
• Rewards & Recognition
• Conflict Management
• Performance evaluation & mentoring
• Education & Training Opportunities etc.,
Project team plays very important role in success of a project. It is very critical to keep them
motivated. The demotivation may happen for various reason.
57
If you get your dream job, and I assume this is your dream job, what
value you think you will be adding to the organization?
Discuss the following points:
• Why the job is your dream job
• What would be your motivation point in this dream
job
• How this dream job can link to objectives of
organization & your profession
• Road map of that job role.
This question is open and generic in nature, while answering such questions following points has
to be considered;
58
What challenges have you encountered while dealing
with other team members?
Some of the important changing scenarios would be:
• Team not collaborating
• Individual preferences and motivation
• Role preference and allocated role
• Performance Appraisal
• Communication gaps etc.,
Project team plays very important role in success of a project. Each team member comes with
the different skills, maturity mindsets & background which put across many challenges
59
Share from your experience the challenges you faced
while using project management tools
Some of the challenges one would face while using the
tools are:
• Selection of right tools for the given project
• Tools features and functionality
• Customization of tools
• The dashboards & reports
• Team’s ability to work with tools etc.,
The effective management of Project requires an efficient tool. Every tools has it’s own
uniqueness & has it’s own advantages & disadvantages
60
Can you tell me about the most difficult/ complex
project you have worked on?
Discuss the following points:
• What was the complexity in the project?
• Why do you consider that project as complex or
difficult?
• What was the size of the project in terms of
deliverables, budget, geography, team, tool &
techniques etc.,
• Was that project successful or not!?
This question is open and generic in nature, while answering such questions following points has
to be considered;
61 When do you know the project is off-track?
Following helps us to understand weather project is in track
of not;
• When SPI & CPI are < 1 (SPI is < 1, indicates, project
is behind the schedule, where as, CPI < 1, project is
over budget)
• Similarly, the results of audits & testing done as part of
quality management also reveals the details related to
compliance & off-specification which needs to be
corrected if they are not as expected.
Every project will have the set plans based on which project have to be completed successfully.
Due to various different scenarios project go of-track. Recognizing and correcting those is very
critical;
62
In the past, what metrics did you use to find out if the project was on track
or not? What did you do to rectify it?
Not required to answer this as it is
already covered in Q.61
63
How do you manage team members that aren’t working
to their full potential?
Not required to answer this as it is
already covered in Q.58
64 Have you managed remote teams and outsourced resources?
While managing the recourses who are remote or
outsourced;
• It is required to engage with the team more often
• The performance of the team member has to be well
known to the reporting manager & that needs to be
communicated regularly
This question comes from the scenario where you have to manage the team not reporting to you
directly & they are managed by different individual.
While having such resources the dynamics will be different.
65
If you could go to the past and do one thing differently as a project manager,
what would you do and why?
While answering this question following point has to be kept
in mind;
• What went well & what did not?
• Why do you think they happened and what would have
been the better solution?
• Why do you think it could have been done better?
• Why did you not do it earlier, the way you are thinking
the right way of doing it today.
Every Project manager who has managed several project earlier, will think of doing better which they have
done already. This is because of the experience they had while doing that project and the insight they
have today.
66
As a project manager, what is the most common
challenge that you face?
Following are the typical challenges;
• Not clearly defined scope.
• No proper sign off between customer and project
organization
• Deadlines / Schedules are not realistic
• Cost / Budget allocated is very low
• Team capability & skills
• Project Environment etc.,
Every project will have various challenges to deal with. Project manager has to prepare
themselves to handle those;
67
Can you describe a situation where the client was unhappy?
Why was he happy and how did you fix it?
Not required to answer this as it is
already covered in Q.54
68
Can you describe a situation where the client was unhappy?
Why was he happy and how did you fix it?

Project Manager Interview Questions And Answers | PMP Certification Training Videos | Simplilearn

  • 2.
    • As perthe PMI’s PMBOK 6th edition, a project is a temporary endeavor to create a unique product, service, or result. The transient nature of projects indicates that a project has a definite beginning and end • Projects can be simple or complex and may be managed by a single person or a group • Projects are often broken into small tasks to utilize team strengths and increase productivity 1 How do you define a project?
  • 3.
    2 What isa project charter? • Project charter is a short document that explains the entire project. • It includes the project's objectives, how they will be carried out, the stakeholders, identification of risks, advantages of the project, and the budget • Project charter plays an integral role in planning the project, as a plan is used in all the phases of the project life cycle.
  • 4.
    Click here towatch the video
  • 5.
    3 What ismeant by the scope of the project? Checking feasibility • Project scope is an essential part of project planning that helps determine the list of specific project goals or deliverables • It helps in the identification of the features, functions, and tasks that a project should fulfill
  • 6.
    3 What ismeant by the scope of the project? • Project scope is an essential part of project planning that helps determine the list of specific project goals or deliverables • It helps in the identification of the features, functions, and tasks that a project should fulfill • Project scope further includes the documentation of project milestones and milestone deliverables • It provides everything that is to be achieved by the project Measuring worth
  • 7.
    4 What isproject life cycle? The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle 2 3 4 Planning Execution Monitoring Closure 5 1 Initiation
  • 8.
    4 What isproject life cycle? 2 3 4 Planning Execution Monitoring Closure 5 1 Initiation During the initiation phase, the creation of project charter, the appointment of a project manager, and identification of key stakeholders will be made. This can be the initiation of the project as a whole or a stage/phase The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle
  • 9.
    4 What isproject life cycle? 3 4 Execution Monitoring Closure 5 1 Initiation The Planning phase involves the processes for creating the plan for achieving the project’s objectives 2 Planning The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle
  • 10.
    4 What isproject life cycle? 4 Monitoring Closure 5 1 Initiation 2 Planning The Executing process group involves the project management processes for identification; allocation & management of resources required for executing the project deliverables 3 Execution The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle
  • 11.
    4 What isproject life cycle? Closure 5 1 Initiation 2 Planning 3 Execution The Monitoring & Controlling phase involves the Project Manager to monitor and control the project 4 Monitoring The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle
  • 12.
    4 What isproject life cycle? 1 Initiation 2 Planning 3 Execution 4 Monitoring The closing phase involves the process required for formally closing the project, where everything, including what went wrong and what went right all through the project is summed up Closure 5 The project life cycle involves series of stages / phases that a project undergoes from the time it begins to the time it is delivered. There are five phases in a project life cycle
  • 13.
    5 Process groups area set of processes that apply to various stages of a project. Each of the methods has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the input The Initiation process group involves the processes needed to initiate the project, developing the project charter, and identifying the stakeholders. The project charter will be handed over to the project manager, and formal declaration of appointment of project manager will be done 1 What is the importance of process groups?
  • 14.
    5 Process groups area set of processes that apply to various stages of a project. Each of the methods has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the input 2 What is the importance of process groups? The Planning process group defines the project's detailed plan, which involves the planning for scope, time, cost, quality, resource, risk, procurement, stakeholder, communication, and integration of all these subsidiary plans
  • 15.
    5 Process groups area set of processes that apply to various stages of a project. Each of the methods has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the input 3 What is the importance of process groups? The Execution process group involves the processes to direct and manage the project works. The team’s active involvement is seen, performing their tasks to execute the project works
  • 16.
    5 What isthe importance of process groups? Process groups are a set of processes that apply to various stages of a project. Each of the methods has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the input 4 The Monitoring and Controlling process group refers to tracking and reviewing the progress and performance of the project. The process of Monitoring and Controlling is continually performed throughout the project life cycle
  • 17.
    5 Process groups area set of processes that apply to various stages of a project. Each of the methods has a defined set of inputs and produce defined outputs by using a set of tools and techniques on the input 5 What is the importance of process groups? The Closing process group involves assembling a report of all the procedures throughout the project life cycle. The Closing process group marks the formal closure of the project & completion of its deliverables
  • 18.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are:
  • 19.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 20.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 21.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 22.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 23.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 24.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 25.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 26.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 27.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 28.
    6 Name tenknowledge areas as mentioned in the PMBOK The ten knowledge areas are: 1. Project Integration Management 2. Project Scope Management 3. Project Schedule Management 4. Project Cost Management 5. Project Quality Management 6. Project Resource Management 7. Project Communications Management 8. Project Risk Management 9. Project Procurement Management 10.Project Stakeholder Management
  • 29.
    7 Why is projectplanning considered as the most significant step in project lifecycle? Project Planning is crucial in a Project as it provides the baselines for project execution and sufficient validation Project Charter, Scope Project Schedule Project Resource Project Budget & cost Project Quality Project Risk Project Communication Project Planning
  • 30.
    7 Why is projectplanning considered as the most significant step in project lifecycle? Project planning is considered the most significant due to the following reasons: Provides visibility Project planning ensures better visibility of project deliverables, processes & activities
  • 31.
    7 Why is projectplanning considered as the most significant step in project lifecycle? Increases employee satisfaction Project planning focuses on engaging the team for greater project performance Provides visibility Project planning ensures better visibility of project deliverables, processes & activities Project planning is considered the most significant due to the following reasons:
  • 32.
    7 Why is projectplanning considered as the most significant step in project lifecycle? Quality Assurance & control Project planning considers & defines, the timely audits & testing to ensure accomplishing compliance and deliverables Project planning is considered the most significant due to the following reasons:
  • 33.
    7 Why is projectplanning considered as the most significant step in project lifecycle? Reduces project riskQuality Assurance & control Project planning considers & defines, the timely audits & testing to ensure accomplishing compliance and deliverables Project planning helps in analysing, prioritizing and having an appropriate plan for all the risks Project planning is considered the most significant due to the following reasons:
  • 34.
    8 When isstakeholder analysis performed? • Stakeholder maybe anyone who is affected because of the project. Stakeholder analysis plays an important role in identifying and analyzing their needs
  • 35.
    8 When isstakeholder analysis performed? • Stakeholder maybe anyone who is affected because of the project. Stakeholder analysis plays an important role in identifying and analyzing their needs • The analysis is generally performed whenever there is a need for any clarification over quantitative and qualitative data
  • 36.
    8 When isstakeholder analysis performed? • Stakeholder maybe anyone who is affected because of the project. Stakeholder analysis plays an important role in identifying and analyzing their needs • The analysis is generally performed whenever there is a need for any clarification over quantitative and qualitative data. • The clarification helps in understanding the interests of the stakeholder, which plays a vital role in the success of the project
  • 37.
    9 What isthe role of a stakeholder in project management? Stakeholders refer to any organization or entity that can have any positive or negative effect because of the project Because their interests are the most important, their positive impacts need to be kept in mind. In contrast, any adverse effects need to be minimized while planning or executing any activity during a project.
  • 38.
    10 What are someessential features to keep in mind while choosing a project management tool? Let’s have a look at some essential features required in project management tools: • Risk management: A great project management tool should be able to assist with identifying and managing risks • Native mobile app: A mobile application would make it easier track to tasks, milestones, and deadlines
  • 39.
    10 What are someessential features to keep in mind while choosing a project management tool? • Dependencies, Milestones, and Critical Path: The tool needs to have a function to define all the development stages of a project, providing task dependencies. Milestones can also be set to mark specific points in the project, to ensure it’s moving in the right direction • Effective time tracking: This feature would improve how the plan works, proving greater accuracy and precision
  • 40.
    10 What are someessential features to keep in mind while choosing a project management tool? • Third party integration: The tool must be able to take and share data with other applications. The tool must check on the possibility of integrating with popular apps like Dropbox, Google Drive, etc. • Agile workflow system: This function would be able to increase flexibility and transparency and help teens to be more productive
  • 41.
    10 What are someessential features to keep in mind while choosing a project management tool? • Boards to manage projects: This feature would ensure a steady flow of tasks sequentially, speeding up task delivery • Ease of use: The tool must have a minimalistic design with a simple drag-drop interface. It should provide easy functionality and smooth maintenance and support
  • 42.
    10 What are someessential features to keep in mind while choosing a project management tool? • Customizable workflows: The tool should be able to adapt to a unique process to track work progression • Resource management: A resource management function in the tool would be able to calculate expenditures and distribute them among tasks
  • 43.
    10 What are someessential features to keep in mind while choosing a project management tool? • Collaborate easily: The tool should enable users to share documents, files, status, timelines, and tasks with ease and quickly with many people • Delegate tasks easily: The tool should be able to delegate tasks, assign roles and ensure they have access to the right information
  • 44.
    11 What do youthink is the difference between projects, programs and a portfolio? Definition Project Program Portfolio It’s a temporary endeavor that is taken-up to create a unique product, service or result A collection of projects managed as a group to achieve efficiency A collection of projects, programs, and other related work
  • 45.
    11 What do youthink is the difference between projects, programs and a portfolio? Managers Project Program Portfolio Project managers expect change and implements processes to manage and control them A program manager expects changes from inside and outside the program to provide strategic benefits A portfolio manager monitors changes in the overall context of the strategic plan of the organization
  • 46.
    11 What do youthink is the difference between projects, programs and a portfolio? Management Project Program Portfolio Project managers manage and co-ordinate the team to ensure success The program manager manages the program staff and the project manager, providing leadership and vision The portfolio manager may co- ordinate or manage the portfolio management staff
  • 47.
    11 What do youthink is the difference between projects, programs and a portfolio? Monitoring Project Program Portfolio A project manager monitors and controls tasks to produce the products, results or services of the project A program manager monitors the progress of the components to lead the program to success A portfolio manager manages the aggregated portfolio performance and value indicators
  • 48.
    11 What do youthink is the difference between projects, programs and a portfolio? Planning Project Program Portfolio A project manager develops, monitors and controls project plans throughout the project lifecycle A program manager develops the program plan and performs high-level planning to guide component level planning A portfolio manager performs planning at a portfolio level
  • 49.
    11 What do youthink is the difference between projects, programs and a portfolio? Scope Project Program Portfolio The scope is developed, monitored and controlled throughout the lifecycle of the project A program has a wider scope aimed at meeting the benefits of the goals of the organization A portfolio has a scope that changes with change in the strategic plan and goals of the organization
  • 50.
    11 What do youthink is the difference between projects, programs and a portfolio? Success Project Program Portfolio The project's success is based on the time taken to finish the project, budget, scope, and customer satisfaction Success of a program is measured in terms of the benefit delivery expected from the program The success of the portfolio is the aggregated performance of all its components: programs and projects
  • 51.
    12 Effective communication skills What arethe skills a project manager must possess? Good leadership skills Strong team management skills
  • 52.
    12 Effective negotiation skills What arethe skills a project manager must possess? Critical thinking Risk management skills
  • 53.
    13 What willbe involved in Project Scope Management? Project Scope Management ensures that a project includes all the necessary steps to meet the project objectives Let’s have a look at the different processes: • Project scope management: It describes the project scope and documents how it will be designed, validated and controlled throughout the project lifecycle • Collect requirements: It is the process of defining and documenting the needs of the stakeholders. The document of collecting requirements is made in the project planning state
  • 54.
    13 What willbe involved in Project Scope Management? Project Scope Management ensures that a project includes all the necessary steps to meet the project objectives • Define scope: In this process, a detailed description of the project and product is developed. A list is created that includes all the requirements • Creating a work breakdown structure: This is done using a technique called decomposition/ breakdown. Project work and deliverables into smaller, more manageable components
  • 55.
    13 What willbe involved in Project Scope Management? Project Scope Management ensures that a project includes all the necessary steps to meet the project objectives • Validate scope: This process involves reviewing deliverables with the customer or sponsors to ensure successful completion and formal acceptance of deliverables • Control scope: In this process, the status of the project and product scope is monitored. Changes to the scope baseline also need to be managed
  • 56.
    14 Tell usabout some project management tools Some of the most common and popular project management tools are:
  • 57.
    15 The M &C involves tracking the project’s performance alongside the planned project management activities What is the significance of Monitoring and Controlling in the project lifecycle? This also focuses on: • Comparing actual and planned performance • Ensuring an accurate information base • Providing information to support status reporting, measuring progress and forecasting • Adding forecasts to update cost and current schedule information • Making sure approved changes are being implemented
  • 58.
    15 The M &C involves tracking the project’s performance alongside the planned project management activities What is the significance of Monitoring and Controlling in the project lifecycle? Upon successfully performing M & C following are the possible outcomes: • Change requests • Work performance reports • Project management plan update • Project document update
  • 59.
    16 What’s the keydifference in the roles of the project and program manager? Program Manager Project Manager Plans program level activities and the schedule of projects Planning a project based on dependencies and the interfaces given by the project manager Defines terms of reference for projects Works within the defined TOR Starts, stops and monitors the progress of constituent projects Runs a project, reports to a program manager Manages program level risks and issues Manages project risks and issues, and escalates them to program manager if required Setting up policies and procedures for projects Runs projects according to policies and procedures Resolving resource conflicts Uses resources assigned to him/ her Determining program standards Delivers products that satisfy the defined standards
  • 60.
    17 What arethe types of risks involved in a project? Some of the common types of project risks are as follows: • Cost risk • Schedule risk • Performance risk • Technical risk • Strategic risk • Legal risk • Market risk • Risks related to external hazards
  • 61.
    18 What is thedifference between a risk and an issue in context of project management? Risk Issue 1. Focused on the future 2. May be positive or negative 3. Response will be in accordance to the “risk response planning” 4. Documented in “Risk register 1. Focused on the present 2. Always negative 3. Response will be in accordance to the “issue work - around” 4. Documented in “Issue register
  • 62.
    19 How doesproject scheduling help in project execution? • Project scheduling makes sure there is a sequence of how all the tasks will be performed. After the resources are estimated, and the plan is made, the schedule plays a very important role. • The sequence defines what activities must be carried out first and what should follow. • The optimized scheduling of tasks provides the best possible output, with the allocated resources and within the deadlines
  • 63.
    20 What doyou understand by quality control? • Quality control refers to the activities needed to evaluate if the project meets all the requirements with respect to the scope of the project planning • Project managers define the standards that a project must fulfill to be successful • Quality control includes validating the deliverables, satisfying the stakeholders' requirements, identifying the cause of poor project quality, and taking necessary actions to eliminate problems
  • 64.
    21 Explain the“forming” in team dynamics • The team forming happens when the team first meets each other. • In the first meeting, they get introduces to each other and get to know their backgrounds, experience, and area of expertise. • The team members discuss the project, consider the project objectives and begin to think about their role in the project
  • 65.
    22 What is WorkBreakdown Structure (WBS), and how does it affect the work estimates of tasks/activities? • Work Breakdown Structure (WBS) is a hierarchal replica of all the work in the project • WBS helps in organizing the team’s work into manageable sections • The structure includes additional details that help define the tasks and helps in more accurate estimation of time and effort
  • 66.
    23 What ismeant by the term SPI? According to PMBOK Guide, the Schedule Performance Index or SPI is a measure of schedule efficiency expressed as the ratio of earned value to planned value SPI = EV/PV
  • 67.
    24 What isthe significance of Agile Project Management? Agile Project Management has been adopted by several types of industries, such as software companies, product development, marketing campaigns, and even in construction companies Some of the reasons that encourage industries to take up the Agile methodology are: High product quality
  • 68.
    24 What isthe significance of Agile Project Management? Agile Project Management has been adopted by several types of industries, such as software companies, product development, marketing campaigns, and even in construction companies Some of the reasons that encourage industries to take up the Agile methodology are: High customer satisfaction
  • 69.
    24 What isthe significance of Agile Project Management? Agile Project Management has been adopted by several types of industries, such as software companies, product development, marketing campaigns, and even in construction companies Some of the reasons that encourage industries to take up the Agile methodology are: Reduced risk
  • 70.
    24 What isthe significance of Agile Project Management? Agile Project Management has been adopted by several types of industries, such as software companies, product development, marketing campaigns, and even in construction companies Some of the reasons that encourage industries to take up the Agile methodology are: Better and faster ROI
  • 71.
    25 What isthe significance of Agile Project Management? Agile Project Management frameworks involve continuous planning and testing. There are different frameworks each of them having their own unique qualities The most popular Agile frameworks are: Kanban framework Kanban framework is used to implement agile software development and requires real-time communication. Work items are represented on a Kanban board, allowing team members to see the state of each work at any time
  • 72.
    25 What isthe significance of Agile Project Management? Agile Project Management frameworks involve continuous planning and testing. There are different frameworks each of them having their own unique qualities The most popular Agile frameworks are: Scrum framework Scrum framework helps in dealing with complex problems and making it possible to deliver high- quality products at the same time. It helps in managing complex, advanced work with a little emphasis on software development
  • 73.
    25 What isthe significance of Agile Project Management? Agile Project Management frameworks involve continuous planning and testing. There are different frameworks each of them having their own unique qualities The most popular Agile frameworks are: Hybrid framework Hybrid framework is a combination of Agile methods with non-Agile methods. Hybrid can handle requirement changes, and it can deliver product in stages. In hybrid, planning is done using a waterfall approach, while the agile approach handles execution and delivery H Y B R I D
  • 74.
    25 What isthe significance of Agile Project Management? Agile Project Management frameworks involve continuous planning and testing. There are different frameworks each of them having their own unique qualities The most popular Agile frameworks are: Lean framework The lean framework works on the concept of maximizing customer value with fewer resources and zero waste. Hence, lean focuses on the flow of products and services instead of focusing on separate technologies. Companies can act upon with changing customer needs and requirements Empower the team Deliver Fast Optimize the whole process Build Quality Defer Decisions Amplify Learnings Lean Eliminate waste
  • 75.
    26 Why doesa Project Manager need to be proactive? A proactive project manager is actively able to determine the several communication needs of the stakeholders A proactive project manager is able to identify the risks in the early stages of the project
  • 76.
    27 What doesa critical path method imply? • Critical Path Method (CPM) is a crucial tool for determining the progress of the project to ensure that the project is on schedule • Critical Path Method helps in determining the essential or critical path by finding out the longest stretch of dependent tasks
  • 77.
    28 What doesa critical path method imply? • Critical Path Method (CPM) is a crucial tool for determining the progress of the project to ensure that the project is on schedule • Critical Path Method helps in determining the essential or critical path by finding out the longest stretch of dependent tasks
  • 78.
    28 Define plannedvalue, actual cost and earned value. Planned Value • Planned Value is the approved value of the work that needs to be completed within a period • It serves as a baseline and needs to be calculated before work can be started • It is also known as Budgeted Cost of Work Scheduled • Formula: • PV = (Planned percentage of work completed) x project budget
  • 79.
    28 Define plannedvalue, actual cost and earned value. Actual Cost • Actual cost is the value of the total expenses that you have incurred for the work done till date • It is also knowns as the Actual Cost of Work Performed • It is used to calculate cost variance and cost performance index
  • 80.
    28 Define plannedvalue, actual cost and earned value. Earned Value • Earned Value represents the value produced by a project • It is also known as Budgeted Cost of Work Performed • Formula: Earned Value = (Percentage of work completed) x Project budget
  • 81.
    29 What isthe purpose of a procurement management plan? • The procurement management plan defines the procurement requirements and how it can be managed, from developing a procurement documentation through to contract closure • The plan identifies and defines the items that need to be procured, the contracts that need to be used for supporting the project, how the contract is approved and criteria for decisions to be made
  • 82.
    29 What isthe purpose of a procurement management plan? • The plan also includes other items including considerations for procurement risks and procurement risk management, deciding how costs need to be determined, standard procurement documentation usage and constraints to procurement
  • 83.
    30 • A projectpost-mortem or project retrospective refers to a process that’s performed at the conclusion of a phase (for a multi-stage project) • These aim to help identify process improvements that can prevent future risks and to ensure best practices are repeated When is post-mortem analysis performed in project management?
  • 84.
    30 • Post-mortems involvea combination of quantitative and qualitative data. • It also includes qualitative data like end-user, stakeholder and team satisfaction, potential for reuse, and the quality of end-deliverable that is perceived When is post-mortem analysis performed in project management?
  • 85.
    31 • A riskregister is tool that is used to document risks, and the actions taken to handle each one of them. • The management of risk is an ongoing process that has the project team raising risks with the risk manager/ project manager, who then logs the risk and determines an appropriate course of action to handle the risk What is the purpose of a risk register?
  • 86.
    31 • The riskregister also needs to reviewed regularly to ensure the appropriate actions are performed. It could be reviewed in every project team meeting, or at the end of each phase of the project lifecycle What is the purpose of a risk register?
  • 87.
    32 • A Ganttchart is a visual view of tasks scheduled over a period. A Gantt chart is useful for outlining all the tasks involved in a project, along with their order shown against a timescale. • It provides an overview of a project, its associated tasks and when they need to be finished When do we use a Gantt Chart?
  • 88.
    32 • A Ganttchart is helpful because: • It provides a detailed view of all tasks, and ensures you can create a workable schedule, and that the right people are assigned to right task • It can be used to determine the practical aspects of the project • It enables you to keep your team and sponsors informed about your progress When do we use a Gantt Chart?
  • 89.
    33 • CPM orCritical Path Method is a tool that’s used to schedule project activities • CPM is used to create a model that includes: • Tasks required to complete the project • Dependencies between tasks • The duration required to complete an activity • The critical path is the longest path in all the available paths in a project and the duration of the critical path will be the minimum time required by the project. What’s the significance of the critical path method?
  • 90.
    34 What are sometools required for arriving at improvement in processes? Process improvement comprises a set of actions implemented by a company to enhance performance, cost reduction, increasing profits, etc. Here are some tools some companies can use to implement a successful process improvement strategy: • Comparing and baselining a project: With this we can get an overview of how the process is performing in comparison to other similar processes
  • 91.
    34 What are sometools required for arriving at improvement in processes? Process improvement comprises a set of actions implemented by a company to enhance performance, cost reduction, increasing profits, etc. • Flow charting: It helps them segregate the processes, activities, events, etc. • Value stream mapping: It helps clearly understand the workflow and helps organization identify waste
  • 92.
    34 What are sometools required for arriving at improvement in processes? Process improvement comprises a set of actions implemented by a company to enhance performance, cost reduction, increasing profits, etc. • Cause and effect analysis: These help organizations determine the root cause of any problem • Hypothesis testing: Testing to determine whether a hypothesis would be favorable to the organization or not
  • 93.
    35 How doyou work with the three-point estimation method? The three-point estimation method is a tool that can be used to help increase the accuracy of cost and time estimates. There are three parts with different estimates: • Optimistic estimate: It is the amount of time required to complete the project (assuming it goes according to plan)
  • 94.
    35 How doyou work with the three-point estimation method? • The pessimistic estimate: It’s the worst-case scenario and is an estimate given if everything goes wrong • Most likely estimate: It’s what is most likely to happen and falls between the pessimistic and optimistic estimates
  • 95.
    36 What doyou understand by RAID? A RAID log is a project management tool that tracks risks, actions, issues and decisions. It provides a simple way to organize this information Here are some the main advantages of a RAID log: • It enables you to think in an organized and strategic way • The RAID log has all the questions that could be asked by stakeholders • The data is easily accessible and acts as a measure for how well your plans are being carried out
  • 96.
    36 What doyou understand by RAID? A RAID log is a project management tool that tracks risks, actions, issues and decisions. It provides a simple way to organize this information • The RAID log makes the process of decision- making more consistent. It provides a place where all decisions made can be captured
  • 97.
    37 What aresome techniques used for defining scope? Here are some tools and techniques to define scope: • Expert judgement: It requires you to bring in experts on the domain • Product analysis: You need to break down your final deliverable into smaller components to ensure all the steps are being taken
  • 98.
    37 What aresome techniques used for defining scope? • Alternative generation: You need to brainstorm for the best and most effective way to created your product • Facilitated workshops: These allow different people with different ideas to find common ground for a project
  • 99.
    38 What iswaterfall model? • Waterfall model is a project management approach in which a project is completed in several phases • A big plan is executed linearly expecting there would not be any changes in the plan • Waterfall model in contrast to Agile model does not respond well to frequent changes
  • 100.
    39 On what basiswould you decide if a particular risk should be avoided or mitigated? • The risks which are having high impact (negative) to the business are avoided by the organizations usually. • Considering something which will have high negative impact may not be worthwhile to take up. • Once the organization considers to take up after identifying and analysing the risks, then organization would work on risk responses plan, for the risks identified
  • 101.
    40 What isEVM, earned value management? • Earned value management (EVM) is a project management technique that is used to measure the project progress • It calculates the project performance and progress by combining constraints like time, scope, and costs
  • 102.
    41 What is thedifference in Product life cycle and Project life cycle? Project life cycle refers to sequence of phases that a project undergoes in the from its initiation to its closure There five process groups defines the process to be followed in project life cycle 1. Initiation 2. Planning 3. Execution 4. Monitoring and controlling 5. Closure Product life cycle includes all the phases that define the growth of a product There are four phases: 1. Market Introduction 2. Market Growth 3. Market Maturity 4. Decline and Saturation Stage
  • 103.
    42 Define CMM(Capability Maturity Model) • Capability Maturity Model or CMM is an approach to improve or refine development processes in an organization. • It is an elaborated structure of elements that help in defining the features of an effective process.
  • 104.
    43 What do youknow about triple constraint triangle in project management? The triple constraint theory in project management states that each project has certain boundaries of time, cost, and scope. A change in any of the factor will affect the other two factors
  • 105.
    44 What is aDecision Support System (DSS)? • Decision support system is an information system used in decision making activities in an organization or a business. • It analyzes data sets and extracts information that may be used to solve complex problems and take decisions
  • 106.
    45 How many typesof DSS are there? There are several types of DSS: 1. Data-driven 2. Model-driven 3. Knowledge-driven 4. Document-driven
  • 107.
    46 Productivity: Units ofInput/ Units of output Actual cost: Total cost per time period x Time period Cost variance: Budgeted cost of work – actual cost of work What are some general metrics that are used to calculate if a project is progressing on track?
  • 108.
    46 Schedule variance: Budgetedcost of work performed – budgeted cost of work scheduled Cost performance Index: Earned value/ actual costs What are some general metrics that are used to calculate if a project is progressing on track?
  • 109.
    47 • A projectmilestone provides a way to observe, measure and monitor the performance/ progress of a project • These represent intermediate stages that need to be fulfilled before getting to the final objective or goal • Milestones can provide a basis on which progress can be monitored What is meant by a milestone in a project?
  • 110.
    47 • They canalso proof for explanation while reporting on the project’s status • It can be used to provide course corrections and learning experiences • It can also be used to maintain accountability and motivate staff What is meant by a milestone in a project?
  • 111.
    48 • The activitytime or duration refers to the process of evaluating the number of work periods required to finish individual activities with the resources available • These help achieve the project objectives on set dates and delivery schedules decided by project management team and key stakeholders How can you estimate the “Activity Time” of a project?
  • 112.
    48 Here are sometools and techniques to calculate activity durations: • Expert judgement • Analogous estimation • PERT method • Three-point estimates • Parametric estimating • Alternative analysis • Published estimating data • Vendor bid analysis How can you estimate the “Activity Time” of a project?
  • 113.
    49 What doyou think about CSF in project management? CSF or Critical Success Factors are found in the project management plan and can define what can be defined as success for the project Some characteristics of CSF: • Time: Was the project completed within the given time period? • Cost: Did it stay within the budgeted cost? • Quality: Did it meet the specification level? • Stakeholder: Was the result acceptable by the end users? • Project changes: Were scope changes minimal and/ or agreed upon? • Performing Organization: Did it effect the corporate culture?
  • 114.
    49 What doyou think about CSF in project management? CSF or Critical Success Factors are found in the project management plan and can define what can be defined as success for the project Here are 8 critical success factors: • Commitment is required from team members, clients, top management and all stakeholders • Goals must be SMART (Specific, Measurable, Attainable, Relevant, Time bound) • There must be a process for quick identification and resolution of conflict • Good project leadership is to be established • Risk management policies have to be established
  • 115.
    49 What doyou think about CSF in project management? CSF or Critical Success Factors are found in the project management plan and can define what can be defined as success for the project • There must be proper project planning that needs to be done • Best practices need to be applied at all stages • Proper communication must take place to ensure information is passed across
  • 116.
    50 What doyou understand by the term ‘SOW’? SOW or Statement of Work, is document that includes and defines each aspect of the project. It is the foundation for the project plan • Intro • Purpose • Scope • Where • Tasks • Milestones • Deliverable • Schedule • Standards • Success • Requirements • Others • Close Before planning an executing, the SOW lays down the entire landscape of the project A SOW consists of:
  • 117.
    50 What doyou understand by the term ‘SOW’? SOW or Statement of Work, is document that includes and defines each aspect of the project. It is the foundation for the project plan A SOW can be of 3 categories: • Design/ Detail • Level of effort/ time and materials: Defines an hourly service and the materials required to perform the tasks • Performance based: Focuses on the purpose of the project, resources and quality expected from the output
  • 118.
    51 What isa fishbone diagram and when is it used? A fishbone diagram, also called Ishikawa diagram is a visualization tool that’s used to categorize potential causes (problems) for an issue, to identify their root causes • It is used in product development and troubleshooting processes, • The team brainstorms for potential causes, and then represents them in the diagram based on their degrees of importance Goal/ Problem
  • 119.
    51 What isa fishbone diagram and when is it used? Here’s when the diagram is used: • To identify the possible causes of an issue • To develop a product that can address issues with current market offerings • To reveal areas of weakness or bottlenecks in the business process • To handle reoccurring issues or employees burning out • To ensure any correction will resolve the issue Goal/ Problem A fishbone diagram, also called Ishikawa diagram is a visualization tool that’s used to categorize potential causes (problems) for an issue, to identify their root causes
  • 120.
    52 What isthe Pareto principle or 80/20 principle? • The pareto principle states that 80% of consequences come from 20% of the causes, indicating an unequal relationships between inputs and outputs • It can be applied to a range of areas like manufacturing, management and human resources • It is usually focused on businesses that are client-based 20 80
  • 121.
    52 What isthe Pareto principle or 80/20 principle? • Some of the advantages of the pareto principle are: • Increase productivity • Increased profitability • Identify and fix problems • Improved customer service 20 80
  • 122.
    53 Can youtell us about your past projects? Discuss the following points: • Objective of the project • Project deliverables • Your roles & responsibilities in the project & what have you achieved. • What was accomplished..! (what went well and what did not) • Project duration, budget, actual cost This question is open and generic in nature, while answering such questions following points has to be considered;
  • 123.
    54 If the customeris not happy with the project, what will you do as a project manager? One has to ensure: • Understanding the reason for dissatisfaction • Are all the requirements fulfilled • Was customer involved in all decision making activities etc., Note: Before customer is dissatisfied, it is very important to be with customer to understand the customer pulse and handling the stakeholder accordingly. Customer satisfaction is very important to ensure the success of a project. In the scenario where customer express their dissatisfaction;
  • 124.
    55 What are thedifferent kinds of projects you have worked upon? Discuss the following points: • Domains of the project • Project deliverables • Project’s nature & complexity • Unique challenges in each different type of project • Project duration, budget, actual cost This question is open and generic in nature, while answering such questions following points has to be considered;
  • 125.
    56 Did you everface a situation where the project team was demotivated and what did you do to bring them back on track? Following points has to be kept in mind while dealing with team: • Team engagement (both formal & informal) • Rewards & Recognition • Conflict Management • Performance evaluation & mentoring • Education & Training Opportunities etc., Project team plays very important role in success of a project. It is very critical to keep them motivated. The demotivation may happen for various reason.
  • 126.
    57 If you getyour dream job, and I assume this is your dream job, what value you think you will be adding to the organization? Discuss the following points: • Why the job is your dream job • What would be your motivation point in this dream job • How this dream job can link to objectives of organization & your profession • Road map of that job role. This question is open and generic in nature, while answering such questions following points has to be considered;
  • 127.
    58 What challenges haveyou encountered while dealing with other team members? Some of the important changing scenarios would be: • Team not collaborating • Individual preferences and motivation • Role preference and allocated role • Performance Appraisal • Communication gaps etc., Project team plays very important role in success of a project. Each team member comes with the different skills, maturity mindsets & background which put across many challenges
  • 128.
    59 Share from yourexperience the challenges you faced while using project management tools Some of the challenges one would face while using the tools are: • Selection of right tools for the given project • Tools features and functionality • Customization of tools • The dashboards & reports • Team’s ability to work with tools etc., The effective management of Project requires an efficient tool. Every tools has it’s own uniqueness & has it’s own advantages & disadvantages
  • 129.
    60 Can you tellme about the most difficult/ complex project you have worked on? Discuss the following points: • What was the complexity in the project? • Why do you consider that project as complex or difficult? • What was the size of the project in terms of deliverables, budget, geography, team, tool & techniques etc., • Was that project successful or not!? This question is open and generic in nature, while answering such questions following points has to be considered;
  • 130.
    61 When doyou know the project is off-track? Following helps us to understand weather project is in track of not; • When SPI & CPI are < 1 (SPI is < 1, indicates, project is behind the schedule, where as, CPI < 1, project is over budget) • Similarly, the results of audits & testing done as part of quality management also reveals the details related to compliance & off-specification which needs to be corrected if they are not as expected. Every project will have the set plans based on which project have to be completed successfully. Due to various different scenarios project go of-track. Recognizing and correcting those is very critical;
  • 131.
    62 In the past,what metrics did you use to find out if the project was on track or not? What did you do to rectify it? Not required to answer this as it is already covered in Q.61
  • 132.
    63 How do youmanage team members that aren’t working to their full potential? Not required to answer this as it is already covered in Q.58
  • 133.
    64 Have youmanaged remote teams and outsourced resources? While managing the recourses who are remote or outsourced; • It is required to engage with the team more often • The performance of the team member has to be well known to the reporting manager & that needs to be communicated regularly This question comes from the scenario where you have to manage the team not reporting to you directly & they are managed by different individual. While having such resources the dynamics will be different.
  • 134.
    65 If you couldgo to the past and do one thing differently as a project manager, what would you do and why? While answering this question following point has to be kept in mind; • What went well & what did not? • Why do you think they happened and what would have been the better solution? • Why do you think it could have been done better? • Why did you not do it earlier, the way you are thinking the right way of doing it today. Every Project manager who has managed several project earlier, will think of doing better which they have done already. This is because of the experience they had while doing that project and the insight they have today.
  • 135.
    66 As a projectmanager, what is the most common challenge that you face? Following are the typical challenges; • Not clearly defined scope. • No proper sign off between customer and project organization • Deadlines / Schedules are not realistic • Cost / Budget allocated is very low • Team capability & skills • Project Environment etc., Every project will have various challenges to deal with. Project manager has to prepare themselves to handle those;
  • 136.
    67 Can you describea situation where the client was unhappy? Why was he happy and how did you fix it? Not required to answer this as it is already covered in Q.54
  • 137.
    68 Can you describea situation where the client was unhappy? Why was he happy and how did you fix it?
