When done right, testing is more than test plans, test scripts, and executing tests. In fact a test leader should consider testing a sub-project of the larger development project. By applying the same techniques project managers use to plan and manage the overall project, test leaders can improve testing and greatly influence the entire project’s success. Ricki Henry explores project management processes that test leaders need to master—risk management, human resources, stakeholder communications, and scope management. Even though you understand that the scope of testing cannot be “everything tested with zero defects,” the customer does not have this same understanding. To prevent this disconnect, test leaders need to determine the scope of what can be tested and then articulate that to the stakeholders. Join Ricki to learn new ways to improve testing while contributing to overall project success through project management processes that test leaders need to master.
2. Who am I?
• Started professional life as a programmer, then
• Sr. programmer, and Lead programmer.
• As a lead programmer at American Express began
managing projects and have been a project manager
ever since.
• PMP (Project Management Professional) certified and
a Certified Scrum Master (Scrum is an agile
methodology)
• Formed the PMO (Project Management Office) where
I work at Clark County Nevada where I also run the
Project Management Workshops
• Currently the VP of Education for my local PMI
(Project Management Institute) chapter
• Frequent presenter at conferences and on webinars
2

5. Successful Test Managers
5
Understand stakeholder goals and benefits
Work with the customer to formulate
testing goals and approaches
Contribute to the overall project planning
7. Customer Expectations
7
Project success is measured against project
objectives
What objectives do stakeholders have for
testing?
What objectives will you be able to deliver?

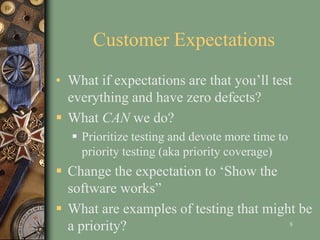

8. Customer Expectations
• What if expectations are that you’ll test
everything and have zero defects?
What CAN we do?
Prioritize testing and devote more time to
priority testing (aka priority coverage)
Change the expectation to ‘Show the
software works”
What are examples of testing that might be
a priority? 8

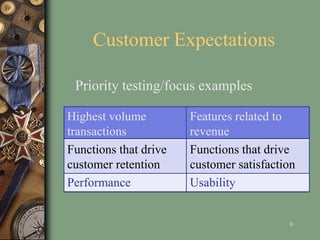

10. Customer Expectations
• Using the priority testing/focus you
identified, formulate goal statements for
testing
• Include these goals in the Project Charter
10
11. Customer Expectations
• A goal is what you want to achieve
• It must be accomplishable and measureable
11

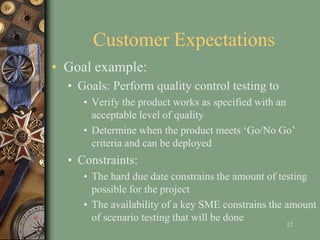

12. Customer Expectations
• Goal example:
• Goals: Perform quality control testing to
• Verify the product works as specified with an
acceptable level of quality
• Determine when the product meets ‘Go/No Go’
criteria and can be deployed
• Constraints:
• The hard due date constrains the amount of testing
possible for the project
• The availability of a key SME constrains the amount
of scenario testing that will be done
12
13. Customer Expectations
• Sample Beta Testing Goals
• Get feedback from the users on customer
experience
• Assess stability and reliability of the application
• Assess full deployment readiness
• Assess performance
• Collect testimonials or case studies
13
14. Test Scope
• List what’s in and out of scope for testing
An example of in scope would be
oThe most common logic paths
oAll APIs
oIE9, IE10, Chrome and Foxfire browsers
An example of out of scope would be
oLogic paths not on the list of commonly used paths
oSafari Browser
oRegression testing for modules not being modified
14

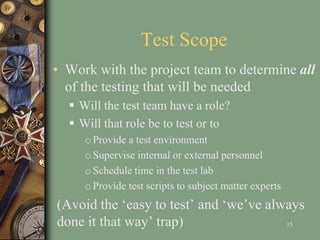

15. Test Scope
• Work with the project team to determine all
of the testing that will be needed
Will the test team have a role?
Will that role be to test or to
o Provide a test environment
o Supervise internal or external personnel
o Schedule time in the test lab
o Provide test scripts to subject matter experts
(Avoid the ‘easy to test’ and ‘we’ve always
done it that way’ trap) 15

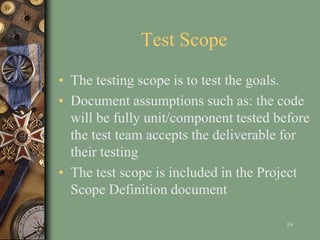

16. Test Scope
• The testing scope is to test the goals.
• Document assumptions such as: the code
will be fully unit/component tested before
the test team accepts the deliverable for
their testing
• The test scope is included in the Project
Scope Definition document
16

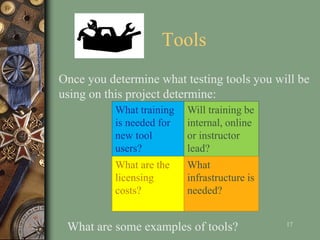

17. Tools
Once you determine what testing tools you will be
using on this project determine:
17
What training
is needed for
new tool
users?
Will training be
internal, online
or instructor
lead?
What are the
licensing
costs?
What
infrastructure is
needed?
What are some examples of tools?

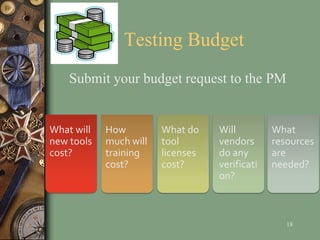

18. Testing Budget
18
Submit your budget request to the PM
What will
new tools
cost?
How
much will
training
cost?
What do
tool
licenses
cost?
Will
vendors
do any
verificati
on?
What
resources
are
needed?
19. • Number of instances needed
• Use of same test tools as developers
• Project risk identification
• “What if” conditions during requirements
• Participate in requirements
19
QA Included Early
Include testers in the early phases to give
input on:
20. QA Included Early
• Help define defect severity
• Help formulate ‘Go/No Go’ criteria
• Help define the defect/fix/retest process
• Help define how change control will work
20

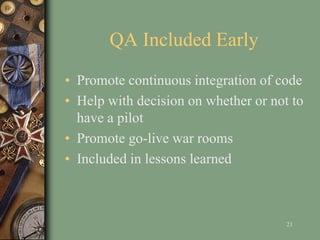

21. QA Included Early
• Promote continuous integration of code
• Help with decision on whether or not to
have a pilot
• Promote go-live war rooms
• Included in lessons learned
21

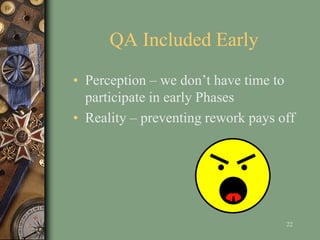

22. QA Included Early
• Perception – we don’t have time to
participate in early Phases
• Reality – preventing rework pays off
22
23. Nothing new
for most of
you
Test plans are
included in
project plans
Determine
types of
testing
Planning
24. Planning
• Document the business value of each type
of testing in your plan
• Document the approach to testing, e.g.
Test cycles
Who will test (you, SMEs, developers, BAs?)
Test early and often (code is delivered often)
NOTE: we’re planning now, not writing test
scripts
24

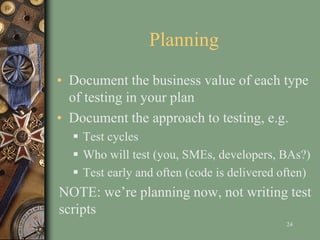

25. Planning
• Include anything that reduces test time
without reducing quality of testing, e.g.
Multiple instances for simultaneous testing
Check QA team for ideas from lessons learned
• Send completed plan to the PM for
inclusion in the Project Management Plan
25
26. Planning
• Human Resource planning
What skills and knowledge do you need to
perform the tests you identified?
Who will be assigned to the project?
What is their availability
• Write test cases as soon as possible in the
project [See V-model]
26

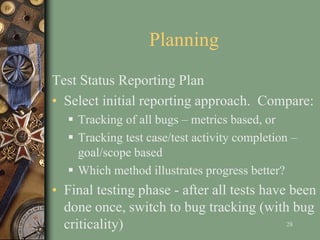

28. Planning
Test Status Reporting Plan
• Select initial reporting approach. Compare:
Tracking of all bugs – metrics based, or
Tracking test case/test activity completion –
goal/scope based
Which method illustrates progress better?
• Final testing phase - after all tests have been
done once, switch to bug tracking (with bug
criticality) 28
31. Scheduling
• Identify all touchpoints
Marketing, training, user documentation all
need final screens/reports to do their job
How does your test schedule align with the
needs of these departments
• Your test schedule needs to be integrated
into the overall project schedule
Work with the PM if there are any resource
conflicts (often happens with use of SMEs)
31

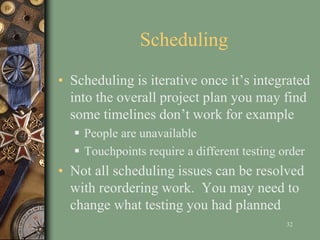

32. Scheduling
• Scheduling is iterative once it’s integrated
into the overall project plan you may find
some timelines don’t work for example
People are unavailable
Touchpoints require a different testing order
• Not all scheduling issues can be resolved
with reordering work. You may need to
change what testing you had planned
32
34. Risk Management
What’s a risk?
“An uncertain event or condition that, if it
occurs, has a positive or negative effect on
one or more project objectives.”
PMBOK
34
35. Risk Management
• Risk Management is about events, not
effects
• There can be multiple events that have the
same effect.
• Each event is a risk that needs to be
managed
35

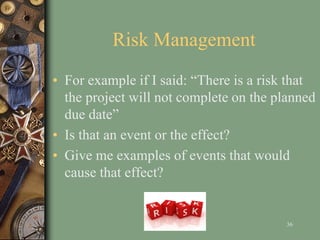

36. Risk Management
• For example if I said: “There is a risk that
the project will not complete on the planned
due date”
• Is that an event or the effect?
• Give me examples of events that would
cause that effect?
36

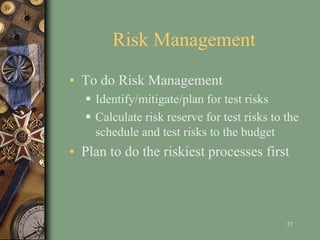

37. Risk Management
• To do Risk Management
Identify/mitigate/plan for test risks
Calculate risk reserve for test risks to the
schedule and test risks to the budget
• Plan to do the riskiest processes first
37

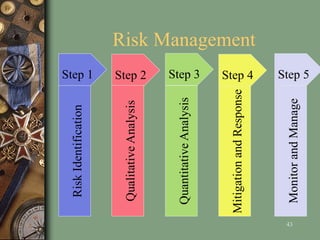

44. Risk Identification
• Risk Identification tools
Checklist of inherent risks (e.g. It’s inherently
risky to not have an instance that mirrors
production)
Lessons learned from prior projects
Problem root cause analysis techniques
Mind mapping
• Determine critical success factors then see
if they present any risks 44
45. Qualitative Risk Analysis
• Qualitative risk analysis
How likely is the risk to occur?
What impact will it have if it occurs?
How critical of a risk is it?
• Use subject matter expertise and a common
scale to determine the qualities of each risk
45

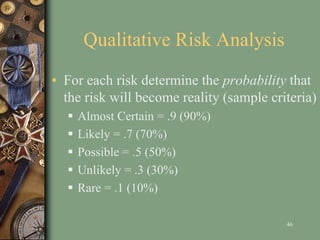

46. Qualitative Risk Analysis
• For each risk determine the probability that
the risk will become reality (sample criteria)
Almost Certain = .9 (90%)
Likely = .7 (70%)
Possible = .5 (50%)
Unlikely = .3 (30%)
Rare = .1 (10%)
46
47. Qualitative Risk Analysis
• For each risk determine the impact to the testing
schedule, testing cost or deliverable quality
(sample scale):
1 = insignificant impact
2 = Minor impact
3 = Moderate impact
4 = Major impact
5 = Extreme impact
47
48. Qualitative Risk Analysis
• Sample Scale
• 1 = insignificant impact: Little to no schedule
or cost variance and quality degradation barely
noticeable.
2 = Minor impact: < 5% schedule or cost
impact, or only minor quality degradation
3 = Moderate impact: 5 – 10 % increase in time
or cost, or quality reduction requires OK from
the project risk approver(s)
48
49. Qualitative Risk Analysis
• Sample Scale, continued
4 = Major impact: 10 – 20 % increase in time or
cost, or quality unacceptable to the project risk
approver(s)
5 = Extreme impact: The entire project needs
to be reevaluated and probably terminated.
49

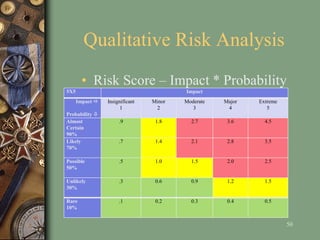

50. Qualitative Risk Analysis
• Risk Score – Impact * Probability
50
5X5 Impact
Impact
Probability
Insignificant
1
Minor
2
Moderate
3
Major
4
Extreme
5
Almost
Certain
90%
.9 1.8 2.7 3.6 4.5
Likely
70%
.7 1.4 2.1 2.8 3.5
Possible
50%
.5 1.0 1.5 2.0 2.5
Unlikely
30%
.3 0.6 0.9 1.2 1.5
Rare
10%
.1 0.2 0.3 0.4 0.5
51. Qualitative Risk Analysis
• Criticality
The matrix shows all of the possible risk scores
and categorizes them as:
Risk Category 1 (Red) = Score 2.0-4.5
Risk Category 2 (Yellow) = Score of 1.0-1.8
Risk Category 3 (Green) = Score of .1-.9
51

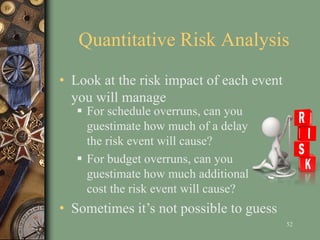

52. Quantitative Risk Analysis
For schedule overruns, can you
guestimate how much of a delay
the risk event will cause?
For budget overruns, can you
guestimate how much additional
cost the risk event will cause?
52
• Sometimes it’s not possible to guess
• Look at the risk impact of each event
you will manage
53. Quantitative Risk Analysis
• When it is possible to guestimate
Multiply each risk’s impact guestimate times
that risk event’s probability
Risk reserve for schedule and budget
For identified risks: Sum all of the calculations
For unknown risks: Add a percentage based on
experience
53

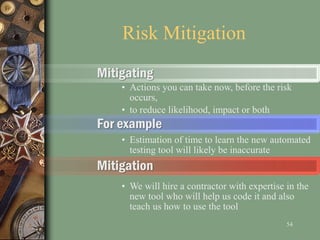

54. Mitigating
• Actions you can take now, before the risk
occurs,
• to reduce likelihood, impact or both
For example
• Estimation of time to learn the new automated
testing tool will likely be inaccurate
Mitigation
• We will hire a contractor with expertise in the
new tool who will help us code it and also
teach us how to use the tool
Risk Mitigation
54

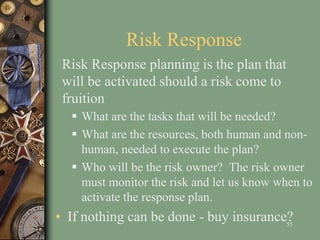

55. Risk Response
What are the tasks that will be needed?
What are the resources, both human and non-
human, needed to execute the plan?
Who will be the risk owner? The risk owner
must monitor the risk and let us know when to
activate the response plan.
• If nothing can be done - buy insurance?55
Risk Response planning is the plan that
will be activated should a risk come to
fruition
56. Risk Monitoring
• Risk logs are great tools for monitoring
your risks, for example keep a log with this
information:
ID, Title, Description, Event
Impact, Probability, Score, Criticality
Owner, Status, Mitigation, Response Plan
56
57. 57
Continuous Process Improvement
Don’t wait
until the end
of testing to
hold lessons
learned
sessionst
Identify
problems and
opportunities
early
Apply
lessons
learned
immediately
58. Conclusion
• Software testing is a critical element in the
software development life cycle
• Everyone involved should be familiar with
the testing goals, planned approaches, and
constraints
• By adopting project management processes
you will set yourself apart – a cut above the
rest
58
59. Check this out
• A good tool to help with planning is from
HARBORLIGHT Management Services:
Project Management for Software Testers
http://www.harborlightmanagement.com/Pres
entations/EuroSTAR%20PM%20workbook.p
df
59
60.
61. Resources
• ‘How to Avoid 7 Testing Project Problems’ from
www.automatedqa.com/support
• ‘Common Testing Problems: Pitfalls to Prevent and
Mitigate’ by Donald Firesmith, September 12 2012
• Fundamental Challenges in Software Testing, Cem Kaner,
April 2003
• ‘Quality Department Involvement in Project Life Cycle’
Part 1, Marcin Zreda, March 15, 2010
• ‘Quality Department Involvement in Project Life Cycle’
Part 2, Marcin Zreda, March 24, 2010
61
62. Resources
• “Plan your Projects’ Testing – or Plan to Fail”, James F.
York, May 26, 2009
• “Software Testing – Goals, Principles, and Limitations”,
S.M.K. Quadri, September 2010
• “Beta Testing Objectives”, centercode.com
62
