IBM




         What’s the value and how to optimize
         Performance with SSD and IBM i


                                                    Gottfried Schimunek
                                                                          3605 Highway 52 North
                                                    Senior Architect      Rochester, MN 55901
                                                    Application Design
                                                    IBM STG Software      Tel 507-253-2367
                                                    Development           Fax 845-491-2347
                                                    Lab Services
                                                                          Gottfried@us.ibm.com
                                                    IBM ISV Enablement




    Power is performance redefined                              ©2012 IBM Corporation




Acknowledgements


    Thanks to Mark Olson, IBM WW Product Manager for providing
    this comprehensive and detailed presentation




2   Power is performance redefined                          ©2012 IBM Corporation

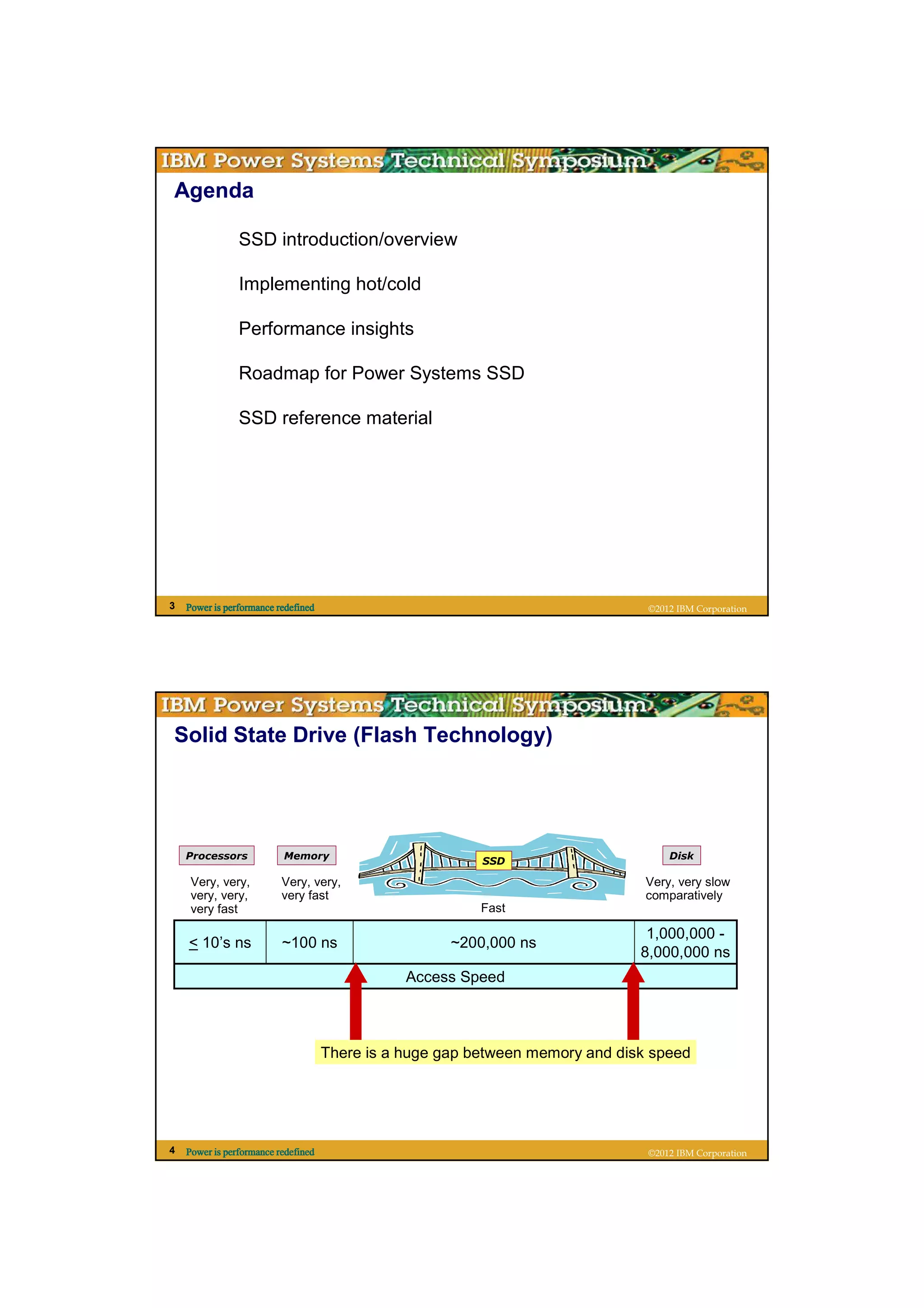

Agenda

                SSD introduction/overview

                Implementing hot/cold

                Performance insights

                Roadmap for Power Systems SSD

                SSD reference material




3   Power is performance redefined                                              ©2012 IBM Corporation




Solid State Drive (Flash Technology)




    Processors            Memory                                                    Disk
                                                          SSD

     Very, very,          Very, very,                                           Very, very slow
     very, very,          very fast                                             comparatively
     very fast                                            Fast

                                                                                1,000,000 -
    < 10’s ns             ~100 ns                     ~200,000 ns
                                                                               8,000,000 ns
                                                Access Speed



                                     There is a huge gap between memory and disk speed




4   Power is performance redefined                                              ©2012 IBM Corporation

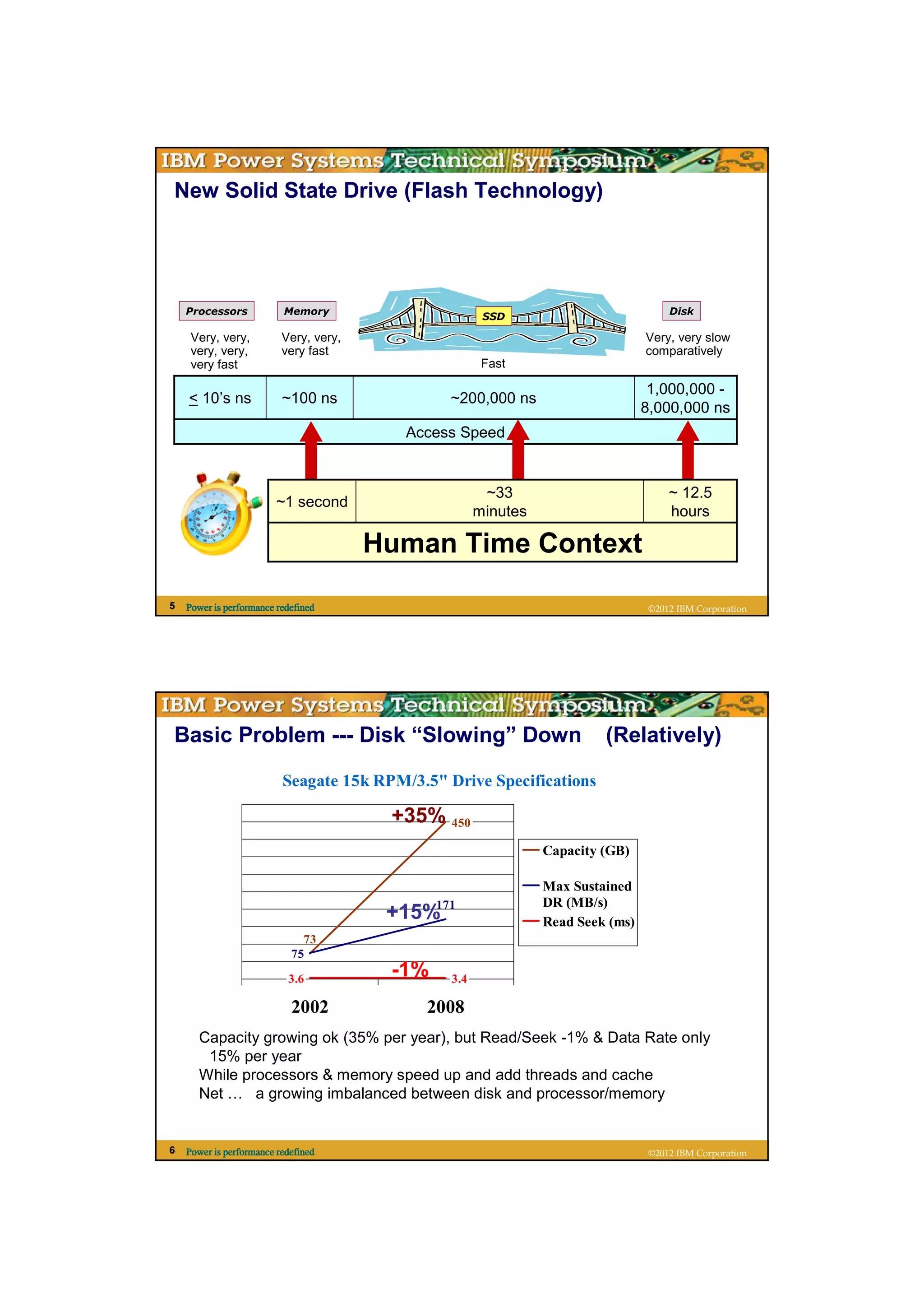

New Solid State Drive (Flash Technology)




    Processors            Memory                                                       Disk
                                                        SSD

     Very, very,          Very, very,                                             Very, very slow
     very, very,          very fast                                               comparatively
     very fast                                          Fast

                                                                                   1,000,000 -
    < 10’s ns             ~100 ns                ~200,000 ns
                                                                                  8,000,000 ns
                                          Access Speed


                                                        ~33                            ~ 12.5
                         ~1 second
                                                       minutes                         hours

                                        Human Time Context

5   Power is performance redefined                                                 ©2012 IBM Corporation




Basic Problem --- Disk “Slowing” Down                                     (Relatively)

                          Seagate 15k RPM/3.5" Drive Specifications

                                         +35% 450
                                                                 Capacity (GB)

                                                                 Max Sustained
                                               171               DR (MB/s)
                                         +15%                    Read Seek (ms)
                              73
                            75

                           3.6
                                         -1%     3.4

                            2002            2008
       Capacity growing ok (35% per year), but Read/Seek -1% & Data Rate only
        15% per year
       While processors & memory speed up and add threads and cache
       Net … a growing imbalanced between disk and processor/memory


6   Power is performance redefined                                                 ©2012 IBM Corporation

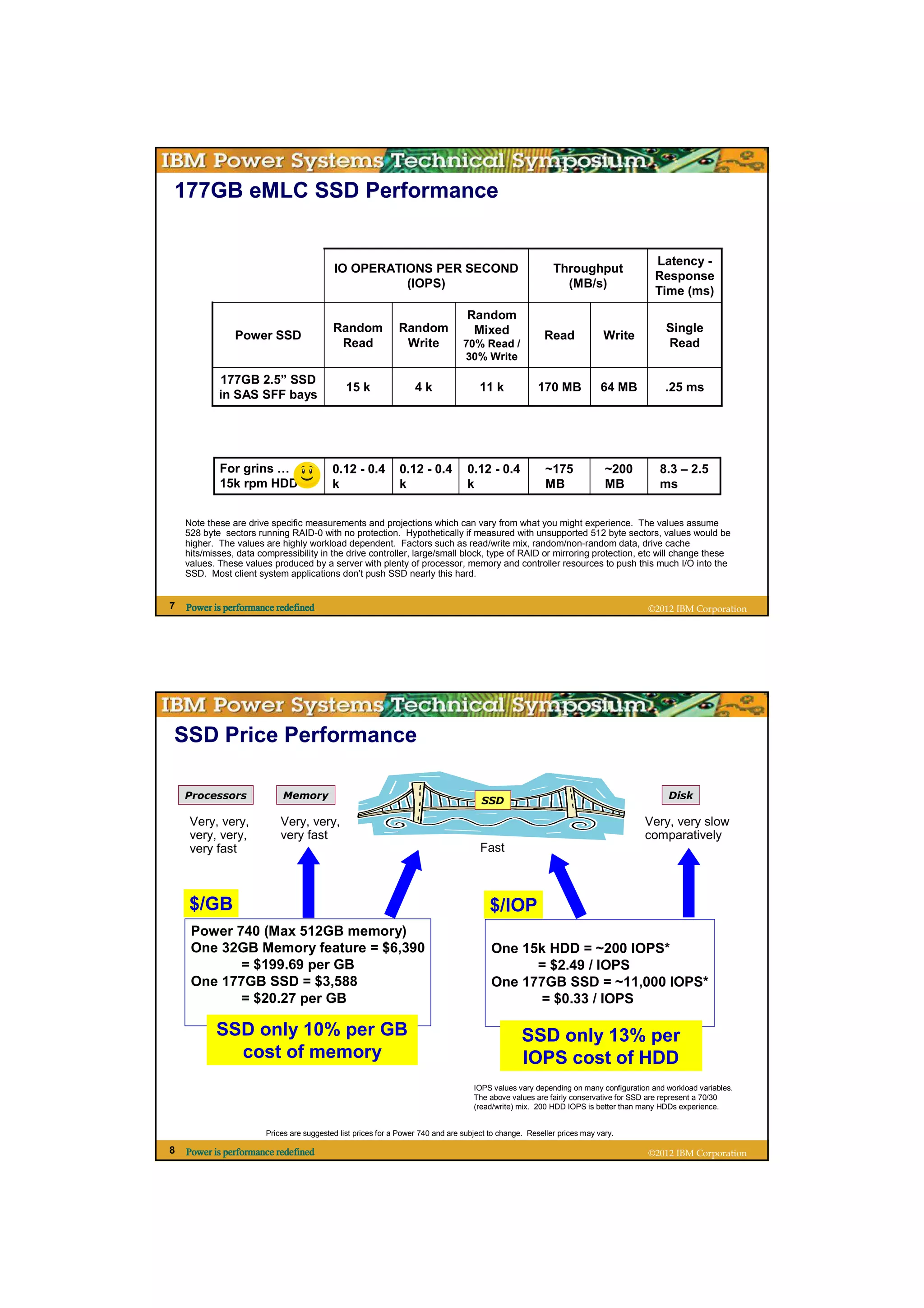

177GB eMLC SSD Performance


                                                                                                                                      Latency -
                                           IO OPERATIONS PER SECOND                                        Throughput
                                                                                                                                      Response
                                                     (IOPS)                                                  (MB/s)
                                                                                                                                      Time (ms)
                                                                                  Random
                                           Random             Random               Mixed                                                 Single
                Power SSD                                                                               Read              Write
                                            Read               Write             70% Read /                                              Read
                                                                                 30% Write

            177GB 2.5” SSD
                                               15 k                4k                 11 k            170 MB             64 MB           .25 ms
            in SAS SFF bays




            For grins …                    0.12 - 0.4         0.12 - 0.4          0.12 - 0.4             ~175             ~200         8.3 – 2.5
            15k rpm HDD                    k                  k                   k                      MB               MB           ms


    Note these are drive specific measurements and projections which can vary from what you might experience. The values assume
    528 byte sectors running RAID-0 with no protection. Hypothetically if measured with unsupported 512 byte sectors, values would be
    higher. The values are highly workload dependent. Factors such as read/write mix, random/non-random data, drive cache
    hits/misses, data compressibility in the drive controller, large/small block, type of RAID or mirroring protection, etc will change these
    values. These values produced by a server with plenty of processor, memory and controller resources to push this much I/O into the
    SSD. Most client system applications don’t push SSD nearly this hard.


7   Power is performance redefined                                                                                                  ©2012 IBM Corporation




SSD Price Performance

    Processors              Memory                                                                                                        Disk
                                                                                      SSD

     Very, very,            Very, very,                                                                                            Very, very slow
     very, very,            very fast                                                                                              comparatively
     very fast                                                                        Fast



     $/GB                                                                                $/IOP
     Power 740 (Max 512GB memory)
     One 32GB Memory feature = $6,390                                                    One 15k HDD = ~200 IOPS*
            = $199.69 per GB                                                                   = $2.49 / IOPS
     One 177GB SSD = $3,588                                                              One 177GB SSD = ~11,000 IOPS*
            = $20.27 per GB                                                                     = $0.33 / IOPS

           SSD only 10% per GB                                                                    SSD only 13% per
             cost of memory                                                                       IOPS cost of HDD
                                                                                    IOPS values vary depending on many configuration and workload variables.
                                                                                    The above values are fairly conservative for SSD are represent a 70/30
                                                                                    (read/write) mix. 200 HDD IOPS is better than many HDDs experience.


                        Prices are suggested list prices for a Power 740 and are subject to change. Reseller prices may vary.

8   Power is performance redefined                                                                                                  ©2012 IBM Corporation

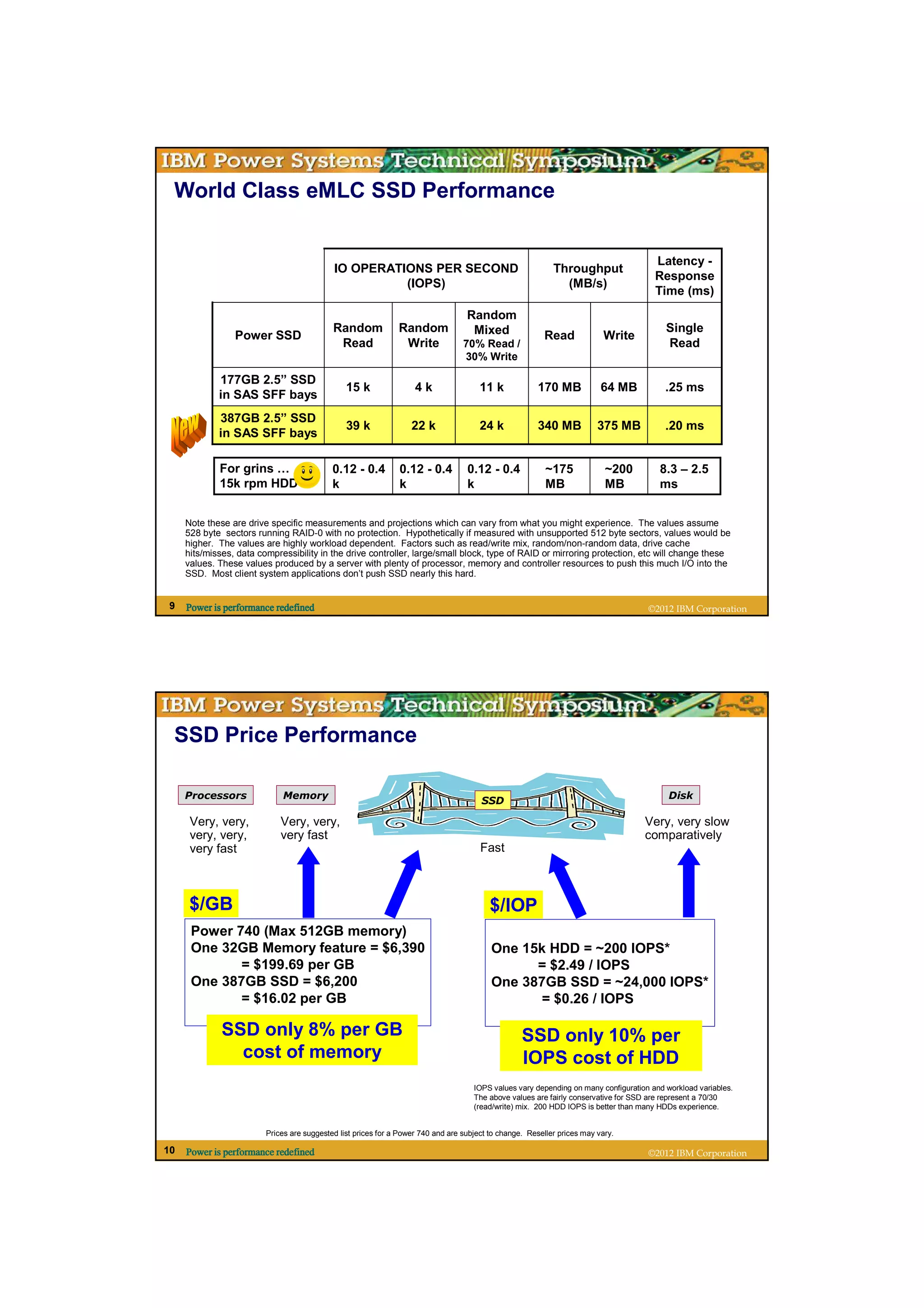

World Class eMLC SSD Performance


                                                                                                                                       Latency -
                                            IO OPERATIONS PER SECOND                                        Throughput
                                                                                                                                       Response
                                                      (IOPS)                                                  (MB/s)
                                                                                                                                       Time (ms)
                                                                                   Random
                                            Random             Random               Mixed                                                 Single
                 Power SSD                                                                               Read              Write
                                             Read               Write             70% Read /                                              Read
                                                                                  30% Write

             177GB 2.5” SSD
                                                15 k                4k                 11 k            170 MB             64 MB           .25 ms
             in SAS SFF bays
             387GB 2.5” SSD
                                                39 k               22 k                24 k            340 MB            375 MB           .20 ms
             in SAS SFF bays

             For grins …                    0.12 - 0.4         0.12 - 0.4          0.12 - 0.4             ~175             ~200         8.3 – 2.5
             15k rpm HDD                    k                  k                   k                      MB               MB           ms


     Note these are drive specific measurements and projections which can vary from what you might experience. The values assume
     528 byte sectors running RAID-0 with no protection. Hypothetically if measured with unsupported 512 byte sectors, values would be
     higher. The values are highly workload dependent. Factors such as read/write mix, random/non-random data, drive cache
     hits/misses, data compressibility in the drive controller, large/small block, type of RAID or mirroring protection, etc will change these
     values. These values produced by a server with plenty of processor, memory and controller resources to push this much I/O into the
     SSD. Most client system applications don’t push SSD nearly this hard.


9    Power is performance redefined                                                                                                  ©2012 IBM Corporation




 SSD Price Performance

     Processors              Memory                                                                                                        Disk
                                                                                       SSD

      Very, very,            Very, very,                                                                                            Very, very slow
      very, very,            very fast                                                                                              comparatively
      very fast                                                                        Fast



      $/GB                                                                                $/IOP
      Power 740 (Max 512GB memory)
      One 32GB Memory feature = $6,390                                                    One 15k HDD = ~200 IOPS*
             = $199.69 per GB                                                                   = $2.49 / IOPS
      One 387GB SSD = $6,200                                                              One 387GB SSD = ~24,000 IOPS*
             = $16.02 per GB                                                                     = $0.26 / IOPS

              SSD only 8% per GB                                                                   SSD only 10% per
                cost of memory                                                                     IOPS cost of HDD
                                                                                     IOPS values vary depending on many configuration and workload variables.
                                                                                     The above values are fairly conservative for SSD are represent a 70/30
                                                                                     (read/write) mix. 200 HDD IOPS is better than many HDDs experience.


                         Prices are suggested list prices for a Power 740 and are subject to change. Reseller prices may vary.

10   Power is performance redefined                                                                                                  ©2012 IBM Corporation

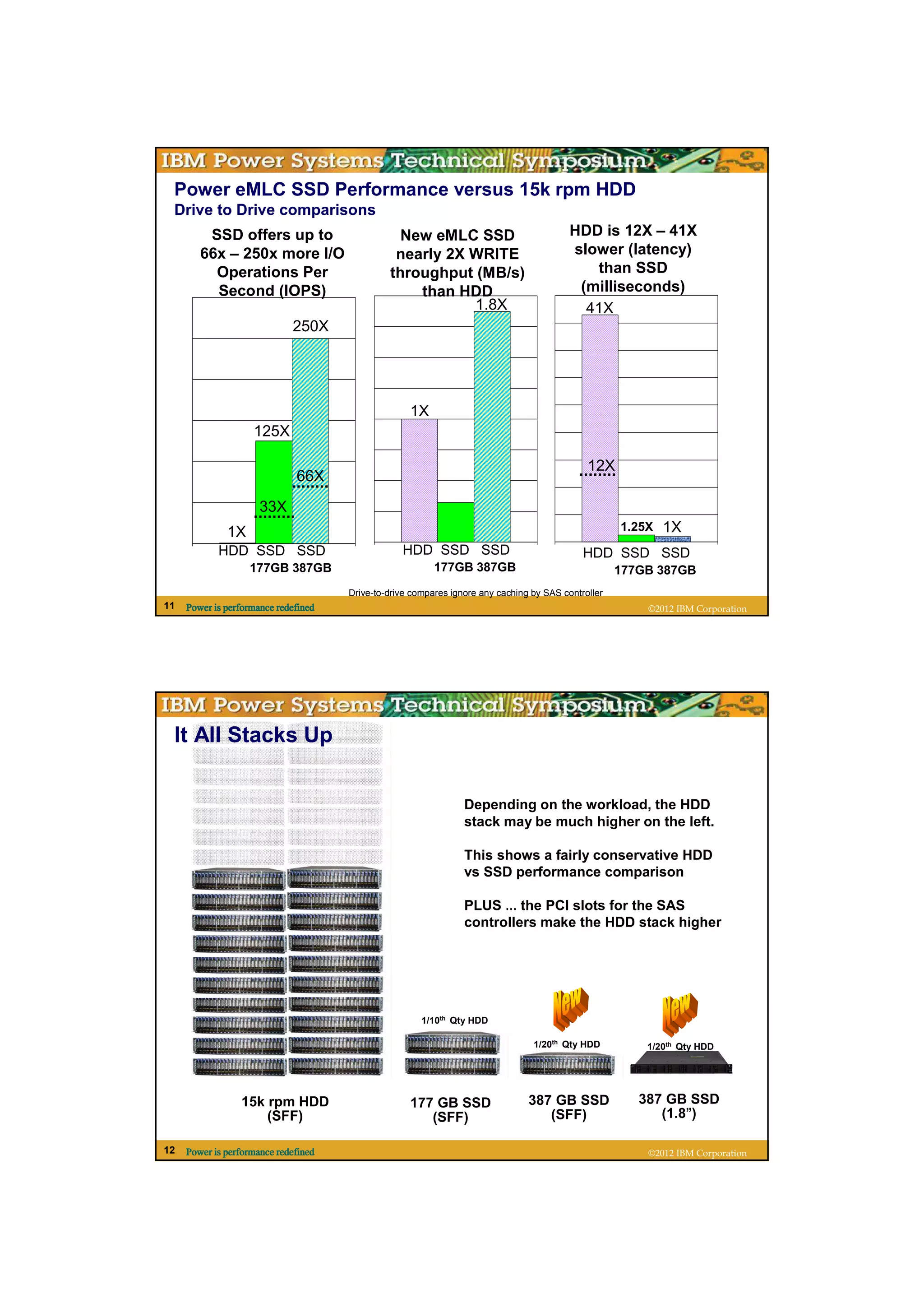

Power eMLC SSD Performance versus 15k rpm HDD
 Drive to Drive comparisons
         SSD offers up to                        New eMLC SSD                             HDD is 12X – 41X
        66x – 250x more I/O                     nearly 2X WRITE                           slower (latency)
          Operations Per                       throughput (MB/s)                             than SSD
          Second (IOPS)                            than HDD                                (milliseconds)
                                                          1.8X                              41X
                             250X




                                                    1X
                    125X

                                                                                              12X
                              66X
                      33X
              1X                                                                                     1.25X   1X
            HDD SSD SSD                           HDD SSD SSD                                HDD SSD SSD
                   177GB 387GB                            177GB 387GB                                177GB 387GB
                                      Drive-to-drive compares ignore any caching by SAS controller
11   Power is performance redefined                                                                      ©2012 IBM Corporation




 It All Stacks Up


                                                                 Depending on the workload, the HDD
                                                                 stack may be much higher on the left.

                                                                 This shows a fairly conservative HDD
                                                                 vs SSD performance comparison

                                                                 PLUS … the PCI slots for the SAS
                                                                 controllers make the HDD stack higher




                                                       1/10th Qty HDD

                                                                                 1/20th Qty HDD          1/20th Qty HDD




                 15k rpm HDD                        177 GB SSD                  387 GB SSD              387 GB SSD
                     (SFF)                             (SFF)                       (SFF)                   (1.8”)

12   Power is performance redefined                                                                      ©2012 IBM Corporation

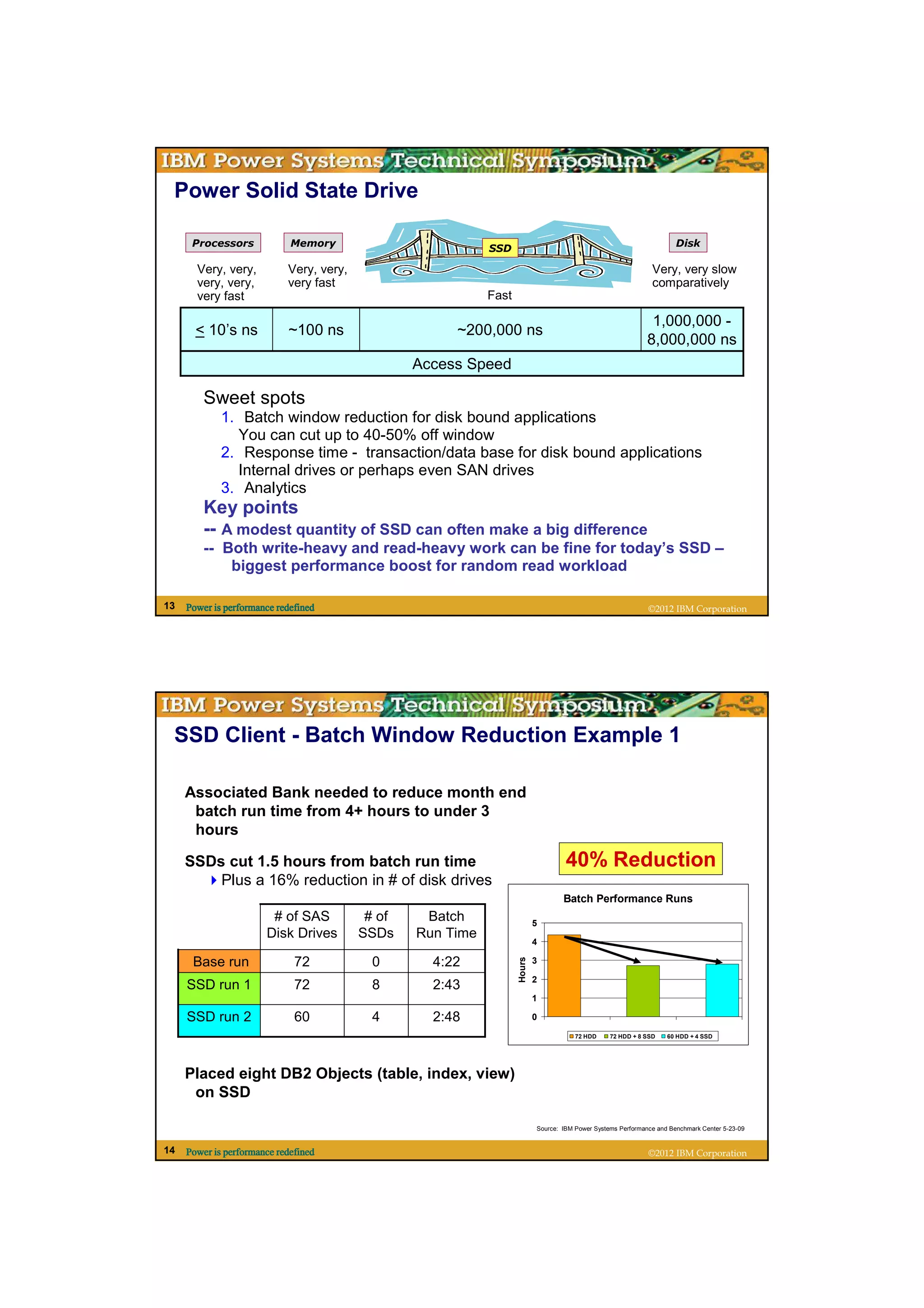

Power Solid State Drive

      Processors             Memory                                                                                     Disk
                                                             SSD

       Very, very,          Very, very,                                                                         Very, very slow
       very, very,          very fast                                                                           comparatively
       very fast                                             Fast

                                                                                                                1,000,000 -
       < 10’s ns            ~100 ns                    ~200,000 ns
                                                                                                               8,000,000 ns
                                                  Access Speed

         Sweet spots
             1. Batch window reduction for disk bound applications
               You can cut up to 40-50% off window
             2. Response time - transaction/data base for disk bound applications
               Internal drives or perhaps even SAN drives
             3. Analytics
         Key points
         -- A modest quantity of SSD can often make a big difference
         -- Both write-heavy and read-heavy work can be fine for today’s SSD –
             biggest performance boost for random read workload

13   Power is performance redefined                                                                            ©2012 IBM Corporation




 SSD Client - Batch Window Reduction Example 1

     Associated Bank needed to reduce month end
      batch run time from 4+ hours to under 3
      hours

     SSDs cut 1.5 hours from batch run time                                          40% Reduction
         Plus a 16% reduction in # of disk drives
                                                                                    Batch Performance Runs
                        # of SAS           # of    Batch                    5
                       Disk Drives        SSDs    Run Time
                                                                            4

      Base run                72           0        4:22
                                                                    Hours




                                                                            3

                                                                            2
     SSD run 1                72           8        2:43
                                                                            1

     SSD run 2                60           4        2:48                    0

                                                                                        72 HDD     72 HDD + 8 SSD    60 HDD + 4 SSD




     Placed eight DB2 Objects (table, index, view)
      on SSD

                                                                            Source: IBM Power Systems Performance and Benchmark Center 5-23-09


14   Power is performance redefined                                                                            ©2012 IBM Corporation

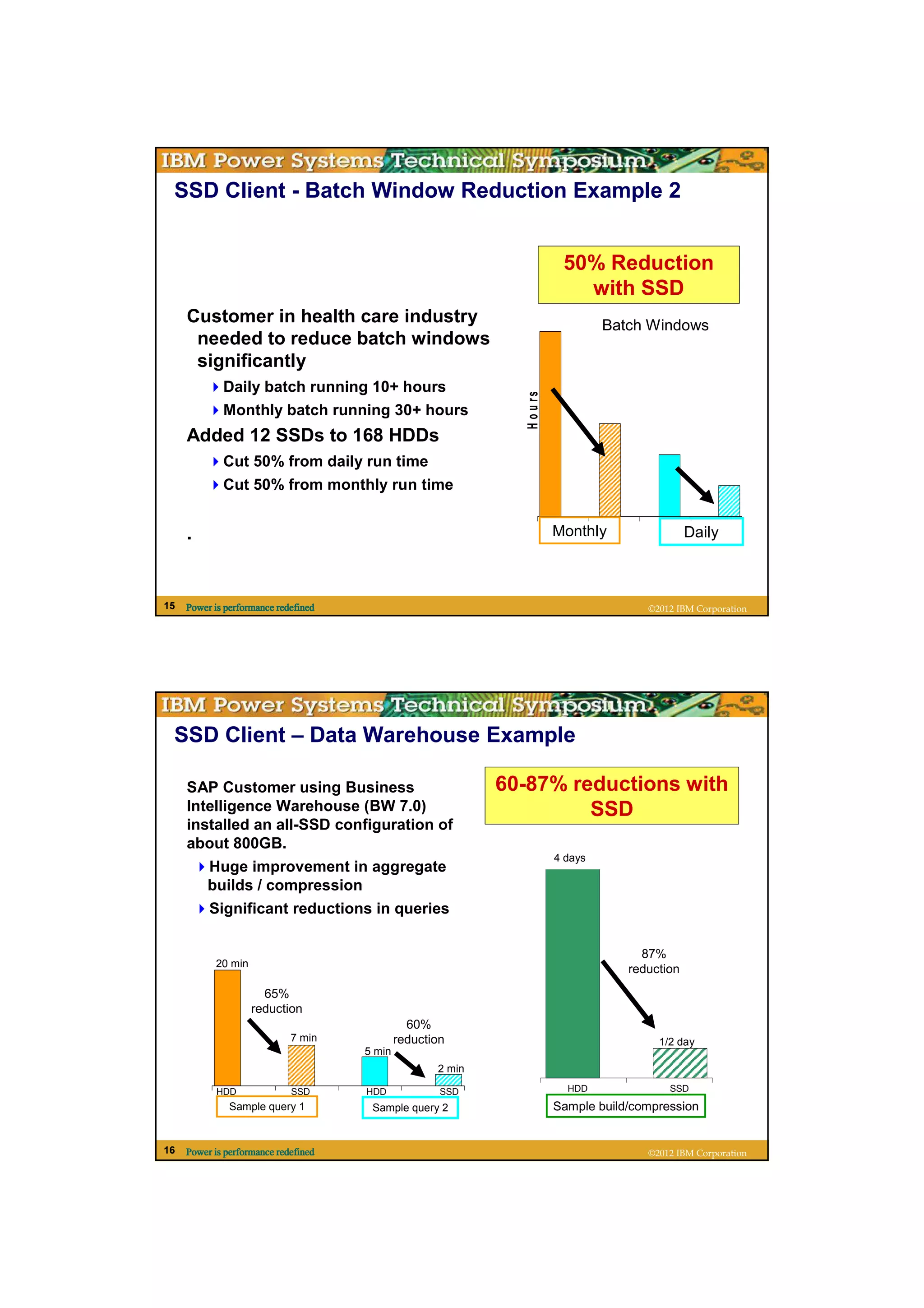

SSD Client - Batch Window Reduction Example 2


                                                                            50% Reduction
                                                                              with SSD
     Customer in health care industry                                               Batch Windows
      needed to reduce batch windows
      significantly
             Daily batch running 10+ hours




                                                                H o u rs
             Monthly batch running 30+ hours
     Added 12 SSDs to 168 HDDs
             Cut 50% from daily run time
             Cut 50% from monthly run time


     .                                                                     Monthly                 Daily

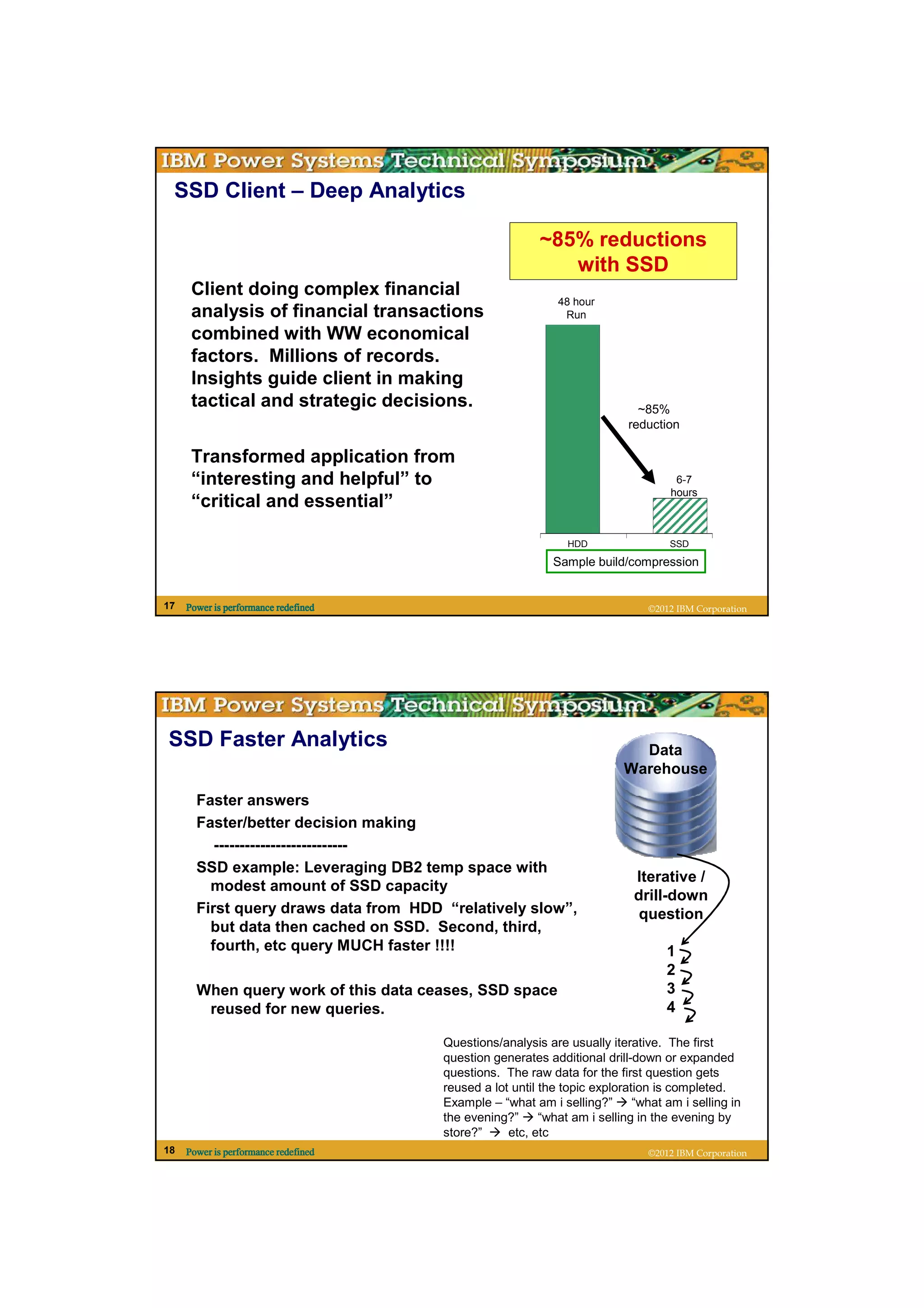

15   Power is performance redefined                                                       ©2012 IBM Corporation




 SSD Client – Data Warehouse Example

     SAP Customer using Business                             60-87% reductions with
     Intelligence Warehouse (BW 7.0)                                  SSD
     installed an all-SSD configuration of
     about 800GB.
                                                                           4 days
          Huge improvement in aggregate
          builds / compression
          Significant reductions in queries

                                                                                         87%
           20 min
                                                                                       reduction
                      65%
                    reduction
                                                60%
                             7 min            reduction                                     1/2 day
                                      5 min
                                                     2 min

            HDD              SSD      HDD             SSD                    HDD              SSD

               Sample query 1          Sample query 2                      Sample build/compression


16   Power is performance redefined                                                       ©2012 IBM Corporation
SSD Client – Deep Analytics

                                                         ~85% reductions
                                                            with SSD
      Client doing complex financial
                                                             48 hour
      analysis of financial transactions                      Run
      combined with WW economical
      factors. Millions of records.
      Insights guide client in making
      tactical and strategic decisions.                                      ~85%
                                                                           reduction

      Transformed application from
      “interesting and helpful” to                                                  6-7
                                                                                   hours
      “critical and essential”

                                                               HDD                 SSD

                                                            Sample build/compression


17   Power is performance redefined                                           ©2012 IBM Corporation




SSD Faster Analytics                                                        Data
                                                                          Warehouse

       Faster answers
       Faster/better decision making
          --------------------------
       SSD example: Leveraging DB2 temp space with
                                                                            Iterative /
         modest amount of SSD capacity
                                                                            drill-down
       First query draws data from HDD “relatively slow”,                    question
         but data then cached on SSD. Second, third,
         fourth, etc query MUCH faster !!!!                                       1
                                                                                  2
       When query work of this data ceases, SSD space                             3
        reused for new queries.                                                   4

                                       Questions/analysis are usually iterative. The first
                                       question generates additional drill-down or expanded
                                       questions. The raw data for the first question gets
                                       reused a lot until the topic exploration is completed.
                                       Example – “what am i selling?”       “what am i selling in
                                       the evening?”      “what am i selling in the evening by
                                       store?”     etc, etc
18   Power is performance redefined                                           ©2012 IBM Corporation
SSD Client Example – IPL Reduction

       IBM Development has projected                                           Less downtime
        modest improvement for IBM i and
        for AIX, but …..
       IBM i POWER6 520 client with 16
        drives (4 SSD and 12 HDD)
                Client put load source on SSD
                Now reporting 3 minute IPLs
       POWER7 IBM i client also reporting 3
        minute IPLs
       Much faster PTF applications

       What is your cost per minute or cost per hour for down
        time? How long is your typical IPL?



19   Power is performance redefined                                                          ©2012 IBM Corporation




 Many Systems Buy “Extra” Disk Arms for Performance

     HDD % utilization of capacity is held low to help ensure higher I/O performance
      and more consistent response time - arm movement, spinning platter an issue
     Write cache and read cache attempt to buffer the impact




                           Often less than 30-50% full for performance sensitive workloads

     SSD % utilization of capacity not restricted




                                      Can run much closer to 100% full



20   Power is performance redefined                                                          ©2012 IBM Corporation
Mixed SSD + HDD Can be Great Solution
 It is typical for data bases to have a large percentage of data which is infrequently
   used (“cold”) and a small percentage of data which is frequently used (“hot”)




                        Hot data may be only 10-20% capacity, but represent 80-90% activity


 SSD offers best price performance when focused on “hot” data
 HDD offers best storage cost, so focus it on “cold” data …. a hierarchical approach




         Cold                                      May be able to use larger HDD and/or a larger % capacity used
         Hot            Can run SSD closer
                        to 100% capacity

21   Power is performance redefined                                                               ©2012 IBM Corporation




 Save Space/Energy/Cooling
     A few SSD can often replace many HDD
                                                                        Fewer total drives
                                                                      Maybe fewer controllers
                                                                        Fewer I/O drawers
                                                                          Fewer cables




                                                                    I/O drawer maintenance reduction
                                                                         can offset SSD maintenance

22   Power is performance redefined                                                               ©2012 IBM Corporation
A Power 740 Scenario (your situation will vary)
                                                                                                                 Acquisition
     Power 740
           Single LPAR
           IBM i V6R1
                                                                                                                               9%
     All HDD, 28 drives, mirrored
          versus
     Mixed HDD & SSD, mirrored
           12 15k RPM HDDs
           4 SAS-bay-based 177GB SSDs
                                                                                                       All HDD         Mix HDD & SSD
     Achieves similar performance results
                   Maintenance                                           Energy                                                   Rack "U's"
                                  22
                                  %                                                 39                                                         40
                                                                                    %                                                          %




         All HDD         Mix HDD & SSD                         All HDD       Mix HDD & SSD                              All HDD        Mix HDD & SSD

23   Power is performance redefined                                                                                            ©2012 IBM Corporation




 Should You Use SAN/SVC SSD or Internal SSD?

                                                              Pro’s                            Con’s


                       Use
                     Internal                                yes                                   yes
                       SSD



                     Use
                   SAN/SVC                                   yes                                   yes
                     SSD




                   “Internal” = drives located in a system unit, in an I/O drawer with PCI slots or in a disk-only I/O drawer.

24   Power is performance redefined                                                                                            ©2012 IBM Corporation
DAS & SAN - Two Good Options
                                  Both options are strategic
                               Both options have their strengths
                               Can use both options on the same
                                            server

                                       DAS                                                                SAN
                     Direct Attached Storage                                               Storage Area Network
                            (“internal”)                                                        (“external”)


                 • Fastest (lower                                                      • Fast
                   latency)                                                            • Multi-server sharing
                 • Typically lower cost                                                • Advanced functions/values
                                                                                            Flash Copy, Metro/Global
                   hardware/software
                                                                                            Mirror, Live Partition Mobility,
                 • Often simpler config                                                     Easy Tier



25    Power is performance redefined                                                                                      ©2012 IBM Corporation




 SSD - SAN/SVC or Internal …. Or Mixed?
                                             Pro’s                                                           Con’s
                        1. Lower latency - internal is about                           1. If already have SAN/SVC, adds
                           0.3 milliseconds faster (per access                            complexity of having internal
       Use                 .. it can add up) (can be larger)                              PLUS SAN/SVC
                        2. If don’t already have SAN/SVC,
     Internal              lower cost & less learning
                                                                                       2. Reduces value of SAN/SVC high
                                                                                          function capabilities – Flash
       SSD              3. Multiple Config options                                        Copy, MetroMirror, HA, partition
                        4. Handle just like other internal                                mobility, etc
                           storage
                        1. Leverage SAN/SVC well-known                                1. If don’t have SAN/SVC, need
                           value proposition of                                          initial SAN/SVC investment in
  Use                      manageability, control,                                       hardware, software, skills
                           functionality, performance, etc                            2. Many medium/entry SAN/SVC
SAN/SVC                 2. If already have SAN/SVC, less                                 don’t offer SSD
  SSD                      learning, reduced cost to add
                        3. DS8000 & V7000 EasyTier


     MIXED: If using a SAN/SVC which doesn’t have SSD, OR if not using the higher
     function capability of a SAN/SVC (for example you do backup/restore functions just like
     it was an internal drive); THEN combining internal Power Systems SSD with SAN/SVC
     storage can be a good thing.
                 “Internal” = drives located in a system unit, in an I/O drawer with PCI slots or in a disk-only I/O drawer.
26    Power is performance redefined                                                                                      ©2012 IBM Corporation
SSD Technology “Myth”


     “Beware SSD as they wear out as they have a limited number of
      writes”
     Key facts to correct myth …. this is not a concern for IBM Power
      Systems SSD
           IBM Power Systems SSD are industrial/enterprise drives designed to
          handle this. Design points are many years of 24x7x365 heavy write
          workloads. These are not “PC-grade” or “consumer-grade” flash drives.
           Even if you do somehow “use up all the writes”, the SSD reports status prior
          to it being a real problem to the server and server sends a message to the
          operator or to IBM for a future scheduled repair action. This is just like a
          disk drive reporting a weakening status. Replacement SSD is covered
          under IBM Maintenance.
          Just like disk drives, you want to protect contents using system mirroring or
          RAID protection


27   Power is performance redefined                                        ©2012 IBM Corporation




 Agenda

                 SSD introduction/overview

                 Implementing hot/cold

                 Performance insights

                 Roadmap for Power Systems SSD

                 SSD reference material




28   Power is performance redefined                                        ©2012 IBM Corporation
Implementing “Hot” and “Cold” Data

     AIX                                                                    IBM i
     Ability to granularly/flexibly select and
     locate hot files on SSD
                                                                            #1 Best integrated, automated
        Key AIX performance tools are filemon                               capability available in the industry
        & iostat.                                                           today
        Database vendors provide hot data                                                                 “Trace and Balance” function part of
        analysis tools, example: DB2 Snapshot.                                                           IBM i – automated in i 7.1
     Migrating hot data                                                                                   Monitors by partition or ASP (Aux
         Migratepv is often useful                                                                       Storage Pool) to determine hot/cold
         Softek Migration Tool provides a nice                                                            Upon request, automatically moves hot
        suite of functions and can be combined                                                           data to SSD, cold to HDD
        with IBM Services                                                                                 Can re-monitor & rebalance any time
         See Total Storage Productivity Center                              A few key OS files can automatically
     SSD white paper for additional                                         be placed on SSD
     insights                                                               Can specify specific data base
     New/enhanced tools being developed                                     objects to be placed on SSD
                                                                            See white paper for additional insights
                                                                            Additional enhancements being
                                                                            developed



29   Power is performance redefined                                                                                                                     ©2012 IBM Corporation




 IBM i Load Balancer

 Industry leading automated capability
 Monitors partition/ASP using “trace”                                                                     IBM i intelligent hot/cold placement
                                                                                                          makes a big difference vs normal IBM
        User turns trace on during a peak time                                                            striping / scattering of data across all
        User turns trace off after reasonable                                                             drives.
       sample time
        Negligible performance impact expected                                                            This example 72 HDD + 16 SSD
        Tool monitors “reads” to identify hot data
        Looks at 1MB stripes of data
 Upon command, automatically moves hot
                                                                             Application Response time




  data to SSD, cold data to HDD                                                                             72 HDD + 16 SSD No Balance
                                                                                                            72 HDD + 16 SSD Data Balanced
       Minimal performance impact, done in
       background
 Can remonitor and rebalance any time
        Probably a weekly or monthly activity                                                                                               Trans/min


        Perhaps less often if data not volatile

       Predicting/analyzing what % of data is hot for presale analysis to
          help size the number of SSD required:
       • Use PEX tool/output
       • Output from monitor (will need technical person to interpret)


30   Power is performance redefined                                                                                                                     ©2012 IBM Corporation
IBM i SSD Balancing One of 5 ASP Balancing Types
       Balance data between busy units and idle units (STRASPBAL
         TYPE(*USAGE))
       Make all of the units in the ASP have the same percent full
         (STRASPBAL TYPE(*CAPACITY))
       Drain the data from a disk, to prepare unit it to be removed from
         the configuration (STRASPBAL TYPE(*MOVDTA))
       (Almost obsolete) move hot data off of a compressed disk, and
         move cold data to the compressed disk (STRASPBAL
         TYPE(*HSM))        Requires specific disk controllers with compression
           capability – feats #2741/2748/2778. Compression only allowed in user ASPs


       Move cold data to HDDs and move
        hot data to SSDs
        (STRASPBAL TYPE(*HSM))



31   Power is performance redefined                                          ©2012 IBM Corporation




 Using TRCASPBAL to place hot data on SSDs – IBM i
               HDD1                   HDD2     HDD3             HDD4                SSD
                  100                  500        100             2000                 6000
                 10000
                  100                  1200      6000
                                                  900             3000               10000
                                                                                      100
                  300                   800       500             900                 6000
                                                                                      900
                   0                   4000
                                        300       300              400                 4000
                                                                                       300
                  200                  600        700             1000                 100
                  100




        Trace ASP balance counts the read operations based
         on 1MB stripes
               TRCASPBAL SET(*ON) ASP(1) TIMLMT(*NOMAX)
        Start ASP balance moves the data
             STRASPBAL TYPE(*HSM) ASP(1) TIMLMT(*NOMAX)
             Target is 50% of read operations to be on SSD
             Cold data is moved (multiple threads) to HDDs, hot data is
             moved (single thread) to SSD


32   Power is performance redefined                                          ©2012 IBM Corporation
How to Find Hot Tables and Indexes - IBM i

      Performance Explorer
             BY FAR the best solution
            Perform analysis based on read complete and write
           complete events
      DB2 maintains statistics about the number of
       operations on a table or index
           Statistics are zeroed on each IPL
           Statistics only identify candidates (logical operations include
           both random and sequential operations)
           Available via:
            Display file description (DSPFD)
            Application programming interface (API) QUSRMBRD
            System i Navigator Health Center (V6R1 only)
            SQL catalog queries

33   Power is performance redefined                              ©2012 IBM Corporation




 Agenda

                 SSD introduction/overview

                 Implementing hot/cold

                 Performance insights

                 Roadmap for Power Systems SSD

                 SSD reference material




34   Power is performance redefined                              ©2012 IBM Corporation
Summary Performance Comparisons of 3 SSD Options




                      SSD                      PCIe-based                             SAS-Bay-Based

               GB capacity                         177 GB                         69 GB                       177 GB

         Flash Technology                            eMLC                           SLC                         eMLC

               SSD drive                                                     Base compare Similar, may be
                                                                               (reference a little slower in
             (no controller                          Similar
                                                                                  point)    write-heavy
            considerations)                                                                      usage


35    Power is performance redefined               * Assuming same number of drives per controller/adapter       ©2012 IBM Corporation




 Performance Comparisons of 69/177GB SSD Options
                       SSD                      PCIe-based                                    SAS-Bay-Based
             GB capacity                           177 GB                            69 GB                            177 GB
         Flash Technology                           eMLC                              SLC                               eMLC
     SSD only performance (no
                                                                                 Base compare
     controller) read heavy              Similar, but can vary a little
                                                                                (reference point)
                                                                                                         Similar, but can vary a little
     workload
     SSD-only performance (no                                                                            Typically somewhat slower
                                                                                 Base compare
     controller) write heavy                        Similar
                                                                                (reference point)                  (0-15%)
     workload                                                                                                 (due to add’l function in SSD)


                                                                             Controlled by
                                       Tied directly to ONE controller                            Controlled by #5805/5903
                                                                       #5805/5903 or by #5906
                                       with no write cache with max 4                             or by #5906 adapter up to
       Controllers / adapters          drives. RAID-5 slowed due to
                                                                        adapter up to 9/8 drives
                                                                                                        9/8 drives per
                                                                        per controller/controller
                                               no write cache.                                     controller/controller pair
                                                                                  pair

       SSD PLUS Controller
                                                                                 Base compare
       performance                            Typically similar *
                                                                                (reference point)
                                                                                                                 Typically similar
       Read heavy workload
                                            Similar throughput, but
       SSD PLUS Controller                potentially slower response                                    Typically somewhat slower
                                                                                 Base compare             (0-5% mixed HDD/SSD)
       performance                     time due to no write cache * ---
                                                                                (reference point)
                                                        --                                                   (0-15% SSD only)
       Write heavy workload                                                                                   (due to add’l function in SSD)
                                           Bigger impact if RAID-5/6

                                                    * Assuming same number of drives per controller/adapter

36    Power is performance redefined                                                                             ©2012 IBM Corporation
Other Performance Insights – background reading
     • Time to Write on a HDD is the same as time to read on an HDD (1:1 ratio)
     • Time to Write on an SSD is much longer than a read on an SSD around (3:1 ratio)
     • Thus the biggest SSD performance boost is for reads compared to HDD.
          SSDs do reads at < 1 ms while from HDD are typically around 3-15 ms
     • Writes to SSD are faster than writes to HDD …. BUT …. Write cache on a SAS controller is even faster than
       a write to SSD. SSD can empty out the write cache faster than HDD, so SSD+write cache is generally faster
       than HDD+write cache, but comparisons have more “it depends” caveats
     • The size of information being handled makes a difference. Handling bigger blocks of data takes longer,
       especially if doing writes.
     • Randomness of information also plays a part. If there are a lot of smaller blocks of information which happen
       to be close together where they will be eventually be stored, then they are more likely to be in the same page
       of space in the SSD device’s internal controller. Thus the access and/or writes can happen “above” the real
       flash memory and is faster.
     • HDD have had ongoing cost/GB improvements over the last 5-10years, but have had little access
       performance enhancements. Most performance boosts have been through enhancements in controllers of
       HDD, not the spinning platter or arm. No significant HDD performance improvements are currently foreseen.
       Thus the gap between server memory and HDD will continue to widen.
     • If operating system can predict the data needed, it can issue a read prior to the application making the request
       reducing HDD delay to application. But random reads by definition are not feasible to pre-fetch. Applications
       with lots of random reads are thus THE ideal area for SSD benefits.
     • Alternatives to SSD – 1) Can “pin” information in memory. This is even faster than SSD. But SSD can
       provide a lot more GB of capacity and is usually more cost effective per GB. 2) Also could go buy a lot more
       adapters with write cache and/or spread data out, but this is less cost effective than SSD.
     • If an HDD fails, it can take hours to format and bring the new HDD into sync with either its mirrored pair or with
       the rest of the RAID-5 array. The larger the drive’s capacity, the longer the resync time can be. Until re-
       synced there is risk a second failure could crash the partition or application. If an SSD is replaced, the time to
       resync so that the RAID array or mirroring protection is restored is MUCH, MUCH faster (minutes vs hours)
       with SSD than HDD.
     • For absolute best performance use internal SSD vs SAN SSD. There in about 0.3ms (3/10ths milliseconds)
       additional latency in accessing SAN. For I/O intensive applications this adds up. But SANs can offer a lot of
       other operational and managerial advantages for many clients. The performance trade off may be a good
       thing to do in the overall decision.
     • For VERY rough rules of thumb for mixing HDD & SSD – use about 5-15% of the GB of the data – or use
       about 5-10% of the drives.

37     Power is performance redefined                                                                   ©2012 IBM Corporation




 SSD Config Options --- April 2012


                                            Power Systems (internal / DAS)
                               PCIe-based
            SAN-based
                                  SSD                               SAS-bay-based SSD
               DS8000                                         #5805             #5913       #ESA1/A2      #5888 Ultra
                              #2053/54/55
                SVC                          In CEC w/ int    Gen1 PCIe         Gen2 PCIe   Gen2 PCIe     Drawer
                              RAID & SSD
               V7000                         SAS contrlr      380MB             1800MB      0 MB          3100MB
                              SAS Adapter
                XIV                                           cache             cache       cache         cache



                               Many DAS SSD config options* for Power Clients
                               Options vary
                                        Performance
                                        Price
                                        Physical size
                                        Where tested/supported
                                        Function


                                                                                     * PCI-X 1.5GB SAS adapter not shown to
                                                                                     focus on most current technologies

38     Power is performance redefined                                                                   ©2012 IBM Corporation
Power DAS SSD Options: April 2012
                                         PCIe-based
                                         SSD                                                                            SAS-bay-based SSD
                                                                                        In CEC w/ int             #5805 &                #5913 &             #ESA1/A2            #5888 Ultra
                                         #2053/54/55
                                                                                        SAS contrlr               #5887***               #5887***            & #5887***          Drawer
 Number PCIe slots used                  2      (4 mirror)                              0                         2                      2                   2                   0
 Number GX slots used                    0                                              0                         0                      0                   0                   1-2   (710/730=2)

 Max SSD attach                          4                                              3-8     mdl dependent     9                      24                  24                  30
 Max 177GB busy SSD                      W1 4                                           W1 2-3                    W1 4-6                 W1 ~24              W1 ~24              N/A
 reasonably supported @                  W2 3-4                                         W2 1-2                    W2 3-4                 W2 ~24              W2 ~24
 Max 387GB busy SSD                      N/A                                            W1 1-2                    W1 2-3                 W1 ~20              W1 ~18              W1 ~22
 reasonably supported @                                                                 W2 1                      W2 1-2                 W2 ~14              W2 ~14              W2 ~14
 Write cache (MB)                        0                                              175                       380                    1800                0                   3100
 GB / SSD                                 177                                           177 or 387                177 or 387             177 or 387          177 or 387          387
 Servers supported
 - Newest 710-740 (C models)             Y                                              Y                         Y 710/730 limit**      Y 710/730 limit**   Y 720/740 limit *   710   740
 - Rest POWER7 710-795                   Y, except 795                                  Y, except 795             Y not 710/730          Y not 710/730       N                   N   (SOD)
 - POWER6                                Y, except 595                                  N                         Y 177GB SSD            Y 177GB SSD         N                   N
 AIX/IBM i/Linux support                 Y                                              Y                         Y                      Y                   Y                   AIX / Linux
 Mix HDD & SSD                           N                                              Y                         N                      Y                   N                   N      (SOD)
 Rack space needed                       depends                                        N/A                       2U+                    2U+                 2U+                 1U
 Easy Tier                               N                                              N                         N                      N                   N                   N      (SOD)
 Approximate USA list price              $3k + 2PCIe                                    0                         $4.4k/pair +           $15k/pair +         $6.1k + 6.1k        $24.5k + $2k
 with zero SSD for Mdl 740               slots                                                                    $5.4k drawer           $5.4k drawer        + $5.4k drwr        PCIe adpter

 PowerHA: share w/ 2 servers             N                                              N                         Y                      Y                   Y                   Y
                       @ This is a simple rule of thumb. Actual reasonable maximum depends on many factors.
 Prices subject to     * ESA1 not in 720/740 system unit. Can place in #5802/5877 I/O drawer attached to 720/740
 change. Reseller      ** Not in 710/730 system unit, but 730 (8231-E2C) can have in #5802/5877 I/O drawer
 prices can vary.      *** Possible to use #5802 or 5803 I/O drawer instead of #5887 EXP24S Drawer. Max 177GB SSD attach would differ for #5913 and ESA1/ESA2
                       W1 = transaction/command/CPW type workload, smaller block, IOPS sensitive RAID5
                       W2 = save/restore/large-file type workload, Throughput sensitive. RAID5 Assumes #5887 is in mode2 using two SAS ports for higher bandwidth.
39    Power is performance redefined                                                                                                                                ©2012 IBM Corporation




 Performance: PCIe-Based vs. 69GB SAS-Bay-Based SSD
 Using 380MB Write Cache RAID Adapters running SAS-Bay-Based
                          (2) #5903/5278 adapters + (8) 69GB SSD                                                                                   (2) #2055 + (8) 177GB SSD
                          Running RAID-5                                                                                                           Running RAID-5
                          2 PCIe slots                                                                                                             4 PCIe slots

                                         Similar performance – RAID-5 to RAID-5
                                                                              10



                                                                                                                   SAS-Bay-
                                                  Appl Response time (ms)




                                                                               1                                   Based              PCIe-Based



                                                                              0.1




                                                                             0.01


       SAS-bay-based
       177GB SSD                                                            0.001
                                                                                    0   20000       40000       60000      80000       100000

       similar to 69GB                                                                              Appl Trans/m in

       SSD

     Notes:
     • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client
       workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can
       impact this comparison. (Your results may differ.) The above measurement used 60% reads and 40% writes.
     • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache. .


40    Power is performance redefined                                                                                                                                ©2012 IBM Corporation
Performance: PCIe-Based vs. 69GB SAS-Bay-Based SSD
 Using 380MB Write Cache RAID Adapters running SAS-Bay-Based

                            (2) #5903/5278 adapters + (8) 69GB SSD                                                                                       (2) #2055 + (8) 177GB SSD
                            Running RAID-5                                                                                                               Running mirroring
                            2 PCIe slots                                                                                                                 4 PCIe slots


           Mirrored PCIe-based outperforms Medium cache RAID-5 SAS-Bay-Based
                                                                                            10
                                                               Appl Response time (ms)
                                                                                                        SAS-Bay-                        PCIe-Based
                                                                                                1
                                                                                                        Based



                                                                                            0.1




       SAS-bay-based                                                                      0.01


       177GB SSD
                                                                                         0.001
       similar to 69GB                                                                              0    50000         100000      150000       200000

       SSD                                                                                                      Application trans/min




     Notes:
     • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client
       workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can
       impact this comparison. (Your results may vary.) The above measurement used 60% reads and 40% writes.
     • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache. .


41    Power is performance redefined                                                                                                                               ©2012 IBM Corporation




 Performance: PCIe-Based vs. 69GB SAS-Bay-Based SSD
 Using 1500MB Write Cache RAID Adapters running SAS-Bay-Based SSD

                           (1) #2055 + (4) 177GB SSD                                                                                        (1) #5904/6/8 adapters + (4) 69GB SSD
                           Running RAID-5                                                                                                   Running RAID-5
                           2 PCIe slots                                                                                                     2 PCI-X slots


                 Large cache PCI-X adapter & SSD outperforms PCIe-Based SSD
                                      ( RAID-5 to RAID-5 )
                                                                                          10
                                                                                                                   PCIe-Based
                                           Appl Response time (ms)




                                                                                           1



                                                                                          0.1


       SAS-bay-based                                                                     0.01
                                                                                                                                        SAS-Bay-
                                                                                                                                        Based
       177GB SSD
       similar to 69GB                                                         0.001

       SSD                                                                                      0       20000         40000       60000         80000

                                                                                                            Application trans/min



     Notes:
     • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client
       workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can
       impact this comparison. (Your results may vary.) The above measurement used 60% reads and 40% writes.
     • Write cache was turned on for #5904/6/8 adapters. #2055 has no write cache.


42    Power is performance redefined                                                                                                                               ©2012 IBM Corporation
Performance: HDD vs. SSD+HDD Hybrid
 Using 380MB Write Cache RAID Adapters running SAS-Bay-Based

                            (2) 5903/5278 + (18) HDD                                                                (2) #5903/5278 adapters ) + (18) HDD
                            Running mirrored                                                                        + (2) #2055 + (8) 177GB SSD
                                                                                                                    Running mirrored
                                                                                                                    Hot data located on SSD

        Adding SSD and placing hot data on SSD, grew workload capability by nearly 3X
                                           Appl Response Time (ms)     10
                                                                                   HDD only

                                                                        1
                                                                                                               SSD+HDD hybrid

                                                                       0.1



                                                                      0.01



                                                                     0.001
                                                                             0   50000     100000     150000      200000        250000

                                                                                         Application Trans/min




     Notes:
     • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client
       workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can
       impact this comparison. The above measurement used 60% reads and 40% writes.
     • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache.


43    Power is performance redefined                                                                                                       ©2012 IBM Corporation




 SSD Analyzer Package




     Provides:
     - SSD Analysis Overview
     - Disk Read Time
     - Job & Tasks by Read Time

     Drilldown from here into CS &
     GHI perspectives




                                    Download from SSD Techdoc site:
                 http://www-03.ibm.com/support/techdocs/atsmastr.nsf/WebIndex/PRS3780


44    Power is performance redefined                                                                                                       ©2012 IBM Corporation
Disk Response Time Charts



                                             Detailed charts are based upon the
                                           increased detail QAPMDISKRB groups




          Use tooltips to fly over & get
                 specific data




45   Power is performance redefined                                    ©2012 IBM Corporation




     CSI – SSD Candidate Screening

        Offered at 7.1 only, helps a user determine if SSDs could help
       performance. It needs data from QAPMDISKRB.




46   Power is performance redefined                                    ©2012 IBM Corporation
CSI – SSD Candidate Screening

        Offered at 7.1 only, helps a user determine if SSDs could help
       performance.




47   Power is performance redefined                                           ©2012 IBM Corporation




     CSI – SSD Candidate Screening job details report

        This is similar to the green screen SSD Analyzer tool:
       http://www-03.ibm.com/support/techdocs/atsmastr.nsf/WebIndex/PRS3780




48   Power is performance redefined                                           ©2012 IBM Corporation
Agenda

                 SSD introduction/overview

                 Implementing hot/cold

                 Performance insights

                 Roadmap for Power Systems SSD

                 SSD reference material




49   Power is performance redefined                                                                                    ©2012 IBM Corporation




 Power Systems SSD Statements of Direction
 Provided August 2010


 IBM plans to enhance its Power Systems Enterprise Class
 SSD solutions with technology designed to continue to
 provide significant improvements in performance and
 storage density over time. IBM plans for these IBM Power
 Systems enhancements to include both SAS-bay-based
 and PCIe-based SSD product offerings that will leverage
 IBM's investments in its SSD optimized Enterprise Class
 RAID Storage Controllers.


 All statements regarding IBM's future direction & intent are subject to change or withdrawal without notice, and represents goals &
 objectives only. Information regarding potential future products is intended to outline our general product direction and it should not be
 relied on in making a purchase decision. The information mentioned regarding potential future products is not a commitment, promise, or
 legal obligation to deliver any material, code or functionality. Information about potential future products may not be incorporated into any
 contract. The development, release, and timing of any future features or functionality described for our products remains at our sole
 discretion.
50   Power is performance redefined                                                                                    ©2012 IBM Corporation
Power Solid State Drives (SSD) Roadmap
       2009
       • Apr/May - Introduction SAS-bay-based
       • July/Oct/Nov - Misc enhancements
       • Nov/Dec - Huge price action – matching memory price action
       2010
       • Feb - support in Power 750, 755, 770, 780
       • April - IBM i 7.1 enhancements
       • August - Support in new POWER7 servers & AIX 7.1
         enhancements
       • August - Introduce additional SSD config option … PCIe-based
       2011
       • Enhancements to both SAS-bay-based and PCIe-based SSD
              More capacity in SSD devices
              More performance in SAS controllers
       2012 … more enhancements

        See SODs made August 2010. All statements regarding IBM's future direction & intent are subject to change or withdrawal
        without notice, and represents goals & objectives only.


51   Power is performance redefined                                                                               ©2012 IBM Corporation




 Roadmap: SSD Configuration 2011 Options

     SAS-bay-based
                                                                              SAS Bays
                  PCI SAS
                                                                                                                                  SSD
                                                                                            SSD
                                                                                                    SSD
                                                                                                           SSD

                                                                                                                    SSD
                                                                SSD
                                                                       SSD
                                                                              SSD
                                                                                     SSD




                                                                                                                           SSD




                  controller


         New PCIe card                                                Larger capacity SSD
           (pair for redundancy)                                      Continue Hot plug SSD
         Large cache, high performance                                More SSD modules / controller



     PCIe-based
                                                                       Double-wide PCIe card
                  PCIe SAS
                                         SSD




                                                                         (need pair for hot plug)
                                        SSD




                  controller
                                       SSD




                                                                       Up to 4 SSD modules
                                      SSD




        See SODs made August 2010. All statements regarding IBM's future direction & intent are subject to change or withdrawal
        without notice, and represents goals & objectives only.


52   Power is performance redefined                                                                               ©2012 IBM Corporation
Agenda

                 SSD introduction/overview

                 Implementing hot/cold

                 Performance insights

                 Roadmap for Power Systems SSD

                 SSD reference material




53   Power is performance redefined                                                                  ©2012 IBM Corporation




 SSD Analyzer Tool for IBM i
     • Quick, easy, no-charge analysis looks at standard performance report output
     • Provides “probably yes”, “probably no”, or “maybe
     • Provides rough estimate of quantity of SSD to recommend



                                            SSD ANALYSIS TOOL (ANZSSDDTA)
                   Type choices, press Enter.
                   PERFORMANCE MEMBER . . . . . . .     *DEFAULT__      Name, *DEFAULT
                     LIBRARY . . . . . . . . . . .        __________    Name
                                                Additional Parameters
                   REPORT TYPE . . . . . . . .    . .   *SUMMARY        *DETAIL, *SUMMARY, *BOTH
                   TIME PERIOD::
                     START TIME AND DATE::
                     BEGINNING TIME . . . . . .   . .   *AVAIL__        Time, *AVAIL
                     BEGINNING DATE . . . . . .   . .   *BEGIN__        Date, *BEGIN
                     END TIME AND DATE::
                     ENDING TIME . . . . . . .    . .   *AVAIL__        Time, *AVAIL
                     ENDING DATE . . . . . . .    . .   *END____        Date, *END
                   NUMBER OF RECORDS IN REPORT    . .   50__            0 - 9999

                                                                                                Bottom
                   F3=Exit   F4=Prompt   F5=Refresh     F12=Cancel      F13=How to use this display
                   F24=More keys




      Available via www.ibm.com/support/techdocs in “Presentations & Tools”.
      Search using keyword SSD
54   Power is performance redefined                                                                  ©2012 IBM Corporation
Additional Marketing Materials

     Brochure ….

     Power System SSD Web pages
        Positioning, educating, linking to other materials
        www.ibm.com/systems/power/hardware/peripherals/ssd/index.html

     Additional white paper information being worked on by Development –
      availability dates TBD

     List of existing SSD white papers follow on separate slides




55   Power is performance redefined                                 ©2012 IBM Corporation




 SSD Brochure




      Sales personnel can
       access brochure through
       SSI / PW web pages




56   Power is performance redefined                                 ©2012 IBM Corporation
Power Systems SSD Web Pages



     Several informative
     pages on SSD
     positioned from a
     Power Systems
     perspective

     http://www.ibm.com/
     systems/power/hard
     ware/peripherals/ss
     d/index.html




57    Power is performance redefined                                                 ©2012 IBM Corporation




 Five Power Systems SSD White Papers

          IBM Power SSD vs Consumer SSD                    (posted Nov 2009)
                 “Advantages of True Enterprise Solid State Drives (SSDs) in Enterprise
                 Systems”
          AIX-specific             (posted Apr 2009)
                  “Driving Business Value on Power Systems with Solid State Drives”
          IBM i-specific               (posted May 2009)
                  “Performance Value of Solid State Drives using IBM i”
                  First published May 2009
          More SSD technology specific – AIX/IBM i/Linux appropriate (posted
             Jun 2009)
                  “Performance Impacts of Flash SSDs Upon IBM Power Systems”
          Above papers in Power Systems web site under “Resources/Literature”
                 http://www.ibm.com/common/ssi/apilite?infotype=SA&infosubt=WH&lastdays
                 =1825&hitlimit=200&ctvwcode=US&pubno=POW*USEN&appname=STGE_PO_
                 PO_USEN_WH&additional=summary&contents=keeponlit




          5th paper for an SAP environment
                 http://www.sdn.sap.com/irj/sdn/db4?rid=/library/uuid/90a1637e-065f-2c10-
                 3ab7-bea9375fc88d




58    Power is performance redefined                                                 ©2012 IBM Corporation
i Oriented References/Tool

 IBM - Performance Management on IBM i Resource Library
   http://www.ibm.com/systems/i/advantages/perfmgmt/resource.html
 Performance Value of Solid State Drives using IBM i
  http://www.ibm.com/systems/resources/ssd_ibmi.pdf
 Performance Impacts of Flash SSDs Upon IBM Power Systems
  http://www.ibm.com/common/ssi/cgi-
  bin/ssialias?infotype=SA&subtype=WH&htmlfid=POW03028USEN&attachme
  nt=POW03028USEN.PDF&appname=STGE_PO_PO_USEN_WH
 Driving Business Value on Power Systems with Solid State Drives
  http://www.ibm.com/common/ssi/cgi-
  bin/ssialias?infotype=SA&subtype=WH&htmlfid=POW03025USEN&attachme
  nt=POW03025USEN.PDF&appname=STGE_PO_PO_USEN_WH
 IBM Systems Lab Services and Training
   http://www.ibm.com/systems/services/labservices
 IBM Power Systems(i) Benchmarking and Proof-of-Concept Centers
   http://www.ibm.com/systems/i/support/benchmarkcenters


59   Power is performance redefined                               ©2012 IBM Corporation




 Agenda

                 SSD introduction/overview

                 Implementing hot/cold

                 Performance insights

                 Roadmap for Power Systems SSD

                 SSD reference material



                 Questions?


60   Power is performance redefined                               ©2012 IBM Corporation
IBM




                                         Tak

                     Dank je Gracia Merci       Thanks
                                   s

                                               Grazie
                                 Danke
                                                   Takk


Power is performance redefined                  ©2012 IBM Corporation




                                                           IBM




Power is performance redefined                  ©2012 IBM Corporation
Performance and Scalability Services
     The IBM i Performance and Scalability Services Center can provide
      facilities and hardware IN ROCHESTER to assist you in testing
      hardware or software changes

             “Traditional” benchmarks
             Release-to-release upgrades
             Assess application performance when migrating to a new release of IBM I
             Stress test your system
             Determine impact of application changes
             Proofs of Concept (e.g. HA alternatives; SSD analysis, external storage, etc.)
             Evaluate application scalability
             Capacity planning

     … all with the availability of Lab Services IBM i experts and
     development personnel

63   To request any of these services, submit at:
      Power is performance redefined                                                         ©2012 IBM Corporation




     IBM Systems Lab Services and
     Training
                                                                                      Mainframe Systems
     Our Mission and Profile
        Support the IBM Systems Agenda and accelerate the adoption of
        new products and solutions                                                       Power Systems

        Maximize performance of our clients’ existing IBM systems
        Deliver technical training, conferences, and other services tailored to     System x & Bladecenter
        meet client needs
        Team with IBM Service Providers to optimize the deployment of IBM
        solutions (GTS, GBS, SWG Lab Services and our IBM Business                      System Storage
        Partners)

     Our Competitive Advantage                                                    IT Infrastructure Optimization
        Leverage relationships with the IBM development labs to build deep
        technical skills and exploit the expertise of our developers
        Combined expertise of Lab Services and the Training for Systems               Data Center Services
        team
        Skills can be deployed worldwide to assure all client needs can be
                          Successful worldwide history:                                Training Services
        met 17 years in Americas, 9 years in Europe/Middle East/Africa,
                                   5 years in Asia Pacific


      www.ibm.com/systems/services/labservices               stgls@us.ibm.com
64    Power is performance redefined                                                         ©2012 IBM Corporation
Special notices
     This document was developed for IBM offerings in the United States as of the date of publication. IBM may not make these offerings available in
     other countries, and the information is subject to change without notice. Consult your local IBM business contact for information on the IBM
     offerings available in your area.
     Information in this document concerning non-IBM products was obtained from the suppliers of these products or other public sources. Questions
     on the capabilities of non-IBM products should be addressed to the suppliers of those products.
     IBM may have patents or pending patent applications covering subject matter in this document. The furnishing of this document does not give
     you any license to these patents. Send license inquires, in writing, to IBM Director of Licensing, IBM Corporation, New Castle Drive, Armonk, NY
     10504-1785 USA.
     All statements regarding IBM future direction and intent are subject to change or withdrawal without notice, and represent goals and objectives
     only.
     The information contained in this document has not been submitted to any formal IBM test and is provided "AS IS" with no warranties or
     guarantees either expressed or implied.
     All examples cited or described in this document are presented as illustrations of the manner in which some IBM products can be used and the
     results that may be achieved. Actual environmental costs and performance characteristics will vary depending on individual client configurations
     and conditions.
     IBM Global Financing offerings are provided through IBM Credit Corporation in the United States and other IBM subsidiaries and divisions
     worldwide to qualified commercial and government clients. Rates are based on a client's credit rating, financing terms, offering type, equipment
     type and options, and may vary by country. Other restrictions may apply. Rates and offerings are subject to change, extension or withdrawal
     without notice.
     IBM is not responsible for printing errors in this document that result in pricing or information inaccuracies.
     All prices shown are IBM's United States suggested list prices and are subject to change without notice; reseller prices may vary.
     IBM hardware products are manufactured from new parts, or new and serviceable used parts. Regardless, our warranty terms apply.
     Any performance data contained in this document was determined in a controlled environment. Actual results may vary significantly and are
     dependent on many factors including system hardware configuration and software design and configuration. Some measurements quoted in this
     document may have been made on development-level systems. There is no guarantee these measurements will be the same on generally-
     available systems. Some measurements quoted in this document may have been estimated through extrapolation. Users of this document
     should verify the applicable data for their specific environment.




                                                                                                                                               Revised September 26, 2006



65    Power is performance redefined                                                                                                               ©2012 IBM Corporation




     Special notices (cont.)
 IBM, the IBM logo, ibm.com AIX, AIX (logo), AIX 5L, AIX 6 (logo), AS/400, BladeCenter, Blue Gene, ClusterProven, DB2, ESCON, i5/OS, i5/OS (logo), IBM Business
 Partner (logo), IntelliStation, LoadLeveler, Lotus, Lotus Notes, Notes, Operating System/400, OS/400, PartnerLink, PartnerWorld, PowerPC, pSeries, Rational, RISC
 System/6000, RS/6000, THINK, Tivoli, Tivoli (logo), Tivoli Management Environment, WebSphere, xSeries, z/OS, zSeries, Active Memory, Balanced Warehouse,
 CacheFlow, Cool Blue, IBM Systems Director VMControl, pureScale, TurboCore, Chiphopper, Cloudscape, DB2 Universal Database, DS4000, DS6000, DS8000,
 EnergyScale, Enterprise Workload Manager, General Parallel File System, , GPFS, HACMP, HACMP/6000, HASM, IBM Systems Director Active Energy Manager,
 iSeries, Micro-Partitioning, POWER, PowerExecutive, PowerVM, PowerVM (logo), PowerHA, Power Architecture, Power Everywhere, Power Family, POWER
 Hypervisor, Power Systems, Power Systems (logo), Power Systems Software, Power Systems Software (logo), POWER2, POWER3, POWER4, POWER4+, POWER5,
 POWER5+, POWER6, POWER6+, POWER7, System i, System p, System p5, System Storage, System z, TME 10, Workload Partitions Manager and X-Architecture are
 trademarks or registered trademarks of International Business Machines Corporation in the United States, other countries, or both. If these and other IBM trademarked
 terms are marked on their first occurrence in this information with a trademark symbol (® or ™), these symbols indicate U.S. registered or common law trademarks
 owned by IBM at the time this information was published. Such trademarks may also be registered or common law trademarks in other countries.

 A full list of U.S. trademarks owned by IBM may be found at: http://www.ibm.com/legal/copytrade.shtml.

 Adobe, the Adobe logo, PostScript, and the PostScript logo are either registered trademarks or trademarks of Adobe Systems Incorporated in the United States, and/or
 other countries.
 AltiVec is a trademark of Freescale Semiconductor, Inc.
 AMD Opteron is a trademark of Advanced Micro Devices, Inc.
 InfiniBand, InfiniBand Trade Association and the InfiniBand design marks are trademarks and/or service marks of the InfiniBand Trade Association.
 Intel, Intel logo, Intel Inside, Intel Inside logo, Intel Centrino, Intel Centrino logo, Celeron, Intel Xeon, Intel SpeedStep, Itanium, and Pentium are trademarks or registered
 trademarks of Intel Corporation or its subsidiaries in the United States and other countries.
 IT Infrastructure Library is a registered trademark of the Central Computer and Telecommunications Agency which is now part of the Office of Government Commerce.
 Java and all Java-based trademarks and logos are trademarks or registered trademarks of Oracle and/or its affiliates.
 Linear Tape-Open, LTO, the LTO Logo, Ultrium, and the Ultrium logo are trademarks of HP, IBM Corp. and Quantum in the U.S. and other countries.
 Linux is a registered trademark of Linus Torvalds in the United States, other countries or both.
 Microsoft, Windows and the Windows logo are registered trademarks of Microsoft Corporation in the United States, other countries or both.
 NetBench is a registered trademark of Ziff Davis Media in the United States, other countries or both.
 SPECint, SPECfp, SPECjbb, SPECweb, SPECjAppServer, SPEC OMP, SPECviewperf, SPECapc, SPEChpc, SPECjvm, SPECmail, SPECimap and SPECsfs are
 trademarks of the Standard Performance Evaluation Corp (SPEC).
 The Power Architecture and Power.org wordmarks and the Power and Power.org logos and related marks are trademarks and service marks licensed by Power.org.
 TPC-C and TPC-H are trademarks of the Transaction Performance Processing Council (TPPC).
 UNIX is a registered trademark of The Open Group in the United States, other countries or both.

 Other company, product and service names may be trademarks or service marks of others.

                                                                                                                                               Revised December 2, 2010



66    Power is performance redefined                                                                                                               ©2012 IBM Corporation
Notes on benchmarks and values
The IBM benchmarks results shown herein were derived using particular, well configured, development-level and generally-available computer systems. Buyers should
consult other sources of information to evaluate the performance of systems they are considering buying and should consider conducting application oriented testing. For
additional information about the benchmarks, values and systems tested, contact your local IBM office or IBM authorized reseller or access the Web site of the benchmark
consortium or benchmark vendor.

IBM benchmark results can be found in the IBM Power Systems Performance Report at http://www.ibm.com/systems/p/hardware/system_perf.html .

All performance measurements were made with AIX or AIX 5L operating systems unless otherwise indicated to have used Linux. For new and upgraded systems, the latest
versions of AIX were used. All other systems used previous versions of AIX. The SPEC CPU2006, LINPACK, and Technical Computing benchmarks were compiled using
IBM's high performance C, C++, and FORTRAN compilers for AIX 5L and Linux. For new and upgraded systems, the latest versions of these compilers were used: XL C
for AIX v11.1, XL C/C++ for AIX v11.1, XL FORTRAN for AIX v13.1, XL C/C++ for Linux v11.1, and XL FORTRAN for Linux v13.1.


For a definition/explanation of each benchmark and the full list of detailed results, visit the Web site of the benchmark consortium or benchmark vendor.

TPC                             http://www.tpc.org
SPEC                            http://www.spec.org
LINPACK                         http://www.netlib.org/benchmark/performance.pdf
Pro/E                           http://www.proe.com
GPC                             http://www.spec.org/gpc
VolanoMark                      http://www.volano.com
STREAM                          http://www.cs.virginia.edu/stream/
SAP                             http://www.sap.com/benchmark/
Oracle, Siebel, PeopleSoft      http://www.oracle.com/apps_benchmark/
Baan                            http://www.ssaglobal.com
Fluent                          http://www.fluent.com/software/fluent/index.htm
TOP500 Supercomputers           http://www.top500.org/
Ideas International             http://www.ideasinternational.com/benchmark/bench.html
Storage Performance Council     http://www.storageperformance.org/results




                                                                                                                                         Revised December 2, 2010



67   Power is performance redefined                                                                                                           ©2012 IBM Corporation




     Notes on HPC benchmarks and values
 The IBM benchmarks results shown herein were derived using particular, well configured, development-level and generally-available computer systems. Buyers should
 consult other sources of information to evaluate the performance of systems they are considering buying and should consider conducting application oriented testing. For
 additional information about the benchmarks, values and systems tested, contact your local IBM office or IBM authorized reseller or access the Web site of the benchmark
 consortium or benchmark vendor.

 IBM benchmark results can be found in the IBM Power Systems Performance Report at http://www.ibm.com/systems/p/hardware/system_perf.html .

 All performance measurements were made with AIX or AIX 5L operating systems unless otherwise indicated to have used Linux. For new and upgraded systems, the latest
 versions of AIX were used. All other systems used previous versions of AIX. The SPEC CPU2006, LINPACK, and Technical Computing benchmarks were compiled using
 IBM's high performance C, C++, and FORTRAN compilers for AIX 5L and Linux. For new and upgraded systems, the latest versions of these compilers were used: XL C
 for AIX v11.1, XL C/C++ for AIX v11.1, XL FORTRAN for AIX v13.1, XL C/C++ for Linux v11.1, and XL FORTRAN for Linux v13.1. Linpack HPC (Highly Parallel
 Computing) used the current versions of the IBM Engineering and Scientific Subroutine Library (ESSL). For Power7 systems, IBM Engineering and Scientific Subroutine
 Library (ESSL) for AIX Version 5.1 and IBM Engineering and Scientific Subroutine Library (ESSL) for Linux Version 5.1 were used.


 For a definition/explanation of each benchmark and the full list of detailed results, visit the Web site of the benchmark consortium or benchmark vendor.
 SPEC                              http://www.spec.org
 LINPACK                           http://www.netlib.org/benchmark/performance.pdf
 Pro/E                             http://www.proe.com
 GPC                               http://www.spec.org/gpc
 STREAM                            http://www.cs.virginia.edu/stream/
 Fluent                            http://www.fluent.com/software/fluent/index.htm
 TOP500 Supercomputers             http://www.top500.org/
 AMBER                             http://amber.scripps.edu/
 FLUENT                            http://www.fluent.com/software/fluent/fl5bench/index.htm
 GAMESS                            http://www.msg.chem.iastate.edu/gamess
 GAUSSIAN                          http://www.gaussian.com
 ANSYS                             http://www.ansys.com/services/hardware-support-db.htm
                                   Click on the "Benchmarks" icon on the left hand side frame to expand. Click on "Benchmark Results in a Table" icon for benchmark
 results.
 ABAQUS                            http://www.simulia.com/support/v68/v68_performance.php
 ECLIPSE                           http://www.sis.slb.com/content/software/simulation/index.asp?seg=geoquest&
 MM5                               http://www.mmm.ucar.edu/mm5/
 MSC.NASTRAN                       http://www.mscsoftware.com/support/prod%5Fsupport/nastran/performance/v04_sngl.cfm
 STAR-CD                           www.cd-adapco.com/products/STAR-CD/performance/320/index/html
 NAMD                              http://www.ks.uiuc.edu/Research/namd                                                                     Revised December 2, 2010
 HMMER                             http://hmmer.janelia.org/
                                   http://powerdev.osuosl.org/project/hmmerAltivecGen2mod

68   Power is performance redefined                                                                                                           ©2012 IBM Corporation
Notes on performance estimates
        rPerf for AIX
        rPerf (Relative Performance) is an estimate of commercial processing performance relative to other IBM UNIX
          systems. It is derived from an IBM analytical model which uses characteristics from IBM internal workloads,
          TPC and SPEC benchmarks. The rPerf model is not intended to represent any specific public benchmark
          results and should not be reasonably used in that way. The model simulates some of the system operations
          such as CPU, cache and memory. However, the model does not simulate disk or network I/O operations.
        rPerf estimates are calculated based on systems with the latest levels of AIX and other pertinent software at
          the time of system announcement. Actual performance will vary based on application and configuration
          specifics. The IBM eServer pSeries 640 is the baseline reference system and has a value of 1.0. Although
          rPerf may be used to approximate relative IBM UNIX commercial processing performance, actual system
          performance may vary and is dependent upon many factors including system hardware configuration and
          software design and configuration. Note that the rPerf methodology used for the POWER6 systems is
          identical to that used for the POWER5 systems. Variations in incremental system performance may be
          observed in commercial workloads due to changes in the underlying system architecture.
        All performance estimates are provided "AS IS" and no warranties or guarantees are expressed or implied by
          IBM. Buyers should consult other sources of information, including system benchmarks, and application
          sizing guides to evaluate the performance of a system they are considering buying. For additional
          information about rPerf, contact your local IBM office or IBM authorized reseller.
        ========================================================================
        CPW for IBM i
        Commercial Processing Workload (CPW) is a relative measure of performance of processors running the IBM i
         operating system. Performance in customer environments may vary. The value is based on maximum
         configurations. More performance information is available in the Performance Capabilities Reference at:
         www.ibm.com/systems/i/solutions/perfmgmt/resource.html


                                                                                                                                              Revised April 2, 2007



69   Power is performance redefined                                                                                                               ©2012 IBM Corporation




 Trademarks and Disclaimers
 8 IBM Corporation 1994-2010. All rights reserved.
 References in this document to IBM products or services do not imply that IBM intends to make them available in every country.
 Trademarks of International Business Machines Corporation in the United States, other countries, or both can be found on the World Wide Web at
 http://www.ibm.com/legal/copytrade.shtml.

 Adobe, Acrobat, PostScript and all Adobe-based trademarks are either registered trademarks or trademarks of Adobe Systems Incorporated in the United States, other
     countries, or both.
 Intel, Intel logo, Intel Inside, Intel Inside logo, Intel Centrino, Intel Centrino logo, Celeron, Intel Xeon, Intel SpeedStep, Itanium, and Pentium are trademarks or registered
     trademarks of Intel Corporation or its subsidiaries in the United States and other countries.
 Linux is a registered trademark of Linus Torvalds in the United States, other countries, or both.
 Microsoft, Windows, Windows NT, and the Windows logo are trademarks of Microsoft Corporation in the United States, other countries, or both.
 IT Infrastructure Library is a registered trademark of the Central Computer and Telecommunications Agency which is now part of the Office of Government Commerce.
 ITIL is a registered trademark, and a registered community trademark of the Office of Government Commerce, and is registered in the U.S. Patent and Trademark
 Office.
 UNIX is a registered trademark of The Open Group in the United States and other countries.
 Cell Broadband Engine and Cell/B.E. are trademarks of Sony Computer Entertainment, Inc., in the United States, other countries, or both and are used under license
     therefrom.
 Java and all Java-based trademarks are trademarks of Sun Microsystems, Inc. in the United States, other countries, or both.
 Other company, product, or service names may be trademarks or service marks of others.

 Information is provided "AS IS" without warranty of any kind.

 The customer examples described are presented as illustrations of how those customers have used IBM products and the results they may have achieved. Actual
 environmental costs and performance characteristics may vary by customer.

 Information concerning non-IBM products was obtained from a supplier of these products, published announcement material, or other publicly available sources and
 does not constitute an endorsement of such products by IBM. Sources for non-IBM list prices and performance numbers are taken from publicly available information,
 including vendor announcements and vendor worldwide homepages. IBM has not tested these products and cannot confirm the accuracy of performance, capability, or
 any other claims related to non-IBM products. Questions on the capability of non-IBM products should be addressed to the supplier of those products.

 All statements regarding IBM future direction and intent are subject to change or withdrawal without notice, and represent goals and objectives only.

 Some information addresses anticipated future capabilities. Such information is not intended as a definitive statement of a commitment to specific levels of performance,
 function or delivery schedules with respect to any future products. Such commitments are only made in IBM product announcements. The information is presented here
 to communicate IBM's current investment and development activities as a good faith effort to help with our customers' future planning.

 Performance is based on measurements and projections using standard IBM benchmarks in a controlled environment. The actual throughput or performance that any
 user will experience will vary depending upon considerations such as the amount of multiprogramming in the user's job stream, the I/O configuration, the storage
 configuration, and the workload processed. Therefore, no assurance can be given that an individual user will achieve throughput or performance improvements
 equivalent to the ratios stated here.

 Prices are suggested U.S. list prices and are subject to change without notice. Contact your IBM representative or Business Partner for the most current pricing in your
 geography.
 Source: If applicable, describe source origin

70   Power is performance redefined                                                                                                               ©2012 IBM Corporation

Practical experiences and best practices for SSD and IBM i

  • 1.
    IBM What’s the value and how to optimize Performance with SSD and IBM i Gottfried Schimunek 3605 Highway 52 North Senior Architect Rochester, MN 55901 Application Design IBM STG Software Tel 507-253-2367 Development Fax 845-491-2347 Lab Services Gottfried@us.ibm.com IBM ISV Enablement Power is performance redefined ©2012 IBM Corporation Acknowledgements Thanks to Mark Olson, IBM WW Product Manager for providing this comprehensive and detailed presentation 2 Power is performance redefined ©2012 IBM Corporation
  • 2.
    Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material 3 Power is performance redefined ©2012 IBM Corporation Solid State Drive (Flash Technology) Processors Memory Disk SSD Very, very, Very, very, Very, very slow very, very, very fast comparatively very fast Fast 1,000,000 - < 10’s ns ~100 ns ~200,000 ns 8,000,000 ns Access Speed There is a huge gap between memory and disk speed 4 Power is performance redefined ©2012 IBM Corporation
  • 3.
    New Solid StateDrive (Flash Technology) Processors Memory Disk SSD Very, very, Very, very, Very, very slow very, very, very fast comparatively very fast Fast 1,000,000 - < 10’s ns ~100 ns ~200,000 ns 8,000,000 ns Access Speed ~33 ~ 12.5 ~1 second minutes hours Human Time Context 5 Power is performance redefined ©2012 IBM Corporation Basic Problem --- Disk “Slowing” Down (Relatively) Seagate 15k RPM/3.5" Drive Specifications +35% 450 Capacity (GB) Max Sustained 171 DR (MB/s) +15% Read Seek (ms) 73 75 3.6 -1% 3.4 2002 2008 Capacity growing ok (35% per year), but Read/Seek -1% & Data Rate only 15% per year While processors & memory speed up and add threads and cache Net … a growing imbalanced between disk and processor/memory 6 Power is performance redefined ©2012 IBM Corporation
  • 4.
    177GB eMLC SSDPerformance Latency - IO OPERATIONS PER SECOND Throughput Response (IOPS) (MB/s) Time (ms) Random Random Random Mixed Single Power SSD Read Write Read Write 70% Read / Read 30% Write 177GB 2.5” SSD 15 k 4k 11 k 170 MB 64 MB .25 ms in SAS SFF bays For grins … 0.12 - 0.4 0.12 - 0.4 0.12 - 0.4 ~175 ~200 8.3 – 2.5 15k rpm HDD k k k MB MB ms Note these are drive specific measurements and projections which can vary from what you might experience. The values assume 528 byte sectors running RAID-0 with no protection. Hypothetically if measured with unsupported 512 byte sectors, values would be higher. The values are highly workload dependent. Factors such as read/write mix, random/non-random data, drive cache hits/misses, data compressibility in the drive controller, large/small block, type of RAID or mirroring protection, etc will change these values. These values produced by a server with plenty of processor, memory and controller resources to push this much I/O into the SSD. Most client system applications don’t push SSD nearly this hard. 7 Power is performance redefined ©2012 IBM Corporation SSD Price Performance Processors Memory Disk SSD Very, very, Very, very, Very, very slow very, very, very fast comparatively very fast Fast $/GB $/IOP Power 740 (Max 512GB memory) One 32GB Memory feature = $6,390 One 15k HDD = ~200 IOPS* = $199.69 per GB = $2.49 / IOPS One 177GB SSD = $3,588 One 177GB SSD = ~11,000 IOPS* = $20.27 per GB = $0.33 / IOPS SSD only 10% per GB SSD only 13% per cost of memory IOPS cost of HDD IOPS values vary depending on many configuration and workload variables. The above values are fairly conservative for SSD are represent a 70/30 (read/write) mix. 200 HDD IOPS is better than many HDDs experience. Prices are suggested list prices for a Power 740 and are subject to change. Reseller prices may vary. 8 Power is performance redefined ©2012 IBM Corporation
  • 5.
    World Class eMLCSSD Performance Latency - IO OPERATIONS PER SECOND Throughput Response (IOPS) (MB/s) Time (ms) Random Random Random Mixed Single Power SSD Read Write Read Write 70% Read / Read 30% Write 177GB 2.5” SSD 15 k 4k 11 k 170 MB 64 MB .25 ms in SAS SFF bays 387GB 2.5” SSD 39 k 22 k 24 k 340 MB 375 MB .20 ms in SAS SFF bays For grins … 0.12 - 0.4 0.12 - 0.4 0.12 - 0.4 ~175 ~200 8.3 – 2.5 15k rpm HDD k k k MB MB ms Note these are drive specific measurements and projections which can vary from what you might experience. The values assume 528 byte sectors running RAID-0 with no protection. Hypothetically if measured with unsupported 512 byte sectors, values would be higher. The values are highly workload dependent. Factors such as read/write mix, random/non-random data, drive cache hits/misses, data compressibility in the drive controller, large/small block, type of RAID or mirroring protection, etc will change these values. These values produced by a server with plenty of processor, memory and controller resources to push this much I/O into the SSD. Most client system applications don’t push SSD nearly this hard. 9 Power is performance redefined ©2012 IBM Corporation SSD Price Performance Processors Memory Disk SSD Very, very, Very, very, Very, very slow very, very, very fast comparatively very fast Fast $/GB $/IOP Power 740 (Max 512GB memory) One 32GB Memory feature = $6,390 One 15k HDD = ~200 IOPS* = $199.69 per GB = $2.49 / IOPS One 387GB SSD = $6,200 One 387GB SSD = ~24,000 IOPS* = $16.02 per GB = $0.26 / IOPS SSD only 8% per GB SSD only 10% per cost of memory IOPS cost of HDD IOPS values vary depending on many configuration and workload variables. The above values are fairly conservative for SSD are represent a 70/30 (read/write) mix. 200 HDD IOPS is better than many HDDs experience. Prices are suggested list prices for a Power 740 and are subject to change. Reseller prices may vary. 10 Power is performance redefined ©2012 IBM Corporation
  • 6.
    Power eMLC SSDPerformance versus 15k rpm HDD Drive to Drive comparisons SSD offers up to New eMLC SSD HDD is 12X – 41X 66x – 250x more I/O nearly 2X WRITE slower (latency) Operations Per throughput (MB/s) than SSD Second (IOPS) than HDD (milliseconds) 1.8X 41X 250X 1X 125X 12X 66X 33X 1X 1.25X 1X HDD SSD SSD HDD SSD SSD HDD SSD SSD 177GB 387GB 177GB 387GB 177GB 387GB Drive-to-drive compares ignore any caching by SAS controller 11 Power is performance redefined ©2012 IBM Corporation It All Stacks Up Depending on the workload, the HDD stack may be much higher on the left. This shows a fairly conservative HDD vs SSD performance comparison PLUS … the PCI slots for the SAS controllers make the HDD stack higher 1/10th Qty HDD 1/20th Qty HDD 1/20th Qty HDD 15k rpm HDD 177 GB SSD 387 GB SSD 387 GB SSD (SFF) (SFF) (SFF) (1.8”) 12 Power is performance redefined ©2012 IBM Corporation
  • 7.
    Power Solid StateDrive Processors Memory Disk SSD Very, very, Very, very, Very, very slow very, very, very fast comparatively very fast Fast 1,000,000 - < 10’s ns ~100 ns ~200,000 ns 8,000,000 ns Access Speed Sweet spots 1. Batch window reduction for disk bound applications You can cut up to 40-50% off window 2. Response time - transaction/data base for disk bound applications Internal drives or perhaps even SAN drives 3. Analytics Key points -- A modest quantity of SSD can often make a big difference -- Both write-heavy and read-heavy work can be fine for today’s SSD – biggest performance boost for random read workload 13 Power is performance redefined ©2012 IBM Corporation SSD Client - Batch Window Reduction Example 1 Associated Bank needed to reduce month end batch run time from 4+ hours to under 3 hours SSDs cut 1.5 hours from batch run time 40% Reduction Plus a 16% reduction in # of disk drives Batch Performance Runs # of SAS # of Batch 5 Disk Drives SSDs Run Time 4 Base run 72 0 4:22 Hours 3 2 SSD run 1 72 8 2:43 1 SSD run 2 60 4 2:48 0 72 HDD 72 HDD + 8 SSD 60 HDD + 4 SSD Placed eight DB2 Objects (table, index, view) on SSD Source: IBM Power Systems Performance and Benchmark Center 5-23-09 14 Power is performance redefined ©2012 IBM Corporation
  • 8.
    SSD Client -Batch Window Reduction Example 2 50% Reduction with SSD Customer in health care industry Batch Windows needed to reduce batch windows significantly Daily batch running 10+ hours H o u rs Monthly batch running 30+ hours Added 12 SSDs to 168 HDDs Cut 50% from daily run time Cut 50% from monthly run time . Monthly Daily 15 Power is performance redefined ©2012 IBM Corporation SSD Client – Data Warehouse Example SAP Customer using Business 60-87% reductions with Intelligence Warehouse (BW 7.0) SSD installed an all-SSD configuration of about 800GB. 4 days Huge improvement in aggregate builds / compression Significant reductions in queries 87% 20 min reduction 65% reduction 60% 7 min reduction 1/2 day 5 min 2 min HDD SSD HDD SSD HDD SSD Sample query 1 Sample query 2 Sample build/compression 16 Power is performance redefined ©2012 IBM Corporation
  • 9.
    SSD Client –Deep Analytics ~85% reductions with SSD Client doing complex financial 48 hour analysis of financial transactions Run combined with WW economical factors. Millions of records. Insights guide client in making tactical and strategic decisions. ~85% reduction Transformed application from “interesting and helpful” to 6-7 hours “critical and essential” HDD SSD Sample build/compression 17 Power is performance redefined ©2012 IBM Corporation SSD Faster Analytics Data Warehouse Faster answers Faster/better decision making -------------------------- SSD example: Leveraging DB2 temp space with Iterative / modest amount of SSD capacity drill-down First query draws data from HDD “relatively slow”, question but data then cached on SSD. Second, third, fourth, etc query MUCH faster !!!! 1 2 When query work of this data ceases, SSD space 3 reused for new queries. 4 Questions/analysis are usually iterative. The first question generates additional drill-down or expanded questions. The raw data for the first question gets reused a lot until the topic exploration is completed. Example – “what am i selling?” “what am i selling in the evening?” “what am i selling in the evening by store?” etc, etc 18 Power is performance redefined ©2012 IBM Corporation
  • 10.
    SSD Client Example– IPL Reduction IBM Development has projected Less downtime modest improvement for IBM i and for AIX, but ….. IBM i POWER6 520 client with 16 drives (4 SSD and 12 HDD) Client put load source on SSD Now reporting 3 minute IPLs POWER7 IBM i client also reporting 3 minute IPLs Much faster PTF applications What is your cost per minute or cost per hour for down time? How long is your typical IPL? 19 Power is performance redefined ©2012 IBM Corporation Many Systems Buy “Extra” Disk Arms for Performance HDD % utilization of capacity is held low to help ensure higher I/O performance and more consistent response time - arm movement, spinning platter an issue Write cache and read cache attempt to buffer the impact Often less than 30-50% full for performance sensitive workloads SSD % utilization of capacity not restricted Can run much closer to 100% full 20 Power is performance redefined ©2012 IBM Corporation
  • 11.
    Mixed SSD +HDD Can be Great Solution It is typical for data bases to have a large percentage of data which is infrequently used (“cold”) and a small percentage of data which is frequently used (“hot”) Hot data may be only 10-20% capacity, but represent 80-90% activity SSD offers best price performance when focused on “hot” data HDD offers best storage cost, so focus it on “cold” data …. a hierarchical approach Cold May be able to use larger HDD and/or a larger % capacity used Hot Can run SSD closer to 100% capacity 21 Power is performance redefined ©2012 IBM Corporation Save Space/Energy/Cooling A few SSD can often replace many HDD Fewer total drives Maybe fewer controllers Fewer I/O drawers Fewer cables I/O drawer maintenance reduction can offset SSD maintenance 22 Power is performance redefined ©2012 IBM Corporation
  • 12.
    A Power 740Scenario (your situation will vary) Acquisition Power 740 Single LPAR IBM i V6R1 9% All HDD, 28 drives, mirrored versus Mixed HDD & SSD, mirrored 12 15k RPM HDDs 4 SAS-bay-based 177GB SSDs All HDD Mix HDD & SSD Achieves similar performance results Maintenance Energy Rack "U's" 22 % 39 40 % % All HDD Mix HDD & SSD All HDD Mix HDD & SSD All HDD Mix HDD & SSD 23 Power is performance redefined ©2012 IBM Corporation Should You Use SAN/SVC SSD or Internal SSD? Pro’s Con’s Use Internal yes yes SSD Use SAN/SVC yes yes SSD “Internal” = drives located in a system unit, in an I/O drawer with PCI slots or in a disk-only I/O drawer. 24 Power is performance redefined ©2012 IBM Corporation
  • 13.
    DAS & SAN- Two Good Options Both options are strategic Both options have their strengths Can use both options on the same server DAS SAN Direct Attached Storage Storage Area Network (“internal”) (“external”) • Fastest (lower • Fast latency) • Multi-server sharing • Typically lower cost • Advanced functions/values Flash Copy, Metro/Global hardware/software Mirror, Live Partition Mobility, • Often simpler config Easy Tier 25 Power is performance redefined ©2012 IBM Corporation SSD - SAN/SVC or Internal …. Or Mixed? Pro’s Con’s 1. Lower latency - internal is about 1. If already have SAN/SVC, adds 0.3 milliseconds faster (per access complexity of having internal Use .. it can add up) (can be larger) PLUS SAN/SVC 2. If don’t already have SAN/SVC, Internal lower cost & less learning 2. Reduces value of SAN/SVC high function capabilities – Flash SSD 3. Multiple Config options Copy, MetroMirror, HA, partition 4. Handle just like other internal mobility, etc storage 1. Leverage SAN/SVC well-known 1. If don’t have SAN/SVC, need value proposition of initial SAN/SVC investment in Use manageability, control, hardware, software, skills functionality, performance, etc 2. Many medium/entry SAN/SVC SAN/SVC 2. If already have SAN/SVC, less don’t offer SSD SSD learning, reduced cost to add 3. DS8000 & V7000 EasyTier MIXED: If using a SAN/SVC which doesn’t have SSD, OR if not using the higher function capability of a SAN/SVC (for example you do backup/restore functions just like it was an internal drive); THEN combining internal Power Systems SSD with SAN/SVC storage can be a good thing. “Internal” = drives located in a system unit, in an I/O drawer with PCI slots or in a disk-only I/O drawer. 26 Power is performance redefined ©2012 IBM Corporation
  • 14.
    SSD Technology “Myth” “Beware SSD as they wear out as they have a limited number of writes” Key facts to correct myth …. this is not a concern for IBM Power Systems SSD IBM Power Systems SSD are industrial/enterprise drives designed to handle this. Design points are many years of 24x7x365 heavy write workloads. These are not “PC-grade” or “consumer-grade” flash drives. Even if you do somehow “use up all the writes”, the SSD reports status prior to it being a real problem to the server and server sends a message to the operator or to IBM for a future scheduled repair action. This is just like a disk drive reporting a weakening status. Replacement SSD is covered under IBM Maintenance. Just like disk drives, you want to protect contents using system mirroring or RAID protection 27 Power is performance redefined ©2012 IBM Corporation Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material 28 Power is performance redefined ©2012 IBM Corporation
  • 15.
    Implementing “Hot” and“Cold” Data AIX IBM i Ability to granularly/flexibly select and locate hot files on SSD #1 Best integrated, automated Key AIX performance tools are filemon capability available in the industry & iostat. today Database vendors provide hot data “Trace and Balance” function part of analysis tools, example: DB2 Snapshot. IBM i – automated in i 7.1 Migrating hot data Monitors by partition or ASP (Aux Migratepv is often useful Storage Pool) to determine hot/cold Softek Migration Tool provides a nice Upon request, automatically moves hot suite of functions and can be combined data to SSD, cold to HDD with IBM Services Can re-monitor & rebalance any time See Total Storage Productivity Center A few key OS files can automatically SSD white paper for additional be placed on SSD insights Can specify specific data base New/enhanced tools being developed objects to be placed on SSD See white paper for additional insights Additional enhancements being developed 29 Power is performance redefined ©2012 IBM Corporation IBM i Load Balancer Industry leading automated capability Monitors partition/ASP using “trace” IBM i intelligent hot/cold placement makes a big difference vs normal IBM User turns trace on during a peak time striping / scattering of data across all User turns trace off after reasonable drives. sample time Negligible performance impact expected This example 72 HDD + 16 SSD Tool monitors “reads” to identify hot data Looks at 1MB stripes of data Upon command, automatically moves hot Application Response time data to SSD, cold data to HDD 72 HDD + 16 SSD No Balance 72 HDD + 16 SSD Data Balanced Minimal performance impact, done in background Can remonitor and rebalance any time Probably a weekly or monthly activity Trans/min Perhaps less often if data not volatile Predicting/analyzing what % of data is hot for presale analysis to help size the number of SSD required: • Use PEX tool/output • Output from monitor (will need technical person to interpret) 30 Power is performance redefined ©2012 IBM Corporation
  • 16.
    IBM i SSDBalancing One of 5 ASP Balancing Types Balance data between busy units and idle units (STRASPBAL TYPE(*USAGE)) Make all of the units in the ASP have the same percent full (STRASPBAL TYPE(*CAPACITY)) Drain the data from a disk, to prepare unit it to be removed from the configuration (STRASPBAL TYPE(*MOVDTA)) (Almost obsolete) move hot data off of a compressed disk, and move cold data to the compressed disk (STRASPBAL TYPE(*HSM)) Requires specific disk controllers with compression capability – feats #2741/2748/2778. Compression only allowed in user ASPs Move cold data to HDDs and move hot data to SSDs (STRASPBAL TYPE(*HSM)) 31 Power is performance redefined ©2012 IBM Corporation Using TRCASPBAL to place hot data on SSDs – IBM i HDD1 HDD2 HDD3 HDD4 SSD 100 500 100 2000 6000 10000 100 1200 6000 900 3000 10000 100 300 800 500 900 6000 900 0 4000 300 300 400 4000 300 200 600 700 1000 100 100 Trace ASP balance counts the read operations based on 1MB stripes TRCASPBAL SET(*ON) ASP(1) TIMLMT(*NOMAX) Start ASP balance moves the data STRASPBAL TYPE(*HSM) ASP(1) TIMLMT(*NOMAX) Target is 50% of read operations to be on SSD Cold data is moved (multiple threads) to HDDs, hot data is moved (single thread) to SSD 32 Power is performance redefined ©2012 IBM Corporation
  • 17.
    How to FindHot Tables and Indexes - IBM i Performance Explorer BY FAR the best solution Perform analysis based on read complete and write complete events DB2 maintains statistics about the number of operations on a table or index Statistics are zeroed on each IPL Statistics only identify candidates (logical operations include both random and sequential operations) Available via: Display file description (DSPFD) Application programming interface (API) QUSRMBRD System i Navigator Health Center (V6R1 only) SQL catalog queries 33 Power is performance redefined ©2012 IBM Corporation Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material 34 Power is performance redefined ©2012 IBM Corporation
  • 18.
    Summary Performance Comparisonsof 3 SSD Options SSD PCIe-based SAS-Bay-Based GB capacity 177 GB 69 GB 177 GB Flash Technology eMLC SLC eMLC SSD drive Base compare Similar, may be (reference a little slower in (no controller Similar point) write-heavy considerations) usage 35 Power is performance redefined * Assuming same number of drives per controller/adapter ©2012 IBM Corporation Performance Comparisons of 69/177GB SSD Options SSD PCIe-based SAS-Bay-Based GB capacity 177 GB 69 GB 177 GB Flash Technology eMLC SLC eMLC SSD only performance (no Base compare controller) read heavy Similar, but can vary a little (reference point) Similar, but can vary a little workload SSD-only performance (no Typically somewhat slower Base compare controller) write heavy Similar (reference point) (0-15%) workload (due to add’l function in SSD) Controlled by Tied directly to ONE controller Controlled by #5805/5903 #5805/5903 or by #5906 with no write cache with max 4 or by #5906 adapter up to Controllers / adapters drives. RAID-5 slowed due to adapter up to 9/8 drives 9/8 drives per per controller/controller no write cache. controller/controller pair pair SSD PLUS Controller Base compare performance Typically similar * (reference point) Typically similar Read heavy workload Similar throughput, but SSD PLUS Controller potentially slower response Typically somewhat slower Base compare (0-5% mixed HDD/SSD) performance time due to no write cache * --- (reference point) -- (0-15% SSD only) Write heavy workload (due to add’l function in SSD) Bigger impact if RAID-5/6 * Assuming same number of drives per controller/adapter 36 Power is performance redefined ©2012 IBM Corporation
  • 19.
    Other Performance Insights– background reading • Time to Write on a HDD is the same as time to read on an HDD (1:1 ratio) • Time to Write on an SSD is much longer than a read on an SSD around (3:1 ratio) • Thus the biggest SSD performance boost is for reads compared to HDD. SSDs do reads at < 1 ms while from HDD are typically around 3-15 ms • Writes to SSD are faster than writes to HDD …. BUT …. Write cache on a SAS controller is even faster than a write to SSD. SSD can empty out the write cache faster than HDD, so SSD+write cache is generally faster than HDD+write cache, but comparisons have more “it depends” caveats • The size of information being handled makes a difference. Handling bigger blocks of data takes longer, especially if doing writes. • Randomness of information also plays a part. If there are a lot of smaller blocks of information which happen to be close together where they will be eventually be stored, then they are more likely to be in the same page of space in the SSD device’s internal controller. Thus the access and/or writes can happen “above” the real flash memory and is faster. • HDD have had ongoing cost/GB improvements over the last 5-10years, but have had little access performance enhancements. Most performance boosts have been through enhancements in controllers of HDD, not the spinning platter or arm. No significant HDD performance improvements are currently foreseen. Thus the gap between server memory and HDD will continue to widen. • If operating system can predict the data needed, it can issue a read prior to the application making the request reducing HDD delay to application. But random reads by definition are not feasible to pre-fetch. Applications with lots of random reads are thus THE ideal area for SSD benefits. • Alternatives to SSD – 1) Can “pin” information in memory. This is even faster than SSD. But SSD can provide a lot more GB of capacity and is usually more cost effective per GB. 2) Also could go buy a lot more adapters with write cache and/or spread data out, but this is less cost effective than SSD. • If an HDD fails, it can take hours to format and bring the new HDD into sync with either its mirrored pair or with the rest of the RAID-5 array. The larger the drive’s capacity, the longer the resync time can be. Until re- synced there is risk a second failure could crash the partition or application. If an SSD is replaced, the time to resync so that the RAID array or mirroring protection is restored is MUCH, MUCH faster (minutes vs hours) with SSD than HDD. • For absolute best performance use internal SSD vs SAN SSD. There in about 0.3ms (3/10ths milliseconds) additional latency in accessing SAN. For I/O intensive applications this adds up. But SANs can offer a lot of other operational and managerial advantages for many clients. The performance trade off may be a good thing to do in the overall decision. • For VERY rough rules of thumb for mixing HDD & SSD – use about 5-15% of the GB of the data – or use about 5-10% of the drives. 37 Power is performance redefined ©2012 IBM Corporation SSD Config Options --- April 2012 Power Systems (internal / DAS) PCIe-based SAN-based SSD SAS-bay-based SSD DS8000 #5805 #5913 #ESA1/A2 #5888 Ultra #2053/54/55 SVC In CEC w/ int Gen1 PCIe Gen2 PCIe Gen2 PCIe Drawer RAID & SSD V7000 SAS contrlr 380MB 1800MB 0 MB 3100MB SAS Adapter XIV cache cache cache cache Many DAS SSD config options* for Power Clients Options vary Performance Price Physical size Where tested/supported Function * PCI-X 1.5GB SAS adapter not shown to focus on most current technologies 38 Power is performance redefined ©2012 IBM Corporation
  • 20.
    Power DAS SSDOptions: April 2012 PCIe-based SSD SAS-bay-based SSD In CEC w/ int #5805 & #5913 & #ESA1/A2 #5888 Ultra #2053/54/55 SAS contrlr #5887*** #5887*** & #5887*** Drawer Number PCIe slots used 2 (4 mirror) 0 2 2 2 0 Number GX slots used 0 0 0 0 0 1-2 (710/730=2) Max SSD attach 4 3-8 mdl dependent 9 24 24 30 Max 177GB busy SSD W1 4 W1 2-3 W1 4-6 W1 ~24 W1 ~24 N/A reasonably supported @ W2 3-4 W2 1-2 W2 3-4 W2 ~24 W2 ~24 Max 387GB busy SSD N/A W1 1-2 W1 2-3 W1 ~20 W1 ~18 W1 ~22 reasonably supported @ W2 1 W2 1-2 W2 ~14 W2 ~14 W2 ~14 Write cache (MB) 0 175 380 1800 0 3100 GB / SSD 177 177 or 387 177 or 387 177 or 387 177 or 387 387 Servers supported - Newest 710-740 (C models) Y Y Y 710/730 limit** Y 710/730 limit** Y 720/740 limit * 710 740 - Rest POWER7 710-795 Y, except 795 Y, except 795 Y not 710/730 Y not 710/730 N N (SOD) - POWER6 Y, except 595 N Y 177GB SSD Y 177GB SSD N N AIX/IBM i/Linux support Y Y Y Y Y AIX / Linux Mix HDD & SSD N Y N Y N N (SOD) Rack space needed depends N/A 2U+ 2U+ 2U+ 1U Easy Tier N N N N N N (SOD) Approximate USA list price $3k + 2PCIe 0 $4.4k/pair + $15k/pair + $6.1k + 6.1k $24.5k + $2k with zero SSD for Mdl 740 slots $5.4k drawer $5.4k drawer + $5.4k drwr PCIe adpter PowerHA: share w/ 2 servers N N Y Y Y Y @ This is a simple rule of thumb. Actual reasonable maximum depends on many factors. Prices subject to * ESA1 not in 720/740 system unit. Can place in #5802/5877 I/O drawer attached to 720/740 change. Reseller ** Not in 710/730 system unit, but 730 (8231-E2C) can have in #5802/5877 I/O drawer prices can vary. *** Possible to use #5802 or 5803 I/O drawer instead of #5887 EXP24S Drawer. Max 177GB SSD attach would differ for #5913 and ESA1/ESA2 W1 = transaction/command/CPW type workload, smaller block, IOPS sensitive RAID5 W2 = save/restore/large-file type workload, Throughput sensitive. RAID5 Assumes #5887 is in mode2 using two SAS ports for higher bandwidth. 39 Power is performance redefined ©2012 IBM Corporation Performance: PCIe-Based vs. 69GB SAS-Bay-Based SSD Using 380MB Write Cache RAID Adapters running SAS-Bay-Based (2) #5903/5278 adapters + (8) 69GB SSD (2) #2055 + (8) 177GB SSD Running RAID-5 Running RAID-5 2 PCIe slots 4 PCIe slots Similar performance – RAID-5 to RAID-5 10 SAS-Bay- Appl Response time (ms) 1 Based PCIe-Based 0.1 0.01 SAS-bay-based 177GB SSD 0.001 0 20000 40000 60000 80000 100000 similar to 69GB Appl Trans/m in SSD Notes: • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can impact this comparison. (Your results may differ.) The above measurement used 60% reads and 40% writes. • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache. . 40 Power is performance redefined ©2012 IBM Corporation
  • 21.
    Performance: PCIe-Based vs.69GB SAS-Bay-Based SSD Using 380MB Write Cache RAID Adapters running SAS-Bay-Based (2) #5903/5278 adapters + (8) 69GB SSD (2) #2055 + (8) 177GB SSD Running RAID-5 Running mirroring 2 PCIe slots 4 PCIe slots Mirrored PCIe-based outperforms Medium cache RAID-5 SAS-Bay-Based 10 Appl Response time (ms) SAS-Bay- PCIe-Based 1 Based 0.1 SAS-bay-based 0.01 177GB SSD 0.001 similar to 69GB 0 50000 100000 150000 200000 SSD Application trans/min Notes: • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can impact this comparison. (Your results may vary.) The above measurement used 60% reads and 40% writes. • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache. . 41 Power is performance redefined ©2012 IBM Corporation Performance: PCIe-Based vs. 69GB SAS-Bay-Based SSD Using 1500MB Write Cache RAID Adapters running SAS-Bay-Based SSD (1) #2055 + (4) 177GB SSD (1) #5904/6/8 adapters + (4) 69GB SSD Running RAID-5 Running RAID-5 2 PCIe slots 2 PCI-X slots Large cache PCI-X adapter & SSD outperforms PCIe-Based SSD ( RAID-5 to RAID-5 ) 10 PCIe-Based Appl Response time (ms) 1 0.1 SAS-bay-based 0.01 SAS-Bay- Based 177GB SSD similar to 69GB 0.001 SSD 0 20000 40000 60000 80000 Application trans/min Notes: • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can impact this comparison. (Your results may vary.) The above measurement used 60% reads and 40% writes. • Write cache was turned on for #5904/6/8 adapters. #2055 has no write cache. 42 Power is performance redefined ©2012 IBM Corporation
  • 22.
    Performance: HDD vs.SSD+HDD Hybrid Using 380MB Write Cache RAID Adapters running SAS-Bay-Based (2) 5903/5278 + (18) HDD (2) #5903/5278 adapters ) + (18) HDD Running mirrored + (2) #2055 + (8) 177GB SSD Running mirrored Hot data located on SSD Adding SSD and placing hot data on SSD, grew workload capability by nearly 3X Appl Response Time (ms) 10 HDD only 1 SSD+HDD hybrid 0.1 0.01 0.001 0 50000 100000 150000 200000 250000 Application Trans/min Notes: • Data points measured using an artificial transaction workload which IBM believes will reasonably represent many commercial client workloads. Differences in application usage and data, for example the percentage of random reads vs percentage of writes can impact this comparison. The above measurement used 60% reads and 40% writes. • Write cache was turned on for #5903/5278 adapters. #2055 has no write cache. 43 Power is performance redefined ©2012 IBM Corporation SSD Analyzer Package Provides: - SSD Analysis Overview - Disk Read Time - Job & Tasks by Read Time Drilldown from here into CS & GHI perspectives Download from SSD Techdoc site: http://www-03.ibm.com/support/techdocs/atsmastr.nsf/WebIndex/PRS3780 44 Power is performance redefined ©2012 IBM Corporation
  • 23.
    Disk Response TimeCharts Detailed charts are based upon the increased detail QAPMDISKRB groups Use tooltips to fly over & get specific data 45 Power is performance redefined ©2012 IBM Corporation CSI – SSD Candidate Screening Offered at 7.1 only, helps a user determine if SSDs could help performance. It needs data from QAPMDISKRB. 46 Power is performance redefined ©2012 IBM Corporation
  • 24.
    CSI – SSDCandidate Screening Offered at 7.1 only, helps a user determine if SSDs could help performance. 47 Power is performance redefined ©2012 IBM Corporation CSI – SSD Candidate Screening job details report This is similar to the green screen SSD Analyzer tool: http://www-03.ibm.com/support/techdocs/atsmastr.nsf/WebIndex/PRS3780 48 Power is performance redefined ©2012 IBM Corporation
  • 25.
    Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material 49 Power is performance redefined ©2012 IBM Corporation Power Systems SSD Statements of Direction Provided August 2010 IBM plans to enhance its Power Systems Enterprise Class SSD solutions with technology designed to continue to provide significant improvements in performance and storage density over time. IBM plans for these IBM Power Systems enhancements to include both SAS-bay-based and PCIe-based SSD product offerings that will leverage IBM's investments in its SSD optimized Enterprise Class RAID Storage Controllers. All statements regarding IBM's future direction & intent are subject to change or withdrawal without notice, and represents goals & objectives only. Information regarding potential future products is intended to outline our general product direction and it should not be relied on in making a purchase decision. The information mentioned regarding potential future products is not a commitment, promise, or legal obligation to deliver any material, code or functionality. Information about potential future products may not be incorporated into any contract. The development, release, and timing of any future features or functionality described for our products remains at our sole discretion. 50 Power is performance redefined ©2012 IBM Corporation
  • 26.
    Power Solid StateDrives (SSD) Roadmap 2009 • Apr/May - Introduction SAS-bay-based • July/Oct/Nov - Misc enhancements • Nov/Dec - Huge price action – matching memory price action 2010 • Feb - support in Power 750, 755, 770, 780 • April - IBM i 7.1 enhancements • August - Support in new POWER7 servers & AIX 7.1 enhancements • August - Introduce additional SSD config option … PCIe-based 2011 • Enhancements to both SAS-bay-based and PCIe-based SSD More capacity in SSD devices More performance in SAS controllers 2012 … more enhancements See SODs made August 2010. All statements regarding IBM's future direction & intent are subject to change or withdrawal without notice, and represents goals & objectives only. 51 Power is performance redefined ©2012 IBM Corporation Roadmap: SSD Configuration 2011 Options SAS-bay-based SAS Bays PCI SAS SSD SSD SSD SSD SSD SSD SSD SSD SSD SSD controller New PCIe card Larger capacity SSD (pair for redundancy) Continue Hot plug SSD Large cache, high performance More SSD modules / controller PCIe-based Double-wide PCIe card PCIe SAS SSD (need pair for hot plug) SSD controller SSD Up to 4 SSD modules SSD See SODs made August 2010. All statements regarding IBM's future direction & intent are subject to change or withdrawal without notice, and represents goals & objectives only. 52 Power is performance redefined ©2012 IBM Corporation
  • 27.
    Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material 53 Power is performance redefined ©2012 IBM Corporation SSD Analyzer Tool for IBM i • Quick, easy, no-charge analysis looks at standard performance report output • Provides “probably yes”, “probably no”, or “maybe • Provides rough estimate of quantity of SSD to recommend SSD ANALYSIS TOOL (ANZSSDDTA) Type choices, press Enter. PERFORMANCE MEMBER . . . . . . . *DEFAULT__ Name, *DEFAULT LIBRARY . . . . . . . . . . . __________ Name Additional Parameters REPORT TYPE . . . . . . . . . . *SUMMARY *DETAIL, *SUMMARY, *BOTH TIME PERIOD:: START TIME AND DATE:: BEGINNING TIME . . . . . . . . *AVAIL__ Time, *AVAIL BEGINNING DATE . . . . . . . . *BEGIN__ Date, *BEGIN END TIME AND DATE:: ENDING TIME . . . . . . . . . *AVAIL__ Time, *AVAIL ENDING DATE . . . . . . . . . *END____ Date, *END NUMBER OF RECORDS IN REPORT . . 50__ 0 - 9999 Bottom F3=Exit F4=Prompt F5=Refresh F12=Cancel F13=How to use this display F24=More keys Available via www.ibm.com/support/techdocs in “Presentations & Tools”. Search using keyword SSD 54 Power is performance redefined ©2012 IBM Corporation
  • 28.
    Additional Marketing Materials Brochure …. Power System SSD Web pages Positioning, educating, linking to other materials www.ibm.com/systems/power/hardware/peripherals/ssd/index.html Additional white paper information being worked on by Development – availability dates TBD List of existing SSD white papers follow on separate slides 55 Power is performance redefined ©2012 IBM Corporation SSD Brochure Sales personnel can access brochure through SSI / PW web pages 56 Power is performance redefined ©2012 IBM Corporation
  • 29.
    Power Systems SSDWeb Pages Several informative pages on SSD positioned from a Power Systems perspective http://www.ibm.com/ systems/power/hard ware/peripherals/ss d/index.html 57 Power is performance redefined ©2012 IBM Corporation Five Power Systems SSD White Papers IBM Power SSD vs Consumer SSD (posted Nov 2009) “Advantages of True Enterprise Solid State Drives (SSDs) in Enterprise Systems” AIX-specific (posted Apr 2009) “Driving Business Value on Power Systems with Solid State Drives” IBM i-specific (posted May 2009) “Performance Value of Solid State Drives using IBM i” First published May 2009 More SSD technology specific – AIX/IBM i/Linux appropriate (posted Jun 2009) “Performance Impacts of Flash SSDs Upon IBM Power Systems” Above papers in Power Systems web site under “Resources/Literature” http://www.ibm.com/common/ssi/apilite?infotype=SA&infosubt=WH&lastdays =1825&hitlimit=200&ctvwcode=US&pubno=POW*USEN&appname=STGE_PO_ PO_USEN_WH&additional=summary&contents=keeponlit 5th paper for an SAP environment http://www.sdn.sap.com/irj/sdn/db4?rid=/library/uuid/90a1637e-065f-2c10- 3ab7-bea9375fc88d 58 Power is performance redefined ©2012 IBM Corporation
  • 30.
    i Oriented References/Tool IBM - Performance Management on IBM i Resource Library http://www.ibm.com/systems/i/advantages/perfmgmt/resource.html Performance Value of Solid State Drives using IBM i http://www.ibm.com/systems/resources/ssd_ibmi.pdf Performance Impacts of Flash SSDs Upon IBM Power Systems http://www.ibm.com/common/ssi/cgi- bin/ssialias?infotype=SA&subtype=WH&htmlfid=POW03028USEN&attachme nt=POW03028USEN.PDF&appname=STGE_PO_PO_USEN_WH Driving Business Value on Power Systems with Solid State Drives http://www.ibm.com/common/ssi/cgi- bin/ssialias?infotype=SA&subtype=WH&htmlfid=POW03025USEN&attachme nt=POW03025USEN.PDF&appname=STGE_PO_PO_USEN_WH IBM Systems Lab Services and Training http://www.ibm.com/systems/services/labservices IBM Power Systems(i) Benchmarking and Proof-of-Concept Centers http://www.ibm.com/systems/i/support/benchmarkcenters 59 Power is performance redefined ©2012 IBM Corporation Agenda SSD introduction/overview Implementing hot/cold Performance insights Roadmap for Power Systems SSD SSD reference material Questions? 60 Power is performance redefined ©2012 IBM Corporation
  • 31.
    IBM Tak Dank je Gracia Merci Thanks s Grazie Danke Takk Power is performance redefined ©2012 IBM Corporation IBM Power is performance redefined ©2012 IBM Corporation
  • 32.
    Performance and ScalabilityServices The IBM i Performance and Scalability Services Center can provide facilities and hardware IN ROCHESTER to assist you in testing hardware or software changes “Traditional” benchmarks Release-to-release upgrades Assess application performance when migrating to a new release of IBM I Stress test your system Determine impact of application changes Proofs of Concept (e.g. HA alternatives; SSD analysis, external storage, etc.) Evaluate application scalability Capacity planning … all with the availability of Lab Services IBM i experts and development personnel 63 To request any of these services, submit at: Power is performance redefined ©2012 IBM Corporation IBM Systems Lab Services and Training Mainframe Systems Our Mission and Profile Support the IBM Systems Agenda and accelerate the adoption of new products and solutions Power Systems Maximize performance of our clients’ existing IBM systems Deliver technical training, conferences, and other services tailored to System x & Bladecenter meet client needs Team with IBM Service Providers to optimize the deployment of IBM solutions (GTS, GBS, SWG Lab Services and our IBM Business System Storage Partners) Our Competitive Advantage IT Infrastructure Optimization Leverage relationships with the IBM development labs to build deep technical skills and exploit the expertise of our developers Combined expertise of Lab Services and the Training for Systems Data Center Services team Skills can be deployed worldwide to assure all client needs can be Successful worldwide history: Training Services met 17 years in Americas, 9 years in Europe/Middle East/Africa, 5 years in Asia Pacific www.ibm.com/systems/services/labservices stgls@us.ibm.com 64 Power is performance redefined ©2012 IBM Corporation
  • 33.
    Special notices This document was developed for IBM offerings in the United States as of the date of publication. IBM may not make these offerings available in other countries, and the information is subject to change without notice. Consult your local IBM business contact for information on the IBM offerings available in your area. Information in this document concerning non-IBM products was obtained from the suppliers of these products or other public sources. Questions on the capabilities of non-IBM products should be addressed to the suppliers of those products. IBM may have patents or pending patent applications covering subject matter in this document. The furnishing of this document does not give you any license to these patents. Send license inquires, in writing, to IBM Director of Licensing, IBM Corporation, New Castle Drive, Armonk, NY 10504-1785 USA. All statements regarding IBM future direction and intent are subject to change or withdrawal without notice, and represent goals and objectives only. The information contained in this document has not been submitted to any formal IBM test and is provided "AS IS" with no warranties or guarantees either expressed or implied. All examples cited or described in this document are presented as illustrations of the manner in which some IBM products can be used and the results that may be achieved. Actual environmental costs and performance characteristics will vary depending on individual client configurations and conditions. IBM Global Financing offerings are provided through IBM Credit Corporation in the United States and other IBM subsidiaries and divisions worldwide to qualified commercial and government clients. Rates are based on a client's credit rating, financing terms, offering type, equipment type and options, and may vary by country. Other restrictions may apply. Rates and offerings are subject to change, extension or withdrawal without notice. IBM is not responsible for printing errors in this document that result in pricing or information inaccuracies. All prices shown are IBM's United States suggested list prices and are subject to change without notice; reseller prices may vary. IBM hardware products are manufactured from new parts, or new and serviceable used parts. Regardless, our warranty terms apply. Any performance data contained in this document was determined in a controlled environment. Actual results may vary significantly and are dependent on many factors including system hardware configuration and software design and configuration. Some measurements quoted in this document may have been made on development-level systems. There is no guarantee these measurements will be the same on generally- available systems. Some measurements quoted in this document may have been estimated through extrapolation. Users of this document should verify the applicable data for their specific environment. Revised September 26, 2006 65 Power is performance redefined ©2012 IBM Corporation Special notices (cont.) IBM, the IBM logo, ibm.com AIX, AIX (logo), AIX 5L, AIX 6 (logo), AS/400, BladeCenter, Blue Gene, ClusterProven, DB2, ESCON, i5/OS, i5/OS (logo), IBM Business Partner (logo), IntelliStation, LoadLeveler, Lotus, Lotus Notes, Notes, Operating System/400, OS/400, PartnerLink, PartnerWorld, PowerPC, pSeries, Rational, RISC System/6000, RS/6000, THINK, Tivoli, Tivoli (logo), Tivoli Management Environment, WebSphere, xSeries, z/OS, zSeries, Active Memory, Balanced Warehouse, CacheFlow, Cool Blue, IBM Systems Director VMControl, pureScale, TurboCore, Chiphopper, Cloudscape, DB2 Universal Database, DS4000, DS6000, DS8000, EnergyScale, Enterprise Workload Manager, General Parallel File System, , GPFS, HACMP, HACMP/6000, HASM, IBM Systems Director Active Energy Manager, iSeries, Micro-Partitioning, POWER, PowerExecutive, PowerVM, PowerVM (logo), PowerHA, Power Architecture, Power Everywhere, Power Family, POWER Hypervisor, Power Systems, Power Systems (logo), Power Systems Software, Power Systems Software (logo), POWER2, POWER3, POWER4, POWER4+, POWER5, POWER5+, POWER6, POWER6+, POWER7, System i, System p, System p5, System Storage, System z, TME 10, Workload Partitions Manager and X-Architecture are trademarks or registered trademarks of International Business Machines Corporation in the United States, other countries, or both. If these and other IBM trademarked terms are marked on their first occurrence in this information with a trademark symbol (® or ™), these symbols indicate U.S. registered or common law trademarks owned by IBM at the time this information was published. Such trademarks may also be registered or common law trademarks in other countries. A full list of U.S. trademarks owned by IBM may be found at: http://www.ibm.com/legal/copytrade.shtml. Adobe, the Adobe logo, PostScript, and the PostScript logo are either registered trademarks or trademarks of Adobe Systems Incorporated in the United States, and/or other countries. AltiVec is a trademark of Freescale Semiconductor, Inc. AMD Opteron is a trademark of Advanced Micro Devices, Inc. InfiniBand, InfiniBand Trade Association and the InfiniBand design marks are trademarks and/or service marks of the InfiniBand Trade Association. Intel, Intel logo, Intel Inside, Intel Inside logo, Intel Centrino, Intel Centrino logo, Celeron, Intel Xeon, Intel SpeedStep, Itanium, and Pentium are trademarks or registered trademarks of Intel Corporation or its subsidiaries in the United States and other countries. IT Infrastructure Library is a registered trademark of the Central Computer and Telecommunications Agency which is now part of the Office of Government Commerce. Java and all Java-based trademarks and logos are trademarks or registered trademarks of Oracle and/or its affiliates. Linear Tape-Open, LTO, the LTO Logo, Ultrium, and the Ultrium logo are trademarks of HP, IBM Corp. and Quantum in the U.S. and other countries. Linux is a registered trademark of Linus Torvalds in the United States, other countries or both. Microsoft, Windows and the Windows logo are registered trademarks of Microsoft Corporation in the United States, other countries or both. NetBench is a registered trademark of Ziff Davis Media in the United States, other countries or both. SPECint, SPECfp, SPECjbb, SPECweb, SPECjAppServer, SPEC OMP, SPECviewperf, SPECapc, SPEChpc, SPECjvm, SPECmail, SPECimap and SPECsfs are trademarks of the Standard Performance Evaluation Corp (SPEC). The Power Architecture and Power.org wordmarks and the Power and Power.org logos and related marks are trademarks and service marks licensed by Power.org. TPC-C and TPC-H are trademarks of the Transaction Performance Processing Council (TPPC). UNIX is a registered trademark of The Open Group in the United States, other countries or both. Other company, product and service names may be trademarks or service marks of others. Revised December 2, 2010 66 Power is performance redefined ©2012 IBM Corporation
  • 34.
    Notes on benchmarksand values The IBM benchmarks results shown herein were derived using particular, well configured, development-level and generally-available computer systems. Buyers should consult other sources of information to evaluate the performance of systems they are considering buying and should consider conducting application oriented testing. For additional information about the benchmarks, values and systems tested, contact your local IBM office or IBM authorized reseller or access the Web site of the benchmark consortium or benchmark vendor. IBM benchmark results can be found in the IBM Power Systems Performance Report at http://www.ibm.com/systems/p/hardware/system_perf.html . All performance measurements were made with AIX or AIX 5L operating systems unless otherwise indicated to have used Linux. For new and upgraded systems, the latest versions of AIX were used. All other systems used previous versions of AIX. The SPEC CPU2006, LINPACK, and Technical Computing benchmarks were compiled using IBM's high performance C, C++, and FORTRAN compilers for AIX 5L and Linux. For new and upgraded systems, the latest versions of these compilers were used: XL C for AIX v11.1, XL C/C++ for AIX v11.1, XL FORTRAN for AIX v13.1, XL C/C++ for Linux v11.1, and XL FORTRAN for Linux v13.1. For a definition/explanation of each benchmark and the full list of detailed results, visit the Web site of the benchmark consortium or benchmark vendor. TPC http://www.tpc.org SPEC http://www.spec.org LINPACK http://www.netlib.org/benchmark/performance.pdf Pro/E http://www.proe.com GPC http://www.spec.org/gpc VolanoMark http://www.volano.com STREAM http://www.cs.virginia.edu/stream/ SAP http://www.sap.com/benchmark/ Oracle, Siebel, PeopleSoft http://www.oracle.com/apps_benchmark/ Baan http://www.ssaglobal.com Fluent http://www.fluent.com/software/fluent/index.htm TOP500 Supercomputers http://www.top500.org/ Ideas International http://www.ideasinternational.com/benchmark/bench.html Storage Performance Council http://www.storageperformance.org/results Revised December 2, 2010 67 Power is performance redefined ©2012 IBM Corporation Notes on HPC benchmarks and values The IBM benchmarks results shown herein were derived using particular, well configured, development-level and generally-available computer systems. Buyers should consult other sources of information to evaluate the performance of systems they are considering buying and should consider conducting application oriented testing. For additional information about the benchmarks, values and systems tested, contact your local IBM office or IBM authorized reseller or access the Web site of the benchmark consortium or benchmark vendor. IBM benchmark results can be found in the IBM Power Systems Performance Report at http://www.ibm.com/systems/p/hardware/system_perf.html . All performance measurements were made with AIX or AIX 5L operating systems unless otherwise indicated to have used Linux. For new and upgraded systems, the latest versions of AIX were used. All other systems used previous versions of AIX. The SPEC CPU2006, LINPACK, and Technical Computing benchmarks were compiled using IBM's high performance C, C++, and FORTRAN compilers for AIX 5L and Linux. For new and upgraded systems, the latest versions of these compilers were used: XL C for AIX v11.1, XL C/C++ for AIX v11.1, XL FORTRAN for AIX v13.1, XL C/C++ for Linux v11.1, and XL FORTRAN for Linux v13.1. Linpack HPC (Highly Parallel Computing) used the current versions of the IBM Engineering and Scientific Subroutine Library (ESSL). For Power7 systems, IBM Engineering and Scientific Subroutine Library (ESSL) for AIX Version 5.1 and IBM Engineering and Scientific Subroutine Library (ESSL) for Linux Version 5.1 were used. For a definition/explanation of each benchmark and the full list of detailed results, visit the Web site of the benchmark consortium or benchmark vendor. SPEC http://www.spec.org LINPACK http://www.netlib.org/benchmark/performance.pdf Pro/E http://www.proe.com GPC http://www.spec.org/gpc STREAM http://www.cs.virginia.edu/stream/ Fluent http://www.fluent.com/software/fluent/index.htm TOP500 Supercomputers http://www.top500.org/ AMBER http://amber.scripps.edu/ FLUENT http://www.fluent.com/software/fluent/fl5bench/index.htm GAMESS http://www.msg.chem.iastate.edu/gamess GAUSSIAN http://www.gaussian.com ANSYS http://www.ansys.com/services/hardware-support-db.htm Click on the "Benchmarks" icon on the left hand side frame to expand. Click on "Benchmark Results in a Table" icon for benchmark results. ABAQUS http://www.simulia.com/support/v68/v68_performance.php ECLIPSE http://www.sis.slb.com/content/software/simulation/index.asp?seg=geoquest& MM5 http://www.mmm.ucar.edu/mm5/ MSC.NASTRAN http://www.mscsoftware.com/support/prod%5Fsupport/nastran/performance/v04_sngl.cfm STAR-CD www.cd-adapco.com/products/STAR-CD/performance/320/index/html NAMD http://www.ks.uiuc.edu/Research/namd Revised December 2, 2010 HMMER http://hmmer.janelia.org/ http://powerdev.osuosl.org/project/hmmerAltivecGen2mod 68 Power is performance redefined ©2012 IBM Corporation
  • 35.
    Notes on performanceestimates rPerf for AIX rPerf (Relative Performance) is an estimate of commercial processing performance relative to other IBM UNIX systems. It is derived from an IBM analytical model which uses characteristics from IBM internal workloads, TPC and SPEC benchmarks. The rPerf model is not intended to represent any specific public benchmark results and should not be reasonably used in that way. The model simulates some of the system operations such as CPU, cache and memory. However, the model does not simulate disk or network I/O operations. rPerf estimates are calculated based on systems with the latest levels of AIX and other pertinent software at the time of system announcement. Actual performance will vary based on application and configuration specifics. The IBM eServer pSeries 640 is the baseline reference system and has a value of 1.0. Although rPerf may be used to approximate relative IBM UNIX commercial processing performance, actual system performance may vary and is dependent upon many factors including system hardware configuration and software design and configuration. Note that the rPerf methodology used for the POWER6 systems is identical to that used for the POWER5 systems. Variations in incremental system performance may be observed in commercial workloads due to changes in the underlying system architecture. All performance estimates are provided "AS IS" and no warranties or guarantees are expressed or implied by IBM. Buyers should consult other sources of information, including system benchmarks, and application sizing guides to evaluate the performance of a system they are considering buying. For additional information about rPerf, contact your local IBM office or IBM authorized reseller. ======================================================================== CPW for IBM i Commercial Processing Workload (CPW) is a relative measure of performance of processors running the IBM i operating system. Performance in customer environments may vary. The value is based on maximum configurations. More performance information is available in the Performance Capabilities Reference at: www.ibm.com/systems/i/solutions/perfmgmt/resource.html Revised April 2, 2007 69 Power is performance redefined ©2012 IBM Corporation Trademarks and Disclaimers 8 IBM Corporation 1994-2010. All rights reserved. References in this document to IBM products or services do not imply that IBM intends to make them available in every country. Trademarks of International Business Machines Corporation in the United States, other countries, or both can be found on the World Wide Web at http://www.ibm.com/legal/copytrade.shtml. Adobe, Acrobat, PostScript and all Adobe-based trademarks are either registered trademarks or trademarks of Adobe Systems Incorporated in the United States, other countries, or both. Intel, Intel logo, Intel Inside, Intel Inside logo, Intel Centrino, Intel Centrino logo, Celeron, Intel Xeon, Intel SpeedStep, Itanium, and Pentium are trademarks or registered trademarks of Intel Corporation or its subsidiaries in the United States and other countries. Linux is a registered trademark of Linus Torvalds in the United States, other countries, or both. Microsoft, Windows, Windows NT, and the Windows logo are trademarks of Microsoft Corporation in the United States, other countries, or both. IT Infrastructure Library is a registered trademark of the Central Computer and Telecommunications Agency which is now part of the Office of Government Commerce. ITIL is a registered trademark, and a registered community trademark of the Office of Government Commerce, and is registered in the U.S. Patent and Trademark Office. UNIX is a registered trademark of The Open Group in the United States and other countries. Cell Broadband Engine and Cell/B.E. are trademarks of Sony Computer Entertainment, Inc., in the United States, other countries, or both and are used under license therefrom. Java and all Java-based trademarks are trademarks of Sun Microsystems, Inc. in the United States, other countries, or both. Other company, product, or service names may be trademarks or service marks of others. Information is provided "AS IS" without warranty of any kind. The customer examples described are presented as illustrations of how those customers have used IBM products and the results they may have achieved. Actual environmental costs and performance characteristics may vary by customer. Information concerning non-IBM products was obtained from a supplier of these products, published announcement material, or other publicly available sources and does not constitute an endorsement of such products by IBM. Sources for non-IBM list prices and performance numbers are taken from publicly available information, including vendor announcements and vendor worldwide homepages. IBM has not tested these products and cannot confirm the accuracy of performance, capability, or any other claims related to non-IBM products. Questions on the capability of non-IBM products should be addressed to the supplier of those products. All statements regarding IBM future direction and intent are subject to change or withdrawal without notice, and represent goals and objectives only. Some information addresses anticipated future capabilities. Such information is not intended as a definitive statement of a commitment to specific levels of performance, function or delivery schedules with respect to any future products. Such commitments are only made in IBM product announcements. The information is presented here to communicate IBM's current investment and development activities as a good faith effort to help with our customers' future planning. Performance is based on measurements and projections using standard IBM benchmarks in a controlled environment. The actual throughput or performance that any user will experience will vary depending upon considerations such as the amount of multiprogramming in the user's job stream, the I/O configuration, the storage configuration, and the workload processed. Therefore, no assurance can be given that an individual user will achieve throughput or performance improvements equivalent to the ratios stated here. Prices are suggested U.S. list prices and are subject to change without notice. Contact your IBM representative or Business Partner for the most current pricing in your geography. Source: If applicable, describe source origin 70 Power is performance redefined ©2012 IBM Corporation
