University of Alberta Technology Training Center
Developed by Priscilla Bahrey, PMP
Project Management
Principles and Practices
Overview

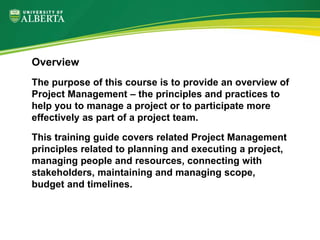

The purpose of this course is to provide an overview of
Project Management – the principles and practices to
help you to manage a project or to participate more
effectively as part of a project team.
This training guide covers related Project Management
principles related to planning and executing a project,
managing people and resources, connecting with
stakeholders, maintaining and managing scope,
budget and timelines.

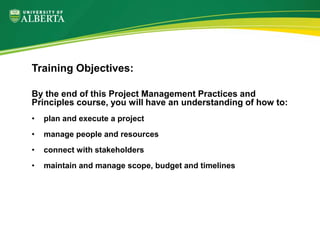

By the end of this Project Management Practices and
Principles course, you will have an understanding of how to:
• plan and execute a project
• manage people and resources
• connect with stakeholders
• maintain and manage scope, budget and timelines
Training Objectives:
Section 1: Introduction
Section 2: Initiating (Definition)
Section 3: Planning
Section 4: Executing
Section 5: Monitoring & Controlling
Section 6: Closing

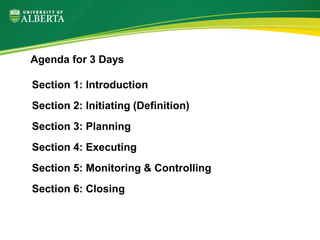

Agenda for 3 Days

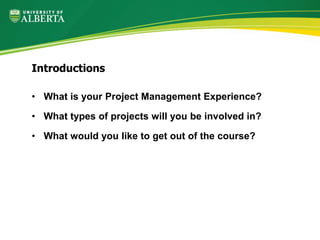

• What is your Project Management Experience?
• What types of projects will you be involved in?
• What would you like to get out of the course?
Introductions
Project Management
Idiot’s Guides As easy as it Gets!
Sixth Edition
Reference Material
This unit will cover:
•Project Successes/Failures
•What is Project Management?
•Project Management Knowledge Areas
•Project Life Cycle

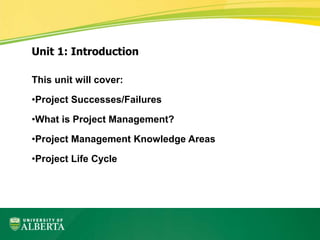

Unit 1: Introduction
What is a Project?
Project
• A temporary endeavor undertaken to create a unique product,
service, or result
—PMBOK®
“PMBOK” is a trademark of the Project Management Institute, Inc.
Why do projects fail?
(Discuss what you have seen in your assigned teams)
Activity
1. Poor project and program management discipline
2. Lack of executive-level support
3. No linkage to the business strategy
4. Wrong team members
5. No measures for evaluating the success of the project
6. No risk management
7. Inability to manage change

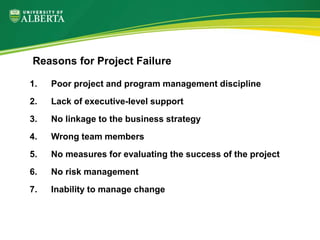

Reasons for Project Failure

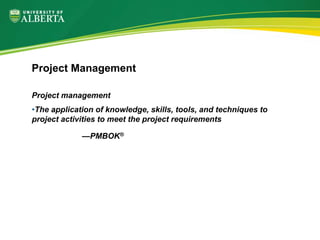

Project management
•The application of knowledge, skills, tools, and techniques to
project activities to meet the project requirements
—PMBOK®
Project Management

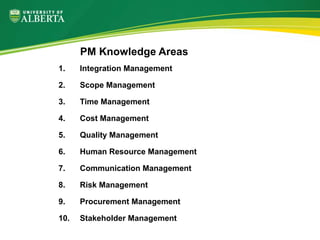

1. Integration Management
2. Scope Management
3. Time Management
4. Cost Management
5. Quality Management
6. Human Resource Management
7. Communication Management
8. Risk Management
9. Procurement Management
10. Stakeholder Management
PM Knowledge Areas
• On time
• Within budget
• Satisfied Stakeholders

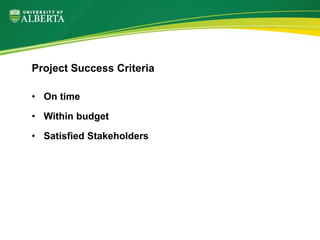

Project Success Criteria
Project Priorities

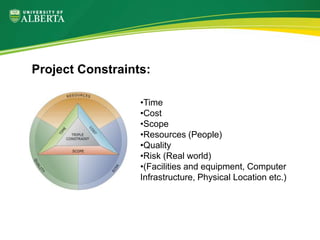

Project Constraints:
•Time
•Cost
•Scope
•Resources (People)
•Quality
•Risk (Real world)
•(Facilities and equipment, Computer
Infrastructure, Physical Location etc.)

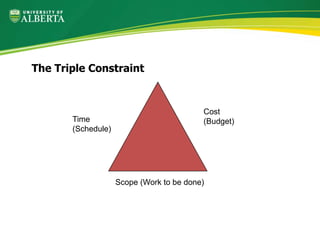

The Triple Constraint
Time
(Schedule)
Cost
(Budget)
Scope (Work to be done)

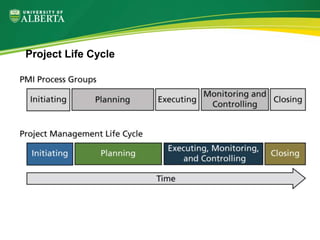

Project Life Cycle
• Initiate the Project
• Identify the Project Manager
• Develop the Project Charter
• Identify the Stakeholders
• Define Planning Phase
• Sign off on the Project Charter

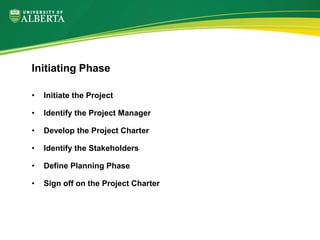

Initiating Phase
• Develop a Project Plan (work plan)
• Organize and staff the project
• Sign off on the Project Plan
Planning Phase
• Execute the Project Plan
• Manage the Project Plan
• Implement the project’s results
• Sign off on project’s completion

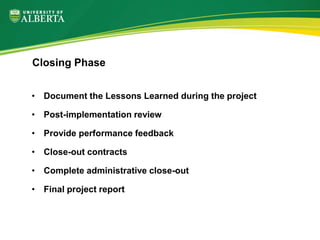

Executing, Monitoring and Controlling Phase
• Document the Lessons Learned during the project
• Post-implementation review
• Provide performance feedback
• Close-out contracts
• Complete administrative close-out
• Final project report
Closing Phase
Discuss the rationale for the Phases of a Project and
the consequence of rushing into the Planning phase
too soon
Discussion
What is Project Management?
Key Functional Areas
Project life cycle

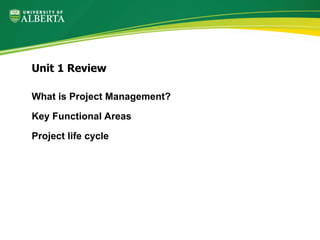

Unit 1 Review
This unit will cover:
•How Projects are selected
•How Projects are defined and approved
•How to identify and manage Stakeholders

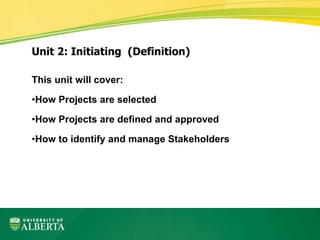

Unit 2: Initiating (Definition)
How Projects are selected

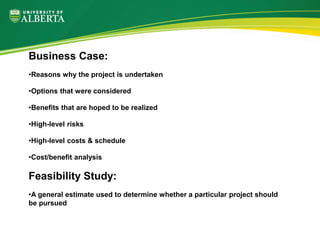

Business Case:
•Reasons why the project is undertaken
•Options that were considered
•Benefits that are hoped to be realized
•High-level risks
•High-level costs & schedule
•Cost/benefit analysis
Feasibility Study:
•A general estimate used to determine whether a particular project should
be pursued
The Project Manager must understand:
• Goals (the need for the project and the measurable benefits)
• Scope
• Time to complete
• Estimates of timeline, resource requirements and costs

Business Goals & Objectives
S – Specific
M – Measurable
A – Agreed upon
R – Realistic
T – Time-bound

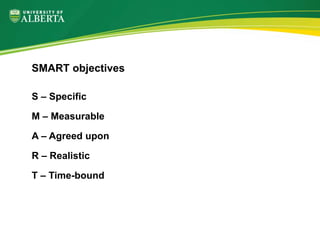

SMART objectives
Using the Case Study:

1) Define a Service that you will showcase
2) Create a SMART Project Objective for the project
- S – Specific
- M – Measurable
- A – Agreed upon
- R – Realistic
- T – Time-bound
Activity
• Purpose statement (Project Objectives)
• Scope statement (In/Out)
• Project approval requirements
• Benefits and risks
• High-level cost and schedule estimates
• Sign-off (approval to move to planning)
Project Charter
• Purpose statement
• Project scope
• Project deliverables
• Goals & objectives
• High-level cost and schedule estimates
• Stakeholders
• Benefits and risks
• Assumptions and constraints
• User acceptance criteria

Statement of Work (SOW)
What is the rationale for getting Approval or sign-off on
the project and what are the consequences of not
getting approval to proceed?
Discussion
Estimating costs
• Create a Project Charter for the case study
• Scope (in/out)
• Project Deliverables
• Success Criteria
• Assumptions and Constraints
• High-level Cost and Schedule and Risks
• Determine who would sign-off
Activity
PMI defines Stakeholders as: “An individual, group or
organization who may affect, be affected by,
or perceive itself to be affected by a decision, activity
or outcome of the project”.

Stakeholder Management
Step 1) Identify Stakeholders
Step 2) Determine Key Stakeholders
Step 3) Determine how to Communicate (and manage
conflicts) with Stakeholders
Stakeholder Management
• Shares responsibility for project success
• Has authority to make decisions and may provide
funding
• Overcomes political and organizational obstacles
Project Sponsor
• Uses the product or services
• May be internal or external
• Provides requirements
• May have multiple categories or roles
The Customer/User
• Group of stakeholders who approve and agree on:
• Project scope
• Schedule
• Budgets
• Plans
• Changes

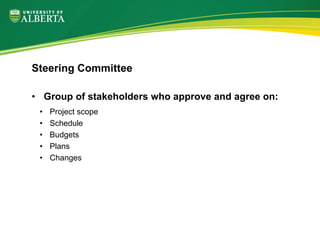

Steering Committee
• Line managers who are responsible for delivering
business results once the project is completed

Working Committee
• May manage or supply people that work on the team
• Need to be communicated with
• Need their commitment to the project

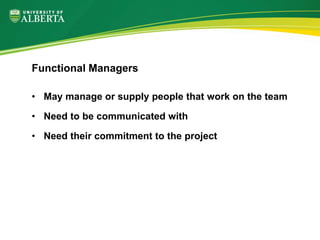

Functional Managers
Input from Stakeholders

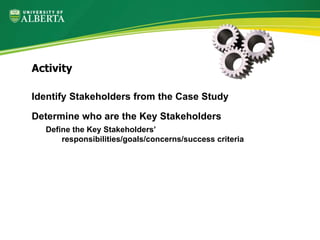

Identify Stakeholders from the Case Study
Determine who are the Key Stakeholders
Define the Key Stakeholders’
responsibilities/goals/concerns/success criteria
Activity
Discuss the importance of knowing who the Key
Stakeholders are and the consequence of not
communicating with them effectively
Discussion
• Ultimately responsible for project success
• Plans the project
• Maintains focus on the project’s objective
• Leads and manages the Project Team

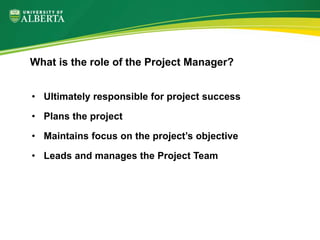

What is the role of the Project Manager?
What characteristics/skills/competencies are required
to be a good Project Manager?
Discussion
Trait 1: Enthusiasm for the project
Trait 2: Ability to manage change effectively
Trait 3: A tolerant attitude toward ambiguity
Trait 4: Team building and negotiating skills
Trait 5: A customer-first orientation
Trait 6: Adherence to the priorities of business
Trait 7: Knowledge of the industry or technology

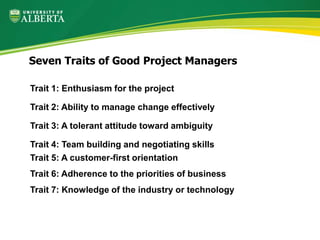

Seven Traits of Good Project Managers
Gain consensus on Project Outcomes
Build the best team you can
Develop a plan and keep it up to date
Remember that people count
Gain the support of Management and Key Stakeholders
Keep others informed of what you are doing

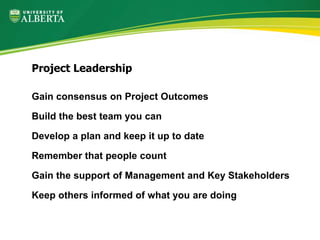

Project Leadership
What can the Project Manager do to gain consensus
and buy-in on project objectives?
How can you build synergy on the project team?
(What is your team is a virtual team?)
Discussion
Establish Ground Rules for a Project Team
(Brainstorm Ground Rules that would be appropriate for this 3-Day
Project Management Course)

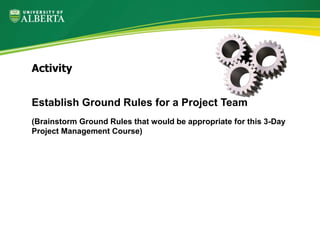

Activity

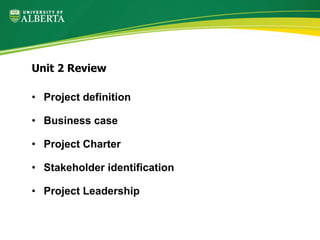

• Project definition
• Business case
• Project Charter
• Stakeholder identification
• Project Leadership
Unit 2 Review
This unit will cover planning:
• Scope (WBS)
• Schedule (Network Diagram)
• Cost (Project Budget)
• Responsibility Allocation (RAM)

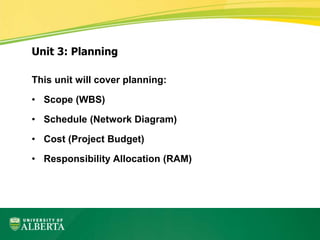

Unit 3: Planning
1) Scope (Work Breakdown Structure)
2) Schedule (Network Diagram)
3) Cost (Budget)

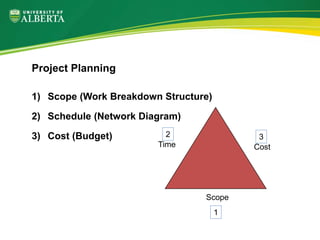

Project Planning
Scope
Time Cost
1
2 3

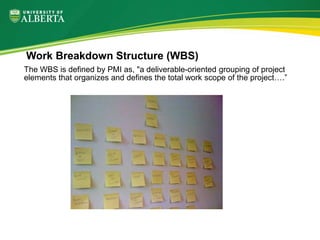

Work Breakdown Structure (WBS)
The WBS is defined by PMI as, "a deliverable-oriented grouping of project
elements that organizes and defines the total work scope of the project….”
• Breaks the large project into manageable units
• Defines the total scope of the project
• Starts with the deliverables
• Shows work packages (tasks or activities)
• Allows you to organize work to then be scheduled
• Allows you to be able to assign work to team members and
identify resources needed
• Communicates all the work that needs to be done

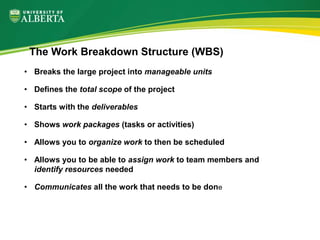

The Work Breakdown Structure (WBS)
1. Break work into independent work packages that can be
sequenced, assigned, scheduled and monitored
2. Define the work package at the appropriate level of detail
3. Integrate the work packages into a total system
4. Present in a format easily communicated to people
5. Verify that the work packages will meet the goals and objectives
of the project

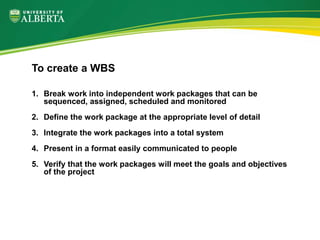

To create a WBS
• Way of managing the project by breaking it down
• Help determine skills required and amount of
resources needed
• Communicate work that needs to be done
• Work sequences are identified and understood
Work Packages

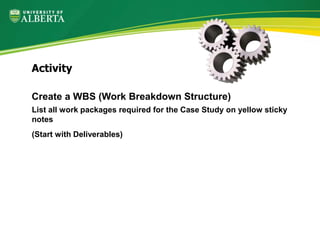

Create a WBS (Work Breakdown Structure)
List all work packages required for the Case Study on yellow sticky
notes
(Start with Deliverables)
Activity
Discuss the importance of defining the “what” we will
do in the WBS before moving to the “how” in building
the schedule?
Discussion
Dilbert’s Scheduling
WBS: what needs to be done
Network Diagram: how the work will be done (the
workflow)

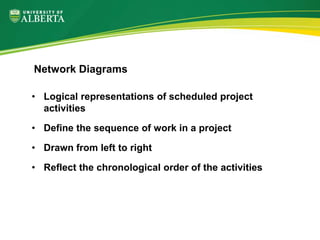

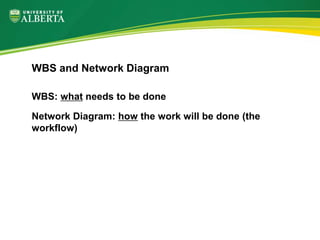

WBS and Network Diagram
1. Establish scheduling assumptions
2. Estimate the resources, effort and duration
• Effort – time that it takes to work on the activity
• Duration – the time to complete the activity
3. Determine calendar dates for activities
4. Adjust individual resource assignments

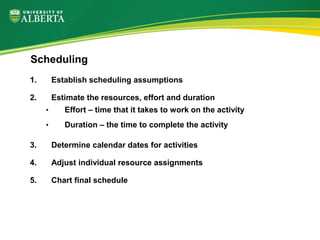

5. Chart final schedule
Scheduling
• Have the people who are doing the work provide the
estimates
• Get an expert’s estimate
• Find a similar task
• Look for relationship between activity and time
(parametric estimate)
• Educated guess
Estimating Time

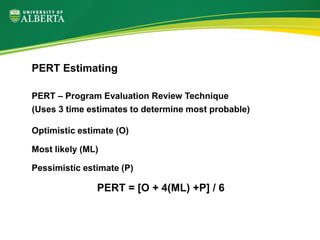

PERT – Program Evaluation Review Technique
(Uses 3 time estimates to determine most probable)
Optimistic estimate (O)
Most likely (ML)
Pessimistic estimate (P)
PERT = [O + 4(ML) +P] / 6
PERT Estimating
Padding Estimates = Poor Estimates
•Add contingency as an activity
•(Contingency is typically 10-15% of the base budget)
Contingency

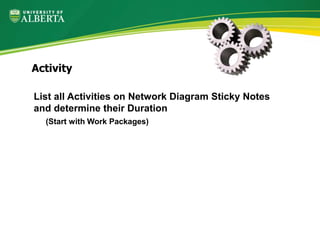

List all Activities on Network Diagram Sticky Notes
and determine their Duration
(Start with Work Packages)
Activity
• Logical representations of scheduled project
activities
• Define the sequence of work in a project
• Drawn from left to right
• Reflect the chronological order of the activities
Network Diagrams
• Precedence defines the sequencing order
• How work elements are related to one another in the
plan
• Many activities can be done in parallel or at the
same time (if resources are available)
Precedence
• Create an Activity for each task
• Lines connect activities to one another
• Activities are laid out horizontal from left to right
• Parallel activities are in the same column
• Precedence is shown by drawing lines from activity to activity
• One activity may depend on the completion of multiple other
activities

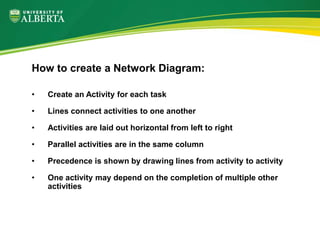

How to create a Network Diagram:
Sample Network Diagram
• Lead – amount of time that precedes the start of
work on another activity
• Lag – amount of time after one activity is started or
finished before the next activity can be started or
finished
Lead and Lag
Critical Path
•The longest path (the sequence of tasks that forms the longest duration)
•The shortest time that you can complete your project
Float
• Amount of time that an activity may be delayed from its earliest possible
start date without delaying the project finish date
• Latest possible finish date – earliest possible start – duration = total float

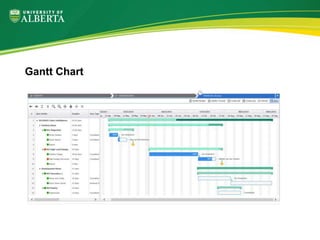

Gantt Chart

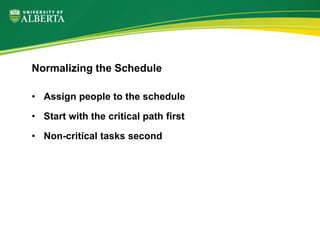

• Assign people to the schedule
• Start with the critical path first
• Non-critical tasks second
Normalizing the Schedule
Resource Load – the amount of work that is assigned
to a resource
Resource Leveling – redistribution to even out the
distribution of work across all resources
Loading and Leveling
• Ensure that learning time is identified
• Ensure that administration time is included
• Be aware that resources seldom work 100% of the
time on one project
Scheduling Tips
Create a Network Diagram for the Case Study
• Order all Activities on Network Diagram (relationships and
dependencies)
• Do a forward pass to determine the project length
• (Input + Duration = Output)
• Mark the Critical Path in red
Activity
Discuss the importance of knowing the critical path
and how that helps the project manager make
decisions
Discussion
Budget = People + Resources + Time
Budgeting
• Giving a number too soon
• Before WBS
• Not considering risk
• Not evaluating experience and skill of resources
Classic Budgeting Mistakes
• Rough Order of Magnitude

• Definitive Estimate
Budgeting Levels
Direct costs (Directly attributed to the project)
• Labor
• Supplies & raw materials
• Equipment
• Travel
• Legal Fees
• Training
• Marketing/advertising
Direct & Indirect Costs
Indirect costs (Shared amongst other projects)
• Facilities
• Site-specific requirements
• Management & administrative overhead
Indirect Costs
• Bottom-Up
• Top-Down
• Phased
Types of Budgeting
• 10-15% of budget is normal
• Don’t pad but manage the contingency
PMI Library article “Change Budget- One Key to Never Padding Estimates Again” by Neal S. Gray, Keane Inc.
Contingency Reserve
Create a Budget for the Case Study
Direct and Indirect costs
(Materials, Supplies, Labour costs, Marketing,
Printing etc.)
Activity

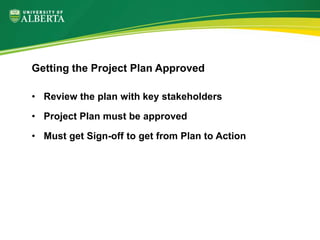

• Review the plan with key stakeholders
• Project Plan must be approved
• Must get Sign-off to get from Plan to Action
Getting the Project Plan Approved
Project risk is defined by PMI as, "an uncertain event
or condition that, if it occurs, has a positive or negative
effect on a project's objectives."
Risk Management
Step 1) Identify Risks
Step 2) Prioritize Risks (Qualitative Analysis)
Step 3) Develop Risk Management Strategies
Risk Management
• Funding
• Time
• Staffing
• Customer relations
• Project size and/or complexity
• Overall structure
• Organizational resistance
• External factors
Risk Categories

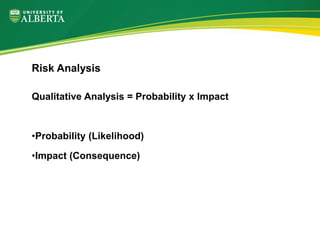

Qualitative Analysis = Probability x Impact
•Probability (Likelihood)
•Impact (Consequence)
Risk Analysis
Threats:
Avoid
Mitigate
Transfer
Accept

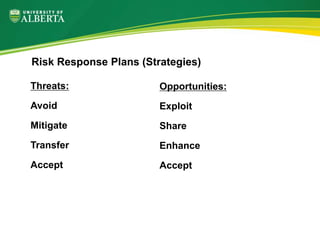

Risk Response Plans (Strategies)
Opportunities:
Exploit
Share
Enhance
Accept
Risk Register
• Review and update regularly
• Assign ownership to risk
Risk Track and Control
1) Identify 10 Risks for Case Study Project
7 threats/3 opportunities
2) Rank the Risks (PxI)
3) Develop Risk Response Strategies
3 threats and 3 opportunities
(for highest ranked risks from PxI)
Activity
Discuss the value of Risk Management and the
consequence of not identifying risks
Discussion
Need to let the team members know:
• The reason they are on the team, and what they have to
offer
• Their Roles and Responsibilities
• Standards that they will be held accountable to
Project Team
R – Responsible
A – Approves
S – Supports
I – Inform
C – Consult
RASIC Chart

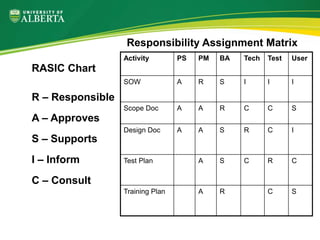

Activity PS PM BA Tech Test User
SOW A R S I I I
Scope Doc A A R C C S
Design Doc A A S R C I
Test Plan A S C R C
Training Plan A R C S
Responsibility Assignment Matrix
• What kinds of experience do you need?
• What kind of competency do they have?
• What is their availability?
• Do they have a personal interest in the outcome of the
project?
• Will they work well in a team environment?
Building a team
• Use your own staff & people from your department
• Staff from other departments
• Contract with consultants, outside agencies, or temporary
agencies
• Hire and train new staff
Staffing Alternatives
• Do the best you can with the people you have, and
document problems and results.
• If they do not have enough skills, and training takes
too long, consider contracting.
• Compromise and negotiate for the team members
you really need.
Dealing with Staffing Challenges

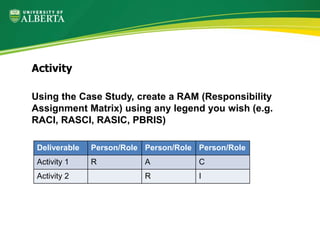

Using the Case Study, create a RAM (Responsibility
Assignment Matrix) using any legend you wish (e.g.
RACI, RASCI, RASIC, PBRIS)
Activity
Deliverable Person/Role Person/Role Person/Role
Activity 1 R A C
Activity 2 R I
WBS
Network Diagrams
Scheduling
Budgeting
Risk
RAM
Sign off on Project Plan
Unit 3 Review
In this unit, you will learn:
• Operating Guidelines
• Communication
Unit 4: Execution
• Reporting Project Status
• Change Management
• Decision making
• Managing the team
Operating Guidelines
Plan-Do-Check-Act Cycle
Discuss how the role of the Project Manager changes
in the Execution phase?
Discussion

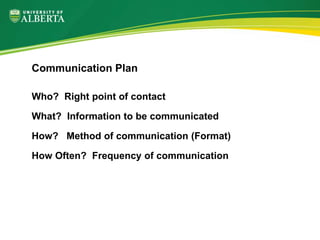

Communication
Who? Right point of contact
What? Information to be communicated
How? Method of communication (Format)
How Often? Frequency of communication
Communication Plan
Develop a communication plan from the case study

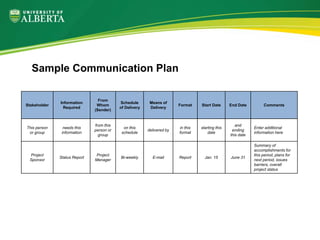

Sample Communication Plan
Stakeholder
Information
Required
From
Whom
(Sender)
Schedule
of Delivery
Means of
Delivery
Format Start Date End Date Comments
This person
or group
needs this
information
from this
person or
group
on this
schedule
delivered by
in this
format
starting this
date
and
ending
this date
Enter additional
information here
Project
Sponsor
Status Report
Project
Manager
Bi-weekly E-mail Report Jan. 15 June 31
Summary of
accomplishments for
this period, plans for
next period, issues
barriers, overall
project status
• Macro and Micro Barriers
• Geography, language, culture
• Attitudes
• Jargon and Acronyms
• Stakeholder preferences
Adapt your communication style based on:
• Draft the message and edit
• Consider audience’s expectations, actions required, and your
expectations after the message is delivered
• Justify the choice of delivery method
• Identify the issue, context or opportunity of interest first
• Make required actions clear and specific
• Be concise
Effective Messages

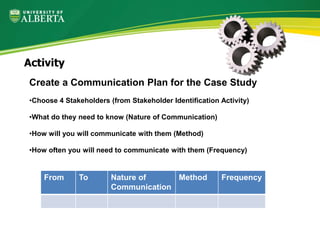

Create a Communication Plan for the Case Study
•Choose 4 Stakeholders (from Stakeholder Identification Activity)
•What do they need to know (Nature of Communication)
•How will you will communicate with them (Method)
•How often you will need to communicate with them (Frequency)
Activity
From To Nature of
Communication
Method Frequency
What is the value of a Communication Plan and what
are the consequences of not communicating
effectively with Stakeholders?
Discussion
Operating Guidelines
PDCA
Communication
Unit 4 Review
In this unit, you will learn:
• What to Monitor and Control
• Earned Value
• Change Management
• Quality
Unit 5: Monitoring and Controlling
Monitoring and Controlling
What does it mean to Monitor and Control the project?
Discussion
• Completion of work packages compared to plan
• Scope of work
• Quality of work
• Costs and expenditures
• Attitudes and cohesiveness of team
What to Monitor?
• Communicate project status and changes to Project Team
• Manage expectations of Stakeholders
• Provide justification for project adjustments
• Document current project plans compared to original
Purpose of Monitoring

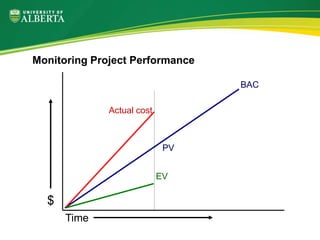

Monitoring Project Performance
Time
$
EV
PV
Actual cost
BAC

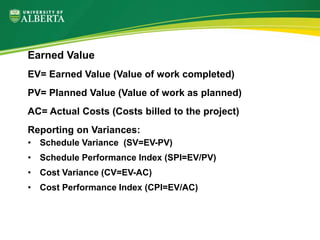

Earned Value
EV= Earned Value (Value of work completed)
PV= Planned Value (Value of work as planned)
AC= Actual Costs (Costs billed to the project)
Reporting on Variances:
• Schedule Variance (SV=EV-PV)
• Schedule Performance Index (SPI=EV/PV)
• Cost Variance (CV=EV-AC)
• Cost Performance Index (CPI=EV/AC)
Reporting Cost and Time
Progress
Status
Forecast
Using a Gantt chart to report progress
• Use the project plan as a guide
• Monitor and update plan regularly
• Adapt project schedule, budget and work plan as needed
• Document progress and changes, communicate them to
the team
• Communicate actions taken to Key Stakeholders
Controlling
Techniques to compress the schedule:
Crashing
• Focused on critical path
• Generate multiple alternatives
• Add additional resources to the project
Fast tracking
• Overlap sequential activities
How to Control?
How will the Case Study project be monitored?
• What will be reviewed and how often?
Activity
The only way to maintain and manage scope!
•Roles involved in managing change
• Change Authority (Sponsor, Change Control Board, PM)
•Process flow diagram for change management
•All changes are documented and communicated (both
approved and rejected changes)
•Control documents
• Change Control Log
• Issues Log
Change Management Plan
Sample Change Control Process
Change?
Good
idea?
To issues
list
Yes
Yes
Yes
No
No
No
Impact
plan or
risk?
Define
impact
Prepare
change order
Change
approved?
Amend
plan
Make the
change
3-20
Sample Change Control Log
3-21
• Update the original baseline for approved Project Scope
changes to continue to report Project Status
(Scope/Time/Cost)
• Update the original plan to reflect the approved change
• Communicate the change to all Stakeholders to manage
stakeholder expectations (no surprises)
How to respond to Approved Change
3-22
A change is requested by the Project Sponsor. What is
the impact of delivering the event 2 weeks sooner to
coincide with another similar event?
• In your groups, perform a Change Impact
Assessment in the Change Request Form
(Tip: Consider the impact of making the change in
terms of time/cost/scope and the impact of not making
the change as well as any additional risks)
Activity
Project quality is defined by PMI as the “degree to
which a set of inherent characteristics (of the finished
product) fulfills requirements."
Quality Management
• Quality Planning
• Development of criteria or metrics
• Quality Control:
• Measuring results
• Quality Assurance:
• Assuring conformance to requirements
Quality
3-22
What activities would you do on the Case Study
Project to verify and validate Quality?
Discussion
What to Monitor
How to Control
Earned Value Analysis
Change Management
Managing Stakeholder Expectations
Quality
Unit 5 Review
This unit will cover:
•Closing the project
•Lessons learned
•Post-Implementation Review
•Final Report
Unit 6: Closing
Closing
• Final approval from stakeholders
• Finalize contractual commitments
• Transfer responsibilities to others
• Reassign people in the project
• Release non-human resources
• Complete final accounting
• Document results and recommendations for the future
Closing the Project
• Meeting with Project Team and Sponsor
• (After celebration but before forgotten)
• Did the Project accomplish the Objective as stated in the
Charter?
Post-Implementation Review
How would the Case Study project be closed out?
What type of post-implementation review would you do
and when?
Activity
Celebrate the success of the Project
•Why is celebrating success and acknowledging
people’s performance on the Project so important?
Discussion
• Overview of project
• Major accomplishments
• Achievements compared to Business Case objectives
• Final Financial accounting
• Analysis of Quality against expectations/requirements
• Evaluation of administration and management performance
• Team’s Performance/Special acknowledgments
• Changes (approved and impact of changes)
• Issues or tasks of further investigation
• Recommendations for future projects
• Post-implementation date
Final Report
Focus areas
• Project Management, Communications, Schedule &
Budget, Training, Quality, Issues, Human Resources,
Administration
•What went well?
•What didn’t?
•What should be improved?
•How?
•Anything else?
Lessons Learned
Why document Lessons Learned on the project?
Discussion
• In your teams, conduct a Lessons Learned
based on your team performance over the past
3 days:
• What did you do well in your teams?
• What could you have done better?
• What advice would you give to a team about to embark on
a similar project (planning an event)?
Activity
Common Problems on Projects
•Start date moves but end date doesn’t
•Not enough time
•Changes, changes, changes
•Key person quits or is unavailable
•Team has more enthusiasm than talent
•People are always 90% done
•Politics
Put Learning into Action:
Each team identifies Strategies (to address the reasons
that projects fail)
Activity
Final Report
Administrative Details
Lessons Learned
Celebrating Project Success
Unit 6 Review
Section 1: Introduction
Section 2: Initiating (Definition)
Section 3: Planning
Section 4: Executing
Section 5: Monitoring & Controlling
Section 6: Closing
Review of 3 Days
Personal Action Plan
• What 3 things do you commit to putting into practice back
on the job?
Activity
Thank you for attending Project
Management Principles and
Practices…
•Slides: www.ualberta.ca/training/ttcfiles
•Evaluations

pmppgoav14.ppt

  • 1.
    University of AlbertaTechnology Training Center Developed by Priscilla Bahrey, PMP Project Management Principles and Practices
  • 2.
    Overview The purpose ofthis course is to provide an overview of Project Management – the principles and practices to help you to manage a project or to participate more effectively as part of a project team. This training guide covers related Project Management principles related to planning and executing a project, managing people and resources, connecting with stakeholders, maintaining and managing scope, budget and timelines.
  • 3.
    By the endof this Project Management Practices and Principles course, you will have an understanding of how to: • plan and execute a project • manage people and resources • connect with stakeholders • maintain and manage scope, budget and timelines Training Objectives:
  • 4.
    Section 1: Introduction Section2: Initiating (Definition) Section 3: Planning Section 4: Executing Section 5: Monitoring & Controlling Section 6: Closing Agenda for 3 Days
  • 5.
    • What isyour Project Management Experience? • What types of projects will you be involved in? • What would you like to get out of the course? Introductions
  • 6.
    Project Management Idiot’s GuidesAs easy as it Gets! Sixth Edition Reference Material
  • 7.
    This unit willcover: •Project Successes/Failures •What is Project Management? •Project Management Knowledge Areas •Project Life Cycle Unit 1: Introduction
  • 8.
    What is aProject? Project • A temporary endeavor undertaken to create a unique product, service, or result —PMBOK® “PMBOK” is a trademark of the Project Management Institute, Inc.
  • 9.
    Why do projectsfail? (Discuss what you have seen in your assigned teams) Activity
  • 10.
    1. Poor projectand program management discipline 2. Lack of executive-level support 3. No linkage to the business strategy 4. Wrong team members 5. No measures for evaluating the success of the project 6. No risk management 7. Inability to manage change Reasons for Project Failure
  • 11.
    Project management •The applicationof knowledge, skills, tools, and techniques to project activities to meet the project requirements —PMBOK® Project Management
  • 12.
    1. Integration Management 2.Scope Management 3. Time Management 4. Cost Management 5. Quality Management 6. Human Resource Management 7. Communication Management 8. Risk Management 9. Procurement Management 10. Stakeholder Management PM Knowledge Areas
  • 13.
    • On time •Within budget • Satisfied Stakeholders Project Success Criteria
  • 14.
  • 15.
    Project Constraints: •Time •Cost •Scope •Resources (People) •Quality •Risk(Real world) •(Facilities and equipment, Computer Infrastructure, Physical Location etc.)
  • 16.
  • 17.
  • 18.
    • Initiate theProject • Identify the Project Manager • Develop the Project Charter • Identify the Stakeholders • Define Planning Phase • Sign off on the Project Charter Initiating Phase
  • 19.
    • Develop aProject Plan (work plan) • Organize and staff the project • Sign off on the Project Plan Planning Phase
  • 20.
    • Execute theProject Plan • Manage the Project Plan • Implement the project’s results • Sign off on project’s completion Executing, Monitoring and Controlling Phase
  • 21.
    • Document theLessons Learned during the project • Post-implementation review • Provide performance feedback • Close-out contracts • Complete administrative close-out • Final project report Closing Phase
  • 22.
    Discuss the rationalefor the Phases of a Project and the consequence of rushing into the Planning phase too soon Discussion
  • 23.
    What is ProjectManagement? Key Functional Areas Project life cycle Unit 1 Review
  • 24.
    This unit willcover: •How Projects are selected •How Projects are defined and approved •How to identify and manage Stakeholders Unit 2: Initiating (Definition)
  • 25.
  • 26.
    Business Case: •Reasons whythe project is undertaken •Options that were considered •Benefits that are hoped to be realized •High-level risks •High-level costs & schedule •Cost/benefit analysis Feasibility Study: •A general estimate used to determine whether a particular project should be pursued
  • 27.
    The Project Managermust understand: • Goals (the need for the project and the measurable benefits) • Scope • Time to complete • Estimates of timeline, resource requirements and costs Business Goals & Objectives
  • 28.
    S – Specific M– Measurable A – Agreed upon R – Realistic T – Time-bound SMART objectives
  • 29.
    Using the CaseStudy: 1) Define a Service that you will showcase 2) Create a SMART Project Objective for the project - S – Specific - M – Measurable - A – Agreed upon - R – Realistic - T – Time-bound Activity
  • 30.
    • Purpose statement(Project Objectives) • Scope statement (In/Out) • Project approval requirements • Benefits and risks • High-level cost and schedule estimates • Sign-off (approval to move to planning) Project Charter
  • 31.
    • Purpose statement •Project scope • Project deliverables • Goals & objectives • High-level cost and schedule estimates • Stakeholders • Benefits and risks • Assumptions and constraints • User acceptance criteria Statement of Work (SOW)
  • 32.
    What is therationale for getting Approval or sign-off on the project and what are the consequences of not getting approval to proceed? Discussion
  • 33.
  • 34.
    • Create aProject Charter for the case study • Scope (in/out) • Project Deliverables • Success Criteria • Assumptions and Constraints • High-level Cost and Schedule and Risks • Determine who would sign-off Activity
  • 35.
    PMI defines Stakeholdersas: “An individual, group or organization who may affect, be affected by, or perceive itself to be affected by a decision, activity or outcome of the project”. Stakeholder Management
  • 36.
    Step 1) IdentifyStakeholders Step 2) Determine Key Stakeholders Step 3) Determine how to Communicate (and manage conflicts) with Stakeholders Stakeholder Management
  • 37.
    • Shares responsibilityfor project success • Has authority to make decisions and may provide funding • Overcomes political and organizational obstacles Project Sponsor
  • 38.
    • Uses theproduct or services • May be internal or external • Provides requirements • May have multiple categories or roles The Customer/User
  • 39.
    • Group ofstakeholders who approve and agree on: • Project scope • Schedule • Budgets • Plans • Changes Steering Committee
  • 40.
    • Line managerswho are responsible for delivering business results once the project is completed Working Committee
  • 41.
    • May manageor supply people that work on the team • Need to be communicated with • Need their commitment to the project Functional Managers
  • 42.
  • 43.
    Identify Stakeholders fromthe Case Study Determine who are the Key Stakeholders Define the Key Stakeholders’ responsibilities/goals/concerns/success criteria Activity
  • 44.
    Discuss the importanceof knowing who the Key Stakeholders are and the consequence of not communicating with them effectively Discussion
  • 45.
    • Ultimately responsiblefor project success • Plans the project • Maintains focus on the project’s objective • Leads and manages the Project Team What is the role of the Project Manager?
  • 46.
    What characteristics/skills/competencies arerequired to be a good Project Manager? Discussion
  • 47.
    Trait 1: Enthusiasmfor the project Trait 2: Ability to manage change effectively Trait 3: A tolerant attitude toward ambiguity Trait 4: Team building and negotiating skills Trait 5: A customer-first orientation Trait 6: Adherence to the priorities of business Trait 7: Knowledge of the industry or technology Seven Traits of Good Project Managers
  • 48.
    Gain consensus onProject Outcomes Build the best team you can Develop a plan and keep it up to date Remember that people count Gain the support of Management and Key Stakeholders Keep others informed of what you are doing Project Leadership
  • 49.
    What can theProject Manager do to gain consensus and buy-in on project objectives? How can you build synergy on the project team? (What is your team is a virtual team?) Discussion
  • 50.
    Establish Ground Rulesfor a Project Team (Brainstorm Ground Rules that would be appropriate for this 3-Day Project Management Course) Activity
  • 51.
    • Project definition •Business case • Project Charter • Stakeholder identification • Project Leadership Unit 2 Review
  • 52.
    This unit willcover planning: • Scope (WBS) • Schedule (Network Diagram) • Cost (Project Budget) • Responsibility Allocation (RAM) Unit 3: Planning
  • 53.
    1) Scope (WorkBreakdown Structure) 2) Schedule (Network Diagram) 3) Cost (Budget) Project Planning Scope Time Cost 1 2 3
  • 54.
    Work Breakdown Structure(WBS) The WBS is defined by PMI as, "a deliverable-oriented grouping of project elements that organizes and defines the total work scope of the project….”
  • 55.
    • Breaks thelarge project into manageable units • Defines the total scope of the project • Starts with the deliverables • Shows work packages (tasks or activities) • Allows you to organize work to then be scheduled • Allows you to be able to assign work to team members and identify resources needed • Communicates all the work that needs to be done The Work Breakdown Structure (WBS)
  • 56.
    1. Break workinto independent work packages that can be sequenced, assigned, scheduled and monitored 2. Define the work package at the appropriate level of detail 3. Integrate the work packages into a total system 4. Present in a format easily communicated to people 5. Verify that the work packages will meet the goals and objectives of the project To create a WBS
  • 57.
    • Way ofmanaging the project by breaking it down • Help determine skills required and amount of resources needed • Communicate work that needs to be done • Work sequences are identified and understood Work Packages
  • 58.
    Create a WBS(Work Breakdown Structure) List all work packages required for the Case Study on yellow sticky notes (Start with Deliverables) Activity
  • 59.
    Discuss the importanceof defining the “what” we will do in the WBS before moving to the “how” in building the schedule? Discussion
  • 60.
  • 61.
    WBS: what needsto be done Network Diagram: how the work will be done (the workflow) WBS and Network Diagram
  • 62.
    1. Establish schedulingassumptions 2. Estimate the resources, effort and duration • Effort – time that it takes to work on the activity • Duration – the time to complete the activity 3. Determine calendar dates for activities 4. Adjust individual resource assignments 5. Chart final schedule Scheduling
  • 63.
    • Have thepeople who are doing the work provide the estimates • Get an expert’s estimate • Find a similar task • Look for relationship between activity and time (parametric estimate) • Educated guess Estimating Time
  • 64.
    PERT – ProgramEvaluation Review Technique (Uses 3 time estimates to determine most probable) Optimistic estimate (O) Most likely (ML) Pessimistic estimate (P) PERT = [O + 4(ML) +P] / 6 PERT Estimating
  • 65.
    Padding Estimates =Poor Estimates •Add contingency as an activity •(Contingency is typically 10-15% of the base budget) Contingency
  • 66.
    List all Activitieson Network Diagram Sticky Notes and determine their Duration (Start with Work Packages) Activity
  • 67.
    • Logical representationsof scheduled project activities • Define the sequence of work in a project • Drawn from left to right • Reflect the chronological order of the activities Network Diagrams
  • 68.
    • Precedence definesthe sequencing order • How work elements are related to one another in the plan • Many activities can be done in parallel or at the same time (if resources are available) Precedence
  • 69.
    • Create anActivity for each task • Lines connect activities to one another • Activities are laid out horizontal from left to right • Parallel activities are in the same column • Precedence is shown by drawing lines from activity to activity • One activity may depend on the completion of multiple other activities How to create a Network Diagram:
  • 70.
  • 71.
    • Lead –amount of time that precedes the start of work on another activity • Lag – amount of time after one activity is started or finished before the next activity can be started or finished Lead and Lag
  • 72.
    Critical Path •The longestpath (the sequence of tasks that forms the longest duration) •The shortest time that you can complete your project Float • Amount of time that an activity may be delayed from its earliest possible start date without delaying the project finish date • Latest possible finish date – earliest possible start – duration = total float
  • 73.
  • 74.
    • Assign peopleto the schedule • Start with the critical path first • Non-critical tasks second Normalizing the Schedule
  • 75.
    Resource Load –the amount of work that is assigned to a resource Resource Leveling – redistribution to even out the distribution of work across all resources Loading and Leveling
  • 76.
    • Ensure thatlearning time is identified • Ensure that administration time is included • Be aware that resources seldom work 100% of the time on one project Scheduling Tips
  • 77.
    Create a NetworkDiagram for the Case Study • Order all Activities on Network Diagram (relationships and dependencies) • Do a forward pass to determine the project length • (Input + Duration = Output) • Mark the Critical Path in red Activity
  • 78.
    Discuss the importanceof knowing the critical path and how that helps the project manager make decisions Discussion
  • 79.
    Budget = People+ Resources + Time Budgeting
  • 80.
    • Giving anumber too soon • Before WBS • Not considering risk • Not evaluating experience and skill of resources Classic Budgeting Mistakes
  • 81.
    • Rough Orderof Magnitude • Definitive Estimate Budgeting Levels
  • 82.
    Direct costs (Directlyattributed to the project) • Labor • Supplies & raw materials • Equipment • Travel • Legal Fees • Training • Marketing/advertising Direct & Indirect Costs
  • 83.
    Indirect costs (Sharedamongst other projects) • Facilities • Site-specific requirements • Management & administrative overhead Indirect Costs
  • 84.
    • Bottom-Up • Top-Down •Phased Types of Budgeting
  • 85.
    • 10-15% ofbudget is normal • Don’t pad but manage the contingency PMI Library article “Change Budget- One Key to Never Padding Estimates Again” by Neal S. Gray, Keane Inc. Contingency Reserve
  • 86.
    Create a Budgetfor the Case Study Direct and Indirect costs (Materials, Supplies, Labour costs, Marketing, Printing etc.) Activity
  • 87.
    • Review theplan with key stakeholders • Project Plan must be approved • Must get Sign-off to get from Plan to Action Getting the Project Plan Approved
  • 88.
    Project risk isdefined by PMI as, "an uncertain event or condition that, if it occurs, has a positive or negative effect on a project's objectives." Risk Management
  • 89.
    Step 1) IdentifyRisks Step 2) Prioritize Risks (Qualitative Analysis) Step 3) Develop Risk Management Strategies Risk Management
  • 90.
    • Funding • Time •Staffing • Customer relations • Project size and/or complexity • Overall structure • Organizational resistance • External factors Risk Categories
  • 91.
    Qualitative Analysis =Probability x Impact •Probability (Likelihood) •Impact (Consequence) Risk Analysis
  • 92.
    Threats: Avoid Mitigate Transfer Accept Risk Response Plans(Strategies) Opportunities: Exploit Share Enhance Accept
  • 93.
    Risk Register • Reviewand update regularly • Assign ownership to risk Risk Track and Control
  • 94.
    1) Identify 10Risks for Case Study Project 7 threats/3 opportunities 2) Rank the Risks (PxI) 3) Develop Risk Response Strategies 3 threats and 3 opportunities (for highest ranked risks from PxI) Activity
  • 95.
    Discuss the valueof Risk Management and the consequence of not identifying risks Discussion
  • 96.
    Need to letthe team members know: • The reason they are on the team, and what they have to offer • Their Roles and Responsibilities • Standards that they will be held accountable to Project Team
  • 97.
    R – Responsible A– Approves S – Supports I – Inform C – Consult RASIC Chart Activity PS PM BA Tech Test User SOW A R S I I I Scope Doc A A R C C S Design Doc A A S R C I Test Plan A S C R C Training Plan A R C S Responsibility Assignment Matrix
  • 98.
    • What kindsof experience do you need? • What kind of competency do they have? • What is their availability? • Do they have a personal interest in the outcome of the project? • Will they work well in a team environment? Building a team
  • 99.
    • Use yourown staff & people from your department • Staff from other departments • Contract with consultants, outside agencies, or temporary agencies • Hire and train new staff Staffing Alternatives
  • 100.
    • Do thebest you can with the people you have, and document problems and results. • If they do not have enough skills, and training takes too long, consider contracting. • Compromise and negotiate for the team members you really need. Dealing with Staffing Challenges
  • 101.
    Using the CaseStudy, create a RAM (Responsibility Assignment Matrix) using any legend you wish (e.g. RACI, RASCI, RASIC, PBRIS) Activity Deliverable Person/Role Person/Role Person/Role Activity 1 R A C Activity 2 R I
  • 102.
  • 103.
    In this unit,you will learn: • Operating Guidelines • Communication Unit 4: Execution
  • 104.
    • Reporting ProjectStatus • Change Management • Decision making • Managing the team Operating Guidelines
  • 105.
  • 106.
    Discuss how therole of the Project Manager changes in the Execution phase? Discussion
  • 107.
  • 108.
    Who? Right pointof contact What? Information to be communicated How? Method of communication (Format) How Often? Frequency of communication Communication Plan
  • 109.
    Develop a communicationplan from the case study Sample Communication Plan Stakeholder Information Required From Whom (Sender) Schedule of Delivery Means of Delivery Format Start Date End Date Comments This person or group needs this information from this person or group on this schedule delivered by in this format starting this date and ending this date Enter additional information here Project Sponsor Status Report Project Manager Bi-weekly E-mail Report Jan. 15 June 31 Summary of accomplishments for this period, plans for next period, issues barriers, overall project status
  • 110.
    • Macro andMicro Barriers • Geography, language, culture • Attitudes • Jargon and Acronyms • Stakeholder preferences Adapt your communication style based on:
  • 111.
    • Draft themessage and edit • Consider audience’s expectations, actions required, and your expectations after the message is delivered • Justify the choice of delivery method • Identify the issue, context or opportunity of interest first • Make required actions clear and specific • Be concise Effective Messages
  • 112.
    Create a CommunicationPlan for the Case Study •Choose 4 Stakeholders (from Stakeholder Identification Activity) •What do they need to know (Nature of Communication) •How will you will communicate with them (Method) •How often you will need to communicate with them (Frequency) Activity From To Nature of Communication Method Frequency
  • 113.
    What is thevalue of a Communication Plan and what are the consequences of not communicating effectively with Stakeholders? Discussion
  • 114.
  • 115.
    In this unit,you will learn: • What to Monitor and Control • Earned Value • Change Management • Quality Unit 5: Monitoring and Controlling
  • 116.
  • 117.
    What does itmean to Monitor and Control the project? Discussion
  • 118.
    • Completion ofwork packages compared to plan • Scope of work • Quality of work • Costs and expenditures • Attitudes and cohesiveness of team What to Monitor?
  • 119.
    • Communicate projectstatus and changes to Project Team • Manage expectations of Stakeholders • Provide justification for project adjustments • Document current project plans compared to original Purpose of Monitoring
  • 120.
  • 121.
    Earned Value EV= EarnedValue (Value of work completed) PV= Planned Value (Value of work as planned) AC= Actual Costs (Costs billed to the project) Reporting on Variances: • Schedule Variance (SV=EV-PV) • Schedule Performance Index (SPI=EV/PV) • Cost Variance (CV=EV-AC) • Cost Performance Index (CPI=EV/AC)
  • 122.
    Reporting Cost andTime Progress Status Forecast
  • 124.
    Using a Ganttchart to report progress
  • 126.
    • Use theproject plan as a guide • Monitor and update plan regularly • Adapt project schedule, budget and work plan as needed • Document progress and changes, communicate them to the team • Communicate actions taken to Key Stakeholders Controlling
  • 127.
    Techniques to compressthe schedule: Crashing • Focused on critical path • Generate multiple alternatives • Add additional resources to the project Fast tracking • Overlap sequential activities How to Control?
  • 128.
    How will theCase Study project be monitored? • What will be reviewed and how often? Activity
  • 129.
    The only wayto maintain and manage scope! •Roles involved in managing change • Change Authority (Sponsor, Change Control Board, PM) •Process flow diagram for change management •All changes are documented and communicated (both approved and rejected changes) •Control documents • Change Control Log • Issues Log Change Management Plan
  • 130.
    Sample Change ControlProcess Change? Good idea? To issues list Yes Yes Yes No No No Impact plan or risk? Define impact Prepare change order Change approved? Amend plan Make the change 3-20
  • 131.
  • 132.
    • Update theoriginal baseline for approved Project Scope changes to continue to report Project Status (Scope/Time/Cost) • Update the original plan to reflect the approved change • Communicate the change to all Stakeholders to manage stakeholder expectations (no surprises) How to respond to Approved Change 3-22
  • 133.
    A change isrequested by the Project Sponsor. What is the impact of delivering the event 2 weeks sooner to coincide with another similar event? • In your groups, perform a Change Impact Assessment in the Change Request Form (Tip: Consider the impact of making the change in terms of time/cost/scope and the impact of not making the change as well as any additional risks) Activity
  • 134.
    Project quality isdefined by PMI as the “degree to which a set of inherent characteristics (of the finished product) fulfills requirements." Quality Management
  • 135.
    • Quality Planning •Development of criteria or metrics • Quality Control: • Measuring results • Quality Assurance: • Assuring conformance to requirements Quality 3-22
  • 136.
    What activities wouldyou do on the Case Study Project to verify and validate Quality? Discussion
  • 137.
    What to Monitor Howto Control Earned Value Analysis Change Management Managing Stakeholder Expectations Quality Unit 5 Review
  • 138.
    This unit willcover: •Closing the project •Lessons learned •Post-Implementation Review •Final Report Unit 6: Closing
  • 139.
  • 140.
    • Final approvalfrom stakeholders • Finalize contractual commitments • Transfer responsibilities to others • Reassign people in the project • Release non-human resources • Complete final accounting • Document results and recommendations for the future Closing the Project
  • 141.
    • Meeting withProject Team and Sponsor • (After celebration but before forgotten) • Did the Project accomplish the Objective as stated in the Charter? Post-Implementation Review
  • 142.
    How would theCase Study project be closed out? What type of post-implementation review would you do and when? Activity
  • 143.
    Celebrate the successof the Project •Why is celebrating success and acknowledging people’s performance on the Project so important? Discussion
  • 144.
    • Overview ofproject • Major accomplishments • Achievements compared to Business Case objectives • Final Financial accounting • Analysis of Quality against expectations/requirements • Evaluation of administration and management performance • Team’s Performance/Special acknowledgments • Changes (approved and impact of changes) • Issues or tasks of further investigation • Recommendations for future projects • Post-implementation date Final Report
  • 145.
    Focus areas • ProjectManagement, Communications, Schedule & Budget, Training, Quality, Issues, Human Resources, Administration •What went well? •What didn’t? •What should be improved? •How? •Anything else? Lessons Learned
  • 146.
    Why document LessonsLearned on the project? Discussion
  • 147.
    • In yourteams, conduct a Lessons Learned based on your team performance over the past 3 days: • What did you do well in your teams? • What could you have done better? • What advice would you give to a team about to embark on a similar project (planning an event)? Activity
  • 148.
    Common Problems onProjects •Start date moves but end date doesn’t •Not enough time •Changes, changes, changes •Key person quits or is unavailable •Team has more enthusiasm than talent •People are always 90% done •Politics
  • 149.
    Put Learning intoAction: Each team identifies Strategies (to address the reasons that projects fail) Activity
  • 150.
    Final Report Administrative Details LessonsLearned Celebrating Project Success Unit 6 Review
  • 151.
    Section 1: Introduction Section2: Initiating (Definition) Section 3: Planning Section 4: Executing Section 5: Monitoring & Controlling Section 6: Closing Review of 3 Days
  • 152.
    Personal Action Plan •What 3 things do you commit to putting into practice back on the job? Activity
  • 153.
    Thank you forattending Project Management Principles and Practices… •Slides: www.ualberta.ca/training/ttcfiles •Evaluations
