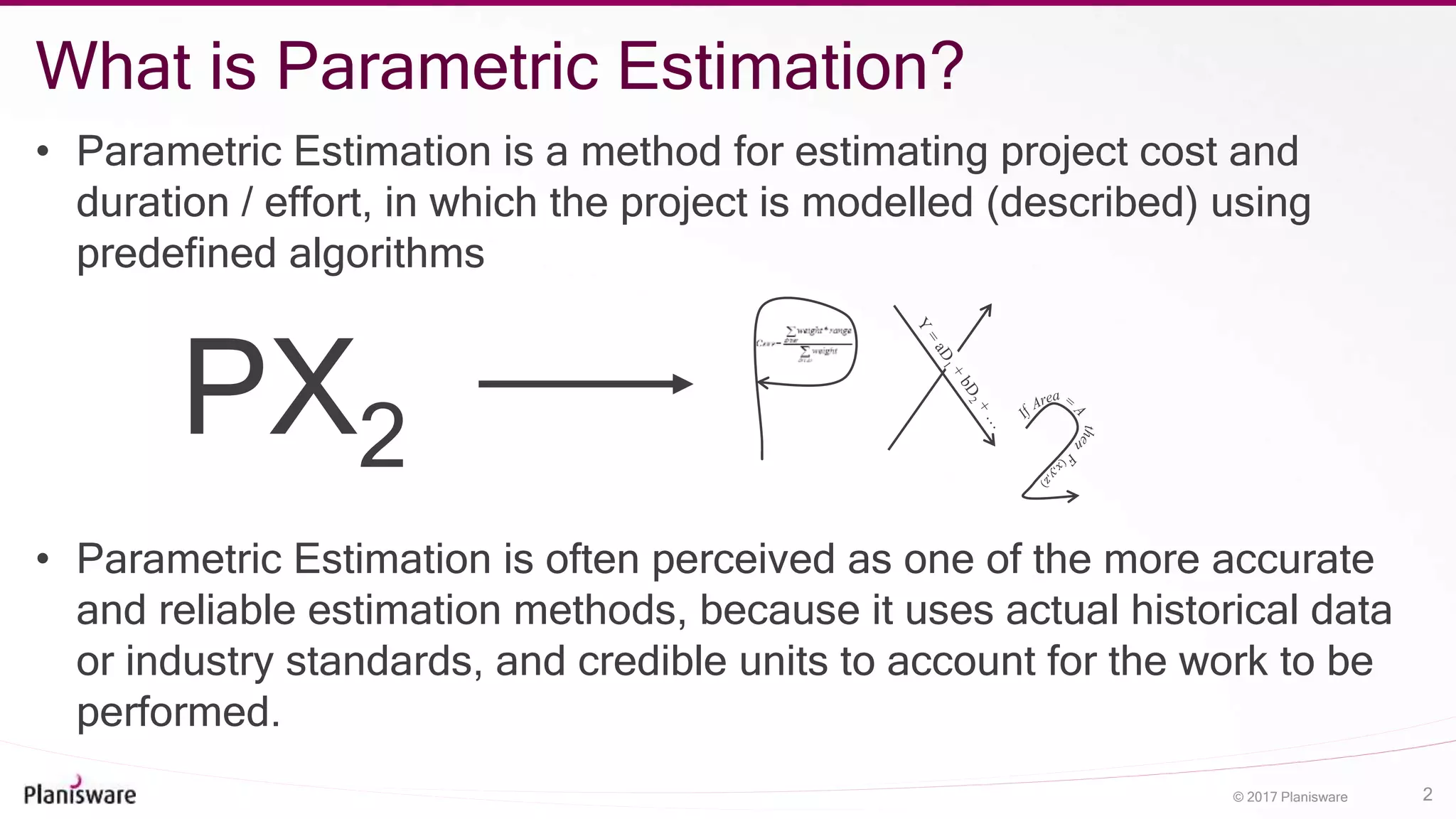

Parametric estimation is one of the four primary methods that project companies use to produce estimates for the cost, duration and effort of a project.

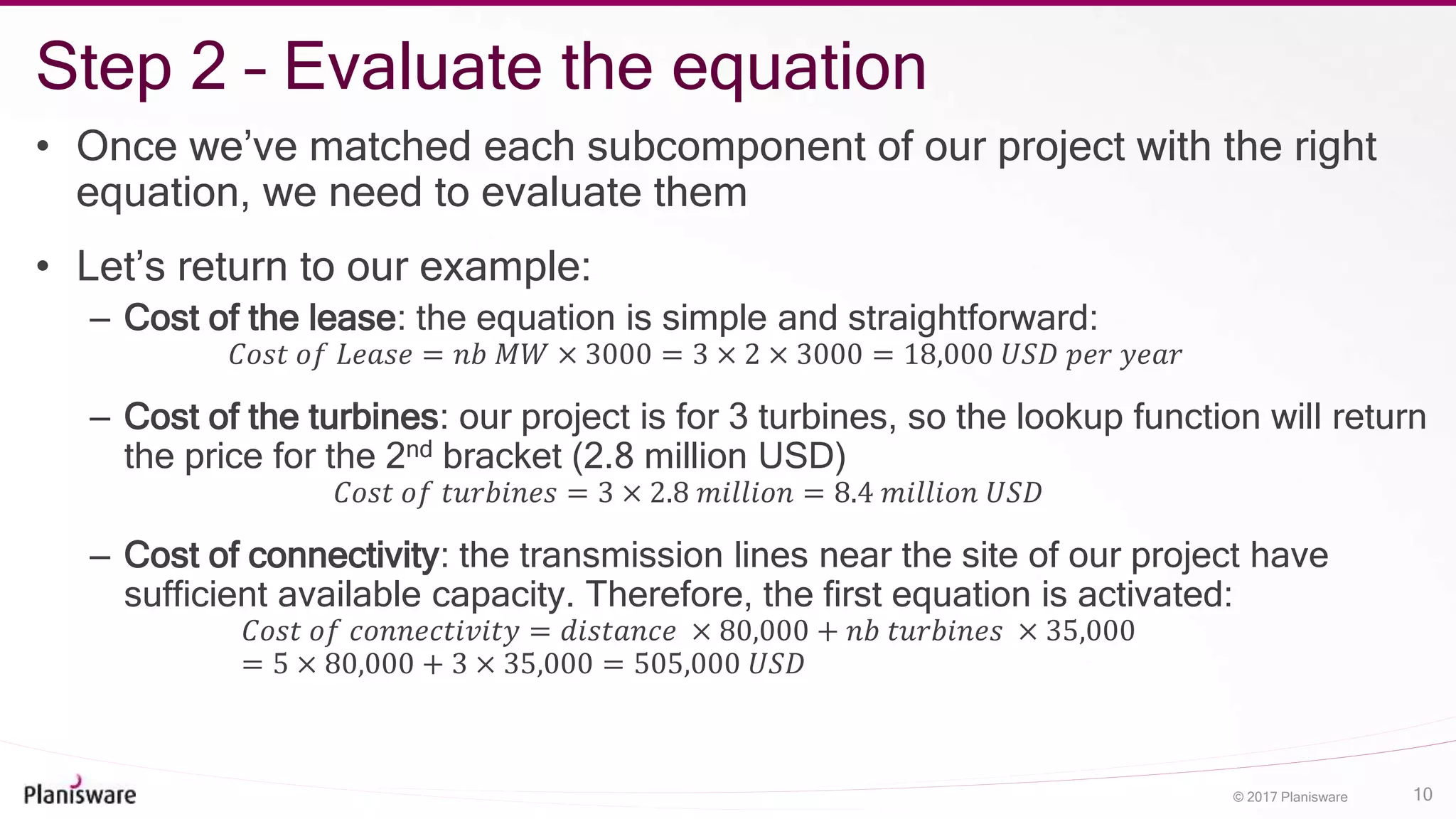

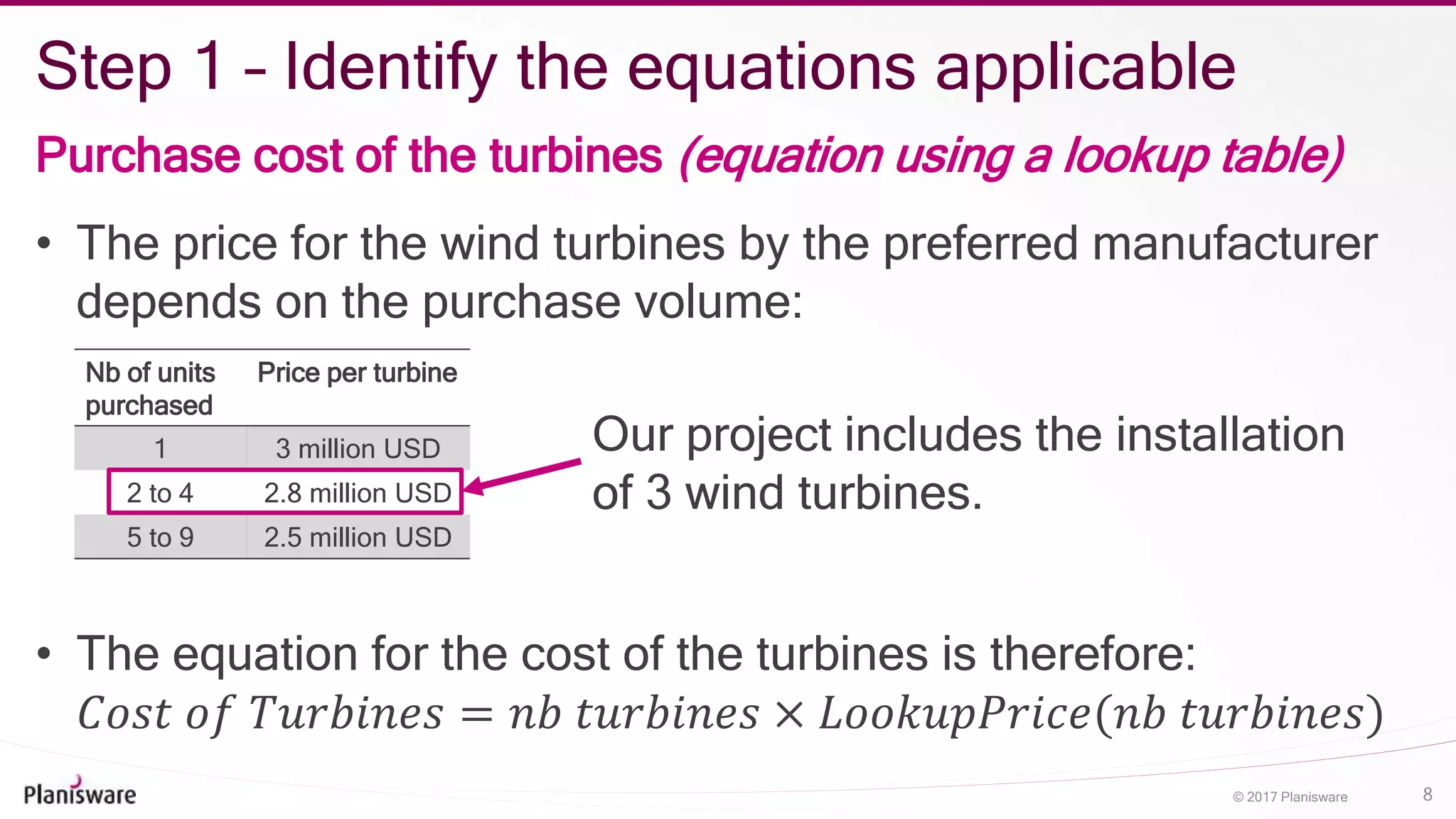

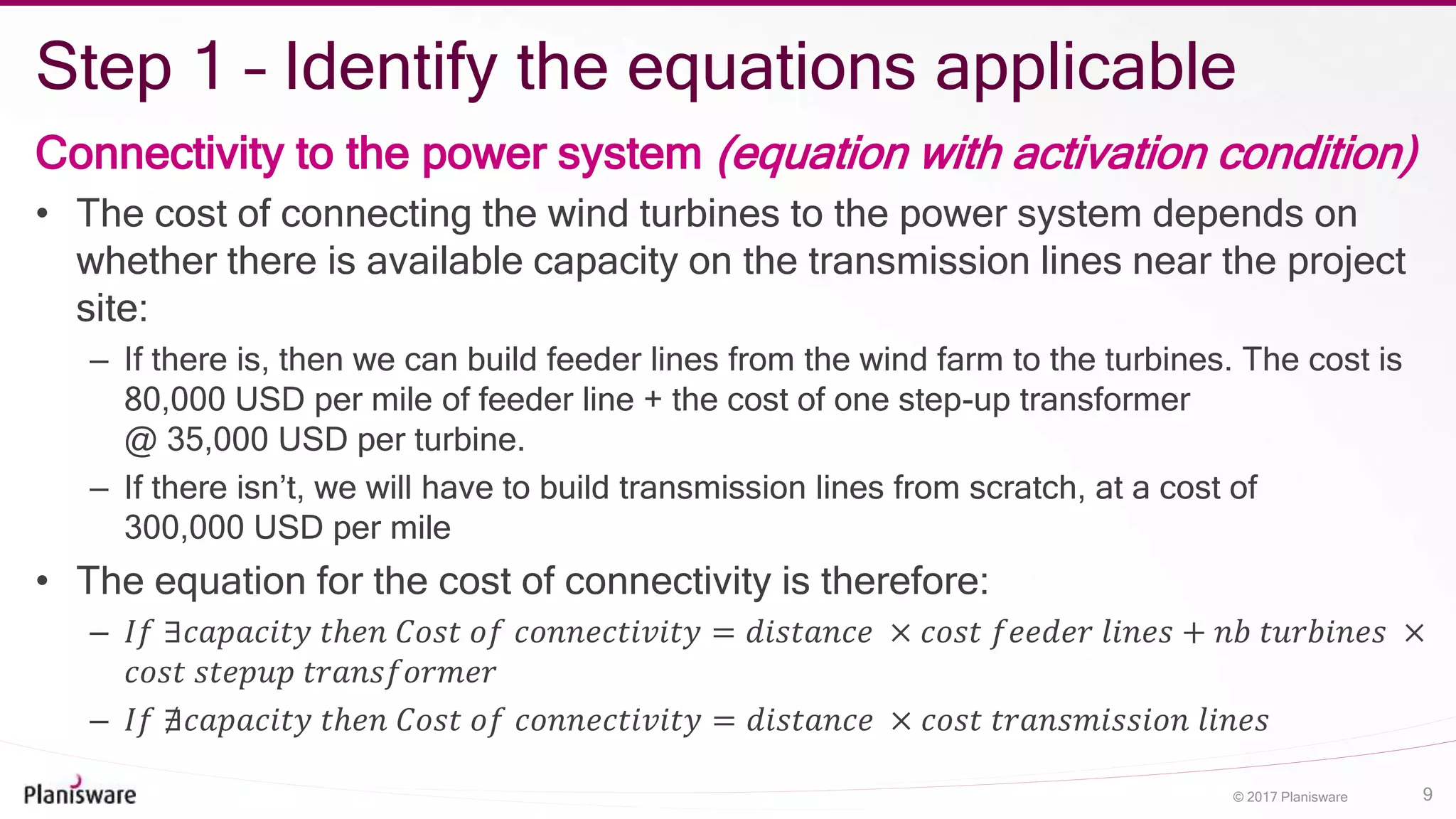

For parametric estimation, the person in charge of the estimates will model (or describe) the project using a set of algorithms. For instance: let’s say that your project includes carrying out a survey of 300 people. Each interview contains 20 multiple-choice questions, and past experience has shown that they take 10 minutes to administer. According to parametric estimation, the total effort for this task will be:

E = nb of interviews × 10 minutes = 3000 minutes = 5 hours
