Spartan Engineering - From Excel to
            Excellence

            Divyesh Muni
   Nishnaat Management Consultants
               Pvt. Ltd.
Overview


•   Background
•   Challenges Faced
•   Steps taken to overcome the challenges
•   The evaluation process
•   Oracle Product Deployment
•   Impact of adopting OBA
•   Achieving Excellence
•   Lessons learnt
•   Consulting Partner

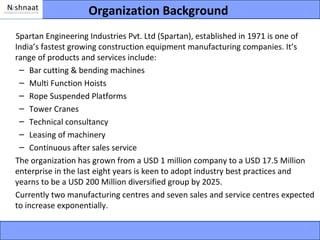

Organization Background
Spartan Engineering Industries Pvt. Ltd (Spartan), established in 1971 is one of
India’s fastest growing construction equipment manufacturing companies. It’s
range of products and services include:
 – Bar cutting & bending machines
 – Multi Function Hoists
 – Rope Suspended Platforms
 – Tower Cranes
 – Technical consultancy
 – Leasing of machinery
 – Continuous after sales service
The organization has grown from a USD 1 million company to a USD 17.5 Million
enterprise in the last eight years is keen to adopt industry best practices and
yearns to be a USD 200 Million diversified group by 2025.
Currently two manufacturing centres and seven sales and service centres expected
to increase exponentially.
Challenges Faced

•   Disparate application systems and data repositories
•   Data Duplication and Data inaccuracy
•   Poor internal controls
•   Lack of interdepartmental integration
•   Excel based reporting systems
•   End user resistance
•   Change Management
•   Family Run business growing at exponential pace. Absence of in-house
    capabilities to comprehend, manage and adapt to the project dynamics.
•   Multiple Locations
Steps taken to overcome the challenges

•   Appoint Process Consultant – Nishnaat Management Consultants Pvt. Ltd.
     –   Process Reengineering
     –   Channelise the implementation,
     –   Advice Spartan leadership on the do’s and don'ts,
     –   Project Management
     –   Manage the softer aspects of the ERP Implementation etc
•   Develop a Long Term Roadmap for Successful Oracle EBS Adaptation, listing
    business impact, projected benefits and responsibilities
•   Listing of Business Requirements to be addressed by the Application System
•   Identifying critical areas to be addressed and long pending issues.
     – Sub-contract Manufacturing
     – De-kitting Process
     – Return to Vendor
•   Development of an RFP to be circulated among shortlisted products and their
    implementation partners
Evaluation Process


•   Evaluation of responses received to the RFP
•   Product and Implementation Partner Evaluation
•   Product Finalization - Oracle EBS 12.1.3
•   Implementation Partner Finalization
•   Contracting
Oracle Product Deployment
•   Establishing Project Goals
•   Project Management
•   Oracle EBS ver 12.1.3 modules
     –   Order management
     –   Discrete Manufacturing
     –   Purchasing
     –   Financials
     –   Tele Sales
     –   Field Service
     –   Service Contracts


•   Adopting Oracle’s EBS deployment methodology
•   Identifying, configuring and implementing Oracle Solution for addressing
    critical areas and long pending issues
•   Project Duration – 5 months
Impact of adapting OBA


Adopted Oracle Business Accelerators (OBA) for the implementation

•   Easy-to-use implementation solution
•   Incorporated industry best practices business flows
•   Enabled the OBA Certified implementation consultants to easily map the
    business to Oracle EBS
•   Oracle EBS could easily be deployed
•   Reduction in the implementation time and cost
Impact of adapting OBA


           Traditional Oracle EBS Implementation Cycle


    As-Is      To Be                                                        Cutover
    Business   Process       Solution Build CRP    UAT     Data Migration   and
    Process    Definition                                                   Go-Live
    Study

                                       Timeline
                      Implementation with OBA + appLOAD


                  OBA Data                             Cutover
                  Collection CRP      UAT    Data      and
                  And Tool                   Migration Go-Live
                  Run
                                      Timeline
9
Achieving Excellence




•   Single information repository organization wide
•   Inter departmental integration
•   Increased speed of response
•   Streamlining of business processes
•   Enhanced internal controls
•   Continuous support from Chain-Sys
•   Adhering to the ERP Roadmap
Lessons Learnt


•   Top Management Commitment key to project success
•   Reduction in implementation schedules by deploying OBA
•   Devise and adhere to the ERP roadmap
•   Effective project communication
•   Link EBS Adoption to employee performance management system
•   The EBS Implementation is a good opportunity for the organization to
    revisit existing business processes
•   A Process Consultant plays an effective role in Business Process Re-
    Engineering, assisting the organization in preparing for the EBS
    Implementation and for managing the softer aspects of the implementation
•   Seek services of a knowledgeable and committed Implementation Partner
Consulting Partner – Chain-Sys India Pvt. Ltd.




•   Reputed implementation partner
•   Simplicity
•   Industry knowledge
•   Top Management Support and commitment to success of the project
•   OBA Experience
•   Demonstrated ability to address issues faced by Spartan
•   Great people to work with
