AEC ProjectCreative Collaborators December 5, 2010

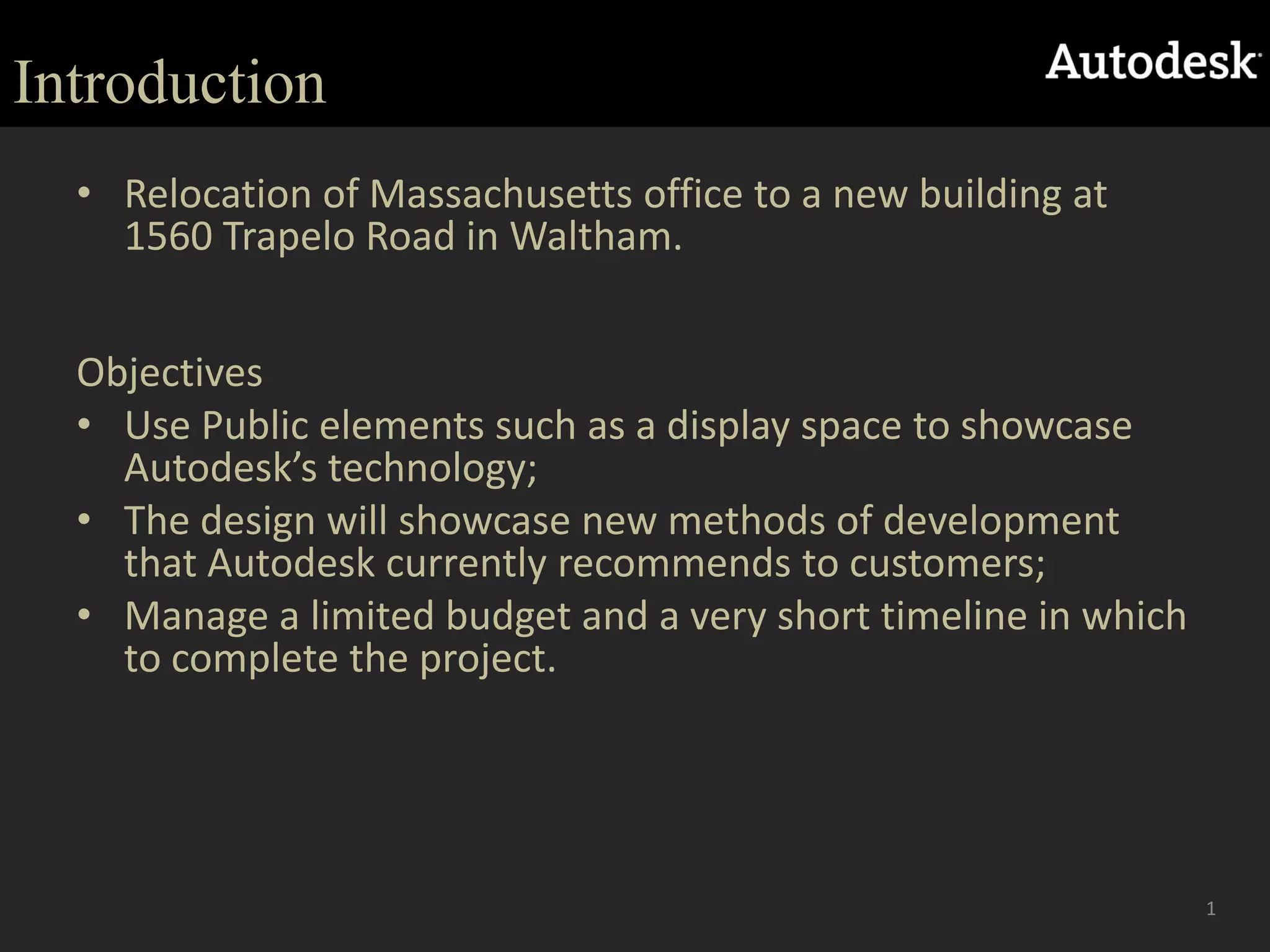

IntroductionRelocation of Massachusetts office to a new building at 1560 Trapelo Road in Waltham.  ObjectivesUse Public elements such as a display space to showcase Autodesk’s technology;The design will showcase new methods of development that Autodesk currently recommends to customers;Manage a limited budget and a very short timeline in which to complete the project.1
Whatis Building Information Modeling (“BIM”)?A software program that allows for a space to be mapped in 3-D, to show all of the design and construction elements; 3-D renderings of a space under construction enables major design elements, such as lighting, to be modified early on, during construction;  This process helps facilitate key design changes and provides for a more collaborative design process. 1
What is Integrated Project Delivery (“IPD”)?A design and construction process, between architects, contractors and the client, which is highly collaborative;  Agreement to work in an IPD environment can be built into the contracts for the architect and contractors.;If the project does not get completed on time or budget, no one gets paid;  Major challenge is to find architects and contracts willing to work in such an environment. 1
Measuring Success - And Paying For It1
3 Key Objectives->	Move 300 people with supplies and equipment->	Creating a case study for future customers->	LEED Platinum Certification1

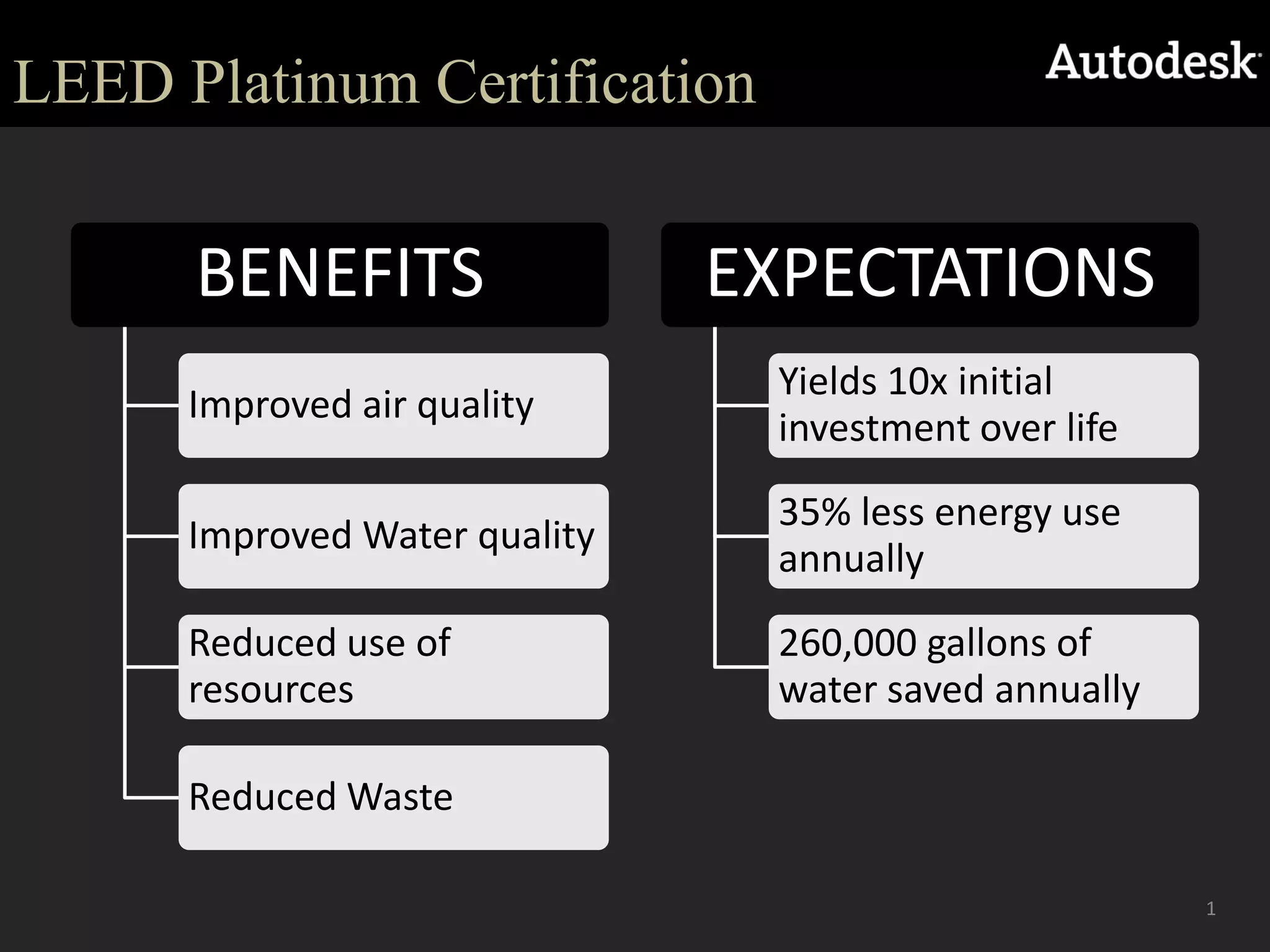

LEED Platinum Certification1

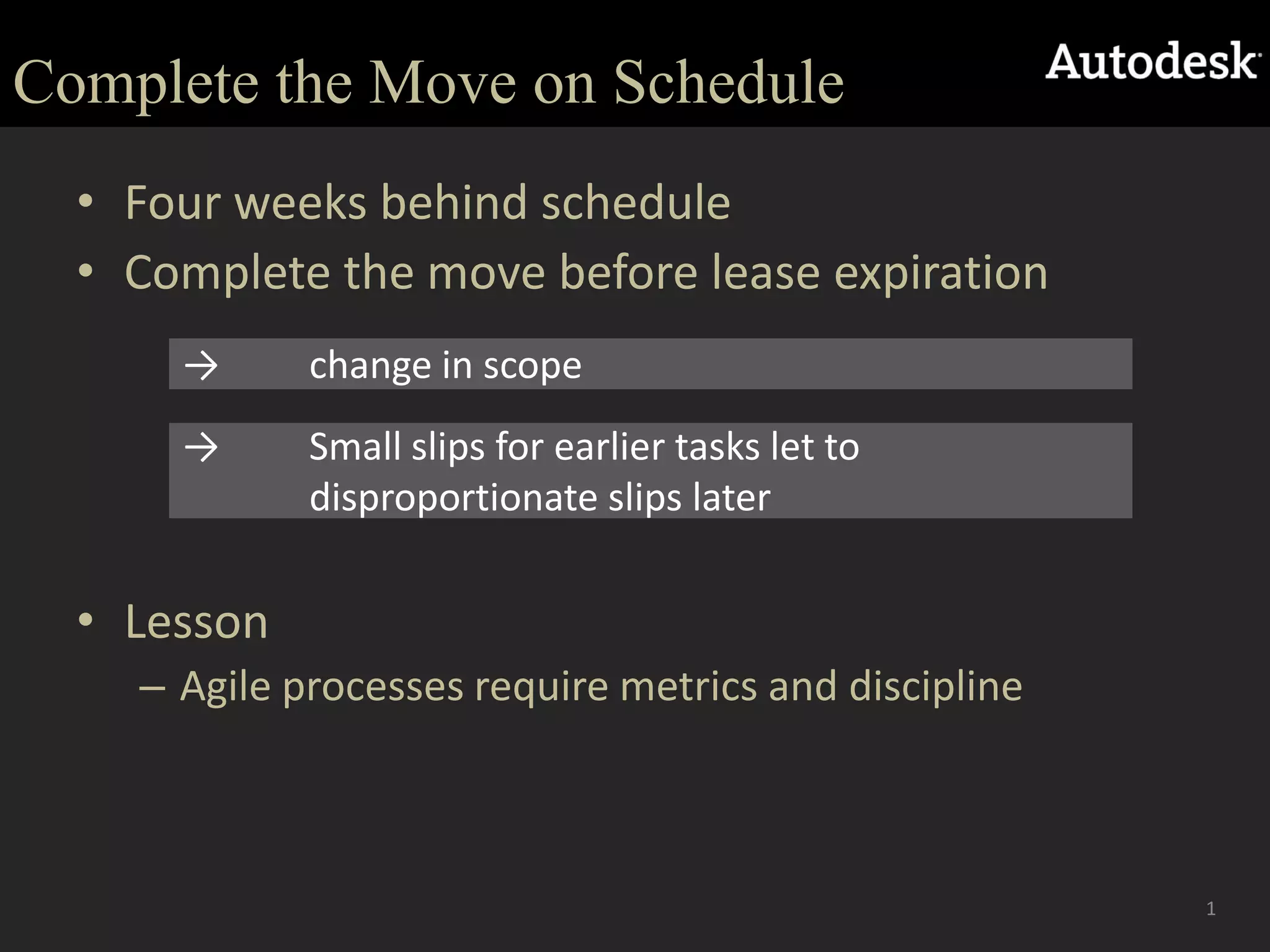

Complete the Move on ScheduleFour weeks behind scheduleComplete the move before lease expirationLessonAgile processes require metrics and discipline->	change in scope->	Small slips for earlier tasks let to 	disproportionate slips later1
Managing a More Agile Process->	discipline->	metrics->	evaluation1
Meet the Needs of StakeholdersLong term stakeholdersProject team stakeholdersIssuesCafé kitchen scope creepFacilities removed from original scopeOther scope changesLessonStakeholder analysisFormal scope change process1
Meet the Needs of StakeholdersLong term stakeholdersProject team stakeholdersIssuesCafé kitchen scope creepFacilities removed from original scopeOther scope changesLessonStakeholder analysisFormal scope change process1

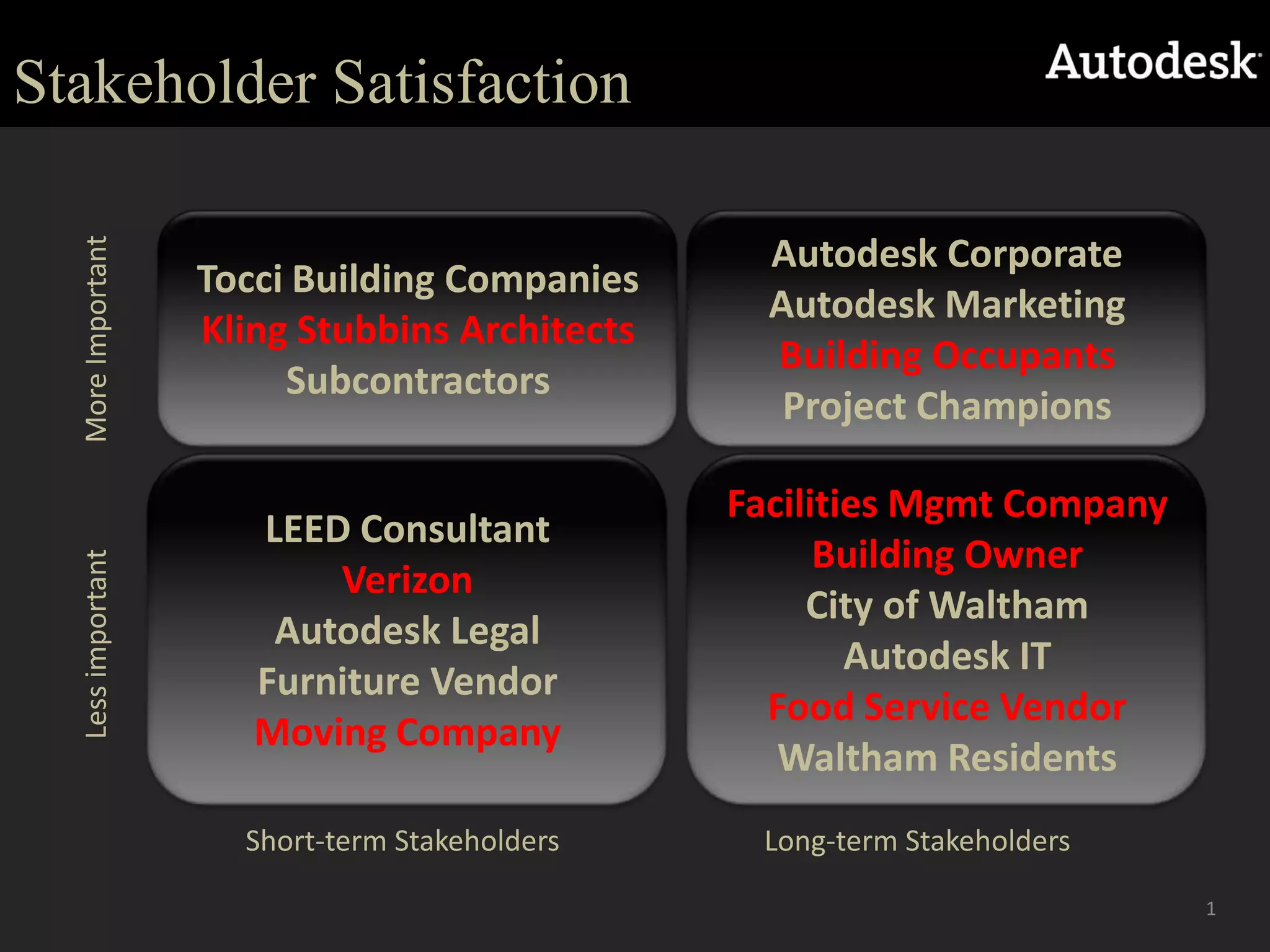

Stakeholder SatisfactionTocci Building CompaniesKling Stubbins ArchitectsSubcontractorsAutodesk CorporateAutodesk MarketingBuilding OccupantsProject ChampionsMore ImportantLEED ConsultantVerizonAutodesk LegalFurniture VendorMoving CompanyFacilities Mgmt CompanyBuilding OwnerCity of WalthamAutodesk ITFood Service VendorWaltham ResidentsLess importantShort-term StakeholdersLong-term Stakeholders1

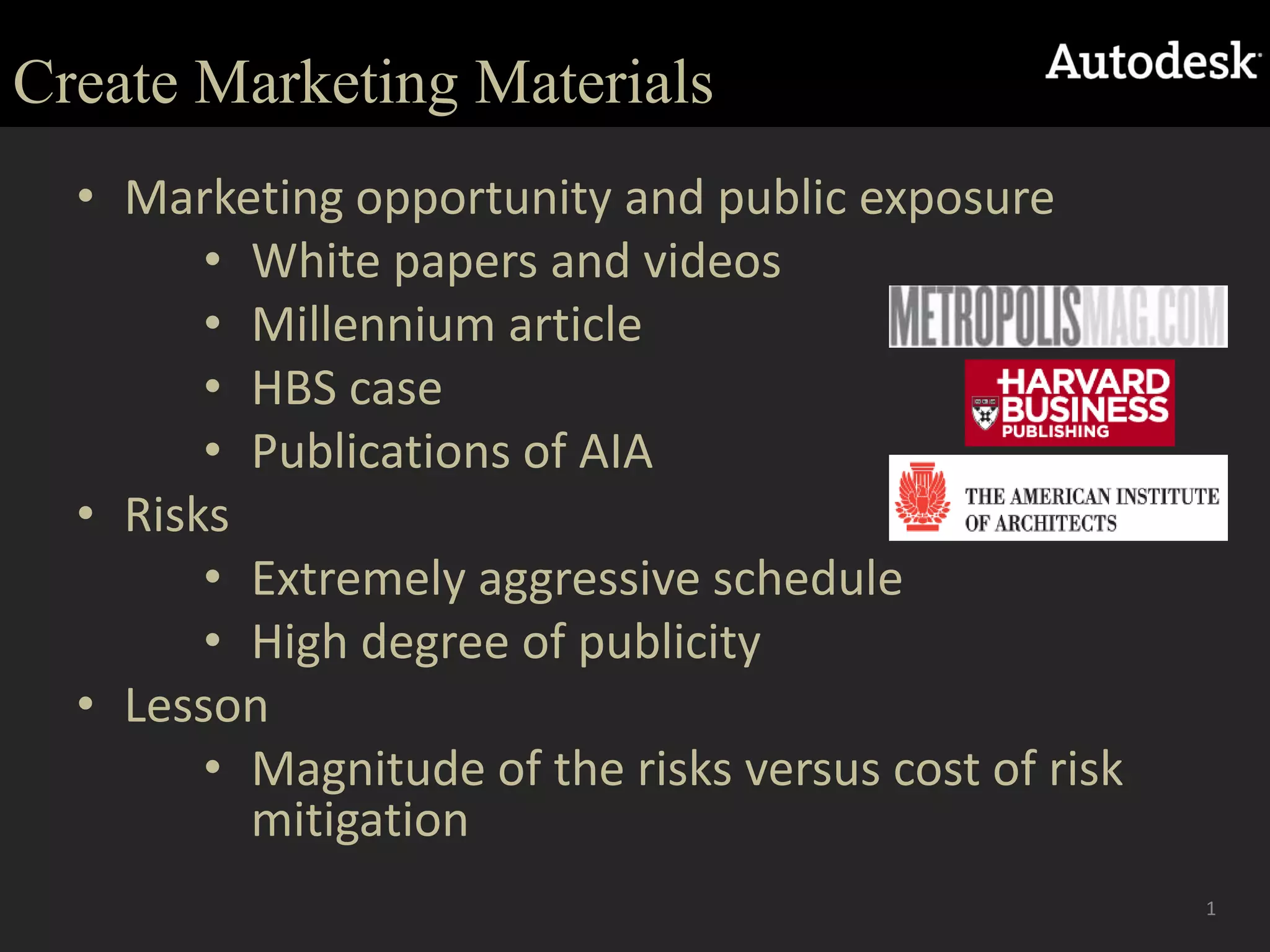

Create Marketing Materials Marketing opportunity and public exposure
White papers and videos
Millennium article

Operations class project

  • 1.
  • 2.
    IntroductionRelocation of Massachusettsoffice to a new building at 1560 Trapelo Road in Waltham. ObjectivesUse Public elements such as a display space to showcase Autodesk’s technology;The design will showcase new methods of development that Autodesk currently recommends to customers;Manage a limited budget and a very short timeline in which to complete the project.1
  • 3.

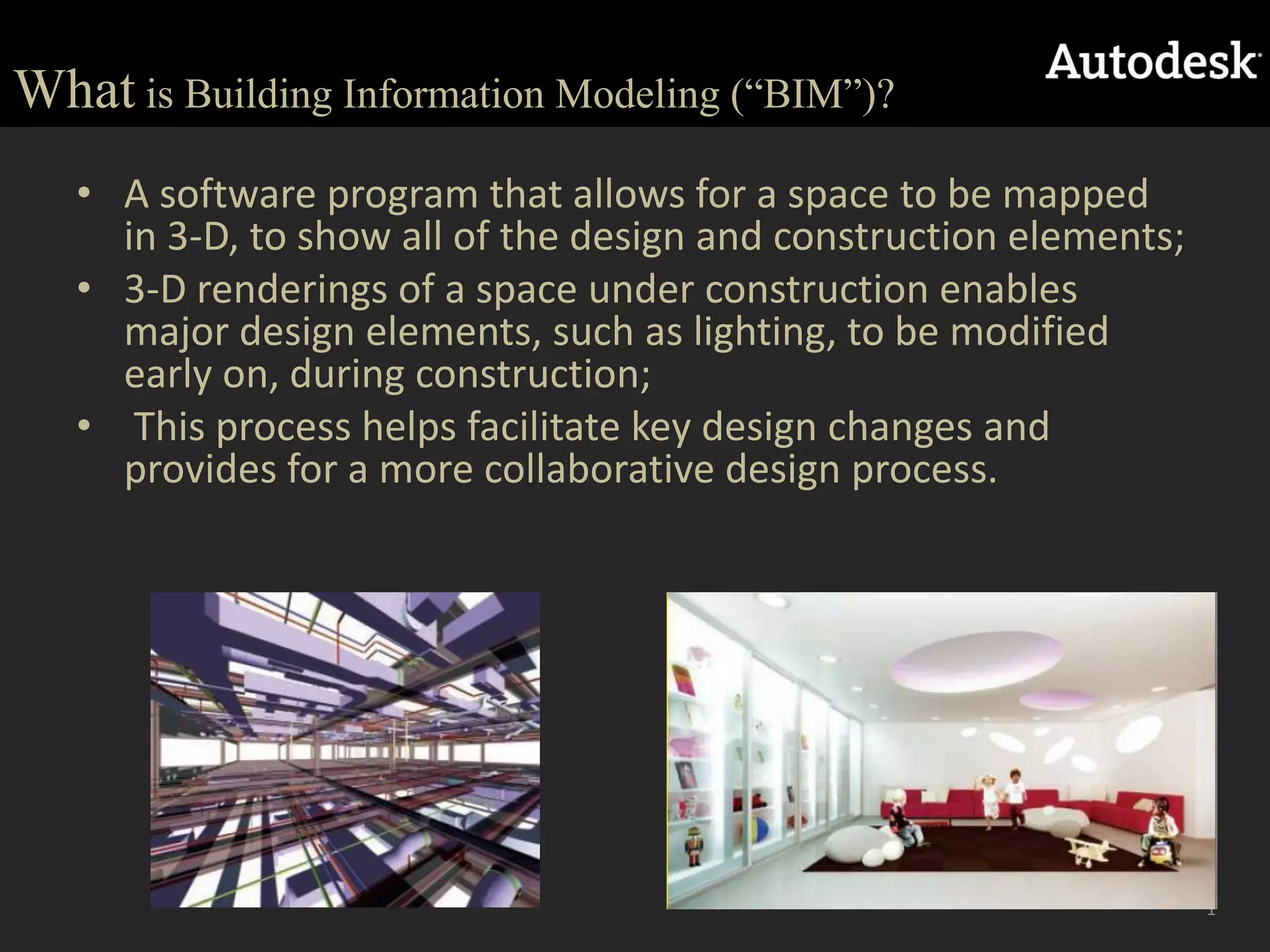

    Whatis Building InformationModeling (“BIM”)?A software program that allows for a space to be mapped in 3-D, to show all of the design and construction elements; 3-D renderings of a space under construction enables major design elements, such as lighting, to be modified early on, during construction; This process helps facilitate key design changes and provides for a more collaborative design process. 1
  • 4.

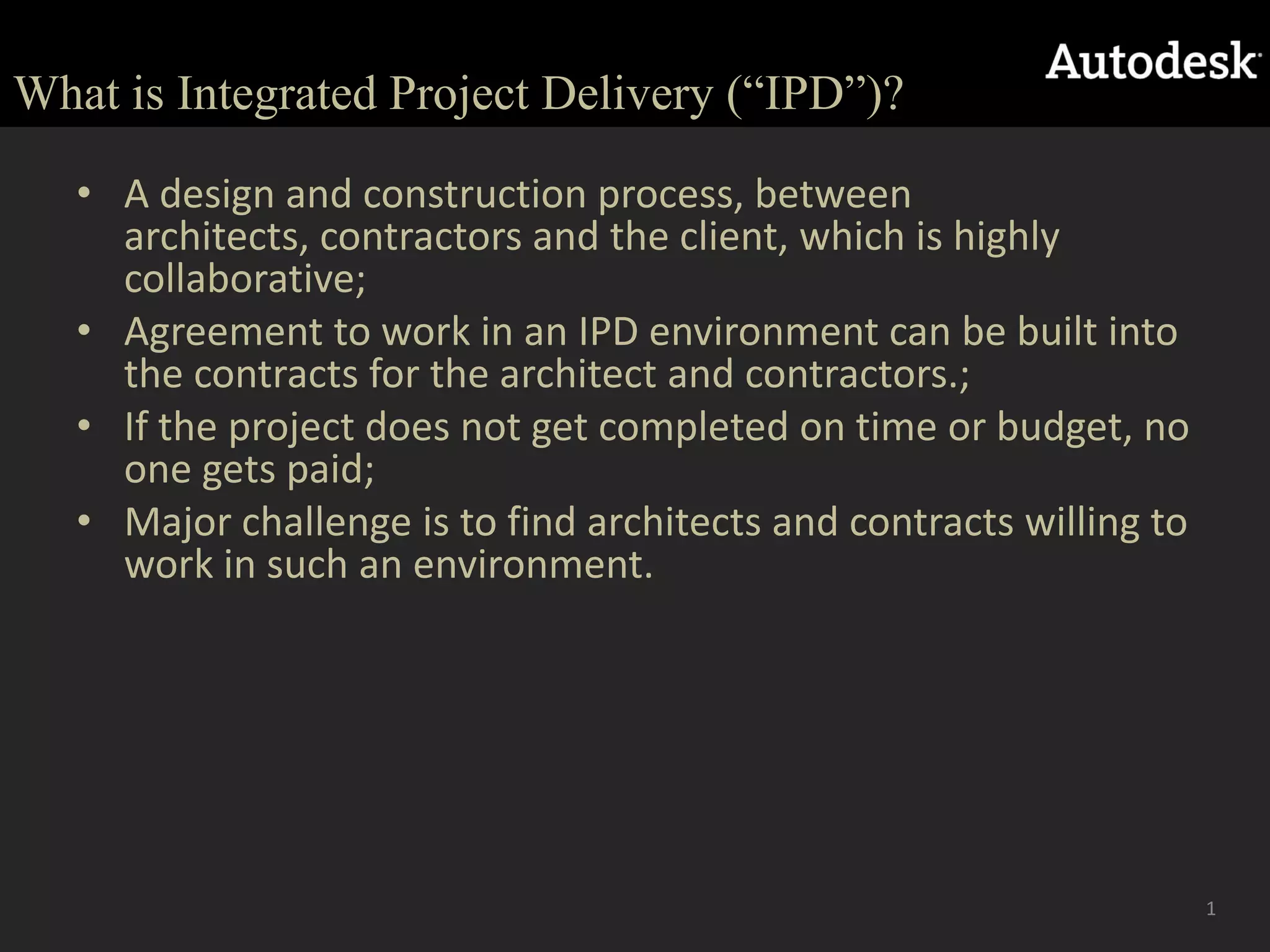

    What is IntegratedProject Delivery (“IPD”)?A design and construction process, between architects, contractors and the client, which is highly collaborative; Agreement to work in an IPD environment can be built into the contracts for the architect and contractors.;If the project does not get completed on time or budget, no one gets paid; Major challenge is to find architects and contracts willing to work in such an environment. 1
  • 5.

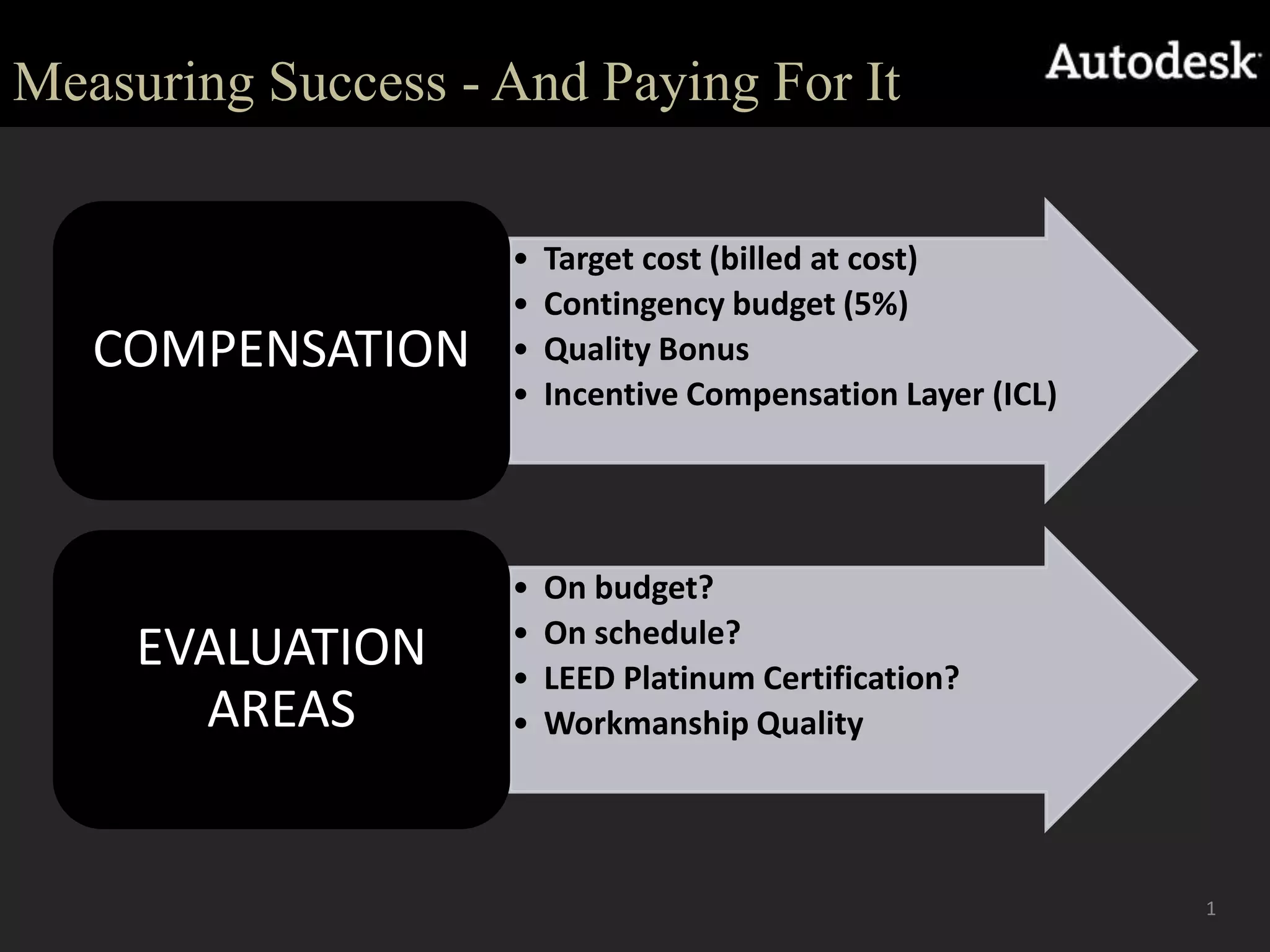

    Measuring Success -And Paying For It1
  • 6.

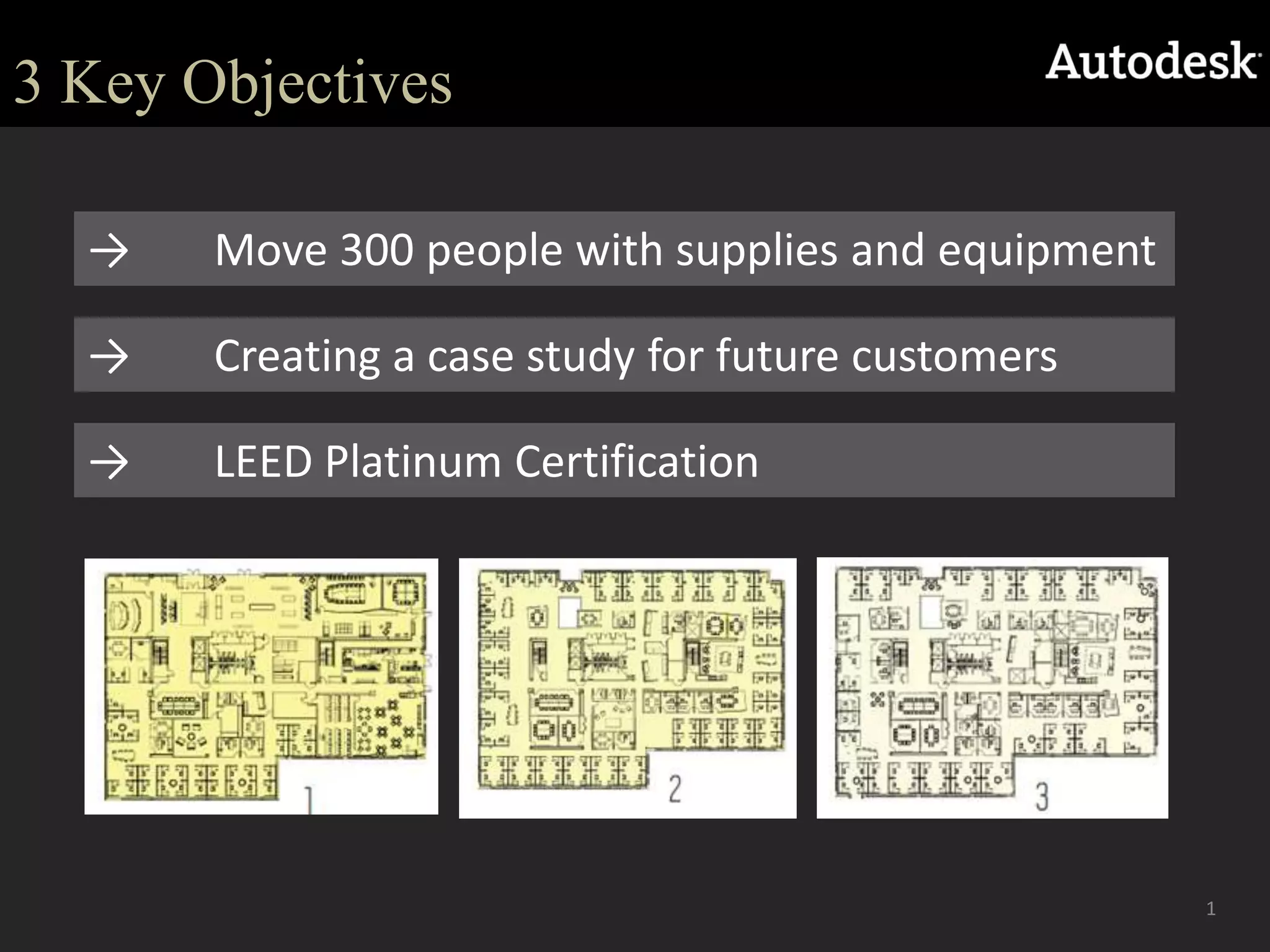

    3 Key Objectives-> Move300 people with supplies and equipment-> Creating a case study for future customers-> LEED Platinum Certification1
  • 7.
  • 8.
    Complete the Moveon ScheduleFour weeks behind scheduleComplete the move before lease expirationLessonAgile processes require metrics and discipline-> change in scope-> Small slips for earlier tasks let to disproportionate slips later1
  • 9.

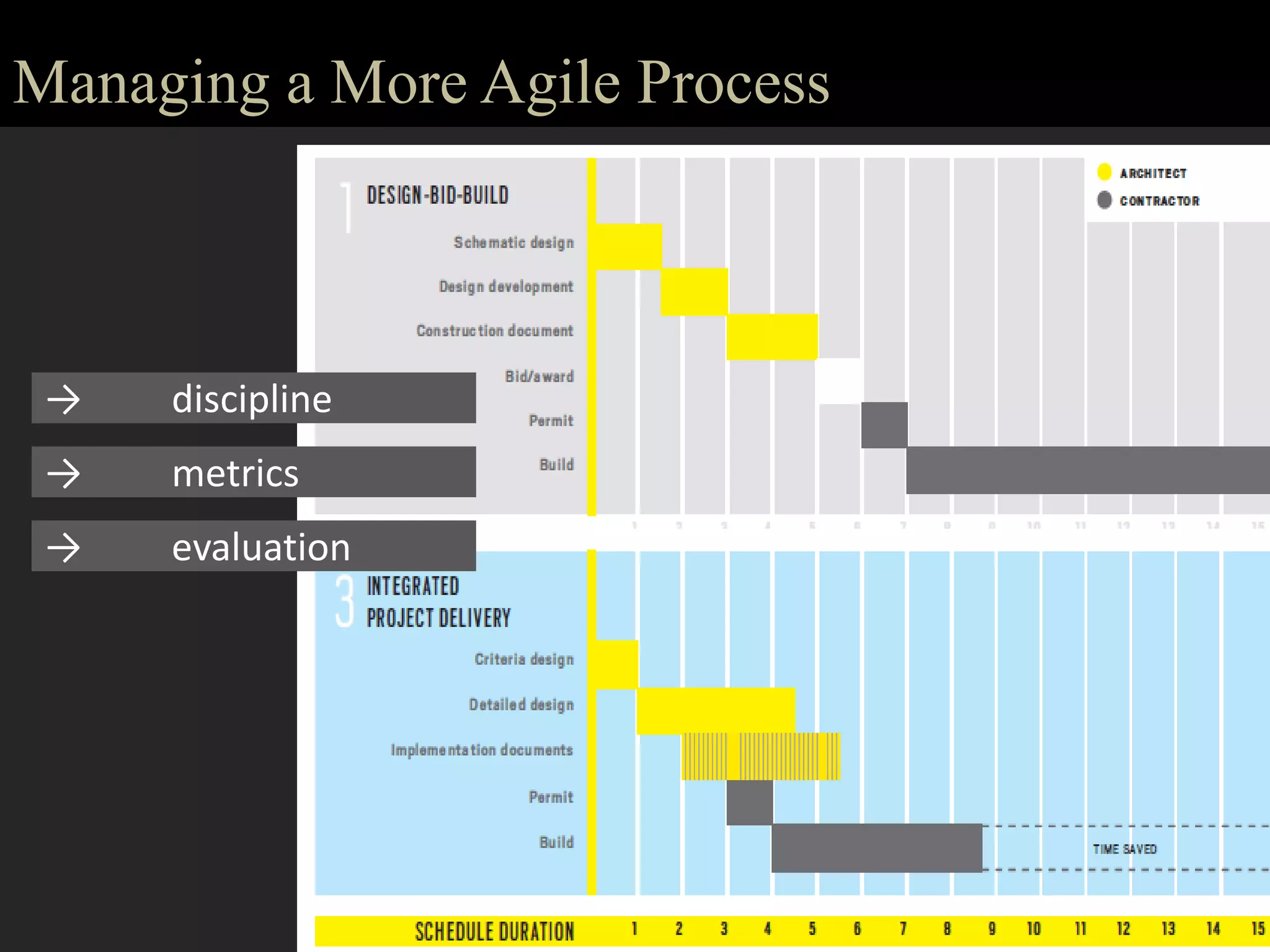

    Managing a MoreAgile Process-> discipline-> metrics-> evaluation1
  • 10.

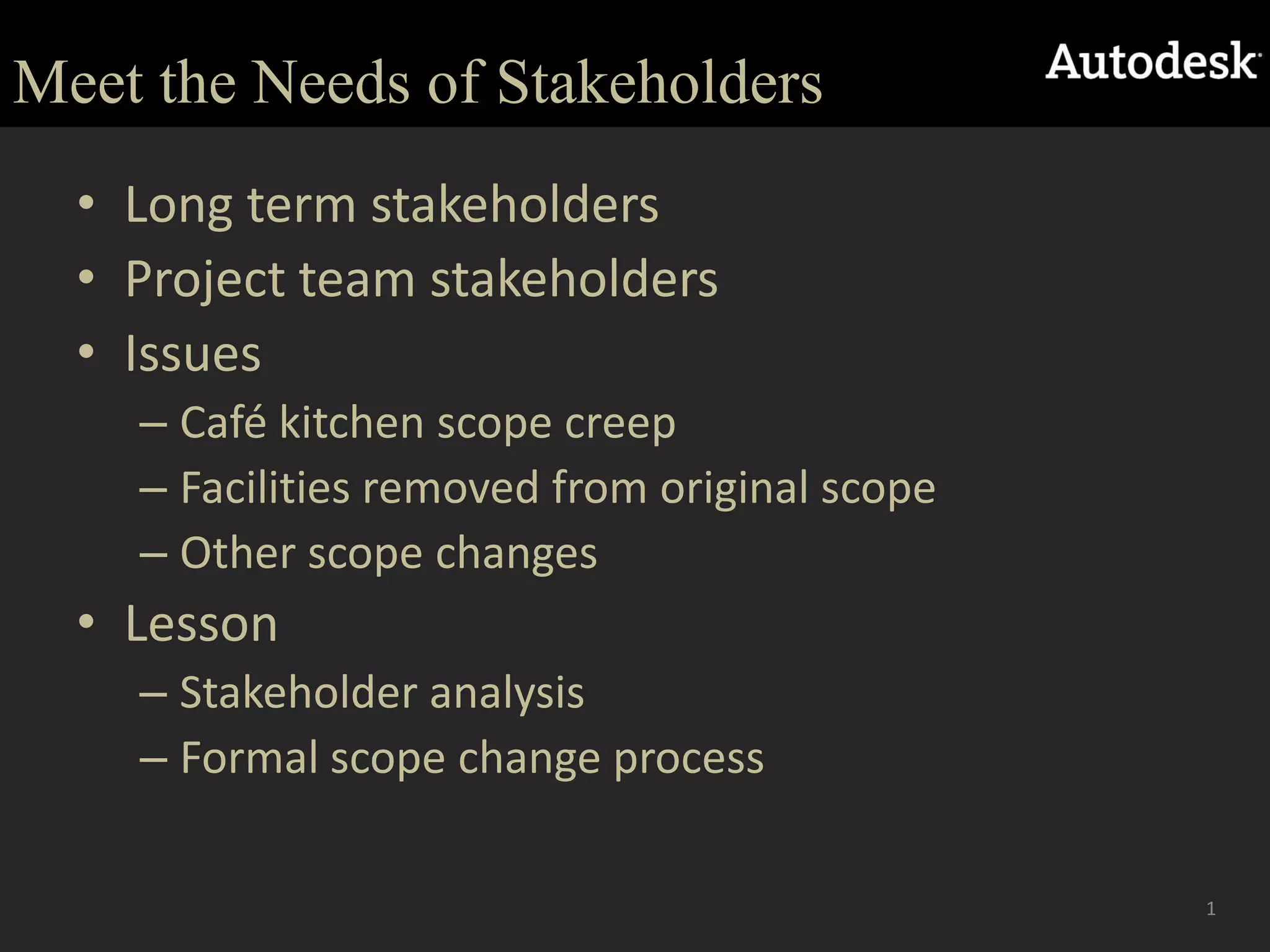

    Meet the Needsof StakeholdersLong term stakeholdersProject team stakeholdersIssuesCafé kitchen scope creepFacilities removed from original scopeOther scope changesLessonStakeholder analysisFormal scope change process1
  • 11.
    Meet the Needsof StakeholdersLong term stakeholdersProject team stakeholdersIssuesCafé kitchen scope creepFacilities removed from original scopeOther scope changesLessonStakeholder analysisFormal scope change process1
  • 12.
    Stakeholder SatisfactionTocci BuildingCompaniesKling Stubbins ArchitectsSubcontractorsAutodesk CorporateAutodesk MarketingBuilding OccupantsProject ChampionsMore ImportantLEED ConsultantVerizonAutodesk LegalFurniture VendorMoving CompanyFacilities Mgmt CompanyBuilding OwnerCity of WalthamAutodesk ITFood Service VendorWaltham ResidentsLess importantShort-term StakeholdersLong-term Stakeholders1
  • 13.
    Create Marketing MaterialsMarketing opportunity and public exposure
  • 14.
  • 15.
  • 16.
  • 17.
  • 18.
  • 19.
  • 20.
  • 21.
  • 22.
    Magnitude of therisks versus cost of risk mitigation1
  • 23.
  • 24.
    SourcesIntegrated Project Deliveryat Autodesk, Inc. (A), p. 8. Harvard Business School Case 9-610-016, 1 Mar 2010, Harvard Business School Press.Integrated Project Delivery at Autodesk, Inc. (C), p. 1. Harvard Business School Case 9-610-018, 24 Sept 2009, Harvard Business School Press.LaBarre, S. & Goldberg, J. (2009). IPD – The Tools. Metropolismag.com, Issue 11, page 50 .“Leadership in Energy and Environmental Design,” www.wikipedia.com, Accessed on 3 Dec 2010.Project Charter, Team Creative Collaborators1
