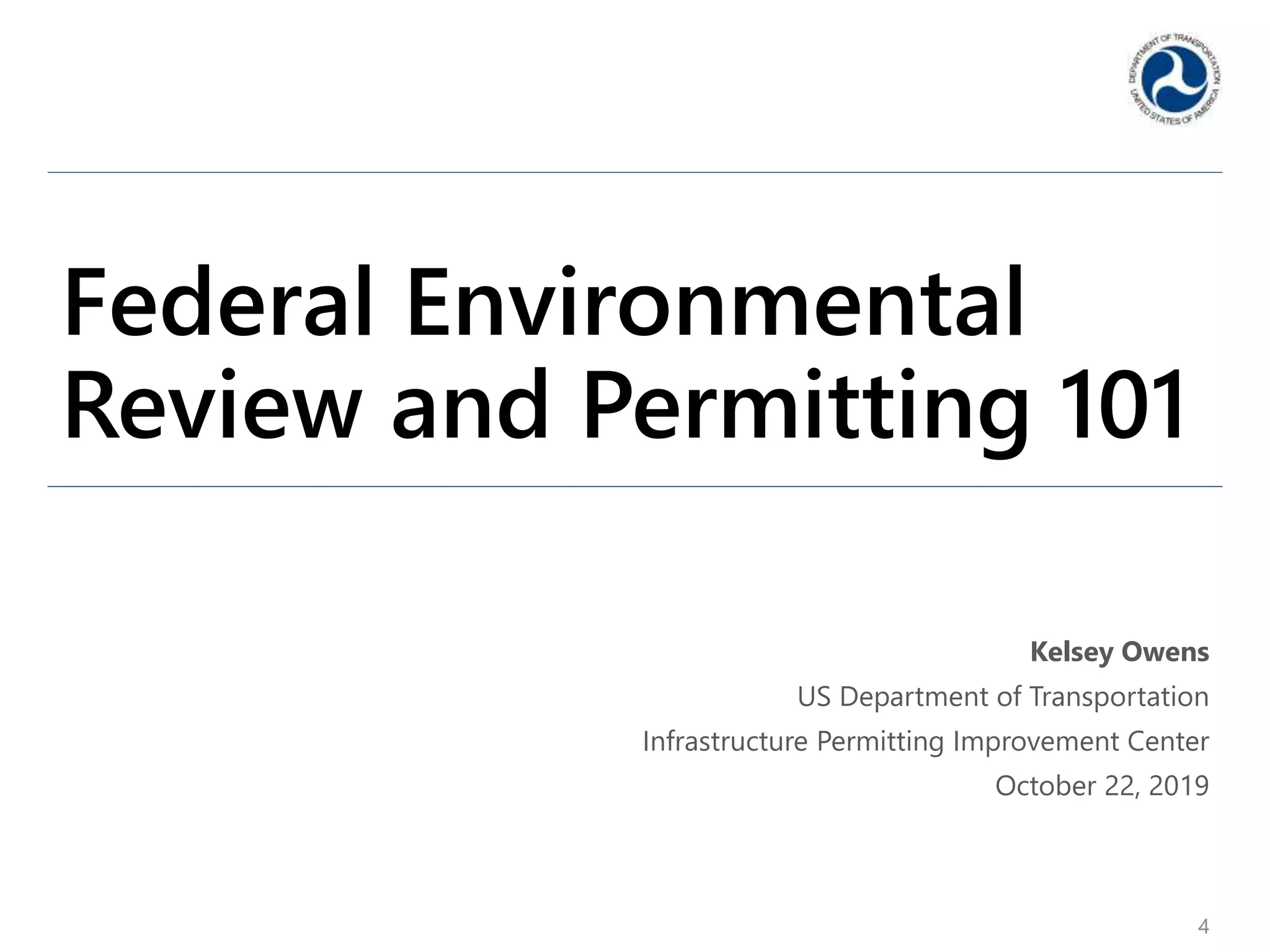

During the 2019 NADO Annual Training Conference (October 19 - 22 in Reno, NV), Kelsey Owens shares information on the basics of federal environmental reviews and permits required by the National Environmental Policy Act.
Everything You Need to Know About the 2019 DORA Accelerate State of DevOps Re...Red Gate Software
Each year, the DevOps Research and Assessment group (DORA) publishes critical research revealing the impact of DevOps on organizations of all sizes. The findings show what makes some teams successful at DevOps, while others fall behind.
Jez Humble, a founding member of DORA well known for his groundbreaking research on IT performance, and Redgate’s Microsoft MVP Steve Jones offer the latest insights from the 2019 Accelerate State of DevOps Report – and what they mean for your organization and career.
The document discusses using Terraform to automate deployment of resources in Oracle Cloud Infrastructure (OCI). It begins with an introduction to Terraform and its components like providers, modules, and backends. It then covers initial steps for setting up Terraform for OCI including installing Terraform, configuring the OCI provider, and running basic commands. The document outlines next steps like using Terraform to build small OCI infrastructures and combining configurations. It introduces using modules to define reusable infrastructure components. Finally, it provides an example of a Trivadis module for deploying a training lab environment on OCI.
Dataplane programming with eBPF: architecture and toolsStefano Salsano
eBPF is definitely a complex technology. Developing complex systems based on eBPF is challenging due to the intrinsic limitations of the model and the known shortcomings of the tool chain.
The learning curve of this technology is very steep and needs continuous coaching from experts. This tutorial will investigate:
What is eBPF and why it has gained a prominent position among the solutions to improve the packet processing performance in Linux/x86 nodes. We will shortly present some important use case scenarios for eBPF, like Kubernetes’ Cilium
The architecture of eBPF and its programming toolchain (e.g. bcc
What are the frameworks for eBPF programming, such as Polycube and InKeV.
How to make eBPF programming easier, more flexible and modular with HIKe/eCLAT
How to implement a custom application logic in eBPF with eCLAT using a python-like script
How to extend the framework and develop new modules
2016.11.30 energiforskyningssystemer ac 12 AC DC energi enerforskyningss...Sven Åge Eriksen
2016.11.30 energiforskyningssystemer ac 12 AC DC energi enerforskyningssystemer tn-systemer tt-systemer tn-s-c-systemer tn-s-systemer sammendrag sven åge eriksen fagskolen telemark Thomas edison nicola tesla
Presentation at 2019 ASHG GRC/GIAB workshop describing history of the human reference genome, current curation efforts and future plans, and the relationship of all 3 to efforts to produce a human pan-genome.
This document discusses XDP (eXpress Data Path), a high-performance network data path that allows programs to run on the receive path of a network interface card. XDP enables packet processing using eBPF programs before packets reach the Linux networking stack. The document provides an overview of XDP and its performance advantages over other packet processing methods. It also discusses XDP's current status and support in the Linux kernel as well as example use cases and benchmarks.
Kea DHCP – the new open source DHCP server from ISCMen and Mice
This webinar will highlight the differences between the old ISC DHCP and new Kea DHCP (database support, dynamic reconfiguration, performance wins, scripting hooks) and will showcase the Men & Mice Suite as a graphical front-end to both ISC DHCP and Kea to ease the migration.
Permitting Geothermal Exploration And Development Projects On Public And Trib...awaltner
1. The document discusses permitting requirements for geothermal exploration and development projects on public and tribal lands. It outlines the typical stages of a geothermal project and environmental impacts.
2. Key regulatory programs that may apply include the National Environmental Policy Act, the Endangered Species Act, the Clean Water Act, and regulations overseen by the Bureau of Land Management, Forest Service, and other agencies depending on the land ownership.
3. Special considerations apply for projects on federal, state, tribal, and private lands. The document provides strategies for navigating the complex permitting process such as preparing core environmental documents, integrating planning, and involving agencies early.
Everything You Need to Know About the 2019 DORA Accelerate State of DevOps Re...Red Gate Software
Each year, the DevOps Research and Assessment group (DORA) publishes critical research revealing the impact of DevOps on organizations of all sizes. The findings show what makes some teams successful at DevOps, while others fall behind.
Jez Humble, a founding member of DORA well known for his groundbreaking research on IT performance, and Redgate’s Microsoft MVP Steve Jones offer the latest insights from the 2019 Accelerate State of DevOps Report – and what they mean for your organization and career.
The document discusses using Terraform to automate deployment of resources in Oracle Cloud Infrastructure (OCI). It begins with an introduction to Terraform and its components like providers, modules, and backends. It then covers initial steps for setting up Terraform for OCI including installing Terraform, configuring the OCI provider, and running basic commands. The document outlines next steps like using Terraform to build small OCI infrastructures and combining configurations. It introduces using modules to define reusable infrastructure components. Finally, it provides an example of a Trivadis module for deploying a training lab environment on OCI.
Dataplane programming with eBPF: architecture and toolsStefano Salsano
eBPF is definitely a complex technology. Developing complex systems based on eBPF is challenging due to the intrinsic limitations of the model and the known shortcomings of the tool chain.
The learning curve of this technology is very steep and needs continuous coaching from experts. This tutorial will investigate:
What is eBPF and why it has gained a prominent position among the solutions to improve the packet processing performance in Linux/x86 nodes. We will shortly present some important use case scenarios for eBPF, like Kubernetes’ Cilium
The architecture of eBPF and its programming toolchain (e.g. bcc
What are the frameworks for eBPF programming, such as Polycube and InKeV.
How to make eBPF programming easier, more flexible and modular with HIKe/eCLAT
How to implement a custom application logic in eBPF with eCLAT using a python-like script
How to extend the framework and develop new modules
2016.11.30 energiforskyningssystemer ac 12 AC DC energi enerforskyningss...Sven Åge Eriksen
2016.11.30 energiforskyningssystemer ac 12 AC DC energi enerforskyningssystemer tn-systemer tt-systemer tn-s-c-systemer tn-s-systemer sammendrag sven åge eriksen fagskolen telemark Thomas edison nicola tesla
Presentation at 2019 ASHG GRC/GIAB workshop describing history of the human reference genome, current curation efforts and future plans, and the relationship of all 3 to efforts to produce a human pan-genome.
This document discusses XDP (eXpress Data Path), a high-performance network data path that allows programs to run on the receive path of a network interface card. XDP enables packet processing using eBPF programs before packets reach the Linux networking stack. The document provides an overview of XDP and its performance advantages over other packet processing methods. It also discusses XDP's current status and support in the Linux kernel as well as example use cases and benchmarks.
Kea DHCP – the new open source DHCP server from ISCMen and Mice
This webinar will highlight the differences between the old ISC DHCP and new Kea DHCP (database support, dynamic reconfiguration, performance wins, scripting hooks) and will showcase the Men & Mice Suite as a graphical front-end to both ISC DHCP and Kea to ease the migration.
Permitting Geothermal Exploration And Development Projects On Public And Trib...awaltner
1. The document discusses permitting requirements for geothermal exploration and development projects on public and tribal lands. It outlines the typical stages of a geothermal project and environmental impacts.
2. Key regulatory programs that may apply include the National Environmental Policy Act, the Endangered Species Act, the Clean Water Act, and regulations overseen by the Bureau of Land Management, Forest Service, and other agencies depending on the land ownership.
3. Special considerations apply for projects on federal, state, tribal, and private lands. The document provides strategies for navigating the complex permitting process such as preparing core environmental documents, integrating planning, and involving agencies early.
The document discusses environmental impact assessments (EIAs). It begins by defining an EIA as an assessment of the potential positive and negative environmental impacts of a proposed project. EIAs help decision-makers consider environmental factors. The main steps in an EIA process are screening, scoping, prediction and mitigation, management and monitoring, and auditing. EIAs began in the 1960s and were formalized in legislation like the US's NEPA in 1969. EIAs have positive externalities like job creation but also negative externalities such as environmental and social impacts. The document outlines India's key EIA laws and notes that EIAs facilitate informed decision-making by providing a structured analysis of project consequences.
The document discusses environmental impact assessments (EIAs). It notes that EIAs identify, predict, and mitigate potential environmental effects of development projects. The main steps in an EIA are screening, scoping, prediction and mitigation, management and monitoring, and auditing. EIAs began in the 1960s and were codified in legislation like the US's NEPA in 1969. The document outlines the EIA process and data requirements, discusses positive and negative externalities of EIAs, and notes their benefits like informed decision making and mitigation of environmental impacts.
The document discusses environmental impact assessments (EIA) in Malaysia. It describes the purpose and legal requirements of EIAs, which were introduced in 1987 to identify and mitigate environmental impacts of development projects. The key aspects of the EIA process in Malaysia are:
1) Projects are screened to determine if an EIA is required based on their potential environmental impacts.
2) The scoping process identifies which issues and impacts the EIA will address.
3) EIAs involve assessing alternatives, environmental baselines, impacts, and mitigation measures.
4) Completed EIA reports are submitted for review and must include opportunities for public consultation.
Developing Guidelines for Public Participation on Environmental Impact Assess...Ethical Sector
On 24 February 2016, MCRB and PACT MPE (Mekong Partnership for Environment) co-organised a discussion in Yangon of public participation in EIA with the objectives of sharing experience which could be used to guide development of regional guidelines on public participation in EIA for the Mekong region (Cambodia, Laos, Myanmar, Thailand, and Vietnam) as well as planned public participation guidelines for the implementation of Myanmar’s new EIA procedures.
U Than Aye, (Yangon office of ECD, MOECAF) gave a presentation on the public participation provisions of the Myanmar government’s EIA Procedures which were adopted on 29 December 2015, highlighting the requirements for consultation and disclosure at different stages of the EIA and Initial Environmental Examination (IEE) processes; and the resource constraints and faced by MOECAF.
National Environmental Policy Act (NEPA) Writing Environmental Assessments (...rshimoda2014
Clough, Helen - Department of the Interior, U.S. Fish and Wildlife Service, retired
Judith Kurtzman - Utah State University
Writing clear Environmental Assessments (EAs) as required by the National Environmental Policy Act (NEPA) is critical to successful implementation of the law and more importantly good decisions. The NEPA process must be well documented in clear language so that the proposals, alternatives and the environmental effects of proposals and alternatives are clearing explained. Often the NEPA analysis is not well documented resulting in costly delays in projects as appeals and litigation occur regarding the NEPA analysis. This training will focus on how to properly document the NEPA analysis for EAs with emphasis and examples relevant to rivers and river management.
This first part of the 3-part training will review NEPA and the types of NEPA documentation. The session will focus on scoping, public involvement, and defining the purpose and need for action. The session will include exercises and review of relevant documents. Ample time is allotted for discussion and questions from participants. The session will be followed up by Parts 2 and 3 covering the rest of the EA process.
EOR Webinar PAS presentation slidesFINAL.pptxPAS_Team
The document discusses a consultation webinar held by the Planning Advisory Service on environmental outcome reports. It provides an overview of the Planning Advisory Service and their work supporting local planning authorities. It then summarizes the webinar which included presentations on the government's plans for introducing environmental outcome reports to replace current environmental assessment processes, and experiences from Surrey County Council and Hampshire County Council conducting environmental monitoring.
Watershed Planning and Advisory Councils (WPACs) are at various stages of creating and implementing water and watershed management plans. There are numerous questions about how implementation of watershed plans is best achieved and what policies may be useful for meeting plan outcomes.
On October 27th Jason Unger, Staff Counsel at the Environmental Law Centre, presented information on how other jurisdictions have approached implementation and discussed some key aspects of the Alberta approach.
National Environmental Policy Act (NEPA) Writing Environmental Assessments (...rshimoda2014
Helen Clough - Department of the Interior, U.S. Fish and Wildlife Service, retired, Judith Kurtzman - Utah State University
Writing clear Environmental Assessments (EAs) as required by the National Environmental Policy Act (NEPA) is critical to successful implementation of the law and more importantly good decisions. The NEPA process must be well documented in clear language so that the proposals, alternatives and the environmental effects of proposals and alternatives are clearing explained. Often the NEPA analysis is not well documented resulting in costly delays in projects as appeals and litigation occur regarding the NEPA analysis.
This training session is a continuation of the materials presented in Writing Environmental Assessments, Parts 1 and 2. Resource-specific analysis (for examples, effects on wildlife, effects on recreation, effects on water quality) and cumulative impact analysis (effects of past, present, and “reasonably foreseeable” future actions) will be explored. Mitigation and monitoring will be addressed. As with the other NEPA sessions examples relevant to river management will be explored and critiqued. Ample time is allotted for discussion and questions from participants.
The document outlines the environmental analysis process that is required by the National Environmental Policy Act (NEPA) for projects funded by the United States Agency for International Development (USAID). The 8-step process includes: 1) identifying the proposed action, 2) scoping potential issues and effects, 3) collecting data on factors that will be considered, 4) designing alternatives, 5) evaluating the effects of each alternative, 6) comparing the alternatives, 7) making a decision and getting public review, and 8) implementing and monitoring the chosen alternative. USAID developed procedures in 1975 to comply with NEPA, requiring identification and mitigation of environmental impacts before funding decisions are made.
The document provides an overview of environmental impact assessments (EIA). It defines EIA and lists its guiding principles, including early application, participation, consideration of alternatives, and transparency. The document also outlines the benefits of EIA, including more sustainable design and compliance. It discusses the roles and responsibilities of various bodies involved in EIA, such as the proponent, consultant, interested parties, and competent agency. Finally, it examines the nature and scope of environmental impact issues that may be considered in an EIA.
Beige and Brown Aesthetic Group Project Presentation_20230920_011228_0000.pdfHajiraThabasum
The document provides an overview of environmental impact assessment (EIA) in India. It describes EIA as a study conducted before undertaking a project to ensure it will not harm the environment. The key stages of EIA are screening, scoping, impact assessment, mitigation, reporting, reviewing, decision making, and post-monitoring. EIA aims to identify, assess, minimize, and mitigate environmental impacts to promote sustainable development. The EIA notification process in India typically takes 210 days to complete.
Assessing proposed project development under EIAKisesa Hamis
This document outlines the key steps in the environmental impact assessment (EIA) process in Tanzania. It discusses the project registration, screening, scoping, terms of reference development, undertaking the EIA study, producing an environmental impact statement, review of the EIA, environmental management and monitoring, auditing, and decision making. The goal of the EIA process is to evaluate potential environmental impacts of proposed projects and identify mitigation measures to reduce negative impacts. The process involves multiple stakeholders and assesses projects at local, national, and international levels to determine what level of assessment is required.
This document summarizes discussions from a November 2022 workshop on the UK's strengthened biodiversity duty and new reporting requirements. It provides an overview of the key aspects of the strengthened duty and upcoming biodiversity reports that local authorities must publish. It then outlines the agenda and discussion questions that were used to get feedback from workshop participants on the draft guidance and reporting template. The document closes by anonymously polling participants on how much effort and impact they believe their local councils will make in complying with the new biodiversity requirements.
Philippine Envaironmental Impact System System. This my presentation in one of my subject Mining 103.. i tried my best just to finish this.. although this report did not cover all the sections in the PEISS.
Environmental Impact Assessment and Environmental Audit- Unit IIIGAURAV. H .TANDON
This document provides an overview of environmental impact assessments and environmental audits. It defines environmental impact assessment as the systematic identification and evaluation of potential impacts of proposed projects on the natural environment. The key steps of an EIA include organizing an interdisciplinary team, performing an assessment of the site and potential impacts, writing an environmental impact statement, and reviewing the EIS. Environmental audits evaluate an organization's environmental performance and position and identify ways to improve environmental management systems. The document outlines the basic components and steps in conducting environmental audits.
Environmental Clearance and Its Regulations and Procedures.pdfJagriti Agarwal
The specific requirements for environmental clearance vary depending on the country and the type of project, but typically involve the submission of an environmental impact assessment (EIA) that outlines the proposed project and its potential impacts.
This document outlines a new approach for counties in Oregon to complete National Environmental Policy Act (NEPA) requirements for transportation projects with assistance from the Oregon Department of Transportation (ODOT). Key points include:
- ODOT will contract qualified consultants to perform NEPA work and studies for county projects and pay associated costs.
- The county will be involved in setting milestones and approving the NEPA document. Signing the document makes the county eligible for federal funding.
- A complete initial project checklist and footprint are required for the consultant selection and NEPA process to begin. The consultant will coordinate directly with the county throughout the NEPA process.
ENVIRONMENTAL IMPACT ASSESSMENT final na.docxMarskyUbia
predict the environmental consequences of human development activities and to plan appropriate measures to eliminate or reduce adverse effects and to augment positive effects.
Even though the mid-term elections are in the rearview and the 2024 elections already in motion, Congress has a full agenda over the coming months. During this session, learn about the latest development impacting the federal agencies that you work with on a daily basis.
Plenary - Stars of the Southwest: Lifting Regional Economiesnado-web
Each year, the SWREDA Board of Directors selects five Star of the Southwest Awardees—one from each state—to showcase their positive impact on a community’s or region’s economic vitality. Learn about the projects, including funding, partnerships, impact, and future plans during this session.
More Related Content
Similar to NEPA and Permitting 101: A Dialogue on the Basics
The document discusses environmental impact assessments (EIAs). It begins by defining an EIA as an assessment of the potential positive and negative environmental impacts of a proposed project. EIAs help decision-makers consider environmental factors. The main steps in an EIA process are screening, scoping, prediction and mitigation, management and monitoring, and auditing. EIAs began in the 1960s and were formalized in legislation like the US's NEPA in 1969. EIAs have positive externalities like job creation but also negative externalities such as environmental and social impacts. The document outlines India's key EIA laws and notes that EIAs facilitate informed decision-making by providing a structured analysis of project consequences.
The document discusses environmental impact assessments (EIAs). It notes that EIAs identify, predict, and mitigate potential environmental effects of development projects. The main steps in an EIA are screening, scoping, prediction and mitigation, management and monitoring, and auditing. EIAs began in the 1960s and were codified in legislation like the US's NEPA in 1969. The document outlines the EIA process and data requirements, discusses positive and negative externalities of EIAs, and notes their benefits like informed decision making and mitigation of environmental impacts.
The document discusses environmental impact assessments (EIA) in Malaysia. It describes the purpose and legal requirements of EIAs, which were introduced in 1987 to identify and mitigate environmental impacts of development projects. The key aspects of the EIA process in Malaysia are:
1) Projects are screened to determine if an EIA is required based on their potential environmental impacts.
2) The scoping process identifies which issues and impacts the EIA will address.
3) EIAs involve assessing alternatives, environmental baselines, impacts, and mitigation measures.
4) Completed EIA reports are submitted for review and must include opportunities for public consultation.
Developing Guidelines for Public Participation on Environmental Impact Assess...Ethical Sector
On 24 February 2016, MCRB and PACT MPE (Mekong Partnership for Environment) co-organised a discussion in Yangon of public participation in EIA with the objectives of sharing experience which could be used to guide development of regional guidelines on public participation in EIA for the Mekong region (Cambodia, Laos, Myanmar, Thailand, and Vietnam) as well as planned public participation guidelines for the implementation of Myanmar’s new EIA procedures.
U Than Aye, (Yangon office of ECD, MOECAF) gave a presentation on the public participation provisions of the Myanmar government’s EIA Procedures which were adopted on 29 December 2015, highlighting the requirements for consultation and disclosure at different stages of the EIA and Initial Environmental Examination (IEE) processes; and the resource constraints and faced by MOECAF.
National Environmental Policy Act (NEPA) Writing Environmental Assessments (...rshimoda2014
Clough, Helen - Department of the Interior, U.S. Fish and Wildlife Service, retired
Judith Kurtzman - Utah State University
Writing clear Environmental Assessments (EAs) as required by the National Environmental Policy Act (NEPA) is critical to successful implementation of the law and more importantly good decisions. The NEPA process must be well documented in clear language so that the proposals, alternatives and the environmental effects of proposals and alternatives are clearing explained. Often the NEPA analysis is not well documented resulting in costly delays in projects as appeals and litigation occur regarding the NEPA analysis. This training will focus on how to properly document the NEPA analysis for EAs with emphasis and examples relevant to rivers and river management.
This first part of the 3-part training will review NEPA and the types of NEPA documentation. The session will focus on scoping, public involvement, and defining the purpose and need for action. The session will include exercises and review of relevant documents. Ample time is allotted for discussion and questions from participants. The session will be followed up by Parts 2 and 3 covering the rest of the EA process.
EOR Webinar PAS presentation slidesFINAL.pptxPAS_Team
The document discusses a consultation webinar held by the Planning Advisory Service on environmental outcome reports. It provides an overview of the Planning Advisory Service and their work supporting local planning authorities. It then summarizes the webinar which included presentations on the government's plans for introducing environmental outcome reports to replace current environmental assessment processes, and experiences from Surrey County Council and Hampshire County Council conducting environmental monitoring.
Watershed Planning and Advisory Councils (WPACs) are at various stages of creating and implementing water and watershed management plans. There are numerous questions about how implementation of watershed plans is best achieved and what policies may be useful for meeting plan outcomes.
On October 27th Jason Unger, Staff Counsel at the Environmental Law Centre, presented information on how other jurisdictions have approached implementation and discussed some key aspects of the Alberta approach.
National Environmental Policy Act (NEPA) Writing Environmental Assessments (...rshimoda2014
Helen Clough - Department of the Interior, U.S. Fish and Wildlife Service, retired, Judith Kurtzman - Utah State University
Writing clear Environmental Assessments (EAs) as required by the National Environmental Policy Act (NEPA) is critical to successful implementation of the law and more importantly good decisions. The NEPA process must be well documented in clear language so that the proposals, alternatives and the environmental effects of proposals and alternatives are clearing explained. Often the NEPA analysis is not well documented resulting in costly delays in projects as appeals and litigation occur regarding the NEPA analysis.
This training session is a continuation of the materials presented in Writing Environmental Assessments, Parts 1 and 2. Resource-specific analysis (for examples, effects on wildlife, effects on recreation, effects on water quality) and cumulative impact analysis (effects of past, present, and “reasonably foreseeable” future actions) will be explored. Mitigation and monitoring will be addressed. As with the other NEPA sessions examples relevant to river management will be explored and critiqued. Ample time is allotted for discussion and questions from participants.
The document outlines the environmental analysis process that is required by the National Environmental Policy Act (NEPA) for projects funded by the United States Agency for International Development (USAID). The 8-step process includes: 1) identifying the proposed action, 2) scoping potential issues and effects, 3) collecting data on factors that will be considered, 4) designing alternatives, 5) evaluating the effects of each alternative, 6) comparing the alternatives, 7) making a decision and getting public review, and 8) implementing and monitoring the chosen alternative. USAID developed procedures in 1975 to comply with NEPA, requiring identification and mitigation of environmental impacts before funding decisions are made.
The document provides an overview of environmental impact assessments (EIA). It defines EIA and lists its guiding principles, including early application, participation, consideration of alternatives, and transparency. The document also outlines the benefits of EIA, including more sustainable design and compliance. It discusses the roles and responsibilities of various bodies involved in EIA, such as the proponent, consultant, interested parties, and competent agency. Finally, it examines the nature and scope of environmental impact issues that may be considered in an EIA.
Beige and Brown Aesthetic Group Project Presentation_20230920_011228_0000.pdfHajiraThabasum
The document provides an overview of environmental impact assessment (EIA) in India. It describes EIA as a study conducted before undertaking a project to ensure it will not harm the environment. The key stages of EIA are screening, scoping, impact assessment, mitigation, reporting, reviewing, decision making, and post-monitoring. EIA aims to identify, assess, minimize, and mitigate environmental impacts to promote sustainable development. The EIA notification process in India typically takes 210 days to complete.
Assessing proposed project development under EIAKisesa Hamis
This document outlines the key steps in the environmental impact assessment (EIA) process in Tanzania. It discusses the project registration, screening, scoping, terms of reference development, undertaking the EIA study, producing an environmental impact statement, review of the EIA, environmental management and monitoring, auditing, and decision making. The goal of the EIA process is to evaluate potential environmental impacts of proposed projects and identify mitigation measures to reduce negative impacts. The process involves multiple stakeholders and assesses projects at local, national, and international levels to determine what level of assessment is required.
This document summarizes discussions from a November 2022 workshop on the UK's strengthened biodiversity duty and new reporting requirements. It provides an overview of the key aspects of the strengthened duty and upcoming biodiversity reports that local authorities must publish. It then outlines the agenda and discussion questions that were used to get feedback from workshop participants on the draft guidance and reporting template. The document closes by anonymously polling participants on how much effort and impact they believe their local councils will make in complying with the new biodiversity requirements.
Philippine Envaironmental Impact System System. This my presentation in one of my subject Mining 103.. i tried my best just to finish this.. although this report did not cover all the sections in the PEISS.
Environmental Impact Assessment and Environmental Audit- Unit IIIGAURAV. H .TANDON
This document provides an overview of environmental impact assessments and environmental audits. It defines environmental impact assessment as the systematic identification and evaluation of potential impacts of proposed projects on the natural environment. The key steps of an EIA include organizing an interdisciplinary team, performing an assessment of the site and potential impacts, writing an environmental impact statement, and reviewing the EIS. Environmental audits evaluate an organization's environmental performance and position and identify ways to improve environmental management systems. The document outlines the basic components and steps in conducting environmental audits.
Environmental Clearance and Its Regulations and Procedures.pdfJagriti Agarwal
The specific requirements for environmental clearance vary depending on the country and the type of project, but typically involve the submission of an environmental impact assessment (EIA) that outlines the proposed project and its potential impacts.
This document outlines a new approach for counties in Oregon to complete National Environmental Policy Act (NEPA) requirements for transportation projects with assistance from the Oregon Department of Transportation (ODOT). Key points include:
- ODOT will contract qualified consultants to perform NEPA work and studies for county projects and pay associated costs.
- The county will be involved in setting milestones and approving the NEPA document. Signing the document makes the county eligible for federal funding.
- A complete initial project checklist and footprint are required for the consultant selection and NEPA process to begin. The consultant will coordinate directly with the county throughout the NEPA process.
ENVIRONMENTAL IMPACT ASSESSMENT final na.docxMarskyUbia
predict the environmental consequences of human development activities and to plan appropriate measures to eliminate or reduce adverse effects and to augment positive effects.
Similar to NEPA and Permitting 101: A Dialogue on the Basics (20)
Even though the mid-term elections are in the rearview and the 2024 elections already in motion, Congress has a full agenda over the coming months. During this session, learn about the latest development impacting the federal agencies that you work with on a daily basis.
Plenary - Stars of the Southwest: Lifting Regional Economiesnado-web
Each year, the SWREDA Board of Directors selects five Star of the Southwest Awardees—one from each state—to showcase their positive impact on a community’s or region’s economic vitality. Learn about the projects, including funding, partnerships, impact, and future plans during this session.
Southwest New Mexico is home to many outdoor recreation opportunities. The region features scenic desert landscapes, mountains, rivers and trails ideal for hiking, camping, mountain biking and other activities. Local organizations work to promote and enhance recreation in the area to support tourism and economic development.
Affordable and Accessible Housing: Imperative for Strong Economies nado-web
Accessible and affordable housing for existing and prospective workforce housing is a challenge nationwide. Lack of housing presents challenges to communities and regions that are hoping to attract new businesses and industries, not to mention meeting the needs of current residents. During this session you will learn about successful approaches to creating housing opportunities from across the Austin region.
This document summarizes Errin Clocker's role as Executive Director of the Grand Gateway EDA and discusses their partnerships with 11 local Native American tribes. It notes that approximately 20% of the EDA's service area population is tribal members and lists ways the EDA encourages tribal investment and participation, including having tribal representatives on decision-making boards. Specific tribal partnerships are discussed in the areas of transit, aging services, and community and economic development projects.
Digital equity means that everyone has affordable access to fast internet connections on a personal device and home network, as well as the digital skills to fully participate online. Louisiana is committed to eliminating the digital divide by 2029 through its Broadband for Everyone in Louisiana executive order. The digital divide disproportionately affects people of color, indigenous people, low-income households, those with disabilities, rural residents, and the elderly as they have less access, skills, and support to engage online. Expanding broadband connectivity is critical infrastructure for economic growth as 21% of Louisiana households lack broadband subscriptions, 12% of schoolchildren are unconnected, and 31% of adults lack needed digital skills.
West Texas Aerospace and Defense Manufacturing Coalitionnado-web
West Texas Aerospace and Defense Manufacturing Coalition: Susannah Byrd, Director, Economic Development and Workforce Excellence Division, University of Texas at El Paso, El Paso, TX
Tulsa Regional Advanced Mobility (TRAM) Corridor: Jennifer Hankins, Chief of Strategic Partnerships, Tulsa Innovation Labs, Indian Nations Council of Governments, Tulsa, OK
Northern New Mexico Workforce Integration Network (WIN)nado-web
Northern New Mexico Workforce Integration Network (WIN): Monica Abeita, Executive Director, North Central New Mexico Economic Development District, Santa Fe, NM
Maggie Belanger, Assistant Director and Technical Assistance to Brownfields Regional Manager, Kansas State University, KS
Kate Lucas, AICP, Planner, Adaapta and KSU TAB Partner, Denver, CO
Christina Wilson, Acting Branch Manager, US Environmental Protection Agency, Region 8, Denver, CO
Scott Hobson, Acting Director of Planning and Community Development, City of Pueblo, CO
The document summarizes a University Center Showcase presented by Jeff Tucker from Kansas State University's Technology Development Institute (TDI). The TDI focuses on accelerating innovation for small and medium enterprises through technology development assistance, supporting commercialization and business expansion. It has received funding from the Economic Development Administration to upgrade equipment for fabrication, machining and additive manufacturing. The TDI has also developed a microfactory program and provides internships in technology entrepreneurship to cultivate innovation ecosystems.
University of Montana Rural Innovation Initiativenado-web
This document provides information about the geographical isolation of Montana and programs offered by the Accelerate Montana Rural Innovation Initiative (AMRII) to support rural entrepreneurs and startups. It notes that some of Montana's major cities are hours apart and outlines AMRII's programs including rural pitch events, legal office hours, and resources on topics like lean startup tools, marketing, and website creation. It also mentions AMRII is conducting a capital scan and working with the Bureau of Business and Economic Research to study capital access and flow within Montana. Contact information is provided to learn more about AMRII.
CIRAS has managed an EDA University Center at Iowa State University continuously since 1980 to provide technical services and support economic development in Iowa. Brenda Martin is the Workforce Programs Director who can be contacted via email or phone to discuss CIRAS' workforce strategies program for 2018-2023, which aims to improve business profitability through applied research, education, and technical assistance. Over a five year period, CIRAS has helped generate $2.8 billion in results for its clients.
The Power of Community Newsletters: A Case Study from Wolverton and Greenleys...Scribe
YOU WILL DISCOVER:
The engaging history and evolution of Wolverton and Greenleys Town Council's newsletter
Strategies for producing a successful community newsletter and generating income through advertising
The decision-making process behind moving newsletter design from in-house to outsourcing and its impacts
Dive into the success story of Wolverton and Greenleys Town Council's newsletter in this insightful webinar. Hear from Mandy Shipp and Jemma English about the newsletter's journey from its inception to becoming a vital part of their community's communication, including its history, production process, and revenue generation through advertising. Discover the reasons behind outsourcing its design and the benefits this brought. Ideal for anyone involved in community engagement or interested in starting their own newsletter.
How To Cultivate Community Affinity Throughout The Generosity JourneyAggregage
This session will dive into how to create rich generosity experiences that foster long-lasting relationships. You’ll walk away with actionable insights to redefine how you engage with your supporters — emphasizing trust, engagement, and community!
Jennifer Schaus and Associates hosts a complimentary webinar series on The FAR in 2024. Join the webinars on Wednesdays and Fridays at noon, eastern.
Recordings are on YouTube and the company website.
https://www.youtube.com/@jenniferschaus/videos
Presentation by Julie Topoleski, CBO’s Director of Labor, Income Security, and Long-Term Analysis, at the 16th Annual Meeting of the OECD Working Party of Parliamentary Budget Officials and Independent Fiscal Institutions.
Indira awas yojana housing scheme renamed as PMAYnarinav14
Indira Awas Yojana (IAY) played a significant role in addressing rural housing needs in India. It emerged as a comprehensive program for affordable housing solutions in rural areas, predating the government’s broader focus on mass housing initiatives.
karnataka housing board schemes . all schemesnarinav14
The Karnataka government, along with the central government’s Pradhan Mantri Awas Yojana (PMAY), offers various housing schemes to cater to the diverse needs of citizens across the state. This article provides a comprehensive overview of the major housing schemes available in the Karnataka housing board for both urban and rural areas in 2024.
1. Office of the Secretary of Transportation
Infrastructure Permitting Improvement Center
Kelsey Owens
US Department of Transportation
Infrastructure Permitting Improvement Center
October 22, 2019
1
2. Infrastructure Permitting
Improvement Center (IPIC)
• IPIC sits within the Office of the Secretary of
Transportation’s Office of Policy Development, Strategic
Planning, and Performance.
• IPIC is responsible for
• Improving performance of DOT’s Federal environmental review
and permitting of infrastructure projects,
• Serving as the central resource for streamlining delivery of all
DOT projects,
• Advancing methods that facilitate efficient environmental review
and approval of projects, and
• Promoting the use of best practices across DOT to improve
consistency and effectiveness in all phases of project delivery.
2

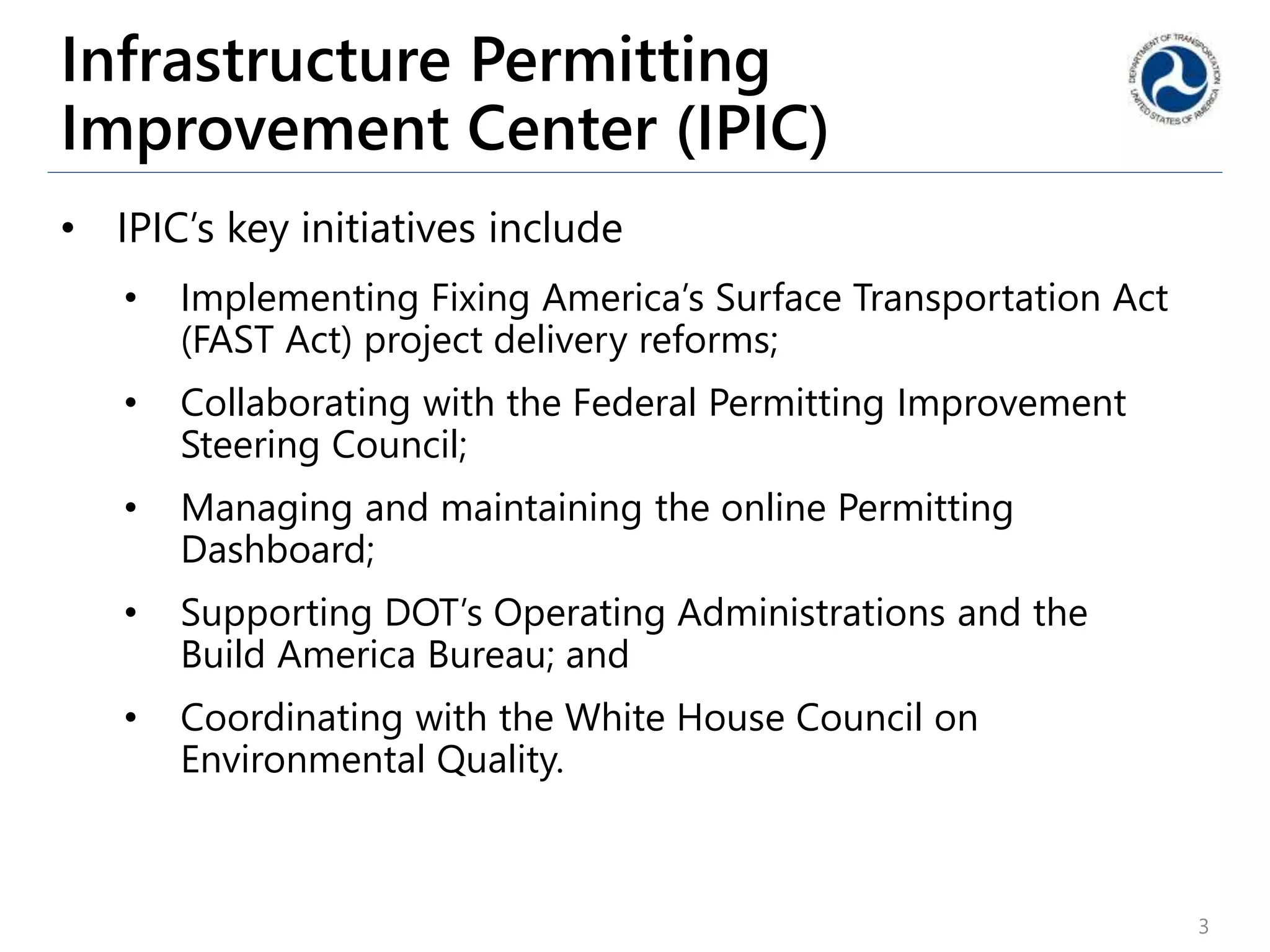

3. Infrastructure Permitting
Improvement Center (IPIC)
• IPIC’s key initiatives include
• Implementing Fixing America’s Surface Transportation Act
(FAST Act) project delivery reforms;
• Collaborating with the Federal Permitting Improvement
Steering Council;
• Managing and maintaining the online Permitting
Dashboard;
• Supporting DOT’s Operating Administrations and the
Build America Bureau; and
• Coordinating with the White House Council on
Environmental Quality.
3
4. Federal Environmental
Review and Permitting 101
Kelsey Owens
US Department of Transportation
Infrastructure Permitting Improvement Center
October 22, 2019
4

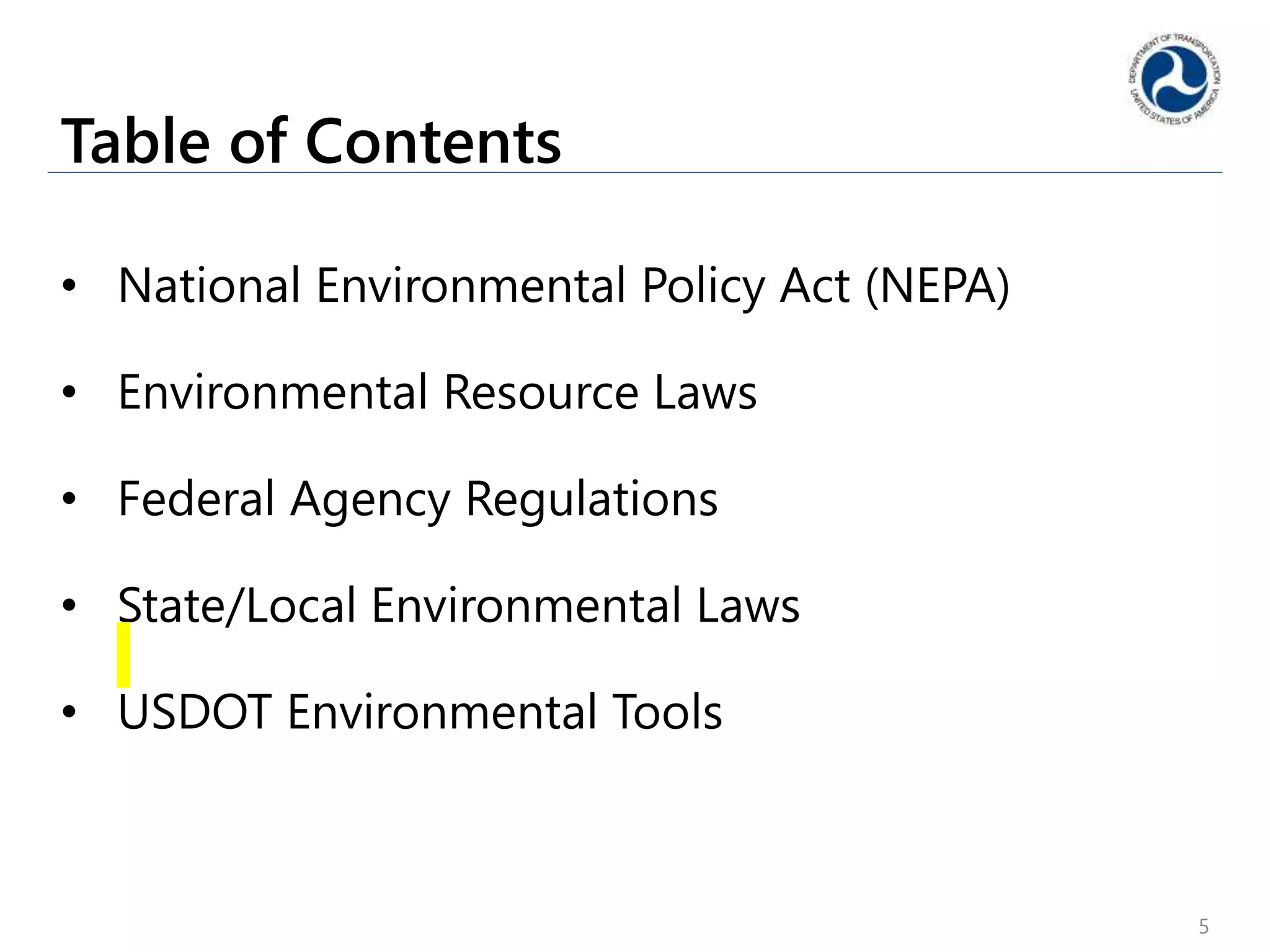

5. Table of Contents
• National Environmental Policy Act (NEPA)
• Environmental Resource Laws
• Federal Agency Regulations
• State/Local Environmental Laws
• USDOT Environmental Tools
5

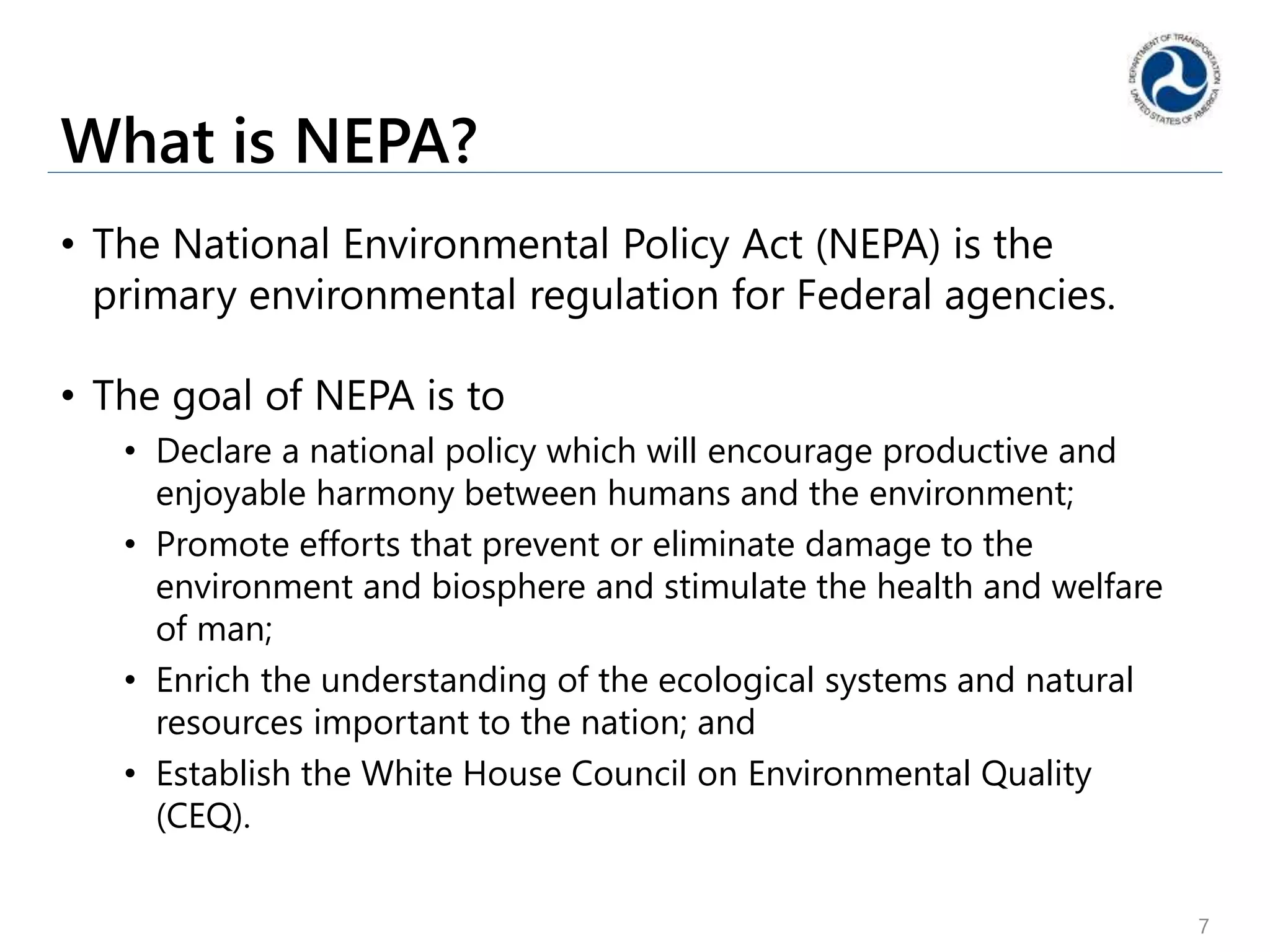

7. What is NEPA?
• The National Environmental Policy Act (NEPA) is the
primary environmental regulation for Federal agencies.
• The goal of NEPA is to
• Declare a national policy which will encourage productive and
enjoyable harmony between humans and the environment;
• Promote efforts that prevent or eliminate damage to the
environment and biosphere and stimulate the health and welfare
of man;
• Enrich the understanding of the ecological systems and natural
resources important to the nation; and
• Establish the White House Council on Environmental Quality
(CEQ).
7

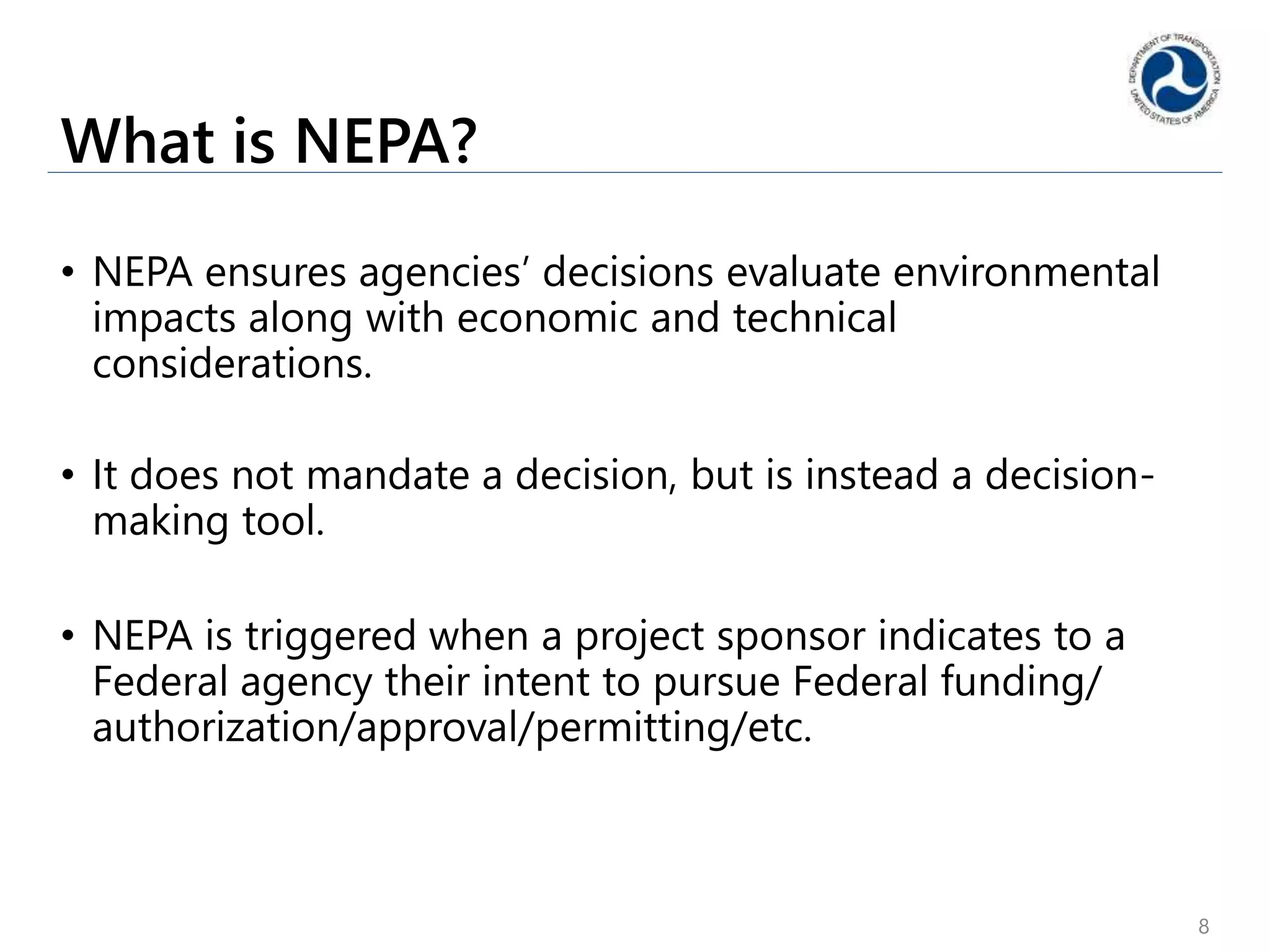

8. What is NEPA?
• NEPA ensures agencies’ decisions evaluate environmental
impacts along with economic and technical
considerations.
• It does not mandate a decision, but is instead a decision-
making tool.
• NEPA is triggered when a project sponsor indicates to a
Federal agency their intent to pursue Federal funding/
authorization/approval/permitting/etc.
8

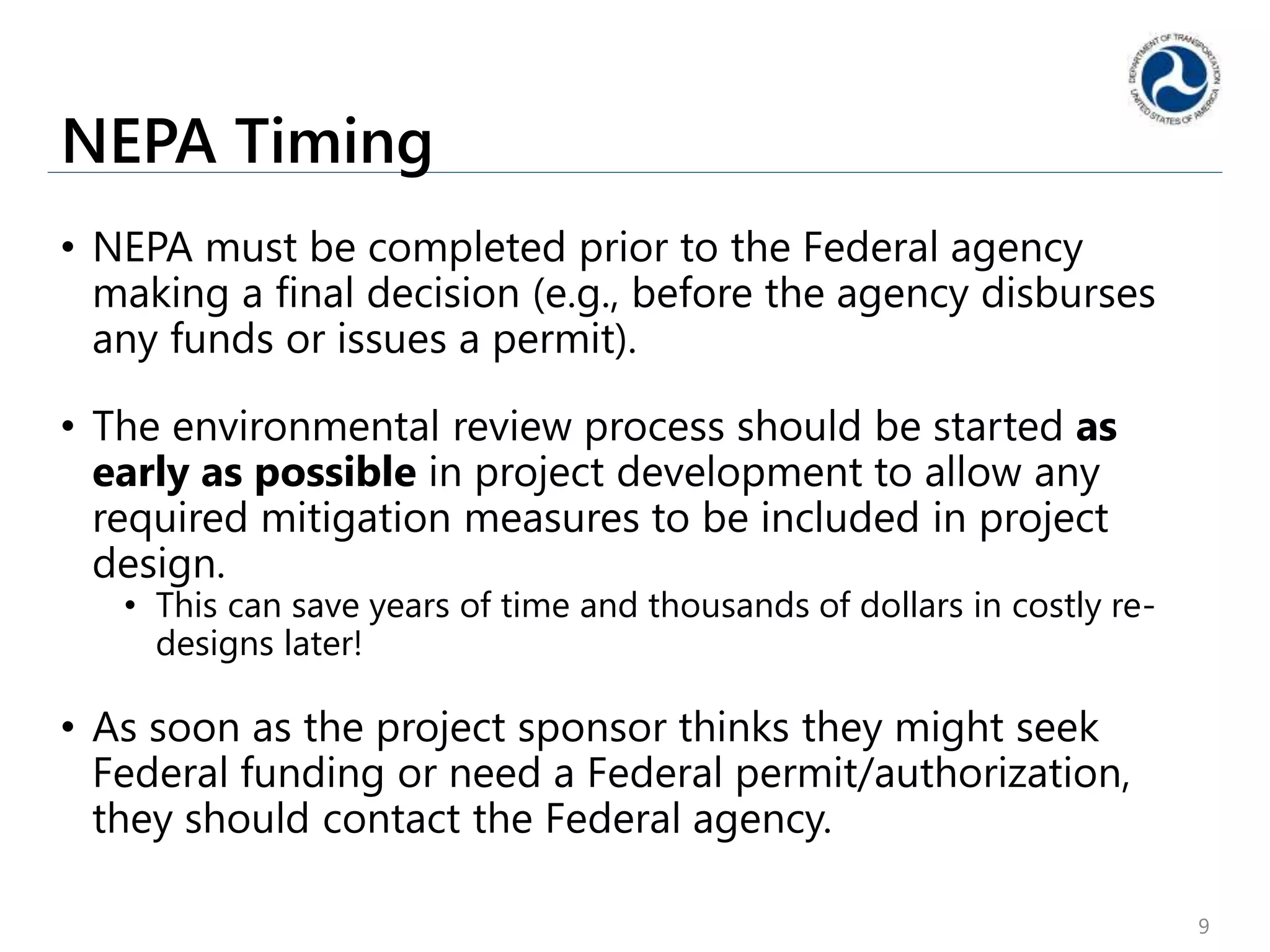

9. NEPA Timing
• NEPA must be completed prior to the Federal agency
making a final decision (e.g., before the agency disburses
any funds or issues a permit).
• The environmental review process should be started as
early as possible in project development to allow any
required mitigation measures to be included in project
design.
• This can save years of time and thousands of dollars in costly re-
designs later!
• As soon as the project sponsor thinks they might seek
Federal funding or need a Federal permit/authorization,
they should contact the Federal agency.
9

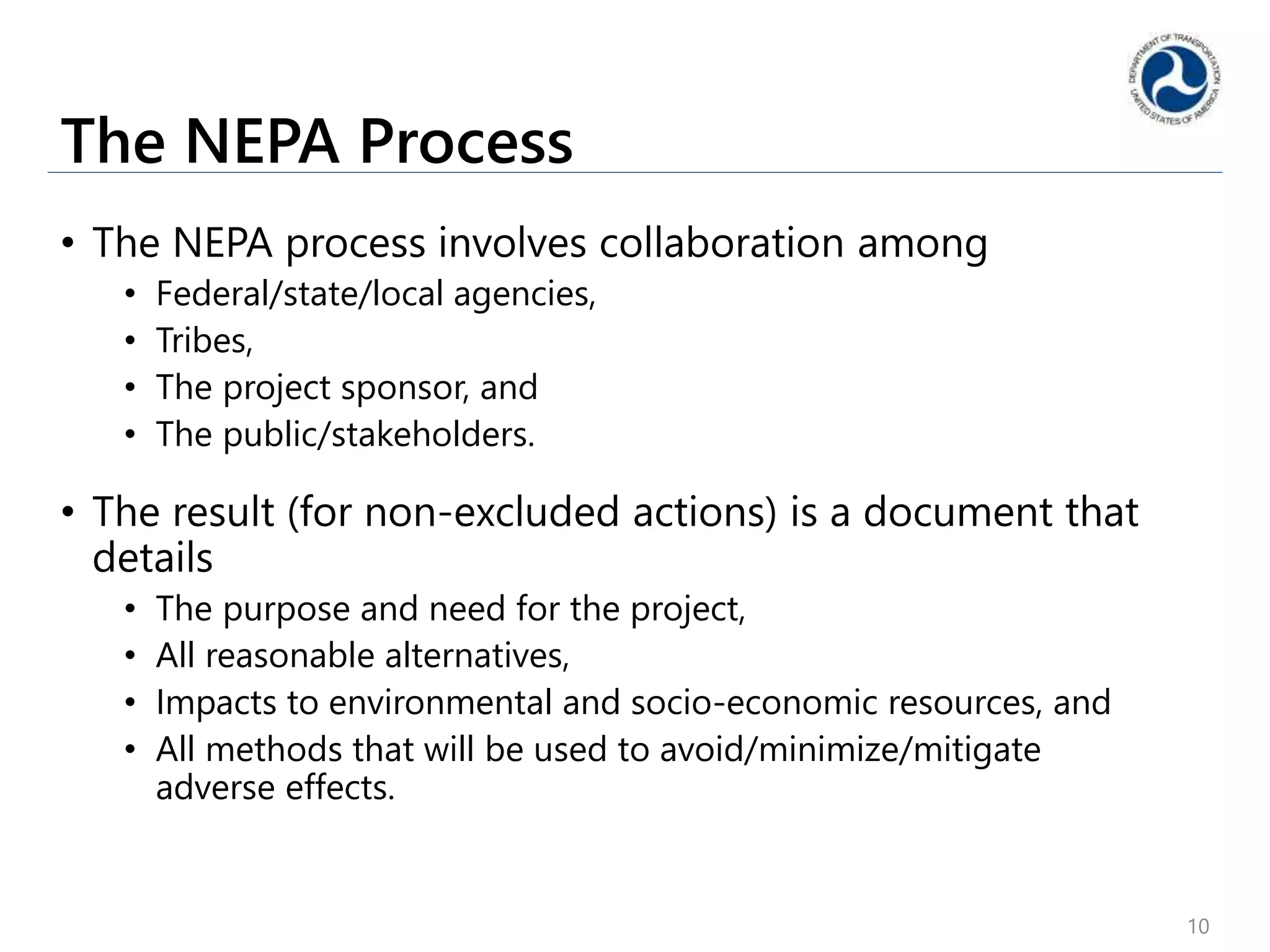

10. The NEPA Process
• The NEPA process involves collaboration among
• Federal/state/local agencies,
• Tribes,
• The project sponsor, and
• The public/stakeholders.
• The result (for non-excluded actions) is a document that
details
• The purpose and need for the project,
• All reasonable alternatives,
• Impacts to environmental and socio-economic resources, and
• All methods that will be used to avoid/minimize/mitigate
adverse effects.
10
11. Essential NEPA Terms
• Lead and Cooperating Agencies: To the maximum
extent possible (and required, in some cases), all Federal
agencies with a NEPA responsibility for the same action
will consolidate their reviews into one.
• Leady Agency: The agency with the most/longest review
responsibility is typically designated as the lead agency (e.g., the
agency with the most funding involved or the need to review
the longest portion of a linear project).
• Cooperating Agency: All other agencies with decision making
roles or special expertise on an impacted resource will serve as
cooperating agencies.
11

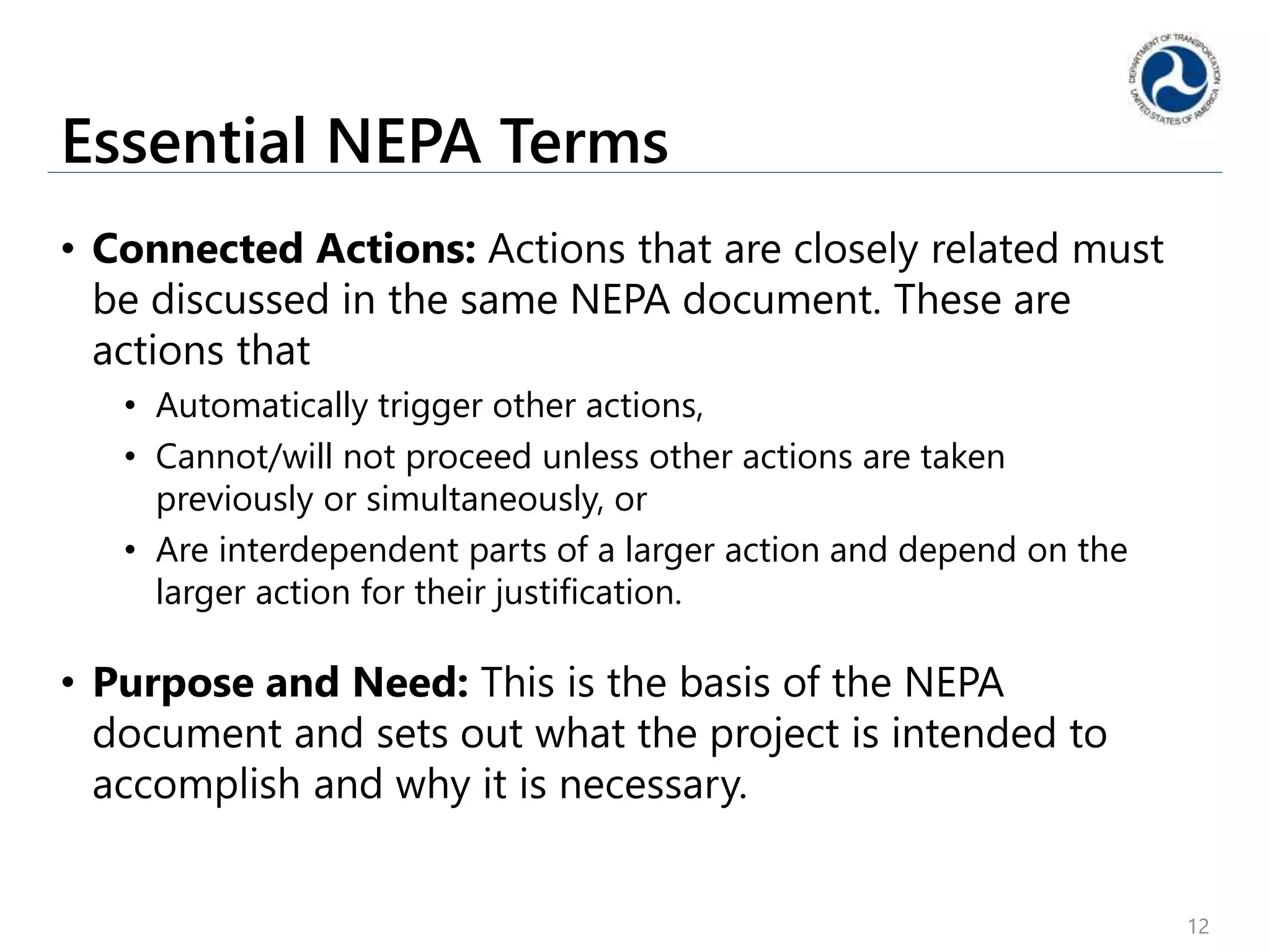

12. Essential NEPA Terms
• Connected Actions: Actions that are closely related must
be discussed in the same NEPA document. These are
actions that
• Automatically trigger other actions,
• Cannot/will not proceed unless other actions are taken
previously or simultaneously, or
• Are interdependent parts of a larger action and depend on the
larger action for their justification.
• Purpose and Need: This is the basis of the NEPA
document and sets out what the project is intended to
accomplish and why it is necessary.
12

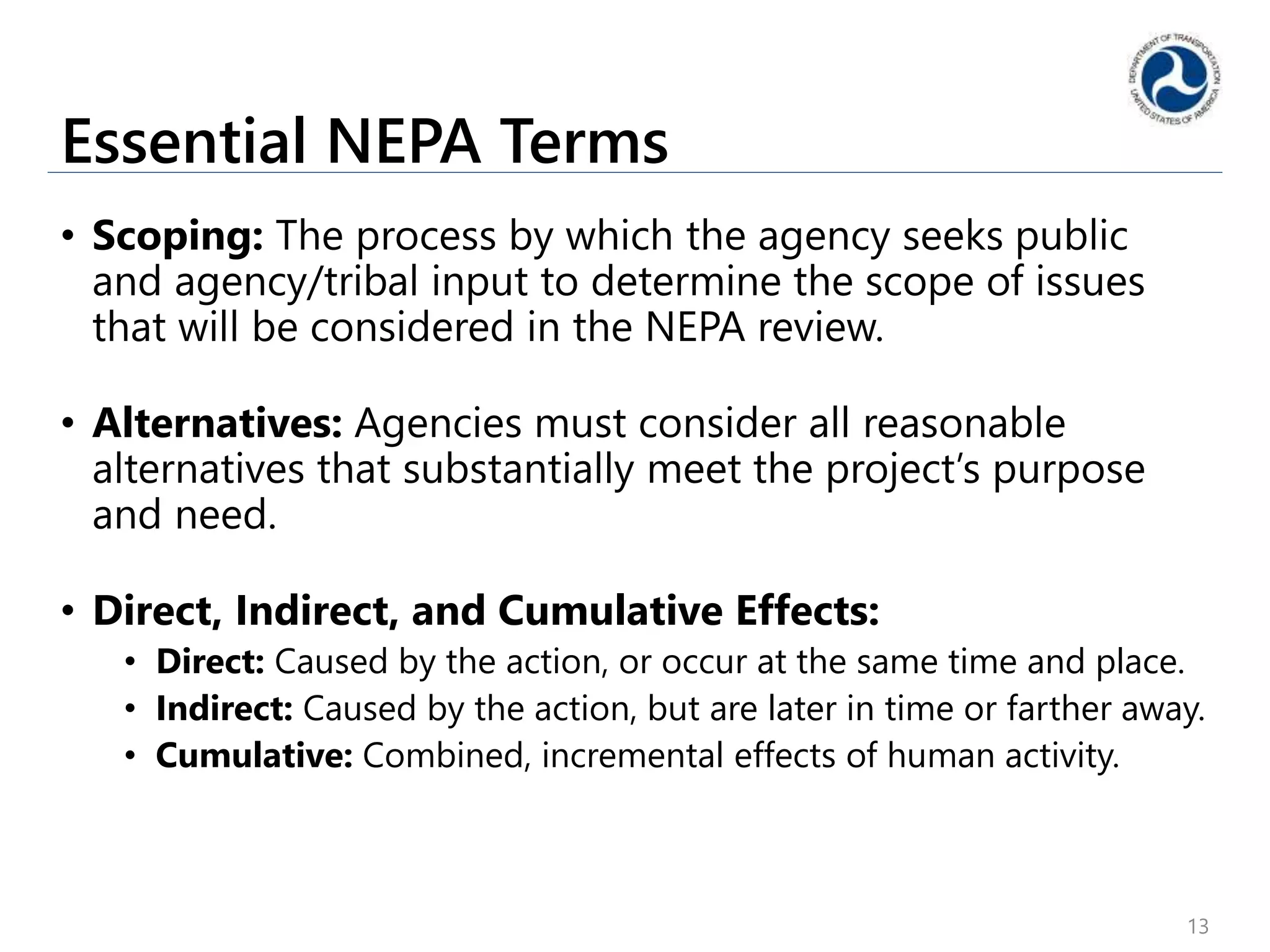

13. Essential NEPA Terms
• Scoping: The process by which the agency seeks public
and agency/tribal input to determine the scope of issues
that will be considered in the NEPA review.
• Alternatives: Agencies must consider all reasonable
alternatives that substantially meet the project’s purpose
and need.
• Direct, Indirect, and Cumulative Effects:
• Direct: Caused by the action, or occur at the same time and place.
• Indirect: Caused by the action, but are later in time or farther away.
• Cumulative: Combined, incremental effects of human activity.
13

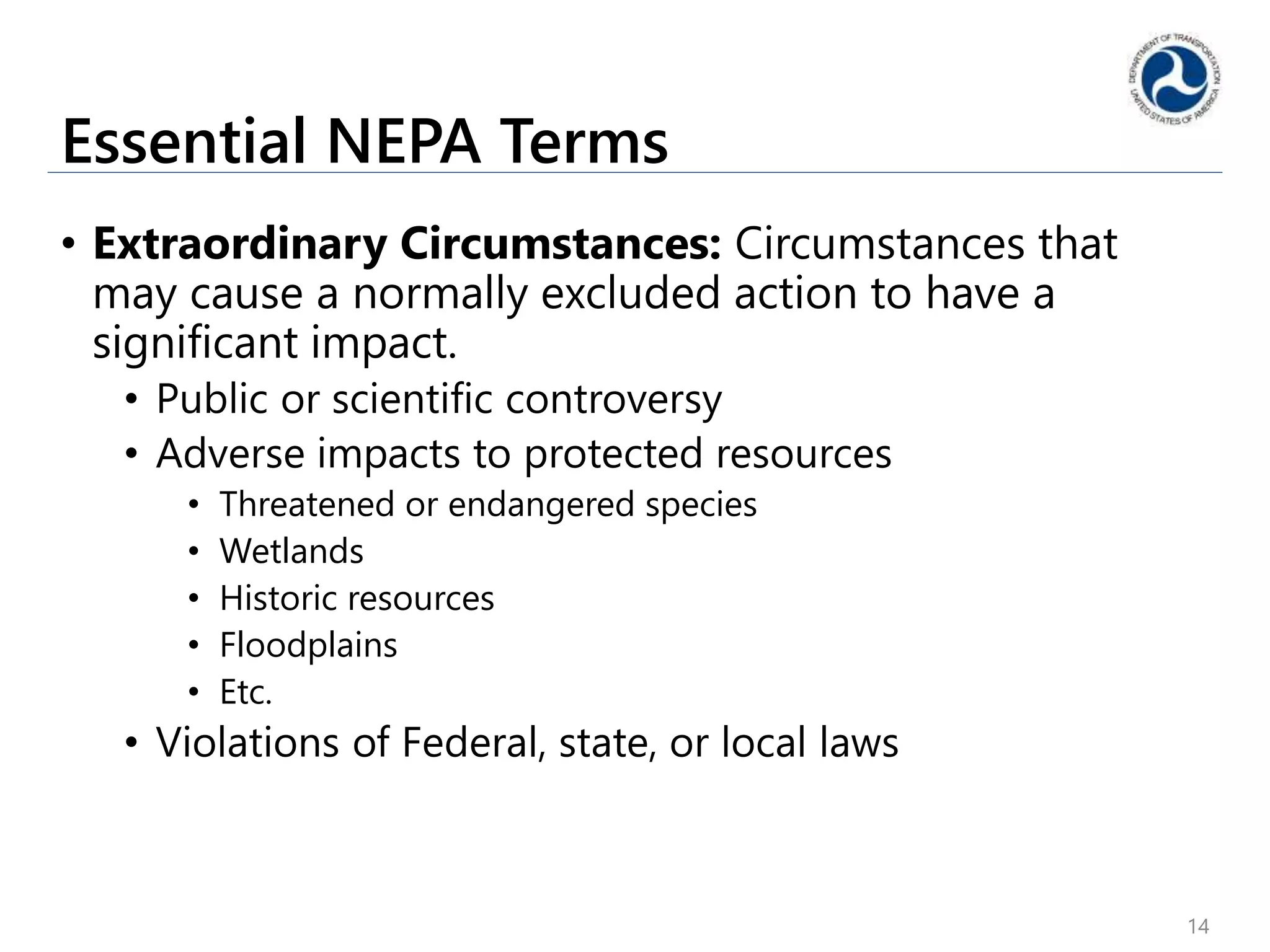

14. Essential NEPA Terms
• Extraordinary Circumstances: Circumstances that
may cause a normally excluded action to have a
significant impact.
• Public or scientific controversy
• Adverse impacts to protected resources
• Threatened or endangered species
• Wetlands
• Historic resources
• Floodplains
• Etc.
• Violations of Federal, state, or local laws
14

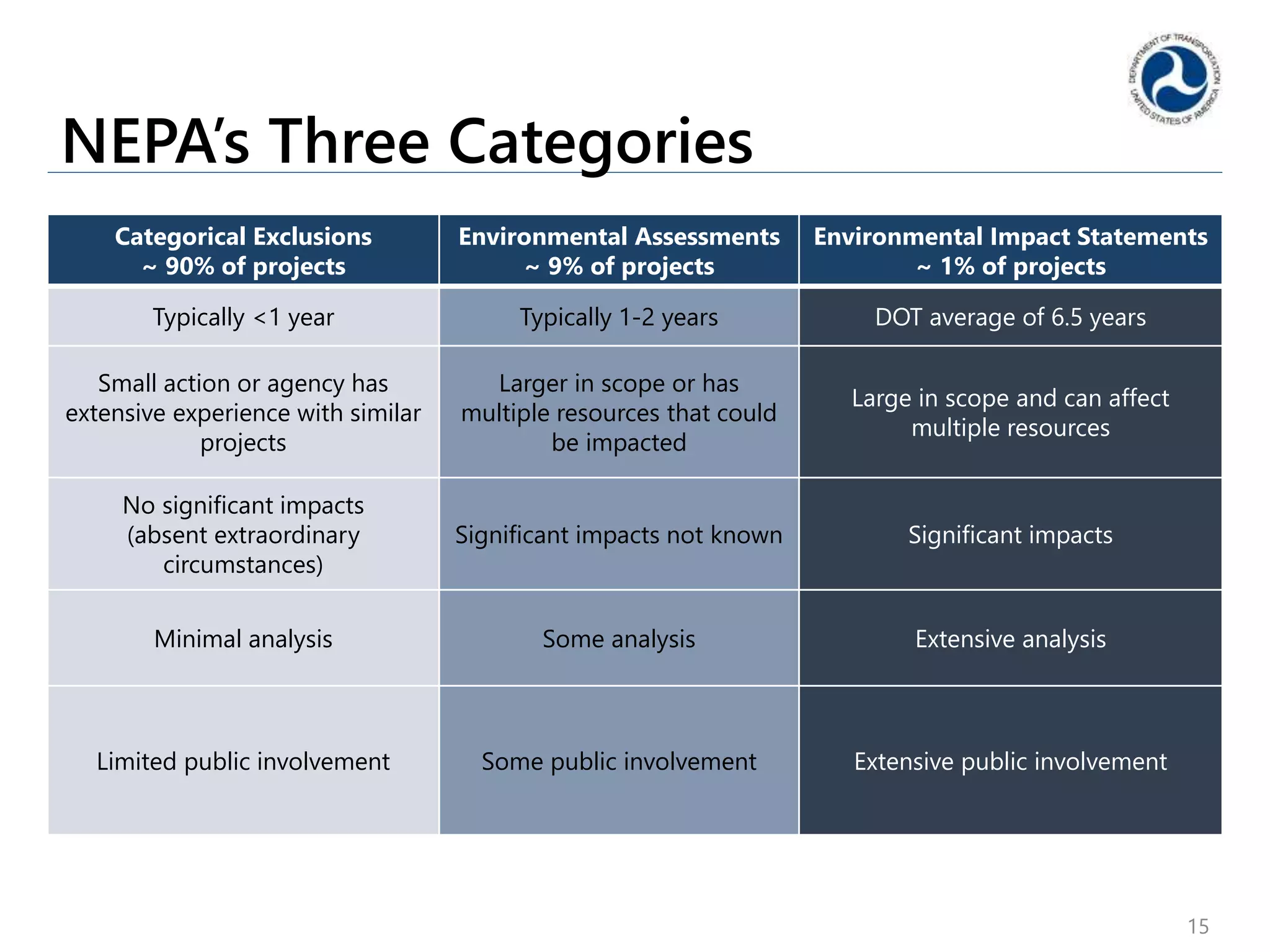

15. NEPA’s Three Categories
15
Categorical Exclusions
~ 90% of projects
Environmental Assessments
~ 9% of projects
Environmental Impact Statements
~ 1% of projects
Typically <1 year Typically 1-2 years DOT average of 6.5 years
Small action or agency has
extensive experience with similar
projects
Larger in scope or has
multiple resources that could
be impacted
Large in scope and can affect
multiple resources
No significant impacts
(absent extraordinary
circumstances)
Significant impacts not known Significant impacts
Minimal analysis Some analysis Extensive analysis
Limited public involvement Some public involvement Extensive public involvement

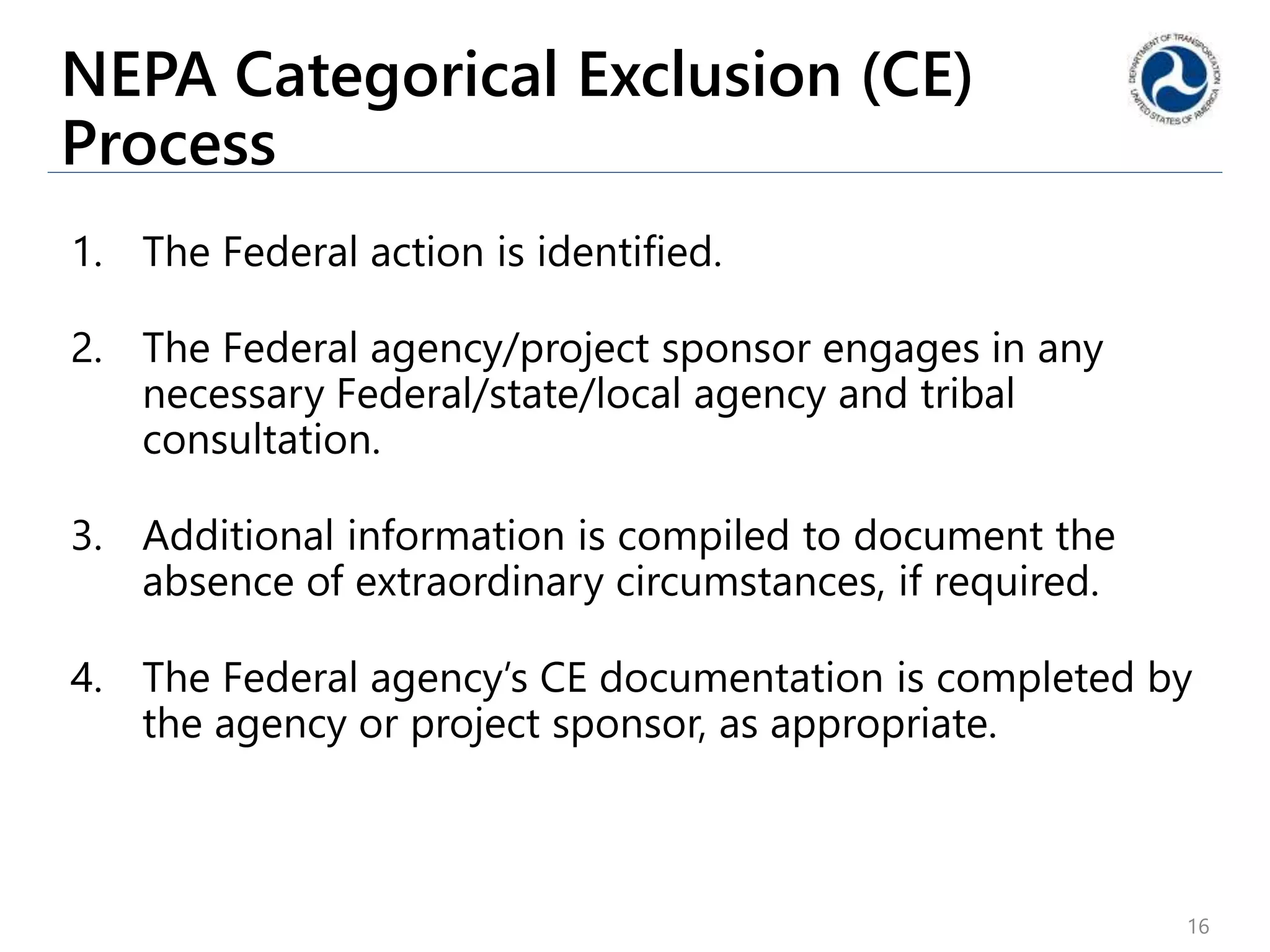

16. NEPA Categorical Exclusion (CE)
Process
1. The Federal action is identified.
2. The Federal agency/project sponsor engages in any
necessary Federal/state/local agency and tribal
consultation.
3. Additional information is compiled to document the
absence of extraordinary circumstances, if required.
4. The Federal agency’s CE documentation is completed by
the agency or project sponsor, as appropriate.
16

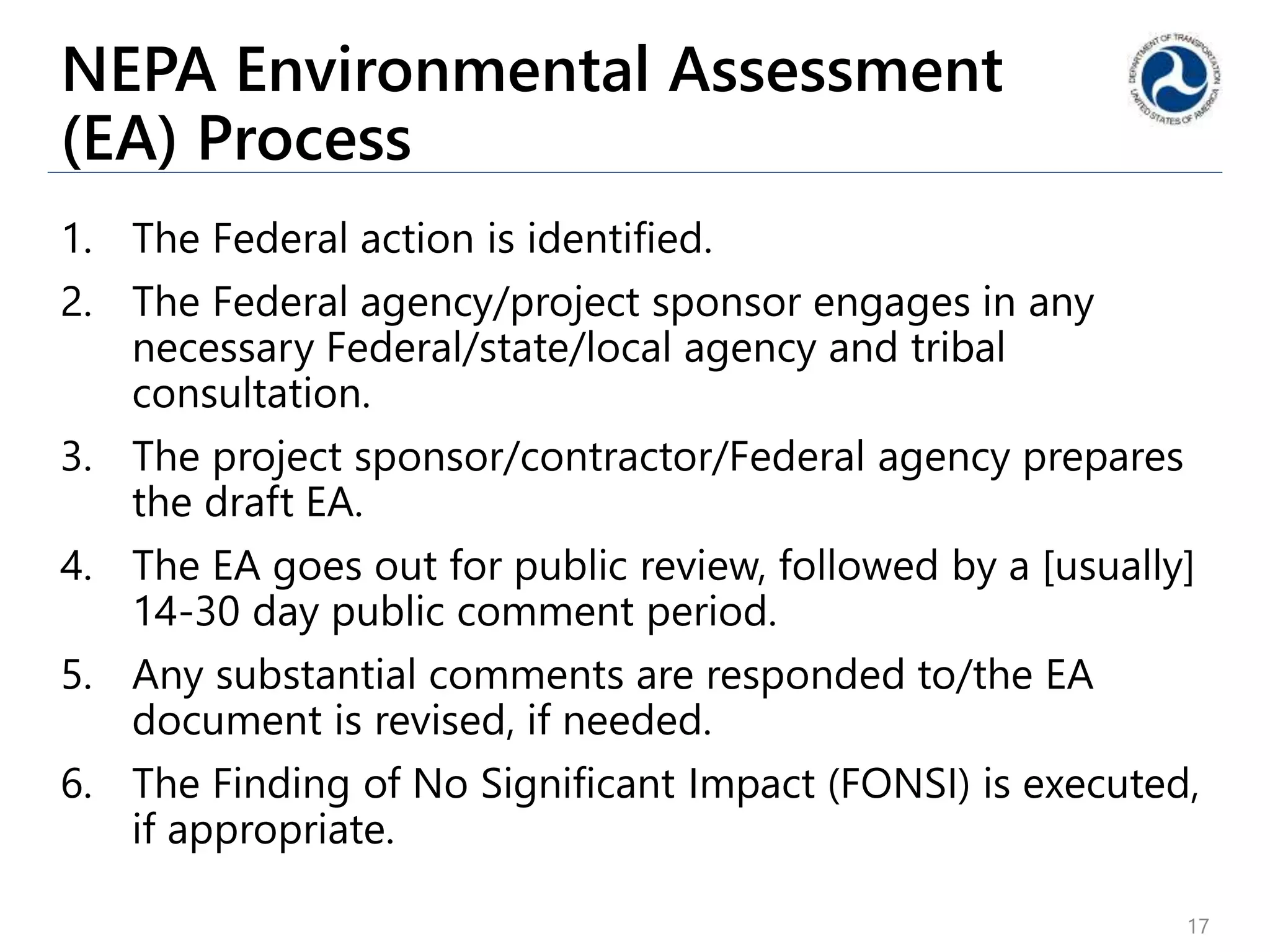

17. NEPA Environmental Assessment
(EA) Process
1. The Federal action is identified.
2. The Federal agency/project sponsor engages in any
necessary Federal/state/local agency and tribal
consultation.
3. The project sponsor/contractor/Federal agency prepares
the draft EA.
4. The EA goes out for public review, followed by a [usually]
14-30 day public comment period.
5. Any substantial comments are responded to/the EA
document is revised, if needed.
6. The Finding of No Significant Impact (FONSI) is executed,
if appropriate.
17

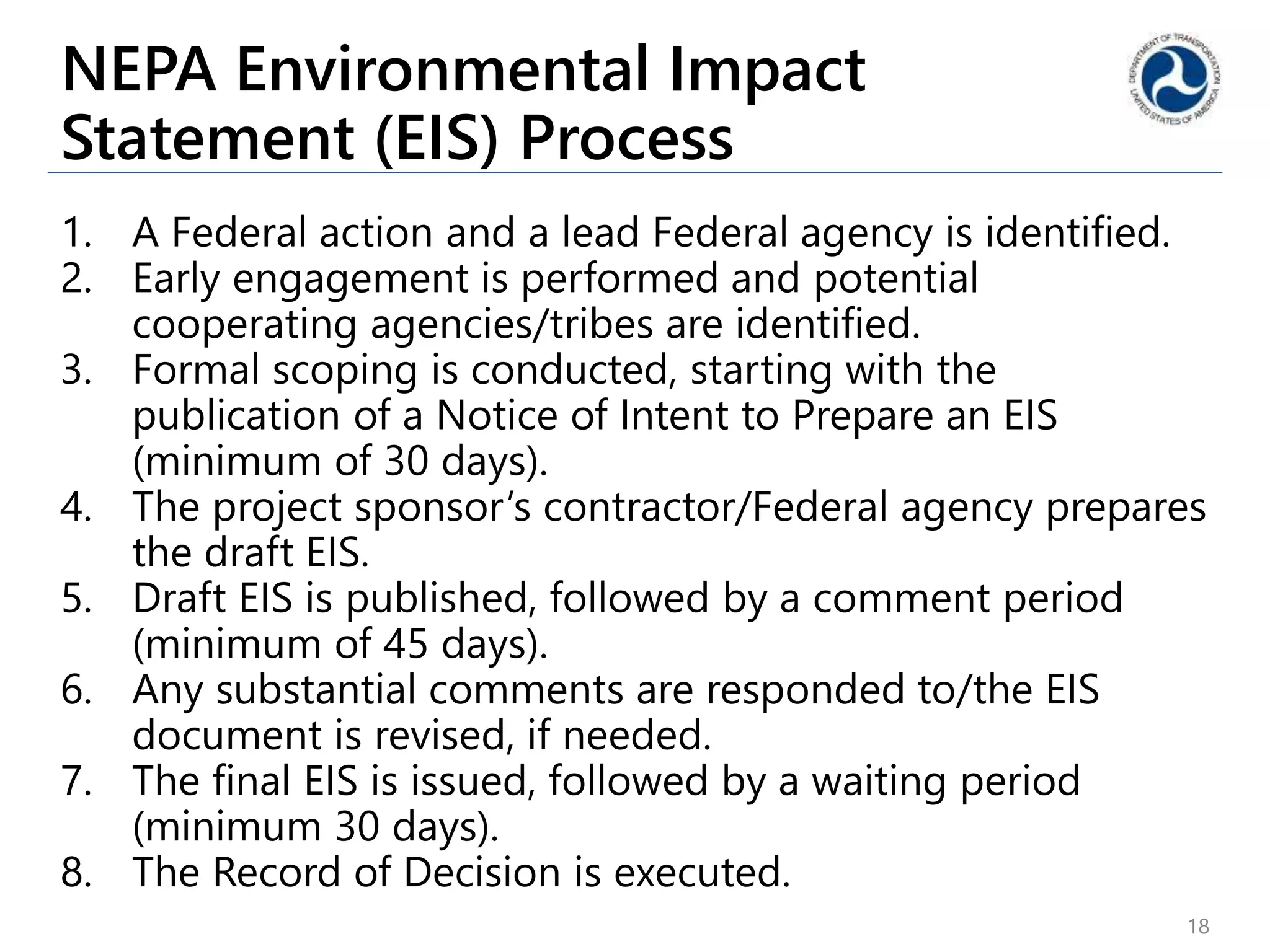

18. NEPA Environmental Impact
Statement (EIS) Process
1. A Federal action and a lead Federal agency is identified.
2. Early engagement is performed and potential
cooperating agencies/tribes are identified.
3. Formal scoping is conducted, starting with the
publication of a Notice of Intent to Prepare an EIS
(minimum of 30 days).
4. The project sponsor’s contractor/Federal agency prepares
the draft EIS.
5. Draft EIS is published, followed by a comment period
(minimum of 45 days).
6. Any substantial comments are responded to/the EIS
document is revised, if needed.
7. The final EIS is issued, followed by a waiting period
(minimum 30 days).
8. The Record of Decision is executed.
18
20. Environmental Resource Laws
• Laws protecting individual environmental resources are
considered to be under the “NEPA umbrella,” meaning
that the project’s compliance with these laws is considered
in the NEPA process.
• Compliance is outlined within the
NEPA document.
• If a project qualifies for a NEPA
categorical exclusion, that does
not automatically mean that no
environmental resource laws apply.
20

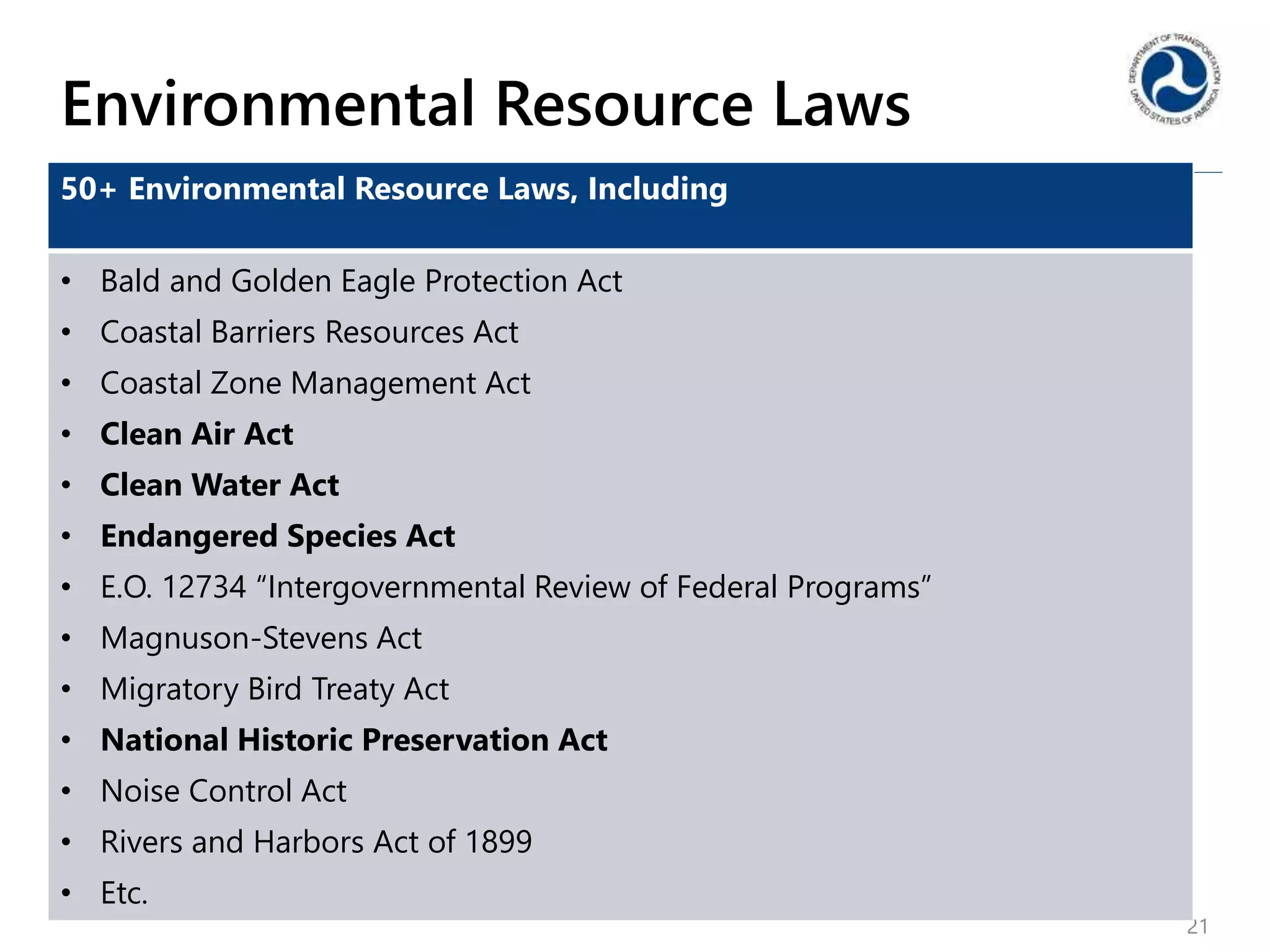

21. Environmental Resource Laws
21
50+ Environmental Resource Laws, Including
• Bald and Golden Eagle Protection Act
• Coastal Barriers Resources Act
• Coastal Zone Management Act
• Clean Air Act
• Clean Water Act
• Endangered Species Act
• E.O. 12734 “Intergovernmental Review of Federal Programs”
• Magnuson-Stevens Act
• Migratory Bird Treaty Act
• National Historic Preservation Act
• Noise Control Act
• Rivers and Harbors Act of 1899
• Etc.

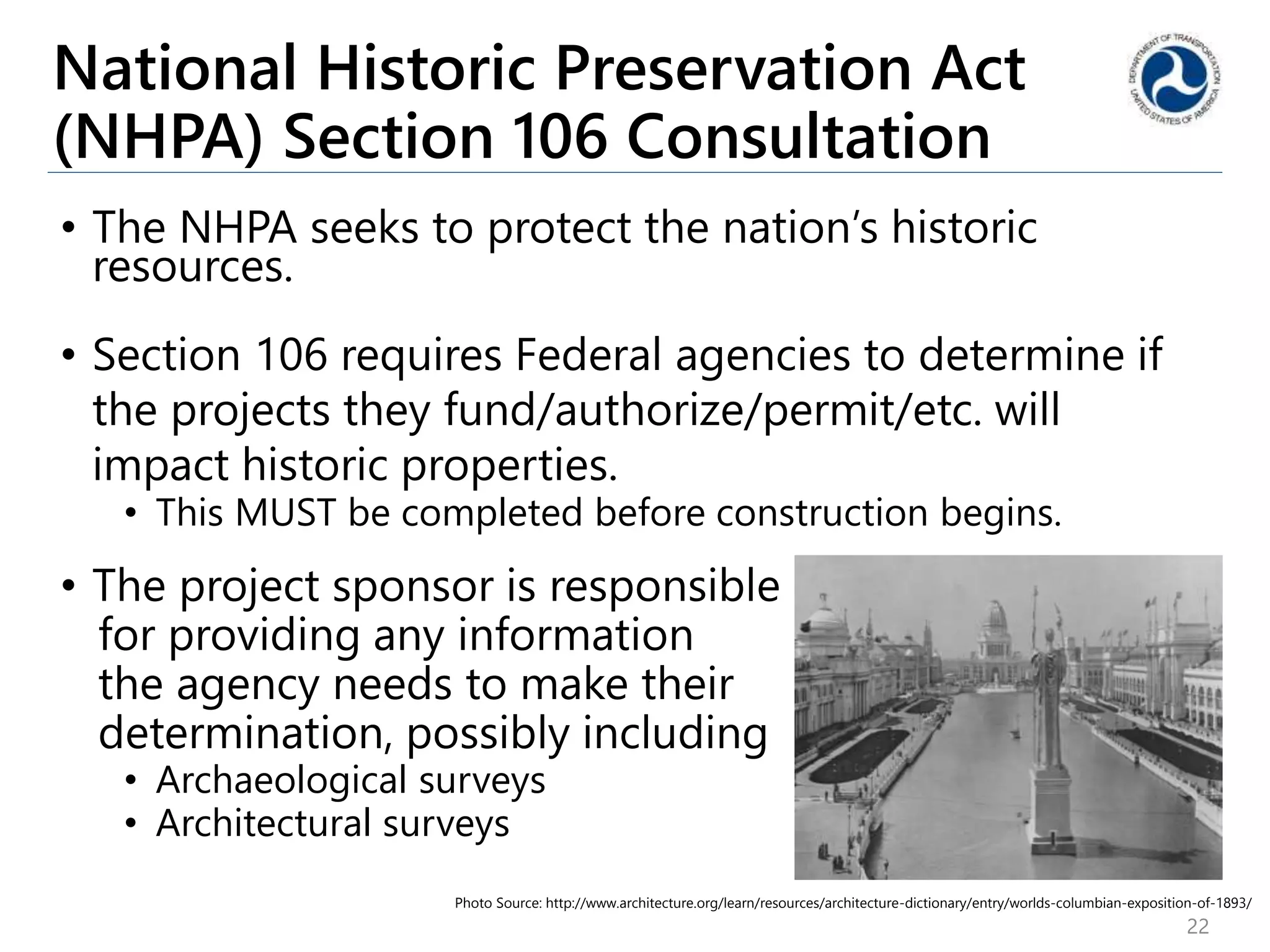

22. National Historic Preservation Act
(NHPA) Section 106 Consultation
• The NHPA seeks to protect the nation’s historic
resources.
• Section 106 requires Federal agencies to determine if
the projects they fund/authorize/permit/etc. will
impact historic properties.
• This MUST be completed before construction begins.
• The project sponsor is responsible
for providing any information
the agency needs to make their
determination, possibly including
• Archaeological surveys
• Architectural surveys
22
Photo Source: http://www.architecture.org/learn/resources/architecture-dictionary/entry/worlds-columbian-exposition-of-1893/

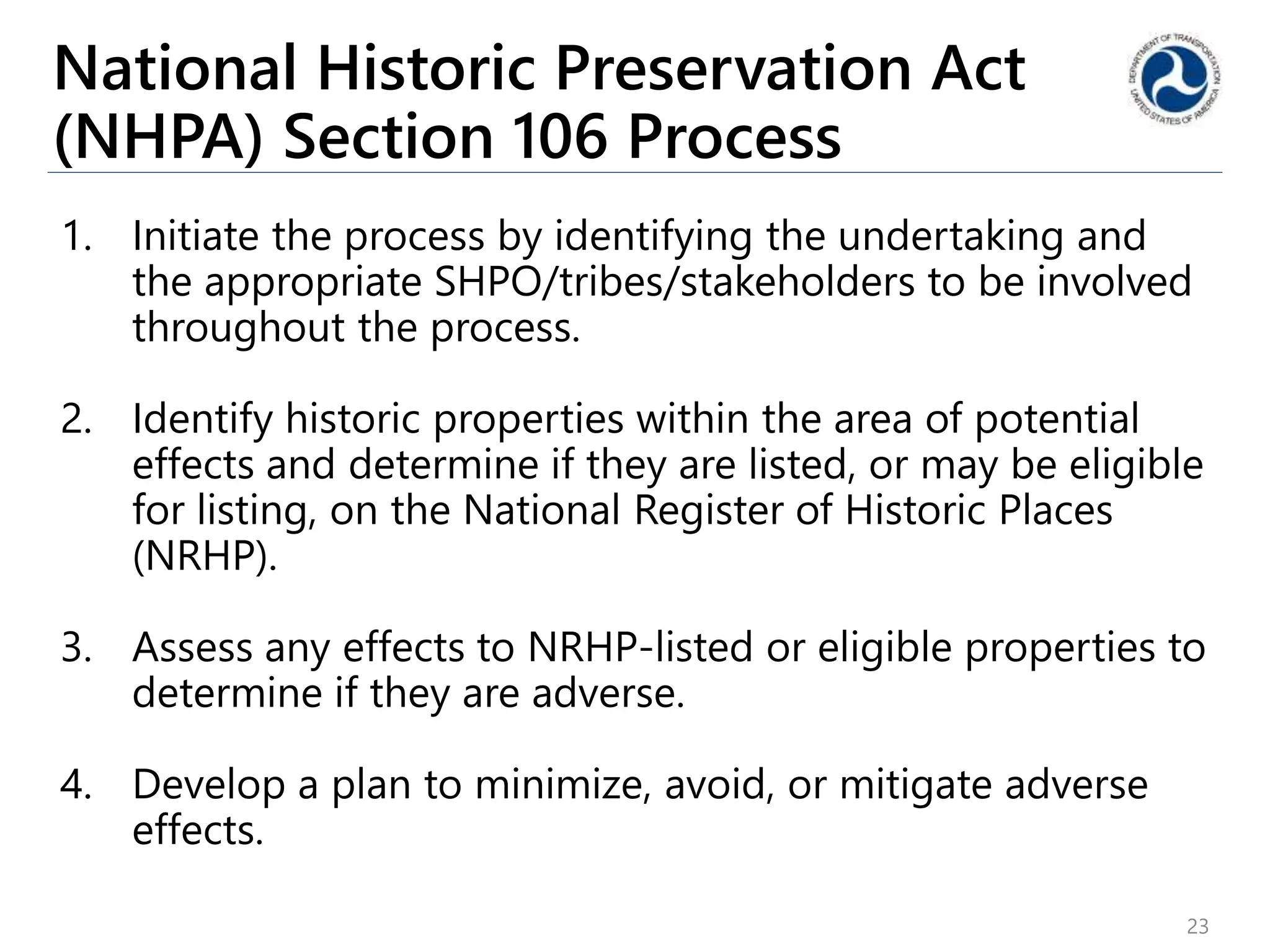

23. National Historic Preservation Act
(NHPA) Section 106 Process
1. Initiate the process by identifying the undertaking and
the appropriate SHPO/tribes/stakeholders to be involved
throughout the process.
2. Identify historic properties within the area of potential
effects and determine if they are listed, or may be eligible
for listing, on the National Register of Historic Places
(NRHP).
3. Assess any effects to NRHP-listed or eligible properties to
determine if they are adverse.
4. Develop a plan to minimize, avoid, or mitigate adverse
effects.
23

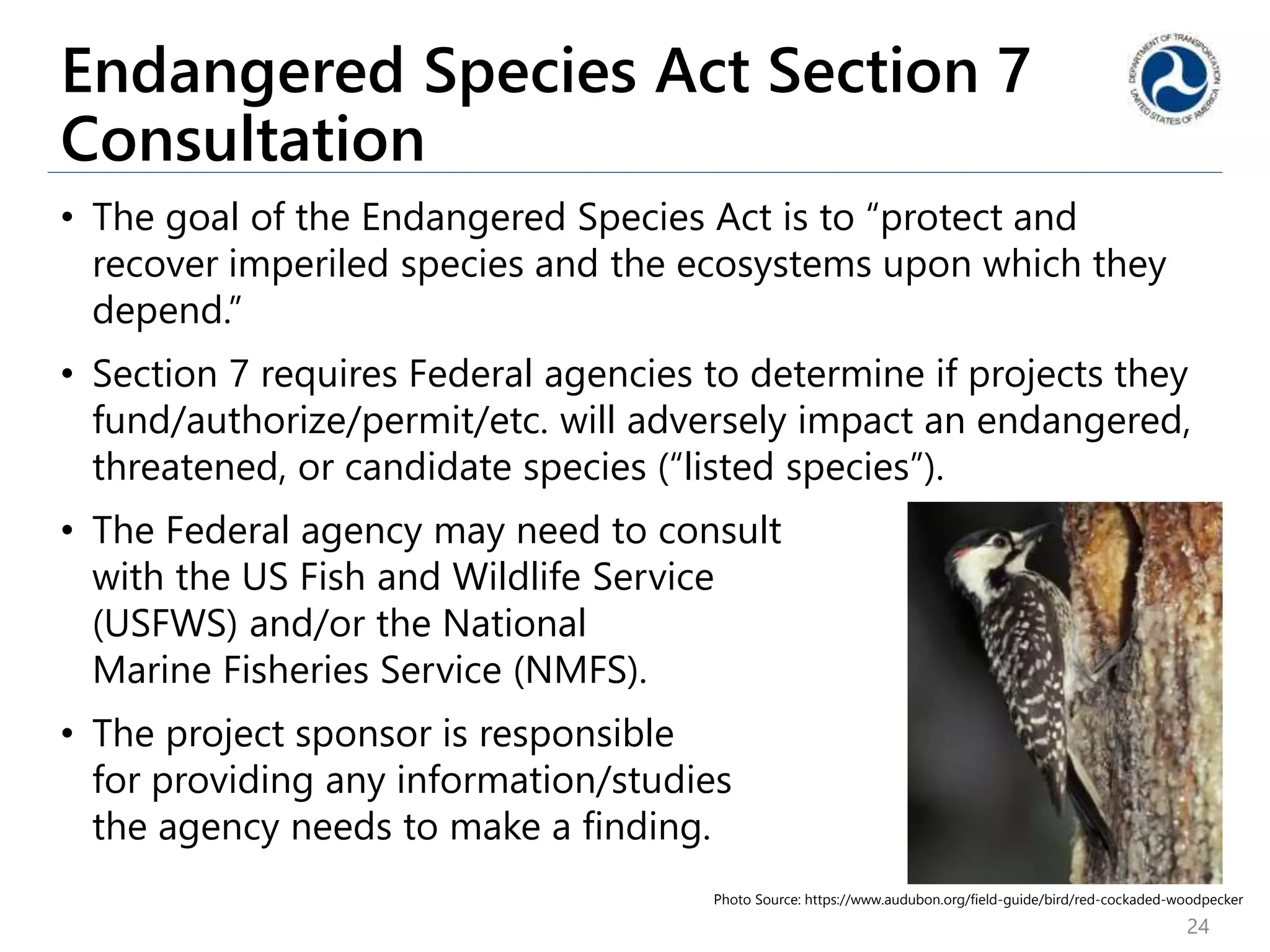

24. Endangered Species Act Section 7
Consultation
• The goal of the Endangered Species Act is to “protect and
recover imperiled species and the ecosystems upon which they
depend.”
• Section 7 requires Federal agencies to determine if projects they
fund/authorize/permit/etc. will adversely impact an endangered,
threatened, or candidate species (“listed species”).
• The Federal agency may need to consult
with the US Fish and Wildlife Service
(USFWS) and/or the National
Marine Fisheries Service (NMFS).
• The project sponsor is responsible
for providing any information/studies
the agency needs to make a finding.
24
Photo Source: https://www.audubon.org/field-guide/bird/red-cockaded-woodpecker
25. Endangered Species Act Section 7
Consultation Findings
• No Effect- The project will not impact a listed species (does
not require concurrence from USFWS/NMFS).
• May Affect, Not Likely to Adversely Affect- Impacts to
the species are unlikely (requires USFWS/NMFS
concurrence).
• May Affect, Likely to Adversely Affect- Adverse impacts
are likely to occur, but consultation with USFWS/NMFS is
required to determine if the project will jeopardize the
existence of the species.
• No Jeopardy- The project will adversely affect the species,
but will not jeopardize the species’ existence.
• Jeopardy- The project will jeopardize the species’
existence.
25
26. Clean Water Act Section 404 Permits
• Clean Water Act was enacted to preserve the integrity of
the nation’s waters.
• A project may need a Clean Water Act permit if it impacts
Waters of the United States (WOTUS), which are waters
• Used in interstate or foreign commerce;
• Interstate waters, including wetlands;
• Interstate waters and wetlands whose use, degradation, or
destruction could affect interstate or foreign commerce (e.g.,
recreational use, fisheries, commerce, and industrial purposes);
• Tributaries and impoundments; and
• Wetlands adjacent to jurisdictional waters.
26
27. Clean Water Act Section 404 Permits
• Section 404 regulates the discharge of dredged or fill
material into the WOTUS.
• The US Army Corps of Engineers (USACE) and the
Environmental Protection Agency jointly administer the
Section 404 program, but USACE is responsible for
reviewing and issuing permits.
• USACE allows compensatory mitigation (restoration,
establishment, enhancement, or preservation).
27
28. Clean Water Act Section 404 Permits
• USACE requires the use of the Least Environmental
Damaging Alternative (LEDPA):
• There must be no “practicable alternative to the proposed
discharge which would have less adverse impact on the aquatic
ecosystem, so long as the alternative does not have other
significant adverse environmental consequences.”
• “Practicable” means “available and capable of being done after
taking into consideration cost, existing technology, and logistics
in light of overall project purposes.”
28
29. Clean Air Act Permits
• The Clean Air Act (CAA) gave the EPA authority to establish
National Ambient Air Quality Standards (NAAQS) to protect
public health and the environment.
• NAAQS have been established for six pollutants: particulate matter,
ground-level ozone, carbon monoxide, sulfur oxides, nitrogen
oxides, and lead.
• EPA designates three types of areas for each pollutant:
• Attainment areas meet the NAAQS standard,
• Non-attainment areas exceed the NAAQS standards, and
• Maintenance areas were formerly non-attainment areas that must
maintain sub-NAAQS levels for two 10-year periods in order to be
re-designated.
29
30. Clean Air Act Federal Requirements
• Federal actions must
• Conform to a state’s implementation plan (SIP) for achieving
attainment of all NAAQS,
• Cannot cause new violations,
• Cannot worsen existing violations, and
• Cannot delay timely attainments of the NAAQS.
• If a project is within an attainment/
maintenance area, SIP conformity
may need to be evaluated.
• Two types of conformity apply to
transportation projects:
• Transportation and
• General.
30
Photo source: https://www.cbsnews.com/news/londons-1952-killer-fog-cause-revealed/
31. Clean Air Act Conformity
• Transportation applies to FHWA/FTA projects and
regionally significant state-only projects.
• All other transportation projects must comply with
general conformity requirements.
• Multi-modal projects may require both types of
conformity.
• For projects in non-attainment/maintenance areas,
projects are considered exempt from General Conformity
if they
• Are actions covered by transportation conformity;
• Have emissions at or below de minimis levels set by EPA;
• Are explicitly exempted in the CAA rule; or
• Are covered by the EPA list of activities that are “presumed to
conform.”
31
32. Clean Air Act Transportation
Conformity
• Transportation plans must conform with SIPs in order to
be approved by FHWA/FTA.
• Individual FHWA/FTA projects must demonstrate that they
are included in an approved transportation plan in order
to remove the requirement for additional CAA conformity
analysis.
• Metropolitan planning organizations (MPOs) make the
initial conformity determination, which is then approved
by FHWA/FTA.
• For those areas without MPOs that are in non-
attainment/maintenance areas (rare), special rules apply.
32
33. Projects on Federal Land
• If the project will need to be located on or cross
Federal land (Bureau of Land Management,
National Park Service, US Forest Service, etc.), a
right-of-way or special use permit may be required.
• The lead agency will assist with identifying which
land management agencies will need to be
contacted.
33
35. Federal Agency Regulations
• Each Federal agency has regulations that set out how
they implement Federal environmental laws.
• These regulations will detail:
• Additional agency environmental policies,
• Which actions fall into each NEPA review category, and
• The format and required information for environmental review
documentation.
• Read these regulations up front, and always feel free
to ask questions about them!!!
35
37. State/Local Laws
• States and localities may also have their own environmental
resource laws that have additional requirements of the
project/project sponsor.
• These laws may be more stringent.
• Some states have a NEPA-like law of their own (e.g.,
California Environmental Quality Act).
• Lead and cooperating Federal agencies will work with
project sponsors to identify all appropriate state agencies
that need to be involved in the environmental review.
• Compliance with state/local laws will also be outlined in the
NEPA document.
37
39. USDOT Environmental Tools
• USDOT has some unique environmental review
capabilities:
• NEPA Assignment- USDOT can delegate most NEPA
responsibilities to a state DOT.
• FHWA Liaisons- Personnel housed in Federal and state resource
agencies that facilitate the environmental review and permitting
process for transportation projects.
• Combined Final EIS and Record of Decision- Issuing this
combined document removes 30 days from the EIS process.
39
40. USDOT Environmental Tools
• Permitting Dashboard- An online tracking system for FHWA,
FRA, FTA, and FAA environmental reviews
(https://www.permits.performance.gov/).
• FAST Act Environmental Review Checklist- A checklist to
be used by USDOT and the project sponsor to aid in the preparation
of NEPA documents.
• Planning and Environmental Linkages (PEL)- An approach
to efficient decision-making that considers benefits and impacts of
transportation system improvements on the environment.
• Environmental Guides and Videos- DOT’s Operating
Administrations have a wide variety of instructional guides and
videos.
40
41. New USDOT Guidance
• One Federal Decision (OFD) Implementation
Guidance- E.O. 13807 created the ODF process aimed at
streamlining and speeding the completion of NEPA for
major infrastructure projects (MIPs) (infrastructure
construction projects with identified funding that require
an EIS and multiple authorizations from multiple Federal
agencies). OFD requires
• Preparation of a single EIS;
• Execution of a shared ROD;
• Lead and cooperating agency concurrence on the purpose and
need, range of alternatives, and preferred alternative; and
• Goal of an agency 2-year average for the completion of MIP EISs,
plus 90 additional days to complete all remaining
authorizations/permits.
41
42. QUICK SUMMARY
• NEPA will apply to projects seeking Federal funding or
requiring a Federal review/permit/approval/
authorization/etc.
• Other state/local and environmental resource laws may
apply depending on the nature and location of the
project.
• The environmental review process should start as early as
possible in project development, and must be completed
prior to the Federal agency(ies) making a final decision.
• USE THE FEDERAL AGENCY(IES) AS A RESOURCE-
ENVIRONMENTAL REVIEWS ARE COLLABORATIVE
EFFORTS!
42
43. Questions?
(Think of something you’d like to discuss later? Please call or email
me at kelsey.owens@dot.gov or 202-366-7378)
43
