SlideShare a Scribd company logo
Adapting to future impacts of climate
change and screening adaptation projects
and programmes - key concepts and
principles (part 1)
Workshop ‘Smart Decision-Making for Climate Change Adaptation Supported by Multi-Criteria Analysis’
Presented by Martin Rokitzki
(PlanAdapt, International consultant)
Adaptation - What types of interventions?
Adaptation - What types of interventions?

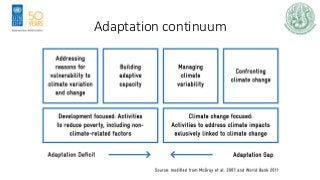

Adaptation continuum

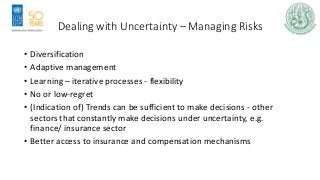

Dealing with Uncertainty – Managing Risks
• Diversification
• Adaptive management
• Learning – iterative processes - flexibility
• No or low-regret
• (Indication of) Trends can be sufficient to make decisions - other
sectors that constantly make decisions under uncertainty, e.g.
finance/ insurance sector
• Better access to insurance and compensation mechanisms

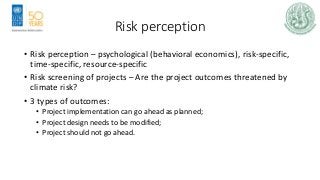

Risk perception
• Risk perception – psychological (behavioral economics), risk-specific,
time-specific, resource-specific
• Risk screening of projects – Are the project outcomes threatened by
climate risk?
• 3 types of outcomes:
• Project implementation can go ahead as planned;
• Project design needs to be modified;
• Project should not go ahead.

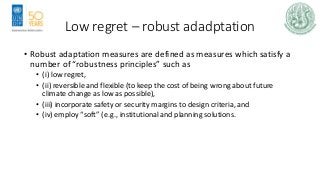

Low regret – robust adadptation
• Robust adaptation measures are defined as measures which satisfy a
number of “robustness principles” such as
• (i) low regret,
• (ii) reversible and flexible (to keep the cost of being wrong about future
climate change as low as possible),
• (iii) incorporate safety or security margins to design criteria, and
• (iv) employ “soft” (e.g., institutional and planning solutions.

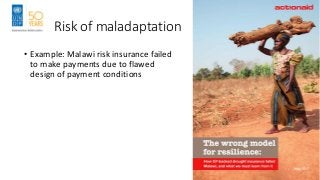

Risk of maladaptation
• Example: Malawi risk insurance failed
to make payments due to flawed
design of payment conditions

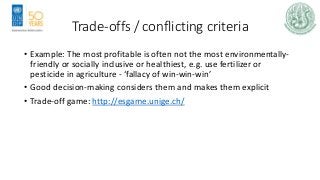

Trade-offs / conflicting criteria
• Example: The most profitable is often not the most environmentally-
friendly or socially inclusive or healthiest, e.g. use fertilizer or
pesticide in agriculture - ‘fallacy of win-win-win’
• Good decision-making considers them and makes them explicit
• Trade-off game: http://esgame.unige.ch/
