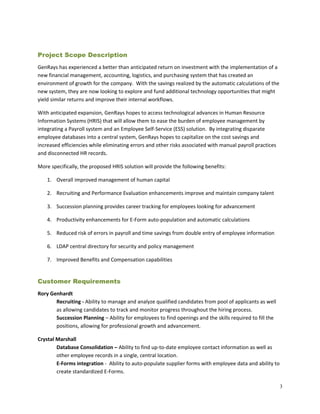

This document provides a scope for implementing a new HRIS system at GenRays. Key points include:
- GenRays wants to consolidate employee data and implement new HR functions like recruiting, payroll, and self-service to improve efficiency.
- The project will select a vendor solution, configure the system, migrate data, and train employees. Acceptance criteria define stakeholder requirements.
- A work breakdown structure outlines tasks, responsibilities, and deliverables. The budget is $103,000 with a 20% contingency. Resource and schedule constraints are defined.

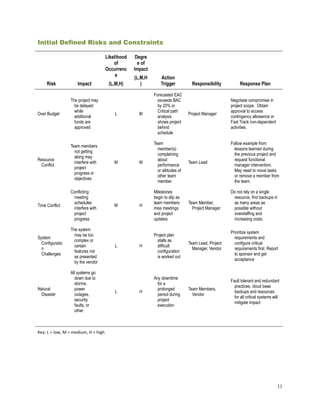

- Initial risks include going over budget, resource conflicts, time conflicts, complex system configuration, and natural disasters. Mitigation plans are outlined.
