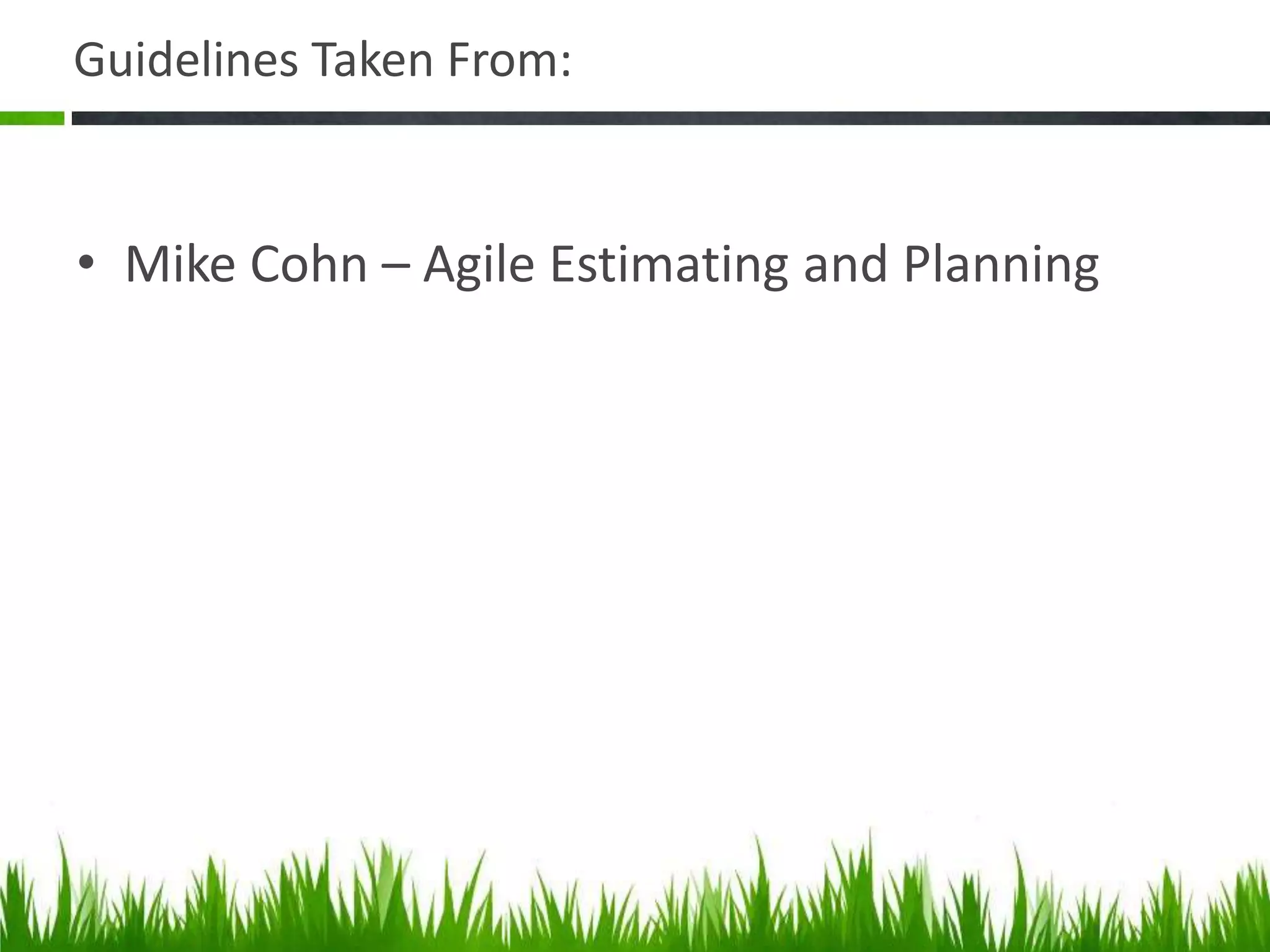

3. FAQs
1. How is the length of the iteration
determined?
2. Does a team sprint indefinitely?
3. Is there any disadvantage in timing the
release at the end of the quarter?
4. 1. HOW IS THE LENGTH OF THE
ITERATION DETERMINED?
5. Guideline – 4 or 5 opportunities
to gather end-of-iteration
feedback
6. Factors Influencing Iteration Length
• Shorter the release; shorter the iteration
• More the uncertainty; shorter the iteration
• More feedback during the iteration; shorter
the iteration
• Higher the frequency of change in priorities;
shorter the iteration
7. Factors and Their Influence - contd
• Higher the need to validate software; shorter
the iteration
• Higher the cost of iterating; longer the
iteration
• Greater the need for urgency; shorter the
iteration
9. Break from the Sustainable Pace - 6*2+1
• 6 2-week iterations followed by a 1-week
iteration
• 1 week to be used by the team to work off
technical debt incurred in early or pre-agile
days
• Team chooses their own work for this 1 week
• Not a slack-off period
10. 3. IS THERE ANY DISADVANTAGE IN
TIMING THE RELEASE AT THE END
OF THE QUARTER?
11. Avoid End of the Quarter Release
• Pressure to meet quarterly revenue goals
(especially in publicly traded companies)
• If a software project does not deliver on the
end-of-quarter date then revenue from pre-
sales and upgrades cannot be recognized in
that quarter
• Software development has too many
unknowns and uncertainties to plan in the
absolute
