Making CIL Work – Wokingham
Borough Council Experience
Brendan Troy
Service Manager - Community
Infrastructure Delivery
E: brendan.troy@wokingham.gov.uk
T: 0118 974 6824

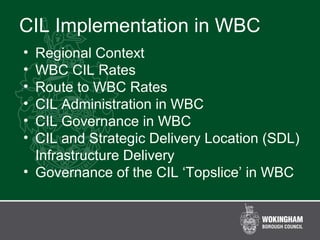

CIL Implementation in WBC
• Regional Context
• WBC CIL Rates
• Route to WBC Rates
• CIL Administration in WBC
• CIL Governance in WBC
• CIL and Strategic Delivery Location (SDL)
Infrastructure Delivery
• Governance of the CIL ‘Topslice’ in WBC

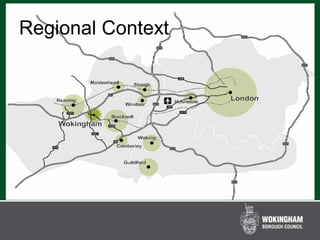

Regional Context

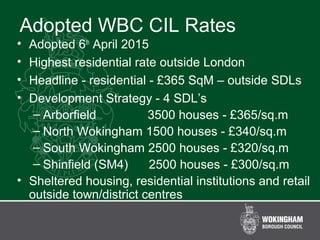

Adopted WBC CIL Rates
• Adopted 6th
April 2015
• Highest residential rate outside London
• Headline - residential - £365 SqM – outside SDLs
• Development Strategy - 4 SDL’s
– Arborfield 3500 houses - £365/sq.m
– North Wokingham 1500 houses - £340/sq.m
– South Wokingham 2500 houses - £320/sq.m
– Shinfield (SM4) 2500 houses - £300/sq.m
• Sheltered housing, residential institutions and retail
outside town/district centres

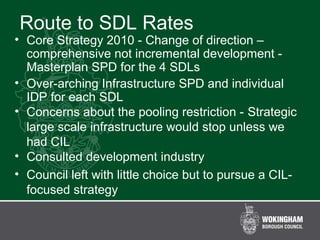

Route to SDL Rates
• Core Strategy 2010 - Change of direction –
comprehensive not incremental development -
Masterplan SPD for the 4 SDLs
• Over-arching Infrastructure SPD and individual
IDP for each SDL
• Concerns about the pooling restriction - Strategic
large scale infrastructure would stop unless we
had CIL
• Consulted development industry
• Council left with little choice but to pursue a CIL-
focused strategy

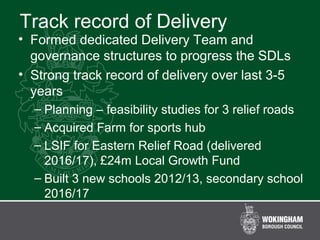

Track record of Delivery
• Formed dedicated Delivery Team and
governance structures to progress the SDLs
• Strong track record of delivery over last 3-5
years
– Planning – feasibility studies for 3 relief roads
– Acquired Farm for sports hub
– LSIF for Eastern Relief Road (delivered
2016/17), £24m Local Growth Fund
– Built 3 new schools 2012/13, secondary school
2016/17
Role of CIL - WBC
• Strategic Transport infrastructure
– South Wokingham Distributor Road (including Road
over Rail Bridge)
– Replacement railway bridges
• Primary and Secondary Education
• Suitable Alternative Natural Greenspace (SANG)
• Indoor & Outdoor Sport Facilities
• Community Centres / Halls / Libraries
• Health Centre / GP Surgeries / Emergency
Services

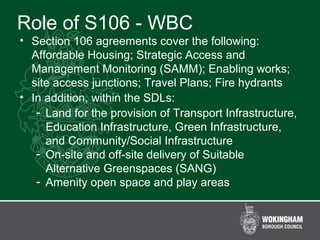

Role of S106 - WBC
• Section 106 agreements cover the following:
Affordable Housing; Strategic Access and
Management Monitoring (SAMM); Enabling works;
site access junctions; Travel Plans; Fire hydrants
• In addition, within the SDLs:
- Land for the provision of Transport Infrastructure,
Education Infrastructure, Green Infrastructure,
and Community/Social Infrastructure
- On-site and off-site delivery of Suitable
Alternative Greenspaces (SANG)
- Amenity open space and play areas

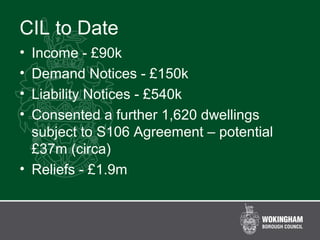

CIL to Date
• Income - £90k
• Demand Notices - £150k
• Liability Notices - £540k
• Consented a further 1,620 dwellings
subject to S106 Agreement – potential
£37m (circa)
• Reliefs - £1.9m

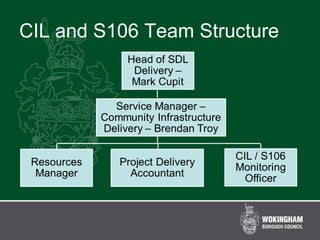

CIL and S106 Team Structure
CIL Administration in WBC
• Business support – Identify CIL liable
applications, upload forms, send follow up
letters, measure plans using .pdf software
• Planning officers – minimal role - attach
informatives, advise on approximate liability
• CIL team – Issue liability / demand notices
(invoices) / process reliefs / notify land charges /
CIL Appeals / allocate funds
• Finance – invoices / debt recovery
• Infrastructure Finance Board
CIL Administration in WBC
• Lack of understanding – small developers
and agents in particular
• So many forms!
• Assumption of Liability is not a validation
requirement
• Extensions over 100sq.m – there are a lot
of them in WBC - heavy on admin / no CIL
• Extensions relief – principal residence

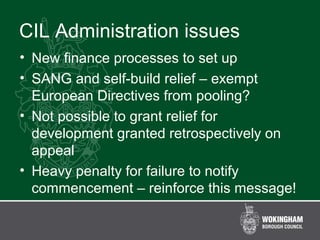

CIL Administration issues
• New finance processes to set up
• SANG and self-build relief – exempt
European Directives from pooling?
• Not possible to grant relief for
development granted retrospectively on
appeal
• Heavy penalty for failure to notify
commencement – reinforce this message!
CIL Administration in WBC

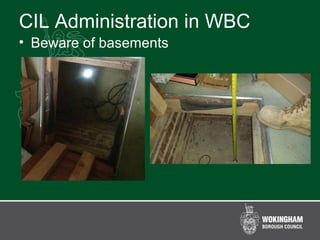

• Beware of basements

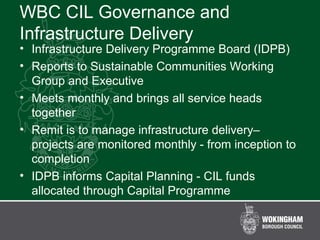

WBC CIL Governance and
Infrastructure Delivery
• Infrastructure Delivery Programme Board (IDPB)
• Reports to Sustainable Communities Working
Group and Executive
• Meets monthly and brings all service heads
together
• Remit is to manage infrastructure delivery–
projects are monitored monthly - from inception to
completion
• IDPB informs Capital Planning - CIL funds
allocated through Capital Programme

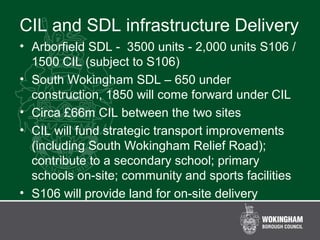

CIL and SDL infrastructure Delivery
• Arborfield SDL - 3500 units - 2,000 units S106 /
1500 CIL (subject to S106)
• South Wokingham SDL – 650 under
construction, 1850 will come forward under CIL
• Circa £66m CIL between the two sites
• CIL will fund strategic transport improvements
(including South Wokingham Relief Road);
contribute to a secondary school; primary
schools on-site; community and sports facilities
• S106 will provide land for on-site delivery

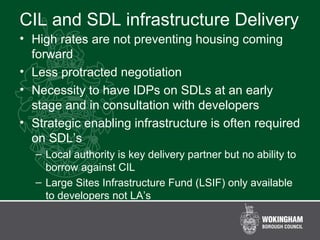

CIL and SDL infrastructure Delivery
• High rates are not preventing housing coming
forward
• Less protracted negotiation
• Necessity to have IDPs on SDLs at an early
stage and in consultation with developers
• Strategic enabling infrastructure is often required
on SDL’s
– Local authority is key delivery partner but no ability to
borrow against CIL
– Large Sites Infrastructure Fund (LSIF) only available
to developers not LA’s

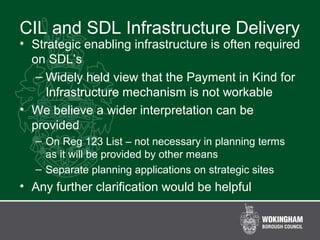

CIL and SDL Infrastructure Delivery
• Strategic enabling infrastructure is often required
on SDL’s
– Widely held view that the Payment in Kind for
Infrastructure mechanism is not workable
• We believe a wider interpretation can be
provided
– On Reg 123 List – not necessary in planning terms
as it will be provided by other means
– Separate planning applications on strategic sites
• Any further clarification would be helpful
WBC Meaningful Proportion
• 17 Parishes – 3 Parishes will benefit from 99%
of WBC ‘CIL Topslice’
• Small organisations which lack staff / knowledge
/ skills to prioritise / commission / finance to deal
with large amounts of infrastructure funding
• Significant drain on SDL infrastructure packages
on sites that affect more than one Parish
• WBC working very closely with Parishes

Shared priorities /
responsibilities

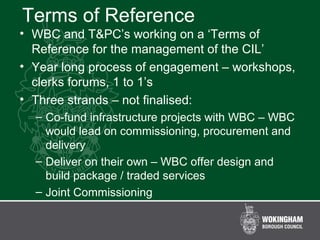

Terms of Reference
• WBC and T&PC’s working on a ‘Terms of
Reference for the management of the CIL’
• Year long process of engagement – workshops,
clerks forums, 1 to 1’s
• Three strands – not finalised:
– Co-fund infrastructure projects with WBC – WBC
would lead on commissioning, procurement and
delivery
– Deliver on their own – WBC offer design and
build package / traded services
– Joint Commissioning
Questions?
