Brimsdown Maintenance
June 2015
2 HONEYWELL - CONFIDENTIAL File Number

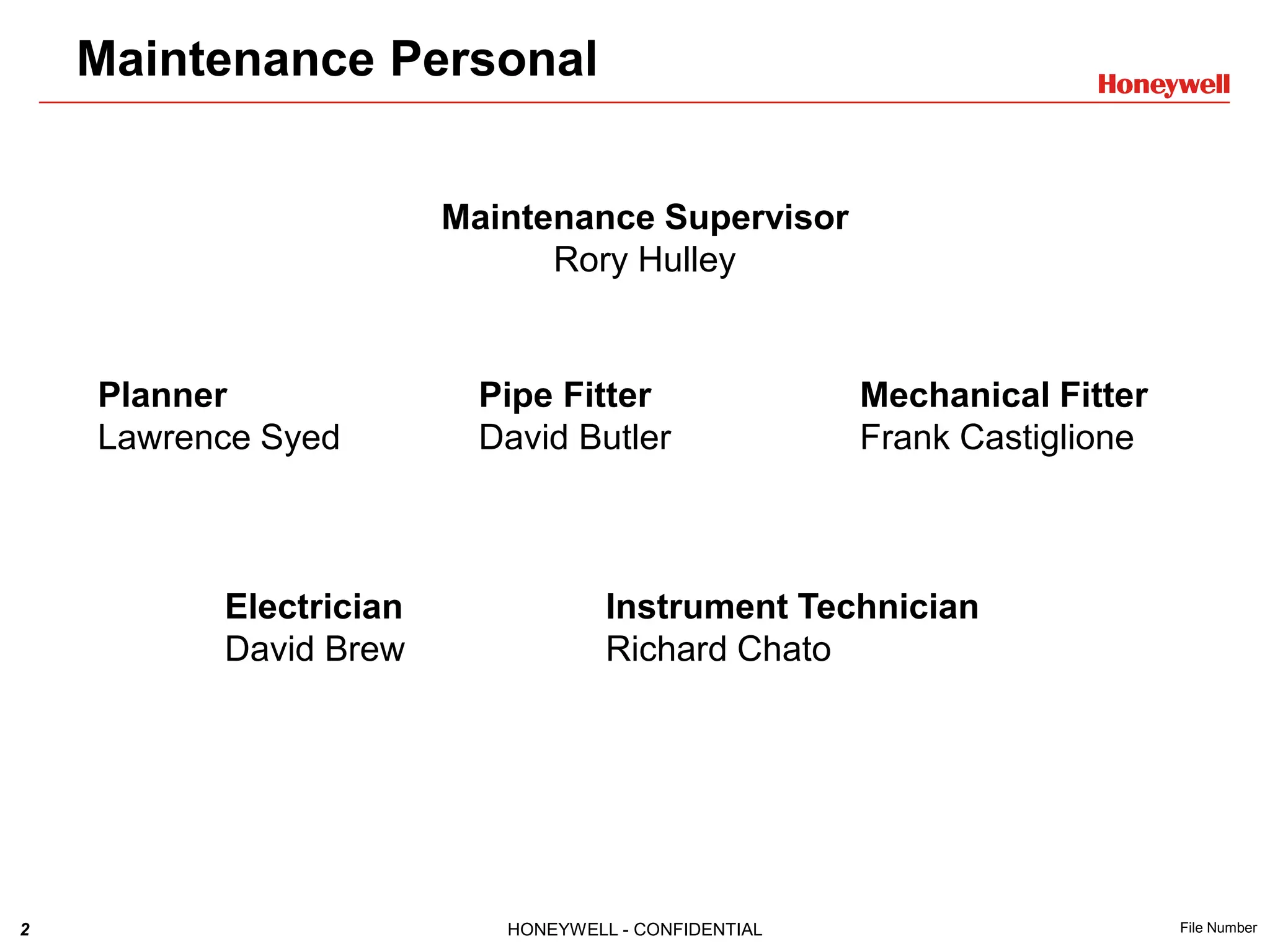

Maintenance Personal
Maintenance Supervisor
Rory Hulley
Planner Pipe Fitter Mechanical Fitter
Lawrence Syed David Butler Frank Castiglione
Electrician Instrument Technician
David Brew Richard Chato
3 HONEYWELL - CONFIDENTIAL File Number

Strategy Deployment TTI Chart

January was a bad month due to the breakdown of 30-K-04 - the circulation fan on Zone 2 in
the furnace broke down. This fans had not been balanced or serviced for several years. They
have now been put on yearly test inspection and balancing PM’s. 30-K-04 is scheduled to be
overhauled in the shutdown this year (2015) and 30-K-03 in the shutdown next year (2016).
Maintenance Key Improvement Processes
0
10
20
30
40
37
5
9
6.5
9.5
BreakdownPercentage
Rate
Months
Monthly Breakdown Downtime Rate 2015
Downtime
% Rate
Target
Rate
20%
4 HONEYWELL - CONFIDENTIAL File Number
The last few months have been better and this is due to the hard work and dedication of the
Maintenance Team, and the cooperation of the Operators.
Maintenance Key Improvement Processes
5 HONEYWELL - CONFIDENTIAL File Number

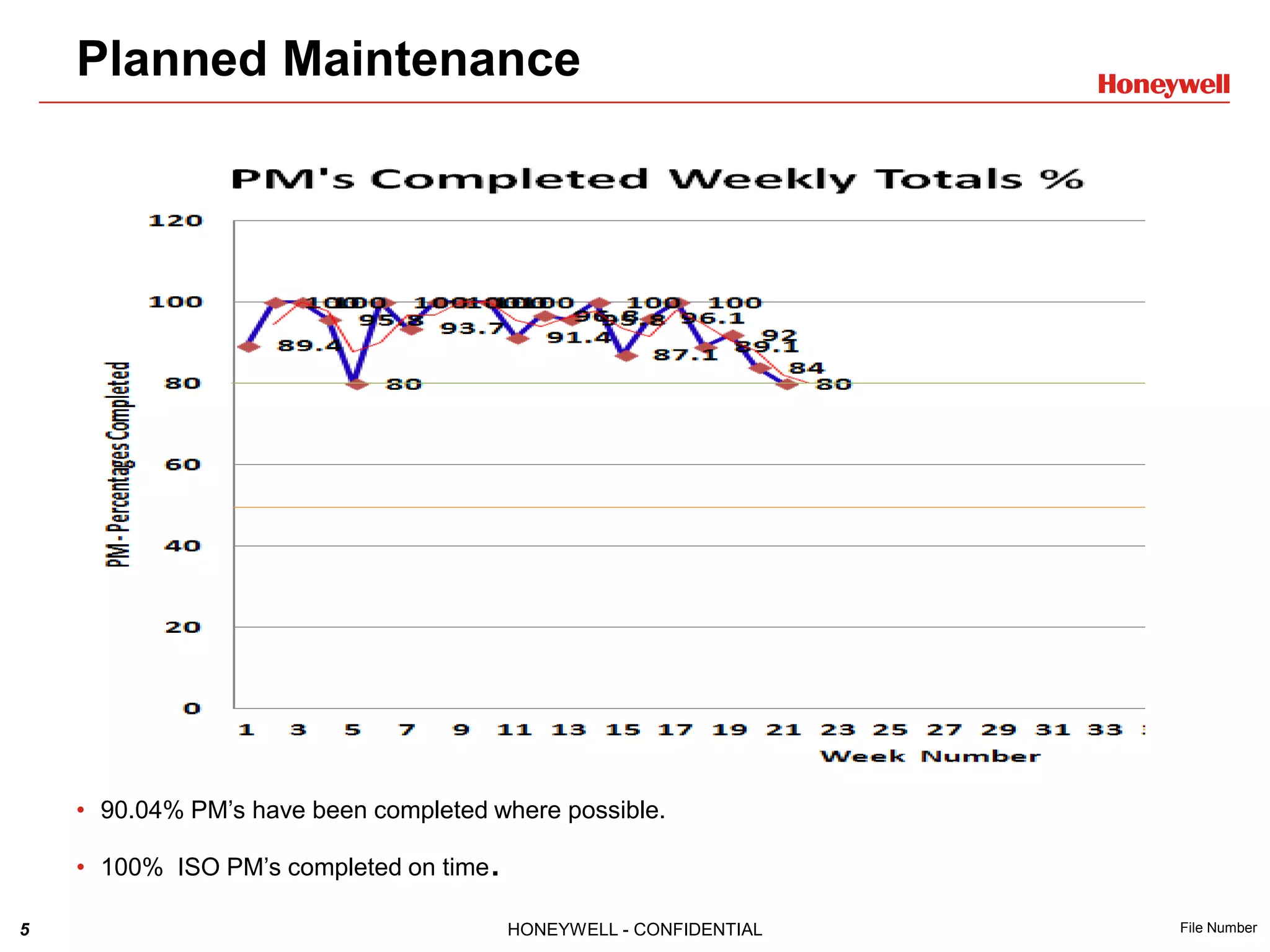

• 90.04% PM’s have been completed where possible.
• 100% ISO PM’s completed on time.
Planned Maintenance
6 HONEYWELL - CONFIDENTIAL File Number
Completed 2015

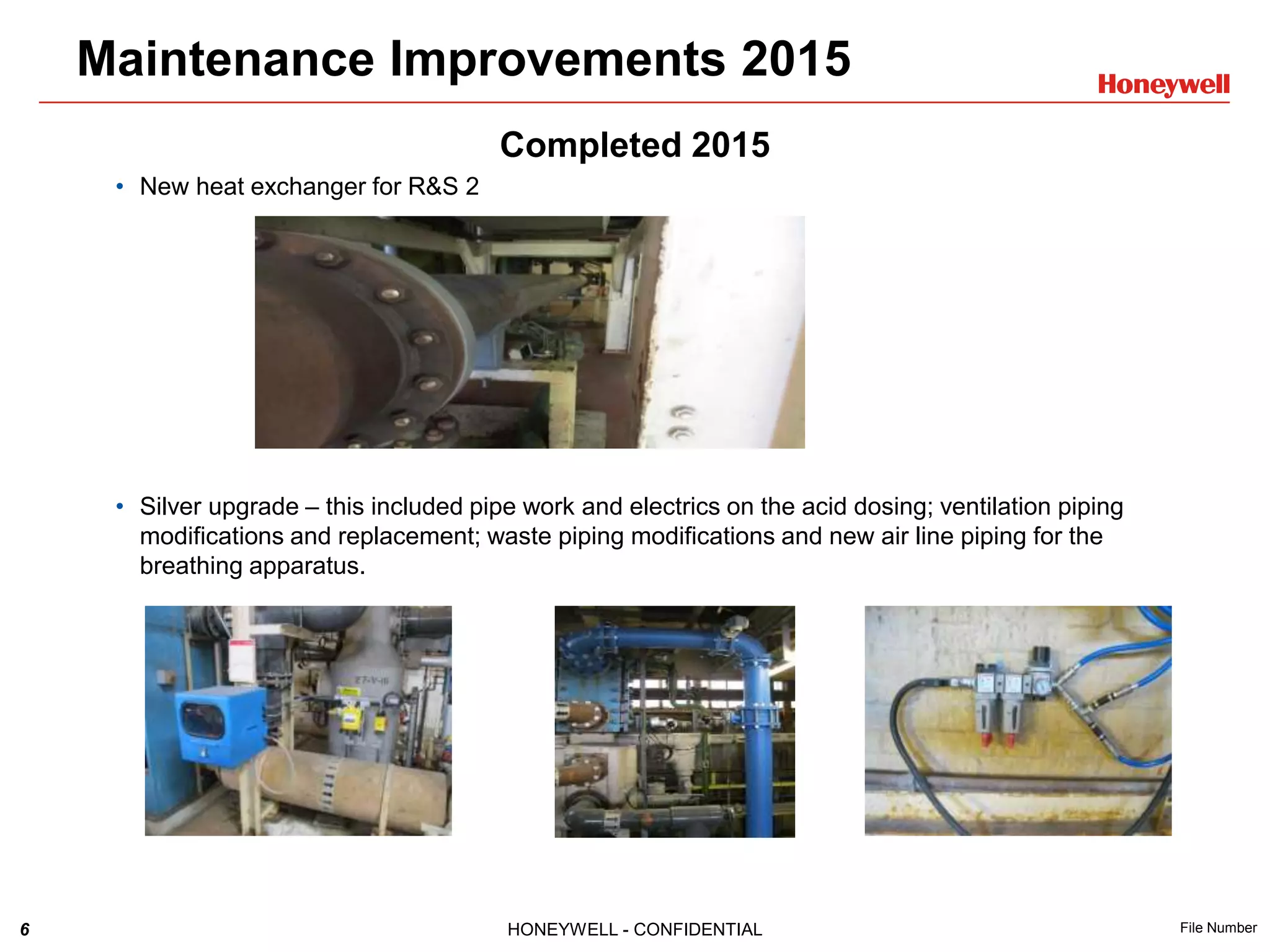

• New heat exchanger for R&S 2
• Silver upgrade – this included pipe work and electrics on the acid dosing; ventilation piping
modifications and replacement; waste piping modifications and new air line piping for the
breathing apparatus.
Maintenance Improvements 2015
7 HONEYWELL - CONFIDENTIAL File Number

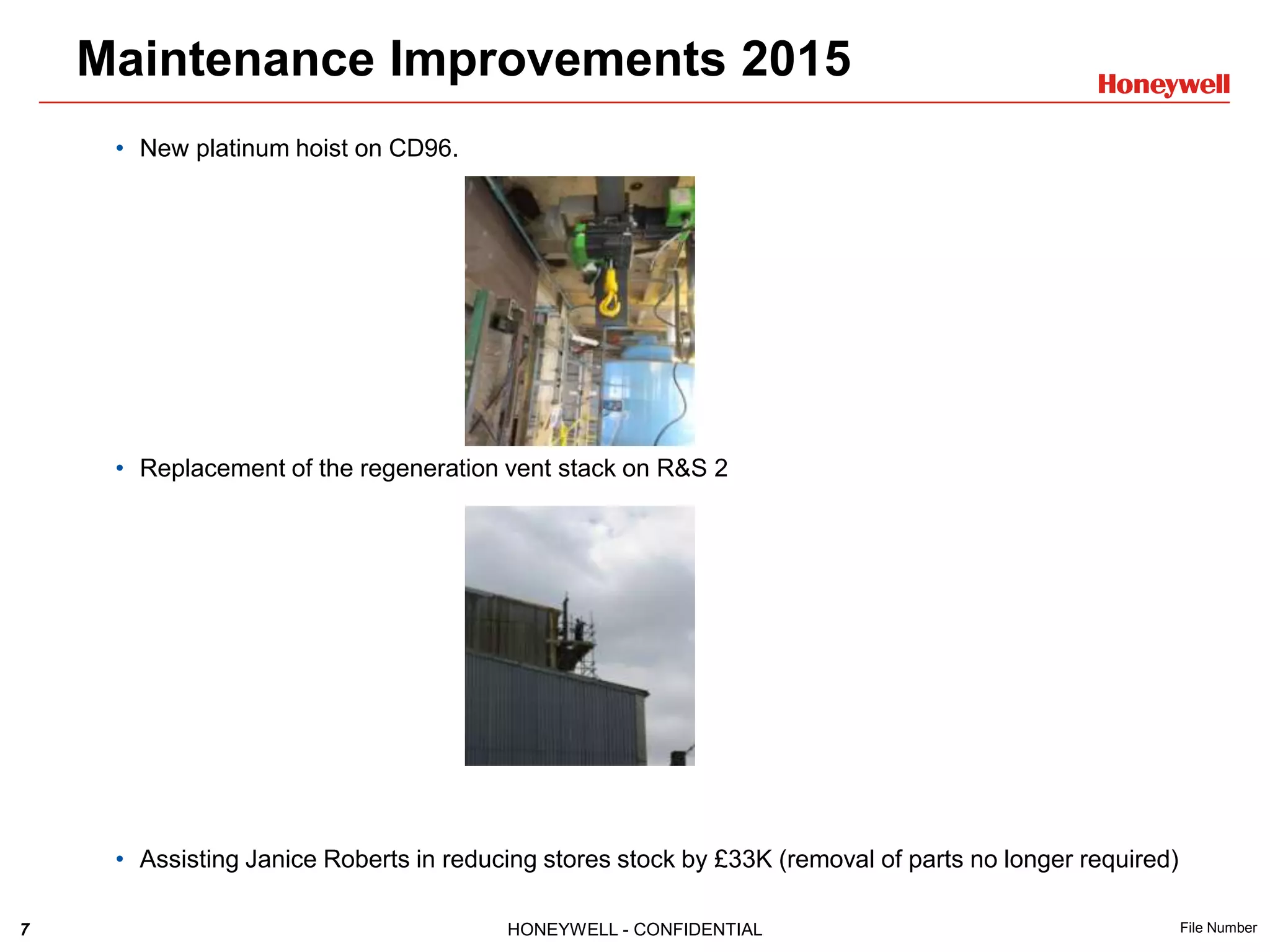

• New platinum hoist on CD96.
• Replacement of the regeneration vent stack on R&S 2
• Assisting Janice Roberts in reducing stores stock by £33K (removal of parts no longer required)
Maintenance Improvements 2015
8 HONEYWELL - CONFIDENTIAL File Number
Plans for the remainder of 2015
• Shutdown 2015
• New hoist fitted R&S 2
• Honeywell Control System upgrade to PC’s and work stations
• New gears for 27-V-02 CD96 number 2 evaporator

• Overhaul of 30-K-04
• Other work in progress
• Upgrade silver rig pump electrics to include a variable speed drive.
• Implement sight glass inspections (SAP completed)
• Install and commission the new O2 H2 analyser on R&S 2.
Maintenance Improvements 2015
9 HONEYWELL - CONFIDENTIAL File Number

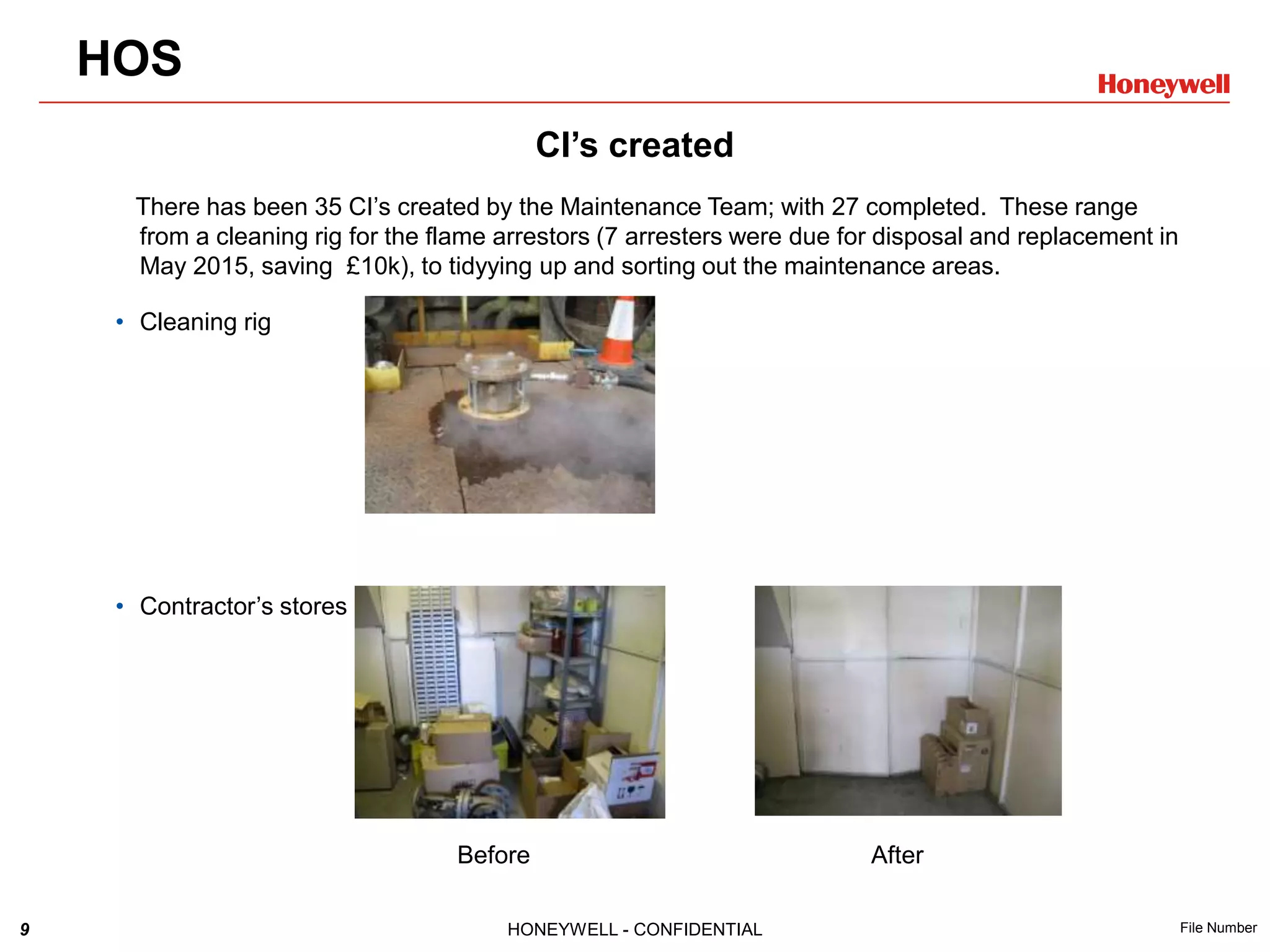

CI’s created
There has been 35 CI’s created by the Maintenance Team; with 27 completed. These range
from a cleaning rig for the flame arrestors (7 arresters were due for disposal and replacement in
May 2015, saving £10k), to tidyying up and sorting out the maintenance areas.
• Cleaning rig
• Contractor’s stores
Before After
HOS
10 HONEYWELL - CONFIDENTIAL File Number
4 Kaizens events this year

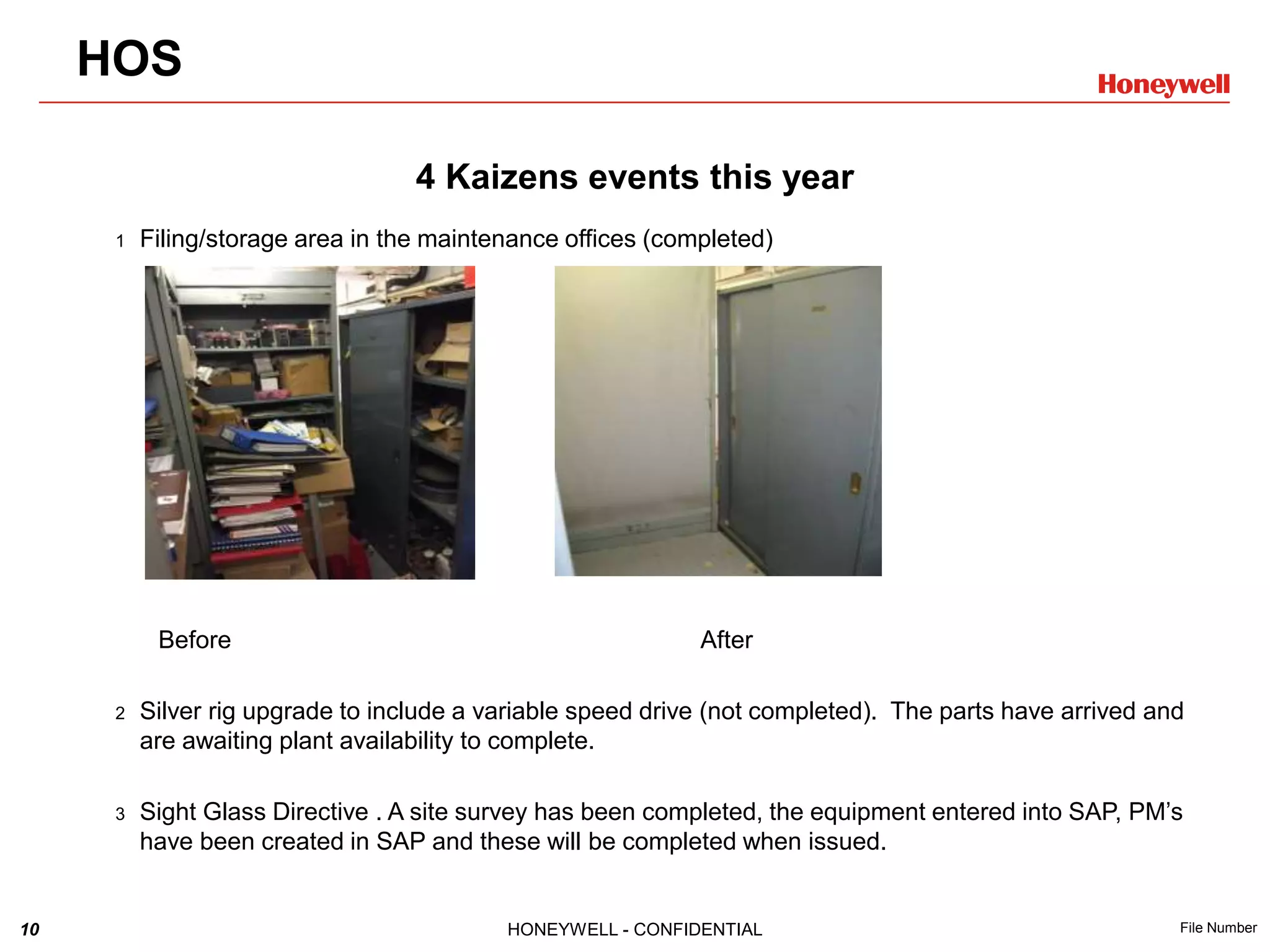

1 Filing/storage area in the maintenance offices (completed)
Before After
2 Silver rig upgrade to include a variable speed drive (not completed). The parts have arrived and
are awaiting plant availability to complete.
3 Sight Glass Directive . A site survey has been completed, the equipment entered into SAP, PM’s
have been created in SAP and these will be completed when issued.
HOS
11 HONEYWELL - CONFIDENTIAL File Number

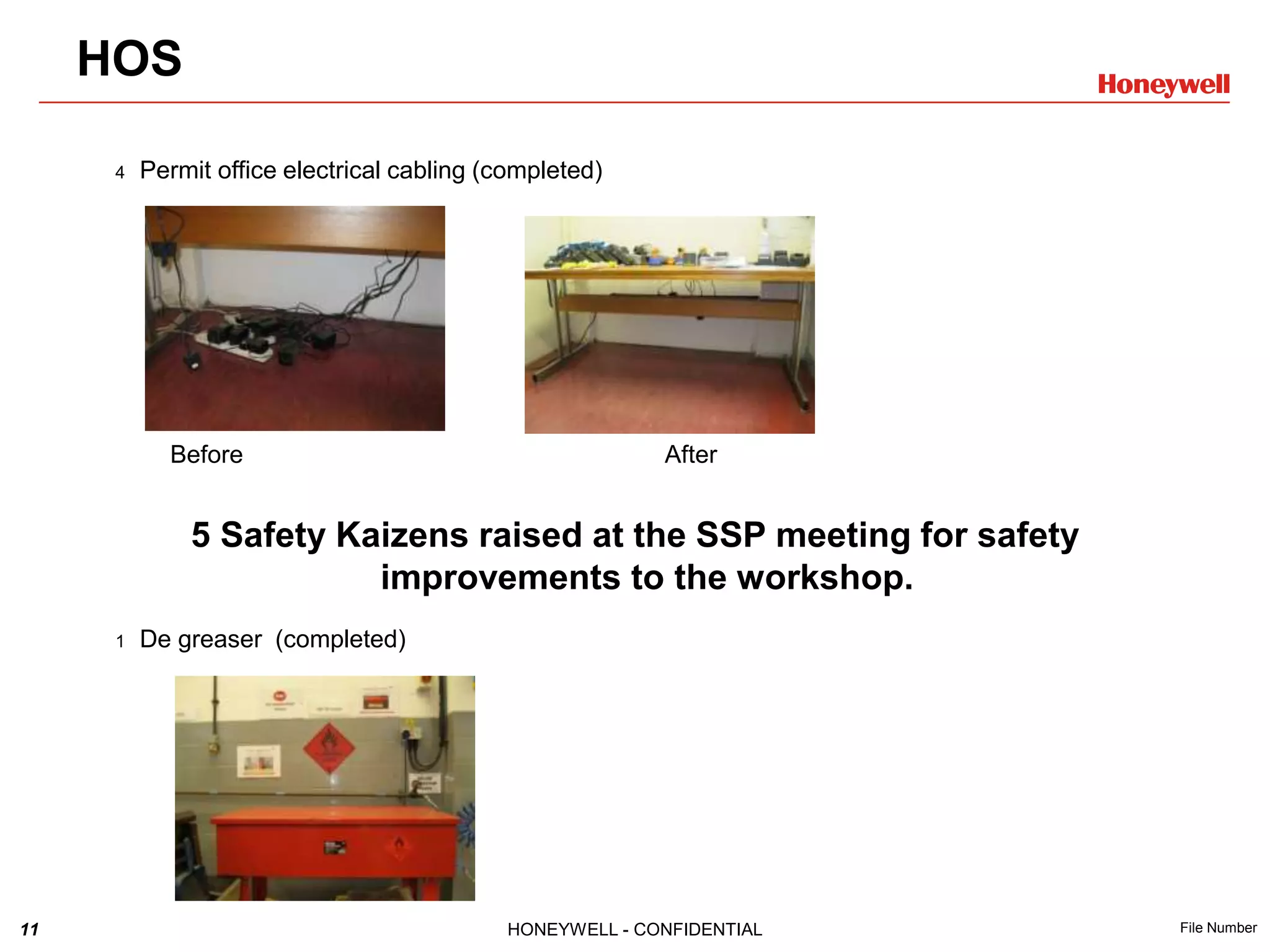

4 Permit office electrical cabling (completed)
Before After
5 Safety Kaizens raised at the SSP meeting for safety
improvements to the workshop.
1 De greaser (completed)
HOS
12 HONEYWELL - CONFIDENTIAL File Number

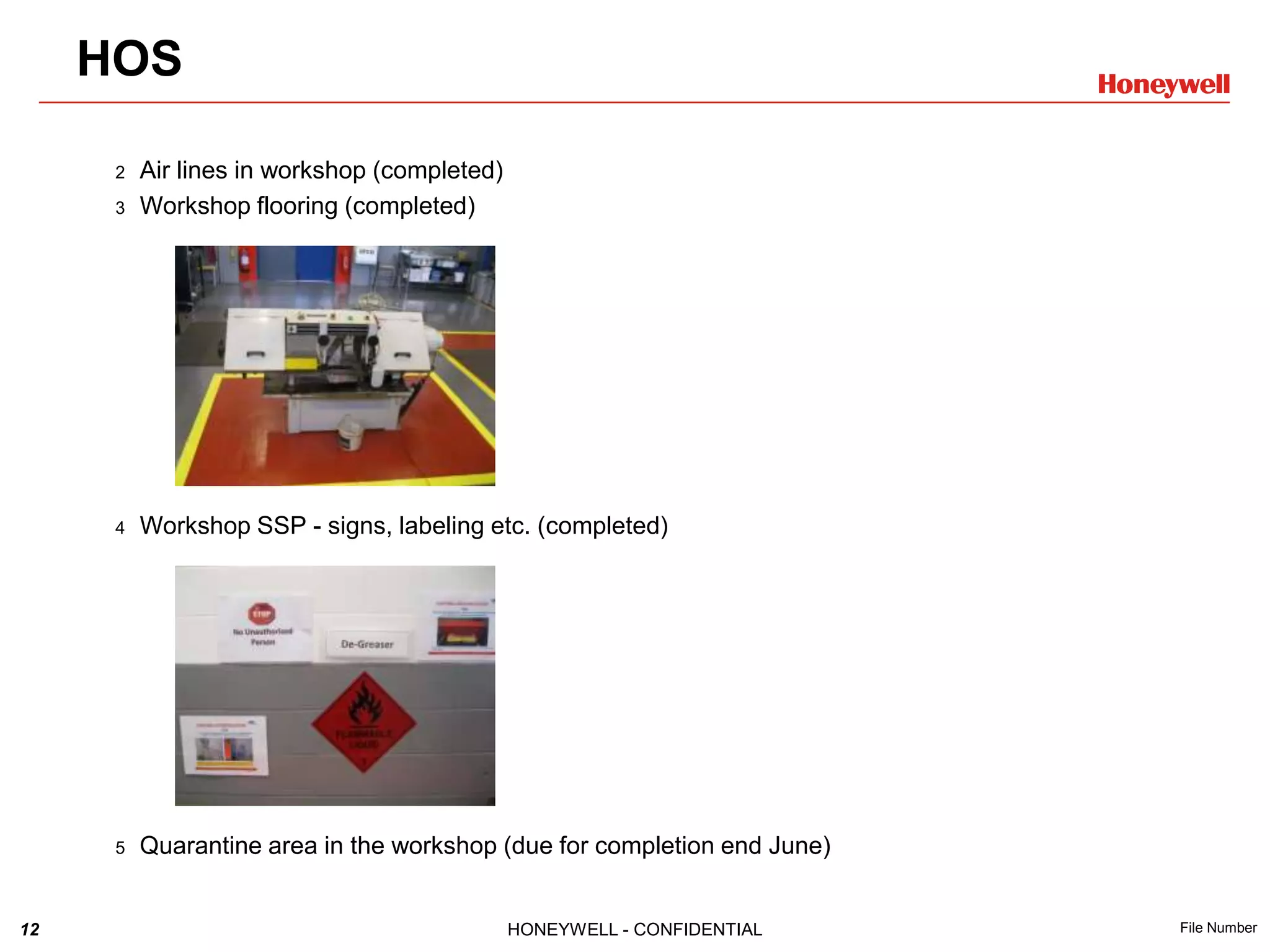

2 Air lines in workshop (completed)
3 Workshop flooring (completed)
4 Workshop SSP - signs, labeling etc. (completed)
5 Quarantine area in the workshop (due for completion end June)
HOS
13 HONEYWELL - CONFIDENTIAL File Number

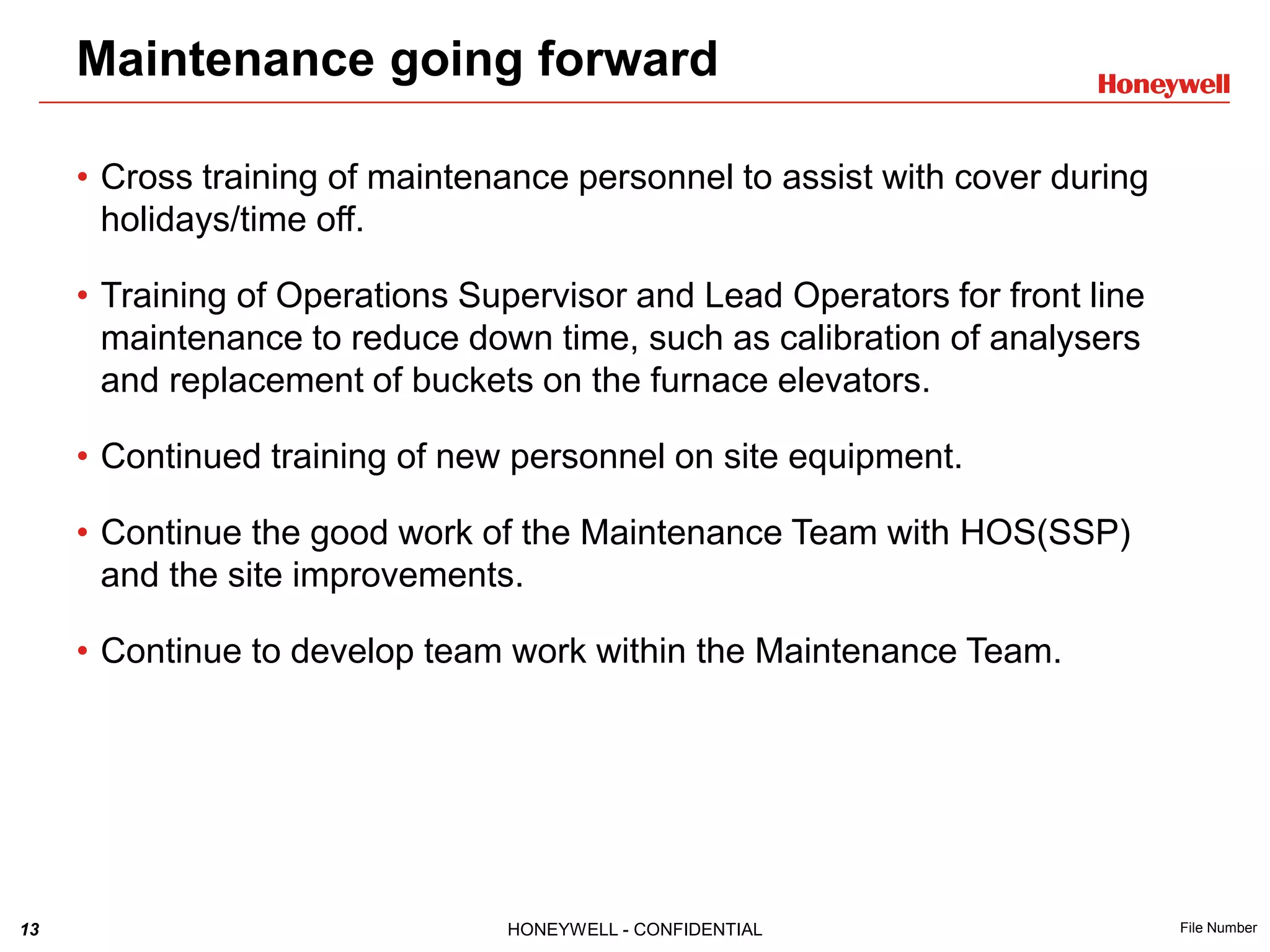

Maintenance going forward
• Cross training of maintenance personnel to assist with cover during
holidays/time off.
• Training of Operations Supervisor and Lead Operators for front line
maintenance to reduce down time, such as calibration of analysers
and replacement of buckets on the furnace elevators.
• Continued training of new personnel on site equipment.
• Continue the good work of the Maintenance Team with HOS(SSP)
and the site improvements.
• Continue to develop team work within the Maintenance Team.

Maintenance presentation 2015

  • 1.
  • 2.
    2 HONEYWELL -CONFIDENTIAL File Number Maintenance Personal Maintenance Supervisor Rory Hulley Planner Pipe Fitter Mechanical Fitter Lawrence Syed David Butler Frank Castiglione Electrician Instrument Technician David Brew Richard Chato
  • 3.
    3 HONEYWELL -CONFIDENTIAL File Number Strategy Deployment TTI Chart January was a bad month due to the breakdown of 30-K-04 - the circulation fan on Zone 2 in the furnace broke down. This fans had not been balanced or serviced for several years. They have now been put on yearly test inspection and balancing PM’s. 30-K-04 is scheduled to be overhauled in the shutdown this year (2015) and 30-K-03 in the shutdown next year (2016). Maintenance Key Improvement Processes 0 10 20 30 40 37 5 9 6.5 9.5 BreakdownPercentage Rate Months Monthly Breakdown Downtime Rate 2015 Downtime % Rate Target Rate 20%
  • 4.
    4 HONEYWELL -CONFIDENTIAL File Number The last few months have been better and this is due to the hard work and dedication of the Maintenance Team, and the cooperation of the Operators. Maintenance Key Improvement Processes
  • 5.
    5 HONEYWELL -CONFIDENTIAL File Number • 90.04% PM’s have been completed where possible. • 100% ISO PM’s completed on time. Planned Maintenance
  • 6.
    6 HONEYWELL -CONFIDENTIAL File Number Completed 2015 • New heat exchanger for R&S 2 • Silver upgrade – this included pipe work and electrics on the acid dosing; ventilation piping modifications and replacement; waste piping modifications and new air line piping for the breathing apparatus. Maintenance Improvements 2015
  • 7.
    7 HONEYWELL -CONFIDENTIAL File Number • New platinum hoist on CD96. • Replacement of the regeneration vent stack on R&S 2 • Assisting Janice Roberts in reducing stores stock by £33K (removal of parts no longer required) Maintenance Improvements 2015
  • 8.
    8 HONEYWELL -CONFIDENTIAL File Number Plans for the remainder of 2015 • Shutdown 2015 • New hoist fitted R&S 2 • Honeywell Control System upgrade to PC’s and work stations • New gears for 27-V-02 CD96 number 2 evaporator • Overhaul of 30-K-04 • Other work in progress • Upgrade silver rig pump electrics to include a variable speed drive. • Implement sight glass inspections (SAP completed) • Install and commission the new O2 H2 analyser on R&S 2. Maintenance Improvements 2015
  • 9.
    9 HONEYWELL -CONFIDENTIAL File Number CI’s created There has been 35 CI’s created by the Maintenance Team; with 27 completed. These range from a cleaning rig for the flame arrestors (7 arresters were due for disposal and replacement in May 2015, saving £10k), to tidyying up and sorting out the maintenance areas. • Cleaning rig • Contractor’s stores Before After HOS
  • 10.
    10 HONEYWELL -CONFIDENTIAL File Number 4 Kaizens events this year 1 Filing/storage area in the maintenance offices (completed) Before After 2 Silver rig upgrade to include a variable speed drive (not completed). The parts have arrived and are awaiting plant availability to complete. 3 Sight Glass Directive . A site survey has been completed, the equipment entered into SAP, PM’s have been created in SAP and these will be completed when issued. HOS
  • 11.
    11 HONEYWELL -CONFIDENTIAL File Number 4 Permit office electrical cabling (completed) Before After 5 Safety Kaizens raised at the SSP meeting for safety improvements to the workshop. 1 De greaser (completed) HOS
  • 12.
    12 HONEYWELL -CONFIDENTIAL File Number 2 Air lines in workshop (completed) 3 Workshop flooring (completed) 4 Workshop SSP - signs, labeling etc. (completed) 5 Quarantine area in the workshop (due for completion end June) HOS
  • 13.
    13 HONEYWELL -CONFIDENTIAL File Number Maintenance going forward • Cross training of maintenance personnel to assist with cover during holidays/time off. • Training of Operations Supervisor and Lead Operators for front line maintenance to reduce down time, such as calibration of analysers and replacement of buckets on the furnace elevators. • Continued training of new personnel on site equipment. • Continue the good work of the Maintenance Team with HOS(SSP) and the site improvements. • Continue to develop team work within the Maintenance Team.
