2
Test management: How to organize your
research and test campaign during the
feasibility study
CONFIDENTIAL
Frederik Mortier
Consultant applied physics & systems
frederik.mortier@verhaert.com
THEME 2: RISK MANAGEMENT IN INNOVATION
3
Frederik Mortier
Consultant Applied Physics & Systems 2012- now
Researcher @ Ghent University 2011-2012
MSc. in Engineering – Electro-Mechanical 2009-2011
MSc. in Industrial Sciences – Electro-Mechanical 2005-2009
frederik.mortier@verhaert.com
4
“A feasibility study is not only meant
to confirm a good idea…”
5
“…, it could also detect a bad idea!”
6
CONFIDENTIAL
Outline
7

Outline
 Context within NPD
 Problems & Risks
 Efficient Test Approach
 Conclusion
8
CONFIDENTIAL
Context within NPD
9
Concept
Design &
Development
Production
Visualization Testing Simulation Review
Quick&Dirty Detailed Conclusion
Utility Allowability Desirability Feasibility Usability
When
What
How
Context within NPD
10

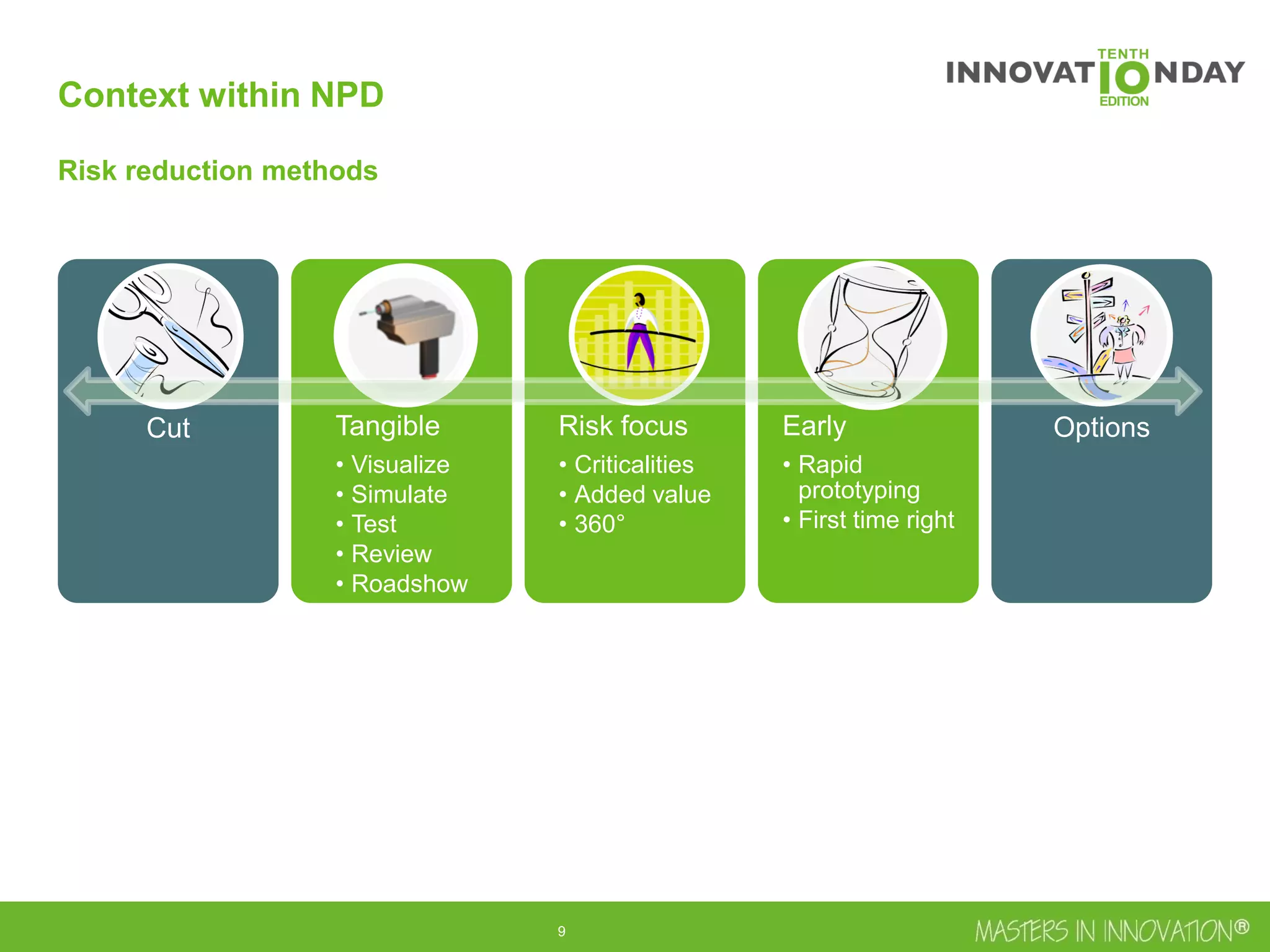

Cut Tangible
• Visualize
• Simulate
• Test
• Review
• Roadshow
Risk focus
• Criticalities
• Added value
• 360°
Early
• Rapid
prototyping
• First time right
Options
Context within NPD
Risk reduction methods
11

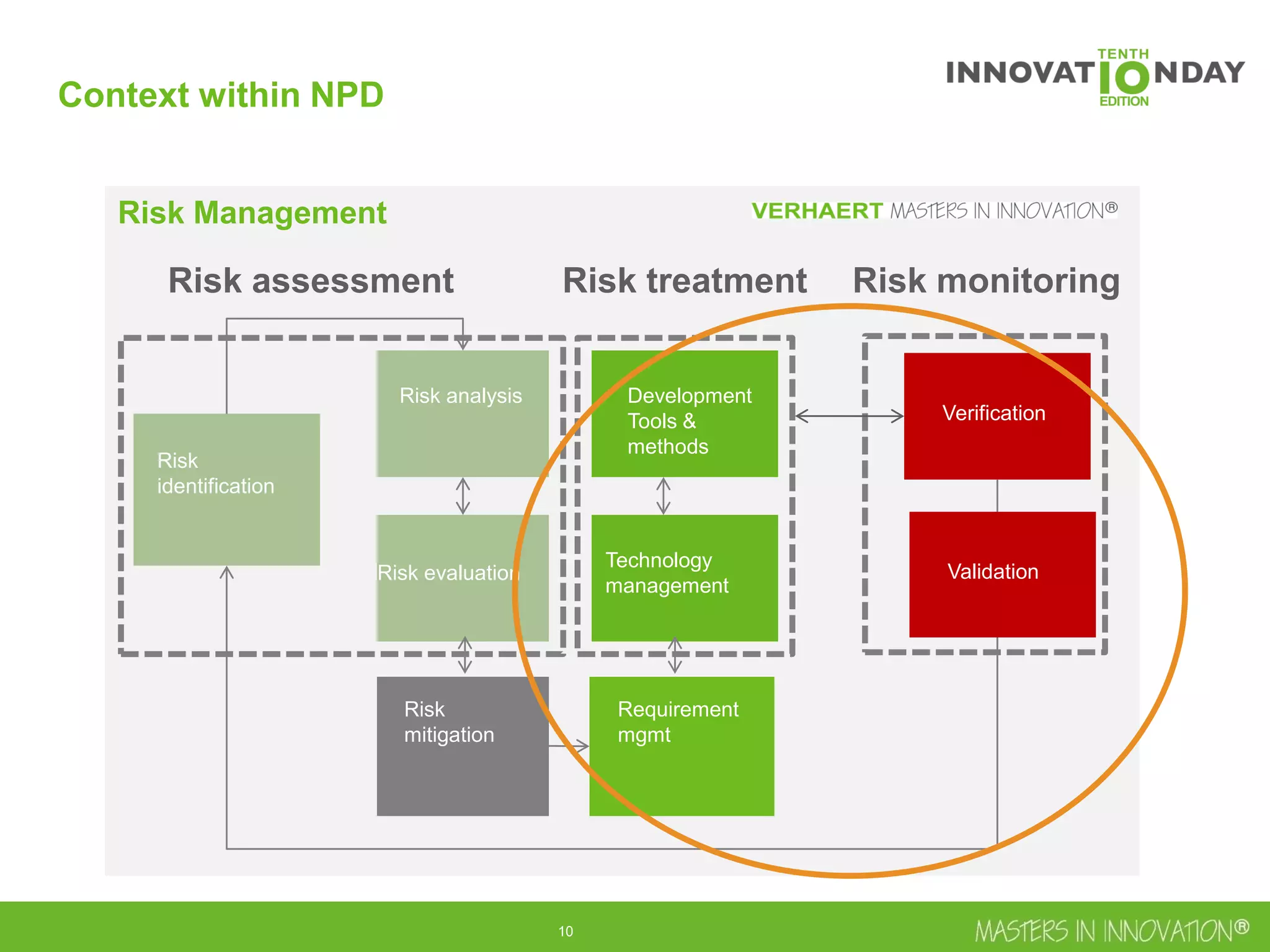

Risk Management
Risk
identification
Risk analysis
Risk evaluation
Technology
management
Development
Tools &
methods
Verification
Risk
mitigation
Requirement
mgmt
Risk assessment Risk treatment Risk monitoring
Validation
Context within NPD
12
Why Feasibility Study?
Investigate feasibility of the idea in the application
•Confirm / deny added value
•Determine required costs
By determining:
Feasibility
Study
Strengths
vs.
Weaknesses
Opportunities
vs. Threats
Needed
resources
Context within NPD
 Risk mitigation
13
Context within NPD

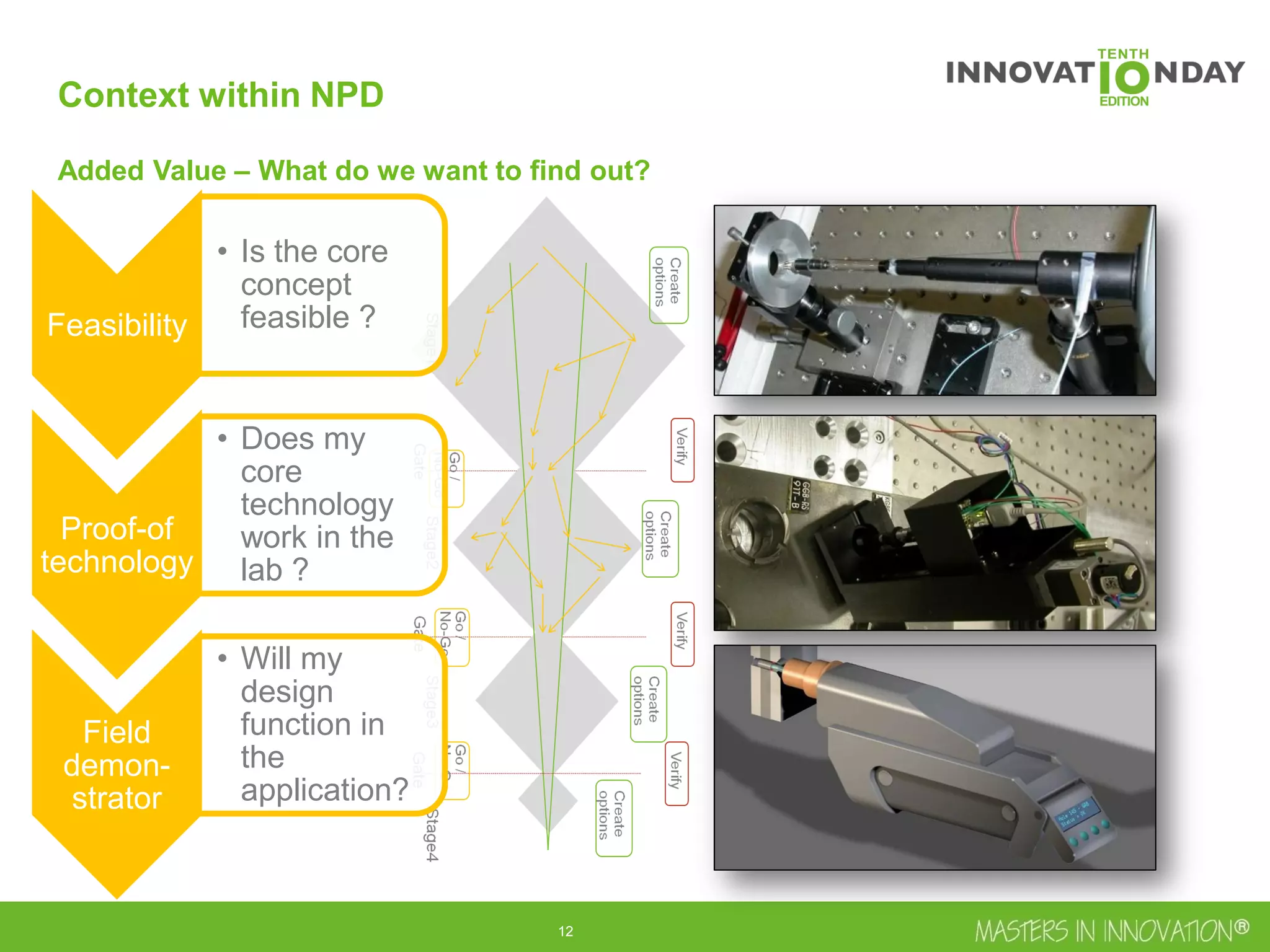

Added Value – What do we want to find out?
Feasibility
• Is the core
concept
feasible ?
Proof-of
technology
• Does my
core
technology
work in the
lab ?
Field
demon-
strator
• Will my
design
function in
the
application?
14

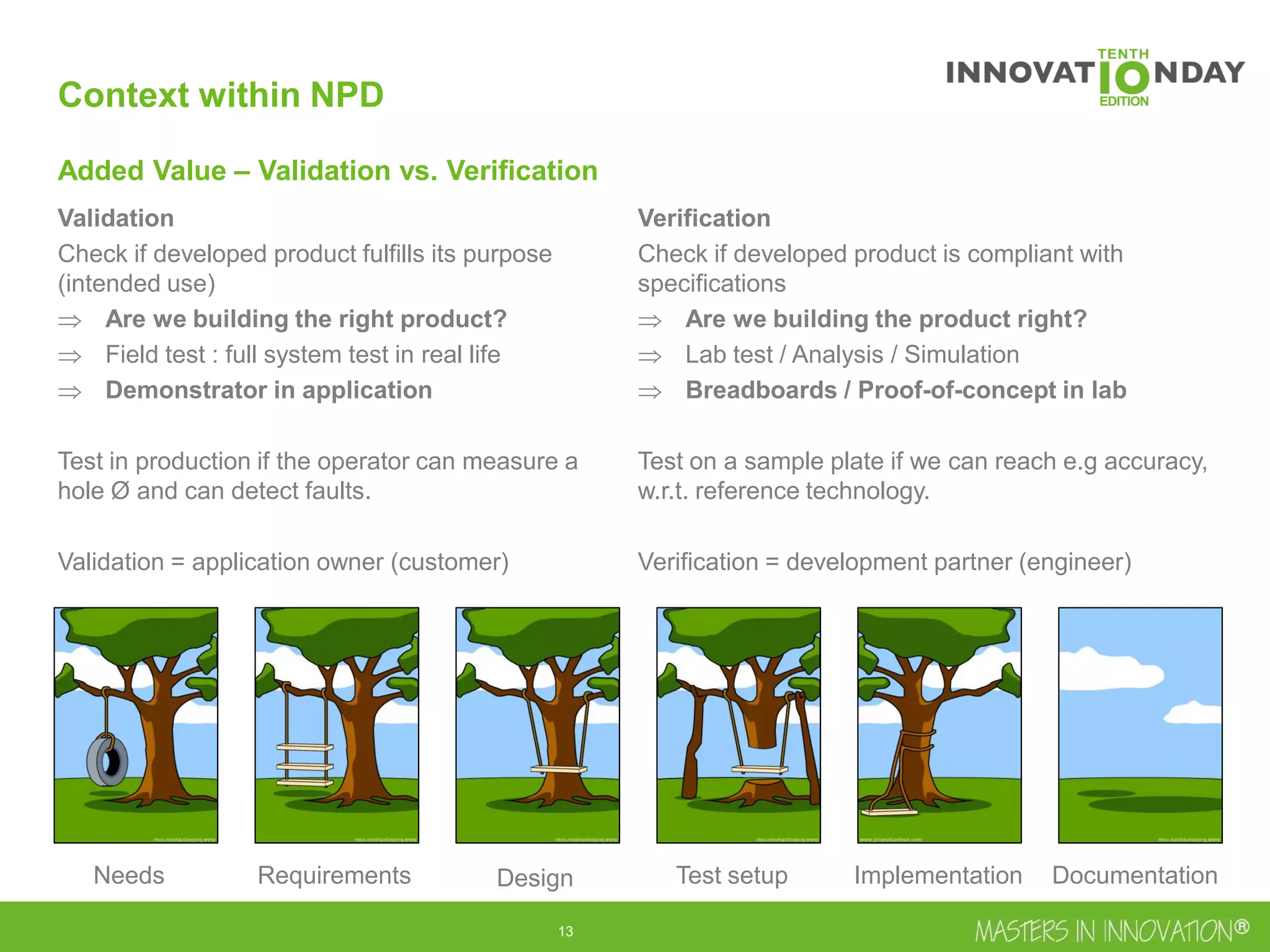

Context within NPD
Added Value – Validation vs. Verification
Needs Requirements Design Test setup Implementation Documentation
Validation
Check if developed product fulfills its purpose
(intended use)
 Are we building the right product?
 Field test : full system test in real life
 Demonstrator in application
Test in production if the operator can measure a
hole Ø and can detect faults.
Validation = application owner (customer)
Verification
Check if developed product is compliant with
specifications
 Are we building the product right?
 Lab test / Analysis / Simulation
 Breadboards / Proof-of-concept in lab
Test on a sample plate if we can reach e.g accuracy,
w.r.t. reference technology.
Verification = development partner (engineer)
15
Context within NPD

Cost Required
Why wait for the risk to come true ?
More freedom to adjust in early project phases
 Early detection of risk allows for measures at
lower cost and with less impact on schedule
Normal
Time
Learning curve
System specification
Conceptual design
Detailed design
Tooling / purchase
Integration
Test
Reversed
 Fail fast, fail cheap!
16
Context within NPD
Why Testing?
Different aspects of technical part of feasibility study:
•Better guarantee on final results
•Simulations often too complex/time consuming
•Sometimes fastest method
•New technologies need testing (no previous experience)
 Feasibility testing is done to learn!
 Avoid unnecessary testing  Example: blister packaging & NASA
Visualization Testing Simulation Review
17

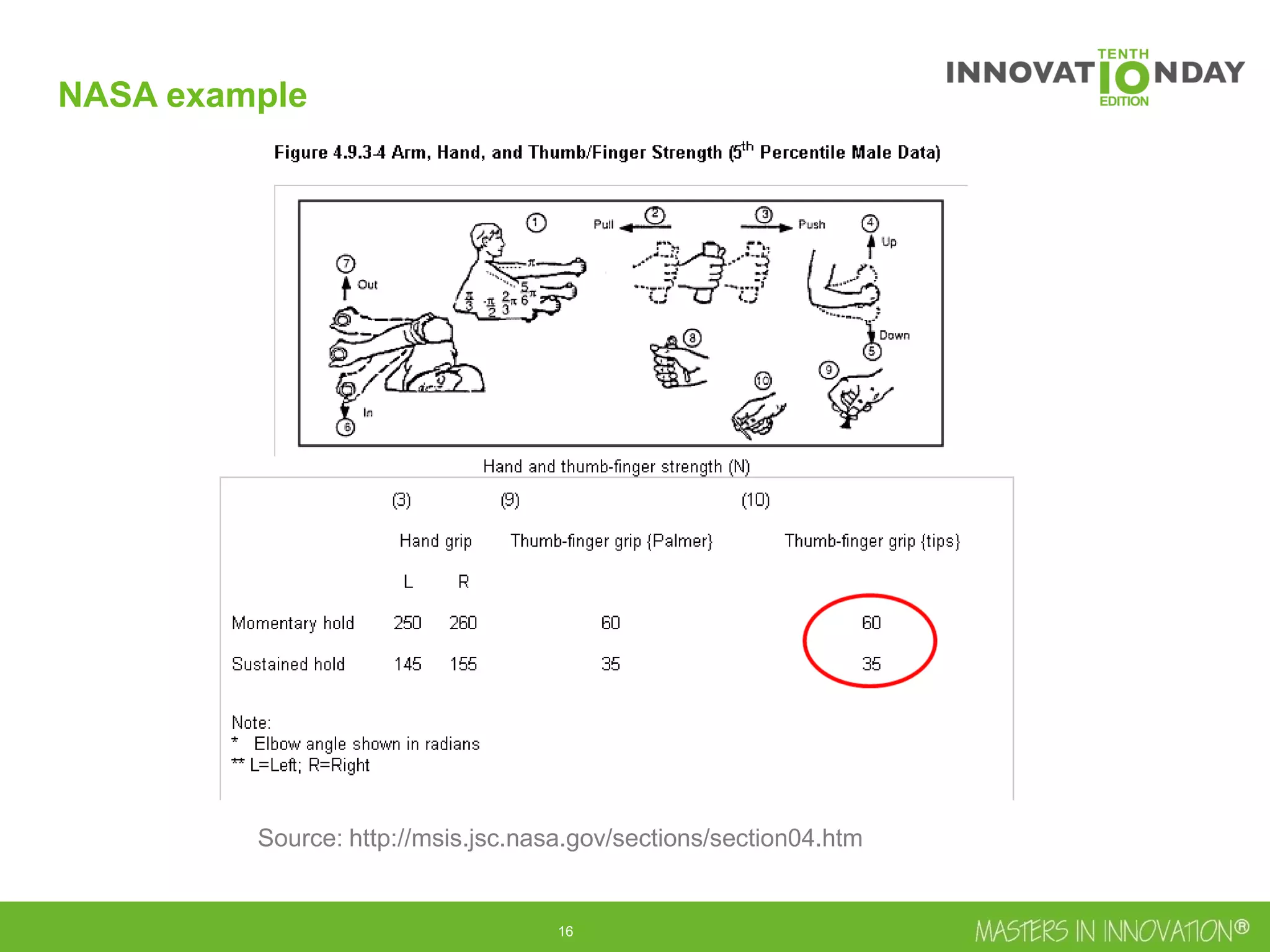

NASA example
Source: http://msis.jsc.nasa.gov/sections/section04.htm
18

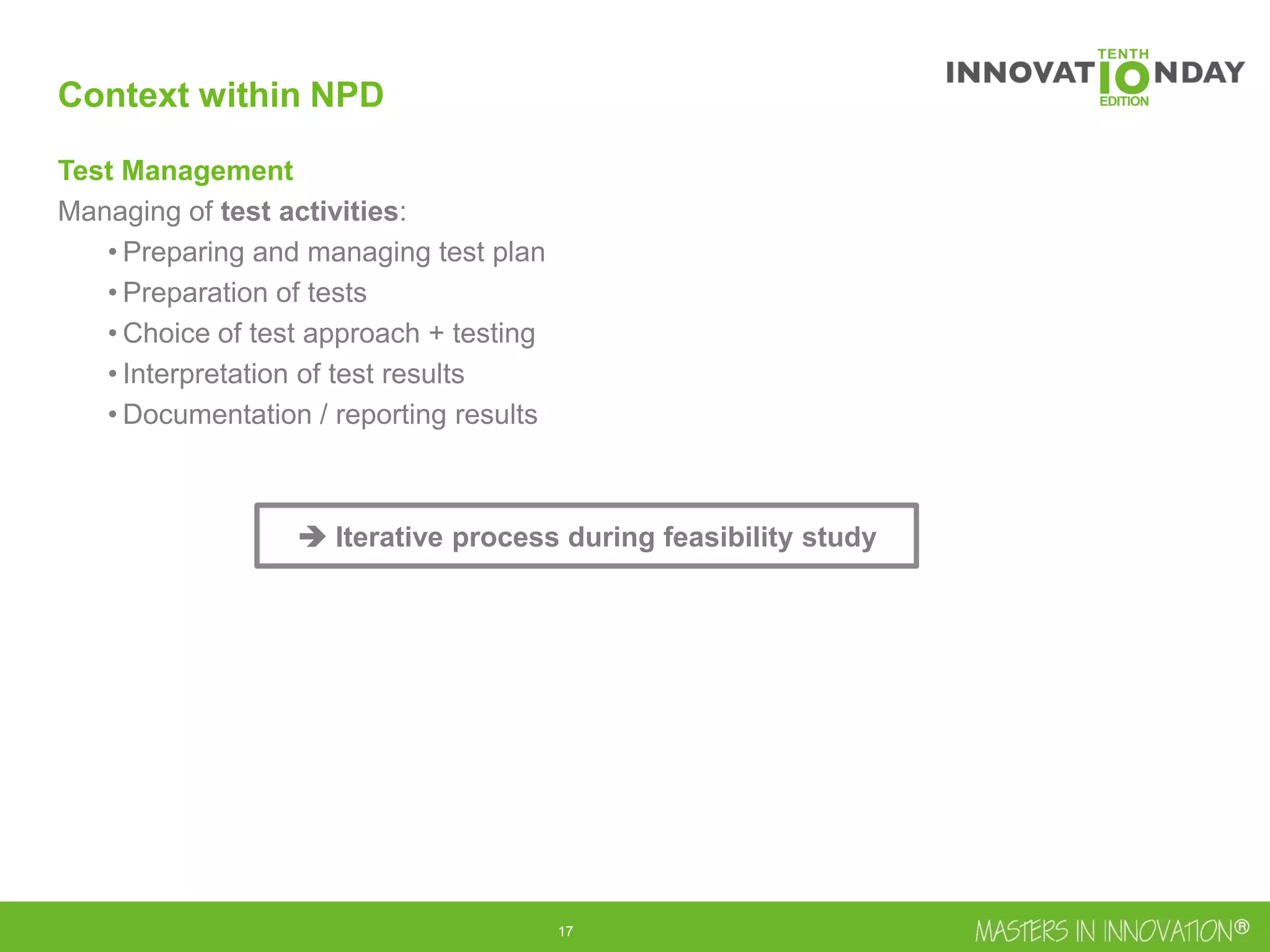

Context within NPD
Test Management
Managing of test activities:
• Preparing and managing test plan
• Preparation of tests
• Choice of test approach + testing
• Interpretation of test results
• Documentation / reporting results
 Iterative process during feasibility study
19
CONFIDENTIAL
Problems & Risks
20
Problems & Risks

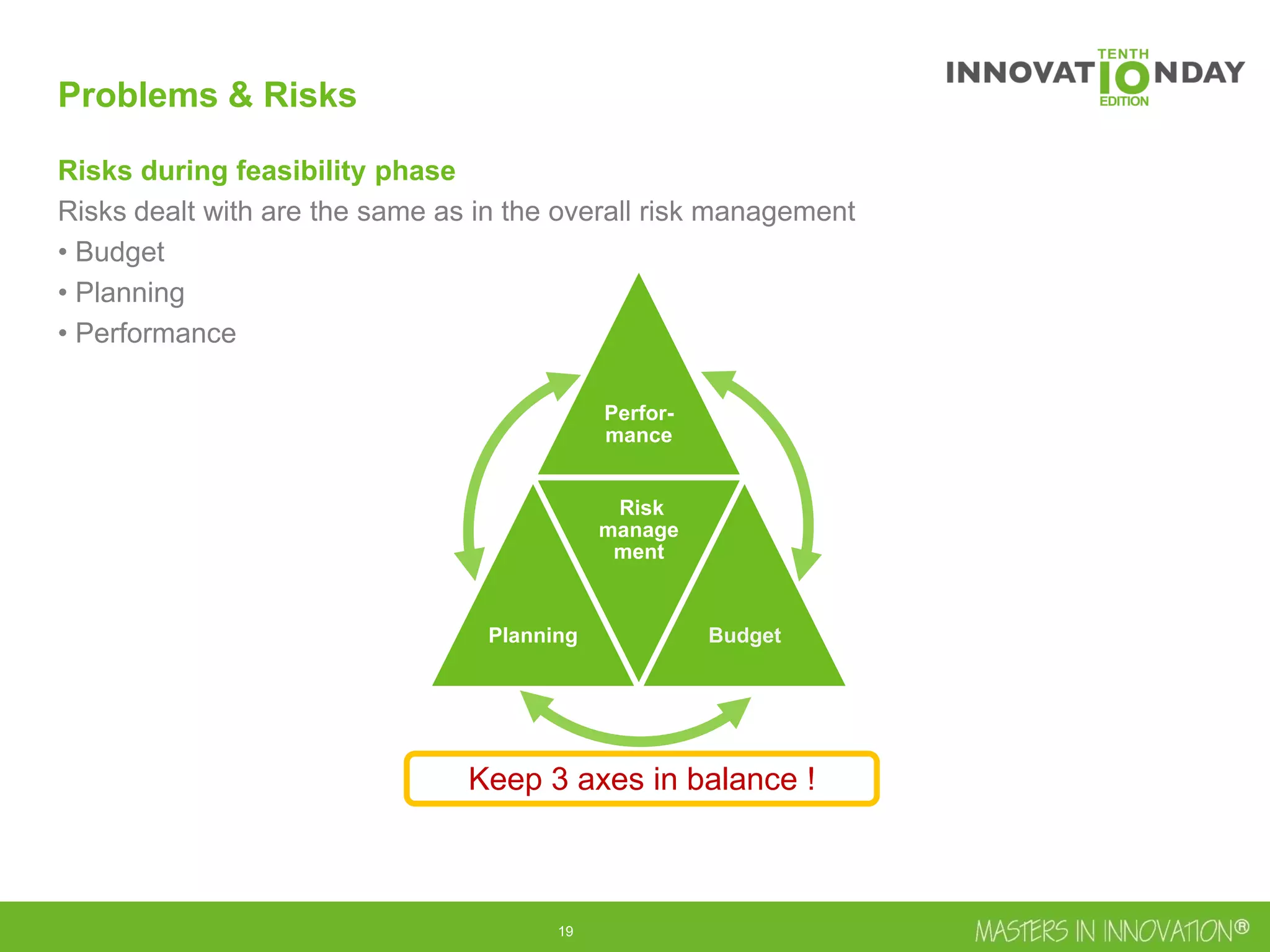

Risks during feasibility phase
Risks dealt with are the same as in the overall risk management
• Budget
• Planning
• Performance
Perfor-
mance
Planning
Risk
manage
ment
Budget
Keep 3 axes in balance !
21

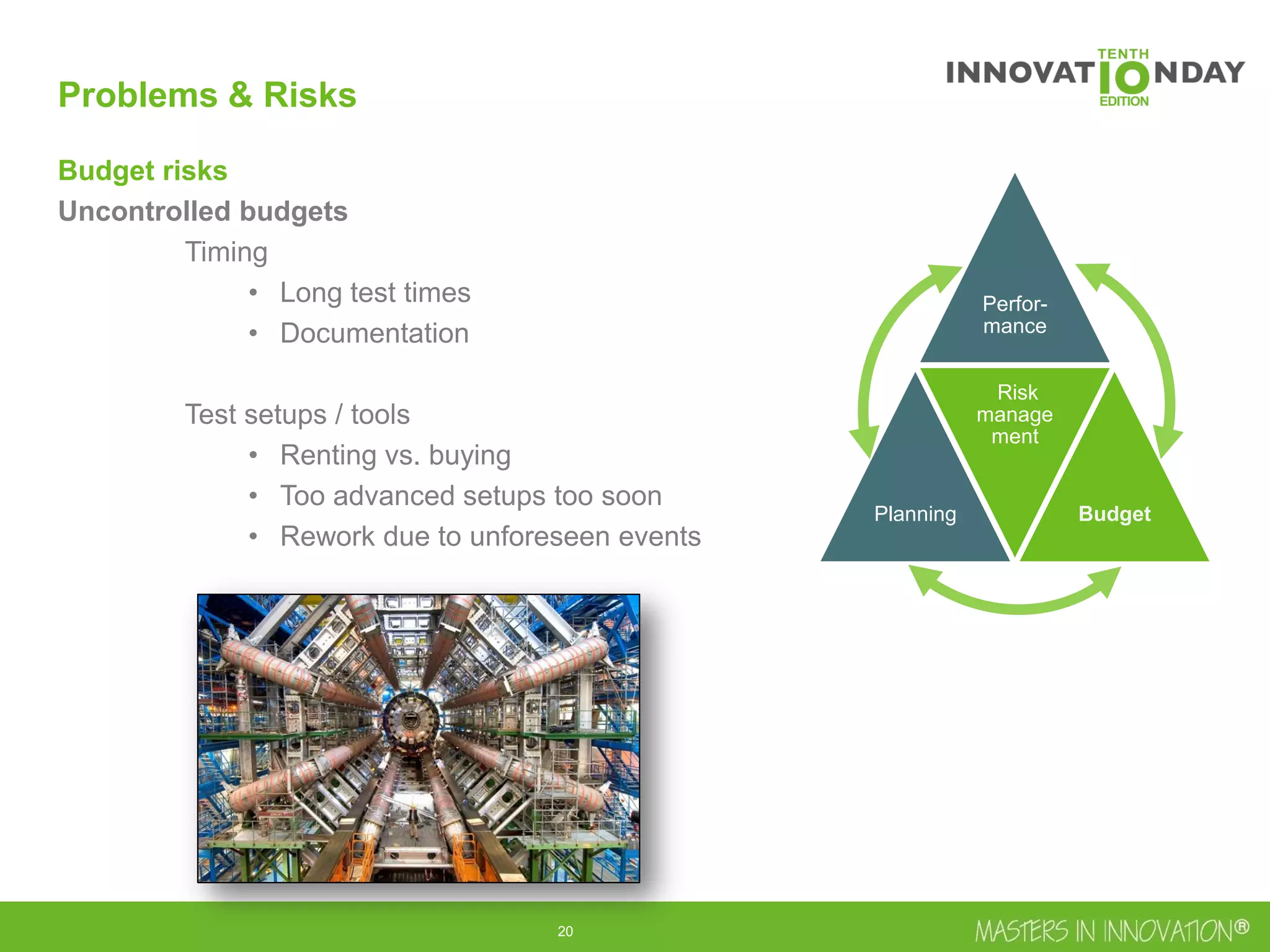

Budget risks
Uncontrolled budgets
Timing
• Long test times
• Documentation
Test setups / tools
• Renting vs. buying
• Too advanced setups too soon
• Rework due to unforeseen events
Perfor-
mance
Planning
Risk
manage
ment
Budget
Problems & Risks
22

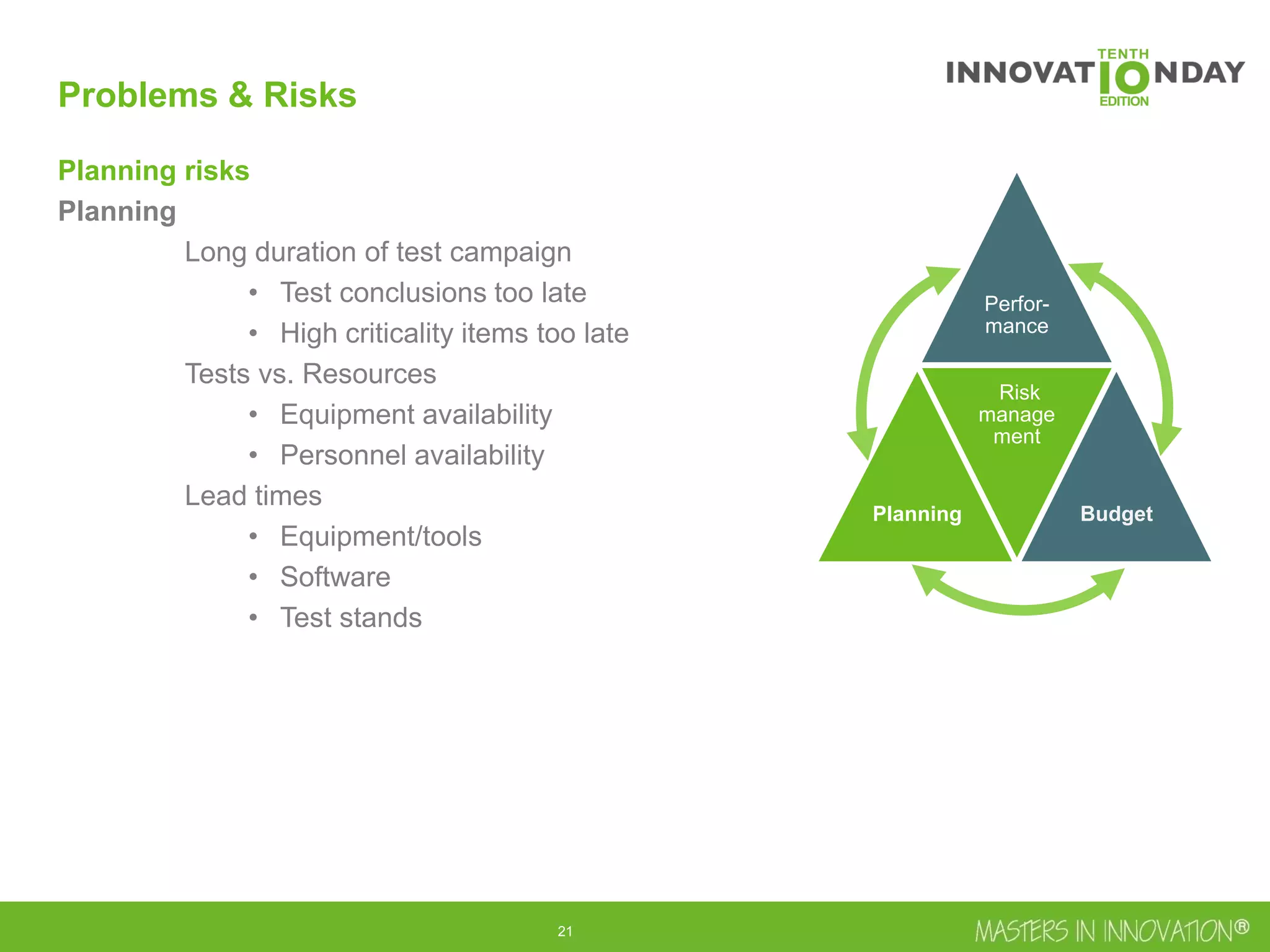

Planning risks
Planning
Long duration of test campaign
• Test conclusions too late
• High criticality items too late
Tests vs. Resources
• Equipment availability
• Personnel availability
Lead times
• Equipment/tools
• Software
• Test stands
Perfor-
mance
Planning
Risk
manage
ment
Budget
Problems & Risks
23

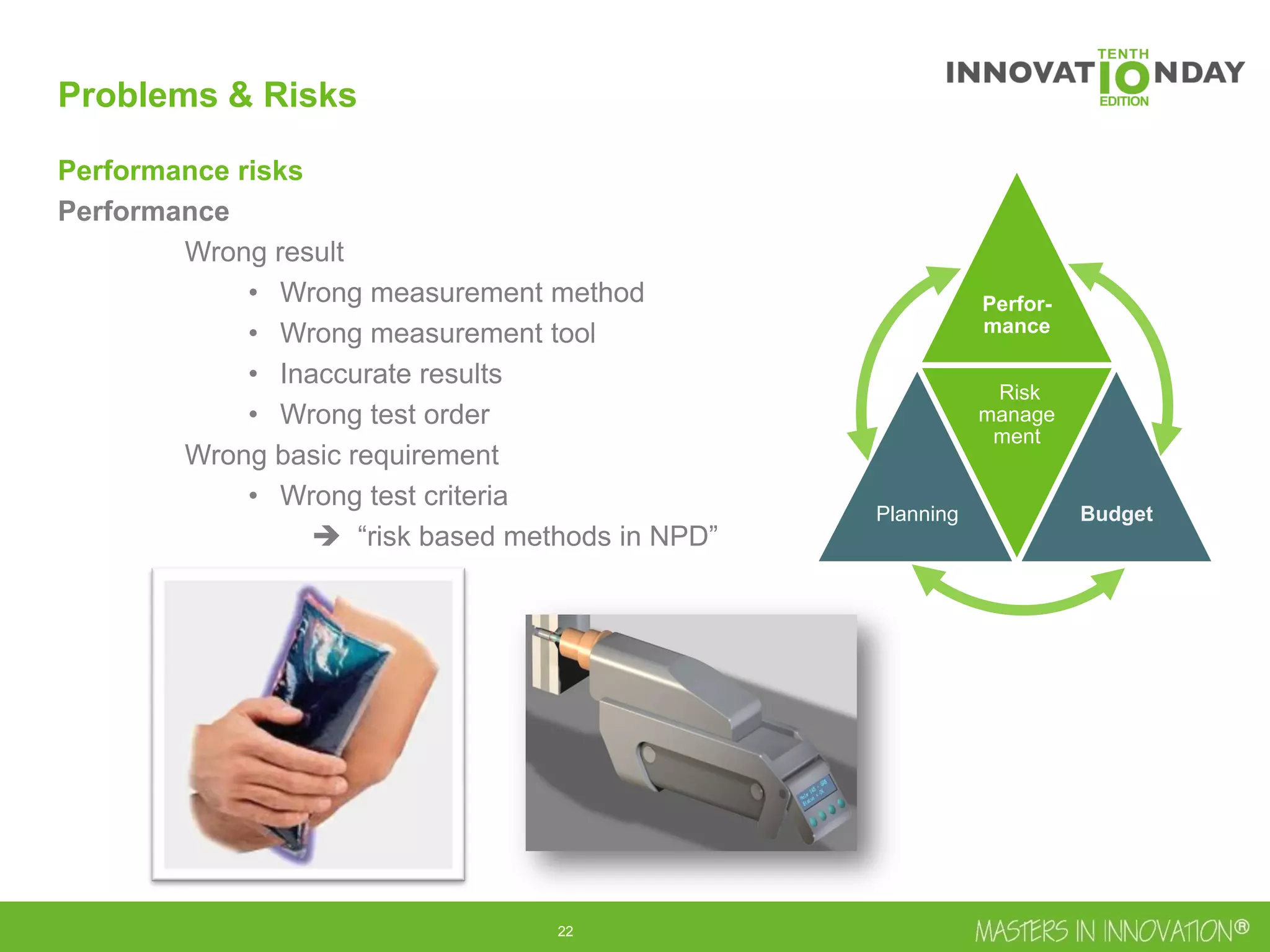

Performance risks
Performance
Wrong result
• Wrong measurement method
• Wrong measurement tool
• Inaccurate results
• Wrong test order
Wrong basic requirement
• Wrong test criteria
 “risk based methods in NPD”
Perfor-
mance
Planning
Risk
manage
ment
Budget
Problems & Risks
24
CONFIDENTIAL
Efficient Test Approach
25

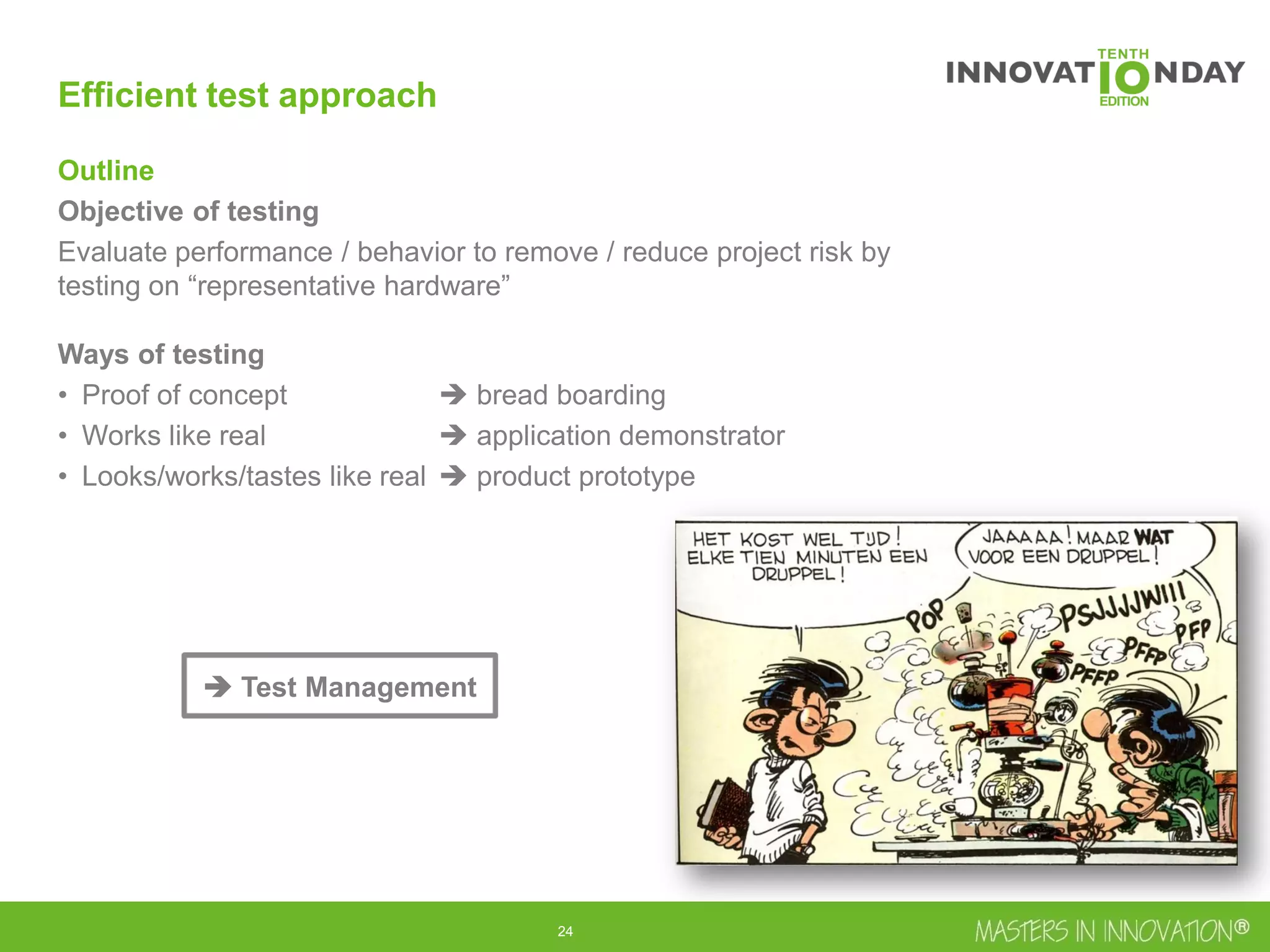

Outline
Objective of testing
Evaluate performance / behavior to remove / reduce project risk by
testing on “representative hardware”
Ways of testing
• Proof of concept  bread boarding
• Works like real  application demonstrator
• Looks/works/tastes like real  product prototype
Efficient test approach
 Test Management
26

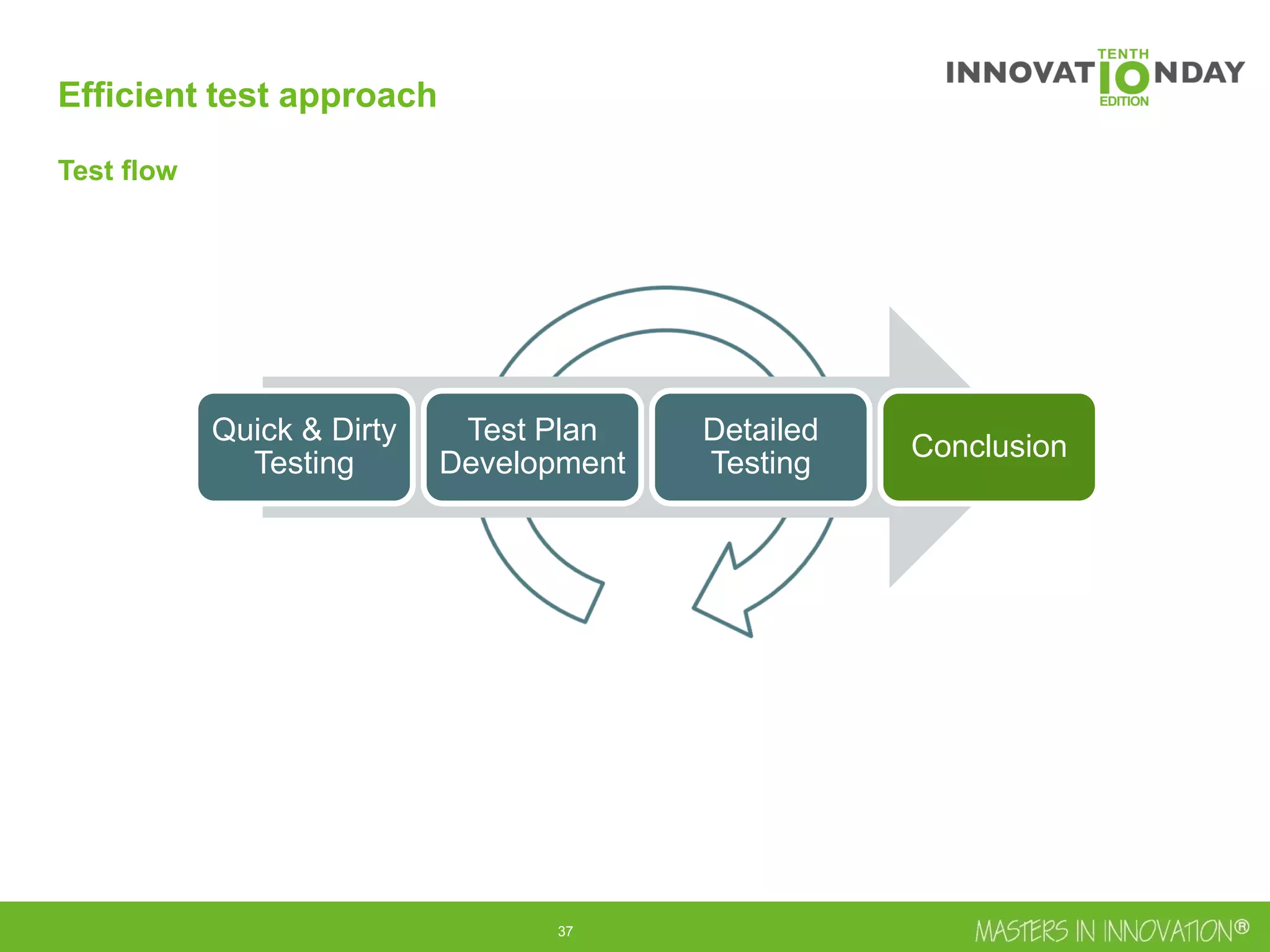

Quick & Dirty
Testing
Test Plan
Development
Detailed
Testing
Conclusion
Efficient test approach

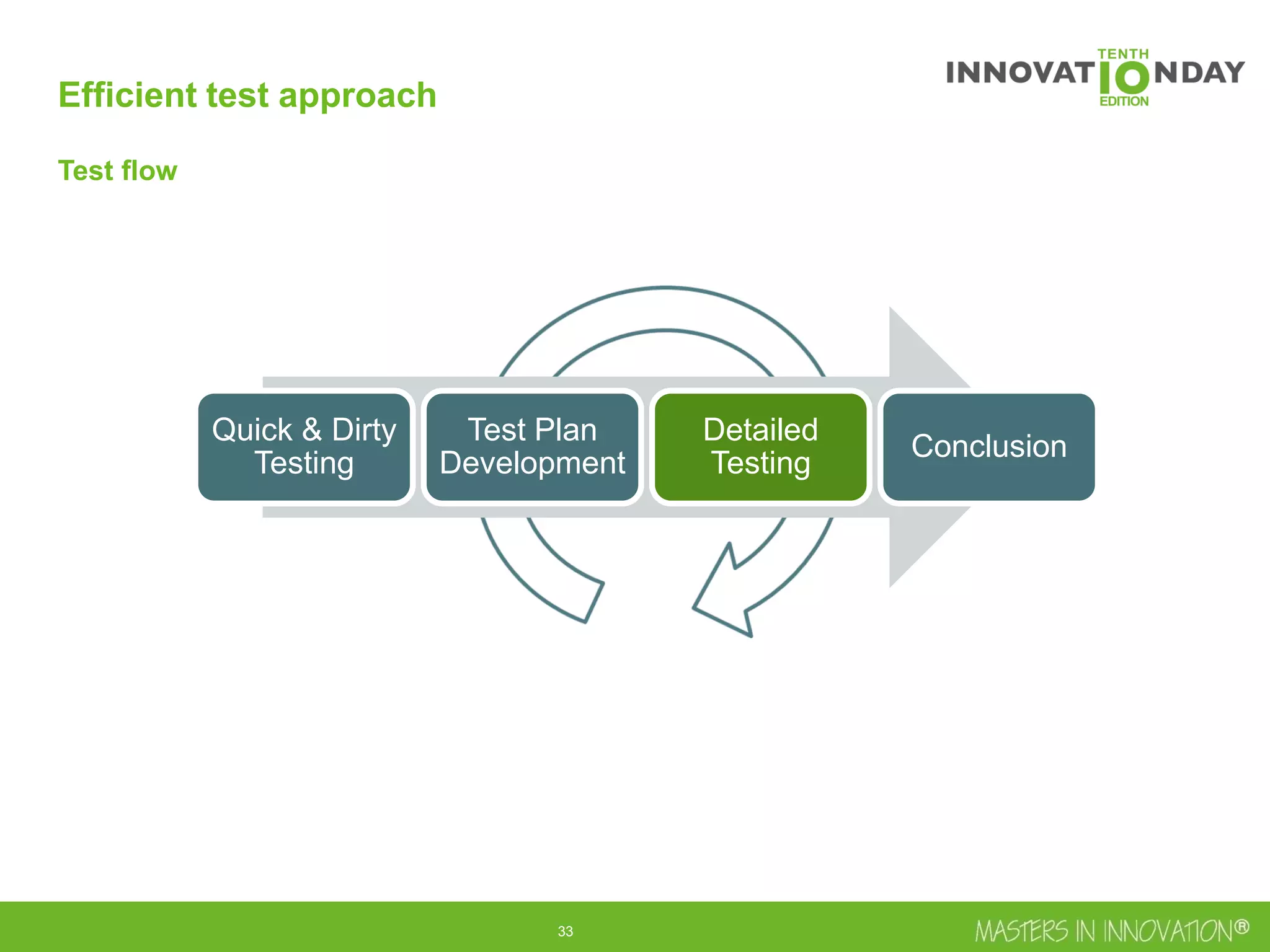

Test flow
27
Quick & Dirty
Testing
Test Plan
Development
Detailed
Testing
Conclusion
Efficient test approach
Test flow
28
Efficient test approach

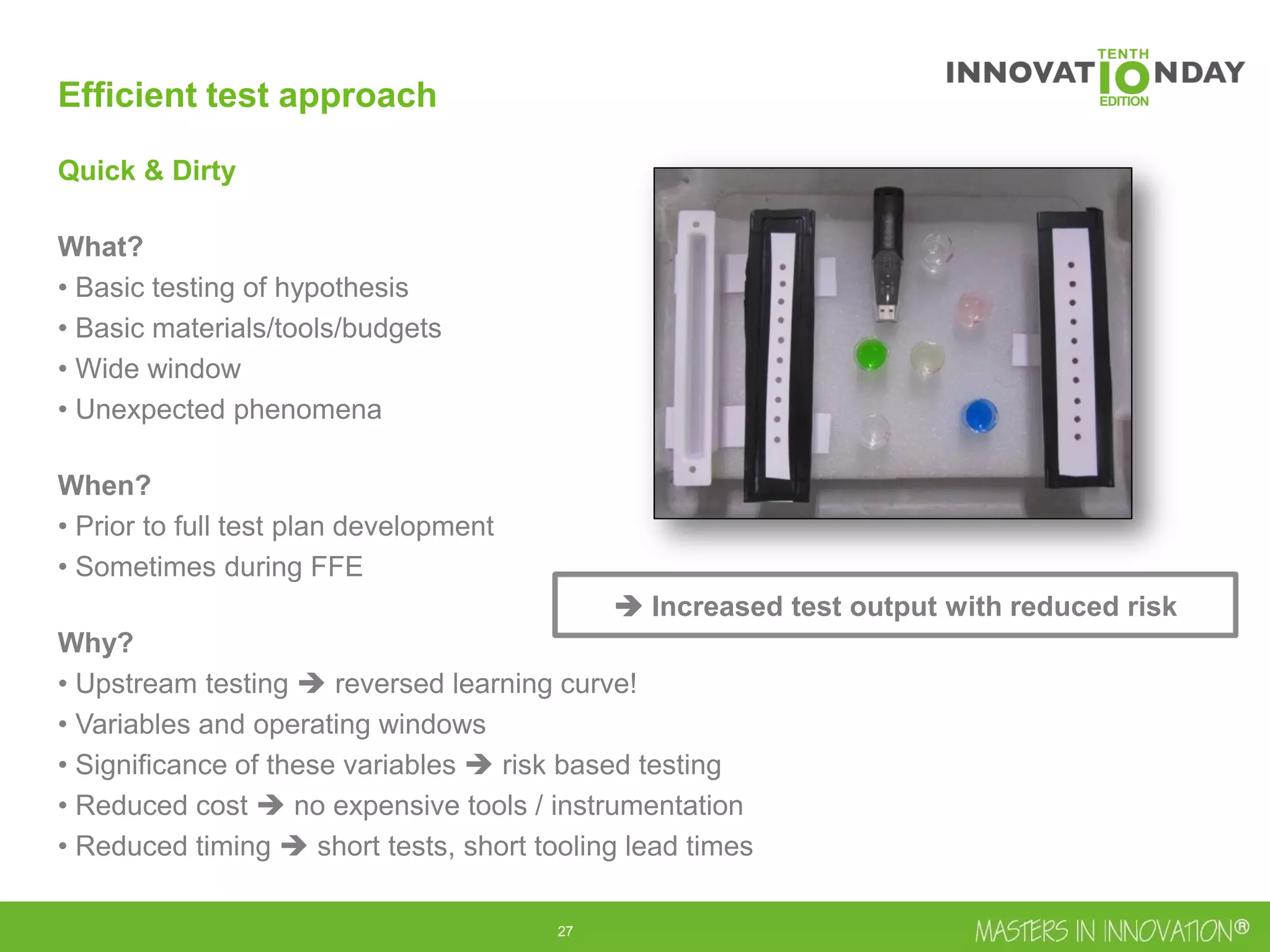

Quick & Dirty
What?
• Basic testing of hypothesis
• Basic materials/tools/budgets
• Wide window
• Unexpected phenomena
When?
• Prior to full test plan development
• Sometimes during FFE
Why?
• Upstream testing  reversed learning curve!
• Variables and operating windows
• Significance of these variables  risk based testing
• Reduced cost  no expensive tools / instrumentation
• Reduced timing  short tests, short tooling lead times
 Increased test output with reduced risk
29
Efficient test approach
Quick & Dirty Examples
Basic testing:
30

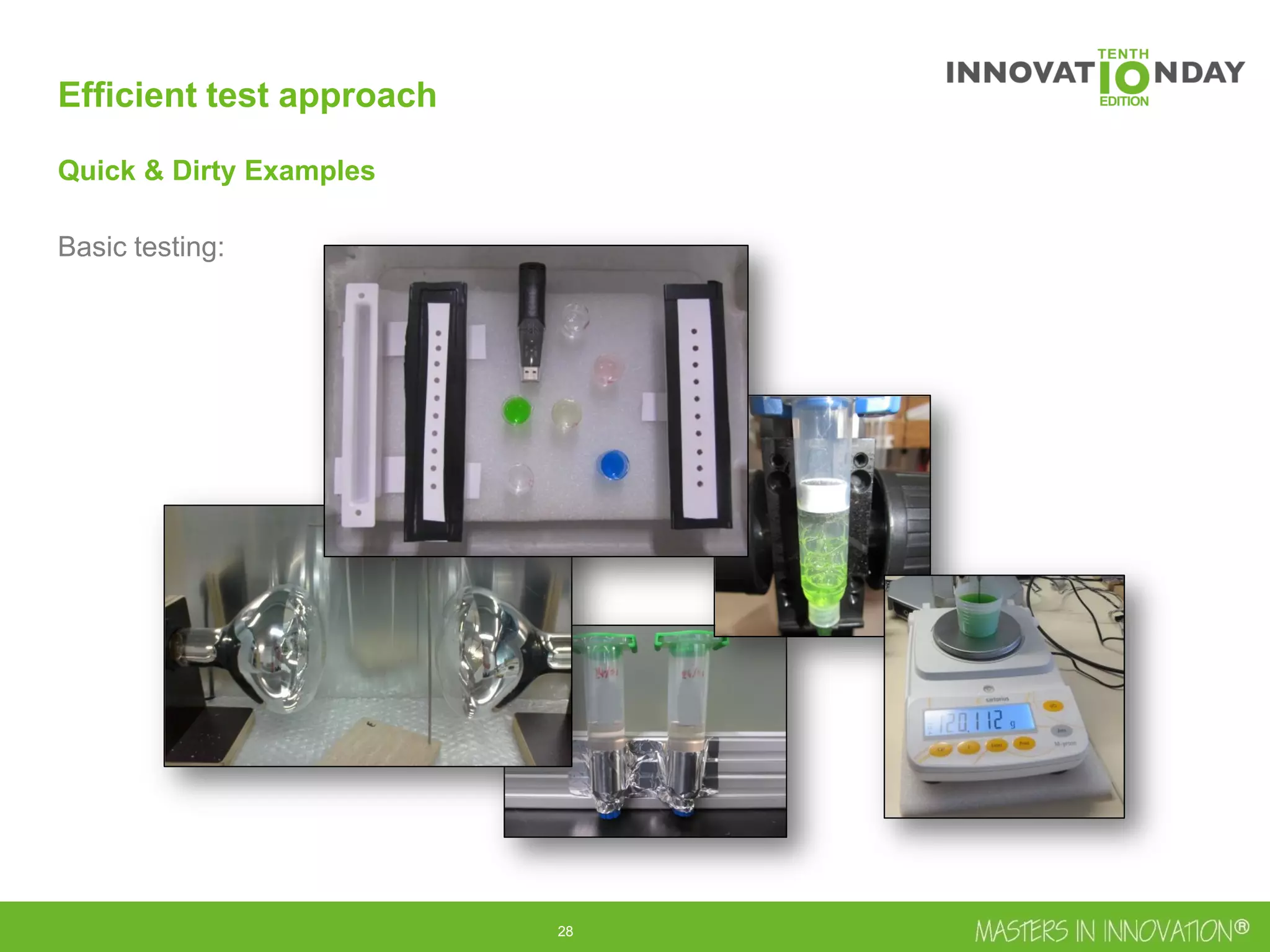

Efficient test approach
Quick & Dirty
So why don’t they?
• Corporate culture  administration during testing
• Availability tools & instrumentation
• Downstream test approach
• Used of testing known things or by known methods
• Afraid to get hands dirty..? Hot potato issue!
• Foresee time & budget for Quick & Dirty testing
• Ensure basic equipment is at hand
 Low threshold for testing should be encouraged
31
Quick & Dirty
Testing
Test Plan
Development
Detailed
Testing
Conclusion
Efficient test approach
Test flow
32
Efficient test approach

Test plan development
1. Gathering inputs
• Desk search
• Quick & dirty test results
• Specification document
• Risk assessment
• ..
2. Define test actions
 List items according to function / module / ..
3. Define acceptance criteria
 Based on gathered information
4. Assign priorities to each test based upon risk/criticality
 Risk based testing
 Assign risks well thought
33
Efficient test approach
Test plan development
5. Define test methods based on:
• Variables
• Measurement method
• Automatic vs. manual
6. Define setup & tools
• Measurement method
• Cost (rent vs. hire)
• Location (EMC, Clima-chamber)
7. Estimate timing
• Lead time setup & tools
• Estimated testing time
 Test plan will give priority / budget / timing overview!
34
Quick & Dirty
Testing
Test Plan
Development
Detailed
Testing
Conclusion
Efficient test approach
Test flow
35
Efficient test approach

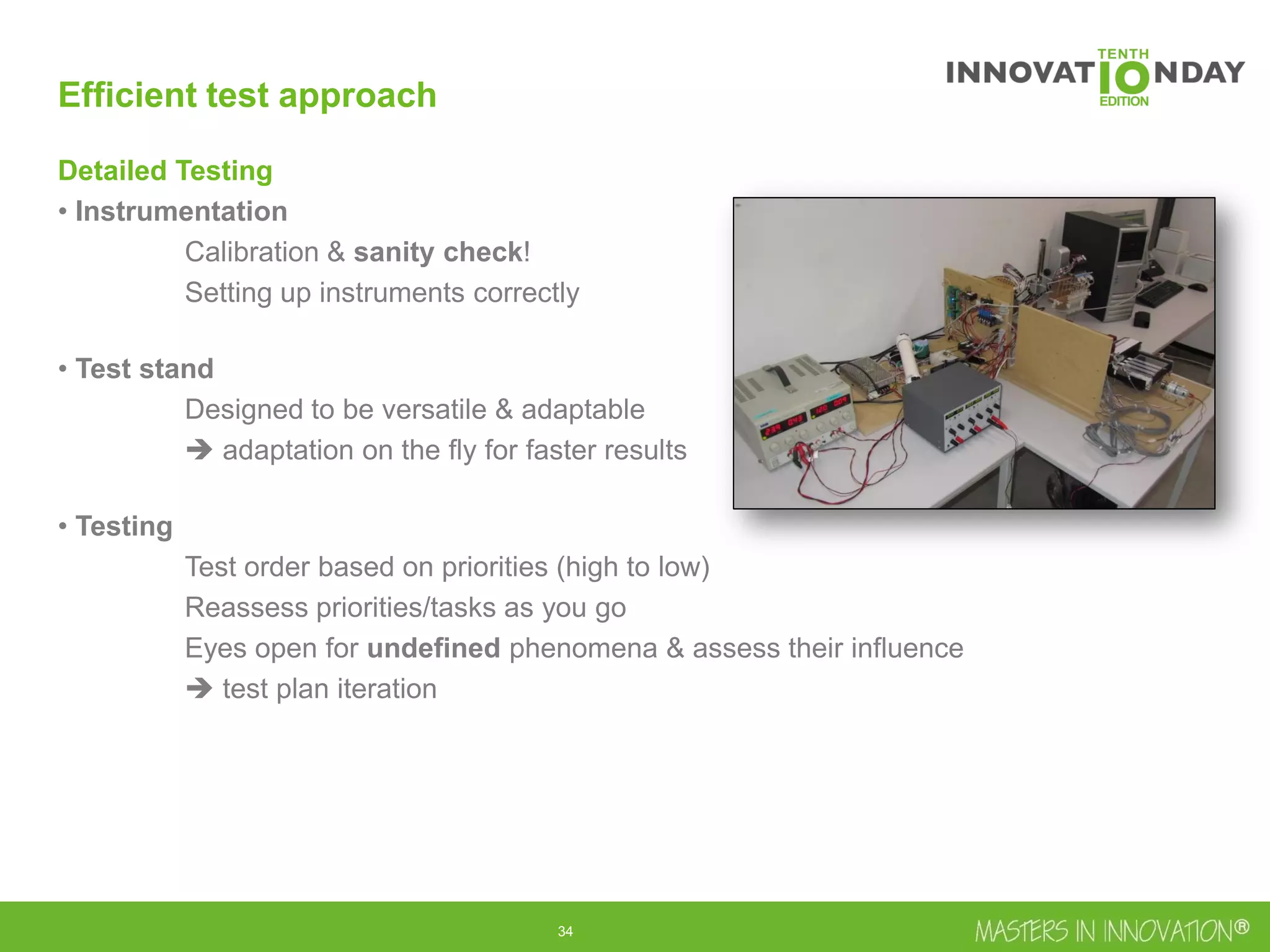

Detailed Testing
• Instrumentation
Calibration & sanity check!
Setting up instruments correctly
• Test stand
Designed to be versatile & adaptable
 adaptation on the fly for faster results
• Testing
Test order based on priorities (high to low)
Reassess priorities/tasks as you go
Eyes open for undefined phenomena & assess their influence
 test plan iteration
36
Efficient test approach
Detailed Testing
• Documentation
On the fly  most efficient, less hassle for test engineer  use templates!
Take pictures  store them for later use, small effort
Need for computer at test stand + internet
37

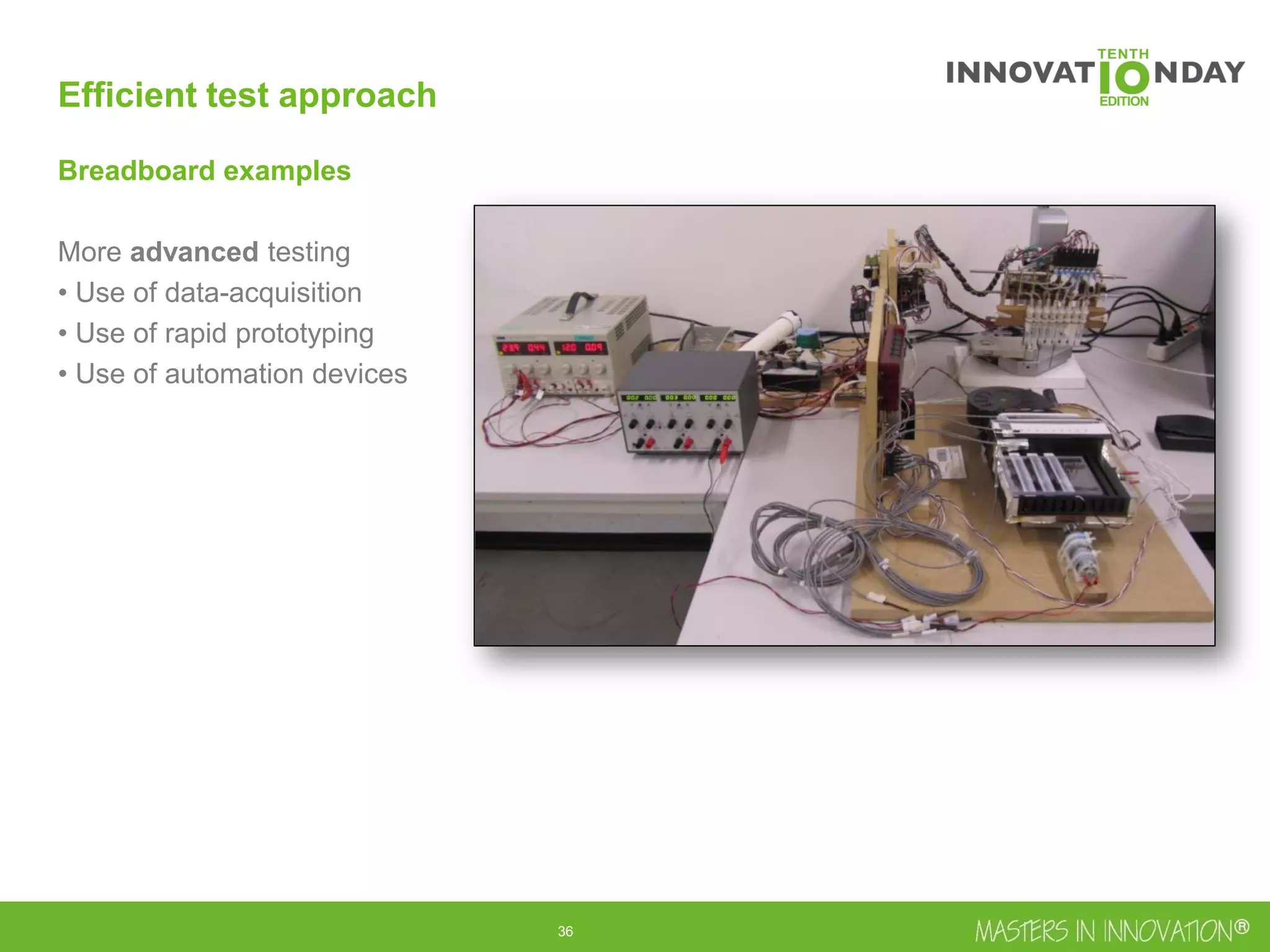

Efficient test approach
Breadboard examples
More advanced testing
• Use of data-acquisition
• Use of rapid prototyping
• Use of automation devices
38
Quick & Dirty
Testing
Test Plan
Development
Detailed
Testing
Conclusion
Efficient test approach
Test flow
39
Efficient test approach
Test conclusion
Test action acceptance
• Fill in test plan acceptance fail/pass
• Comment on possible fails
• Identify show stoppers as soon as possible
Feasibility
Study
Strengths
vs.
Weaknesses
Opportunities
vs. Threats
Needed
resources
40
CONFIDENTIAL
Conclusion
41

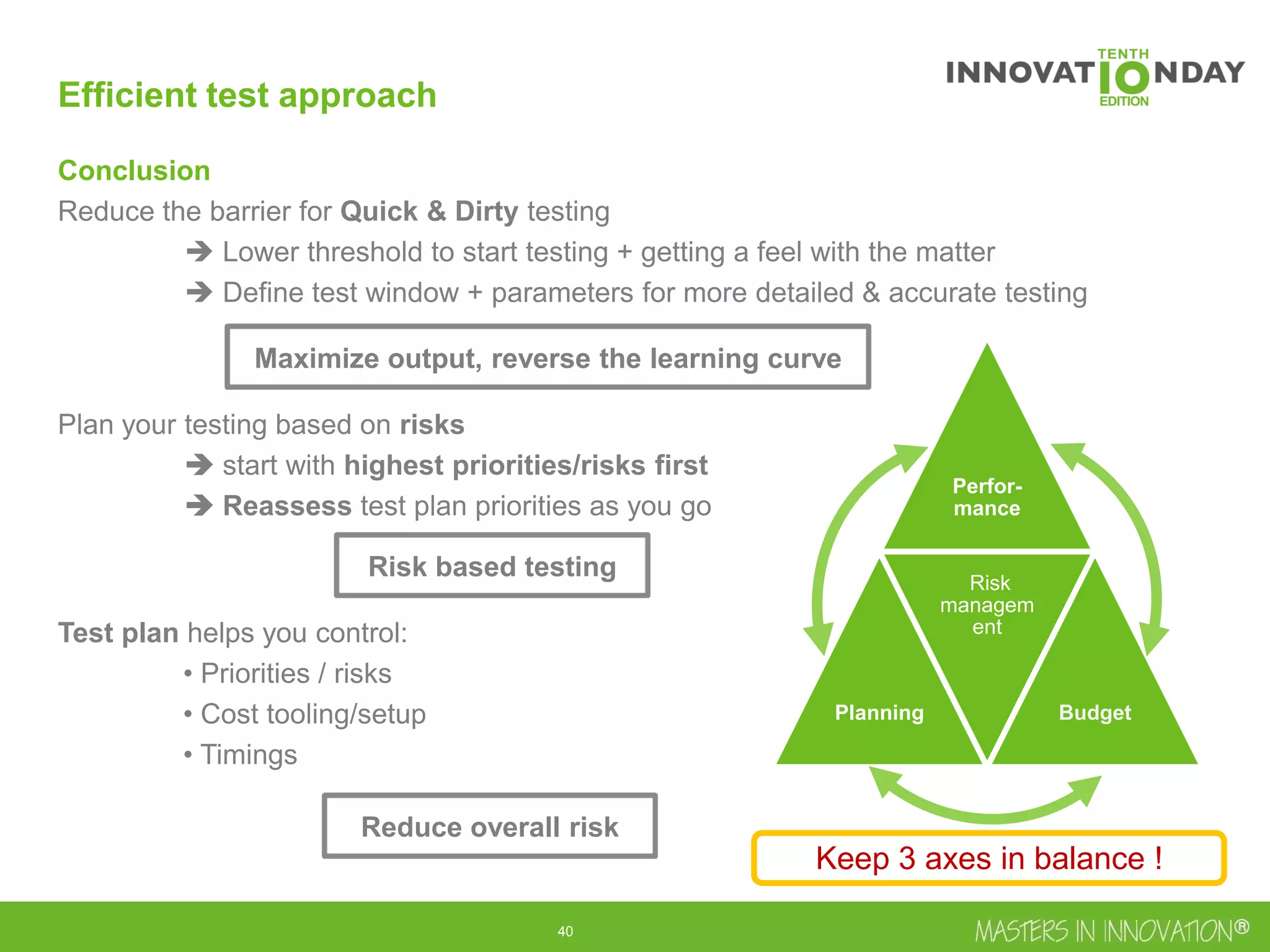

Efficient test approach
Conclusion
Reduce the barrier for Quick & Dirty testing
 Lower threshold to start testing + getting a feel with the matter
 Define test window + parameters for more detailed & accurate testing
Plan your testing based on risks
 start with highest priorities/risks first
 Reassess test plan priorities as you go
Test plan helps you control:
• Priorities / risks
• Cost tooling/setup
• Timings
Perfor-
mance
Planning
Risk
managem
ent
Budget
Keep 3 axes in balance !
Maximize output, reverse the learning curve
Reduce overall risk
Risk based testing
42
43
VERHAERT MASTERS IN INNOVATION®
Headquarters
Hogenakkerhoekstraat 21
9150 Kruibeke (B)
tel +32 (0)3 250 19 00
fax +32 (0)3 254 10 08
ezine@verhaert.com
More at www.verhaert.com
VERHAERT MASTERS IN INNOVATION®
Netherlands
ESIC European Space Innovation Centre
Kapteynstraat 1
2201 BB Noordwijk (NL)
Tel: +31 (0)618 12 19 19
derk.schneemann@verhaert.com
More at www.verhaert.com
MASTERS IN INNOVATION® is a platform set up by VERHAERT to train, stimulate and incubate
you as an innovator.
We provide an extensive training program with different tracks and covering critical areas of new
products and business innovation.
Furthermore we manage the VERHAERT venturing program and organize our Innovation Day, an
annual conference on best practices and insights on new products & business innovation.

Innovation day 2013 2.4 frederik mortier (verhaert) - test management

  • 1.
    2 Test management: Howto organize your research and test campaign during the feasibility study CONFIDENTIAL Frederik Mortier Consultant applied physics & systems frederik.mortier@verhaert.com THEME 2: RISK MANAGEMENT IN INNOVATION
  • 2.
    3 Frederik Mortier Consultant AppliedPhysics & Systems 2012- now Researcher @ Ghent University 2011-2012 MSc. in Engineering – Electro-Mechanical 2009-2011 MSc. in Industrial Sciences – Electro-Mechanical 2005-2009 frederik.mortier@verhaert.com
  • 3.
    4 “A feasibility studyis not only meant to confirm a good idea…”
  • 4.
    5 “…, it couldalso detect a bad idea!”
  • 5.
  • 6.
    7 Outline  Context withinNPD  Problems & Risks  Efficient Test Approach  Conclusion
  • 7.
  • 8.
    9 Concept Design & Development Production Visualization TestingSimulation Review Quick&Dirty Detailed Conclusion Utility Allowability Desirability Feasibility Usability When What How Context within NPD
  • 9.
    10 Cut Tangible • Visualize •Simulate • Test • Review • Roadshow Risk focus • Criticalities • Added value • 360° Early • Rapid prototyping • First time right Options Context within NPD Risk reduction methods
  • 10.
    11 Risk Management Risk identification Risk analysis Riskevaluation Technology management Development Tools & methods Verification Risk mitigation Requirement mgmt Risk assessment Risk treatment Risk monitoring Validation Context within NPD
  • 11.
    12 Why Feasibility Study? Investigatefeasibility of the idea in the application •Confirm / deny added value •Determine required costs By determining: Feasibility Study Strengths vs. Weaknesses Opportunities vs. Threats Needed resources Context within NPD  Risk mitigation
  • 12.
    13 Context within NPD AddedValue – What do we want to find out? Feasibility • Is the core concept feasible ? Proof-of technology • Does my core technology work in the lab ? Field demon- strator • Will my design function in the application?
  • 13.
    14 Context within NPD AddedValue – Validation vs. Verification Needs Requirements Design Test setup Implementation Documentation Validation Check if developed product fulfills its purpose (intended use)  Are we building the right product?  Field test : full system test in real life  Demonstrator in application Test in production if the operator can measure a hole Ø and can detect faults. Validation = application owner (customer) Verification Check if developed product is compliant with specifications  Are we building the product right?  Lab test / Analysis / Simulation  Breadboards / Proof-of-concept in lab Test on a sample plate if we can reach e.g accuracy, w.r.t. reference technology. Verification = development partner (engineer)
  • 14.
    15 Context within NPD CostRequired Why wait for the risk to come true ? More freedom to adjust in early project phases  Early detection of risk allows for measures at lower cost and with less impact on schedule Normal Time Learning curve System specification Conceptual design Detailed design Tooling / purchase Integration Test Reversed  Fail fast, fail cheap!
  • 15.
    16 Context within NPD WhyTesting? Different aspects of technical part of feasibility study: •Better guarantee on final results •Simulations often too complex/time consuming •Sometimes fastest method •New technologies need testing (no previous experience)  Feasibility testing is done to learn!  Avoid unnecessary testing  Example: blister packaging & NASA Visualization Testing Simulation Review
  • 16.
  • 17.
    18 Context within NPD TestManagement Managing of test activities: • Preparing and managing test plan • Preparation of tests • Choice of test approach + testing • Interpretation of test results • Documentation / reporting results  Iterative process during feasibility study
  • 18.
  • 19.
    20 Problems & Risks Risksduring feasibility phase Risks dealt with are the same as in the overall risk management • Budget • Planning • Performance Perfor- mance Planning Risk manage ment Budget Keep 3 axes in balance !
  • 20.
    21 Budget risks Uncontrolled budgets Timing •Long test times • Documentation Test setups / tools • Renting vs. buying • Too advanced setups too soon • Rework due to unforeseen events Perfor- mance Planning Risk manage ment Budget Problems & Risks
  • 21.
    22 Planning risks Planning Long durationof test campaign • Test conclusions too late • High criticality items too late Tests vs. Resources • Equipment availability • Personnel availability Lead times • Equipment/tools • Software • Test stands Perfor- mance Planning Risk manage ment Budget Problems & Risks
  • 22.
    23 Performance risks Performance Wrong result •Wrong measurement method • Wrong measurement tool • Inaccurate results • Wrong test order Wrong basic requirement • Wrong test criteria  “risk based methods in NPD” Perfor- mance Planning Risk manage ment Budget Problems & Risks
  • 23.
  • 24.
    25 Outline Objective of testing Evaluateperformance / behavior to remove / reduce project risk by testing on “representative hardware” Ways of testing • Proof of concept  bread boarding • Works like real  application demonstrator • Looks/works/tastes like real  product prototype Efficient test approach  Test Management
  • 25.
    26 Quick & Dirty Testing TestPlan Development Detailed Testing Conclusion Efficient test approach Test flow
  • 26.
    27 Quick & Dirty Testing TestPlan Development Detailed Testing Conclusion Efficient test approach Test flow
  • 27.
    28 Efficient test approach Quick& Dirty What? • Basic testing of hypothesis • Basic materials/tools/budgets • Wide window • Unexpected phenomena When? • Prior to full test plan development • Sometimes during FFE Why? • Upstream testing  reversed learning curve! • Variables and operating windows • Significance of these variables  risk based testing • Reduced cost  no expensive tools / instrumentation • Reduced timing  short tests, short tooling lead times  Increased test output with reduced risk
  • 28.
    29 Efficient test approach Quick& Dirty Examples Basic testing:
  • 29.
    30 Efficient test approach Quick& Dirty So why don’t they? • Corporate culture  administration during testing • Availability tools & instrumentation • Downstream test approach • Used of testing known things or by known methods • Afraid to get hands dirty..? Hot potato issue! • Foresee time & budget for Quick & Dirty testing • Ensure basic equipment is at hand  Low threshold for testing should be encouraged
  • 30.
    31 Quick & Dirty Testing TestPlan Development Detailed Testing Conclusion Efficient test approach Test flow
  • 31.
    32 Efficient test approach Testplan development 1. Gathering inputs • Desk search • Quick & dirty test results • Specification document • Risk assessment • .. 2. Define test actions  List items according to function / module / .. 3. Define acceptance criteria  Based on gathered information 4. Assign priorities to each test based upon risk/criticality  Risk based testing  Assign risks well thought
  • 32.
    33 Efficient test approach Testplan development 5. Define test methods based on: • Variables • Measurement method • Automatic vs. manual 6. Define setup & tools • Measurement method • Cost (rent vs. hire) • Location (EMC, Clima-chamber) 7. Estimate timing • Lead time setup & tools • Estimated testing time  Test plan will give priority / budget / timing overview!
  • 33.
    34 Quick & Dirty Testing TestPlan Development Detailed Testing Conclusion Efficient test approach Test flow
  • 34.
    35 Efficient test approach DetailedTesting • Instrumentation Calibration & sanity check! Setting up instruments correctly • Test stand Designed to be versatile & adaptable  adaptation on the fly for faster results • Testing Test order based on priorities (high to low) Reassess priorities/tasks as you go Eyes open for undefined phenomena & assess their influence  test plan iteration
  • 35.
    36 Efficient test approach DetailedTesting • Documentation On the fly  most efficient, less hassle for test engineer  use templates! Take pictures  store them for later use, small effort Need for computer at test stand + internet
  • 36.
    37 Efficient test approach Breadboardexamples More advanced testing • Use of data-acquisition • Use of rapid prototyping • Use of automation devices
  • 37.
    38 Quick & Dirty Testing TestPlan Development Detailed Testing Conclusion Efficient test approach Test flow
  • 38.
    39 Efficient test approach Testconclusion Test action acceptance • Fill in test plan acceptance fail/pass • Comment on possible fails • Identify show stoppers as soon as possible Feasibility Study Strengths vs. Weaknesses Opportunities vs. Threats Needed resources
  • 39.
  • 40.
    41 Efficient test approach Conclusion Reducethe barrier for Quick & Dirty testing  Lower threshold to start testing + getting a feel with the matter  Define test window + parameters for more detailed & accurate testing Plan your testing based on risks  start with highest priorities/risks first  Reassess test plan priorities as you go Test plan helps you control: • Priorities / risks • Cost tooling/setup • Timings Perfor- mance Planning Risk managem ent Budget Keep 3 axes in balance ! Maximize output, reverse the learning curve Reduce overall risk Risk based testing
  • 41.
  • 42.
    43 VERHAERT MASTERS ININNOVATION® Headquarters Hogenakkerhoekstraat 21 9150 Kruibeke (B) tel +32 (0)3 250 19 00 fax +32 (0)3 254 10 08 ezine@verhaert.com More at www.verhaert.com VERHAERT MASTERS IN INNOVATION® Netherlands ESIC European Space Innovation Centre Kapteynstraat 1 2201 BB Noordwijk (NL) Tel: +31 (0)618 12 19 19 derk.schneemann@verhaert.com More at www.verhaert.com MASTERS IN INNOVATION® is a platform set up by VERHAERT to train, stimulate and incubate you as an innovator. We provide an extensive training program with different tracks and covering critical areas of new products and business innovation. Furthermore we manage the VERHAERT venturing program and organize our Innovation Day, an annual conference on best practices and insights on new products & business innovation.

Editor's Notes

  • #6 feasibility study is niet enkel ter bevestiging Zekere risico’s aan verbonden (past binnen kader van risk management op inno day) Risico’s bespreken en daarna een efficiënte aanpak voorstellen
  • #8 feasibility study is niet enkel ter bevestiging Situering binnen NPD Zekere risico’s aan verbonden (past binnen kader van risk management op inno day) Risico’s bespreken en daarna een efficiënte aanpak voorstellen
  • #10 Situering van de presentatie Conceptniveau  presentatie handelt over innovatieprojecten(kader inno day / verhaert)  focus ligt op technische haalbaarheid Technische haalbaarheid nagaan dmv testen (uiteraard niet enigste mogelijkheid)
  • #11 link naar andere presentaties en algemene risk mgmt aanpak duidelijk maken
  • #12 feasibility is not only looking at the feasibility (monitoring), but also about making the concept feasible (treatment) Snapshot uit de presentatie ‘risk training’
  • #14 Innovatief project  technical feasibility Uitleg geven rondom HQMS (aerotecs project) Last item  usability Field demonstrator  user centered
  • #15 validation  demonstrator in application (feasibility & usability & desirability check) verification  BB or PoC (feasibility check) Over specification will have its influence throughout the entire project! Example: Fusionics (wrong specification leads to expensive instrument) Airbus 5µm accuracy possible, however, customer does not have a need for such a precision
  • #16 Early stage cost reduction by changing concept has significant influence in overall project costs Reversing the learning curve by learning as much as fast as possible  overall advantage!
  • #17 You test what you really want to know Simulations are possible for partially determined cases with many variable changes Human interpretation also for testing, but without translation from theoretical case to practical Blister package: Determine in feasibility study Bullnett the break force of the blister  NASA already has very detailed information regarding human capabilities!
  • #22 renting vs. buying: FLIR camera for 1 day, gekalibreerde meettoestellen
  • #24 wrong basic requirement: Fusionics (te zwaar gespec’t) Hot cold treatment: Temperature target 2 °C very demanding and not usefull for treatment New application based on ice packs => good and bad characteristics copied Airbus (té goed en daardoor te omslachtig) Borehole measurement 5 µm target very demanding , set by quality department and not usefull for end user (production)
  • #26 Proof of concept => breadboarding Works like real => application demonstrator looks/works/tastes like real => product prototype
  • #27 Test plan schrijven + uitvoeren => Iteratief proces test plan: Banksys: - loopt het mis indien… ? - wanneer loopt het mis?  andere insteek
  • #28 Test plan schrijven + uitvoeren => Iteratief proces test plan: Banksys: - loopt het mis indien… ? - wanneer loopt het mis?  andere insteek
  • #29 quick desk search  parameters/eigenschappen/moeilijkheden leren kennen
  • #31 low threshold  nog steeds hoog in de praktijk: - corporate culture (veel administratie) - beschikbaarheid instrumentatie/tools - often downstream test approach  uitstellen testen (enkel voor validatie/verificatie) - niet durven handen vuil te maken? Foto’s opstelling beneden: -
  • #32 Test plan schrijven + uitvoeren => Iteratief proces test plan: Banksys: - loopt het mis indien… ? - wanneer loopt het mis?  andere insteek
  • #35 Test plan schrijven + uitvoeren => Iteratief proces test plan: Banksys: - loopt het mis indien… ? - wanneer loopt het mis?  andere insteek
  • #38 Link to sentence in beginning  bad idea/concept  show example.
  • #39 Test plan schrijven + uitvoeren => Iteratief proces test plan: Banksys: - loopt het mis indien… ? - wanneer loopt het mis?  andere insteek
  • #42 Zo snel mogelijk leren door Q&D met daarop gevolgd een test plan op basis van priorities/risks zal het totale risico van een feasibility study beperken.
