Transportation Improvement Program
FY 2016/17 – 2020/21
MAR TIN
FY 2016/17 -2020/21
Transportation Improvement Program
Adopted by the Martin l1PO Board on June 20, 2016
Troy McDonald
l1PO Board Chairman
The Transportation lmprovement Program ofthe Martin Metropolitan Planning
Organization has been developed consistent with Federal regulations 23 U.S.C. l34(h)
and CFR 450 and Florida Statute 339.175(8) in cooperation with the Florida Department
ofTransportation, and the local member agencies and public transit operators in the
Martin MPO Planning Area.
ii Page
ii | P a g e

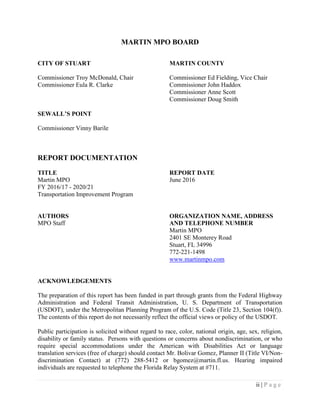

MARTIN MPO BOARD
CITY OF STUART MARTIN COUNTY
Commissioner Troy McDonald, Chair Commissioner Ed Fielding, Vice Chair
Commissioner Eula R. Clarke Commissioner John Haddox
Commissioner Anne Scott
Commissioner Doug Smith
SEWALL’S POINT
Commissioner Vinny Barile
REPORT DOCUMENTATION
TITLE REPORT DATE
Martin MPO June 2016
FY 2016/17 - 2020/21
Transportation Improvement Program
AUTHORS ORGANIZATION NAME, ADDRESS
MPO Staff AND TELEPHONE NUMBER
Martin MPO
2401 SE Monterey Road
Stuart, FL 34996
772-221-1498
www.martinmpo.com
ACKNOWLEDGEMENTS
The preparation of this report has been funded in part through grants from the Federal Highway
Administration and Federal Transit Administration, U. S. Department of Transportation
(USDOT), under the Metropolitan Planning Program of the U.S. Code (Title 23, Section 104(f)).
The contents of this report do not necessarily reflect the official views or policy of the USDOT.
Public participation is solicited without regard to race, color, national origin, age, sex, religion,
disability or family status. Persons with questions or concerns about nondiscrimination, or who
require special accommodations under the American with Disabilities Act or language
translation services (free of charge) should contact Mr. Bolivar Gomez, Planner II (Title VI/Non-
discrimination Contact) at (772) 288-5412 or bgomez@martin.fl.us. Hearing impaired
individuals are requested to telephone the Florida Relay System at #711.
iii | P a g e

CERTIFICATION
FHWA/ FTA CERTIFICATION
Federal Law requires the Federal Highway Administration (FHWA) and the Federal Transit
Administration (FTA) to jointly certify the transportation planning processes of Transportation
Management Areas (TMAs) at least every four years (a TMA is an urbanized area, as defined by
the US Census, with a population over 200,000).1
Pursuant to 23 CFR 450.328(a), the FHWA/FTA must jointly find that each metropolitan TIP is
based on a “3-C” (continuing, comprehensive, and cooperative) planning process by the MPO,
State Department of Transportation, and transit service provider(s). In Florida, this finding
primarily has been based on the annual MPO/FDOT joint certification statements on the
respective metropolitan planning processes.2
The most recent Federal Certification Review was completed in December 2012.
1
Federal Highway Administration Florida Division & Federal Transit Administration Region 4. Certification
Report: Port St. Lucie Transportation Management Area – St. Lucie Transportation Planning Organization & Martin
Metropolitan Planning Organization. March 2009.
2
Federal Highway Administration Florida Division & Federal Transit Administration Region 4. 2009 Florida
Statewide Annual Assessment. September 2009.
Appendix A

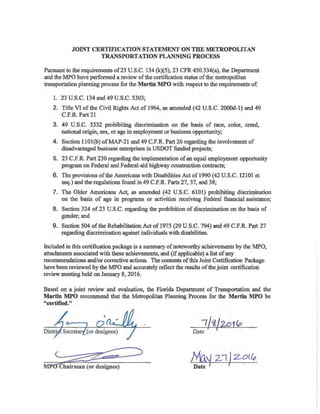

JOINT CERTIFICATION STATEMENT ON THE METROPOLITAN
TRANSPORTATION PLANNING PROCESS
Pursuant to the requirements of23 U.S.C. 134 (k)(5), 23 CFR 450.334(a), the Department
and the MPO have performed a review ofthe certification status of the metropolitan
transportation planning process for the Martin MPO with respect to the requirements of:
1. 23 U.S.C. 134 and 49 U.S.C. 5303;
2. Title VI of the Civil Rights Act of 1964, as amended (42 U.S.C. 2000d-l) and 49
C.F.R. Part 21
3. 49 U.S.C. 5332 prohibiting discrimination on the basis of race, color, creed,
national origin, sex, or age in employment or business opportunity;
4. Section 1lOl(b) ofMAP-21 and 49 C.F.R Part 26 regarding the involvement of
disadvantaged business enterprises in USDOT fimded projects;
5. 23 C.F.R. Part 230 regarding the implementation ofan equal employment opportunity
program on Federal and Federal-aid highway construction contracts;
6. The provisions ofthe Americans with Disabilities Act of 1990 (42 U.S.C. 12101 et
seq.) and the regulations found in 49 C.F.R. Parts 27, 37, and 38;
7. The Older Americans Act, as amended (42 U.S.C. 6101) prohibiting discrimination
on the basis of age in programs or activities receiving Federal financial assistance;
8. Section 324 of23 U.S.C. regarding the prohibition of discrimination on the basis of
gender; and
9. Section 504 of the Rehabilitation Act of 1973 (29 U.S.C. 794) and 49 C.F.R Part 27
regarding discrimination against individuals with disabilities.
Included in this certification package is a summary ofnoteworthy achievements by the MPO,
attachments associated with these achievements, and (ifapplicable) a list ofany
recommendations and/or corrective actions. The contents ofthis Joint Certification Package
have been reviewed by the MPO and accurately reflect the results ofthe joint certification
review meeting held on January 8, 2016.
Based on a joint review and evaluation, the Florida Department of Transportation and the
Martin MPO recommend that the Metropolitan Planning Process for the Martin MPO be
"certified."
~~ihairman (or designee)
/y{a~ 2"1 JZOI~
Date /
v | P a g e
GLOSSARY OF TERMS
ABBREVIATIONS AND ACRONYMS
ADM Administration
BPAC Bicycle & Pedestrian Advisory
Committee
CAC Citizens Advisory Committee
CEI Construction, Engineering, and
Inspection
CIP Capital Improvement Program/Plan
CLV Culvert
CMS Congestion Management System
CMP Congestion Management Process
COA Council on Aging
CTC Community Transportation Coordinator
DCA Department of Community Affairs
DEP Department of Environmental
Protection (FL)
E/D Engineering/Design
EMO Environmental Management Office
EPA (U.S.) Environmental Protection
Agency
ETDM Efficient Transportation Decision
Making
FAA Federal Aviation Administration
FDOT Florida Department of Transportation
FHWA Federal Highway Administration
FTA Federal Transit Administration
FY Fiscal Year
LCB-TD Local Coordinating Board for the
Transportation Disadvantaged
LRTP Long Range Transportation Plan
MIT Mitigation
MPO Metropolitan Planning Organization
MSC Miscellaneous
PIP Public Involvement Process or Plan
PTO Public Transportation Office
RELOC Relocation
RLRTP Regional Long Range Transportation
Plan
RRX Railroad Crossing
RTA Regional Transit Authority
SAFETEA-LU Safe, Accountable, Efficient,
Transportation Equity Act—A Legacy
for Users
TAC Technical Advisory Committee
TD Transportation Disadvantaged
TDP Transit Development Plan
TEA-21 Transportation Efficiency Act for the
21st
Century
TIP Transportation Improvement Program
TPO Transportation Planning Organization
UMTA Urban Mass Transportation
Administration
UTIL Utilities
FEDERAL AND STATE FUND CODES
ACIM Advance Construction (IM)
ACNH Advance Construction (NH)
ACSA Advance Construction (SA)
BA Donor Bonus - any area Federal
BL Donor Bonus - areas <200K
population(federal)
BNCA Bonds - controlled access road (state)
BNDS Bonds - state roads (state)
BRP State Bridge Replacement
BRRP State Bridge Replacement and Repair
BRT Federal Bridge Replacement - on
federal system
BRTZ Federal Bridge Replacement - off
federal system
CIGP County Incentive Grant Program
CM Congestion Mitigation
D Unrestricted state primary funds
DDR District Dedicated Revenue (state)
DFTA Federal Pass Through Dollars from
FTA
DIH State in-house product support
DIM State intermodal development
DOH State primary overhead
DPTO State PTO
vi | P a g e
DS State primary highways and public
transit
DSL Local Government Cooperative
Assistance Program
DU State primary funds/federal
reimbursement
EB Equity Bonus
FAA Federal Aviation Administration
FCO State-fixed capital outlay
FHPP Federal High Priority Projects
FRA Federal Railroad Administration
FTA Federal Transit Administration
FTAT FHWA Transfer to FTA
GMR General Revenue for SIS
GRSC General Revenue for SCOP
HSP Highway Safety Program
MABP Minimum Allocation - Bridges (non-
BRT)
MGBP Minimum Allocation - Bridges
Supplement
ML Minimum allocation - areas < 200K
population (federal)
NH National Highway (federal)
NHAC NH (AC/ Regular)
NHIR FIHS from NH Federal Funds
NHS National Highway Safety (federal)
NHTS National Highway Traffic Safety
(federal)
PORT Seaport Trust Fund
PKCA Turnpike - controlled access
PKYR Turnpike Rehabilitation
PKYI Turnpike Improvement
PL Metropolitan Planning
P01A Turnpike Bond Construction
HPR Highway Planning Research (federal)
IM Interstate maintenance
LF or LFF Local funds
LFR Local funds - reimbursement from
FDOT
MA Minimum allocation - any area (federal)
SA Surface Transportation Program (STP) -
any area (federal)
SABR STP, Bridges
SCOP Small County Outreach Program
SE STP - enhancement (federal)
SH STP - hazard elimination (federal)
SL STP - areas less than 200K population
SN STP - mandatory non-urban (federal)
SP STP - RR protective devices (federal)
SR STP - RR hazard elimination (federal)
SS STP - Safety (federal)
STP Surface Transportation Program
SU STP, Urban Areas greater than 200K
TDD Transportation Disadvantaged
Discretionary
TDTF Transportation Disadvantaged Trust
Fund
Umxx Minimum allocation funds
XA STP (consolidated BA, MA, and SA
funds)
XL STP (consolidated BL, ML, and SL
funds)
XU STP (consolidated BU, MU, and SU
funds)
PHASE OF CONSTRUCTION AND COST ALLOCATION CODES
ADM Administration Other Agency
PDE Project Development & Environment
PE Preliminary Engineering
PLN Planning
ROW Right of Way Support
RELOC Right of Way Relocation
ROW LND Right of Way Land
UTIL Utility Coordination
CAP Capital Grant
R/R CST Railroad construction
CST Construction, CEI (Construction,
engineering, inspection), Post Design
INC Construction Incentive
MNT Maintenance
RRU Railroad/Utilities Construction
ENV Environmental
OPS Operations/Grant Services
LAR Local Agency Reimbursement
DSB Design Build
MSC Miscellaneous
vii | P a g e

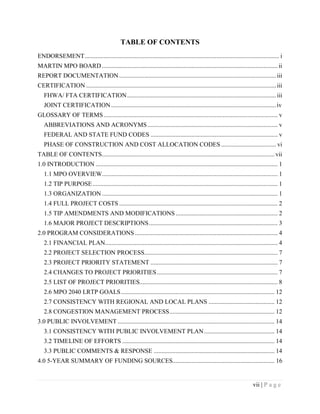

TABLE OF CONTENTS
ENDORSEMENT............................................................................................................................ i
MARTIN MPO BOARD ................................................................................................................ii
REPORT DOCUMENTATION ....................................................................................................iii
CERTIFICATION .........................................................................................................................iii
FHWA/ FTA CERTIFICATION...............................................................................................iii
JOINT CERTIFICATION .........................................................................................................iv
GLOSSARY OF TERMS............................................................................................................... v
ABBREVIATIONS AND ACRONYMS................................................................................... v
FEDERAL AND STATE FUND CODES ................................................................................. v
PHASE OF CONSTRUCTION AND COST ALLOCATION CODES ................................... vi
TABLE OF CONTENTS..............................................................................................................vii
1.0 INTRODUCTION .................................................................................................................... 1
1.1 MPO OVERVIEW................................................................................................................ 1
1.2 TIP PURPOSE...................................................................................................................... 1
1.3 ORGANIZATION................................................................................................................ 1
1.4 FULL PROJECT COSTS ..................................................................................................... 2
1.5 TIP AMENDMENTS AND MODIFICATIONS ................................................................. 2

1.6 MAJOR PROJECT DESCRIPTIONS.................................................................................. 3

2.0 PROGRAM CONSIDERATIONS ........................................................................................... 4
2.1 FINANCIAL PLAN.............................................................................................................. 4
2.2 PROJECT SELECTION PROCESS..................................................................................... 7

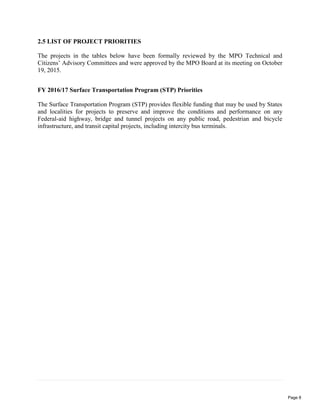

2.3 PROJECT PRIORITY STATEMENT ................................................................................. 7
2.4 CHANGES TO PROJECT PRIORITIES............................................................................. 7
2.5 LIST OF PROJECT PRIORITIES........................................................................................ 8

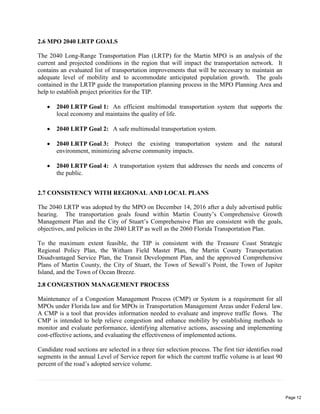

2.6 MPO 2040 LRTP GOALS.................................................................................................. 12
2.7 CONSISTENCY WITH REGIONAL AND LOCAL PLANS .......................................... 12
2.8 CONGESTION MANAGEMENT PROCESS................................................................... 12

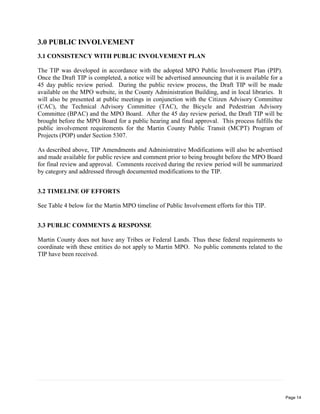

3.0 PUBLIC INVOLVEMENT .................................................................................................... 14
3.1 CONSISTENCY WITH PUBLIC INVOLVEMENT PLAN............................................. 14
3.2 TIMELINE OF EFFORTS ................................................................................................. 14
3.3 PUBLIC COMMENTS & RESPONSE ............................................................................. 14

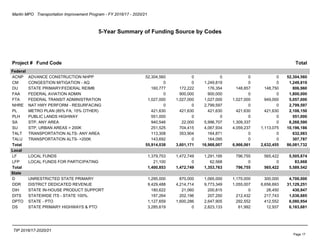

4.0 5-YEAR SUMMARY OF FUNDING SOURCES................................................................. 16
viii | P a g e
LIST OF TABLES
Table 1. List of Project Priorities.............................................................................................. 9
Table 2. List of Transportation Alternative Program (TAP) Priorities.................................... 10

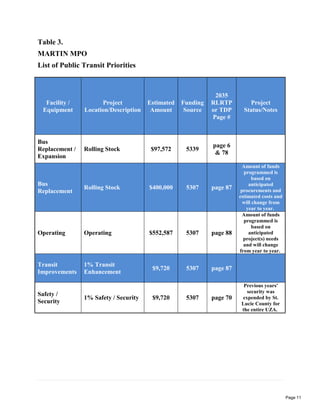

Table 3. List of Transit Priorities............................................................................................. 11

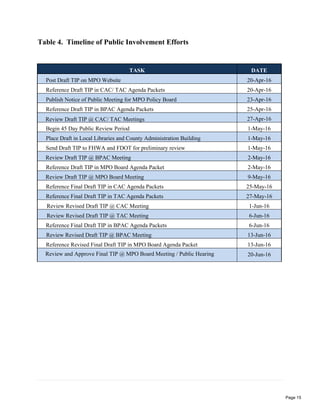

Table 4. Timeline of Public Involvement Efforts.................................................................... 15
APPENDICES
LOCAL CAPITAL IMPROVEMENT PLANS ........................................................................21
FEDERALLY OBLIGATED PROJECTS...............................................................................26
PLANNING AREA MAP ........................................................................................................28
PROJECT INDEX BY NUM BER .....................................................................................29
PROJECT SHEETS ..................................................................................................................33
A - Highway.......................................................................................................................33
B - Transit...........................................................................................................................79
C - Aviation........................................................................................................................85
G - Districtwide..................................................................................................................91
PROJECT INDEX BY NAM E ..............................................................................................98
1.0 INTRODUCTION
1.1 MPO OVERVIEW
Established in 1993, the Martin MPO is governed by a Policy Board and serves the residents of
Martin County. Planning tasks of the Martin MPO include regional coordination, bicycle and
pedestrian planning, mobility management, demographic research, air quality planning, and PIP
processes and updates. As an agency, the Martin MPO also serves its primary function as the
coordinator for multi-modal transportation project planning and funding in and through the
county with various state agencies responsible for transportation and land use plans as well as
adjacent MPOs. On specific regional issues, the Martin MPO partners with the St. Lucie TPO,
the Indian River County MPO, and the Palm Beach MPO.
1.2 TIP PURPOSE
The purpose of this Transportation Improvement Program (TIP) is to provide a comprehensive
and prioritized listing of transportation projects for FY 2016/17 – 20/21 that is consistent with
the 2040 Long-Range Transportation Plan (LRTP). It contains all federally funded and
regionally significant transportation projects planned for the upcoming five years and is updated
annually with funding priority given to the highest ranked projects from the LRTP Cost Feasible
Plan.
The TIP is based on funding data contained within the FDOT Tentative Work Program (also
known as the Citizen’s Report), which is developed annually and made public by FDOT prior to
the development of the TIP. This report is the result of FDOT working with local agencies to
establish priorities for scheduling improvements to the Strategic Intermodal System (SIS),
including freight and Intelligent Transportation System (ITS) strategies, Federal interstate
highway system, local roadways and MPO priorities concerning transit, pedestrian and bicycle-
friendly environments and transportation demand management programs.
1.3 ORGANIZATION
Section 1.0 contains a brief overview of the MPO and the purpose of the TIP. It also contains a
list of major projects that are considered top priorities. Section 2.0 contains specific items that
were considered in the development of this TIP. These include (among other sections) the
Financial Plan, List of Project Priorities, and the MPO’s overall goals as described within the
2040 LRTP.
Section 3.0 contains a list of efforts the MPO plans to make in order to obtain public input for the
development and approval of the TIP. It will also contain a brief summary of the public
comments received and the MPO’s response to them.
The Appendix contains a list of projects by funding category, the project sheets programmed in
Martin County, the Local Capital Improvement Plans and FY 15 Federal Obligated Projects. The
detailed project sections are based on the FDOT District 4 Tentative Work Program as imported
Page 1
on April 1, 2016. Depending on many factors, these lists of projects may potentially change
prior to July 1, 2016. Once the MPO receives a final Work Program from FDOT District 4, this
section may be modified.
Because the project portion of the TIP is generated through the Interactive TIP Tool, there can be
several variations of the project report. For efficiency and reduction of printed pages, the
adopted version shows project detail with maps for only the Highway projects. Sections for
transit, aviation, rail and districtwide list are summarized with project details without location
maps. All project details include a summary of costs and revenues by funding source. Because
only funded projects and phases are listed in the FDOT District 4 Work Program, the costs and
revenues are assumed to be equal, demonstrating financial constraint.
1.4 FULL PROJECT COSTS
The normal project production sequence is to have a Project Development and Environment
(PD&E) phase, a Design (PE) phase, a Right of Way (ROW) phase and a Construction (CST)
phase. Some projects may not have a ROW phase, if land is not needed to complete the project.
Costs on the TIP pages for projects both on and off the SIS will have historical costs and five
years of the current TIP, which may or may not be the total project cost. In addition, SIS
projects will also have costs for five years beyond the current TIP. If there is no CST phase on
the TIP page, then the entry will probably not be reflective of the total project cost. For some
projects, such as resurfacing, safety or operational project, there may not be a total cost provided
but rather additional details on that program.
The SIS is a network of high priority transportation facilities which includes the state’s largest
and most significant commercial service airports, spaceport, deep water seaports, freight rail
terminals, passenger rail and intercity bus terminals, rail corridors, waterways and highways.
For costs beyond the ten year window, access to the Long Range Transportation Plan (LRTP) is
provided. The LRTP reference on the TIP page provides the information necessary to locate the
full project costs and/or additional details regarding the project in the LRTP. If there is no LRTP
reference in the TIP, full project costs are provided in the TIP. The link to the Martin LRTP is
https://www.martinmpo.com/wp-content/uploads/2016/03/Martin-2040-LRTP_final-
report_v3.pdf.
1.5 TIP AMENDMENTS AND MODIFICATIONS
Once the TIP is adopted, there are times that it must be modified or amended because the MPO
does not have direct control of funding resources. This can be accomplished by amendment or
administrative modification. Amendments are revisions that involve a major change, including
an added or deleted project, a significant change to project cost (increase of 20% and greater than
$2 million), or major change to a project scope. Administrative modifications are revisions that
include minor changes to project costs, funding sources, and project initiation dates.
Amendments require a review period to gather public comments. During this review and
comment period, the TIP will be brought before the MPO Advisory Committees for review and
Page 2
approval. Modifications are not required for public review but staff will present them to the
Advisory Committees whenever feasible. Modifications require MPO Policy Board approval.
The Martin MPO coordinates all TIP Amendments and Administrative Modifications with
FDOT District 4.
1.6 MAJOR PROJECT DESCRIPTIONS

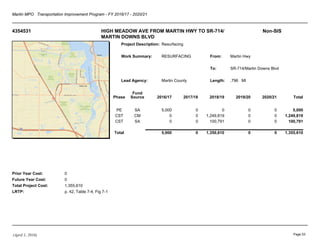

FM# 435431 - High Meadow Ave: Resurfacing of High Meadow Avenue from Martin
Highway to Murphy Road. (Project was updated to include the addition of sidewalks and
extension of project limits). Preliminary Engineering funds are programmed for FY 16/17 and
Construction funds have been programed for FY 2018/19.

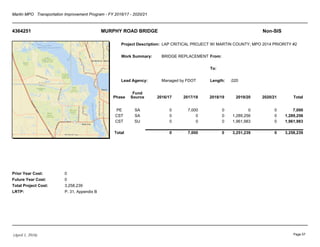

FM# 4364251 - Murphy Road Bridge: Construction and CEI for the replacement of the
existing bridge.
FM# 4368701 - SR-714 Widening: PD&E/PE (Divided 2-4 Lanes) Widening of SR 714 from
Citrus Blvd to SW Martin Downs Blvd.
Page 3
2.0 PROGRAM CONSIDERATIONS
2.1 FINANCIAL PLAN
In accordance with Federal Legislations [23 C.F.R. 450.324(i)], the MPO must demonstrate that
the TIP is financially constrained. This means that the estimated expenses (or project costs) are
consistent with the anticipated revenues for each funding source. Only those projects for which a
revenue source has been identified are shown in the TIP to ensure a balance between the costs
and revenues.
The TIP must include a financial plan that demonstrates how the approved TIP can be
implemented, indicates resources from public and private sources that are reasonably expected to
be made available to carry out the TIP, and recommends any additional financing strategies for
needed projects and programs. However, because the MPO does not have direct control of
funding resources, Administrative Modifications of Amendments may have to be made to the
TIP during the fiscal year.
The TIP is developed by the MPO in cooperation with the FDOT and the transit operator. These
agencies provide the MPO with estimates of available Federal and state funds used to develop
the Financial Summary of Costs and Revenues by Funding Source and Fiscal Year.

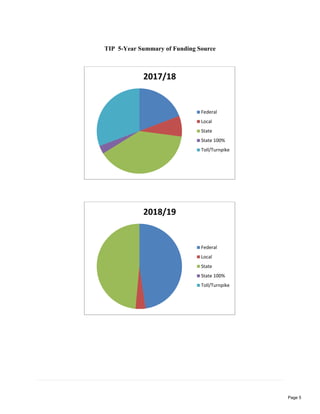

TIP 5-Year Summary of Funding Source
2016/17
Federal
Local
State
State 100%
Toll/Turnpike
Page 4
TIP 5-Year Summary of Funding Source
2017/18
Federal
Local
State
State 100%
Toll/Turnpike
2018/19
Federal
Local
State
State 100%
Toll/Turnpike
Page 5

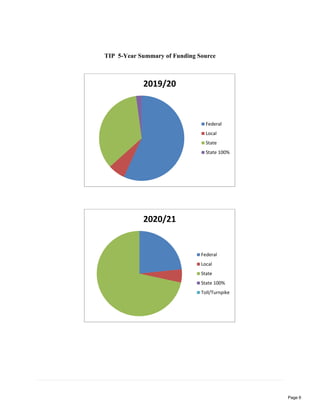

TIP 5-Year Summary of Funding Source
2019/20
Federal
Local
State
State 100%
2020/21
Federal
Local
State
State 100%
Toll/Turnpike
Page 6
2.2 PROJECT SELECTION PROCESS
In accordance with 23 CFR 450.330(a), federally funded projects are selected by the MPO in
conjunction with the development of the FDOT Tentative Work Program and through the
cooperation of the public transit operator.
In addition, the 2040 LRTP plays a major role in identifying projects for selection. Contained
within the LRTP is an evaluation of existing conditions, an evaluation of projected conditions,
the identification of policy and project needs, and a determination of the cost feasibility of
implementing these projects.
Both the FDOT Tentative Work Program and the 2040 LRTP provide the basis for establishing
project priorities consistent with the planning factors considered in their annual selection, and
subsequent development of the TIP pursuant to the requirements set forth in Federal legislation.
2.3 PROJECT PRIORITY STATEMENT
As required under 339.175 (8) (b) F.S., the annual list of project priorities was developed based
on criteria that included the:
 Approved 2040 Long Range Transportation Plan (LRTP);
 Strategic Intermodal System Plan (SIS);
 Results of the transportation management systems; and
 MPO’s public involvement procedures.
MPO and FDOT Staff meet annually to discuss project priorities. During this process, priorities
are identified based on those of the previous year and the priorities listed in the Cost Feasible
Plan of the current LRTP. This new list of priorities is discussed with the MPO Advisory
Committees and then approved by the MPO Board. These priorities are then submitted to FDOT
and used to program projects accordingly.
2.4 CHANGES TO PROJECT PRIORITIES
In accordance with 23 CFR 450.324(l) (1), MPOs are required to explain any changes in
priorities from previous TIPs.
The Number 3 ranked priority CR 609 Guardrail came about during discussions with Martin
County Engineering. In addition, Numbers 2, 8 and 9 are resurfacing projects. Savannah Road,
Indian Street and St. Lucie Blvd. are on the Federal Aid system and serve as important roadways
in the Martin transportation system that were deteriorating, yet eligible projects.
Safety improvements along US 1 (longer left turn storage area southbound on Joan Jefferson
Way and buffered bicycle lanes on the Roosevelt Bridge) are the Number 4 ranked priority,
recommended in FDOT’s Baseline Assessment of the US 1 Corridor. Number 7 ranked priority
is pedestrian improvements along State roadways, Monterey Road and East Ocean Blvd.

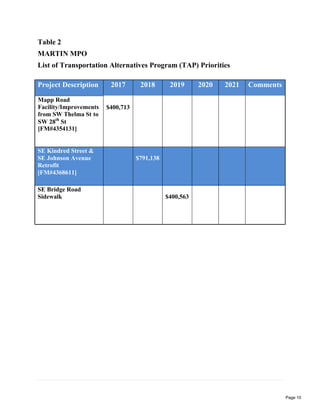

The Transportation Alternatives and Transit Priorities have been updated to reflect recent
Transportation Alternatives Program applications, as well as previously funded projects.
Page 7

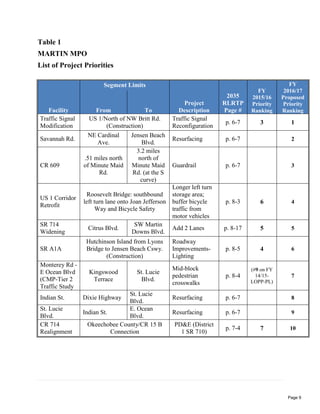

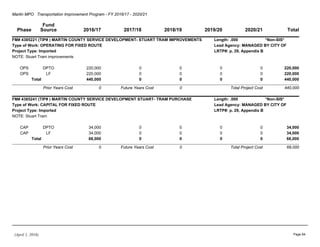

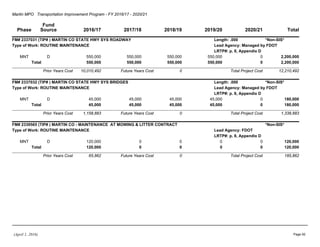

2.5 LIST OF PROJECT PRIORITIES
The projects in the tables below have been formally reviewed by the MPO Technical and
Citizens’ Advisory Committees and were approved by the MPO Board at its meeting on October
19, 2015.
FY 2016/17 Surface Transportation Program (STP) Priorities
The Surface Transportation Program (STP) provides flexible funding that may be used by States
and localities for projects to preserve and improve the conditions and performance on any
Federal-aid highway, bridge and tunnel projects on any public road, pedestrian and bicycle
infrastructure, and transit capital projects, including intercity bus terminals.
Page 8
Table 1
MARTIN MPO
List of Project Priorities

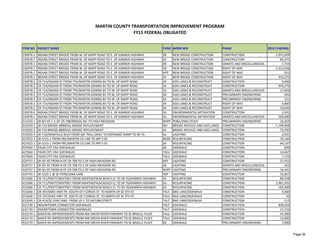

Facility
Segment Limits
Project
Description
2035
RLRTP
Page #
FY
2015/16
Priority
Ranking
FY
2016/17
Proposed
Priority
RankingFrom To

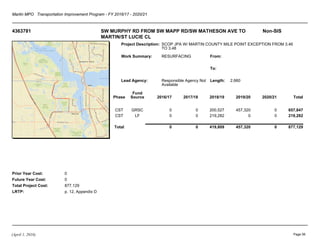

Traffic Signal
Modification
US 1/North of NW Britt Rd.
(Construction)
Traffic Signal
Reconfiguration
p. 6-7 3 1

Savannah Rd.
NE Cardinal
Ave.
Jensen Beach
Blvd.
Resurfacing p. 6-7 2
CR 609
.51 miles north
of Minute Maid
Rd.
3.2 miles
north of
Minute Maid
Rd. (at the S
curve)
Guardrail p. 6-7 3
US 1 Corridor
Retrofit
Roosevelt Bridge: southbound
left turn lane onto Joan Jefferson
Way and Bicycle Safety
Longer left turn
storage area;
buffer bicycle
traffic from
motor vehicles
p. 8-3 6 4

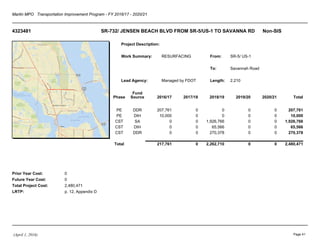

SR 714
Widening
Citrus Blvd.
SW Martin
Downs Blvd.
Add 2 Lanes p. 8-17 5 5
SR A1A
Hutchinson Island from Lyons
Bridge to Jensen Beach Cswy.
(Construction)
Roadway
Improvements-
Lighting
p. 8-5 4 6
Monterey Rd -
E Ocean Blvd
(CMP-Tier 2
Traffic Study
Kingswood
Terrace
St. Lucie
Blvd.
Mid-block
pedestrian
crosswalks
p. 8-4
(#9 on FY
14/15-
LOPP-PL)
7

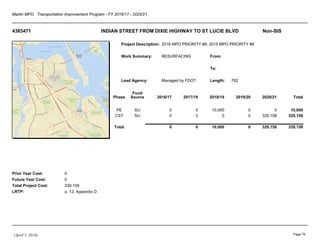

Indian St. Dixie Highway
St. Lucie
Blvd.
Resurfacing p. 6-7 8
St. Lucie
Blvd.
Indian St.
E. Ocean
Blvd.
Resurfacing p. 6-7 9
CR 714
Realignment
Okeechobee County/CR 15 B
Connection
PD&E (District
1 SR 710)
p. 7-4 7 10

Page 9
Table 2
MARTIN MPO
List of Transportation Alternatives Program (TAP) Priorities
Project Description 2017 2018 2019 2020 2021 Comments

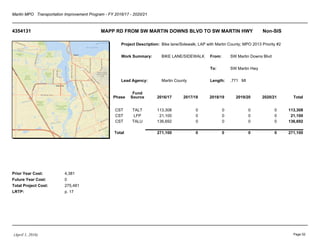

Mapp Road
Facility/Improvements
from SW Thelma St to
SW 28th
St
[FM#4354131]
$400,713
SE Kindred Street &
SE Johnson Avenue
Retrofit
[FM#4368611]
$791,138

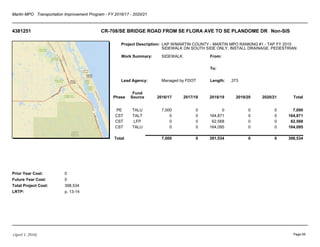

SE Bridge Road
Sidewalk $400,563
Page 10
Table 3.
MARTIN MPO
List of Public Transit Priorities
Facility /
Equipment
Project
Location/Description
Estimated
Amount
Funding
Source
2035
RLRTP
or TDP
Page #
Project
Status/Notes
Bus
Replacement /
Expansion
Rolling Stock $97,572 5339
page 6
& 78
Bus
Replacement
Rolling Stock $400,000 5307 page 87
Amount of funds
programmed is
based on
anticipated
procurements and
estimated costs and
will change from
year to year.
Operating Operating $552,587 5307 page 88
Amount of funds
programmed is
based on
anticipated
project(s) needs
and will change
from year to year.
Transit
Improvements
1% Transit
Enhancement
$9,720 5307 page 87
Safety /
Security
1% Safety / Security $9,720 5307 page 70
Previous years'
security was
expended by St.
Lucie County for
the entire UZA.
Page 11
2.6 MPO 2040 LRTP GOALS
The 2040 Long-Range Transportation Plan (LRTP) for the Martin MPO is an analysis of the
current and projected conditions in the region that will impact the transportation network. It
contains an evaluated list of transportation improvements that will be necessary to maintain an
adequate level of mobility and to accommodate anticipated population growth. The goals
contained in the LRTP guide the transportation planning process in the MPO Planning Area and
help to establish project priorities for the TIP.
 2040 LRTP Goal 1: An efficient multimodal transportation system that supports the
local economy and maintains the quality of life.
 2040 LRTP Goal 2: A safe multimodal transportation system.
 2040 LRTP Goal 3: Protect the existing transportation system and the natural
environment, minimizing adverse community impacts.
 2040 LRTP Goal 4: A transportation system that addresses the needs and concerns of
the public.
2.7 CONSISTENCY WITH REGIONAL AND LOCAL PLANS
The 2040 LRTP was adopted by the MPO on December 14, 2016 after a duly advertised public
hearing. The transportation goals found within Martin County’s Comprehensive Growth
Management Plan and the City of Stuart’s Comprehensive Plan are consistent with the goals,
objectives, and policies in the 2040 LRTP as well as the 2060 Florida Transportation Plan.
To the maximum extent feasible, the TIP is consistent with the Treasure Coast Strategic
Regional Policy Plan, the Witham Field Master Plan, the Martin County Transportation
Disadvantaged Service Plan, the Transit Development Plan, and the approved Comprehensive
Plans of Martin County, the City of Stuart, the Town of Sewall’s Point, the Town of Jupiter
Island, and the Town of Ocean Breeze.
2.8 CONGESTION MANAGEMENT PROCESS
Maintenance of a Congestion Management Process (CMP) or System is a requirement for all
MPOs under Florida law and for MPOs in Transportation Management Areas under Federal law.
A CMP is a tool that provides information needed to evaluate and improve traffic flows. The
CMP is intended to help relieve congestion and enhance mobility by establishing methods to
monitor and evaluate performance, identifying alternative actions, assessing and implementing
cost-effective actions, and evaluating the effectiveness of implemented actions.
Candidate road sections are selected in a three tier selection process. The first tier identifies road
segments in the annual Level of Service report for which the current traffic volume is at least 90
percent of the road’s adopted service volume.
Page 12
The second tier eliminates projects for which an improvement is currently programmed within
the Work Program, either to the facility itself or to a parallel facility that will, when improved,
provide relief to the candidate road section.
The third tier sorts the remaining projects by the timeframe in which a major capacity
improvement was deemed financially feasible in the LRTP. The segment for which the expected
funding is furthest in the future is then examined to identify low cost improvements that will
reduce congestion.
Once the set of possible improvements are identified and preliminary cost estimates developed, a
benefit/cost analysis is done to establish the relationship of the improvement costs to the value of
the time saved by the improvements’ implementation.
In 2014 the selection process (described above) identified the East Ocean Boulevard/Southeast
Monterey Road Corridor. The analysis of the segment yielded recommendations for low cost
improvements. The design phases for two of these recommendations are funded in this TIP.
Page 13
3.0 PUBLIC INVOLVEMENT
3.1 CONSISTENCY WITH PUBLIC INVOLVEMENT PLAN
The TIP was developed in accordance with the adopted MPO Public Involvement Plan (PIP).
Once the Draft TIP is completed, a notice will be advertised announcing that it is available for a
45 day public review period. During the public review process, the Draft TIP will be made
available on the MPO website, in the County Administration Building, and in local libraries. It
will also be presented at public meetings in conjunction with the Citizen Advisory Committee
(CAC), the Technical Advisory Committee (TAC), the Bicycle and Pedestrian Advisory
Committee (BPAC) and the MPO Board. After the 45 day review period, the Draft TIP will be
brought before the MPO Board for a public hearing and final approval. This process fulfills the
public involvement requirements for the Martin County Public Transit (MCPT) Program of
Projects (POP) under Section 5307.
As described above, TIP Amendments and Administrative Modifications will also be advertised
and made available for public review and comment prior to being brought before the MPO Board
for final review and approval. Comments received during the review period will be summarized
by category and addressed through documented modifications to the TIP.
3.2 TIMELINE OF EFFORTS
See Table 4 below for the Martin MPO timeline of Public Involvement efforts for this TIP.
3.3 PUBLIC COMMENTS & RESPONSE
Martin County does not have any Tribes or Federal Lands. Thus these federal requirements to
coordinate with these entities do not apply to Martin MPO. No public comments related to the
TIP have been received.
Page 14
Table 4. Timeline of Public Involvement Efforts
TASK DATE
Post Draft TIP on MPO Website 20-Apr-16
Reference Draft TIP in CAC/ TAC Agenda Packets 20-Apr-16
Publish Notice of Public Meeting for MPO Policy Board 23-Apr-16
Reference Draft TIP in BPAC Agenda Packets 25-Apr-16
Review Draft TIP @ CAC/ TAC Meetings 27-Apr-16
Begin 45 Day Public Review Period 1-May-16
Place Draft in Local Libraries and County Administration Building 1-May-16
Send Draft TIP to FHWA and FDOT for preliminary review 1-May-16
Review Draft TIP @ BPAC Meeting 2-May-16
Reference Draft TIP in MPO Board Agenda Packet 2-May-16
Review Draft TIP @ MPO Board Meeting 9-May-16
Reference Final Draft TIP in CAC Agenda Packets 25-May-16
Reference Final Draft TIP in TAC Agenda Packets 27-May-16
Review Revised Draft TIP @ CAC Meeting 1-Jun-16
Review Revised Draft TIP @ TAC Meeting 6-Jun-16
Reference Final Draft TIP in BPAC Agenda Packets 6-Jun-16
Review Revised Draft TIP @ BPAC Meeting 13-Jun-16
Reference Revised Final Draft TIP in MPO Board Agenda Packet 13-Jun-16
Review and Approve Final TIP @ MPO Board Meeting / Public Hearing 20-Jun-16
Page 15
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
5-Year Summary of Funding Source
TIP 2016/17-2020/21
Funding Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
Federal 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732
Local 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542
State 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018
State 100% 7,145 581,542 0 260,646 0 849,333
Toll/Turnpike 0 5,752,545 0 0 0 5,752,545
Total 73,844,659 18,721,303 35,605,649 12,253,388 11,258,171 151,683,170
Page 16
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
5-Year Summary of Funding Source by Codes
TIP 2016/17-2020/21
Project # Fund Code Total
Federal
ACNP ADVANCE CONSTRUCTION NHPP 52,304,560 0 0 0 0 52,304,560
CM CONGESTION MITIGATION - AQ 0 0 1,249,819 0 0 1,249,819
DU STATE PRIMARY/FEDERAL REIMB 160,777 172,222 176,354 148,857 148,750 806,960
FAA FEDERAL AVIATION ADMIN 0 900,000 900,000 0 0 1,800,000
FTA FEDERAL TRANSIT ADMINISTRATION 1,027,000 1,027,000 1,027,000 1,027,000 949,000 5,057,000
NHRE NAT HWY PERFORM - RESURFACING 0 0 2,799,597 0 0 2,799,597
PL METRO PLAN (85% FA; 15% OTHER) 421,630 421,630 421,630 421,630 421,630 2,108,150
PLH PUBLIC LANDS HIGHWAY 551,000 0 0 0 0 551,000
SA STP, ANY AREA 940,546 22,000 5,996,707 1,309,337 0 8,268,590
SU STP, URBAN AREAS > 200K 251,525 704,415 4,067,934 4,059,237 1,113,075 10,196,186
TALT TRANSPORTATION ALTS- ANY AREA 113,308 353,904 164,871 0 0 632,083
TALU TRANSPORTATION ALTS- >200K 143,692 0 164,095 0 0 307,787
Total 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732
Local
LF LOCAL FUNDS 1,379,753 1,472,749 1,291,195 796,755 565,422 5,505,874
LFP LOCAL FUNDS FOR PARTICIPATING 21,100 0 62,568 0 0 83,668
Total 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542
State
D UNRESTRICTED STATE PRIMARY 1,295,000 870,000 1,065,000 1,170,000 300,000 4,700,000
DDR DISTRICT DEDICATED REVENUE 9,429,488 4,214,714 9,773,349 1,055,007 6,656,693 31,129,251
DIH STATE IN-HOUSE PRODUCT SUPPORT 180,622 21,060 200,815 0 28,450 430,947
DITS STATEWIDE ITS - STATE 100%. 197,264 202,196 207,250 212,432 217,743 1,036,885
DPTO STATE - PTO 1,127,659 1,600,286 2,647,905 292,552 412,552 6,080,954
DS STATE PRIMARY HIGHWAYS & PTO 3,285,619 0 2,823,133 61,992 12,937 6,183,681
Page 17
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
5-Year Summary of Funding Source by Codes
TIP 2016/17-2020/21
Project # Fund Code Total
State
GRSC GROWTH MANAGEMENT FOR SCOP 216,342 299,406 566,427 890,916 0 1,973,091
SCED 2012 SB1998-SMALL CO OUTREACH 540,541 98,066 0 54,054 0 692,661
SCOP SMALL COUNTY OUTREACH PROGRAM 250,088 7,568 0 492,973 431,919 1,182,548
Total 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018
State 100%
SCWR 2015 SB2514A-SMALL CO OUTREACH 7,145 581,542 0 260,646 0 849,333
Total 7,145 581,542 0 260,646 0 849,333
Toll/Turnpike
PKYI TURNPIKE IMPROVEMENT 0 5,752,545 0 0 0 5,752,545
Total 0 5,752,545 0 0 0 5,752,545
Page 18
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
5-Year Summary of Funding Source by Codes
TIP 2016/17-2020/21
Project # Fund Code Total
Federal
ACNP ADVANCE CONSTRUCTION NHPP 52,304,560 0 0 0 0 52,304,560
CM CONGESTION MITIGATION - AQ 0 0 1,249,819 0 0 1,249,819
DU STATE PRIMARY/FEDERAL REIMB 160,777 172,222 176,354 148,857 148,750 806,960
FAA FEDERAL AVIATION ADMIN 0 900,000 900,000 0 0 1,800,000
FTA FEDERAL TRANSIT ADMINISTRATION 1,027,000 1,027,000 1,027,000 1,027,000 949,000 5,057,000
NHRE NAT HWY PERFORM - RESURFACING 0 0 2,799,597 0 0 2,799,597
PL METRO PLAN (85% FA; 15% OTHER) 421,630 421,630 421,630 421,630 421,630 2,108,150
PLH PUBLIC LANDS HIGHWAY 551,000 0 0 0 0 551,000
SA STP, ANY AREA 940,546 22,000 5,996,707 1,309,337 0 8,268,590
SU STP, URBAN AREAS > 200K 251,525 704,415 4,067,934 4,059,237 1,113,075 10,196,186
TALT TRANSPORTATION ALTS- ANY AREA 113,308 353,904 164,871 0 0 632,083
TALU TRANSPORTATION ALTS- >200K 143,692 0 164,095 0 0 307,787
Total 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732
Local
LF LOCAL FUNDS 1,379,753 1,472,749 1,291,195 796,755 565,422 5,505,874
LFP LOCAL FUNDS FOR PARTICIPATING 21,100 0 62,568 0 0 83,668
Total 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542
State
D UNRESTRICTED STATE PRIMARY 1,295,000 870,000 1,065,000 1,170,000 300,000 4,700,000
DDR DISTRICT DEDICATED REVENUE 9,429,488 4,214,714 9,773,349 1,055,007 6,656,693 31,129,251
DIH STATE IN-HOUSE PRODUCT SUPPORT 180,622 21,060 200,815 0 28,450 430,947
DITS STATEWIDE ITS - STATE 100%. 197,264 202,196 207,250 212,432 217,743 1,036,885
DPTO STATE - PTO 1,127,659 1,600,286 2,647,905 292,552 412,552 6,080,954
DS STATE PRIMARY HIGHWAYS & PTO 3,285,619 0 2,823,133 61,992 12,937 6,183,681
Page 19
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
5-Year Summary of Funding Source by Codes
TIP 2016/17-2020/21
Project # Fund Code Total
State
GRSC GROWTH MANAGEMENT FOR SCOP 216,342 299,406 566,427 890,916 0 1,973,091
SCED 2012 SB1998-SMALL CO OUTREACH 540,541 98,066 0 54,054 0 692,661
SCOP SMALL COUNTY OUTREACH PROGRAM 250,088 7,568 0 492,973 431,919 1,182,548
Total 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018
State 100%
SCWR 2015 SB2514A-SMALL CO OUTREACH 7,145 581,542 0 260,646 0 849,333
Total 7,145 581,542 0 260,646 0 849,333
Toll/Turnpike
PKYI TURNPIKE IMPROVEMENT 0 5,752,545 0 0 0 5,752,545
Total 0 5,752,545 0 0 0 5,752,545
Page 20
Project C or N Priority Total To Date Unfunded FY2016 FY2017 FY2018 FY2019 FY2020 FY2021 FY2022 FY2023 FY2024 FY2025
Resurfacing, Drainage, Striping & Maintenance (1017) N 1 119,454,000 0 106,781,000 1,016,000 837,000 847,000 1,284,000 1,454,000 22,803,200 22,803,200 22,803,200 22,803,200 22,803,200
CR-714 (SW Martin Hwy) / CR-609 (SW Allapattah Rd) - Resurfacing (101710) N 1 1,948,452.5 5,958 0 1,942,495 0 0 0 0 0 0 0 0 0
CR-726 (Citrus Blvd) - Resurfacing & Bike Lanes (101701) N 1 3,556,152 11,390 0 3,544,762 0 0 0 0 0 0 0 0 0
CR-708 (Bridge Rd) - Resurfacing & Bike Lanes (101706) N 1 958,569.0 5,520 0 953,049 0 0 0 0 0 0 0 0 0
CR711 (Pratt Whitney Rd) - Resurfacing & Bike Lanes (101707) N 1 3,343,896 57,053 0 3,286,843 0 0 0 0 0 0 0 0 0
SE Cove Road - Resurfacing (101712) N 1 1,497,776.0 0 0 0 60,000 10,000 0 1,427,776 0 0 0 0 0
Signal & Intersection Improvements (1016) N 1, 2, 4 4,233,717 0 0 375,000 630,000 375,000 390,000 588,717 375,000 375,000 375,000 375,000 375,000
Streetlights - Dixie Hwy (1121) N 1, 2, 4 530,000.0 175,000 215,000 140,000 0 0 0 0 215,000 0 0 0 0
Annual Commitments (1019) N 8 3,755,218.0 0 0 605,218 350,000 350,000 350,000 350,000 350,000 350,000 350,000 350,000 350,000
Multi-Modal Pathways (1011) N 1 200,000 0 0 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000
Baker Road Improvements (1011H) N 1 370,400.0 0 0 370,400 0 0 0 0 0 0 0 0 0

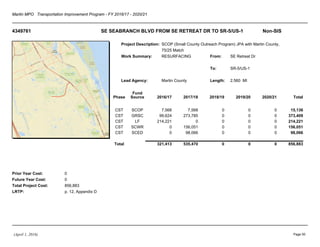

SE Seabranch Blvd - Resurfacing (101709) N 2 1,016,217 0 0 60,000 10,000 0 946,217 0 0 0 0 0 0
SW High Meadow Ave - Resurfacing & Bike Lanes (101711) N 2 1,399,115.0 0 0 65,000 10,000 0 1,324,115 0 0 0 0 0 0
SW Mapp Road - Resurfacing (101714) N 2 1,256,688 0 0 60,000 10,000 1,186,688 0 0 0 0 0 0 0
SW Murphy Road Resurfacing (101715) N 2 1,009,139.0 0 0 60,000 10,000 0 939,139 0 0 0 0 0 0
Parkwood Subdivision Resurfacing (101717) N 2 1,401,000.0 0 0 1,401,000 0 0 0 0 0 0 0 0 0
Palm City Farms Resurfacing (101718) N 2 935,000.0 0 0 935,000 0 0 0 0 0 0 0 0 0
Skyline/Highland/Pitchford Resurfacing (101719) N 2 526,000.0 0 0 526,000 0 0 0 0 0 0 0 0 0
Pinecrest Lakes Resurfacing (101720) N 2 769,000.0 0 0 769,000 0 0 0 0 0 0 0 0 0
Poinciana Gardens Resurfacing (101721) N 2 556,000.0 0 0 556,000 0 0 0 0 0 0 0 0 0
96th Street/Greenridge Resurfacing (101722) N 2 255,000.0 0 0 255,000 0 0 0 0 0 0 0 0 0
Heritage Ridge Resurfacing (101723) N 2 935,000.0 0 0 935,000 0 0 0 0 0 0 0 0 0
Murphy Rd (over C-23) - Bridge Replacement (105303) N 2 3,532,215 170,000 0 25,000 25,000 25,000 25,000 3,262,215 0 0 0 0 0
Bridge Replacements/Renovations (1053) N 2 21,391,740.0 0 18,030,480 124,000 157,250 157,250 157,250 157,250 4,127,748 4,127,748 4,127,748 4,127,748 4,127,748
Britt Rd Bridge - Bridge Replacement (105301) N 2 1,733,000 233,000 1,500,000 0 0 0 0 0 1,500,000 0 0 0 0
Heavy Equipment Replacement (4957) N 2 9,964,899.6 0 5,214,121 700,779 450,000 450,000 450,000 450,000 1,492,824 1,492,824 1,492,824 1,492,824 1,492,824
Engineering Field Ops and Traffic Building Replacement N 2 1,352,000 0 1,352,000 0 0 0 0 0 1,352,000 0 0 0 0
South Beach Road Resurfacing (1019) N 2 5,111,918 0 0 475,000 0 4,636,918 0 0 0 0 0 0
Hutchinson Island Beautification (2028A) N 10 1,386,450 319,950 0 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650
SR-76 (S Kanner Hwy) - Interchange (1074A) C 3 7,011,133.0 2,965,133 0 4,046,000 0 0 0 0 0 0 0 0 0
SR-714 (Martin Hwy) - Widening (1123A) C 3 2,345,000.0 0 0 510,000 1,835,000 0 0 0 0 0 0 0 0
SR-76 (S Kanner Hwy) - Widening (1074) C 7 29,027,551 28,369,336 0 154,000 504,215 0 0 0 0 0 0 0 0
SE Willoughby Blvd - Extension (1031) C 5 5,920,000 1,915,000 3,024,688 837,000 0 0 0 0 3,168,000 0 0 0 0
SR710 (SW Warfield Blvd) - Widening (1066) C 5 2,225,000.0 0 1,908,574 0 0 0 0 257,000 1,968,000 0 0 0 0
Expenditure Totals 240,907,246 34,227,340 138,025,863 24,379,196 5,490,115 3,527,588 10,629,289 8,073,608 37,478,422 29,275,422 29,275,422 29,275,422 29,275,422
Revenue Total To Date Carryover FY2016 FY2017 FY2018 FY2019 FY2020 FY2021 FY2022 FY2023 FY2024 FY2025
Ad Valorem 5,377,000 0 0 5,377,000 0 0 0 0 0 0 0 0 0
City Funds 556,000 250,000 306,000 0 0 0 0 0 0 0 0 0 0
Gas Tax 21,741,329 1,270,163 3,181,166 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000
Grant 25,212,351 2,560,061 2,347,500 7,846,277 475,000 806,688 7,126,834 4,049,991 0 0 0 0 0
Hutchinson Island MSTU 1,386,450 319,950 0 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650
Impact Fee 1,707,715 695,872 811,843 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000
LLC Contribution 1,600,000 756,000 844,000 0 0 0 0 0 0 0 0 0 0
Prop Share 316,426 0 0 0 0 0 316,426 0 0 0 0 0 0
Road MSTU 13,205,796 5,958 1,199,838 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000
State Funds 31,781,268 28,369,336 0 664,000 2,594,215 0 0 153,717 0 0 0 0 0
Revenue Total 102,884,335 34,227,340 8,690,347 16,942,927 6,124,865 3,862,338 10,498,910 7,259,358 3,055,650 3,055,650 3,055,650 3,055,650 3,055,650
Total Unfunded 138,025,863
FY 2016
MARTIN COUNTY CAPITAL IMPROVEMENT PLAN (CIP)
ROADS EXPENDITURE SUMMARY
ROADS REVENUE SUMMARY
Page 21
Page 22
Page 23
Town of Sewall's Point 2016
CAPITAL IMPROVEMENT PLAN 2016 2017 2018 2019 2020 5-YEAR TOTAL
Streets & Bridges 90,000 350,000 350,000 345,000 345,000 1,480,000
Storm Water System 72,500 72,500 72,500 35,000 35,000 287,500
Vehicles 0 90,000 0 60,000 0 150,000
Parks & Landscaping 30,000 17,000 20,000 17,000 20,000 104,000
Town Hall 10,000 20,000 20,000 15,000 10,000 75,000
Pedway 0 25,000 85,000 0 0 110,000
Annual Expenditures 202,500 574,500 547,500 472,000 410,000 2,206,500
Page 24
Page 25
MARTIN COUNTY TRANSPORTATION IMPROVEMENT PROGRAM
FY15 FEDERAL OBLIGATED
ITEM NO PROJECT NAME FUND WORK MIX PHASE 2015 FUNDING
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION CONSTRUCTION ‐1,971,029
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SA NEW BRIDGE CONSTRUCTION CONSTRUCTION ‐83,375
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION GRANTS AND MISCELLANEOUS ‐7,754
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐1,412,028
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY HPP NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐553
230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SA NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐416,375
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT CONSTRUCTION 9,000
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT CONSTRUCTION 976,276
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SU ADD LANES & RECONSTRUCT GRANTS AND MISCELLANEOUS ‐17,694
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT PRELIMINARY ENGINEERING ‐426
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT PRELIMINARY ENGINEERING ‐151
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT RIGHT OF WAY 6,860
230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT RIGHT OF WAY 10,646
230978 4 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SU ENVIRONMENTAL MITIGATION CONSTRUCTION 2,931
230978 4 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SU ENVIRONMENTAL MITIGATION GRANTS AND MISCELLANEOUS 500,000
413254 1 SR‐9/I‐95 F. S OF CR‐708/BRIDGE RD. TO HIGH MEADOW NHPP PD&E/EMO STUDY PRELIMINARY ENGINEERING 23,403
419250 2 SR‐710 BRIDGE #890016, BRIDGE REPLACEMENT NH BRIDGE‐REPLACE AND ADD LANES CONSTRUCTION ‐1,749,908
419250 2 SR‐710 BRIDGE #890016, BRIDGE REPLACEMENT SA BRIDGE‐REPLACE AND ADD LANES CONSTRUCTION 75,930
419250 4 SR‐710/WARFIELD BLVD FROM SW TRAIL DRIVE TO ENTRANCE RAMP TO SR‐76 SU LIGHTING CONSTRUCTION 2,931
427023 1 SR‐5/US‐1 FROM PBC/MARTIN CO LINE TO MP 5.03 NHRE RESURFACING CONSTRUCTION ‐70,184
427023 1 SR‐5/US‐1 FROM PBC/MARTIN CO LINE TO MP 5.03 SA RESURFACING CONSTRUCTION ‐64,147
427664 1 PALM CITY CRA SIDEWALKS EB SIDEWALK CONSTRUCTION ‐696
427664 1 PALM CITY CRA SIDEWALKS TALU SIDEWALK CONSTRUCTION 14,067
427664 1 PALM CITY CRA SIDEWALKS TALU SIDEWALK CONSTRUCTION 7,153
429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD HSP LIGHTING CONSTRUCTION 27,432
429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD EB LIGHTING GRANTS AND MISCELLANEOUS ‐524
429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD NHPP LIGHTING PRELIMINARY ENGINEERING 16,441
429745 1 SR‐5/US‐1 @ SE POINCIANA LANE HSP LIGHTING CONSTRUCTION ‐55,067
431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SA RESURFACING CONSTRUCTION 89,038
431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SU RESURFACING CONSTRUCTION 2,961,935
431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SU RESURFACING CONSTRUCTION 105,000
431646 1 CR‐707/DIXIE HWY FR. SOUTH OF FLORIDA ST. TO NORTH OF SE 5TH ST. TALT BIKE LANE/SIDEWALK CONSTRUCTION 5,000
431646 1 CR‐707/DIXIE HWY FR. SOUTH OF FLORIDA ST. TO NORTH OF SE 5TH ST. TALU BIKE LANE/SIDEWALK CONSTRUCTION 50
431649 1 CR‐A1A/SE DIXIE HWY. FROM US‐1 TO SATURN STREET TALT BIKE LANE/SIDEWALK CONSTRUCTION ‐113
431730 1 INDIANTOWN CONNECTOR SIDEWALKS TALT SIDEWALK CONSTRUCTION 830,034
431730 1 INDIANTOWN CONNECTOR SIDEWALKS TALT SIDEWALK CONSTRUCTION 27,233
433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALU SIDEWALK CONSTRUCTION 43,400
433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALU SIDEWALK CONSTRUCTION 13,000
433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE EB SIDEWALK PRELIMINARY ENGINEERING 7,000
Page 26
MARTIN COUNTY TRANSPORTATION IMPROVEMENT PROGRAM
FY15 FEDERAL OBLIGATED
433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALT SIDEWALK PRELIMINARY ENGINEERING 300
434008 1 SW CITRIS BLVD. EMBANKMENT SLOPE EROSION MARTIN COUNTY (EMERGENCY) ER13 EMERGENCY OPERATIONS GRANTS AND MISCELLANEOUS 600
434273 1 I‐95/SR‐9 FR PALM BEACH COUNTYLINE TO N OF CR‐708/SE BRIDGE ROAD NHPP RESURFACING PRELIMINARY ENGINEERING ‐188,991
435353 1 SR‐76/ SW KANNER HWY @SCFE R/R XING #272274‐B RR MP; K 40.14 RHH RAIL SAFETY PROJECT RAILROAD AND UTILITIES 47,734
435423 1 SR‐714/SW MARTIN HWY @ SCFE CROSSING 272270Y RHH RAIL SAFETY PROJECT RAILROAD AND UTILITIES 36,607
436735 1 JONATHAN DICKINSON STATE PARK‐FLAP GRANT FOR TRAIL & US‐1 SIGNALIZATN PLH MISCELLANEOUS CONSTRUCTION PRELIMINARY ENGINEERING 100,000
427829 1 MARTIN UPWP FY 2012/2013 & 2013/2014 PL TRANSPORTATION PLANNING PRELIMINARY ENGINEERING ‐574,224
427830 1 MARTIN UPWP FY 2014/2015 & 2015/2016 PL TRANSPORTATION PLANNING PRELIMINARY ENGINEERING 838,079
Page 27
434273.4
434273.1
435139.1
432705.1
437701.1
437838.1
434275.1
432348.1
436096.1
438040.1
436869.1
434733.1
433349.1
10
10
10
Witham Field
Indiantown Airport
Hobe
Sound
North
Fork
St
Lucie
River
Loxahatchee
River
South
Fork
St
Lucie
River
LAKE OKEECHOBEE
INDIANRIVER
ATLANTICOCEAN
ST716
ST714
ST710
STA1A
ST732
ST707
ST5
ST91
ST76
£¤1
£¤1
£¤98
§¨¦95
§¨¦95
State of Florida
Department of Transportation
0 2 4
Miles
®
Deepwater Seaportí
n¤ Passenger Intermodal Station
Bus Stationn£
Freight Intermodal Station#
Major US or State Highway
Other US or State Highway
County Highway
Major Airport
o
Interstate Highway
Public Airportp
Transportation Facilities
Railway
Florida at Work
Transportation Improvements
MARTIN COUNTY
FY 2017-2021 Tentative
Work Program
FDOT Construction Only
Overview Map:
Area of Interest
2017
2018
2019
2020
2021
Projects by First Year
of Construction
Page 28
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Number)
FM # TIP # Project Name Page
4130805 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4
4130806 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4
4130807 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4
4134931 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT CAPITAL - 5307 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3
4137332 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO TRANSIT PLANNING - 5303 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3
4192522 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT TO CR609/SW ALLAPATTAH RD . . . . . . . A-3
4226413 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76/KANNER HWY - FROM LOST RIVER ROAD to MONTEREY RD. . . . . . . . . . . . . . . . . . . . . . . . . A-4
4241336 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
4241337 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
4259772 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT OPERATING - 5311 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4
4259773 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4
4278033 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-5
4278302 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO PL FY 16/17 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-6
4278303 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN UPWP FY 18-19/19-20 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-7
4278304 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-8
2309782 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/INDIAN ST - MARTIN DOWNS TO MAPP . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-2
2337031 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS ROADWAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
2337032 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
2339565 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
2339567 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO-PRIMARY MOWING & LITTER CONTRACT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
2342651 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
2342652 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO INTERSTATE BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
4071892 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT OPERATING - STATE GRANT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2
4071893 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2
(April 1, 2016) Page 29
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Number)
FM # TIP # Project Name Page
4293105 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS ... . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
4297744 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST PRIMARY ASPHALT REPAIR ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-6
4310351 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2
4315151 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY D . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2
4323481 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-732/JENSEN BCH BL FROM SR-5/US-1 TO SAVANAH RD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-9

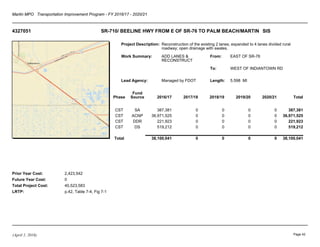

4327051 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/BEELINE HWY FROM E. OF SR-76 TO PALM BEACH/MARTIN CL . . . . . . . . . . . . . . . . . . . . . . A-10
4330691 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SW BRIDGE RD FROM SR-76/SW KANNER HWY TO SW PRATT-WHITNEY RD . . . . . . . . . . A-11
4331591 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE . . . . . . . . . . . . . . . . . . . . . . . . . C-3

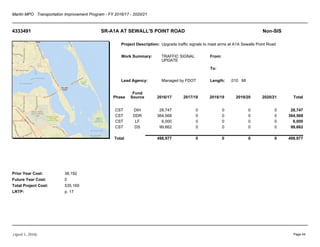

4333491 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A AT SEWALL'S POINT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-12
4342731 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FR PALM BEACH COUNTYLINE TO N OF CR-807/SE BRDG RD . . . . . . . . . . . . . . . . . . . . . . A-13
4342734 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 INTERCHANGE . . . . . . . . . . . . . . . . . . . A-14
4342751 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76 KANNER HIGHWAY PORT MAYACA AREA . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-15
4346201 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) . . . . . . . . . . . . . . . . . . . . . . . . C-3
4346241 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) . . . . . . . . . . . . . . . . . . . . . . C-4
4346371 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-4
4346601 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS . . . . . . . . . . . . . . . . . . . . . . . B-5
4346611 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SEC 5339 CAPITAL FOR BUS & BUS FACILITIES . . . . . . . . . . . . . . . . . . . . . . B-5
4347331 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-16
(April 1, 2016)
Page 30
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Number)
FM # TIP # Project Name Page
4348381 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF SR-9/I-95 . . . . . . . . . . . . . . . . . . . . A-17
4349761 . . . . . . . . . . . . . . . . . . . . . . . . . . . S.E. SEABRANCH BLVD. FROM S.E. RETREAT DR. TO SR-5/US-1 . . . . . . . . . . . . . . . . . . . . . . . . . . . A-18
4351391 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL TO CR-708/SE BRIDGE ROAD . . . . . . . A-19
4354131 . . . . . . . . . . . . . . . . . . . . . . . . . . . MAPP RD. FROM SW MARTIN DOWNS BLVD TO SW MARTIN HIGHWAY . . . . . . . . . . . . . . . . . . . . . . A-20
4354531 . . . . . . . . . . . . . . . . . . . . . . . . . . . HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/MARTIN DOWNS BVLD . . . . . . . . . . . . . . . . . . A-21

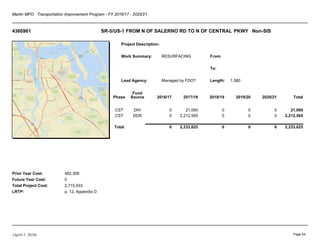

4360961 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 FROM NORTH OF SALERNO RD. TO NORTH OF CENTRAL PARKWAY . . . . . . . . . . . . . . A-22
4363771 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MAPP RD.FROM SR-714/SW MARTIN DOWNS BLVD TO SW BRIDGEWAY ST. . . . . . . . . . . . . . . A-23
4363781 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MURPHY RD. FROM SW MAPP RD/SW MATHESON AVE TO MARTIN/ST. LUCIE CL . . . . . . . . . A-24
4364001 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS . . . . . . . . . . . . . . C-5
4364011 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) . . . . . . . . . . . . C-5
4364251 . . . . . . . . . . . . . . . . . . . . . . . . . . . MURPHY ROAD BRIDGE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-25

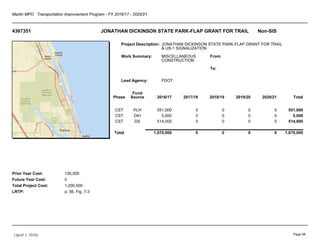

4367351 . . . . . . . . . . . . . . . . . . . . . . . . . . . JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL & US-1 SIGNALIZTION . . . . . . . . . . A-26
4368511 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-27
4368611 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE KINDRED STREET/SE JOHNSON AVE FROM SOUTH COLORADO TO SR-5/US-1 . . . . . . . . . . . . A-28
4368691 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD. . . . . . . . . . . . . . . . . . . . A-29
4368701 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLVD. TO SW MARTIN DOWNS BLVD. . . . . . . . . . . . . . . . A-30
4369671 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-31
4377011 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . A-32
4378381 . . . . . . . . . . . . . . . . . . . . . . . . . . . US-1/SR-5 FROM SOUTHEAST HERITAGE BLVD. TO NORTH OF SALERNO RD. . . . . . . . . . . . . . . . . A-33
4379631 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT SECURITY FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-5
4379641 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, WILDLIFE FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-6
4379711 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE PREPARATION . . . . . . . . . . . . C-6
4379801 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST) . . . . . . . . . . . . . . . C-6
4379921 . . . . . . . . . . . . . . . . . . . . . . . . . . . RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . . . . . . . . G-6
4379922 . . . . . . . . . . . . . . . . . . . . . . . . . . . THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . G-6
4379923 . . . . . . . . . . . . . . . . . . . . . . . . . . . ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . . . . . . . G-7
4380401 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-34
(April 1, 2016)
Page 31
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Number)
FM # TIP # Project Name Page
4380711 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE INDIAN ST FR US-1/FEDERAL HWY TO S OF RAILROAD CROSSING . . . . . . . . . . . . . . . . . . . . . . A-35
4380721 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE DIXIE HWY/CR-A1A FR SE JEFFERSON ST TO SE INDIAN ST . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-36
4381251 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DRIVE . . . . . . . . . . . . . . . . . . . A-37
4383421 . . . . . . . . . . . . . . . . . . . . . . . . . . . SAVANNAH ROAD FROM NE CARDINAL AVENUE TO JENSEN BEACH BOULEVARD . . . . . . . . . . . . A-38

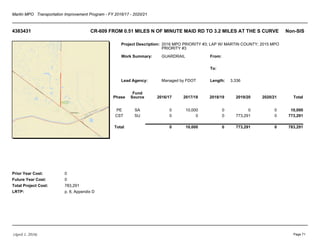

4383431 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-609 FROM .51 MILES N. OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE . . . . . . . . . . . . . . A-39
4383441 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLV TO SW MARTIN DOWNS BLV - RESERVE . . . . . . . . . A-40
4383451 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-41
4383452 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-42
4383461 . . . . . . . . . . . . . . . . . . . . . . . . . . . MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST. LUCIE BLVD . . . . . . . . . . . . . . . . . . . . . . . A-43
4383471 . . . . . . . . . . . . . . . . . . . . . . . . . . . INDIAN STREET FROM DIXIE HIGHWAY TO ST. LUCIE BLVD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-44
4383481 . . . . . . . . . . . . . . . . . . . . . . . . . . . ST. LUCIE BLVD FROM INDIAN ST TO E. OCEAN BLVD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-45
4385221 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS . . . . . . . . . . . . . . . . . B-6
4385241 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE . . . . . . . . . . . . . . . . . . . . . . B-6
4385661 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-46
(April 1, 2016)
Page 32
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Section A - Highway
(April 1, 2016) Page 33
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

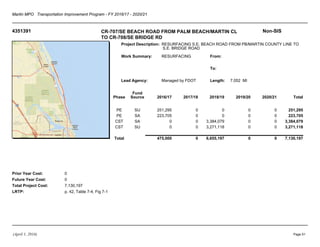

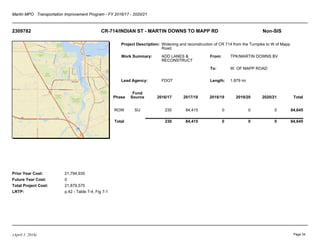

2309782 CR-714/INDIAN ST - MARTIN DOWNS TO MAPP RD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Widening and reconstruction of CR 714 from the Turnpike to W of Mapp
Road.
ADD LANES &
RECONSTRUCT
FDOT
TPK/MARTIN DOWNS BV
W. OF MAPP ROAD
1.879 mi
21,794,930
0
21,879,575
p.42 - Table 7-4, Fig 7-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
ROW SU 230 84,415 0 0 0 84,645
Total 230 84,415 0 0 0 84,645
(April 1, 2016) Page 34
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

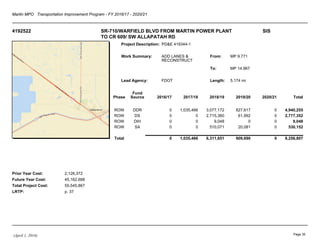

4192522 SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT
TO CR 609/ SW ALLAPATAH RD
SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
PD&E 419344-1
ADD LANES &
RECONSTRUCT
FDOT
MP 9.771
MP 14.967
5.174 mi
2,126,372
45,162,688
55,545,867
p. 37
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
ROW DDR 0 1,035,466 3,077,172 827,617 0 4,940,255
ROW DS 0 0 2,715,360 61,992 0 2,777,352
ROW DIH 0 0 9,048 0 0 9,048
ROW SA 0 0 510,071 20,081 0 530,152
Total 0 1,035,466 6,311,651 909,690 0 8,256,807
(April 1, 2016) Page 35
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

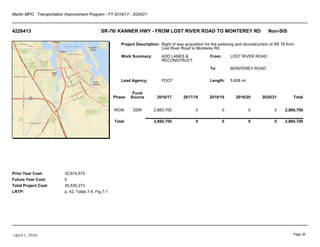

4226413 SR-76/ KANNER HWY - FROM LOST RIVER ROAD TO MONTEREY RD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Right of way acquisition for the widening and reconstruction of SR 76 from
Lost River Road to Monterey Rd.
ADD LANES &
RECONSTRUCT
FDOT
LOST RIVER ROAD
MONTEREY ROAD
5.608 mi
32,674,573
0
35,535,273
p. 42, Table 7-4, Fig 7-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
ROW DDR 2,860,700 0 0 0 0 2,860,700
Total 2,860,700 0 0 0 0 2,860,700
(April 1, 2016) Page 36
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4278033 MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
TRAFFIC CONTROL
DEVICES/SYSTEM
Managed by MARTIN
COUNTY BOARD OF
.000
228,456
0
1,842,959
p. 10, Table 3-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
OPS DITS 197,264 202,196 207,250 212,432 217,743 1,036,885
OPS DDR 136,599 141,683 146,946 152,390 0 577,618
Total 333,863 343,879 354,196 364,822 217,743 1,614,503
(April 1, 2016) Page 37
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4278302 MARTIN MPO PL FY 16/17 Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
TRANSPORTATION PLANNING FUNDS; UPWP 2016/2017 & 2017/2018
TRANSPORTATION
PLANNING
FDOT
FY 2016/2017
2017/2018
0
0
843,260
p. 10, Table 3-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PLN (12) PL 421,630 0 0 0 0 421,630
PLN PL 0 421,630 0 0 0 421,630
Total 421,630 421,630 0 0 0 843,260
(April 1, 2016) Page 38
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

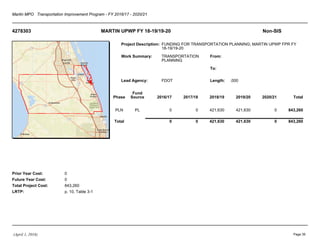

4278303 MARTIN UPWP FY 18-19/19-20 Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
FUNDING FOR TRANSPORTATION PLANNING; MARTIN UPWP FPR FY
18-19/19-20
TRANSPORTATION
PLANNING
FDOT .000
0
0
843,260
p. 10, Table 3-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PLN PL 0 0 421,630 421,630 0 843,260
Total 0 0 421,630 421,630 0 843,260
(April 1, 2016) Page 39
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

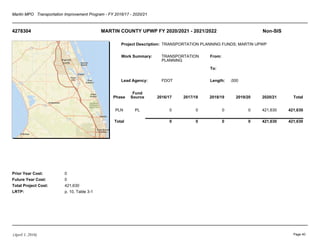

4278304 MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
TRANSPORTATION PLANNING FUNDS; MARTIN UPWP
TRANSPORTATION
PLANNING
FDOT .000
0
0
421,630
p. 10, Table 3-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PLN PL 0 0 0 0 421,630 421,630
Total 0 0 0 0 421,630 421,630
(April 1, 2016) Page 40
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4323481 SR-732/ JENSEN BEACH BLVD FROM SR-5/US-1 TO SAVANNA RD Non-SIS

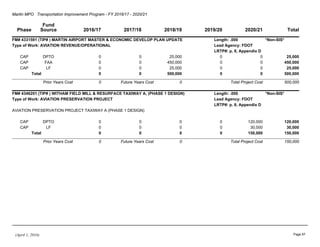

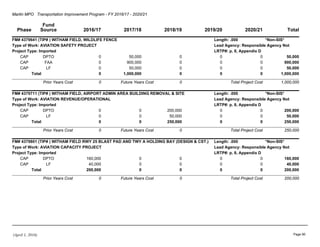

Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
RESURFACING
Managed by FDOT
SR-5/ US-1
Savannah Road
2.210
0
0
2,480,471
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE DDR 207,761 0 0 0 0 207,761
PE DIH 10,000 0 0 0 0 10,000
CST SA 0 0 1,926,766 0 0 1,926,766
CST DIH 0 0 65,566 0 0 65,566
CST DDR 0 0 270,378 0 0 270,378
Total 217,761 0 2,262,710 0 0 2,480,471
(April 1, 2016) Page 41
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4327051 SR-710/ BEELINE HWY FROM E OF SR-76 TO PALM BEACH/MARTIN SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Reconstruction of the existing 2 lanes; expanded to 4 lanes divided rural
roadway; open drainage with swales.
ADD LANES &
RECONSTRUCT
Managed by FDOT
EAST OF SR-76
WEST OF INDIANTOWN RD
5.598 MI
2,423,542
0
40,523,583
p.42, Table 7-4, Fig 7-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SA 387,381 0 0 0 0 387,381
CST ACNP 36,971,525 0 0 0 0 36,971,525
CST DDR 221,923 0 0 0 0 221,923
CST DS 519,212 0 0 0 0 519,212
Total 38,100,041 0 0 0 0 38,100,041
(April 1, 2016) Page 42
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4330691 CR-708/ SW BRIDGE RD FROM SR-76/ SW KANNER HWY
TO SW PRATT-WHITNEY RD
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Resurfacing; SCOP (Small County Outreach Program);
RESURFACING
Martin County
SR-76
SW Pratt-Whitney Road
2.676 MI
0
0
803,904
p. 12, Appendix D, p. 8
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCED 540,541 0 0 0 0 540,541
CST GRSC 62,387 0 0 0 0 62,387
CST LF 200,976 0 0 0 0 200,976
Total 803,904 0 0 0 0 803,904
(April 1, 2016) Page 43
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4333491 SR-A1A AT SEWALL'S POINT ROAD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Upgrade traffic signals to mast arms at A1A Sewalls Point Road
TRAFFIC SIGNAL
UPDATE
Managed by FDOT .010 MI
36,192
0
535,169
p. 17
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DIH 28,747 0 0 0 0 28,747
CST DDR 364,568 0 0 0 0 364,568
CST LF 6,000 0 0 0 0 6,000
CST DS 99,662 0 0 0 0 99,662
Total 498,977 0 0 0 0 498,977
(April 1, 2016) Page 44
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4342731 I-95/SR-9 FROM PALM BEACH COUNTYLINE TO N OF CR-807/SE BRIDGE RD SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
NEW INTERSTATE RRR CANDIDATE
RESURFACING
Managed by FDOT
PALM BEACH COUNTYLINE
N OF C-807/SE BRDGE ROAD
7.849 MI
394,331
0
16,126,826
p. 7, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SA 324,460 0 0 0 0 324,460
CST ACNP 15,333,035 0 0 0 0 15,333,035
INC SA 0 0 75,000 0 0 75,000
Total 15,657,495 0 75,000 0 0 15,732,495
(April 1, 2016) Page 45
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

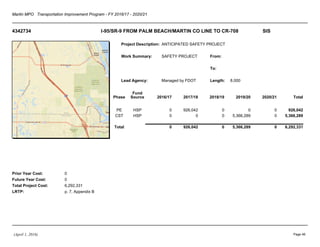

4342734 I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
ANTICIPATED SAFETY PROJECT
SAFETY PROJECT
Managed by FDOT 8.000
0
0
6,292,331
p. 7, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE HSP 0 926,042 0 0 0 926,042
CST HSP 0 0 0 5,366,289 0 5,366,289
Total 0 926,042 0 5,366,289 0 6,292,331
(April 1, 2016) Page 46
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4342751 SR-76 KANNER HIGHWAY PORT MAYACA AREA Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
THIS SEGMENT IS OUT BY THE LAKE IN THE PORT MAYACA AREA
CHANGE TRANSPORT SYSTEM 05 TO 03 2013-07-13 CHANGE
RESURFACING
Managed by FDOT 1.810 MI
350,871
0
2,172,954
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DIH 25,625 0 0 0 0 25,625
CST DDR 1,750,015 0 0 0 0 1,750,015
CST DS 46,443 0 0 0 0 46,443
Total 1,822,083 0 0 0 0 1,822,083
(April 1, 2016) Page 47
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

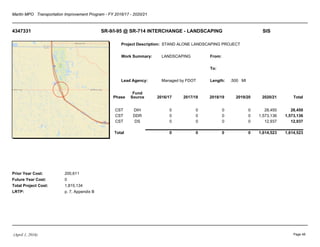

4347331 SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
STAND ALONE LANDSCAPING PROJECT
LANDSCAPING
Managed by FDOT .500 MI
200,611
0
1,815,134
p. 7, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DIH 0 0 0 0 28,450 28,450
CST DDR 0 0 0 0 1,573,136 1,573,136
CST DS 0 0 0 0 12,937 12,937
Total 0 0 0 0 1,614,523 1,614,523
(April 1, 2016) Page 48
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

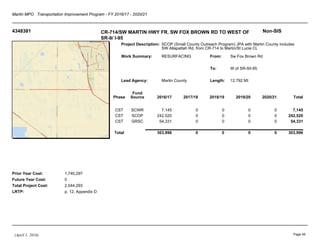

4348381 CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF
SR-9/ I-95
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
SCOP (Small County Outreach Program) JPA with Martin County includes
SW Allapattah Rd. from CR-714 to Martin/St Lucie CL
RESURFACING
Martin County
Sw Fox Brown Rd
W of SR-9/I-95
12.792 MI
1,740,297
0
2,044,293
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCWR 7,145 0 0 0 0 7,145
CST SCOP 242,520 0 0 0 0 242,520
CST GRSC 54,331 0 0 0 0 54,331
Total 303,996 0 0 0 0 303,996
(April 1, 2016) Page 49
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4349761 SE SEABRANCH BLVD FROM SE RETREAT DR TO SR-5/US-1 Non-SIS
Project Description:
Work Summary:
Lead Agency:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Martin County
SCOP (Small County Outreach Program) JPA with Martin County,
75/25 Match
RESURFACING From: SE Retreat Dr
SR-5/US-1
2.560 MI
0
0
856,883
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCOP 7,568 7,568 0 0 0 15,136
CST GRSC 99,624 273,785 0 0 0 373,409
CST LF 214,221 0 0 0 0 214,221
CST SCWR 0 156,051 0 0 0 156,051
CST SCED 0 98,066 0 0 0 98,066
Total 321,413 535,470 0 0 0 856,883
(April 1, 2016) Page 50
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4351391 CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL
TO CR-708/SE BRIDGE RD
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
RESURFACING S.E. BEACH ROAD FROM PB/MARTIN COUNTY LINE TO
S.E. BRIDGE ROAD
RESURFACING
Managed by FDOT 7.052 MI
0
0
7,130,197
p. 42, Table 7-4, Fig 7-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 251,295 0 0 0 0 251,295
PE SA 223,705 0 0 0 0 223,705
CST SA 0 0 3,384,079 0 0 3,384,079
CST SU 0 0 3,271,118 0 0 3,271,118
Total 475,000 0 6,655,197 0 0 7,130,197
(April 1, 2016) Page 51
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4354131 MAPP RD FROM SW MARTIN DOWNS BLVD TO SW MARTIN HWY Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Bike lane/Sidewalk; LAP with Martin County; MPO 2013 Priority #2
BIKE LANE/SIDEWALK
Martin County
SW Martin Downs Blvd
SW Martin Hwy
.771 MI
4,381
0
275,481
p. 17
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST TALT 113,308 0 0 0 0 113,308
CST LFP 21,100 0 0 0 0 21,100
CST TALU 136,692 0 0 0 0 136,692
Total 271,100 0 0 0 0 271,100
(April 1, 2016) Page 52
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4354531 HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/
MARTIN DOWNS BLVD
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
Resurfacing
RESURFACING
Martin County
Martin Hwy
SR-714/Martin Downs Blvd
.796 MI
0
0
1,355,610
p. 42, Table 7-4, Fig 7-1
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SA 5,000 0 0 0 0 5,000
CST CM 0 0 1,249,819 0 0 1,249,819
CST SA 0 0 100,791 0 0 100,791
Total 5,000 0 1,350,610 0 0 1,355,610
(April 1, 2016) Page 53
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4360961 SR-5/US-1 FROM N OF SALERNO RD TO N OF CENTRAL PKWY Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
RESURFACING
Managed by FDOT 1.580
482,308
0
2,715,933
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DIH 0 21,060 0 0 0 21,060
CST DDR 0 2,212,565 0 0 0 2,212,565
Total 0 2,233,625 0 0 0 2,233,625
(April 1, 2016) Page 54
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
(April 1, 2016)

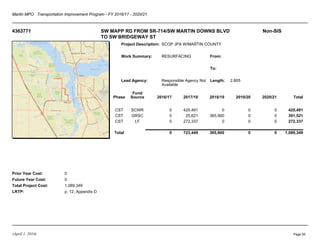

4363771 SW MAPP RD FROM SR-714/SW MARTIN DOWNS BLVD
TO SW BRIDGEWAY ST
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
SCOP JPA W/MARTIN COUNTY
RESURFACING
Responsible Agency Not
Available
2.805
0
0
1,089,349
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCWR 0 425,491 0 0 0 425,491
CST GRSC 0 25,621 365,900 0 0 391,521
CST LF 0 272,337 0 0 0 272,337
Total 0 723,449 365,900 0 0 1,089,349
Page 55
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
(April 1, 2016)
4363781 SW MURPHY RD FROM SW MAPP RD/SW MATHESON AVE TO
MARTIN/ST LUCIE CL
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
SCOP JPA W/ MARTIN COUNTY MILE POINT EXCEPTION FROM 3.46
TO 3.48
RESURFACING
Responsible Agency Not
Available
2.660
0
0
877,129
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST GRSC 0 0 200,527 457,320 0 657,847
CST LF 0 0 219,282 0 0 219,282
Total 0 0 419,809 457,320 0 877,129
Page 56
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4364251 MURPHY ROAD BRIDGE Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
LAP CRITICAL PROJECT W/ MARTIN COUNTY; MPO 2014 PRIORITY #2
BRIDGE REPLACEMENT
Managed by FDOT .020
0
0
3,258,239
P. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SA 0 7,000 0 0 0 7,000
CST SA 0 0 0 1,289,256 0 1,289,256
CST SU 0 0 0 1,961,983 0 1,961,983
Total 0 7,000 0 3,251,239 0 3,258,239
(April 1, 2016) Page 57
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4367351 JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL
& US-1 SIGNALIZATION
MISCELLANEOUS
CONSTRUCTION
FDOT
130,000
0
1,200,000
p. 56, Fig. 7-3
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST PLH 551,000 0 0 0 0 551,000
CST DIH 5,000 0 0 0 0 5,000
CST DS 514,000 0 0 0 0 514,000
Total 1,070,000 0 0 0 0 1,070,000
(April 1, 2016) Page 58
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4368511 SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
SMALL COUNTY OUTREACH PROGRAM JPA WITH MARTIN COUNTY.
RESURFACING
Responsible Agency Not
Available
4.340
0
0
1,345,657
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCWR 0 0 0 260,646 0 260,646
CST SCED 0 0 0 54,054 0 54,054
CST SCOP 0 0 0 260,947 0 260,947
CST GRSC 0 0 0 433,596 0 433,596
CST LF 0 0 0 336,414 0 336,414
Total 0 0 0 1,345,657 0 1,345,657
(April 1, 2016) Page 59
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4368611 SE KINDRED STREET/SE JOHNSON AVE FROM S COLORADO TO SR-5/ US-1 Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2014 MPO TAP PRIORITY #1 LAP PROJECT WITH MARTIN COUNTY
SIDEWALK
Managed by FDOT .381
5,000
0
730,218
p. 15-16
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST TALT 0 353,904 0 0 0 353,904
CST LF 0 371,314 0 0 0 371,314
Total 0 725,218 0 0 0 725,218
(April 1, 2016) Page 60
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4368691 SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #6; LF FOR DECORATIVE LIGHTING
DIFFERENTIAL; 2014 MPO PRIORITY #4
LIGHTING
Managed by FDOT 3.700
0
0
1,865,817
p. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE DDR 200,000 0 0 0 0 200,000
PE DIH 5,000 0 0 0 0 5,000
CST DDR 0 0 776,228 0 0 776,228
CST SU 0 0 776,816 0 0 776,816
CST DS 0 0 107,773 0 0 107,773
Total 205,000 0 1,660,817 0 0 1,865,817
(April 1, 2016) Page 61
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

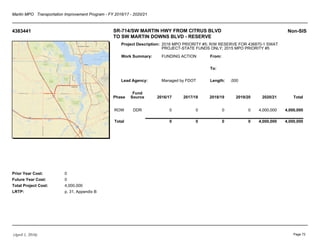

4368701 SR-714/SW MARTIN HWY FROM CITRUS BLVD TO SW MARTIN DOWNS BLVD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #5; STATE FUNDS ONLY; 2014 MPO PRIORITY #5
PD&E/EMO STUDY
Managed by FDOT 1.120
583,149
0
2,428,149
p. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE DDR 800,000 0 0 0 0 800,000
PDE DDR 1,000,000 0 0 0 0 1,000,000
PDE DIH 30,000 0 0 0 0 30,000
PE DIH 15,000 0 0 0 0 15,000
Total 1,845,000 0 0 0 0 1,845,000
(April 1, 2016) Page 62
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4369671 SR-5/US-1 NORTH OF NW BRITT ROAD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #1; MASTARM RELOCATION NORTHEAST
QUADRANT OF NW MALL ENTRY SOUTH; 2014 MPO PRIORITY #3
TRAFFIC SIGNALS
Managed by FDOT .020
0
0
408,717
p. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE DDR 250,000 0 0 0 0 250,000
PE DIH 5,000 0 0 0 0 5,000
ROW DDR 0 0 135,717 0 0 135,717
ROW DIH 0 0 18,000 0 0 18,000
Total 255,000 0 153,717 0 0 408,717
(April 1, 2016) Page 63
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

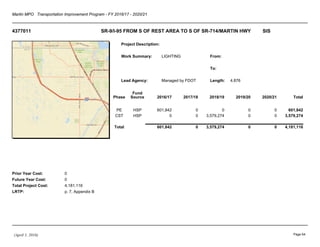

4377011 SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
LIGHTING
Managed by FDOT 4.876
0
0
4,181,116
p. 7, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE HSP 601,842 0 0 0 0 601,842
CST HSP 0 0 3,579,274 0 0 3,579,274
Total 601,842 0 3,579,274 0 0 4,181,116
(April 1, 2016) Page 64
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4378381 US-1/SR-5 FROM SE HERITAGE BLVD TO NORTH OF SALERNO RD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
ADJACENT TO FM#436096.1
RESURFACING
Managed by FDOT 3.560
0
0
8,843,533
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE DDR 819,891 0 0 0 0 819,891
PE DIH 5,000 0 0 0 0 5,000
CST DIH 0 0 108,201 0 0 108,201
CST NHRE 0 0 2,799,597 0 0 2,799,597
CST DDR 0 0 5,110,844 0 0 5,110,844
Total 824,891 0 8,018,642 0 0 8,843,533
(April 1, 2016) Page 65
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

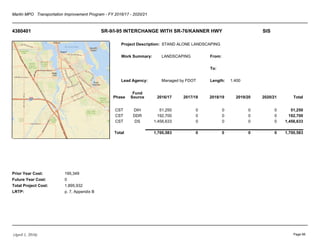

4380401 SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
STAND ALONE LANDSCAPING
LANDSCAPING
Managed by FDOT 1.400
195,349
0
1,895,932
p. 7, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DIH 51,250 0 0 0 0 51,250
CST DDR 192,700 0 0 0 0 192,700
CST DS 1,456,633 0 0 0 0 1,456,633
Total 1,700,583 0 0 0 0 1,700,583
(April 1, 2016) Page 66
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4380711 SE INDIAN ST FROM US-1/FEDERAL HWY
TO S OF RAILROAD CROSSING
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
RESURFACING
Managed by MARTIN
COUNTY BOARD OF
.260
0
0
309,368
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCOP 0 0 0 232,026 0 232,026
CST LF 0 0 0 77,342 0 77,342
Total 0 0 0 309,368 0 309,368
(April 1, 2016) Page 67
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4380721 SE DIXIE HWY/CR-A1A FROM SE JEFFERSON ST TO SE INDIAN ST Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
RESURFACING
Responsible Agency Not
Available
.590
0
0
575,892
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST SCOP 0 0 0 0 431,919 431,919
CST LF 0 0 0 0 143,973 143,973
Total 0 0 0 0 575,892 575,892
(April 1, 2016) Page 68
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4381251 CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DR Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
LAP W/MARTIN COUNTY - MARTIN MPO RANKING #1 - TAP FY 2015
SIDEWALK ON SOUTH SIDE ONLY, INSTALL DRAINAGE, PEDESTRIAN
SIDEWALK
Managed by FDOT .373
0
0
398,534
p. 13-14
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE TALU 7,000 0 0 0 0 7,000
CST TALT 0 0 164,871 0 0 164,871
CST LFP 0 0 62,568 0 0 62,568
CST TALU 0 0 164,095 0 0 164,095
Total 7,000 0 391,534 0 0 398,534
(April 1, 2016) Page 69
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383421 SAVANNAH ROAD
FROM NE CARDINAL AVENUE TO JENSEN BEACH BLVD
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #2;LAP W/ MARTIN COUNTY; 2015 MPO #2
RESURFACING
Managed by FDOT 2.085
0
0
1,125,963
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SA 0 5,000 0 0 0 5,000
CST SU 0 0 0 1,120,963 0 1,120,963
Total 0 5,000 0 1,120,963 0 1,125,963
(April 1, 2016) Page 70
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383431 CR-609 FROM 0.51 MILES N OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #3; LAP W/ MARTIN COUNTY; 2015 MPO
PRIORITY #3
GUARDRAIL
Managed by FDOT 3.336
0
0
783,291
p. 8, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SA 0 10,000 0 0 0 10,000
CST SU 0 0 0 773,291 0 773,291
Total 0 10,000 0 773,291 0 783,291
(April 1, 2016) Page 71
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383441 SR-714/SW MARTIN HWY FROM CITRUS BLVD
TO SW MARTIN DOWNS BLVD - RESERVE
Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #5; R/W RESERVE FOR 436870-1 SWAT
PROJECT-STATE FUNDS ONLY; 2015 MPO PRIORITY #5
FUNDING ACTION
Managed by FDOT .000
0
0
4,000,000
p. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
ROW DDR 0 0 0 0 4,000,000 4,000,000
Total 0 0 0 0 4,000,000 4,000,000
(April 1, 2016) Page 72
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383451 SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #4;PROVIDE BUFFERED SHOULDERS/BIKE LANE;
2015 MPO PRIORITY #4
PRELIMINARY
ENGINEERING
Managed by FDOT .650
0
0
310,000
p. 13-14
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 0 310,000 0 0 0 310,000
Total 0 310,000 0 0 0 310,000
(April 1, 2016) Page 73
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

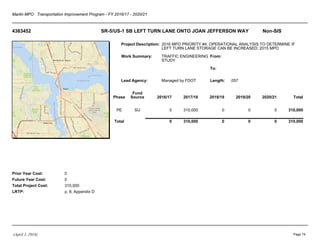

4383452 SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #4; OPERATIONAL ANALYSIS TO DETERMINE IF
LEFT TURN LANE STORAGE CAN BE INCREASED; 2015 MPO
TRAFFIC ENGINEERING
STUDY
Managed by FDOT .057
0
0
310,000
p. 8, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 0 310,000 0 0 0 310,000
Total 0 310,000 0 0 0 310,000
(April 1, 2016) Page 74
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383461 MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST LUCIE BLVD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #7; MID-BLOCK PEDESTRIAN CROSSWALKS
ALSO INCLUDES OCEAN BLVD FROM MONTEREY RD TO ST. LUCIE
TRAFFIC ENGINEERING
STUDY
Managed by FDOT .000
0
0
203,000
p. 13-14
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 0 0 0 203,000 0 203,000
Total 0 0 0 203,000 0 203,000
(April 1, 2016) Page 75
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4383471 INDIAN STREET FROM DIXIE HIGHWAY TO ST LUCIE BLVD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #8; 2015 MPO PRIORITY #8
RESURFACING
Managed by FDOT .762
0
0
339,158
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 0 0 10,000 0 0 10,000
CST SU 0 0 0 0 329,158 329,158
Total 0 0 10,000 0 329,158 339,158
(April 1, 2016) Page 76
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

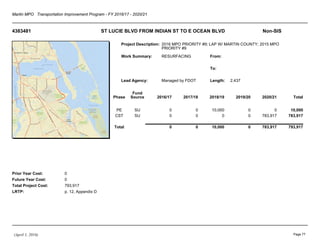

4383481 ST LUCIE BLVD FROM INDIAN ST TO E OCEAN BLVD Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #9; LAP W/ MARTIN COUNTY; 2015 MPO
PRIORITY #9
RESURFACING
Managed by FDOT 2.437
0
0
793,917
p. 12, Appendix D
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
PE SU 0 0 10,000 0 0 10,000
CST SU 0 0 0 0 783,917 783,917
Total 0 0 10,000 0 783,917 793,917
(April 1, 2016) Page 77
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
4385661 SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE Non-SIS
Project Description:
Work Summary:
Lead Agency:
From:
To:
Length:
Prior Year Cost:
Future Year Cost:
Total Project Cost:
LRTP:
2016 MPO PRIORITY #1; CONSTRUCTION RESERVE FOR 436967-1;
2015 MPO PRIORITY #1
FUNDING ACTION
Managed by FDOT .000
0
0
1,000,000
p. 31, Appendix B
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
CST DDR 0 0 0 0 1,000,000 1,000,000
Total 0 0 0 0 1,000,000 1,000,000
(April 1, 2016) Page 78
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

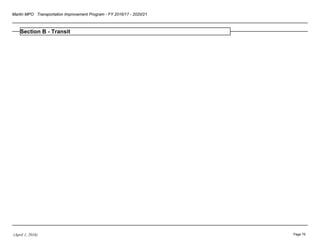

Section B - Transit
(April 1, 2016) Page 79
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4071892 (TIP# ) MARTIN CO TRANSIT OPERATING - STATE GRANT FROM BLOCK GRANT TO *Non-SIS*
Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: Martin County
LRTP#: p. 29, Appendix B
Additional 75,000 programmed to supplement Block Grant change
OPS DPTO 256,358 262,985 271,668 0 0 791,011
OPS DDR 75,000 75,000 75,000 0 0 225,000
OPS LF 256,358 262,985 271,668 0 0 791,011
Total 587,716 600,970 618,336 0 0 1,807,022
Prior Years Cost 1,172,626 Future Years Cost 0 Total Project Cost 2,979,648
FM# 4071893 (TIP# ) MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE *Non-SIS*Length: .000
Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: MANAGED BY MARTIN
LRTP#: p. 29, Appendix B
OPS DPTO 0 0 0 285,251 285,251 570,502
OPS DDR 0 0 0 75,000 83,557 158,557
OPS LF 0 0 0 285,251 293,808 579,059
Total 0 0 0 645,502 662,616 1,308,118
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,308,118
(April 1, 2016) Page 80
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4134931 (TIP# ) MARTIN CO TRANSIT CAPITAL - 5307 AT FTA SECTION 5307 *Non-SIS*
Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: Martin County
LRTP#: p. 29, Appendix B
Transit funding for fixed route.
OPS FTA 719,000 719,000 719,000 719,000 719,000 3,595,000
CAP FTA 230,000 230,000 230,000 230,000 230,000 1,150,000
Total 949,000 949,000 949,000 949,000 949,000 4,745,000
Prior Years Cost 4,690,824 Future Years Cost 0 Total Project Cost 9,435,824
FM# 4137332 (TIP# ) MARTIN MPO TRANSIT PLANNING - 5303 FROM SECTION 5303 TO TRANSIT *Non-SIS*
Type of Work: PTO STUDIES Lead Agency: Martin MPO
LRTP#: p. 29, Appendix B
Public Transit Planning Studies
PLN DU 58,410 0 0 0 0 58,410
PLN LF 7,301 0 0 0 0 7,301
PLN (1NA) DPTO 7,301 7,301 7,301 7,301 7,301 36,505
PLN (1NA) LF 0 7,301 7,301 7,301 7,301 29,204
PLN (1NA) DU 0 58,410 58,410 58,410 58,410 233,640
Total 73,012 73,012 73,012 73,012 73,012 365,060
Prior Years Cost 169,092 Future Years Cost 0 Total Project Cost 534,152
(April 1, 2016) Page 81
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4259772 (TIP# ) MARTIN COUNTY TRANSIT OPERATING - 5311 FROM SECTION 5311, TO SMALL *Non-SIS*
Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: Martin County
LRTP#: p. 29, Appendix B
Transit operations funding
OPS DU 102,367 113,812 117,944 0 0 334,123
OPS LF 100,897 113,812 117,944 0 0 332,653
Total 203,264 227,624 235,888 0 0 666,776
Prior Years Cost 426,380 Future Years Cost 0 Total Project Cost 1,093,156
FM# 4259773 (TIP# ) MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS *Non-SIS*Length: .000
Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: MANAGED BY MARTIN
LRTP#: p. 29, Appendix B
OPS DU 0 0 0 90,447 90,340 180,787
OPS LF 0 0 0 90,447 90,340 180,787
Total 0 0 0 180,894 180,680 361,574
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 361,574
(April 1, 2016) Page 82
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4346601 (TIP# ) MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS *Non-SIS*Length: .000
Type of Work: OPERATING FOR FIXED ROUTE Lead Agency: Martin County
LRTP#: p. 29, Appendix B
OPERATING FOR FIXED ROUTE; MARTIN COUNTY TRANSIT CORRIDOR
OPS DPTO 450,000 0 0 0 0 450,000
OPS DDR 0 450,000 0 0 0 450,000
Total 450,000 450,000 0 0 0 900,000
Prior Years Cost 396,880 Future Years Cost 0 Total Project Cost 1,296,880
FM# 4346611 (TIP# ) MARTIN COUNTY SEC 5339 CAPITAL FOR BUS & BUS FACILITIES *Non-SIS*Length: .000
Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: Martin County
LRTP#: p. 29, Appendix B
CAPITAL FOR BUS AND BUS FACILITIES
CAP FTA 78,000 78,000 78,000 78,000 0 312,000
Total 78,000 78,000 78,000 78,000 0 312,000
Prior Years Cost 273,145 Future Years Cost 0 Total Project Cost 585,145
(April 1, 2016) Page 83
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4385221 (TIP# ) MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS *Non-SIS*Length: .000
Type of Work: OPERATING FOR FIXED ROUTE Lead Agency: MANAGED BY CITY OF
LRTP#: p. 29, Appendix BProject Type: Imported
NOTE: Stuart Tram improvements
OPS DPTO 220,000 0 0 0 0 220,000
OPS LF 220,000 0 0 0 0 220,000
Total 440,000 0 0 0 0 440,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 440,000
FM# 4385241 (TIP# ) MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE *Non-SIS*Length: .000
Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: MANAGED BY CITY OF
LRTP#: p. 29, Appendix BProject Type: Imported
NOTE: Stuart Tram
CAP DPTO 34,000 0 0 0 0 34,000
CAP LF 34,000 0 0 0 0 34,000
Total 68,000 0 0 0 0 68,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 68,000
(April 1, 2016) Page 84
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21

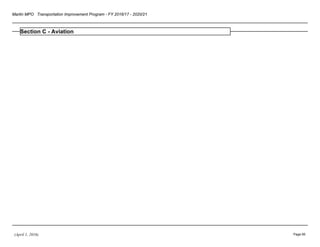

Section C - Aviation
(April 1, 2016) Page 85
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4310351 (TIP# ) WITHAM FIELD - TAXIWAY A AT TAXIWAY A IMPROVEMENTS *Non-SIS*
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT
LRTP#: p. 8, Appendix D
Improvements to Taxiway A
CAP DS 649,669 0 0 0 0 649,669
CAP DDR 550,331 0 0 0 0 550,331
CAP LF 300,000 0 0 0 0 300,000
Total 1,500,000 0 0 0 0 1,500,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,500,000
FM# 4315151 (TIP# ) WITHAM FIELD - TAXIWAY D AT TAXIWAY D IMPROVEMENTS *Non-SIS*
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT
LRTP#: p. 8, Appendix D
Improvements to Taxiway D
CAP DDR 0 300,000 181,064 0 0 481,064
CAP LF 0 75,000 75,000 0 0 150,000
CAP DPTO 0 0 118,936 0 0 118,936
Total 0 375,000 375,000 0 0 750,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 750,000
(April 1, 2016) Page 86
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4331591 (TIP# ) MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE *Non-SIS*Length: .000
Type of Work: AVIATION REVENUE/OPERATIONAL Lead Agency: FDOT
LRTP#: p. 8, Appendix D
CAP DPTO 0 0 25,000 0 0 25,000
CAP FAA 0 0 450,000 0 0 450,000
CAP LF 0 0 25,000 0 0 25,000
Total 0 0 500,000 0 0 500,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 500,000
FM# 4346201 (TIP# ) WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) *Non-SIS*Length: .000
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT
LRTP#: p. 8, Appendix D
AVIATION PRESERVATION PROJECT TAXIWAY A (PHASE 1 DESIGN)
CAP DPTO 0 0 0 0 120,000 120,000
CAP LF 0 0 0 0 30,000 30,000
Total 0 0 0 0 150,000 150,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000
(April 1, 2016) Page 87
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4346241 (TIP# ) WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) *Non-SIS*Length: .000
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT
LRTP#: p. 8, Appendix D
AVIATION PRESERVATION; INTERCONNECT ROAD (PHASE 2)
CAP DPTO 0 480,000 0 0 0 480,000
CAP LF 0 120,000 0 0 0 120,000
Total 0 600,000 0 0 0 600,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 600,000
FM# 4346371 (TIP# ) WITHAM FIELD MILL & RESURFACE TAXIWAY A *Non-SIS*Length: .000
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT
LRTP#: p. 8, Appendix D
TAXIWAY A AVIATION PRESERVATION
MSC LF 0 0 300,000 0 0 300,000
MSC DPTO 0 0 1,200,000 0 0 1,200,000
Total 0 0 1,500,000 0 0 1,500,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,500,000
(April 1, 2016) Page 88
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4364001 (TIP# ) WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS *Non-SIS*Length: .000
Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix D
CAP DPTO 0 0 25,000 0 0 25,000
CAP FAA 0 0 450,000 0 0 450,000
CAP LF 0 0 25,000 0 0 25,000
Total 0 0 500,000 0 0 500,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 500,000
FM# 4364011 (TIP# ) WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) *Non-SIS*Length: .000
Type of Work: AVIATION CAPACITY PROJECT Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix D
CAP DPTO 0 0 800,000 0 0 800,000
CAP LF 0 0 200,000 0 0 200,000
Total 0 0 1,000,000 0 0 1,000,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000
FM# 4379631 (TIP# ) WITHAM FIELD, AIRPORT SECURITY FENCE *Non-SIS*Length: .000
Type of Work: AVIATION SECURITY PROJECT Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix DProject Type: Imported
CAP DPTO 0 800,000 0 0 0 800,000
CAP LF 0 200,000 0 0 0 200,000
Total 0 1,000,000 0 0 0 1,000,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000
(April 1, 2016) Page 89
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4379641 (TIP# ) WITHAM FIELD, WILDLIFE FENCE *Non-SIS*Length: .000
Type of Work: AVIATION SAFETY PROJECT Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix DProject Type: Imported
CAP DPTO 0 50,000 0 0 0 50,000
CAP FAA 0 900,000 0 0 0 900,000
CAP LF 0 50,000 0 0 0 50,000
Total 0 1,000,000 0 0 0 1,000,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000
FM# 4379711 (TIP# ) WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE *Non-SIS*Length: .000
Type of Work: AVIATION REVENUE/OPERATIONAL Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix DProject Type: Imported
CAP DPTO 0 0 200,000 0 0 200,000
CAP LF 0 0 50,000 0 0 50,000
Total 0 0 250,000 0 0 250,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 250,000
FM# 4379801 (TIP# ) WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST.) *Non-SIS*Length: .000
Type of Work: AVIATION CAPACITY PROJECT Lead Agency: Responsible Agency Not
LRTP#: p. 8, Appendix DProject Type: Imported
CAP DPTO 160,000 0 0 0 0 160,000
CAP LF 40,000 0 0 0 0 40,000
Total 200,000 0 0 0 0 200,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 200,000
(April 1, 2016) Page 90
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Section G - Districtwide
(April 1, 2016) Page 91
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 2337031 (TIP# ) MARTIN CO STATE HWY SYS ROADWAY *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 550,000 550,000 550,000 550,000 0 2,200,000
Total 550,000 550,000 550,000 550,000 0 2,200,000
Prior Years Cost 10,010,492 Future Years Cost 0 Total Project Cost 12,210,492
FM# 2337032 (TIP# ) MARTIN CO STATE HWY SYS BRIDGES *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 45,000 45,000 45,000 45,000 0 180,000
Total 45,000 45,000 45,000 45,000 0 180,000
Prior Years Cost 1,158,883 Future Years Cost 0 Total Project Cost 1,338,883
FM# 2339565 (TIP# ) MARTIN CO - MAINTENANCE AT MOWING & LITTER CONTRACT *Non-SIS*
Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT
LRTP#: p. 8, Appendix D
MNT D 120,000 0 0 0 0 120,000
Total 120,000 0 0 0 0 120,000
Prior Years Cost 65,862 Future Years Cost 0 Total Project Cost 185,862
(April 1, 2016) Page 92
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 2339567 (TIP# ) MARTIN CO-PRIMARY MOWING & LITTER CONTRACT *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix DProject Type: Imported

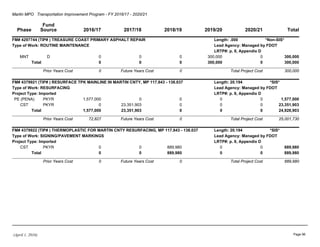

MNT D 0 0 0 0 150,000 150,000
Total 0 0 0 0 150,000 150,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000
FM# 2342651 (TIP# ) MARTIN CO - MAINTENANCE FROM INTERSTATE TO ROADWAY *SIS*
Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT
LRTP#: p. 8, Appendix D
MNT D 500,000 200,000 200,000 200,000 0 1,100,000
Total 500,000 200,000 200,000 200,000 0 1,100,000
Prior Years Cost 5,738,110 Future Years Cost 0 Total Project Cost 6,838,110
FM# 2342652 (TIP# ) MARTIN CO INTERSTATE BRIDGES *SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 70,000 20,000 20,000 20,000 0 130,000
Total 70,000 20,000 20,000 20,000 0 130,000
Prior Years Cost 437,461 Future Years Cost 0 Total Project Cost 567,461
(April 1, 2016) Page 93
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4130805 (TIP# ) TREASURE COAST - MAINTENANCE FROM PAVEMENT MARKERS TO PRIMARY *Non-SIS*
Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT
LRTP#: p. 8, Appendix D
MNT D 10,000 0 0 0 0 10,000
Total 10,000 0 0 0 0 10,000
Prior Years Cost 50,000 Future Years Cost 0 Total Project Cost 60,000
FM# 4130806 (TIP# ) PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 0 55,000 0 0 0 55,000
Total 0 55,000 0 0 0 55,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 55,000
FM# 4130807 (TIP# ) PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 0 0 0 55,000 0 55,000
Total 0 0 0 55,000 0 55,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 55,000
(April 1, 2016) Page 94
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4241336 (TIP# ) TREASURE COAST STRIPING PRIMARY *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 0 0 150,000 0 0 150,000
Total 0 0 150,000 0 0 150,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000
FM# 4241337 (TIP# ) TREASURE COAST STRIPING PRIMARY *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix DProject Type: Imported
MNT D 0 0 0 0 150,000 150,000
Total 0 0 0 0 150,000 150,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000
FM# 4293105 (TIP# ) TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
ROUTINE MAINTENANCE; HERBICIDE APPLCIATION
MSC D 0 0 100,000 0 0 100,000
Total 0 0 100,000 0 0 100,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 100,000
(April 1, 2016) Page 95
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4297744 (TIP# ) TREASURE COAST PRIMARY ASPHALT REPAIR *Non-SIS*Length: .000
Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix D
MNT D 0 0 0 300,000 0 300,000
Total 0 0 0 300,000 0 300,000
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 300,000
FM# 4379921 (TIP# ) RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 *SIS*Length: 20.194
Type of Work: RESURFACING Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix DProject Type: Imported
PE (PENA) PKYR 1,577,000 0 0 0 0 1,577,000
CST PKYR 0 23,351,903 0 0 0 23,351,903
Total 1,577,000 23,351,903 0 0 0 24,928,903
Prior Years Cost 72,827 Future Years Cost 0 Total Project Cost 25,001,730
FM# 4379922 (TIP# ) THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 *SIS*Length: 20.194
Type of Work: SIGNING/PAVEMENT MARKINGS Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix DProject Type: Imported
CST PKYR 0 0 889,980 0 0 889,980
Total 0 0 889,980 0 0 889,980
Prior Years Cost 0 Future Years Cost 0 Total Project Cost 889,980
(April 1, 2016) Page 96
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Phase
Fund
Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total
FM# 4379923 (TIP# ) ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 *SIS*Length: 20.194
Type of Work: GUARDRAIL Lead Agency: Managed by FDOT
LRTP#: p. 8, Appendix DProject Type: Imported

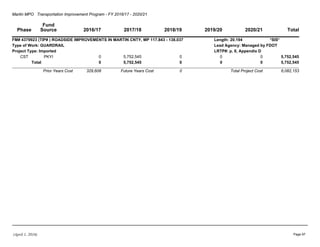

CST PKYI 0 5,752,545 0 0 0 5,752,545
Total 0 5,752,545 0 0 0 5,752,545
Prior Years Cost 329,608 Future Years Cost 0 Total Project Cost 6,082,153
(April 1, 2016) Page 97
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Name)
FM # TIP # Project Name Page
4383431 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-609 FROM .51 MILES N. OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE . . . . . . . . . . . . . . A-39
4351391 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL TO CR-708/SE BRIDGE ROAD . . . . . . . A-19
4381251 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DRIVE . . . . . . . . . . . . . . . . . . . A-37
4330691 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SW BRIDGE RD FROM SR-76/SW KANNER HWY TO SW PRATT-WHITNEY RD . . . . . . . . . . A-11
2309782 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/INDIAN ST - MARTIN DOWNS TO MAPP . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-2
4348381 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF SR-9/I-95 . . . . . . . . . . . . . . . . . . . . A-17
4354531 . . . . . . . . . . . . . . . . . . . . . . . . . . . HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/MARTIN DOWNS BVLD . . . . . . . . . . . . . . . . . . A-21
4342731 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FR PALM BEACH COUNTYLINE TO N OF CR-807/SE BRDG RD . . . . . . . . . . . . . . . . . . . . . . A-13
4342734 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 INTERCHANGE . . . . . . . . . . . . . . . . . . . A-14
4383471 . . . . . . . . . . . . . . . . . . . . . . . . . . . INDIAN STREET FROM DIXIE HIGHWAY TO ST. LUCIE BLVD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-44
4367351 . . . . . . . . . . . . . . . . . . . . . . . . . . . JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL & US-1 SIGNALIZTION . . . . . . . . . . A-26
4354131 . . . . . . . . . . . . . . . . . . . . . . . . . . . MAPP RD. FROM SW MARTIN DOWNS BLVD TO SW MARTIN HIGHWAY . . . . . . . . . . . . . . . . . . . . . . A-20
4331591 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE . . . . . . . . . . . . . . . . . . . . . . . . . C-4
2339565 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
2342651 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
2342652 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO INTERSTATE BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
2337032 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
2337031 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS ROADWAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2
4134931 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT CAPITAL - 5307 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3
4071892 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT OPERATING - STATE GRANT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2
2339567 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO-PRIMARY MOWING & LITTER CONTRACT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3
4071893 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2
4278033 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-5
(April 1, 2016) Page 98
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Name)
FM # TIP # Project Name Page
4346611 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5339, CAPITAL FOR BUS & BUS FACILITIES . . . . . . . . . . . . . . . . . . . . . .. . B-5
4259773 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4
4385241 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE ... . . . . . . . . . . . . . . . . . . . . B-6
4385221 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS ... . . . . . . . . . . . . . . . B-6
4346601 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS . . . . . . . . . . . . . . . . . . . . . . . B-5
4259772 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT OPERATING - 5311 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4
4278304 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-8
4278302 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO PL FY 16/17 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-6
4137332 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO TRANSIT PLANNING - 5303 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-5
4278303 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN UPWP FY 18-19/19-20 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-7
4383461 . . . . . . . . . . . . . . . . . . . . . . . . . . . MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST. LUCIE BLVD . . . . . . . . . . . . . . . . . . . . . . . A-43
4364251 . . . . . . . . . . . . . . . . . . . . . . . . . . . MURPHY ROAD BRIDGE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-25
4130806 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4
4130807 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4
4379921 . . . . . . . . . . . . . . . . . . . . . . . . . . . RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . . . . . . . . G-6
4379923 . . . . . . . . . . . . . . . . . . . . . . . . . . . ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . . . . . . . G-6
4349761 . . . . . . . . . . . . . . . . . . . . . . . . . . . S.E. SEABRANCH BLVD. FROM S.E. RETREAT DR. TO SR-5/US-1 . . . . . . . . . . . . . . . . . . . . . . . . . . . A-18
4383421 . . . . . . . . . . . . . . . . . . . . . . . . . . . SAVANNAH ROAD FROM NE CARDINAL AVENUE TO JENSEN BEACH BOULEVARD . . . . . . . . . . . . A-38
4368511 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-27
4380721 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE DIXIE HWY/CR-A1A FR SE JEFFERSON ST TO SE INDIAN ST . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-36
4380711 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE INDIAN ST FR US-1/FEDERAL HWY TO S OF RAILROAD CROSSING . . . . . . . . . . . . . . . . . . . . . . A-35
4368611 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE KINDRED STREET/SE JOHNSON AVE FROM SOUTH COLORADO TO SR-5/US-1 . . . . . . . . . . . . A-28
4360961 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 FROM NORTH OF SALERNO RD. TO NORTH OF CENTRAL PARKWAY . . . . . . . . . . . . . . A-22
4369671 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-31
4385661 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-46
4383451 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-41
(April 1, 2016) Page 99
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Name)
FM # TIP # Project Name Page
4383452 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-42
4327051 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/BEELINE HWY FROM E. OF SR-76 TO PALM BEACH/MARTIN CL . . . . . . . . . . . . . . . . . . . . . . A-10
4192522 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT TO CR609/SW ALLAPATTAH RD . . . . . . . A-3
4383441 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLV TO SW MARTIN DOWNS BLV - RESERVE . . . . . . . . . A-40
4368701 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLVD. TO SW MARTIN DOWNS BLVD. . . . . . . . . . . . . . . . A-30
4323481 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-732/JENSEN BCH BL FROM SR-5/US-1 TO SAVANAH RD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-9
4342751 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76 KANNER HIGHWAY PORT MAYACA AREA . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-15
4226413 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76/KANNER HWY - from LOST RIVER ROAD to MONTEREY RD. . . . . . . . . . . . . . . . . . . . . . . . . . . A-4
4347331 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-16
4377011 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . A-32
4380401 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-34
4333491 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A AT SEWALL'S POINT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-12
4368691 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD. . . . . . . . . . . . . . . . . . . . A-29
4383481 . . . . . . . . . . . . . . . . . . . . . . . . . . . ST. LUCIE BLVD FROM INDIAN ST TO E. OCEAN BLVD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-45
4363771 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MAPP RD.FROM SR-714/SW MARTIN DOWNS BLVD TO SW BRIDGEWAY ST. . . . . . . . . . . . . . . A-23
4363781 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MURPHY RD. FROM SW MAPP RD/SW MATHESON AVE TO MARTIN/ST. LUCIE CL . . . . . . . . . A-24
4379922 . . . . . . . . . . . . . . . . . . . . . . . . . . . THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . G-6
4130805 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-8
4293105 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
4297744 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST PRIMARY ASPHALT REPAIR . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-6
4241336 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
(April 1, 2016) Page 100
Martin MPO Transportation Improvement Program - FY 2016/17 - 2020/21
Project Index (by Name)
FM # TIP # Project Name Page
4241337 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5
4378381 . . . . . . . . . . . . . . . . . . . . . . . . . . . US-1/SR-5 FROM SOUTHEAST HERITAGE BLVD. TO NORTH OF SALERNO RD. . . . . . . . . . . . . . . . . A-33
4310351 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2
4315151 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY D . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-3
4346241 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) . . . . . . . . . . . . . . . . . . . . . . C-6
4346371 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-7
4346201 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) . . . . . . . . . . . . . . . . . . . . . . . . C-5
4364011 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) . . . . . . . . . . . . C-9
4364001 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS . . . . . . . . . . . . . . C-8
4379801 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST.) . . . . . . . . . . . . . . C-13
4379711 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE PREPARATION . . . . . . . . . . . C-12
4379631 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT SECURITY FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-10
4379641 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, WILDLIFE FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-11
(April 1, 2016) Page 101

_FINAL TIP FY2017 R with Endorsements

  • 1.
  • 2.
    MAR TIN FY 2016/17-2020/21 Transportation Improvement Program Adopted by the Martin l1PO Board on June 20, 2016 Troy McDonald l1PO Board Chairman The Transportation lmprovement Program ofthe Martin Metropolitan Planning Organization has been developed consistent with Federal regulations 23 U.S.C. l34(h) and CFR 450 and Florida Statute 339.175(8) in cooperation with the Florida Department ofTransportation, and the local member agencies and public transit operators in the Martin MPO Planning Area. ii Page
  • 3.
    ii | Pa g e MARTIN MPO BOARD CITY OF STUART MARTIN COUNTY Commissioner Troy McDonald, Chair Commissioner Ed Fielding, Vice Chair Commissioner Eula R. Clarke Commissioner John Haddox Commissioner Anne Scott Commissioner Doug Smith SEWALL’S POINT Commissioner Vinny Barile REPORT DOCUMENTATION TITLE REPORT DATE Martin MPO June 2016 FY 2016/17 - 2020/21 Transportation Improvement Program AUTHORS ORGANIZATION NAME, ADDRESS MPO Staff AND TELEPHONE NUMBER Martin MPO 2401 SE Monterey Road Stuart, FL 34996 772-221-1498 www.martinmpo.com ACKNOWLEDGEMENTS The preparation of this report has been funded in part through grants from the Federal Highway Administration and Federal Transit Administration, U. S. Department of Transportation (USDOT), under the Metropolitan Planning Program of the U.S. Code (Title 23, Section 104(f)). The contents of this report do not necessarily reflect the official views or policy of the USDOT. Public participation is solicited without regard to race, color, national origin, age, sex, religion, disability or family status. Persons with questions or concerns about nondiscrimination, or who require special accommodations under the American with Disabilities Act or language translation services (free of charge) should contact Mr. Bolivar Gomez, Planner II (Title VI/Non- discrimination Contact) at (772) 288-5412 or bgomez@martin.fl.us. Hearing impaired individuals are requested to telephone the Florida Relay System at #711.
  • 4.
    iii | Pa g e CERTIFICATION FHWA/ FTA CERTIFICATION Federal Law requires the Federal Highway Administration (FHWA) and the Federal Transit Administration (FTA) to jointly certify the transportation planning processes of Transportation Management Areas (TMAs) at least every four years (a TMA is an urbanized area, as defined by the US Census, with a population over 200,000).1 Pursuant to 23 CFR 450.328(a), the FHWA/FTA must jointly find that each metropolitan TIP is based on a “3-C” (continuing, comprehensive, and cooperative) planning process by the MPO, State Department of Transportation, and transit service provider(s). In Florida, this finding primarily has been based on the annual MPO/FDOT joint certification statements on the respective metropolitan planning processes.2 The most recent Federal Certification Review was completed in December 2012. 1 Federal Highway Administration Florida Division & Federal Transit Administration Region 4. Certification Report: Port St. Lucie Transportation Management Area – St. Lucie Transportation Planning Organization & Martin Metropolitan Planning Organization. March 2009. 2 Federal Highway Administration Florida Division & Federal Transit Administration Region 4. 2009 Florida Statewide Annual Assessment. September 2009.
  • 5.
    Appendix A JOINT CERTIFICATIONSTATEMENT ON THE METROPOLITAN TRANSPORTATION PLANNING PROCESS Pursuant to the requirements of23 U.S.C. 134 (k)(5), 23 CFR 450.334(a), the Department and the MPO have performed a review ofthe certification status of the metropolitan transportation planning process for the Martin MPO with respect to the requirements of: 1. 23 U.S.C. 134 and 49 U.S.C. 5303; 2. Title VI of the Civil Rights Act of 1964, as amended (42 U.S.C. 2000d-l) and 49 C.F.R. Part 21 3. 49 U.S.C. 5332 prohibiting discrimination on the basis of race, color, creed, national origin, sex, or age in employment or business opportunity; 4. Section 1lOl(b) ofMAP-21 and 49 C.F.R Part 26 regarding the involvement of disadvantaged business enterprises in USDOT fimded projects; 5. 23 C.F.R. Part 230 regarding the implementation ofan equal employment opportunity program on Federal and Federal-aid highway construction contracts; 6. The provisions ofthe Americans with Disabilities Act of 1990 (42 U.S.C. 12101 et seq.) and the regulations found in 49 C.F.R. Parts 27, 37, and 38; 7. The Older Americans Act, as amended (42 U.S.C. 6101) prohibiting discrimination on the basis of age in programs or activities receiving Federal financial assistance; 8. Section 324 of23 U.S.C. regarding the prohibition of discrimination on the basis of gender; and 9. Section 504 of the Rehabilitation Act of 1973 (29 U.S.C. 794) and 49 C.F.R Part 27 regarding discrimination against individuals with disabilities. Included in this certification package is a summary ofnoteworthy achievements by the MPO, attachments associated with these achievements, and (ifapplicable) a list ofany recommendations and/or corrective actions. The contents ofthis Joint Certification Package have been reviewed by the MPO and accurately reflect the results ofthe joint certification review meeting held on January 8, 2016. Based on a joint review and evaluation, the Florida Department of Transportation and the Martin MPO recommend that the Metropolitan Planning Process for the Martin MPO be "certified." ~~ihairman (or designee) /y{a~ 2"1 JZOI~ Date /
  • 6.
    v | Pa g e GLOSSARY OF TERMS ABBREVIATIONS AND ACRONYMS ADM Administration BPAC Bicycle & Pedestrian Advisory Committee CAC Citizens Advisory Committee CEI Construction, Engineering, and Inspection CIP Capital Improvement Program/Plan CLV Culvert CMS Congestion Management System CMP Congestion Management Process COA Council on Aging CTC Community Transportation Coordinator DCA Department of Community Affairs DEP Department of Environmental Protection (FL) E/D Engineering/Design EMO Environmental Management Office EPA (U.S.) Environmental Protection Agency ETDM Efficient Transportation Decision Making FAA Federal Aviation Administration FDOT Florida Department of Transportation FHWA Federal Highway Administration FTA Federal Transit Administration FY Fiscal Year LCB-TD Local Coordinating Board for the Transportation Disadvantaged LRTP Long Range Transportation Plan MIT Mitigation MPO Metropolitan Planning Organization MSC Miscellaneous PIP Public Involvement Process or Plan PTO Public Transportation Office RELOC Relocation RLRTP Regional Long Range Transportation Plan RRX Railroad Crossing RTA Regional Transit Authority SAFETEA-LU Safe, Accountable, Efficient, Transportation Equity Act—A Legacy for Users TAC Technical Advisory Committee TD Transportation Disadvantaged TDP Transit Development Plan TEA-21 Transportation Efficiency Act for the 21st Century TIP Transportation Improvement Program TPO Transportation Planning Organization UMTA Urban Mass Transportation Administration UTIL Utilities FEDERAL AND STATE FUND CODES ACIM Advance Construction (IM) ACNH Advance Construction (NH) ACSA Advance Construction (SA) BA Donor Bonus - any area Federal BL Donor Bonus - areas <200K population(federal) BNCA Bonds - controlled access road (state) BNDS Bonds - state roads (state) BRP State Bridge Replacement BRRP State Bridge Replacement and Repair BRT Federal Bridge Replacement - on federal system BRTZ Federal Bridge Replacement - off federal system CIGP County Incentive Grant Program CM Congestion Mitigation D Unrestricted state primary funds DDR District Dedicated Revenue (state) DFTA Federal Pass Through Dollars from FTA DIH State in-house product support DIM State intermodal development DOH State primary overhead DPTO State PTO
  • 7.
    vi | Pa g e DS State primary highways and public transit DSL Local Government Cooperative Assistance Program DU State primary funds/federal reimbursement EB Equity Bonus FAA Federal Aviation Administration FCO State-fixed capital outlay FHPP Federal High Priority Projects FRA Federal Railroad Administration FTA Federal Transit Administration FTAT FHWA Transfer to FTA GMR General Revenue for SIS GRSC General Revenue for SCOP HSP Highway Safety Program MABP Minimum Allocation - Bridges (non- BRT) MGBP Minimum Allocation - Bridges Supplement ML Minimum allocation - areas < 200K population (federal) NH National Highway (federal) NHAC NH (AC/ Regular) NHIR FIHS from NH Federal Funds NHS National Highway Safety (federal) NHTS National Highway Traffic Safety (federal) PORT Seaport Trust Fund PKCA Turnpike - controlled access PKYR Turnpike Rehabilitation PKYI Turnpike Improvement PL Metropolitan Planning P01A Turnpike Bond Construction HPR Highway Planning Research (federal) IM Interstate maintenance LF or LFF Local funds LFR Local funds - reimbursement from FDOT MA Minimum allocation - any area (federal) SA Surface Transportation Program (STP) - any area (federal) SABR STP, Bridges SCOP Small County Outreach Program SE STP - enhancement (federal) SH STP - hazard elimination (federal) SL STP - areas less than 200K population SN STP - mandatory non-urban (federal) SP STP - RR protective devices (federal) SR STP - RR hazard elimination (federal) SS STP - Safety (federal) STP Surface Transportation Program SU STP, Urban Areas greater than 200K TDD Transportation Disadvantaged Discretionary TDTF Transportation Disadvantaged Trust Fund Umxx Minimum allocation funds XA STP (consolidated BA, MA, and SA funds) XL STP (consolidated BL, ML, and SL funds) XU STP (consolidated BU, MU, and SU funds) PHASE OF CONSTRUCTION AND COST ALLOCATION CODES ADM Administration Other Agency PDE Project Development & Environment PE Preliminary Engineering PLN Planning ROW Right of Way Support RELOC Right of Way Relocation ROW LND Right of Way Land UTIL Utility Coordination CAP Capital Grant R/R CST Railroad construction CST Construction, CEI (Construction, engineering, inspection), Post Design INC Construction Incentive MNT Maintenance RRU Railroad/Utilities Construction ENV Environmental OPS Operations/Grant Services LAR Local Agency Reimbursement DSB Design Build MSC Miscellaneous
  • 8.
    vii | Pa g e TABLE OF CONTENTS ENDORSEMENT............................................................................................................................ i MARTIN MPO BOARD ................................................................................................................ii REPORT DOCUMENTATION ....................................................................................................iii CERTIFICATION .........................................................................................................................iii FHWA/ FTA CERTIFICATION...............................................................................................iii JOINT CERTIFICATION .........................................................................................................iv GLOSSARY OF TERMS............................................................................................................... v ABBREVIATIONS AND ACRONYMS................................................................................... v FEDERAL AND STATE FUND CODES ................................................................................. v PHASE OF CONSTRUCTION AND COST ALLOCATION CODES ................................... vi TABLE OF CONTENTS..............................................................................................................vii 1.0 INTRODUCTION .................................................................................................................... 1 1.1 MPO OVERVIEW................................................................................................................ 1 1.2 TIP PURPOSE...................................................................................................................... 1 1.3 ORGANIZATION................................................................................................................ 1 1.4 FULL PROJECT COSTS ..................................................................................................... 2 1.5 TIP AMENDMENTS AND MODIFICATIONS ................................................................. 2 1.6 MAJOR PROJECT DESCRIPTIONS.................................................................................. 3 2.0 PROGRAM CONSIDERATIONS ........................................................................................... 4 2.1 FINANCIAL PLAN.............................................................................................................. 4 2.2 PROJECT SELECTION PROCESS..................................................................................... 7 2.3 PROJECT PRIORITY STATEMENT ................................................................................. 7 2.4 CHANGES TO PROJECT PRIORITIES............................................................................. 7 2.5 LIST OF PROJECT PRIORITIES........................................................................................ 8 2.6 MPO 2040 LRTP GOALS.................................................................................................. 12 2.7 CONSISTENCY WITH REGIONAL AND LOCAL PLANS .......................................... 12 2.8 CONGESTION MANAGEMENT PROCESS................................................................... 12 3.0 PUBLIC INVOLVEMENT .................................................................................................... 14 3.1 CONSISTENCY WITH PUBLIC INVOLVEMENT PLAN............................................. 14 3.2 TIMELINE OF EFFORTS ................................................................................................. 14 3.3 PUBLIC COMMENTS & RESPONSE ............................................................................. 14 4.0 5-YEAR SUMMARY OF FUNDING SOURCES................................................................. 16
  • 9.
    viii | Pa g e LIST OF TABLES Table 1. List of Project Priorities.............................................................................................. 9 Table 2. List of Transportation Alternative Program (TAP) Priorities.................................... 10 Table 3. List of Transit Priorities............................................................................................. 11 Table 4. Timeline of Public Involvement Efforts.................................................................... 15 APPENDICES LOCAL CAPITAL IMPROVEMENT PLANS ........................................................................21 FEDERALLY OBLIGATED PROJECTS...............................................................................26 PLANNING AREA MAP ........................................................................................................28 PROJECT INDEX BY NUM BER .....................................................................................29 PROJECT SHEETS ..................................................................................................................33 A - Highway.......................................................................................................................33 B - Transit...........................................................................................................................79 C - Aviation........................................................................................................................85 G - Districtwide..................................................................................................................91 PROJECT INDEX BY NAM E ..............................................................................................98
  • 10.
    1.0 INTRODUCTION 1.1 MPOOVERVIEW Established in 1993, the Martin MPO is governed by a Policy Board and serves the residents of Martin County. Planning tasks of the Martin MPO include regional coordination, bicycle and pedestrian planning, mobility management, demographic research, air quality planning, and PIP processes and updates. As an agency, the Martin MPO also serves its primary function as the coordinator for multi-modal transportation project planning and funding in and through the county with various state agencies responsible for transportation and land use plans as well as adjacent MPOs. On specific regional issues, the Martin MPO partners with the St. Lucie TPO, the Indian River County MPO, and the Palm Beach MPO. 1.2 TIP PURPOSE The purpose of this Transportation Improvement Program (TIP) is to provide a comprehensive and prioritized listing of transportation projects for FY 2016/17 – 20/21 that is consistent with the 2040 Long-Range Transportation Plan (LRTP). It contains all federally funded and regionally significant transportation projects planned for the upcoming five years and is updated annually with funding priority given to the highest ranked projects from the LRTP Cost Feasible Plan. The TIP is based on funding data contained within the FDOT Tentative Work Program (also known as the Citizen’s Report), which is developed annually and made public by FDOT prior to the development of the TIP. This report is the result of FDOT working with local agencies to establish priorities for scheduling improvements to the Strategic Intermodal System (SIS), including freight and Intelligent Transportation System (ITS) strategies, Federal interstate highway system, local roadways and MPO priorities concerning transit, pedestrian and bicycle- friendly environments and transportation demand management programs. 1.3 ORGANIZATION Section 1.0 contains a brief overview of the MPO and the purpose of the TIP. It also contains a list of major projects that are considered top priorities. Section 2.0 contains specific items that were considered in the development of this TIP. These include (among other sections) the Financial Plan, List of Project Priorities, and the MPO’s overall goals as described within the 2040 LRTP. Section 3.0 contains a list of efforts the MPO plans to make in order to obtain public input for the development and approval of the TIP. It will also contain a brief summary of the public comments received and the MPO’s response to them. The Appendix contains a list of projects by funding category, the project sheets programmed in Martin County, the Local Capital Improvement Plans and FY 15 Federal Obligated Projects. The detailed project sections are based on the FDOT District 4 Tentative Work Program as imported Page 1
  • 11.
    on April 1,2016. Depending on many factors, these lists of projects may potentially change prior to July 1, 2016. Once the MPO receives a final Work Program from FDOT District 4, this section may be modified. Because the project portion of the TIP is generated through the Interactive TIP Tool, there can be several variations of the project report. For efficiency and reduction of printed pages, the adopted version shows project detail with maps for only the Highway projects. Sections for transit, aviation, rail and districtwide list are summarized with project details without location maps. All project details include a summary of costs and revenues by funding source. Because only funded projects and phases are listed in the FDOT District 4 Work Program, the costs and revenues are assumed to be equal, demonstrating financial constraint. 1.4 FULL PROJECT COSTS The normal project production sequence is to have a Project Development and Environment (PD&E) phase, a Design (PE) phase, a Right of Way (ROW) phase and a Construction (CST) phase. Some projects may not have a ROW phase, if land is not needed to complete the project. Costs on the TIP pages for projects both on and off the SIS will have historical costs and five years of the current TIP, which may or may not be the total project cost. In addition, SIS projects will also have costs for five years beyond the current TIP. If there is no CST phase on the TIP page, then the entry will probably not be reflective of the total project cost. For some projects, such as resurfacing, safety or operational project, there may not be a total cost provided but rather additional details on that program. The SIS is a network of high priority transportation facilities which includes the state’s largest and most significant commercial service airports, spaceport, deep water seaports, freight rail terminals, passenger rail and intercity bus terminals, rail corridors, waterways and highways. For costs beyond the ten year window, access to the Long Range Transportation Plan (LRTP) is provided. The LRTP reference on the TIP page provides the information necessary to locate the full project costs and/or additional details regarding the project in the LRTP. If there is no LRTP reference in the TIP, full project costs are provided in the TIP. The link to the Martin LRTP is https://www.martinmpo.com/wp-content/uploads/2016/03/Martin-2040-LRTP_final- report_v3.pdf. 1.5 TIP AMENDMENTS AND MODIFICATIONS Once the TIP is adopted, there are times that it must be modified or amended because the MPO does not have direct control of funding resources. This can be accomplished by amendment or administrative modification. Amendments are revisions that involve a major change, including an added or deleted project, a significant change to project cost (increase of 20% and greater than $2 million), or major change to a project scope. Administrative modifications are revisions that include minor changes to project costs, funding sources, and project initiation dates. Amendments require a review period to gather public comments. During this review and comment period, the TIP will be brought before the MPO Advisory Committees for review and Page 2
  • 12.
    approval. Modifications arenot required for public review but staff will present them to the Advisory Committees whenever feasible. Modifications require MPO Policy Board approval. The Martin MPO coordinates all TIP Amendments and Administrative Modifications with FDOT District 4. 1.6 MAJOR PROJECT DESCRIPTIONS FM# 435431 - High Meadow Ave: Resurfacing of High Meadow Avenue from Martin Highway to Murphy Road. (Project was updated to include the addition of sidewalks and extension of project limits). Preliminary Engineering funds are programmed for FY 16/17 and Construction funds have been programed for FY 2018/19. FM# 4364251 - Murphy Road Bridge: Construction and CEI for the replacement of the existing bridge. FM# 4368701 - SR-714 Widening: PD&E/PE (Divided 2-4 Lanes) Widening of SR 714 from Citrus Blvd to SW Martin Downs Blvd. Page 3
  • 13.
    2.0 PROGRAM CONSIDERATIONS 2.1FINANCIAL PLAN In accordance with Federal Legislations [23 C.F.R. 450.324(i)], the MPO must demonstrate that the TIP is financially constrained. This means that the estimated expenses (or project costs) are consistent with the anticipated revenues for each funding source. Only those projects for which a revenue source has been identified are shown in the TIP to ensure a balance between the costs and revenues. The TIP must include a financial plan that demonstrates how the approved TIP can be implemented, indicates resources from public and private sources that are reasonably expected to be made available to carry out the TIP, and recommends any additional financing strategies for needed projects and programs. However, because the MPO does not have direct control of funding resources, Administrative Modifications of Amendments may have to be made to the TIP during the fiscal year. The TIP is developed by the MPO in cooperation with the FDOT and the transit operator. These agencies provide the MPO with estimates of available Federal and state funds used to develop the Financial Summary of Costs and Revenues by Funding Source and Fiscal Year. TIP 5-Year Summary of Funding Source 2016/17 Federal Local State State 100% Toll/Turnpike Page 4
  • 14.
    TIP 5-Year Summaryof Funding Source 2017/18 Federal Local State State 100% Toll/Turnpike 2018/19 Federal Local State State 100% Toll/Turnpike Page 5
  • 15.
    TIP 5-Year Summaryof Funding Source 2019/20 Federal Local State State 100% 2020/21 Federal Local State State 100% Toll/Turnpike Page 6
  • 16.
    2.2 PROJECT SELECTIONPROCESS In accordance with 23 CFR 450.330(a), federally funded projects are selected by the MPO in conjunction with the development of the FDOT Tentative Work Program and through the cooperation of the public transit operator. In addition, the 2040 LRTP plays a major role in identifying projects for selection. Contained within the LRTP is an evaluation of existing conditions, an evaluation of projected conditions, the identification of policy and project needs, and a determination of the cost feasibility of implementing these projects. Both the FDOT Tentative Work Program and the 2040 LRTP provide the basis for establishing project priorities consistent with the planning factors considered in their annual selection, and subsequent development of the TIP pursuant to the requirements set forth in Federal legislation. 2.3 PROJECT PRIORITY STATEMENT As required under 339.175 (8) (b) F.S., the annual list of project priorities was developed based on criteria that included the:  Approved 2040 Long Range Transportation Plan (LRTP);  Strategic Intermodal System Plan (SIS);  Results of the transportation management systems; and  MPO’s public involvement procedures. MPO and FDOT Staff meet annually to discuss project priorities. During this process, priorities are identified based on those of the previous year and the priorities listed in the Cost Feasible Plan of the current LRTP. This new list of priorities is discussed with the MPO Advisory Committees and then approved by the MPO Board. These priorities are then submitted to FDOT and used to program projects accordingly. 2.4 CHANGES TO PROJECT PRIORITIES In accordance with 23 CFR 450.324(l) (1), MPOs are required to explain any changes in priorities from previous TIPs. The Number 3 ranked priority CR 609 Guardrail came about during discussions with Martin County Engineering. In addition, Numbers 2, 8 and 9 are resurfacing projects. Savannah Road, Indian Street and St. Lucie Blvd. are on the Federal Aid system and serve as important roadways in the Martin transportation system that were deteriorating, yet eligible projects. Safety improvements along US 1 (longer left turn storage area southbound on Joan Jefferson Way and buffered bicycle lanes on the Roosevelt Bridge) are the Number 4 ranked priority, recommended in FDOT’s Baseline Assessment of the US 1 Corridor. Number 7 ranked priority is pedestrian improvements along State roadways, Monterey Road and East Ocean Blvd. The Transportation Alternatives and Transit Priorities have been updated to reflect recent Transportation Alternatives Program applications, as well as previously funded projects. Page 7
  • 17.
    2.5 LIST OFPROJECT PRIORITIES The projects in the tables below have been formally reviewed by the MPO Technical and Citizens’ Advisory Committees and were approved by the MPO Board at its meeting on October 19, 2015. FY 2016/17 Surface Transportation Program (STP) Priorities The Surface Transportation Program (STP) provides flexible funding that may be used by States and localities for projects to preserve and improve the conditions and performance on any Federal-aid highway, bridge and tunnel projects on any public road, pedestrian and bicycle infrastructure, and transit capital projects, including intercity bus terminals. Page 8
  • 18.
    Table 1 MARTIN MPO Listof Project Priorities Facility Segment Limits Project Description 2035 RLRTP Page # FY 2015/16 Priority Ranking FY 2016/17 Proposed Priority RankingFrom To Traffic Signal Modification US 1/North of NW Britt Rd. (Construction) Traffic Signal Reconfiguration p. 6-7 3 1 Savannah Rd. NE Cardinal Ave. Jensen Beach Blvd. Resurfacing p. 6-7 2 CR 609 .51 miles north of Minute Maid Rd. 3.2 miles north of Minute Maid Rd. (at the S curve) Guardrail p. 6-7 3 US 1 Corridor Retrofit Roosevelt Bridge: southbound left turn lane onto Joan Jefferson Way and Bicycle Safety Longer left turn storage area; buffer bicycle traffic from motor vehicles p. 8-3 6 4 SR 714 Widening Citrus Blvd. SW Martin Downs Blvd. Add 2 Lanes p. 8-17 5 5 SR A1A Hutchinson Island from Lyons Bridge to Jensen Beach Cswy. (Construction) Roadway Improvements- Lighting p. 8-5 4 6 Monterey Rd - E Ocean Blvd (CMP-Tier 2 Traffic Study Kingswood Terrace St. Lucie Blvd. Mid-block pedestrian crosswalks p. 8-4 (#9 on FY 14/15- LOPP-PL) 7 Indian St. Dixie Highway St. Lucie Blvd. Resurfacing p. 6-7 8 St. Lucie Blvd. Indian St. E. Ocean Blvd. Resurfacing p. 6-7 9 CR 714 Realignment Okeechobee County/CR 15 B Connection PD&E (District 1 SR 710) p. 7-4 7 10 Page 9
  • 19.
    Table 2 MARTIN MPO Listof Transportation Alternatives Program (TAP) Priorities Project Description 2017 2018 2019 2020 2021 Comments Mapp Road Facility/Improvements from SW Thelma St to SW 28th St [FM#4354131] $400,713 SE Kindred Street & SE Johnson Avenue Retrofit [FM#4368611] $791,138 SE Bridge Road Sidewalk $400,563 Page 10
  • 20.
    Table 3. MARTIN MPO Listof Public Transit Priorities Facility / Equipment Project Location/Description Estimated Amount Funding Source 2035 RLRTP or TDP Page # Project Status/Notes Bus Replacement / Expansion Rolling Stock $97,572 5339 page 6 & 78 Bus Replacement Rolling Stock $400,000 5307 page 87 Amount of funds programmed is based on anticipated procurements and estimated costs and will change from year to year. Operating Operating $552,587 5307 page 88 Amount of funds programmed is based on anticipated project(s) needs and will change from year to year. Transit Improvements 1% Transit Enhancement $9,720 5307 page 87 Safety / Security 1% Safety / Security $9,720 5307 page 70 Previous years' security was expended by St. Lucie County for the entire UZA. Page 11
  • 21.
    2.6 MPO 2040LRTP GOALS The 2040 Long-Range Transportation Plan (LRTP) for the Martin MPO is an analysis of the current and projected conditions in the region that will impact the transportation network. It contains an evaluated list of transportation improvements that will be necessary to maintain an adequate level of mobility and to accommodate anticipated population growth. The goals contained in the LRTP guide the transportation planning process in the MPO Planning Area and help to establish project priorities for the TIP.  2040 LRTP Goal 1: An efficient multimodal transportation system that supports the local economy and maintains the quality of life.  2040 LRTP Goal 2: A safe multimodal transportation system.  2040 LRTP Goal 3: Protect the existing transportation system and the natural environment, minimizing adverse community impacts.  2040 LRTP Goal 4: A transportation system that addresses the needs and concerns of the public. 2.7 CONSISTENCY WITH REGIONAL AND LOCAL PLANS The 2040 LRTP was adopted by the MPO on December 14, 2016 after a duly advertised public hearing. The transportation goals found within Martin County’s Comprehensive Growth Management Plan and the City of Stuart’s Comprehensive Plan are consistent with the goals, objectives, and policies in the 2040 LRTP as well as the 2060 Florida Transportation Plan. To the maximum extent feasible, the TIP is consistent with the Treasure Coast Strategic Regional Policy Plan, the Witham Field Master Plan, the Martin County Transportation Disadvantaged Service Plan, the Transit Development Plan, and the approved Comprehensive Plans of Martin County, the City of Stuart, the Town of Sewall’s Point, the Town of Jupiter Island, and the Town of Ocean Breeze. 2.8 CONGESTION MANAGEMENT PROCESS Maintenance of a Congestion Management Process (CMP) or System is a requirement for all MPOs under Florida law and for MPOs in Transportation Management Areas under Federal law. A CMP is a tool that provides information needed to evaluate and improve traffic flows. The CMP is intended to help relieve congestion and enhance mobility by establishing methods to monitor and evaluate performance, identifying alternative actions, assessing and implementing cost-effective actions, and evaluating the effectiveness of implemented actions. Candidate road sections are selected in a three tier selection process. The first tier identifies road segments in the annual Level of Service report for which the current traffic volume is at least 90 percent of the road’s adopted service volume. Page 12
  • 22.
    The second tiereliminates projects for which an improvement is currently programmed within the Work Program, either to the facility itself or to a parallel facility that will, when improved, provide relief to the candidate road section. The third tier sorts the remaining projects by the timeframe in which a major capacity improvement was deemed financially feasible in the LRTP. The segment for which the expected funding is furthest in the future is then examined to identify low cost improvements that will reduce congestion. Once the set of possible improvements are identified and preliminary cost estimates developed, a benefit/cost analysis is done to establish the relationship of the improvement costs to the value of the time saved by the improvements’ implementation. In 2014 the selection process (described above) identified the East Ocean Boulevard/Southeast Monterey Road Corridor. The analysis of the segment yielded recommendations for low cost improvements. The design phases for two of these recommendations are funded in this TIP. Page 13
  • 23.
    3.0 PUBLIC INVOLVEMENT 3.1CONSISTENCY WITH PUBLIC INVOLVEMENT PLAN The TIP was developed in accordance with the adopted MPO Public Involvement Plan (PIP). Once the Draft TIP is completed, a notice will be advertised announcing that it is available for a 45 day public review period. During the public review process, the Draft TIP will be made available on the MPO website, in the County Administration Building, and in local libraries. It will also be presented at public meetings in conjunction with the Citizen Advisory Committee (CAC), the Technical Advisory Committee (TAC), the Bicycle and Pedestrian Advisory Committee (BPAC) and the MPO Board. After the 45 day review period, the Draft TIP will be brought before the MPO Board for a public hearing and final approval. This process fulfills the public involvement requirements for the Martin County Public Transit (MCPT) Program of Projects (POP) under Section 5307. As described above, TIP Amendments and Administrative Modifications will also be advertised and made available for public review and comment prior to being brought before the MPO Board for final review and approval. Comments received during the review period will be summarized by category and addressed through documented modifications to the TIP. 3.2 TIMELINE OF EFFORTS See Table 4 below for the Martin MPO timeline of Public Involvement efforts for this TIP. 3.3 PUBLIC COMMENTS & RESPONSE Martin County does not have any Tribes or Federal Lands. Thus these federal requirements to coordinate with these entities do not apply to Martin MPO. No public comments related to the TIP have been received. Page 14
  • 24.
    Table 4. Timelineof Public Involvement Efforts TASK DATE Post Draft TIP on MPO Website 20-Apr-16 Reference Draft TIP in CAC/ TAC Agenda Packets 20-Apr-16 Publish Notice of Public Meeting for MPO Policy Board 23-Apr-16 Reference Draft TIP in BPAC Agenda Packets 25-Apr-16 Review Draft TIP @ CAC/ TAC Meetings 27-Apr-16 Begin 45 Day Public Review Period 1-May-16 Place Draft in Local Libraries and County Administration Building 1-May-16 Send Draft TIP to FHWA and FDOT for preliminary review 1-May-16 Review Draft TIP @ BPAC Meeting 2-May-16 Reference Draft TIP in MPO Board Agenda Packet 2-May-16 Review Draft TIP @ MPO Board Meeting 9-May-16 Reference Final Draft TIP in CAC Agenda Packets 25-May-16 Reference Final Draft TIP in TAC Agenda Packets 27-May-16 Review Revised Draft TIP @ CAC Meeting 1-Jun-16 Review Revised Draft TIP @ TAC Meeting 6-Jun-16 Reference Final Draft TIP in BPAC Agenda Packets 6-Jun-16 Review Revised Draft TIP @ BPAC Meeting 13-Jun-16 Reference Revised Final Draft TIP in MPO Board Agenda Packet 13-Jun-16 Review and Approve Final TIP @ MPO Board Meeting / Public Hearing 20-Jun-16 Page 15
  • 25.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 5-Year Summary of Funding Source TIP 2016/17-2020/21 Funding Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total Federal 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732 Local 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542 State 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018 State 100% 7,145 581,542 0 260,646 0 849,333 Toll/Turnpike 0 5,752,545 0 0 0 5,752,545 Total 73,844,659 18,721,303 35,605,649 12,253,388 11,258,171 151,683,170 Page 16
  • 26.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 5-Year Summary of Funding Source by Codes TIP 2016/17-2020/21 Project # Fund Code Total Federal ACNP ADVANCE CONSTRUCTION NHPP 52,304,560 0 0 0 0 52,304,560 CM CONGESTION MITIGATION - AQ 0 0 1,249,819 0 0 1,249,819 DU STATE PRIMARY/FEDERAL REIMB 160,777 172,222 176,354 148,857 148,750 806,960 FAA FEDERAL AVIATION ADMIN 0 900,000 900,000 0 0 1,800,000 FTA FEDERAL TRANSIT ADMINISTRATION 1,027,000 1,027,000 1,027,000 1,027,000 949,000 5,057,000 NHRE NAT HWY PERFORM - RESURFACING 0 0 2,799,597 0 0 2,799,597 PL METRO PLAN (85% FA; 15% OTHER) 421,630 421,630 421,630 421,630 421,630 2,108,150 PLH PUBLIC LANDS HIGHWAY 551,000 0 0 0 0 551,000 SA STP, ANY AREA 940,546 22,000 5,996,707 1,309,337 0 8,268,590 SU STP, URBAN AREAS > 200K 251,525 704,415 4,067,934 4,059,237 1,113,075 10,196,186 TALT TRANSPORTATION ALTS- ANY AREA 113,308 353,904 164,871 0 0 632,083 TALU TRANSPORTATION ALTS- >200K 143,692 0 164,095 0 0 307,787 Total 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732 Local LF LOCAL FUNDS 1,379,753 1,472,749 1,291,195 796,755 565,422 5,505,874 LFP LOCAL FUNDS FOR PARTICIPATING 21,100 0 62,568 0 0 83,668 Total 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542 State D UNRESTRICTED STATE PRIMARY 1,295,000 870,000 1,065,000 1,170,000 300,000 4,700,000 DDR DISTRICT DEDICATED REVENUE 9,429,488 4,214,714 9,773,349 1,055,007 6,656,693 31,129,251 DIH STATE IN-HOUSE PRODUCT SUPPORT 180,622 21,060 200,815 0 28,450 430,947 DITS STATEWIDE ITS - STATE 100%. 197,264 202,196 207,250 212,432 217,743 1,036,885 DPTO STATE - PTO 1,127,659 1,600,286 2,647,905 292,552 412,552 6,080,954 DS STATE PRIMARY HIGHWAYS & PTO 3,285,619 0 2,823,133 61,992 12,937 6,183,681 Page 17
  • 27.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 5-Year Summary of Funding Source by Codes TIP 2016/17-2020/21 Project # Fund Code Total State GRSC GROWTH MANAGEMENT FOR SCOP 216,342 299,406 566,427 890,916 0 1,973,091 SCED 2012 SB1998-SMALL CO OUTREACH 540,541 98,066 0 54,054 0 692,661 SCOP SMALL COUNTY OUTREACH PROGRAM 250,088 7,568 0 492,973 431,919 1,182,548 Total 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018 State 100% SCWR 2015 SB2514A-SMALL CO OUTREACH 7,145 581,542 0 260,646 0 849,333 Total 7,145 581,542 0 260,646 0 849,333 Toll/Turnpike PKYI TURNPIKE IMPROVEMENT 0 5,752,545 0 0 0 5,752,545 Total 0 5,752,545 0 0 0 5,752,545 Page 18
  • 28.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 5-Year Summary of Funding Source by Codes TIP 2016/17-2020/21 Project # Fund Code Total Federal ACNP ADVANCE CONSTRUCTION NHPP 52,304,560 0 0 0 0 52,304,560 CM CONGESTION MITIGATION - AQ 0 0 1,249,819 0 0 1,249,819 DU STATE PRIMARY/FEDERAL REIMB 160,777 172,222 176,354 148,857 148,750 806,960 FAA FEDERAL AVIATION ADMIN 0 900,000 900,000 0 0 1,800,000 FTA FEDERAL TRANSIT ADMINISTRATION 1,027,000 1,027,000 1,027,000 1,027,000 949,000 5,057,000 NHRE NAT HWY PERFORM - RESURFACING 0 0 2,799,597 0 0 2,799,597 PL METRO PLAN (85% FA; 15% OTHER) 421,630 421,630 421,630 421,630 421,630 2,108,150 PLH PUBLIC LANDS HIGHWAY 551,000 0 0 0 0 551,000 SA STP, ANY AREA 940,546 22,000 5,996,707 1,309,337 0 8,268,590 SU STP, URBAN AREAS > 200K 251,525 704,415 4,067,934 4,059,237 1,113,075 10,196,186 TALT TRANSPORTATION ALTS- ANY AREA 113,308 353,904 164,871 0 0 632,083 TALU TRANSPORTATION ALTS- >200K 143,692 0 164,095 0 0 307,787 Total 55,914,038 3,601,171 16,968,007 6,966,061 2,632,455 86,081,732 Local LF LOCAL FUNDS 1,379,753 1,472,749 1,291,195 796,755 565,422 5,505,874 LFP LOCAL FUNDS FOR PARTICIPATING 21,100 0 62,568 0 0 83,668 Total 1,400,853 1,472,749 1,353,763 796,755 565,422 5,589,542 State D UNRESTRICTED STATE PRIMARY 1,295,000 870,000 1,065,000 1,170,000 300,000 4,700,000 DDR DISTRICT DEDICATED REVENUE 9,429,488 4,214,714 9,773,349 1,055,007 6,656,693 31,129,251 DIH STATE IN-HOUSE PRODUCT SUPPORT 180,622 21,060 200,815 0 28,450 430,947 DITS STATEWIDE ITS - STATE 100%. 197,264 202,196 207,250 212,432 217,743 1,036,885 DPTO STATE - PTO 1,127,659 1,600,286 2,647,905 292,552 412,552 6,080,954 DS STATE PRIMARY HIGHWAYS & PTO 3,285,619 0 2,823,133 61,992 12,937 6,183,681 Page 19
  • 29.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 5-Year Summary of Funding Source by Codes TIP 2016/17-2020/21 Project # Fund Code Total State GRSC GROWTH MANAGEMENT FOR SCOP 216,342 299,406 566,427 890,916 0 1,973,091 SCED 2012 SB1998-SMALL CO OUTREACH 540,541 98,066 0 54,054 0 692,661 SCOP SMALL COUNTY OUTREACH PROGRAM 250,088 7,568 0 492,973 431,919 1,182,548 Total 16,522,623 7,313,296 17,283,879 4,229,926 8,060,294 53,410,018 State 100% SCWR 2015 SB2514A-SMALL CO OUTREACH 7,145 581,542 0 260,646 0 849,333 Total 7,145 581,542 0 260,646 0 849,333 Toll/Turnpike PKYI TURNPIKE IMPROVEMENT 0 5,752,545 0 0 0 5,752,545 Total 0 5,752,545 0 0 0 5,752,545 Page 20
  • 30.
    Project C orN Priority Total To Date Unfunded FY2016 FY2017 FY2018 FY2019 FY2020 FY2021 FY2022 FY2023 FY2024 FY2025 Resurfacing, Drainage, Striping & Maintenance (1017) N 1 119,454,000 0 106,781,000 1,016,000 837,000 847,000 1,284,000 1,454,000 22,803,200 22,803,200 22,803,200 22,803,200 22,803,200 CR-714 (SW Martin Hwy) / CR-609 (SW Allapattah Rd) - Resurfacing (101710) N 1 1,948,452.5 5,958 0 1,942,495 0 0 0 0 0 0 0 0 0 CR-726 (Citrus Blvd) - Resurfacing & Bike Lanes (101701) N 1 3,556,152 11,390 0 3,544,762 0 0 0 0 0 0 0 0 0 CR-708 (Bridge Rd) - Resurfacing & Bike Lanes (101706) N 1 958,569.0 5,520 0 953,049 0 0 0 0 0 0 0 0 0 CR711 (Pratt Whitney Rd) - Resurfacing & Bike Lanes (101707) N 1 3,343,896 57,053 0 3,286,843 0 0 0 0 0 0 0 0 0 SE Cove Road - Resurfacing (101712) N 1 1,497,776.0 0 0 0 60,000 10,000 0 1,427,776 0 0 0 0 0 Signal & Intersection Improvements (1016) N 1, 2, 4 4,233,717 0 0 375,000 630,000 375,000 390,000 588,717 375,000 375,000 375,000 375,000 375,000 Streetlights - Dixie Hwy (1121) N 1, 2, 4 530,000.0 175,000 215,000 140,000 0 0 0 0 215,000 0 0 0 0 Annual Commitments (1019) N 8 3,755,218.0 0 0 605,218 350,000 350,000 350,000 350,000 350,000 350,000 350,000 350,000 350,000 Multi-Modal Pathways (1011) N 1 200,000 0 0 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 Baker Road Improvements (1011H) N 1 370,400.0 0 0 370,400 0 0 0 0 0 0 0 0 0 SE Seabranch Blvd - Resurfacing (101709) N 2 1,016,217 0 0 60,000 10,000 0 946,217 0 0 0 0 0 0 SW High Meadow Ave - Resurfacing & Bike Lanes (101711) N 2 1,399,115.0 0 0 65,000 10,000 0 1,324,115 0 0 0 0 0 0 SW Mapp Road - Resurfacing (101714) N 2 1,256,688 0 0 60,000 10,000 1,186,688 0 0 0 0 0 0 0 SW Murphy Road Resurfacing (101715) N 2 1,009,139.0 0 0 60,000 10,000 0 939,139 0 0 0 0 0 0 Parkwood Subdivision Resurfacing (101717) N 2 1,401,000.0 0 0 1,401,000 0 0 0 0 0 0 0 0 0 Palm City Farms Resurfacing (101718) N 2 935,000.0 0 0 935,000 0 0 0 0 0 0 0 0 0 Skyline/Highland/Pitchford Resurfacing (101719) N 2 526,000.0 0 0 526,000 0 0 0 0 0 0 0 0 0 Pinecrest Lakes Resurfacing (101720) N 2 769,000.0 0 0 769,000 0 0 0 0 0 0 0 0 0 Poinciana Gardens Resurfacing (101721) N 2 556,000.0 0 0 556,000 0 0 0 0 0 0 0 0 0 96th Street/Greenridge Resurfacing (101722) N 2 255,000.0 0 0 255,000 0 0 0 0 0 0 0 0 0 Heritage Ridge Resurfacing (101723) N 2 935,000.0 0 0 935,000 0 0 0 0 0 0 0 0 0 Murphy Rd (over C-23) - Bridge Replacement (105303) N 2 3,532,215 170,000 0 25,000 25,000 25,000 25,000 3,262,215 0 0 0 0 0 Bridge Replacements/Renovations (1053) N 2 21,391,740.0 0 18,030,480 124,000 157,250 157,250 157,250 157,250 4,127,748 4,127,748 4,127,748 4,127,748 4,127,748 Britt Rd Bridge - Bridge Replacement (105301) N 2 1,733,000 233,000 1,500,000 0 0 0 0 0 1,500,000 0 0 0 0 Heavy Equipment Replacement (4957) N 2 9,964,899.6 0 5,214,121 700,779 450,000 450,000 450,000 450,000 1,492,824 1,492,824 1,492,824 1,492,824 1,492,824 Engineering Field Ops and Traffic Building Replacement N 2 1,352,000 0 1,352,000 0 0 0 0 0 1,352,000 0 0 0 0 South Beach Road Resurfacing (1019) N 2 5,111,918 0 0 475,000 0 4,636,918 0 0 0 0 0 0 Hutchinson Island Beautification (2028A) N 10 1,386,450 319,950 0 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 SR-76 (S Kanner Hwy) - Interchange (1074A) C 3 7,011,133.0 2,965,133 0 4,046,000 0 0 0 0 0 0 0 0 0 SR-714 (Martin Hwy) - Widening (1123A) C 3 2,345,000.0 0 0 510,000 1,835,000 0 0 0 0 0 0 0 0 SR-76 (S Kanner Hwy) - Widening (1074) C 7 29,027,551 28,369,336 0 154,000 504,215 0 0 0 0 0 0 0 0 SE Willoughby Blvd - Extension (1031) C 5 5,920,000 1,915,000 3,024,688 837,000 0 0 0 0 3,168,000 0 0 0 0 SR710 (SW Warfield Blvd) - Widening (1066) C 5 2,225,000.0 0 1,908,574 0 0 0 0 257,000 1,968,000 0 0 0 0 Expenditure Totals 240,907,246 34,227,340 138,025,863 24,379,196 5,490,115 3,527,588 10,629,289 8,073,608 37,478,422 29,275,422 29,275,422 29,275,422 29,275,422 Revenue Total To Date Carryover FY2016 FY2017 FY2018 FY2019 FY2020 FY2021 FY2022 FY2023 FY2024 FY2025 Ad Valorem 5,377,000 0 0 5,377,000 0 0 0 0 0 0 0 0 0 City Funds 556,000 250,000 306,000 0 0 0 0 0 0 0 0 0 0 Gas Tax 21,741,329 1,270,163 3,181,166 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 1,729,000 Grant 25,212,351 2,560,061 2,347,500 7,846,277 475,000 806,688 7,126,834 4,049,991 0 0 0 0 0 Hutchinson Island MSTU 1,386,450 319,950 0 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 106,650 Impact Fee 1,707,715 695,872 811,843 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 20,000 LLC Contribution 1,600,000 756,000 844,000 0 0 0 0 0 0 0 0 0 0 Prop Share 316,426 0 0 0 0 0 316,426 0 0 0 0 0 0 Road MSTU 13,205,796 5,958 1,199,838 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 1,200,000 State Funds 31,781,268 28,369,336 0 664,000 2,594,215 0 0 153,717 0 0 0 0 0 Revenue Total 102,884,335 34,227,340 8,690,347 16,942,927 6,124,865 3,862,338 10,498,910 7,259,358 3,055,650 3,055,650 3,055,650 3,055,650 3,055,650 Total Unfunded 138,025,863 FY 2016 MARTIN COUNTY CAPITAL IMPROVEMENT PLAN (CIP) ROADS EXPENDITURE SUMMARY ROADS REVENUE SUMMARY Page 21
  • 31.
  • 32.
  • 33.
    Town of Sewall's Point 2016 CAPITAL IMPROVEMENT PLAN2016 2017 2018 2019 2020 5-YEAR TOTAL Streets & Bridges 90,000 350,000 350,000 345,000 345,000 1,480,000 Storm Water System 72,500 72,500 72,500 35,000 35,000 287,500 Vehicles 0 90,000 0 60,000 0 150,000 Parks & Landscaping 30,000 17,000 20,000 17,000 20,000 104,000 Town Hall 10,000 20,000 20,000 15,000 10,000 75,000 Pedway 0 25,000 85,000 0 0 110,000 Annual Expenditures 202,500 574,500 547,500 472,000 410,000 2,206,500 Page 24
  • 34.
  • 35.
    MARTIN COUNTY TRANSPORTATION IMPROVEMENT PROGRAM FY15 FEDERAL OBLIGATED ITEM NO PROJECT NAME FUNDWORK MIX PHASE 2015 FUNDING 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION CONSTRUCTION ‐1,971,029 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SA NEW BRIDGE CONSTRUCTION CONSTRUCTION ‐83,375 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION GRANTS AND MISCELLANEOUS ‐7,754 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY EB NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐1,412,028 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY HPP NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐553 230978 1 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SA NEW BRIDGE CONSTRUCTION RIGHT OF WAY ‐416,375 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT CONSTRUCTION 9,000 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT CONSTRUCTION 976,276 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SU ADD LANES & RECONSTRUCT GRANTS AND MISCELLANEOUS ‐17,694 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT PRELIMINARY ENGINEERING ‐426 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT PRELIMINARY ENGINEERING ‐151 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD EB ADD LANES & RECONSTRUCT RIGHT OF WAY 6,860 230978 2 CR‐714/INDIAN ST FROM TPK/MARTIN DOWNS BV TO W. OF MAPP ROAD SA ADD LANES & RECONSTRUCT RIGHT OF WAY 10,646 230978 4 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SU ENVIRONMENTAL MITIGATION CONSTRUCTION 2,931 230978 4 INDIAN STREET BRIDGE FROM W. OF MAPP ROAD TO E. OF KANNER HIGHWAY SU ENVIRONMENTAL MITIGATION GRANTS AND MISCELLANEOUS 500,000 413254 1 SR‐9/I‐95 F. S OF CR‐708/BRIDGE RD. TO HIGH MEADOW NHPP PD&E/EMO STUDY PRELIMINARY ENGINEERING 23,403 419250 2 SR‐710 BRIDGE #890016, BRIDGE REPLACEMENT NH BRIDGE‐REPLACE AND ADD LANES CONSTRUCTION ‐1,749,908 419250 2 SR‐710 BRIDGE #890016, BRIDGE REPLACEMENT SA BRIDGE‐REPLACE AND ADD LANES CONSTRUCTION 75,930 419250 4 SR‐710/WARFIELD BLVD FROM SW TRAIL DRIVE TO ENTRANCE RAMP TO SR‐76 SU LIGHTING CONSTRUCTION 2,931 427023 1 SR‐5/US‐1 FROM PBC/MARTIN CO LINE TO MP 5.03 NHRE RESURFACING CONSTRUCTION ‐70,184 427023 1 SR‐5/US‐1 FROM PBC/MARTIN CO LINE TO MP 5.03 SA RESURFACING CONSTRUCTION ‐64,147 427664 1 PALM CITY CRA SIDEWALKS EB SIDEWALK CONSTRUCTION ‐696 427664 1 PALM CITY CRA SIDEWALKS TALU SIDEWALK CONSTRUCTION 14,067 427664 1 PALM CITY CRA SIDEWALKS TALU SIDEWALK CONSTRUCTION 7,153 429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD HSP LIGHTING CONSTRUCTION 27,432 429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD EB LIGHTING GRANTS AND MISCELLANEOUS ‐524 429737 1 SR‐9/I‐95 FROM N OF CR‐708 TO S OF HIGH MEADOW RD NHPP LIGHTING PRELIMINARY ENGINEERING 16,441 429745 1 SR‐5/US‐1 @ SE POINCIANA LANE HSP LIGHTING CONSTRUCTION ‐55,067 431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SA RESURFACING CONSTRUCTION 89,038 431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SU RESURFACING CONSTRUCTION 2,961,935 431606 1 CR‐711/PRATT/WHITNEY FROM MARTIN/PALM BEACH CL TO SR‐76/KANNER HIGHWAY SU RESURFACING CONSTRUCTION 105,000 431646 1 CR‐707/DIXIE HWY FR. SOUTH OF FLORIDA ST. TO NORTH OF SE 5TH ST. TALT BIKE LANE/SIDEWALK CONSTRUCTION 5,000 431646 1 CR‐707/DIXIE HWY FR. SOUTH OF FLORIDA ST. TO NORTH OF SE 5TH ST. TALU BIKE LANE/SIDEWALK CONSTRUCTION 50 431649 1 CR‐A1A/SE DIXIE HWY. FROM US‐1 TO SATURN STREET TALT BIKE LANE/SIDEWALK CONSTRUCTION ‐113 431730 1 INDIANTOWN CONNECTOR SIDEWALKS TALT SIDEWALK CONSTRUCTION 830,034 431730 1 INDIANTOWN CONNECTOR SIDEWALKS TALT SIDEWALK CONSTRUCTION 27,233 433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALU SIDEWALK CONSTRUCTION 43,400 433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALU SIDEWALK CONSTRUCTION 13,000 433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE EB SIDEWALK PRELIMINARY ENGINEERING 7,000 Page 26
  • 36.
    MARTIN COUNTY TRANSPORTATION IMPROVEMENT PROGRAM FY15 FEDERAL OBLIGATED 433170 1 BAKER RD IMPROVEMENTS FROM NW GREEN RIVER PARKWAY TO SE BRAILLE PLACE TALTSIDEWALK PRELIMINARY ENGINEERING 300 434008 1 SW CITRIS BLVD. EMBANKMENT SLOPE EROSION MARTIN COUNTY (EMERGENCY) ER13 EMERGENCY OPERATIONS GRANTS AND MISCELLANEOUS 600 434273 1 I‐95/SR‐9 FR PALM BEACH COUNTYLINE TO N OF CR‐708/SE BRIDGE ROAD NHPP RESURFACING PRELIMINARY ENGINEERING ‐188,991 435353 1 SR‐76/ SW KANNER HWY @SCFE R/R XING #272274‐B RR MP; K 40.14 RHH RAIL SAFETY PROJECT RAILROAD AND UTILITIES 47,734 435423 1 SR‐714/SW MARTIN HWY @ SCFE CROSSING 272270Y RHH RAIL SAFETY PROJECT RAILROAD AND UTILITIES 36,607 436735 1 JONATHAN DICKINSON STATE PARK‐FLAP GRANT FOR TRAIL & US‐1 SIGNALIZATN PLH MISCELLANEOUS CONSTRUCTION PRELIMINARY ENGINEERING 100,000 427829 1 MARTIN UPWP FY 2012/2013 & 2013/2014 PL TRANSPORTATION PLANNING PRELIMINARY ENGINEERING ‐574,224 427830 1 MARTIN UPWP FY 2014/2015 & 2015/2016 PL TRANSPORTATION PLANNING PRELIMINARY ENGINEERING 838,079 Page 27
  • 37.
    434273.4 434273.1 435139.1 432705.1 437701.1 437838.1 434275.1 432348.1 436096.1 438040.1 436869.1 434733.1 433349.1 10 10 10 Witham Field Indiantown Airport Hobe Sound North Fork St Lucie River Loxahatchee River South Fork St Lucie River LAKEOKEECHOBEE INDIANRIVER ATLANTICOCEAN ST716 ST714 ST710 STA1A ST732 ST707 ST5 ST91 ST76 £¤1 £¤1 £¤98 §¨¦95 §¨¦95 State of Florida Department of Transportation 0 2 4 Miles ® Deepwater Seaportí n¤ Passenger Intermodal Station Bus Stationn£ Freight Intermodal Station# Major US or State Highway Other US or State Highway County Highway Major Airport o Interstate Highway Public Airportp Transportation Facilities Railway Florida at Work Transportation Improvements MARTIN COUNTY FY 2017-2021 Tentative Work Program FDOT Construction Only Overview Map: Area of Interest 2017 2018 2019 2020 2021 Projects by First Year of Construction Page 28
  • 38.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Number) FM # TIP # Project Name Page 4130805 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4 4130806 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4 4130807 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4 4134931 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT CAPITAL - 5307 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3 4137332 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO TRANSIT PLANNING - 5303 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3 4192522 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT TO CR609/SW ALLAPATTAH RD . . . . . . . A-3 4226413 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76/KANNER HWY - FROM LOST RIVER ROAD to MONTEREY RD. . . . . . . . . . . . . . . . . . . . . . . . . A-4 4241336 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 4241337 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 4259772 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT OPERATING - 5311 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4 4259773 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4 4278033 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-5 4278302 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO PL FY 16/17 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-6 4278303 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN UPWP FY 18-19/19-20 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-7 4278304 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-8 2309782 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/INDIAN ST - MARTIN DOWNS TO MAPP . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-2 2337031 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS ROADWAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 2337032 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 2339565 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 2339567 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO-PRIMARY MOWING & LITTER CONTRACT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 2342651 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 2342652 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO INTERSTATE BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 4071892 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT OPERATING - STATE GRANT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2 4071893 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2 (April 1, 2016) Page 29
  • 39.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Number) FM # TIP # Project Name Page 4293105 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS ... . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 4297744 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST PRIMARY ASPHALT REPAIR ... . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-6 4310351 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2 4315151 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY D . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2 4323481 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-732/JENSEN BCH BL FROM SR-5/US-1 TO SAVANAH RD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-9 4327051 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/BEELINE HWY FROM E. OF SR-76 TO PALM BEACH/MARTIN CL . . . . . . . . . . . . . . . . . . . . . . A-10 4330691 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SW BRIDGE RD FROM SR-76/SW KANNER HWY TO SW PRATT-WHITNEY RD . . . . . . . . . . A-11 4331591 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE . . . . . . . . . . . . . . . . . . . . . . . . . C-3 4333491 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A AT SEWALL'S POINT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-12 4342731 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FR PALM BEACH COUNTYLINE TO N OF CR-807/SE BRDG RD . . . . . . . . . . . . . . . . . . . . . . A-13 4342734 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 INTERCHANGE . . . . . . . . . . . . . . . . . . . A-14 4342751 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76 KANNER HIGHWAY PORT MAYACA AREA . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-15 4346201 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) . . . . . . . . . . . . . . . . . . . . . . . . C-3 4346241 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) . . . . . . . . . . . . . . . . . . . . . . C-4 4346371 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-4 4346601 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS . . . . . . . . . . . . . . . . . . . . . . . B-5 4346611 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SEC 5339 CAPITAL FOR BUS & BUS FACILITIES . . . . . . . . . . . . . . . . . . . . . . B-5 4347331 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-16 (April 1, 2016) Page 30
  • 40.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Number) FM # TIP # Project Name Page 4348381 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF SR-9/I-95 . . . . . . . . . . . . . . . . . . . . A-17 4349761 . . . . . . . . . . . . . . . . . . . . . . . . . . . S.E. SEABRANCH BLVD. FROM S.E. RETREAT DR. TO SR-5/US-1 . . . . . . . . . . . . . . . . . . . . . . . . . . . A-18 4351391 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL TO CR-708/SE BRIDGE ROAD . . . . . . . A-19 4354131 . . . . . . . . . . . . . . . . . . . . . . . . . . . MAPP RD. FROM SW MARTIN DOWNS BLVD TO SW MARTIN HIGHWAY . . . . . . . . . . . . . . . . . . . . . . A-20 4354531 . . . . . . . . . . . . . . . . . . . . . . . . . . . HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/MARTIN DOWNS BVLD . . . . . . . . . . . . . . . . . . A-21 4360961 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 FROM NORTH OF SALERNO RD. TO NORTH OF CENTRAL PARKWAY . . . . . . . . . . . . . . A-22 4363771 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MAPP RD.FROM SR-714/SW MARTIN DOWNS BLVD TO SW BRIDGEWAY ST. . . . . . . . . . . . . . . A-23 4363781 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MURPHY RD. FROM SW MAPP RD/SW MATHESON AVE TO MARTIN/ST. LUCIE CL . . . . . . . . . A-24 4364001 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS . . . . . . . . . . . . . . C-5 4364011 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) . . . . . . . . . . . . C-5 4364251 . . . . . . . . . . . . . . . . . . . . . . . . . . . MURPHY ROAD BRIDGE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-25 4367351 . . . . . . . . . . . . . . . . . . . . . . . . . . . JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL & US-1 SIGNALIZTION . . . . . . . . . . A-26 4368511 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-27 4368611 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE KINDRED STREET/SE JOHNSON AVE FROM SOUTH COLORADO TO SR-5/US-1 . . . . . . . . . . . . A-28 4368691 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD. . . . . . . . . . . . . . . . . . . . A-29 4368701 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLVD. TO SW MARTIN DOWNS BLVD. . . . . . . . . . . . . . . . A-30 4369671 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-31 4377011 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . A-32 4378381 . . . . . . . . . . . . . . . . . . . . . . . . . . . US-1/SR-5 FROM SOUTHEAST HERITAGE BLVD. TO NORTH OF SALERNO RD. . . . . . . . . . . . . . . . . A-33 4379631 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT SECURITY FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-5 4379641 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, WILDLIFE FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-6 4379711 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE PREPARATION . . . . . . . . . . . . C-6 4379801 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST) . . . . . . . . . . . . . . . C-6 4379921 . . . . . . . . . . . . . . . . . . . . . . . . . . . RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . . . . . . . . G-6 4379922 . . . . . . . . . . . . . . . . . . . . . . . . . . . THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . G-6 4379923 . . . . . . . . . . . . . . . . . . . . . . . . . . . ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 ... . . . . . . . . . . . . . . . . . . . . . . . G-7 4380401 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-34 (April 1, 2016) Page 31
  • 41.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Number) FM # TIP # Project Name Page 4380711 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE INDIAN ST FR US-1/FEDERAL HWY TO S OF RAILROAD CROSSING . . . . . . . . . . . . . . . . . . . . . . A-35 4380721 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE DIXIE HWY/CR-A1A FR SE JEFFERSON ST TO SE INDIAN ST . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-36 4381251 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DRIVE . . . . . . . . . . . . . . . . . . . A-37 4383421 . . . . . . . . . . . . . . . . . . . . . . . . . . . SAVANNAH ROAD FROM NE CARDINAL AVENUE TO JENSEN BEACH BOULEVARD . . . . . . . . . . . . A-38 4383431 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-609 FROM .51 MILES N. OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE . . . . . . . . . . . . . . A-39 4383441 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLV TO SW MARTIN DOWNS BLV - RESERVE . . . . . . . . . A-40 4383451 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-41 4383452 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-42 4383461 . . . . . . . . . . . . . . . . . . . . . . . . . . . MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST. LUCIE BLVD . . . . . . . . . . . . . . . . . . . . . . . A-43 4383471 . . . . . . . . . . . . . . . . . . . . . . . . . . . INDIAN STREET FROM DIXIE HIGHWAY TO ST. LUCIE BLVD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-44 4383481 . . . . . . . . . . . . . . . . . . . . . . . . . . . ST. LUCIE BLVD FROM INDIAN ST TO E. OCEAN BLVD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-45 4385221 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS . . . . . . . . . . . . . . . . . B-6 4385241 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE . . . . . . . . . . . . . . . . . . . . . . B-6 4385661 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-46 (April 1, 2016) Page 32
  • 42.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Section A - Highway (April 1, 2016) Page 33
  • 43.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 2309782 CR-714/INDIAN ST - MARTIN DOWNS TO MAPP RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Widening and reconstruction of CR 714 from the Turnpike to W of Mapp Road. ADD LANES & RECONSTRUCT FDOT TPK/MARTIN DOWNS BV W. OF MAPP ROAD 1.879 mi 21,794,930 0 21,879,575 p.42 - Table 7-4, Fig 7-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total ROW SU 230 84,415 0 0 0 84,645 Total 230 84,415 0 0 0 84,645 (April 1, 2016) Page 34
  • 44.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4192522 SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT TO CR 609/ SW ALLAPATAH RD SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: PD&E 419344-1 ADD LANES & RECONSTRUCT FDOT MP 9.771 MP 14.967 5.174 mi 2,126,372 45,162,688 55,545,867 p. 37 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total ROW DDR 0 1,035,466 3,077,172 827,617 0 4,940,255 ROW DS 0 0 2,715,360 61,992 0 2,777,352 ROW DIH 0 0 9,048 0 0 9,048 ROW SA 0 0 510,071 20,081 0 530,152 Total 0 1,035,466 6,311,651 909,690 0 8,256,807 (April 1, 2016) Page 35
  • 45.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4226413 SR-76/ KANNER HWY - FROM LOST RIVER ROAD TO MONTEREY RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Right of way acquisition for the widening and reconstruction of SR 76 from Lost River Road to Monterey Rd. ADD LANES & RECONSTRUCT FDOT LOST RIVER ROAD MONTEREY ROAD 5.608 mi 32,674,573 0 35,535,273 p. 42, Table 7-4, Fig 7-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total ROW DDR 2,860,700 0 0 0 0 2,860,700 Total 2,860,700 0 0 0 0 2,860,700 (April 1, 2016) Page 36
  • 46.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4278033 MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: TRAFFIC CONTROL DEVICES/SYSTEM Managed by MARTIN COUNTY BOARD OF .000 228,456 0 1,842,959 p. 10, Table 3-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total OPS DITS 197,264 202,196 207,250 212,432 217,743 1,036,885 OPS DDR 136,599 141,683 146,946 152,390 0 577,618 Total 333,863 343,879 354,196 364,822 217,743 1,614,503 (April 1, 2016) Page 37
  • 47.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4278302 MARTIN MPO PL FY 16/17 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: TRANSPORTATION PLANNING FUNDS; UPWP 2016/2017 & 2017/2018 TRANSPORTATION PLANNING FDOT FY 2016/2017 2017/2018 0 0 843,260 p. 10, Table 3-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PLN (12) PL 421,630 0 0 0 0 421,630 PLN PL 0 421,630 0 0 0 421,630 Total 421,630 421,630 0 0 0 843,260 (April 1, 2016) Page 38
  • 48.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4278303 MARTIN UPWP FY 18-19/19-20 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: FUNDING FOR TRANSPORTATION PLANNING; MARTIN UPWP FPR FY 18-19/19-20 TRANSPORTATION PLANNING FDOT .000 0 0 843,260 p. 10, Table 3-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PLN PL 0 0 421,630 421,630 0 843,260 Total 0 0 421,630 421,630 0 843,260 (April 1, 2016) Page 39
  • 49.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4278304 MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: TRANSPORTATION PLANNING FUNDS; MARTIN UPWP TRANSPORTATION PLANNING FDOT .000 0 0 421,630 p. 10, Table 3-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PLN PL 0 0 0 0 421,630 421,630 Total 0 0 0 0 421,630 421,630 (April 1, 2016) Page 40
  • 50.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4323481 SR-732/ JENSEN BEACH BLVD FROM SR-5/US-1 TO SAVANNA RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: RESURFACING Managed by FDOT SR-5/ US-1 Savannah Road 2.210 0 0 2,480,471 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE DDR 207,761 0 0 0 0 207,761 PE DIH 10,000 0 0 0 0 10,000 CST SA 0 0 1,926,766 0 0 1,926,766 CST DIH 0 0 65,566 0 0 65,566 CST DDR 0 0 270,378 0 0 270,378 Total 217,761 0 2,262,710 0 0 2,480,471 (April 1, 2016) Page 41
  • 51.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4327051 SR-710/ BEELINE HWY FROM E OF SR-76 TO PALM BEACH/MARTIN SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Reconstruction of the existing 2 lanes; expanded to 4 lanes divided rural roadway; open drainage with swales. ADD LANES & RECONSTRUCT Managed by FDOT EAST OF SR-76 WEST OF INDIANTOWN RD 5.598 MI 2,423,542 0 40,523,583 p.42, Table 7-4, Fig 7-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SA 387,381 0 0 0 0 387,381 CST ACNP 36,971,525 0 0 0 0 36,971,525 CST DDR 221,923 0 0 0 0 221,923 CST DS 519,212 0 0 0 0 519,212 Total 38,100,041 0 0 0 0 38,100,041 (April 1, 2016) Page 42
  • 52.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4330691 CR-708/ SW BRIDGE RD FROM SR-76/ SW KANNER HWY TO SW PRATT-WHITNEY RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Resurfacing; SCOP (Small County Outreach Program); RESURFACING Martin County SR-76 SW Pratt-Whitney Road 2.676 MI 0 0 803,904 p. 12, Appendix D, p. 8 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCED 540,541 0 0 0 0 540,541 CST GRSC 62,387 0 0 0 0 62,387 CST LF 200,976 0 0 0 0 200,976 Total 803,904 0 0 0 0 803,904 (April 1, 2016) Page 43
  • 53.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4333491 SR-A1A AT SEWALL'S POINT ROAD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Upgrade traffic signals to mast arms at A1A Sewalls Point Road TRAFFIC SIGNAL UPDATE Managed by FDOT .010 MI 36,192 0 535,169 p. 17 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DIH 28,747 0 0 0 0 28,747 CST DDR 364,568 0 0 0 0 364,568 CST LF 6,000 0 0 0 0 6,000 CST DS 99,662 0 0 0 0 99,662 Total 498,977 0 0 0 0 498,977 (April 1, 2016) Page 44
  • 54.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4342731 I-95/SR-9 FROM PALM BEACH COUNTYLINE TO N OF CR-807/SE BRIDGE RD SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: NEW INTERSTATE RRR CANDIDATE RESURFACING Managed by FDOT PALM BEACH COUNTYLINE N OF C-807/SE BRDGE ROAD 7.849 MI 394,331 0 16,126,826 p. 7, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SA 324,460 0 0 0 0 324,460 CST ACNP 15,333,035 0 0 0 0 15,333,035 INC SA 0 0 75,000 0 0 75,000 Total 15,657,495 0 75,000 0 0 15,732,495 (April 1, 2016) Page 45
  • 55.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4342734 I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: ANTICIPATED SAFETY PROJECT SAFETY PROJECT Managed by FDOT 8.000 0 0 6,292,331 p. 7, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE HSP 0 926,042 0 0 0 926,042 CST HSP 0 0 0 5,366,289 0 5,366,289 Total 0 926,042 0 5,366,289 0 6,292,331 (April 1, 2016) Page 46
  • 56.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4342751 SR-76 KANNER HIGHWAY PORT MAYACA AREA Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: THIS SEGMENT IS OUT BY THE LAKE IN THE PORT MAYACA AREA CHANGE TRANSPORT SYSTEM 05 TO 03 2013-07-13 CHANGE RESURFACING Managed by FDOT 1.810 MI 350,871 0 2,172,954 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DIH 25,625 0 0 0 0 25,625 CST DDR 1,750,015 0 0 0 0 1,750,015 CST DS 46,443 0 0 0 0 46,443 Total 1,822,083 0 0 0 0 1,822,083 (April 1, 2016) Page 47
  • 57.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4347331 SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: STAND ALONE LANDSCAPING PROJECT LANDSCAPING Managed by FDOT .500 MI 200,611 0 1,815,134 p. 7, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DIH 0 0 0 0 28,450 28,450 CST DDR 0 0 0 0 1,573,136 1,573,136 CST DS 0 0 0 0 12,937 12,937 Total 0 0 0 0 1,614,523 1,614,523 (April 1, 2016) Page 48
  • 58.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4348381 CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF SR-9/ I-95 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: SCOP (Small County Outreach Program) JPA with Martin County includes SW Allapattah Rd. from CR-714 to Martin/St Lucie CL RESURFACING Martin County Sw Fox Brown Rd W of SR-9/I-95 12.792 MI 1,740,297 0 2,044,293 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCWR 7,145 0 0 0 0 7,145 CST SCOP 242,520 0 0 0 0 242,520 CST GRSC 54,331 0 0 0 0 54,331 Total 303,996 0 0 0 0 303,996 (April 1, 2016) Page 49
  • 59.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4349761 SE SEABRANCH BLVD FROM SE RETREAT DR TO SR-5/US-1 Non-SIS Project Description: Work Summary: Lead Agency: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Martin County SCOP (Small County Outreach Program) JPA with Martin County, 75/25 Match RESURFACING From: SE Retreat Dr SR-5/US-1 2.560 MI 0 0 856,883 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCOP 7,568 7,568 0 0 0 15,136 CST GRSC 99,624 273,785 0 0 0 373,409 CST LF 214,221 0 0 0 0 214,221 CST SCWR 0 156,051 0 0 0 156,051 CST SCED 0 98,066 0 0 0 98,066 Total 321,413 535,470 0 0 0 856,883 (April 1, 2016) Page 50
  • 60.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4351391 CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL TO CR-708/SE BRIDGE RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: RESURFACING S.E. BEACH ROAD FROM PB/MARTIN COUNTY LINE TO S.E. BRIDGE ROAD RESURFACING Managed by FDOT 7.052 MI 0 0 7,130,197 p. 42, Table 7-4, Fig 7-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 251,295 0 0 0 0 251,295 PE SA 223,705 0 0 0 0 223,705 CST SA 0 0 3,384,079 0 0 3,384,079 CST SU 0 0 3,271,118 0 0 3,271,118 Total 475,000 0 6,655,197 0 0 7,130,197 (April 1, 2016) Page 51
  • 61.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4354131 MAPP RD FROM SW MARTIN DOWNS BLVD TO SW MARTIN HWY Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Bike lane/Sidewalk; LAP with Martin County; MPO 2013 Priority #2 BIKE LANE/SIDEWALK Martin County SW Martin Downs Blvd SW Martin Hwy .771 MI 4,381 0 275,481 p. 17 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST TALT 113,308 0 0 0 0 113,308 CST LFP 21,100 0 0 0 0 21,100 CST TALU 136,692 0 0 0 0 136,692 Total 271,100 0 0 0 0 271,100 (April 1, 2016) Page 52
  • 62.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4354531 HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/ MARTIN DOWNS BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: Resurfacing RESURFACING Martin County Martin Hwy SR-714/Martin Downs Blvd .796 MI 0 0 1,355,610 p. 42, Table 7-4, Fig 7-1 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SA 5,000 0 0 0 0 5,000 CST CM 0 0 1,249,819 0 0 1,249,819 CST SA 0 0 100,791 0 0 100,791 Total 5,000 0 1,350,610 0 0 1,355,610 (April 1, 2016) Page 53
  • 63.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4360961 SR-5/US-1 FROM N OF SALERNO RD TO N OF CENTRAL PKWY Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: RESURFACING Managed by FDOT 1.580 482,308 0 2,715,933 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DIH 0 21,060 0 0 0 21,060 CST DDR 0 2,212,565 0 0 0 2,212,565 Total 0 2,233,625 0 0 0 2,233,625 (April 1, 2016) Page 54
  • 64.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 (April 1, 2016) 4363771 SW MAPP RD FROM SR-714/SW MARTIN DOWNS BLVD TO SW BRIDGEWAY ST Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: SCOP JPA W/MARTIN COUNTY RESURFACING Responsible Agency Not Available 2.805 0 0 1,089,349 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCWR 0 425,491 0 0 0 425,491 CST GRSC 0 25,621 365,900 0 0 391,521 CST LF 0 272,337 0 0 0 272,337 Total 0 723,449 365,900 0 0 1,089,349 Page 55
  • 65.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 (April 1, 2016) 4363781 SW MURPHY RD FROM SW MAPP RD/SW MATHESON AVE TO MARTIN/ST LUCIE CL Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: SCOP JPA W/ MARTIN COUNTY MILE POINT EXCEPTION FROM 3.46 TO 3.48 RESURFACING Responsible Agency Not Available 2.660 0 0 877,129 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST GRSC 0 0 200,527 457,320 0 657,847 CST LF 0 0 219,282 0 0 219,282 Total 0 0 419,809 457,320 0 877,129 Page 56
  • 66.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4364251 MURPHY ROAD BRIDGE Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: LAP CRITICAL PROJECT W/ MARTIN COUNTY; MPO 2014 PRIORITY #2 BRIDGE REPLACEMENT Managed by FDOT .020 0 0 3,258,239 P. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SA 0 7,000 0 0 0 7,000 CST SA 0 0 0 1,289,256 0 1,289,256 CST SU 0 0 0 1,961,983 0 1,961,983 Total 0 7,000 0 3,251,239 0 3,258,239 (April 1, 2016) Page 57
  • 67.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4367351 JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL Non-SIS Project Description: Work Summary: Lead Agency: From: To: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL & US-1 SIGNALIZATION MISCELLANEOUS CONSTRUCTION FDOT 130,000 0 1,200,000 p. 56, Fig. 7-3 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST PLH 551,000 0 0 0 0 551,000 CST DIH 5,000 0 0 0 0 5,000 CST DS 514,000 0 0 0 0 514,000 Total 1,070,000 0 0 0 0 1,070,000 (April 1, 2016) Page 58
  • 68.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4368511 SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: SMALL COUNTY OUTREACH PROGRAM JPA WITH MARTIN COUNTY. RESURFACING Responsible Agency Not Available 4.340 0 0 1,345,657 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCWR 0 0 0 260,646 0 260,646 CST SCED 0 0 0 54,054 0 54,054 CST SCOP 0 0 0 260,947 0 260,947 CST GRSC 0 0 0 433,596 0 433,596 CST LF 0 0 0 336,414 0 336,414 Total 0 0 0 1,345,657 0 1,345,657 (April 1, 2016) Page 59
  • 69.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4368611 SE KINDRED STREET/SE JOHNSON AVE FROM S COLORADO TO SR-5/ US-1 Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2014 MPO TAP PRIORITY #1 LAP PROJECT WITH MARTIN COUNTY SIDEWALK Managed by FDOT .381 5,000 0 730,218 p. 15-16 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST TALT 0 353,904 0 0 0 353,904 CST LF 0 371,314 0 0 0 371,314 Total 0 725,218 0 0 0 725,218 (April 1, 2016) Page 60
  • 70.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4368691 SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #6; LF FOR DECORATIVE LIGHTING DIFFERENTIAL; 2014 MPO PRIORITY #4 LIGHTING Managed by FDOT 3.700 0 0 1,865,817 p. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE DDR 200,000 0 0 0 0 200,000 PE DIH 5,000 0 0 0 0 5,000 CST DDR 0 0 776,228 0 0 776,228 CST SU 0 0 776,816 0 0 776,816 CST DS 0 0 107,773 0 0 107,773 Total 205,000 0 1,660,817 0 0 1,865,817 (April 1, 2016) Page 61
  • 71.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4368701 SR-714/SW MARTIN HWY FROM CITRUS BLVD TO SW MARTIN DOWNS BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #5; STATE FUNDS ONLY; 2014 MPO PRIORITY #5 PD&E/EMO STUDY Managed by FDOT 1.120 583,149 0 2,428,149 p. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE DDR 800,000 0 0 0 0 800,000 PDE DDR 1,000,000 0 0 0 0 1,000,000 PDE DIH 30,000 0 0 0 0 30,000 PE DIH 15,000 0 0 0 0 15,000 Total 1,845,000 0 0 0 0 1,845,000 (April 1, 2016) Page 62
  • 72.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4369671 SR-5/US-1 NORTH OF NW BRITT ROAD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #1; MASTARM RELOCATION NORTHEAST QUADRANT OF NW MALL ENTRY SOUTH; 2014 MPO PRIORITY #3 TRAFFIC SIGNALS Managed by FDOT .020 0 0 408,717 p. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE DDR 250,000 0 0 0 0 250,000 PE DIH 5,000 0 0 0 0 5,000 ROW DDR 0 0 135,717 0 0 135,717 ROW DIH 0 0 18,000 0 0 18,000 Total 255,000 0 153,717 0 0 408,717 (April 1, 2016) Page 63
  • 73.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4377011 SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: LIGHTING Managed by FDOT 4.876 0 0 4,181,116 p. 7, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE HSP 601,842 0 0 0 0 601,842 CST HSP 0 0 3,579,274 0 0 3,579,274 Total 601,842 0 3,579,274 0 0 4,181,116 (April 1, 2016) Page 64
  • 74.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4378381 US-1/SR-5 FROM SE HERITAGE BLVD TO NORTH OF SALERNO RD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: ADJACENT TO FM#436096.1 RESURFACING Managed by FDOT 3.560 0 0 8,843,533 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE DDR 819,891 0 0 0 0 819,891 PE DIH 5,000 0 0 0 0 5,000 CST DIH 0 0 108,201 0 0 108,201 CST NHRE 0 0 2,799,597 0 0 2,799,597 CST DDR 0 0 5,110,844 0 0 5,110,844 Total 824,891 0 8,018,642 0 0 8,843,533 (April 1, 2016) Page 65
  • 75.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4380401 SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: STAND ALONE LANDSCAPING LANDSCAPING Managed by FDOT 1.400 195,349 0 1,895,932 p. 7, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DIH 51,250 0 0 0 0 51,250 CST DDR 192,700 0 0 0 0 192,700 CST DS 1,456,633 0 0 0 0 1,456,633 Total 1,700,583 0 0 0 0 1,700,583 (April 1, 2016) Page 66
  • 76.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4380711 SE INDIAN ST FROM US-1/FEDERAL HWY TO S OF RAILROAD CROSSING Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: RESURFACING Managed by MARTIN COUNTY BOARD OF .260 0 0 309,368 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCOP 0 0 0 232,026 0 232,026 CST LF 0 0 0 77,342 0 77,342 Total 0 0 0 309,368 0 309,368 (April 1, 2016) Page 67
  • 77.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4380721 SE DIXIE HWY/CR-A1A FROM SE JEFFERSON ST TO SE INDIAN ST Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: RESURFACING Responsible Agency Not Available .590 0 0 575,892 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST SCOP 0 0 0 0 431,919 431,919 CST LF 0 0 0 0 143,973 143,973 Total 0 0 0 0 575,892 575,892 (April 1, 2016) Page 68
  • 78.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4381251 CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DR Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: LAP W/MARTIN COUNTY - MARTIN MPO RANKING #1 - TAP FY 2015 SIDEWALK ON SOUTH SIDE ONLY, INSTALL DRAINAGE, PEDESTRIAN SIDEWALK Managed by FDOT .373 0 0 398,534 p. 13-14 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE TALU 7,000 0 0 0 0 7,000 CST TALT 0 0 164,871 0 0 164,871 CST LFP 0 0 62,568 0 0 62,568 CST TALU 0 0 164,095 0 0 164,095 Total 7,000 0 391,534 0 0 398,534 (April 1, 2016) Page 69
  • 79.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383421 SAVANNAH ROAD FROM NE CARDINAL AVENUE TO JENSEN BEACH BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #2;LAP W/ MARTIN COUNTY; 2015 MPO #2 RESURFACING Managed by FDOT 2.085 0 0 1,125,963 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SA 0 5,000 0 0 0 5,000 CST SU 0 0 0 1,120,963 0 1,120,963 Total 0 5,000 0 1,120,963 0 1,125,963 (April 1, 2016) Page 70
  • 80.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383431 CR-609 FROM 0.51 MILES N OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #3; LAP W/ MARTIN COUNTY; 2015 MPO PRIORITY #3 GUARDRAIL Managed by FDOT 3.336 0 0 783,291 p. 8, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SA 0 10,000 0 0 0 10,000 CST SU 0 0 0 773,291 0 773,291 Total 0 10,000 0 773,291 0 783,291 (April 1, 2016) Page 71
  • 81.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383441 SR-714/SW MARTIN HWY FROM CITRUS BLVD TO SW MARTIN DOWNS BLVD - RESERVE Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #5; R/W RESERVE FOR 436870-1 SWAT PROJECT-STATE FUNDS ONLY; 2015 MPO PRIORITY #5 FUNDING ACTION Managed by FDOT .000 0 0 4,000,000 p. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total ROW DDR 0 0 0 0 4,000,000 4,000,000 Total 0 0 0 0 4,000,000 4,000,000 (April 1, 2016) Page 72
  • 82.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383451 SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #4;PROVIDE BUFFERED SHOULDERS/BIKE LANE; 2015 MPO PRIORITY #4 PRELIMINARY ENGINEERING Managed by FDOT .650 0 0 310,000 p. 13-14 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 0 310,000 0 0 0 310,000 Total 0 310,000 0 0 0 310,000 (April 1, 2016) Page 73
  • 83.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383452 SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #4; OPERATIONAL ANALYSIS TO DETERMINE IF LEFT TURN LANE STORAGE CAN BE INCREASED; 2015 MPO TRAFFIC ENGINEERING STUDY Managed by FDOT .057 0 0 310,000 p. 8, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 0 310,000 0 0 0 310,000 Total 0 310,000 0 0 0 310,000 (April 1, 2016) Page 74
  • 84.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383461 MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST LUCIE BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #7; MID-BLOCK PEDESTRIAN CROSSWALKS ALSO INCLUDES OCEAN BLVD FROM MONTEREY RD TO ST. LUCIE TRAFFIC ENGINEERING STUDY Managed by FDOT .000 0 0 203,000 p. 13-14 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 0 0 0 203,000 0 203,000 Total 0 0 0 203,000 0 203,000 (April 1, 2016) Page 75
  • 85.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383471 INDIAN STREET FROM DIXIE HIGHWAY TO ST LUCIE BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #8; 2015 MPO PRIORITY #8 RESURFACING Managed by FDOT .762 0 0 339,158 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 0 0 10,000 0 0 10,000 CST SU 0 0 0 0 329,158 329,158 Total 0 0 10,000 0 329,158 339,158 (April 1, 2016) Page 76
  • 86.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4383481 ST LUCIE BLVD FROM INDIAN ST TO E OCEAN BLVD Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #9; LAP W/ MARTIN COUNTY; 2015 MPO PRIORITY #9 RESURFACING Managed by FDOT 2.437 0 0 793,917 p. 12, Appendix D Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total PE SU 0 0 10,000 0 0 10,000 CST SU 0 0 0 0 783,917 783,917 Total 0 0 10,000 0 783,917 793,917 (April 1, 2016) Page 77
  • 87.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 4385661 SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE Non-SIS Project Description: Work Summary: Lead Agency: From: To: Length: Prior Year Cost: Future Year Cost: Total Project Cost: LRTP: 2016 MPO PRIORITY #1; CONSTRUCTION RESERVE FOR 436967-1; 2015 MPO PRIORITY #1 FUNDING ACTION Managed by FDOT .000 0 0 1,000,000 p. 31, Appendix B Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total CST DDR 0 0 0 0 1,000,000 1,000,000 Total 0 0 0 0 1,000,000 1,000,000 (April 1, 2016) Page 78
  • 88.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Section B - Transit (April 1, 2016) Page 79
  • 89.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4071892 (TIP# ) MARTIN CO TRANSIT OPERATING - STATE GRANT FROM BLOCK GRANT TO *Non-SIS* Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: Martin County LRTP#: p. 29, Appendix B Additional 75,000 programmed to supplement Block Grant change OPS DPTO 256,358 262,985 271,668 0 0 791,011 OPS DDR 75,000 75,000 75,000 0 0 225,000 OPS LF 256,358 262,985 271,668 0 0 791,011 Total 587,716 600,970 618,336 0 0 1,807,022 Prior Years Cost 1,172,626 Future Years Cost 0 Total Project Cost 2,979,648 FM# 4071893 (TIP# ) MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE *Non-SIS*Length: .000 Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: MANAGED BY MARTIN LRTP#: p. 29, Appendix B OPS DPTO 0 0 0 285,251 285,251 570,502 OPS DDR 0 0 0 75,000 83,557 158,557 OPS LF 0 0 0 285,251 293,808 579,059 Total 0 0 0 645,502 662,616 1,308,118 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,308,118 (April 1, 2016) Page 80
  • 90.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4134931 (TIP# ) MARTIN CO TRANSIT CAPITAL - 5307 AT FTA SECTION 5307 *Non-SIS* Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: Martin County LRTP#: p. 29, Appendix B Transit funding for fixed route. OPS FTA 719,000 719,000 719,000 719,000 719,000 3,595,000 CAP FTA 230,000 230,000 230,000 230,000 230,000 1,150,000 Total 949,000 949,000 949,000 949,000 949,000 4,745,000 Prior Years Cost 4,690,824 Future Years Cost 0 Total Project Cost 9,435,824 FM# 4137332 (TIP# ) MARTIN MPO TRANSIT PLANNING - 5303 FROM SECTION 5303 TO TRANSIT *Non-SIS* Type of Work: PTO STUDIES Lead Agency: Martin MPO LRTP#: p. 29, Appendix B Public Transit Planning Studies PLN DU 58,410 0 0 0 0 58,410 PLN LF 7,301 0 0 0 0 7,301 PLN (1NA) DPTO 7,301 7,301 7,301 7,301 7,301 36,505 PLN (1NA) LF 0 7,301 7,301 7,301 7,301 29,204 PLN (1NA) DU 0 58,410 58,410 58,410 58,410 233,640 Total 73,012 73,012 73,012 73,012 73,012 365,060 Prior Years Cost 169,092 Future Years Cost 0 Total Project Cost 534,152 (April 1, 2016) Page 81
  • 91.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4259772 (TIP# ) MARTIN COUNTY TRANSIT OPERATING - 5311 FROM SECTION 5311, TO SMALL *Non-SIS* Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: Martin County LRTP#: p. 29, Appendix B Transit operations funding OPS DU 102,367 113,812 117,944 0 0 334,123 OPS LF 100,897 113,812 117,944 0 0 332,653 Total 203,264 227,624 235,888 0 0 666,776 Prior Years Cost 426,380 Future Years Cost 0 Total Project Cost 1,093,156 FM# 4259773 (TIP# ) MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS *Non-SIS*Length: .000 Type of Work: OPERATING/ADMIN. ASSISTANCE Lead Agency: MANAGED BY MARTIN LRTP#: p. 29, Appendix B OPS DU 0 0 0 90,447 90,340 180,787 OPS LF 0 0 0 90,447 90,340 180,787 Total 0 0 0 180,894 180,680 361,574 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 361,574 (April 1, 2016) Page 82
  • 92.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4346601 (TIP# ) MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS *Non-SIS*Length: .000 Type of Work: OPERATING FOR FIXED ROUTE Lead Agency: Martin County LRTP#: p. 29, Appendix B OPERATING FOR FIXED ROUTE; MARTIN COUNTY TRANSIT CORRIDOR OPS DPTO 450,000 0 0 0 0 450,000 OPS DDR 0 450,000 0 0 0 450,000 Total 450,000 450,000 0 0 0 900,000 Prior Years Cost 396,880 Future Years Cost 0 Total Project Cost 1,296,880 FM# 4346611 (TIP# ) MARTIN COUNTY SEC 5339 CAPITAL FOR BUS & BUS FACILITIES *Non-SIS*Length: .000 Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: Martin County LRTP#: p. 29, Appendix B CAPITAL FOR BUS AND BUS FACILITIES CAP FTA 78,000 78,000 78,000 78,000 0 312,000 Total 78,000 78,000 78,000 78,000 0 312,000 Prior Years Cost 273,145 Future Years Cost 0 Total Project Cost 585,145 (April 1, 2016) Page 83
  • 93.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4385221 (TIP# ) MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS *Non-SIS*Length: .000 Type of Work: OPERATING FOR FIXED ROUTE Lead Agency: MANAGED BY CITY OF LRTP#: p. 29, Appendix BProject Type: Imported NOTE: Stuart Tram improvements OPS DPTO 220,000 0 0 0 0 220,000 OPS LF 220,000 0 0 0 0 220,000 Total 440,000 0 0 0 0 440,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 440,000 FM# 4385241 (TIP# ) MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE *Non-SIS*Length: .000 Type of Work: CAPITAL FOR FIXED ROUTE Lead Agency: MANAGED BY CITY OF LRTP#: p. 29, Appendix BProject Type: Imported NOTE: Stuart Tram CAP DPTO 34,000 0 0 0 0 34,000 CAP LF 34,000 0 0 0 0 34,000 Total 68,000 0 0 0 0 68,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 68,000 (April 1, 2016) Page 84
  • 94.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Section C - Aviation (April 1, 2016) Page 85
  • 95.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4310351 (TIP# ) WITHAM FIELD - TAXIWAY A AT TAXIWAY A IMPROVEMENTS *Non-SIS* Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT LRTP#: p. 8, Appendix D Improvements to Taxiway A CAP DS 649,669 0 0 0 0 649,669 CAP DDR 550,331 0 0 0 0 550,331 CAP LF 300,000 0 0 0 0 300,000 Total 1,500,000 0 0 0 0 1,500,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,500,000 FM# 4315151 (TIP# ) WITHAM FIELD - TAXIWAY D AT TAXIWAY D IMPROVEMENTS *Non-SIS* Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT LRTP#: p. 8, Appendix D Improvements to Taxiway D CAP DDR 0 300,000 181,064 0 0 481,064 CAP LF 0 75,000 75,000 0 0 150,000 CAP DPTO 0 0 118,936 0 0 118,936 Total 0 375,000 375,000 0 0 750,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 750,000 (April 1, 2016) Page 86
  • 96.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4331591 (TIP# ) MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE *Non-SIS*Length: .000 Type of Work: AVIATION REVENUE/OPERATIONAL Lead Agency: FDOT LRTP#: p. 8, Appendix D CAP DPTO 0 0 25,000 0 0 25,000 CAP FAA 0 0 450,000 0 0 450,000 CAP LF 0 0 25,000 0 0 25,000 Total 0 0 500,000 0 0 500,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 500,000 FM# 4346201 (TIP# ) WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) *Non-SIS*Length: .000 Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT LRTP#: p. 8, Appendix D AVIATION PRESERVATION PROJECT TAXIWAY A (PHASE 1 DESIGN) CAP DPTO 0 0 0 0 120,000 120,000 CAP LF 0 0 0 0 30,000 30,000 Total 0 0 0 0 150,000 150,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000 (April 1, 2016) Page 87
  • 97.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4346241 (TIP# ) WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) *Non-SIS*Length: .000 Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT LRTP#: p. 8, Appendix D AVIATION PRESERVATION; INTERCONNECT ROAD (PHASE 2) CAP DPTO 0 480,000 0 0 0 480,000 CAP LF 0 120,000 0 0 0 120,000 Total 0 600,000 0 0 0 600,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 600,000 FM# 4346371 (TIP# ) WITHAM FIELD MILL & RESURFACE TAXIWAY A *Non-SIS*Length: .000 Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: FDOT LRTP#: p. 8, Appendix D TAXIWAY A AVIATION PRESERVATION MSC LF 0 0 300,000 0 0 300,000 MSC DPTO 0 0 1,200,000 0 0 1,200,000 Total 0 0 1,500,000 0 0 1,500,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,500,000 (April 1, 2016) Page 88
  • 98.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4364001 (TIP# ) WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS *Non-SIS*Length: .000 Type of Work: AVIATION PRESERVATION PROJECT Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix D CAP DPTO 0 0 25,000 0 0 25,000 CAP FAA 0 0 450,000 0 0 450,000 CAP LF 0 0 25,000 0 0 25,000 Total 0 0 500,000 0 0 500,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 500,000 FM# 4364011 (TIP# ) WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) *Non-SIS*Length: .000 Type of Work: AVIATION CAPACITY PROJECT Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix D CAP DPTO 0 0 800,000 0 0 800,000 CAP LF 0 0 200,000 0 0 200,000 Total 0 0 1,000,000 0 0 1,000,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000 FM# 4379631 (TIP# ) WITHAM FIELD, AIRPORT SECURITY FENCE *Non-SIS*Length: .000 Type of Work: AVIATION SECURITY PROJECT Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix DProject Type: Imported CAP DPTO 0 800,000 0 0 0 800,000 CAP LF 0 200,000 0 0 0 200,000 Total 0 1,000,000 0 0 0 1,000,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000 (April 1, 2016) Page 89
  • 99.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4379641 (TIP# ) WITHAM FIELD, WILDLIFE FENCE *Non-SIS*Length: .000 Type of Work: AVIATION SAFETY PROJECT Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix DProject Type: Imported CAP DPTO 0 50,000 0 0 0 50,000 CAP FAA 0 900,000 0 0 0 900,000 CAP LF 0 50,000 0 0 0 50,000 Total 0 1,000,000 0 0 0 1,000,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 1,000,000 FM# 4379711 (TIP# ) WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE *Non-SIS*Length: .000 Type of Work: AVIATION REVENUE/OPERATIONAL Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix DProject Type: Imported CAP DPTO 0 0 200,000 0 0 200,000 CAP LF 0 0 50,000 0 0 50,000 Total 0 0 250,000 0 0 250,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 250,000 FM# 4379801 (TIP# ) WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST.) *Non-SIS*Length: .000 Type of Work: AVIATION CAPACITY PROJECT Lead Agency: Responsible Agency Not LRTP#: p. 8, Appendix DProject Type: Imported CAP DPTO 160,000 0 0 0 0 160,000 CAP LF 40,000 0 0 0 0 40,000 Total 200,000 0 0 0 0 200,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 200,000 (April 1, 2016) Page 90
  • 100.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Section G - Districtwide (April 1, 2016) Page 91
  • 101.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 2337031 (TIP# ) MARTIN CO STATE HWY SYS ROADWAY *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 550,000 550,000 550,000 550,000 0 2,200,000 Total 550,000 550,000 550,000 550,000 0 2,200,000 Prior Years Cost 10,010,492 Future Years Cost 0 Total Project Cost 12,210,492 FM# 2337032 (TIP# ) MARTIN CO STATE HWY SYS BRIDGES *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 45,000 45,000 45,000 45,000 0 180,000 Total 45,000 45,000 45,000 45,000 0 180,000 Prior Years Cost 1,158,883 Future Years Cost 0 Total Project Cost 1,338,883 FM# 2339565 (TIP# ) MARTIN CO - MAINTENANCE AT MOWING & LITTER CONTRACT *Non-SIS* Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT LRTP#: p. 8, Appendix D MNT D 120,000 0 0 0 0 120,000 Total 120,000 0 0 0 0 120,000 Prior Years Cost 65,862 Future Years Cost 0 Total Project Cost 185,862 (April 1, 2016) Page 92
  • 102.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 2339567 (TIP# ) MARTIN CO-PRIMARY MOWING & LITTER CONTRACT *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix DProject Type: Imported MNT D 0 0 0 0 150,000 150,000 Total 0 0 0 0 150,000 150,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000 FM# 2342651 (TIP# ) MARTIN CO - MAINTENANCE FROM INTERSTATE TO ROADWAY *SIS* Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT LRTP#: p. 8, Appendix D MNT D 500,000 200,000 200,000 200,000 0 1,100,000 Total 500,000 200,000 200,000 200,000 0 1,100,000 Prior Years Cost 5,738,110 Future Years Cost 0 Total Project Cost 6,838,110 FM# 2342652 (TIP# ) MARTIN CO INTERSTATE BRIDGES *SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 70,000 20,000 20,000 20,000 0 130,000 Total 70,000 20,000 20,000 20,000 0 130,000 Prior Years Cost 437,461 Future Years Cost 0 Total Project Cost 567,461 (April 1, 2016) Page 93
  • 103.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4130805 (TIP# ) TREASURE COAST - MAINTENANCE FROM PAVEMENT MARKERS TO PRIMARY *Non-SIS* Type of Work: ROUTINE MAINTENANCE Lead Agency: FDOT LRTP#: p. 8, Appendix D MNT D 10,000 0 0 0 0 10,000 Total 10,000 0 0 0 0 10,000 Prior Years Cost 50,000 Future Years Cost 0 Total Project Cost 60,000 FM# 4130806 (TIP# ) PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 0 55,000 0 0 0 55,000 Total 0 55,000 0 0 0 55,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 55,000 FM# 4130807 (TIP# ) PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 0 0 0 55,000 0 55,000 Total 0 0 0 55,000 0 55,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 55,000 (April 1, 2016) Page 94
  • 104.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4241336 (TIP# ) TREASURE COAST STRIPING PRIMARY *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 0 0 150,000 0 0 150,000 Total 0 0 150,000 0 0 150,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000 FM# 4241337 (TIP# ) TREASURE COAST STRIPING PRIMARY *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix DProject Type: Imported MNT D 0 0 0 0 150,000 150,000 Total 0 0 0 0 150,000 150,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 150,000 FM# 4293105 (TIP# ) TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D ROUTINE MAINTENANCE; HERBICIDE APPLCIATION MSC D 0 0 100,000 0 0 100,000 Total 0 0 100,000 0 0 100,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 100,000 (April 1, 2016) Page 95
  • 105.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4297744 (TIP# ) TREASURE COAST PRIMARY ASPHALT REPAIR *Non-SIS*Length: .000 Type of Work: ROUTINE MAINTENANCE Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix D MNT D 0 0 0 300,000 0 300,000 Total 0 0 0 300,000 0 300,000 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 300,000 FM# 4379921 (TIP# ) RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 *SIS*Length: 20.194 Type of Work: RESURFACING Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix DProject Type: Imported PE (PENA) PKYR 1,577,000 0 0 0 0 1,577,000 CST PKYR 0 23,351,903 0 0 0 23,351,903 Total 1,577,000 23,351,903 0 0 0 24,928,903 Prior Years Cost 72,827 Future Years Cost 0 Total Project Cost 25,001,730 FM# 4379922 (TIP# ) THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 *SIS*Length: 20.194 Type of Work: SIGNING/PAVEMENT MARKINGS Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix DProject Type: Imported CST PKYR 0 0 889,980 0 0 889,980 Total 0 0 889,980 0 0 889,980 Prior Years Cost 0 Future Years Cost 0 Total Project Cost 889,980 (April 1, 2016) Page 96
  • 106.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Phase Fund Source 2016/17 2017/18 2018/19 2019/20 2020/21 Total FM# 4379923 (TIP# ) ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 *SIS*Length: 20.194 Type of Work: GUARDRAIL Lead Agency: Managed by FDOT LRTP#: p. 8, Appendix DProject Type: Imported CST PKYI 0 5,752,545 0 0 0 5,752,545 Total 0 5,752,545 0 0 0 5,752,545 Prior Years Cost 329,608 Future Years Cost 0 Total Project Cost 6,082,153 (April 1, 2016) Page 97
  • 107.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Name) FM # TIP # Project Name Page 4383431 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-609 FROM .51 MILES N. OF MINUTE MAID RD TO 3.2 MILES AT THE S CURVE . . . . . . . . . . . . . . A-39 4351391 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-707/SE BEACH ROAD FROM PALM BEACH/MARTIN CL TO CR-708/SE BRIDGE ROAD . . . . . . . A-19 4381251 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SE BRIDGE ROAD FROM SE FLORA AVE TO SE PLANDOME DRIVE . . . . . . . . . . . . . . . . . . . A-37 4330691 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-708/SW BRIDGE RD FROM SR-76/SW KANNER HWY TO SW PRATT-WHITNEY RD . . . . . . . . . . A-11 2309782 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/INDIAN ST - MARTIN DOWNS TO MAPP . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-2 4348381 . . . . . . . . . . . . . . . . . . . . . . . . . . . CR-714/SW MARTIN HWY FR. SW FOX BROWN RD TO WEST OF SR-9/I-95 . . . . . . . . . . . . . . . . . . . . A-17 4354531 . . . . . . . . . . . . . . . . . . . . . . . . . . . HIGH MEADOW AVE FROM MARTIN HWY TO SR-714/MARTIN DOWNS BVLD . . . . . . . . . . . . . . . . . . A-21 4342731 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FR PALM BEACH COUNTYLINE TO N OF CR-807/SE BRDG RD . . . . . . . . . . . . . . . . . . . . . . A-13 4342734 . . . . . . . . . . . . . . . . . . . . . . . . . . . I-95/SR-9 FROM PALM BEACH/MARTIN CO LINE TO CR-708 INTERCHANGE . . . . . . . . . . . . . . . . . . . A-14 4383471 . . . . . . . . . . . . . . . . . . . . . . . . . . . INDIAN STREET FROM DIXIE HIGHWAY TO ST. LUCIE BLVD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-44 4367351 . . . . . . . . . . . . . . . . . . . . . . . . . . . JONATHAN DICKINSON STATE PARK-FLAP GRANT FOR TRAIL & US-1 SIGNALIZTION . . . . . . . . . . A-26 4354131 . . . . . . . . . . . . . . . . . . . . . . . . . . . MAPP RD. FROM SW MARTIN DOWNS BLVD TO SW MARTIN HIGHWAY . . . . . . . . . . . . . . . . . . . . . . A-20 4331591 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN AIRPORT MASTER & ECONOMIC DEVELOP PLAN UPDATE . . . . . . . . . . . . . . . . . . . . . . . . . C-4 2339565 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 2342651 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 2342652 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO INTERSTATE BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 2337032 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS BRIDGES . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 2337031 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO STATE HWY SYS ROADWAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-2 4134931 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT CAPITAL - 5307 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-3 4071892 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO TRANSIT OPERATING - STATE GRANT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2 2339567 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN CO-PRIMARY MOWING & LITTER CONTRACT . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-3 4071893 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY BLOCK GRANT OPERATING ASSISTANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-2 4278033 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY JPA SIGNAL MAINTENANCE & OPS ON SHS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-5 (April 1, 2016) Page 98
  • 108.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Name) FM # TIP # Project Name Page 4346611 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5339, CAPITAL FOR BUS & BUS FACILITIES . . . . . . . . . . . . . . . . . . . . . .. . B-5 4259773 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SECTION 5311, OPERATING RURAL FUNDS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4 4385241 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT STUART- TRAM PURCHASE ... . . . . . . . . . . . . . . . . . . . . B-6 4385221 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY SERVICE DEVELOPMENT- STUART TRAM IMPROVEMENTS ... . . . . . . . . . . . . . . . B-6 4346601 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT CORRIDOR TREASURE COAST EXPRESS . . . . . . . . . . . . . . . . . . . . . . . B-5 4259772 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY TRANSIT OPERATING - 5311 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-4 4278304 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN COUNTY UPWP FY 2020/2021 - 2021/2022 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-8 4278302 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO PL FY 16/17 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-6 4137332 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN MPO TRANSIT PLANNING - 5303 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . B-5 4278303 . . . . . . . . . . . . . . . . . . . . . . . . . . . MARTIN UPWP FY 18-19/19-20 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-7 4383461 . . . . . . . . . . . . . . . . . . . . . . . . . . . MONTEREY ROAD FROM KINGSWOOD TERRACE TO ST. LUCIE BLVD . . . . . . . . . . . . . . . . . . . . . . . A-43 4364251 . . . . . . . . . . . . . . . . . . . . . . . . . . . MURPHY ROAD BRIDGE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-25 4130806 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4 4130807 . . . . . . . . . . . . . . . . . . . . . . . . . . . PRIMARY RETRO-REFLECTIVE PAVEMENT MARKERS (RPM'S) . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-4 4379921 . . . . . . . . . . . . . . . . . . . . . . . . . . . RESURFACE TPK MAINLINE IN MARTIN CNTY, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . . . . . . . . G-6 4379923 . . . . . . . . . . . . . . . . . . . . . . . . . . . ROADSIDE IMPROVEMENTS IN MARTIN CNTY, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . . . . . . . G-6 4349761 . . . . . . . . . . . . . . . . . . . . . . . . . . . S.E. SEABRANCH BLVD. FROM S.E. RETREAT DR. TO SR-5/US-1 . . . . . . . . . . . . . . . . . . . . . . . . . . . A-18 4383421 . . . . . . . . . . . . . . . . . . . . . . . . . . . SAVANNAH ROAD FROM NE CARDINAL AVENUE TO JENSEN BEACH BOULEVARD . . . . . . . . . . . . A-38 4368511 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE COVE ROAD FROM SR-76/SW KANNER HWY TO US-1/SR-5 . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-27 4380721 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE DIXIE HWY/CR-A1A FR SE JEFFERSON ST TO SE INDIAN ST . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-36 4380711 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE INDIAN ST FR US-1/FEDERAL HWY TO S OF RAILROAD CROSSING . . . . . . . . . . . . . . . . . . . . . . A-35 4368611 . . . . . . . . . . . . . . . . . . . . . . . . . . . SE KINDRED STREET/SE JOHNSON AVE FROM SOUTH COLORADO TO SR-5/US-1 . . . . . . . . . . . . A-28 4360961 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 FROM NORTH OF SALERNO RD. TO NORTH OF CENTRAL PARKWAY . . . . . . . . . . . . . . A-22 4369671 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-31 4385661 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 NORTH OF NW BRITT ROAD - RESERVE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-46 4383451 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 ROOSEVELT BRIDGE RESTRIPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-41 (April 1, 2016) Page 99
  • 109.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Name) FM # TIP # Project Name Page 4383452 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-5/US-1 SB LEFT TURN LANE ONTO JOAN JEFFERSON WAY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-42 4327051 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/BEELINE HWY FROM E. OF SR-76 TO PALM BEACH/MARTIN CL . . . . . . . . . . . . . . . . . . . . . . A-10 4192522 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-710/WARFIELD BLVD FROM MARTIN POWER PLANT TO CR609/SW ALLAPATTAH RD . . . . . . . A-3 4383441 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLV TO SW MARTIN DOWNS BLV - RESERVE . . . . . . . . . A-40 4368701 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-714/SW MARTIN HWY FROM CITRUS BLVD. TO SW MARTIN DOWNS BLVD. . . . . . . . . . . . . . . . A-30 4323481 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-732/JENSEN BCH BL FROM SR-5/US-1 TO SAVANAH RD. . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-9 4342751 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76 KANNER HIGHWAY PORT MAYACA AREA . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-15 4226413 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-76/KANNER HWY - from LOST RIVER ROAD to MONTEREY RD. . . . . . . . . . . . . . . . . . . . . . . . . . . A-4 4347331 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 @ SR-714 INTERCHANGE - LANDSCAPING . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-16 4377011 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 FROM S OF REST AREA TO S OF SR-714/MARTIN HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . A-32 4380401 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-9/I-95 INTERCHANGE WITH SR-76/KANNER HWY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-34 4333491 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A AT SEWALL'S POINT ROAD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-12 4368691 . . . . . . . . . . . . . . . . . . . . . . . . . . . SR-A1A FROM EAST OF LYONS BRIDGE TO SR-732/JENSEN BEACH BLVD. . . . . . . . . . . . . . . . . . . . A-29 4383481 . . . . . . . . . . . . . . . . . . . . . . . . . . . ST. LUCIE BLVD FROM INDIAN ST TO E. OCEAN BLVD . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . A-45 4363771 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MAPP RD.FROM SR-714/SW MARTIN DOWNS BLVD TO SW BRIDGEWAY ST. . . . . . . . . . . . . . . A-23 4363781 . . . . . . . . . . . . . . . . . . . . . . . . . . . SW MURPHY RD. FROM SW MAPP RD/SW MATHESON AVE TO MARTIN/ST. LUCIE CL . . . . . . . . . A-24 4379922 . . . . . . . . . . . . . . . . . . . . . . . . . . . THERMOPLASTIC FOR MARTIN CNTY RESURFACING, MP 117.843 - 138.037 . . . . . . . . . . . . . . . . . . . G-6 4130805 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST - MAINTENANCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-8 4293105 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST HERBICIDE APPLICATION PRIMARY ROADS . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 4297744 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST PRIMARY ASPHALT REPAIR . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-6 4241336 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 (April 1, 2016) Page 100
  • 110.
    Martin MPO TransportationImprovement Program - FY 2016/17 - 2020/21 Project Index (by Name) FM # TIP # Project Name Page 4241337 . . . . . . . . . . . . . . . . . . . . . . . . . . . TREASURE COAST STRIPING PRIMARY . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . G-5 4378381 . . . . . . . . . . . . . . . . . . . . . . . . . . . US-1/SR-5 FROM SOUTHEAST HERITAGE BLVD. TO NORTH OF SALERNO RD. . . . . . . . . . . . . . . . . A-33 4310351 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-2 4315151 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD - TAXIWAY D . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-3 4346241 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD CONSTRUCT AIRPORT INTERCONNECT RD.(PHASE 2) . . . . . . . . . . . . . . . . . . . . . . C-6 4346371 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-7 4346201 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD MILL & RESURFACE TAXIWAY A, (PHASE 1 DESIGN) . . . . . . . . . . . . . . . . . . . . . . . . C-5 4364011 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD REHAB OF MC NON-MOVEMENT AREAS PHASE III (DESIGN & CST) . . . . . . . . . . . . C-9 4364001 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RUNWAY PROTECTION ZONE CLEARING AND IMPROVEMENTS . . . . . . . . . . . . . . C-8 4379801 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD RWY 25 BLAST PAD AND TWY A HOLDING BAY (DESIGN & CST.) . . . . . . . . . . . . . . C-13 4379711 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT ADMIN AREA BUILDING REMOVAL & SITE PREPARATION . . . . . . . . . . . C-12 4379631 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, AIRPORT SECURITY FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-10 4379641 . . . . . . . . . . . . . . . . . . . . . . . . . . . WITHAM FIELD, WILDLIFE FENCE . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . . C-11 (April 1, 2016) Page 101
