Schedule  Analysis of performance Complete and Deadline Met.  Incomplete and Deadline Not Met.  Key

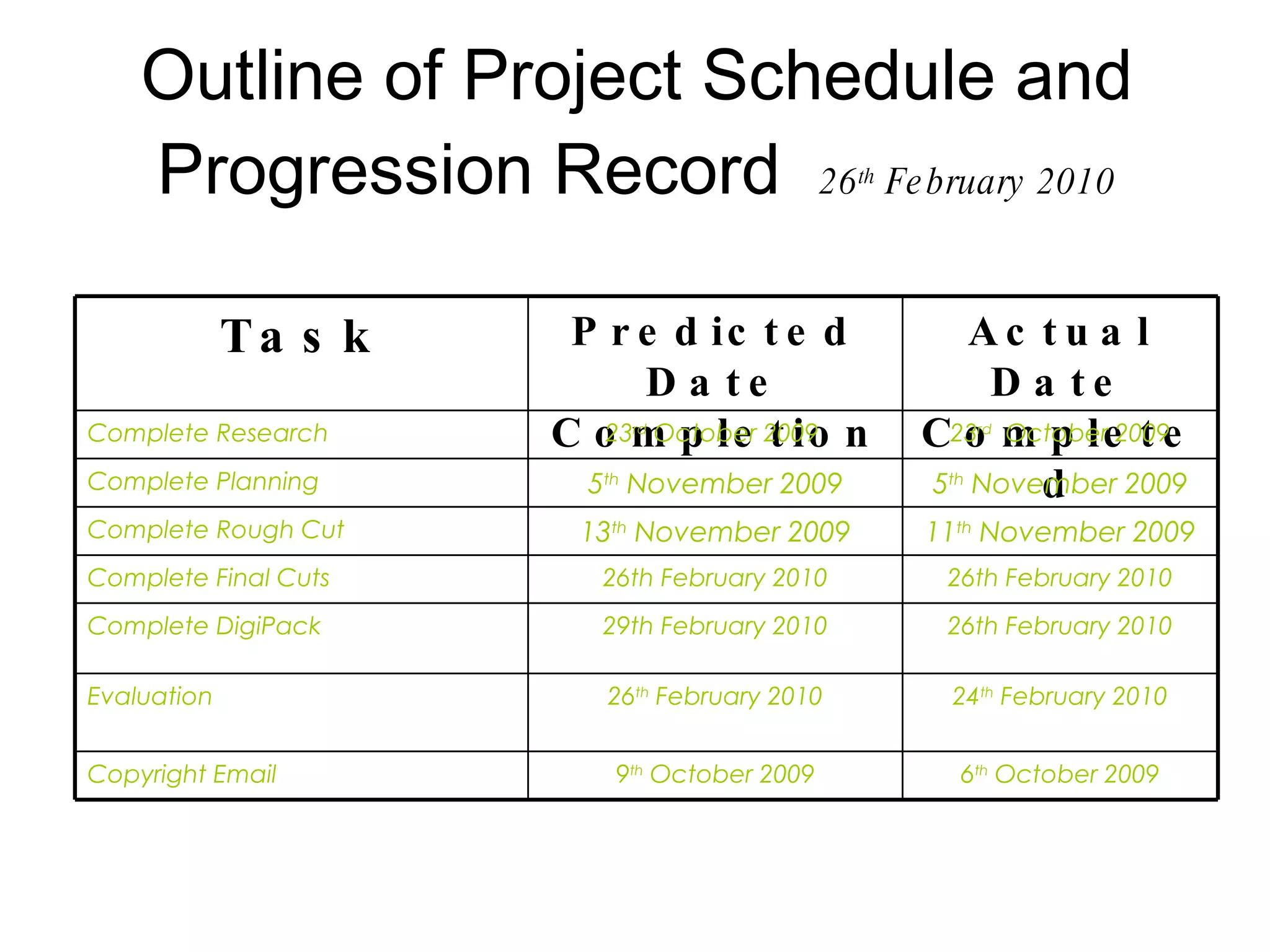

Outline of Project Schedule and Progression Record  26 th  February 2010   Task Predicted Date Completion Actual Date Completed Complete Research 23 rd  October 2009  23 rd   October 2009 Complete Planning 5 th  November 2009 5 th  November 2009 Complete Rough Cut 13 th  November 2009 11 th  November 2009 Complete Final Cuts 26th February 2010 26th February 2010 Complete DigiPack  29th February 2010 26th February 2010 Evaluation  26 th  February 2010 24 th  February 2010 Copyright Email  9 th  October 2009 6 th  October 2009

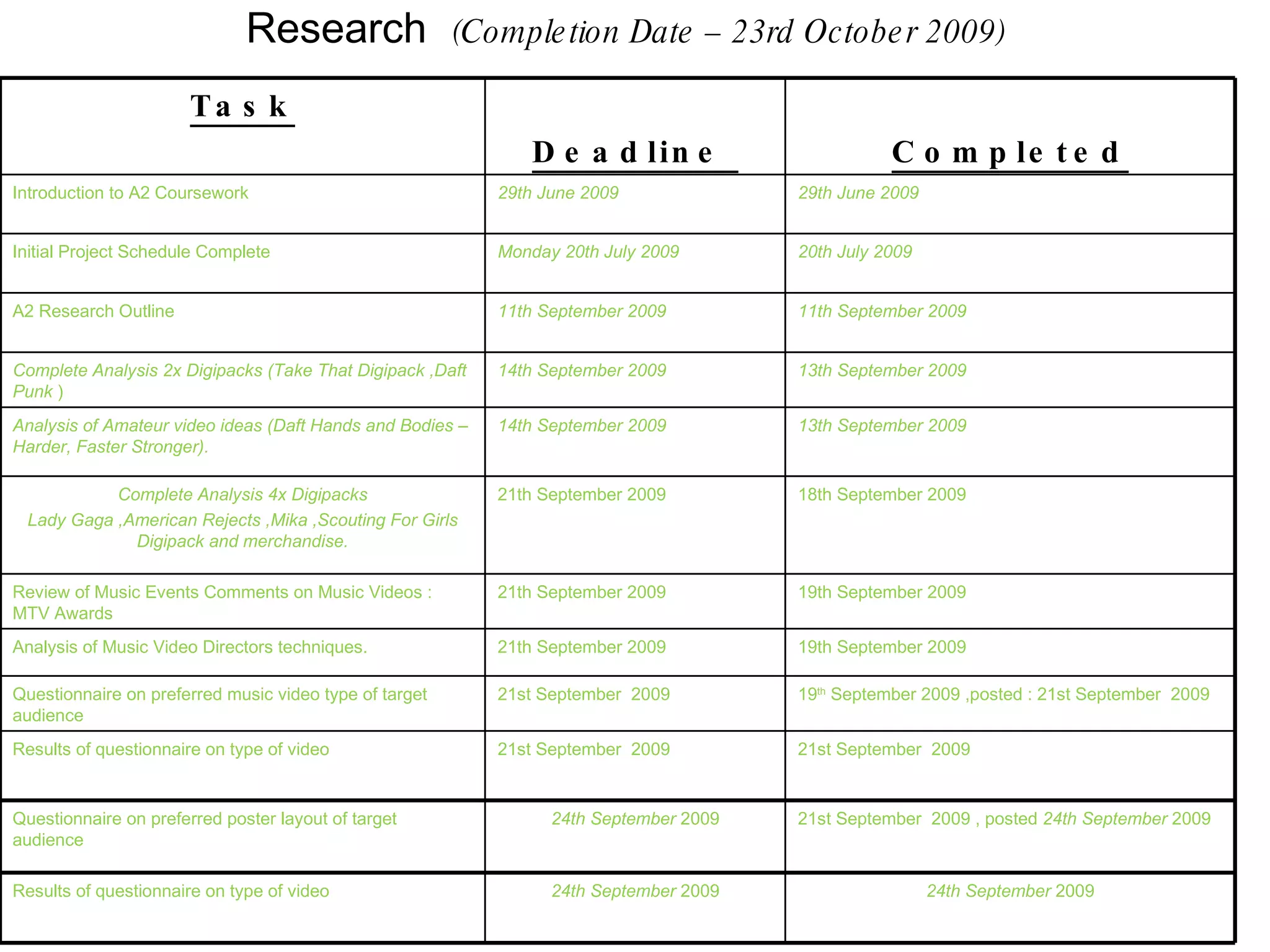

Research  (Completion Date – 23rd October 2009) Task Deadline  Completed Introduction to A2 Coursework  29th June 2009   29th June 2009 Initial Project Schedule Complete  Monday 20th July 2009   20th July 2009   A2 Research Outline  11th September 2009   11th September 2009   Complete Analysis 2x Digipacks (Take That Digipack ,Daft Punk  ) 14th September 2009   13th September 2009   Analysis of Amateur video ideas (Daft Hands and Bodies –Harder, Faster Stronger).   14th September 2009   13th September 2009   Complete Analysis 4x Digipacks Lady Gaga ,American Rejects ,Mika ,Scouting For Girls Digipack and merchandise. 21th September 2009 18th September 2009  Review of Music Events Comments on Music Videos : MTV Awards 21th September 2009 19th September 2009  Analysis of Music Video Directors techniques. 21th September 2009 19th September 2009  Questionnaire on preferred music video type of target audience  21st September  2009  19 th  September 2009 ,posted : 21st September  2009  Results of questionnaire on type of video 21st September  2009  21st September  2009  Questionnaire on preferred poster layout of target audience  24th September  2009 21st September  2009 , posted  24th September  2009 Results of questionnaire on type of video 24th September  2009 24th September  2009

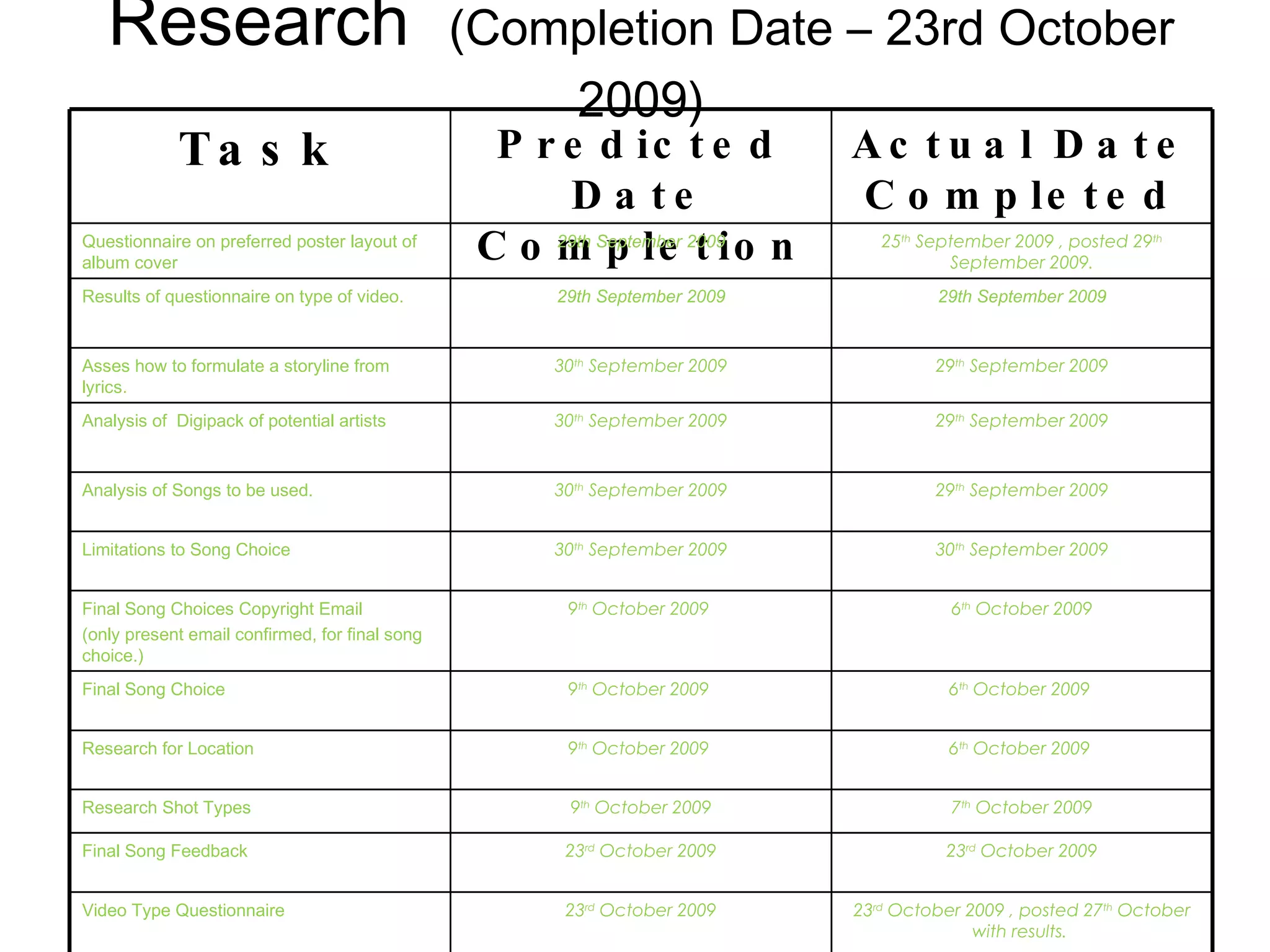

Research  (Completion Date – 23rd October 2009) Task Predicted Date Completion Actual Date Completed Questionnaire on preferred poster layout of album cover  29th September 2009 25 th  September 2009 , posted 29 th  September 2009. Results of questionnaire on type of video. 29th September 2009 29th September 2009 Asses how to formulate a storyline from lyrics.   30 th  September 2009 29 th  September 2009 Analysis of  Digipack of potential artists  30 th  September 2009 29 th  September 2009 Analysis of Songs to be used.  30 th  September 2009 29 th  September 2009 Limitations to Song Choice  30 th  September 2009 30 th  September 2009 Final Song Choices Copyright Email (only present email confirmed, for final song choice.)  9 th  October 2009  6 th  October 2009 Final Song Choice  9 th  October 2009  6 th  October 2009  Research for Location 9 th  October 2009  6 th  October 2009  Research Shot Types  9 th  October 2009 7 th  October 2009 Final Song Feedback  23 rd  October 2009 23 rd  October 2009 Video Type Questionnaire  23 rd  October 2009 23 rd  October 2009 , posted 27 th  October with results.

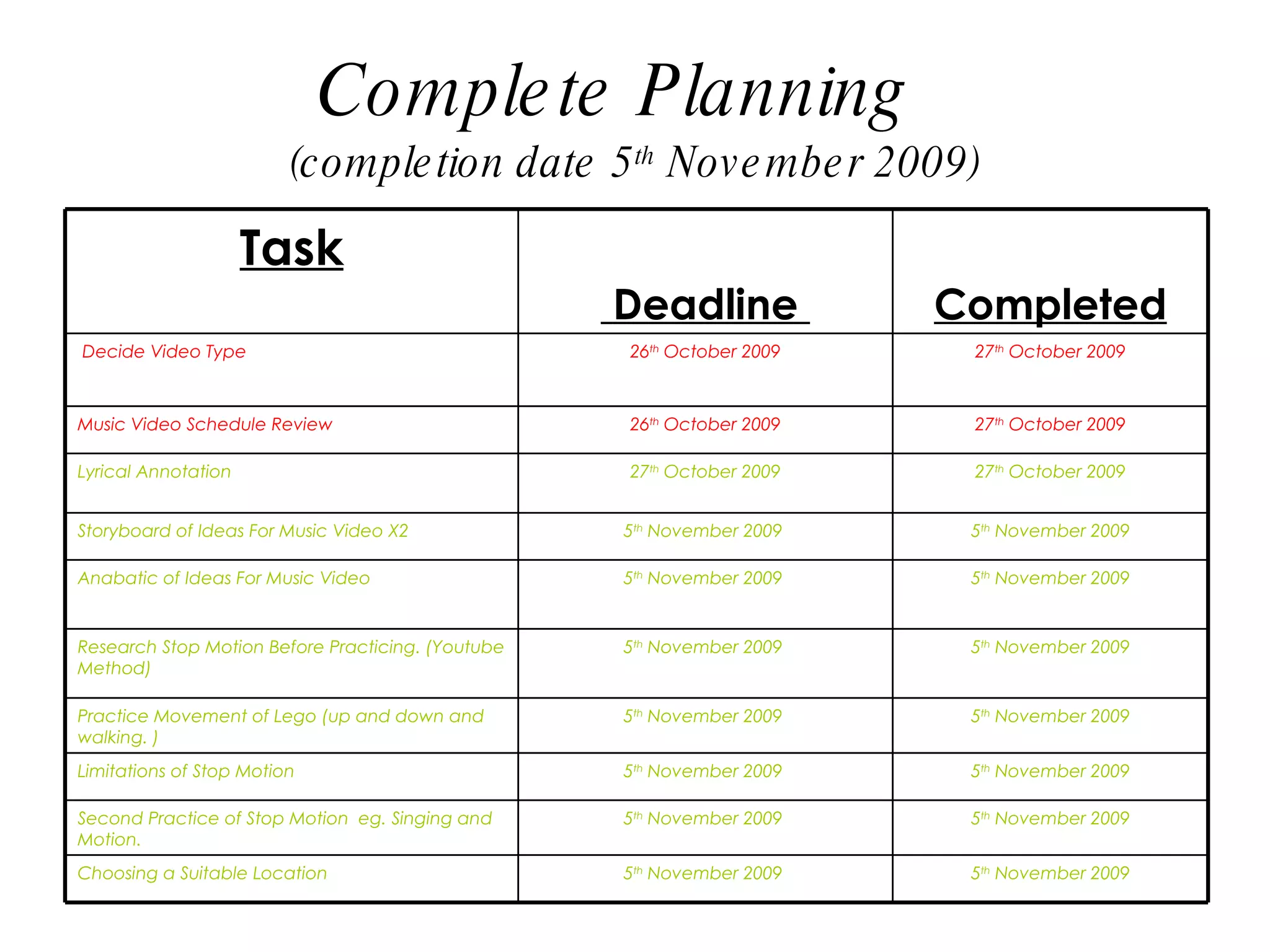

Complete Planning (completion date 5 th  November 2009) Task Deadline  Completed Decide Video Type 26 th  October 2009 27 th  October 2009 Music Video Schedule Review  26 th  October 2009 27 th  October 2009 Lyrical Annotation  27 th  October 2009 27 th  October 2009 Storyboard of Ideas For Music Video X2 5 th  November 2009  5 th  November 2009 Anabatic of Ideas For Music Video 5 th  November 2009  5 th  November 2009 Research Stop Motion Before Practicing. (Youtube Method)  5 th  November 2009  5 th  November 2009 Practice Movement of Lego (up and down and walking. ) 5 th  November 2009  5 th  November 2009 Limitations of Stop Motion  5 th  November 2009  5 th  November 2009 Second Practice of Stop Motion  eg. Singing and Motion.  5 th  November 2009  5 th  November 2009 Choosing a Suitable Location  5 th  November 2009  5 th  November 2009

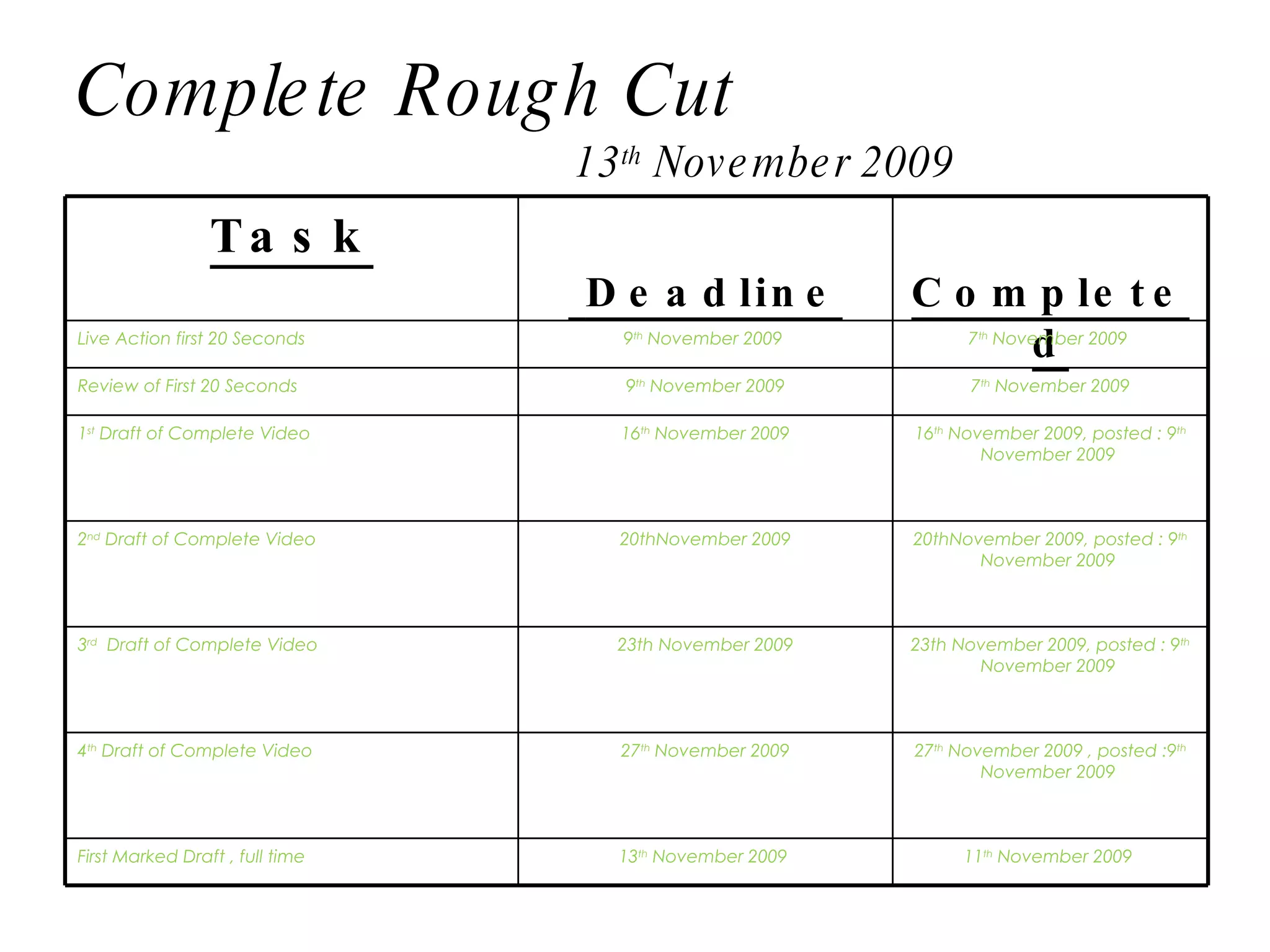

Complete Rough Cut   13 th  November 2009 Task Deadline Completed Live Action first 20 Seconds  9 th  November 2009  7 th  November 2009  Review of First 20 Seconds  9 th  November 2009 7 th  November 2009 1 st  Draft of Complete Video  16 th  November 2009 16 th  November 2009, posted : 9 th  November 2009  2 nd  Draft of Complete Video 20thNovember 2009 20thNovember 2009, posted : 9 th  November 2009  3 rd   Draft of Complete Video 23th November 2009 23th November 2009, posted : 9 th  November 2009  4 th  Draft of Complete Video 27 th  November 2009 27 th  November 2009 , posted :9 th  November 2009  First Marked Draft , full time  13 th  November 2009  11 th  November 2009

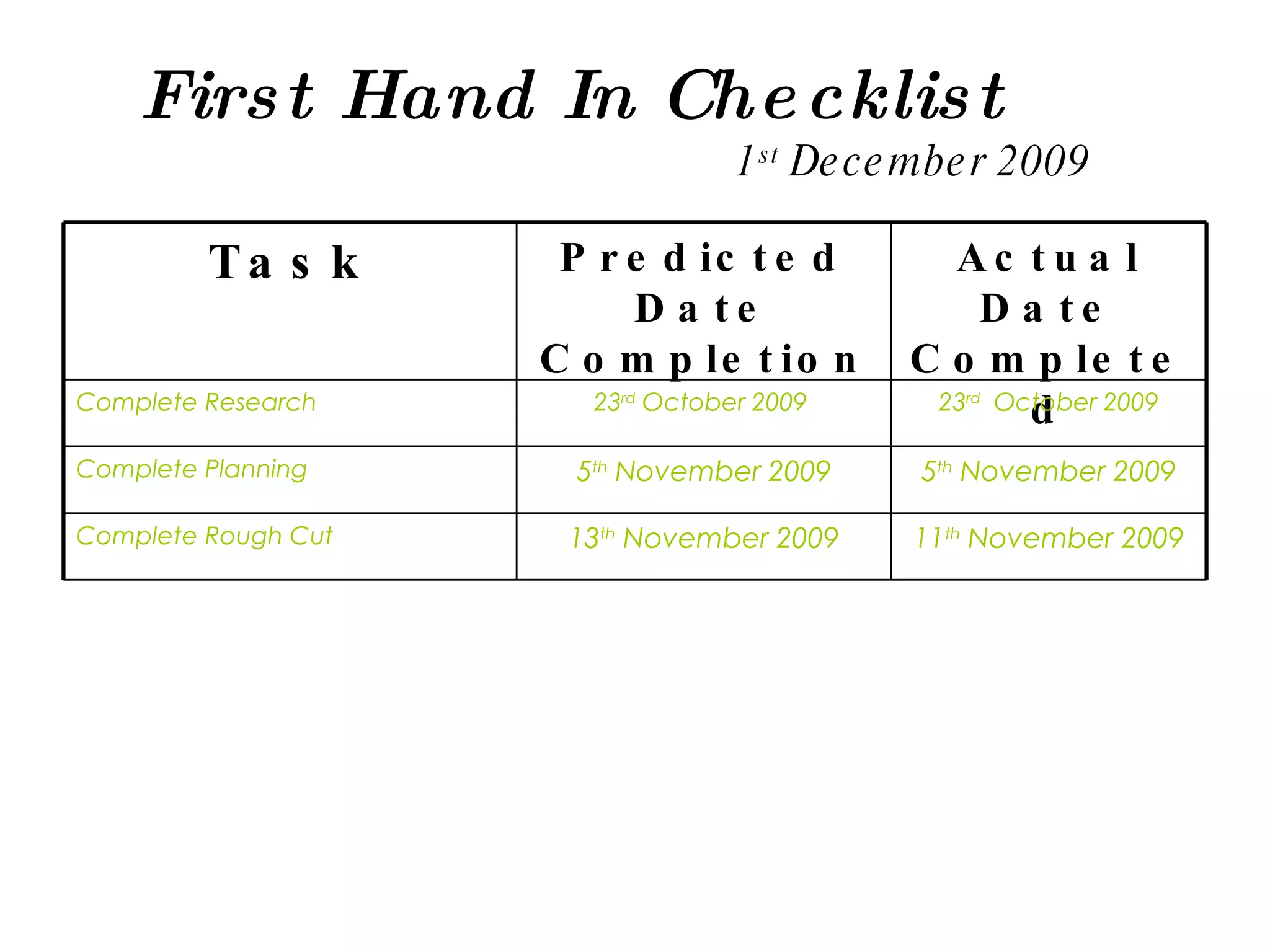

First Hand In Checklist   1 st  December 2009 Task Predicted Date Completion Actual Date Completed Complete Research 23 rd  October 2009  23 rd   October 2009 Complete Planning 5 th  November 2009 5 th  November 2009 Complete Rough Cut 13 th  November 2009 11 th  November 2009

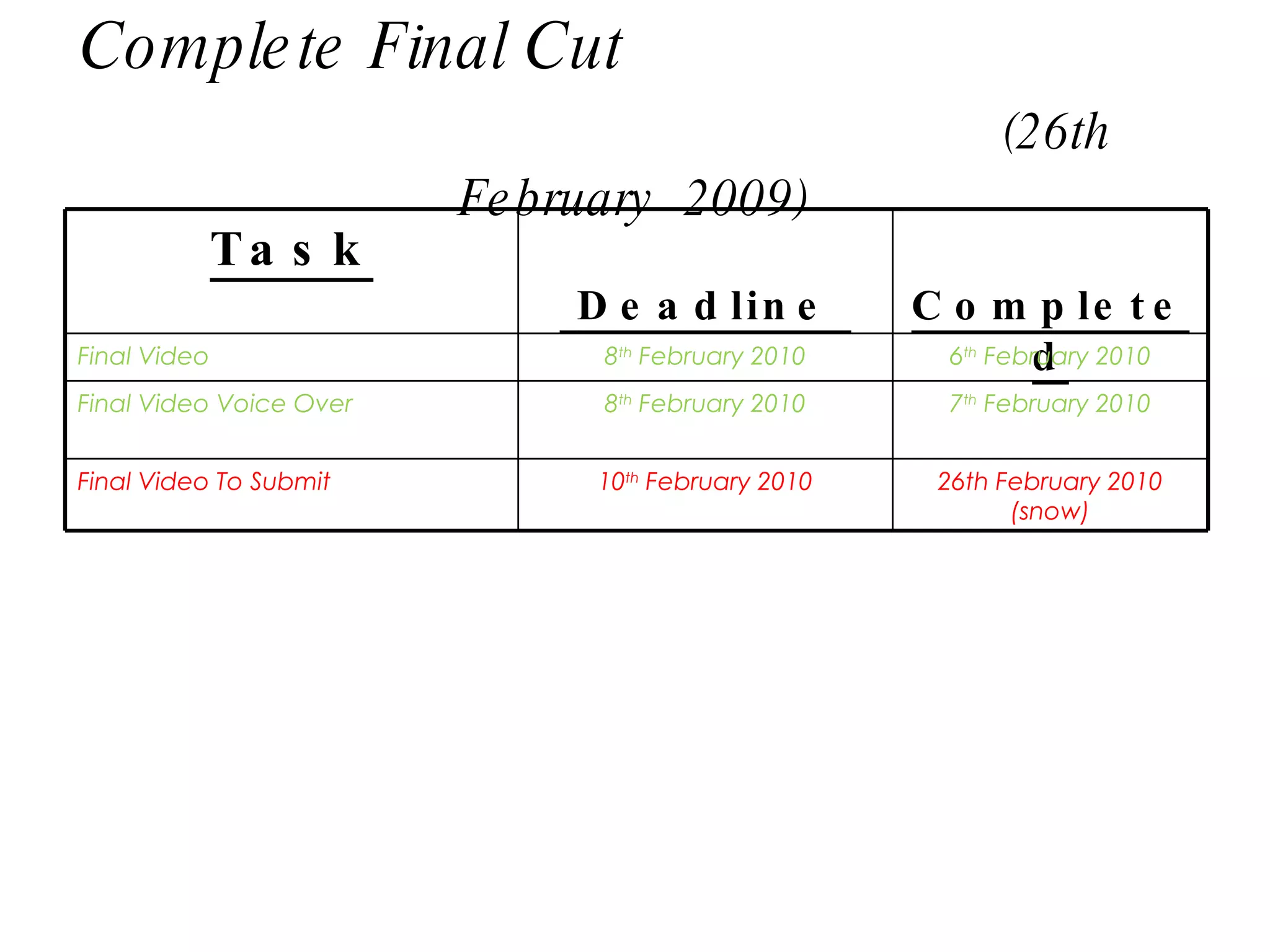

Complete Final Cut   (26th February  2009) Task Deadline  Completed Final Video  8 th  February 2010 6 th  February 2010 Final Video Voice Over  8 th  February 2010 7 th  February 2010 Final Video To Submit  10 th  February 2010 26th February 2010 (snow)

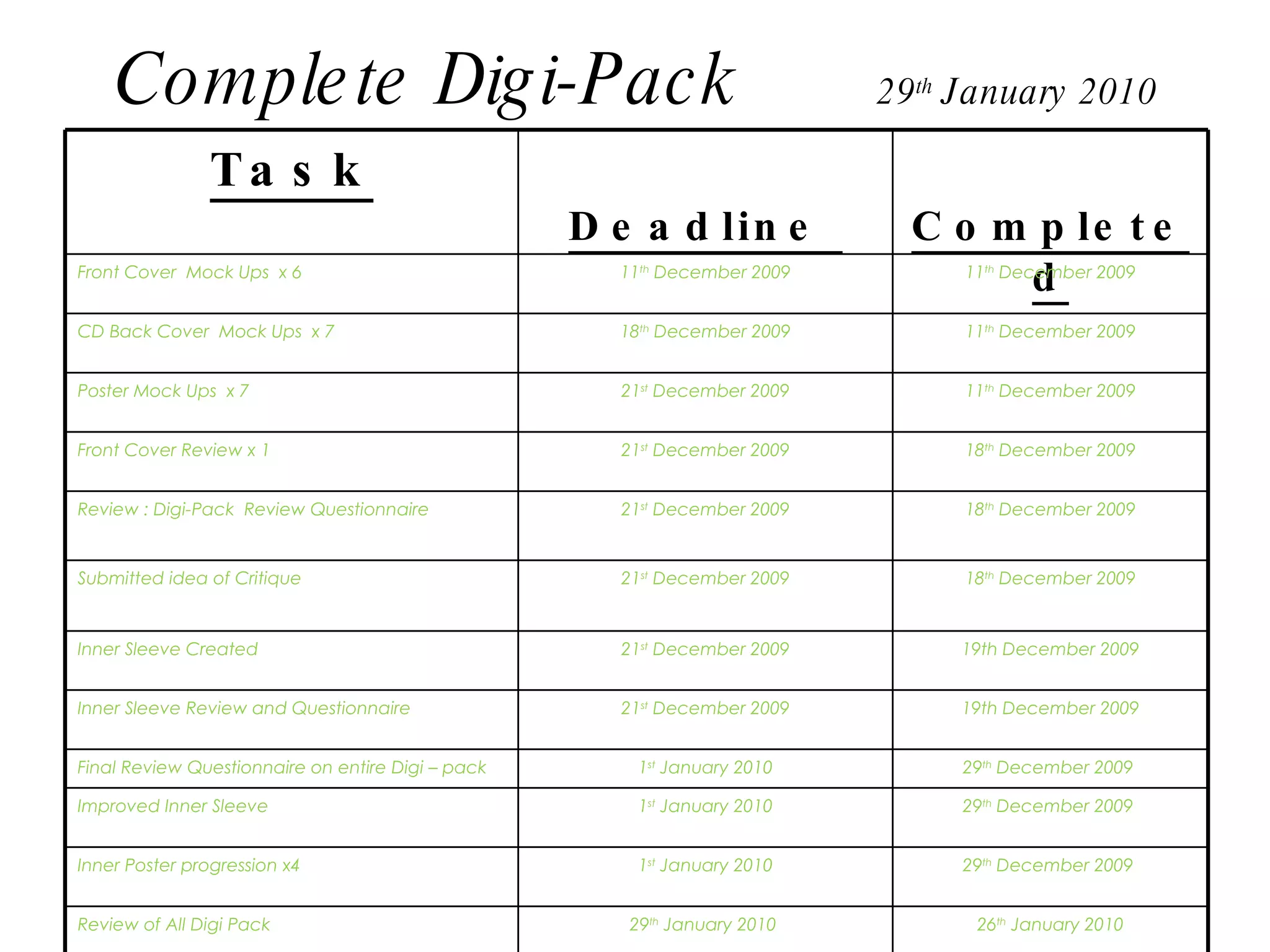

Complete Digi-Pack  29 th  January 2010 Task Deadline  Completed Front Cover  Mock Ups  x 6 11 th  December 2009 11 th  December 2009 CD Back Cover  Mock Ups  x 7 18 th  December 2009 11 th  December 2009 Poster Mock Ups  x 7 21 st  December 2009 11 th  December 2009 Front Cover Review x 1  21 st  December 2009 18 th  December 2009 Review : Digi-Pack  Review Questionnaire  21 st  December 2009 18 th  December 2009 Submitted idea of Critique  21 st  December 2009 18 th  December 2009 Inner Sleeve Created  21 st  December 2009 19th December 2009 Inner Sleeve Review and Questionnaire 21 st  December 2009 19th December 2009 Final Review Questionnaire on entire Digi – pack  1 st  January 2010 29 th  December 2009  Improved Inner Sleeve  1 st  January 2010 29 th  December 2009  Inner Poster progression x4  1 st  January 2010 29 th  December 2009  Review of All Digi Pack  29 th  January 2010  26 th  January 2010

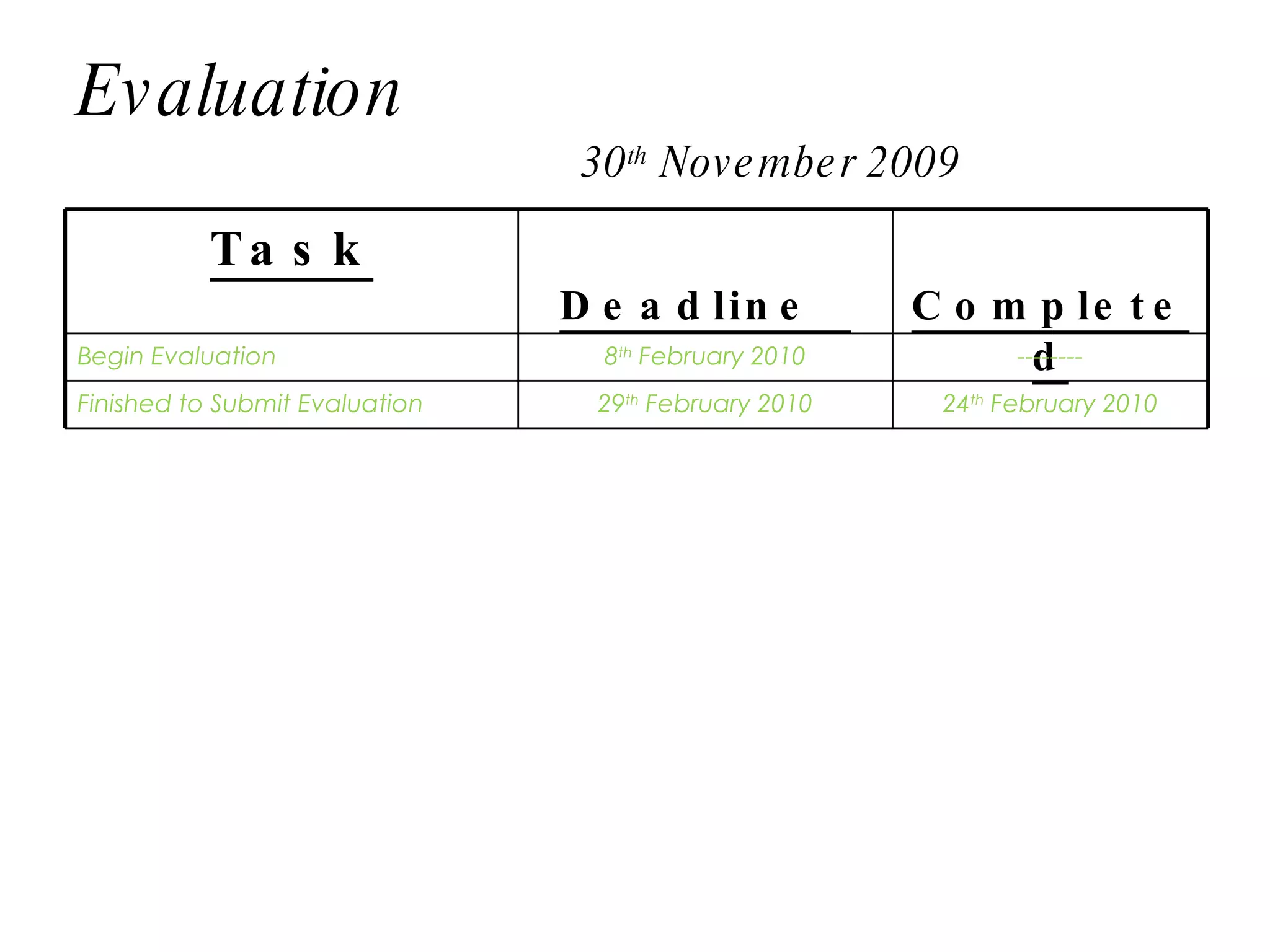

Evaluation     30 th  November 2009 Task Deadline  Completed Begin Evaluation  8 th  February 2010 -------- Finished to Submit Evaluation  29 th  February 2010 24 th  February 2010

Final Deadline Checklist Moderation  Task Predicted Date Completion Actual Date Completed Complete Research 23 rd  October 2009  23 rd   October 2009 Copyright Email  9 th  October 2009 6 th  October 2009 Complete Planning 5 th  November 2009 5 th  November 2009 Complete Rough Cut 13 th  November 2009 11 th  November 2009 Complete Final Cuts 10th February 2010 26th February 2010 (snow) Complete Digi Pack  29th February 2010 26th February 2010 Evaluation  26 th  February 2010 24 th  February 2010

Final Schedule Of A2 Project

  • 1.
    Schedule Analysisof performance Complete and Deadline Met. Incomplete and Deadline Not Met. Key
  • 2.
    Outline of ProjectSchedule and Progression Record 26 th February 2010 Task Predicted Date Completion Actual Date Completed Complete Research 23 rd October 2009 23 rd October 2009 Complete Planning 5 th November 2009 5 th November 2009 Complete Rough Cut 13 th November 2009 11 th November 2009 Complete Final Cuts 26th February 2010 26th February 2010 Complete DigiPack 29th February 2010 26th February 2010 Evaluation 26 th February 2010 24 th February 2010 Copyright Email 9 th October 2009 6 th October 2009
  • 3.
    Research (CompletionDate – 23rd October 2009) Task Deadline Completed Introduction to A2 Coursework 29th June 2009 29th June 2009 Initial Project Schedule Complete Monday 20th July 2009 20th July 2009 A2 Research Outline 11th September 2009 11th September 2009 Complete Analysis 2x Digipacks (Take That Digipack ,Daft Punk ) 14th September 2009 13th September 2009 Analysis of Amateur video ideas (Daft Hands and Bodies –Harder, Faster Stronger). 14th September 2009 13th September 2009 Complete Analysis 4x Digipacks Lady Gaga ,American Rejects ,Mika ,Scouting For Girls Digipack and merchandise. 21th September 2009 18th September 2009 Review of Music Events Comments on Music Videos : MTV Awards 21th September 2009 19th September 2009 Analysis of Music Video Directors techniques. 21th September 2009 19th September 2009 Questionnaire on preferred music video type of target audience 21st September 2009 19 th September 2009 ,posted : 21st September 2009 Results of questionnaire on type of video 21st September 2009 21st September 2009 Questionnaire on preferred poster layout of target audience 24th September 2009 21st September 2009 , posted 24th September 2009 Results of questionnaire on type of video 24th September 2009 24th September 2009
  • 4.
    Research (CompletionDate – 23rd October 2009) Task Predicted Date Completion Actual Date Completed Questionnaire on preferred poster layout of album cover 29th September 2009 25 th September 2009 , posted 29 th September 2009. Results of questionnaire on type of video. 29th September 2009 29th September 2009 Asses how to formulate a storyline from lyrics. 30 th September 2009 29 th September 2009 Analysis of Digipack of potential artists 30 th September 2009 29 th September 2009 Analysis of Songs to be used. 30 th September 2009 29 th September 2009 Limitations to Song Choice 30 th September 2009 30 th September 2009 Final Song Choices Copyright Email (only present email confirmed, for final song choice.) 9 th October 2009 6 th October 2009 Final Song Choice 9 th October 2009 6 th October 2009 Research for Location 9 th October 2009 6 th October 2009 Research Shot Types 9 th October 2009 7 th October 2009 Final Song Feedback 23 rd October 2009 23 rd October 2009 Video Type Questionnaire 23 rd October 2009 23 rd October 2009 , posted 27 th October with results.
  • 5.
    Complete Planning (completiondate 5 th November 2009) Task Deadline Completed Decide Video Type 26 th October 2009 27 th October 2009 Music Video Schedule Review 26 th October 2009 27 th October 2009 Lyrical Annotation 27 th October 2009 27 th October 2009 Storyboard of Ideas For Music Video X2 5 th November 2009 5 th November 2009 Anabatic of Ideas For Music Video 5 th November 2009 5 th November 2009 Research Stop Motion Before Practicing. (Youtube Method) 5 th November 2009 5 th November 2009 Practice Movement of Lego (up and down and walking. ) 5 th November 2009 5 th November 2009 Limitations of Stop Motion 5 th November 2009 5 th November 2009 Second Practice of Stop Motion eg. Singing and Motion. 5 th November 2009 5 th November 2009 Choosing a Suitable Location 5 th November 2009 5 th November 2009
  • 6.
    Complete Rough Cut 13 th November 2009 Task Deadline Completed Live Action first 20 Seconds 9 th November 2009 7 th November 2009 Review of First 20 Seconds 9 th November 2009 7 th November 2009 1 st Draft of Complete Video 16 th November 2009 16 th November 2009, posted : 9 th November 2009 2 nd Draft of Complete Video 20thNovember 2009 20thNovember 2009, posted : 9 th November 2009 3 rd Draft of Complete Video 23th November 2009 23th November 2009, posted : 9 th November 2009 4 th Draft of Complete Video 27 th November 2009 27 th November 2009 , posted :9 th November 2009 First Marked Draft , full time 13 th November 2009 11 th November 2009
  • 7.
    First Hand InChecklist 1 st December 2009 Task Predicted Date Completion Actual Date Completed Complete Research 23 rd October 2009 23 rd October 2009 Complete Planning 5 th November 2009 5 th November 2009 Complete Rough Cut 13 th November 2009 11 th November 2009
  • 8.
    Complete Final Cut (26th February 2009) Task Deadline Completed Final Video 8 th February 2010 6 th February 2010 Final Video Voice Over 8 th February 2010 7 th February 2010 Final Video To Submit 10 th February 2010 26th February 2010 (snow)
  • 9.
    Complete Digi-Pack 29 th January 2010 Task Deadline Completed Front Cover Mock Ups x 6 11 th December 2009 11 th December 2009 CD Back Cover Mock Ups x 7 18 th December 2009 11 th December 2009 Poster Mock Ups x 7 21 st December 2009 11 th December 2009 Front Cover Review x 1 21 st December 2009 18 th December 2009 Review : Digi-Pack Review Questionnaire 21 st December 2009 18 th December 2009 Submitted idea of Critique 21 st December 2009 18 th December 2009 Inner Sleeve Created 21 st December 2009 19th December 2009 Inner Sleeve Review and Questionnaire 21 st December 2009 19th December 2009 Final Review Questionnaire on entire Digi – pack 1 st January 2010 29 th December 2009 Improved Inner Sleeve 1 st January 2010 29 th December 2009 Inner Poster progression x4 1 st January 2010 29 th December 2009 Review of All Digi Pack 29 th January 2010 26 th January 2010
  • 10.
    Evaluation 30 th November 2009 Task Deadline Completed Begin Evaluation 8 th February 2010 -------- Finished to Submit Evaluation 29 th February 2010 24 th February 2010
  • 11.
    Final Deadline ChecklistModeration Task Predicted Date Completion Actual Date Completed Complete Research 23 rd October 2009 23 rd October 2009 Copyright Email 9 th October 2009 6 th October 2009 Complete Planning 5 th November 2009 5 th November 2009 Complete Rough Cut 13 th November 2009 11 th November 2009 Complete Final Cuts 10th February 2010 26th February 2010 (snow) Complete Digi Pack 29th February 2010 26th February 2010 Evaluation 26 th February 2010 24 th February 2010
