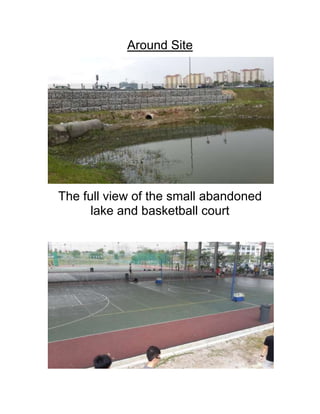

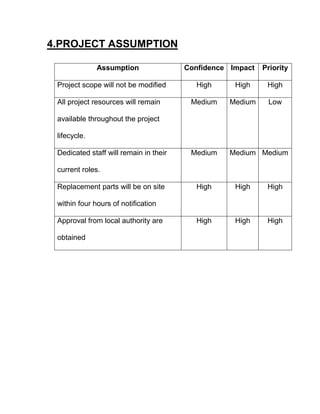

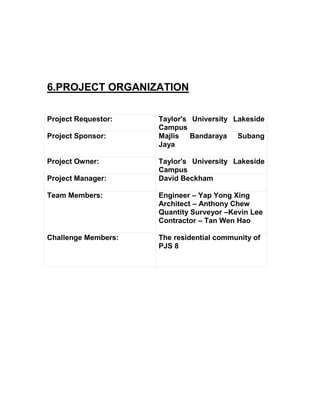

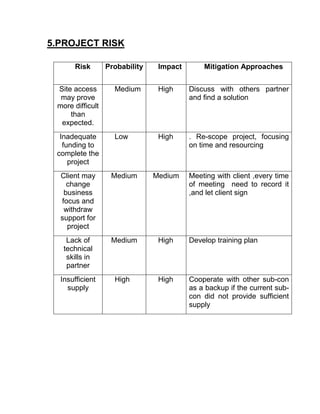

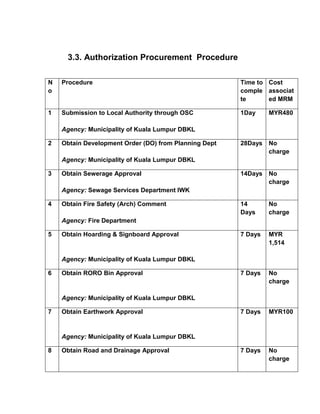

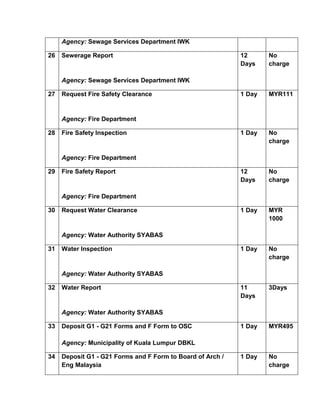

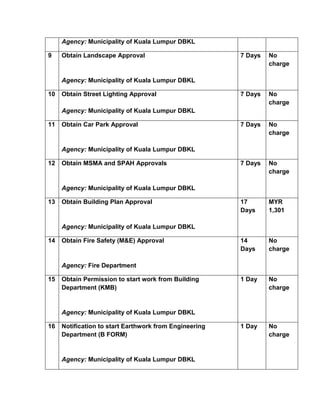

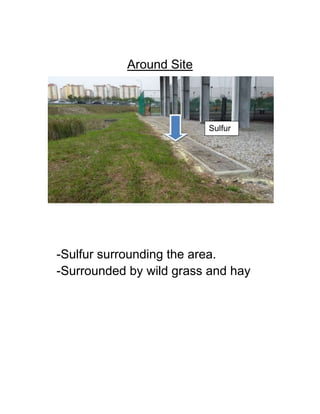

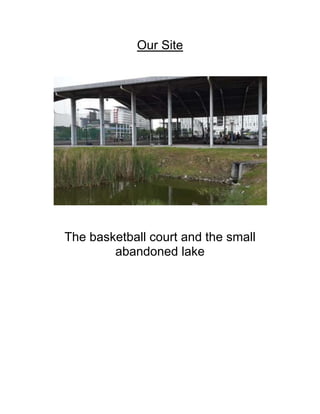

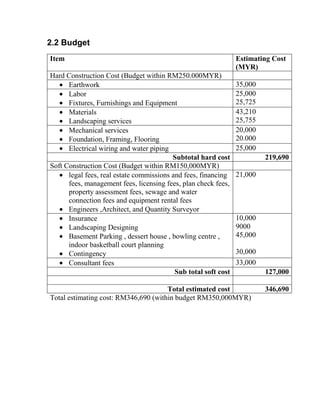

The document outlines a proposal for a new recreational facility to be built on the grounds of Taylor's University Lakeside Campus, utilizing the space of an existing abandoned lake and basketball court. The proposed 3-floor building would include a basement parking area, indoor bowling alley, dessert cafe, and upgraded basketball court, providing additional amenities and activities for students. A project plan, budget, timeline, risks, and team are defined to transform the space and achieve the goals of creating a safe, attractive gathering place for the university community.
