Crosstown Parkway Extension:
Innovations Through Design-Build
APWA Florida Chapter
2016 Public Works Expo
April 19, 2016
Presenters
» Frank Knott, City of Port St. Lucie Public Works, Project Manager
» Rachel Back, PE, CFM, RS&H, Inc., Design Project Manager
» Stephen Park, PE, RS&H, Inc., Roadway Engineer of Record
Technical Session Outline
1. Project History/Overview – Frank Knott
2. Design-Build Process – Rachel Back
3. Archer Western/RS&H Team Approach
1. Overview
2. Alternative Technical Concepts (ATCs) and Innovations
3. Superstreet Intersection – Stephen Park
4. Other Added Value
4. Design-Build Procurement Results
5. Post-Award Partnering
6. Project Visualization
7. Project Status
8. Questions
Timeline
1980s -1990s - 3rd East-West River
Crossing Planning Efforts
– Completion of the Port St. Lucie Blvd.
and Prima Vista Blvd. Bridges
- City conveys over 1,000 acres of river
property to FDEP
2000s
- Federalization of the Project
from Manth Lane to US-1 and
the PD&E Study
- Initiation of PD&E Study and
conceptual alternatives/corridor
analysis
- 2005 Voter Referendum, 89%
approval of $165M general
obligation bond to fund Project
- 2009 Opened 5 miles
Crosstown Parkway Corridor
from I-95 East to Manth Lane
Project History/Overview
Project History/Overview
2010s
- Representative Corridor
addressing “worst case scenario”
impacts
- MOU with FDEP
- Draft EIS approved and LPA
Route 1C adopted
- FDEP’s Proprietary Mitigation
Plan implemented
February 2014 to Present
- FHWA’s ROD Issued approving
the LPA Route 1C
- 1st Amendment FDEP MOU
executed: revised Proprietary
Mitigation Plan
- City permit applications to
SFWMD and USACE
- Design-Build Procurement as
LAP Project with FDOT
Project History/Overview

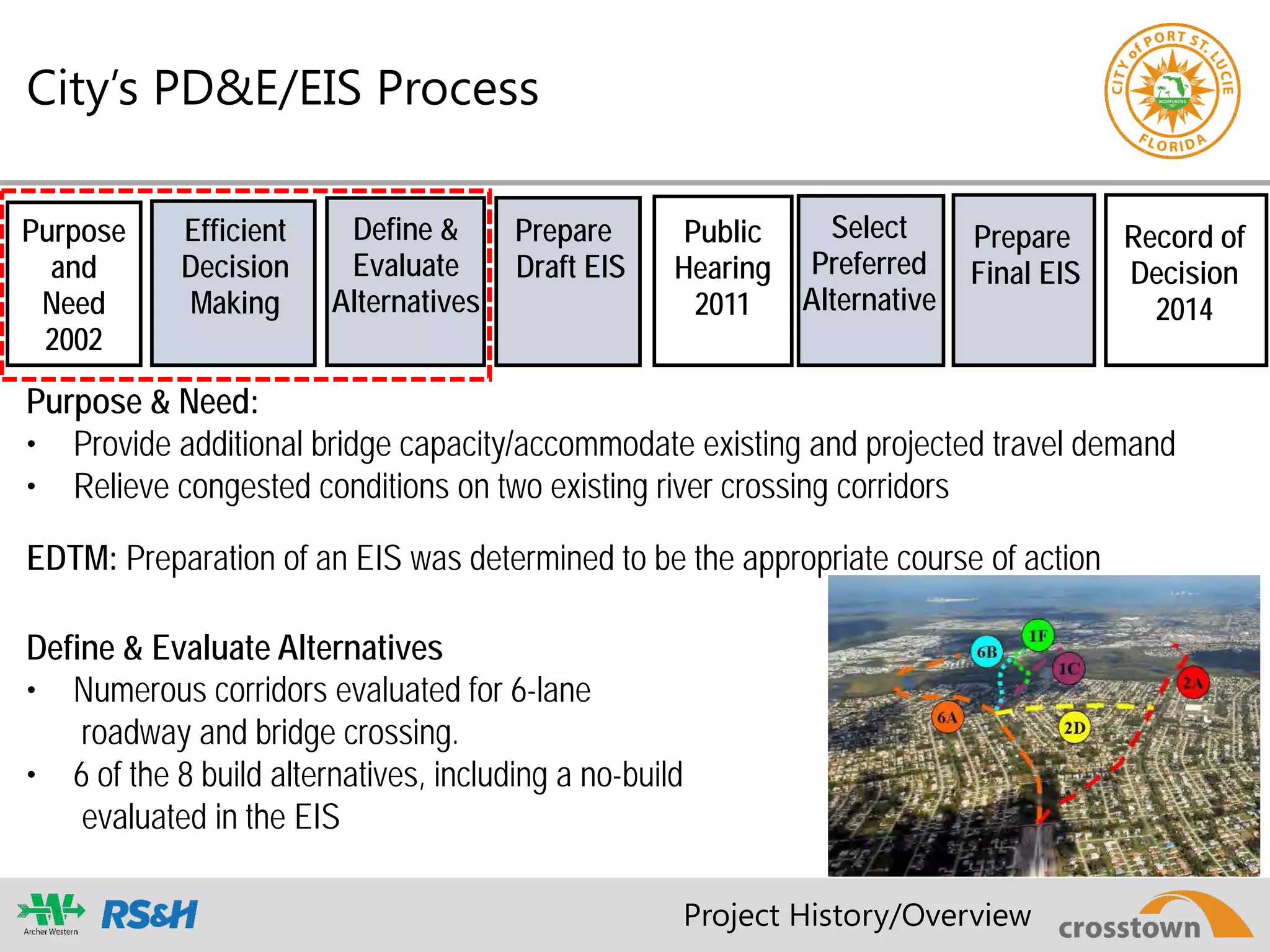

City’s PD&E/EIS Process
Purpose & Need:
• Provide additional bridge capacity/accommodate existing and projected travel demand
• Relieve congested conditions on two existing river crossing corridors
EDTM: Preparation of an EIS was determined to be the appropriate course of action
Define & Evaluate Alternatives
• Numerous corridors evaluated for 6-lane
roadway and bridge crossing.
• 6 of the 8 build alternatives, including a no-build
evaluated in the EIS

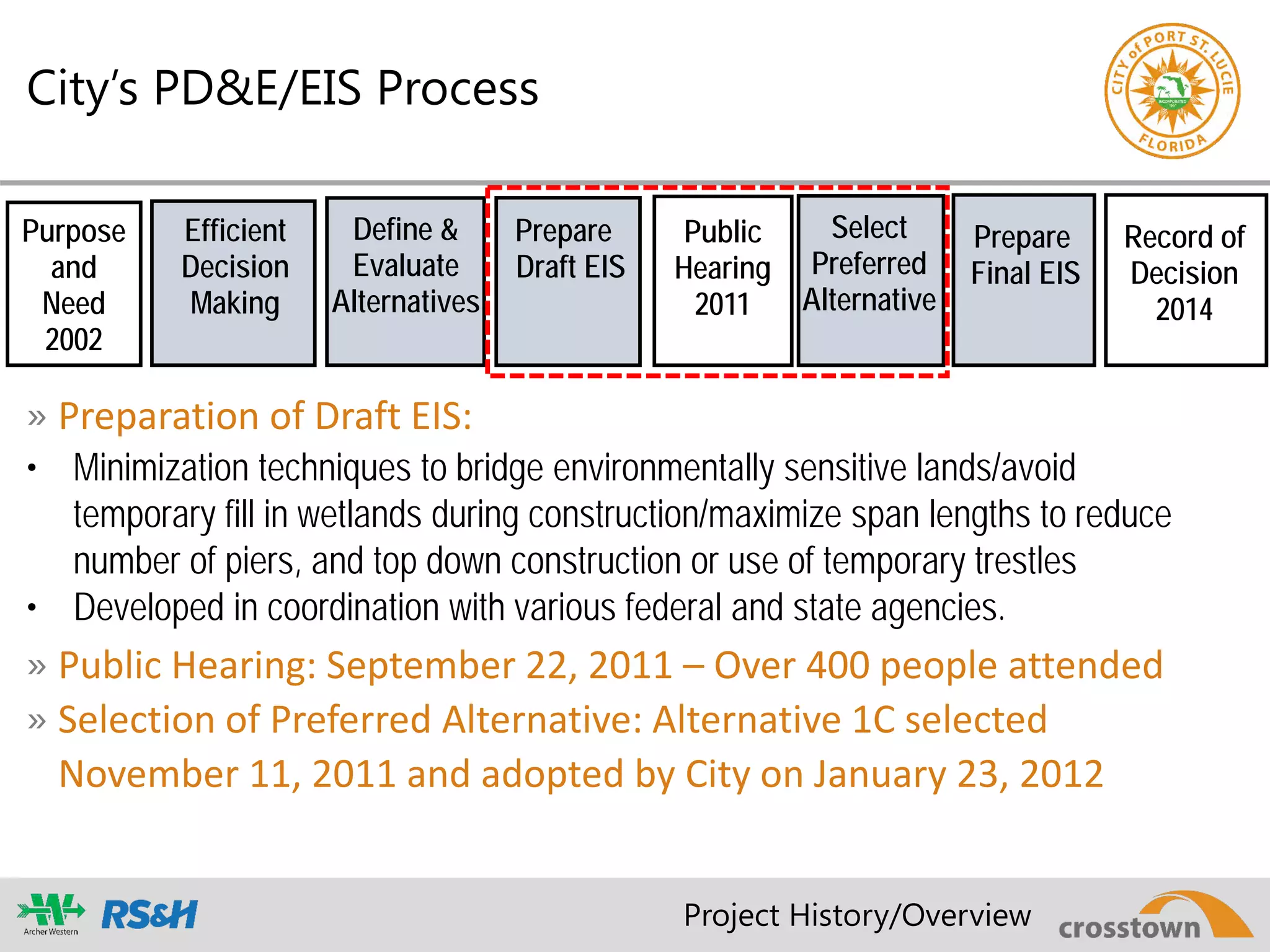

Purpose
and
Need
2002
Public
Hearing
2011
Record of
Decision
2014
Efficient
Decision
Making
Define &
Evaluate
Alternatives
Prepare
Draft EIS
Select
Preferred
Alternative
Prepare
Final EIS
Project History/Overview
City’s PD&E/EIS Process
Purpose
and
Need
2002
Public
Hearing
2011
Record of
Decision
2014
Efficient
Decision
Making
Define &
Evaluate
Alternatives
Prepare
Draft EIS
Select
Preferred
Alternative
Prepare
Final EIS
» Preparation of Draft EIS:
• Minimization techniques to bridge environmentally sensitive lands/avoid
temporary fill in wetlands during construction/maximize span lengths to reduce
number of piers, and top down construction or use of temporary trestles
• Developed in coordination with various federal and state agencies.
» Public Hearing: September 22, 2011 – Over 400 people attended
» Selection of Preferred Alternative: Alternative 1C selected
November 11, 2011 and adopted by City on January 23, 2012
Project History/Overview
City’s PD&E/EIS Process
Purpose
and
Need
2002
Public
Hearing
2011
Record of
Decision
2014
Efficient
Decision
Making
Define &
Evaluate
Alternatives
Prepare
Draft EIS
Select
Preferred
Alternative
Prepare
Final EIS
» Final EIS:
• FHWA concurrence with selection of Alternative 1C
• Signed by FHWA on November 14, 2013
» Record of Decision (ROD): February 24, 2014 signed by FHWA
Project History/Overview
» Final approval of Project
and Alternative 1C
corridor.

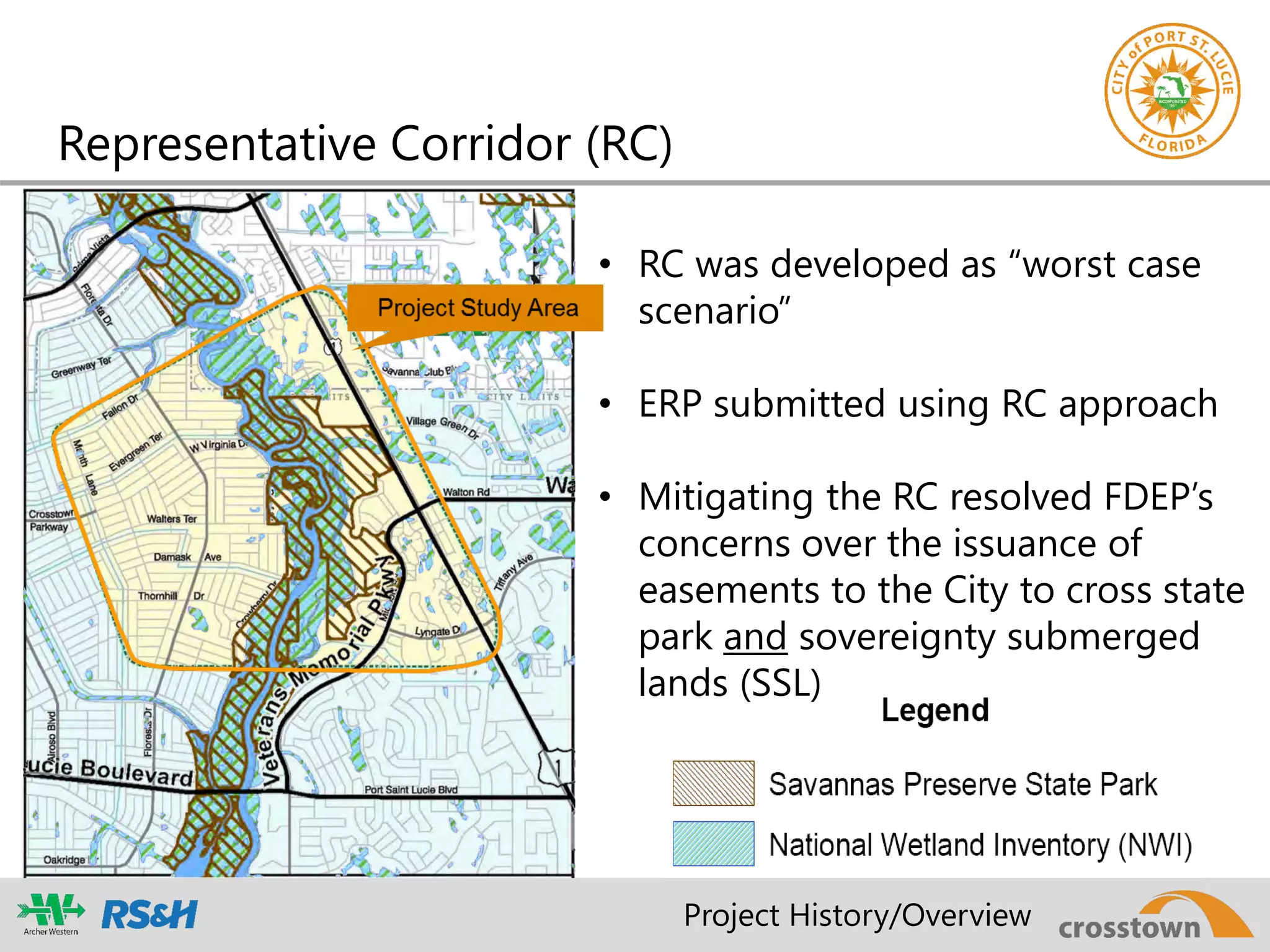

Representative Corridor (RC)
• RC was developed as “worst case
scenario”
• ERP submitted using RC approach
• Mitigating the RC resolved FDEP’s
concerns over the issuance of
easements to the City to cross state
park and sovereignty submerged
lands (SSL)
Project History/Overview
FDEP Proprietary Mitigation:
Water Quality Improvements
Four Restoration Projects
• Evans Creek
• Site 5 West
• Riverplace Upstream
• Baffle Boxes at five locations
Site 5 West
–Before-
Site 5 West
–After-
Project History/Overview
FDEP Proprietary Mitigation:
Recreational
Savannas Recreation Area Trail
• 1.25 mile multi-use trail
• 8’ conc. with 3 boardwalk crossings
Project History/Overview
FDEP Proprietary Mitigation:
Recreational
Savannas Preserve State Park
Education Center Improvements
Project History/Overview
Halpatiokee Trail
Canoe Access Replacement
Crosstown Parkway Segment 1
» From Manth Lane to US-1/Village Green Dr (Alt. 1C)
» 1.5 miles roadway improvements in 330 ft R/W
• 3 lanes in each direction
• Bicycle lanes and pedestrian paths on both sides of road
• Landscaped berm
» 4,000 foot long bridge over North Fork of St. Lucie River
• Signature bridge
• Architectural towers at bridge approaches with art
Project History/Overview

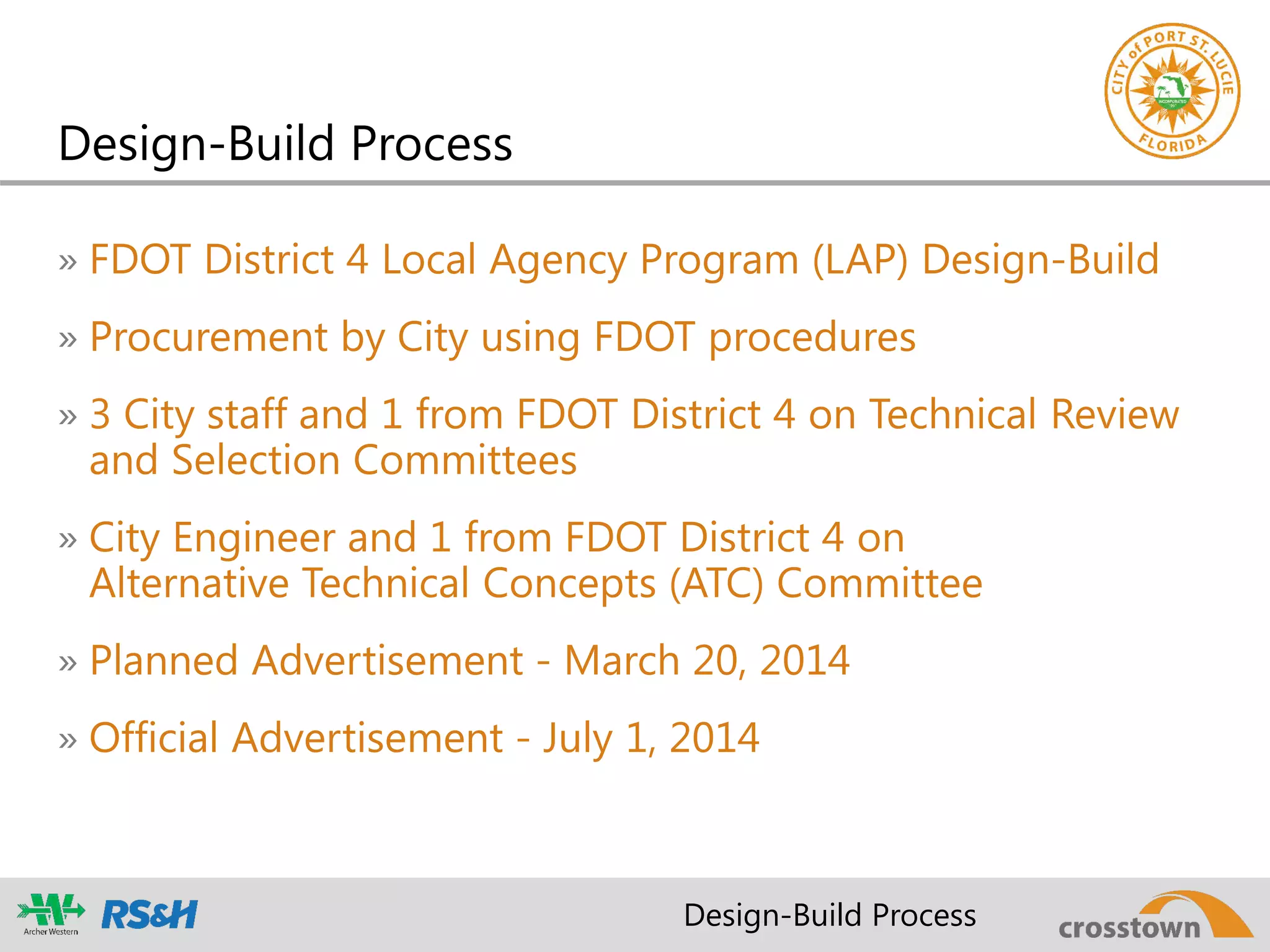

Design-Build Process
» FDOT District 4 Local Agency Program (LAP) Design-Build
» Procurement by City using FDOT procedures
» 3 City staff and 1 from FDOT District 4 on Technical Review
and Selection Committees
» City Engineer and 1 from FDOT District 4 on
Alternative Technical Concepts (ATC) Committee
» Planned Advertisement - March 20, 2014
» Official Advertisement - July 1, 2014
Design-Build Process

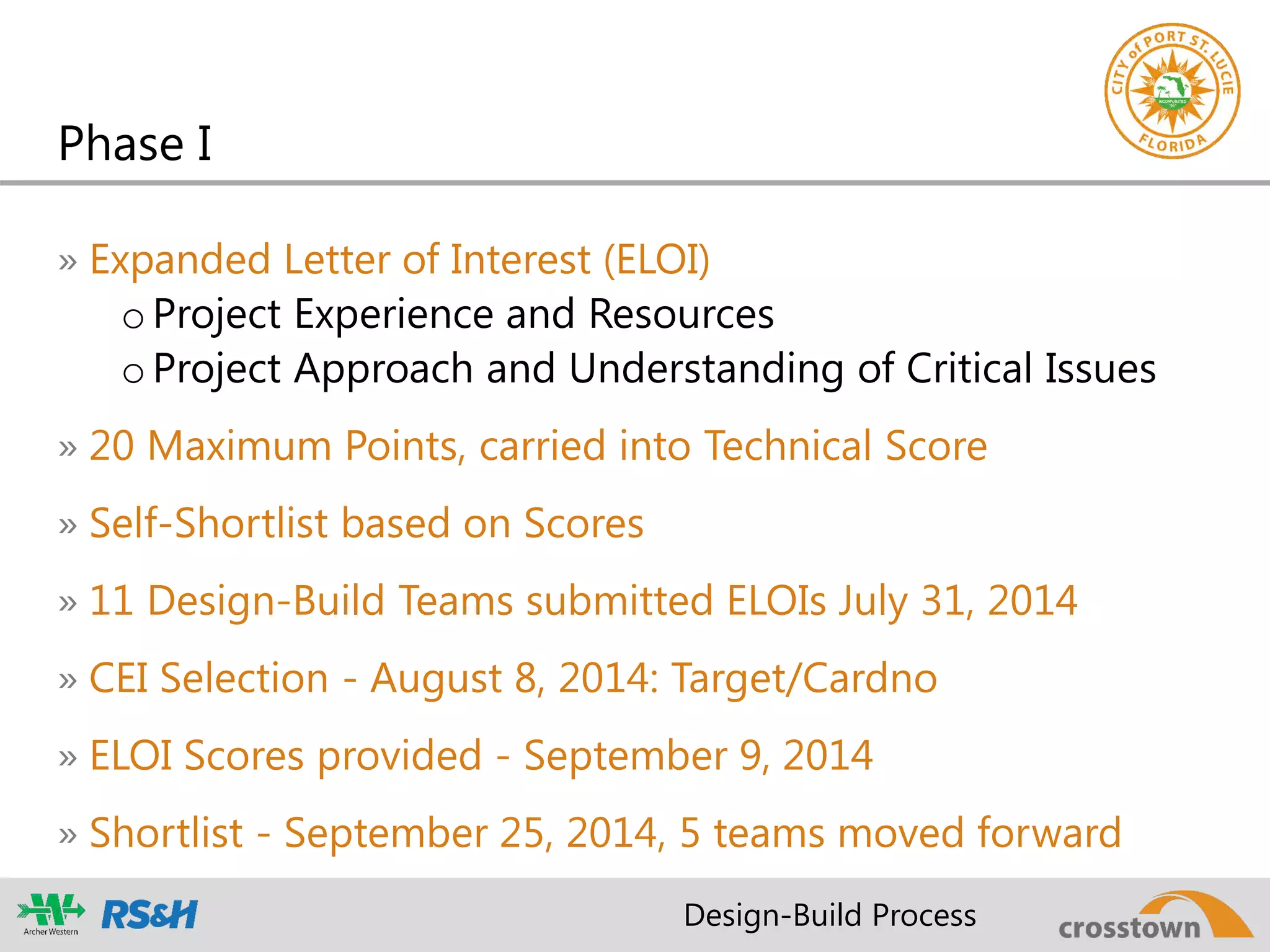

Phase I
» Expanded Letter of Interest (ELOI)
oProject Experience and Resources
oProject Approach and Understanding of Critical Issues
» 20 Maximum Points, carried into Technical Score
» Self-Shortlist based on Scores
» 11 Design-Build Teams submitted ELOIs July 31, 2014
» CEI Selection - August 8, 2014: Target/Cardno
» ELOI Scores provided - September 9, 2014
» Shortlist - September 25, 2014, 5 teams moved forward
Design-Build Process
Phase II
» Pre-proposal Meeting/RFP Provided - October 7, 2014
» ATC Meetings/Submittals - October 28-December 2, 2014
» Final ATC Decisions - December 16, 2014
» Technical Proposals Due - January 13, 2015 (80 points max)
» Page Turn Meeting - January 16, 2015
» Question and Answer Session - February 18, 2015
» Technical Scores Announced/Price Proposals Due -
May 19, 2015 (Let Date)
» Maximum Bid Price: $101,854,000
» Adjusted Scoring: Bid Price/Technical Score
Design-Build Process
Archer Western/RS&H Team Approach
» Brainstormed for ATCs/Innovations
• How to improve project
• Not just cut costs
• Provide best value to City/FDOT
• Reduce maintenance, wetland impacts
» Build Bridge from Temporary Trestle
• Longer spans
• Reduced cost/construction duration
• Reduced wetland impacts
Approach: Overview
ATCs & Innovations

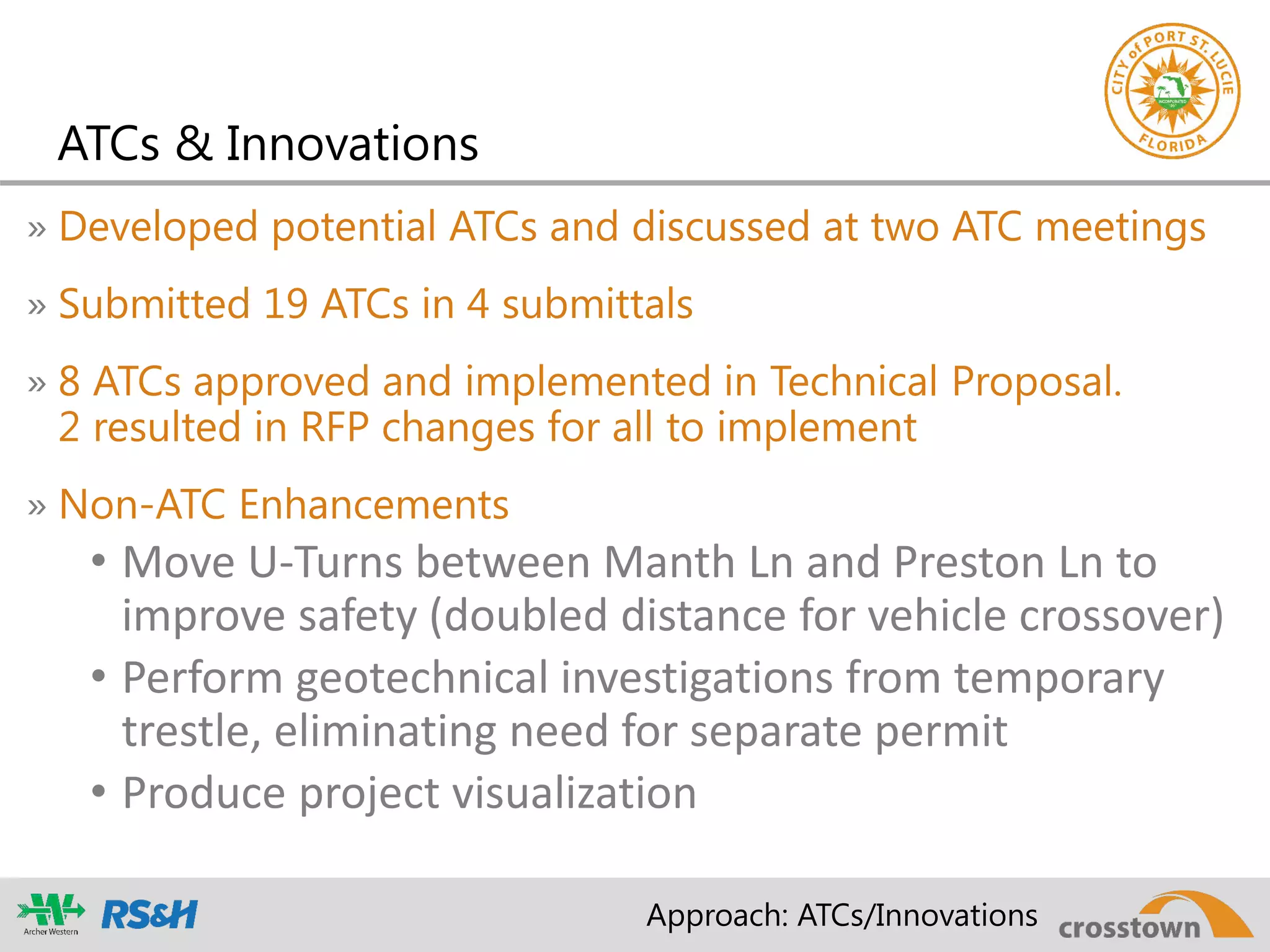

» Developed potential ATCs and discussed at two ATC meetings
» Submitted 19 ATCs in 4 submittals
» 8 ATCs approved and implemented in Technical Proposal.
2 resulted in RFP changes for all to implement
» Non-ATC Enhancements
• Move U-Turns between Manth Ln and Preston Ln to
improve safety (doubled distance for vehicle crossover)
• Perform geotechnical investigations from temporary
trestle, eliminating need for separate permit
• Produce project visualization
Approach: ATCs/Innovations

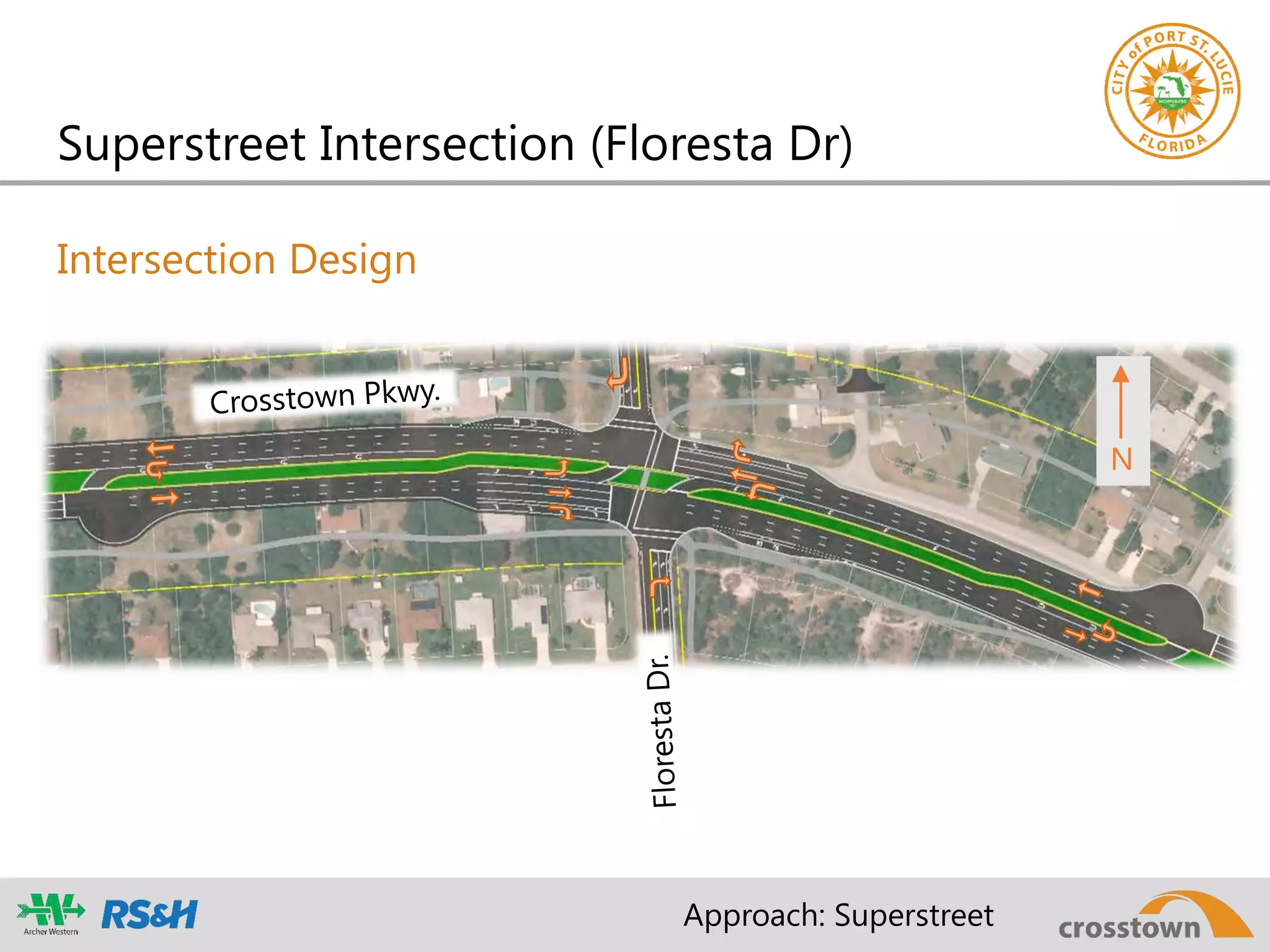

Superstreet Intersection (Floresta Dr)
Intersection Design
N
Approach: Superstreet

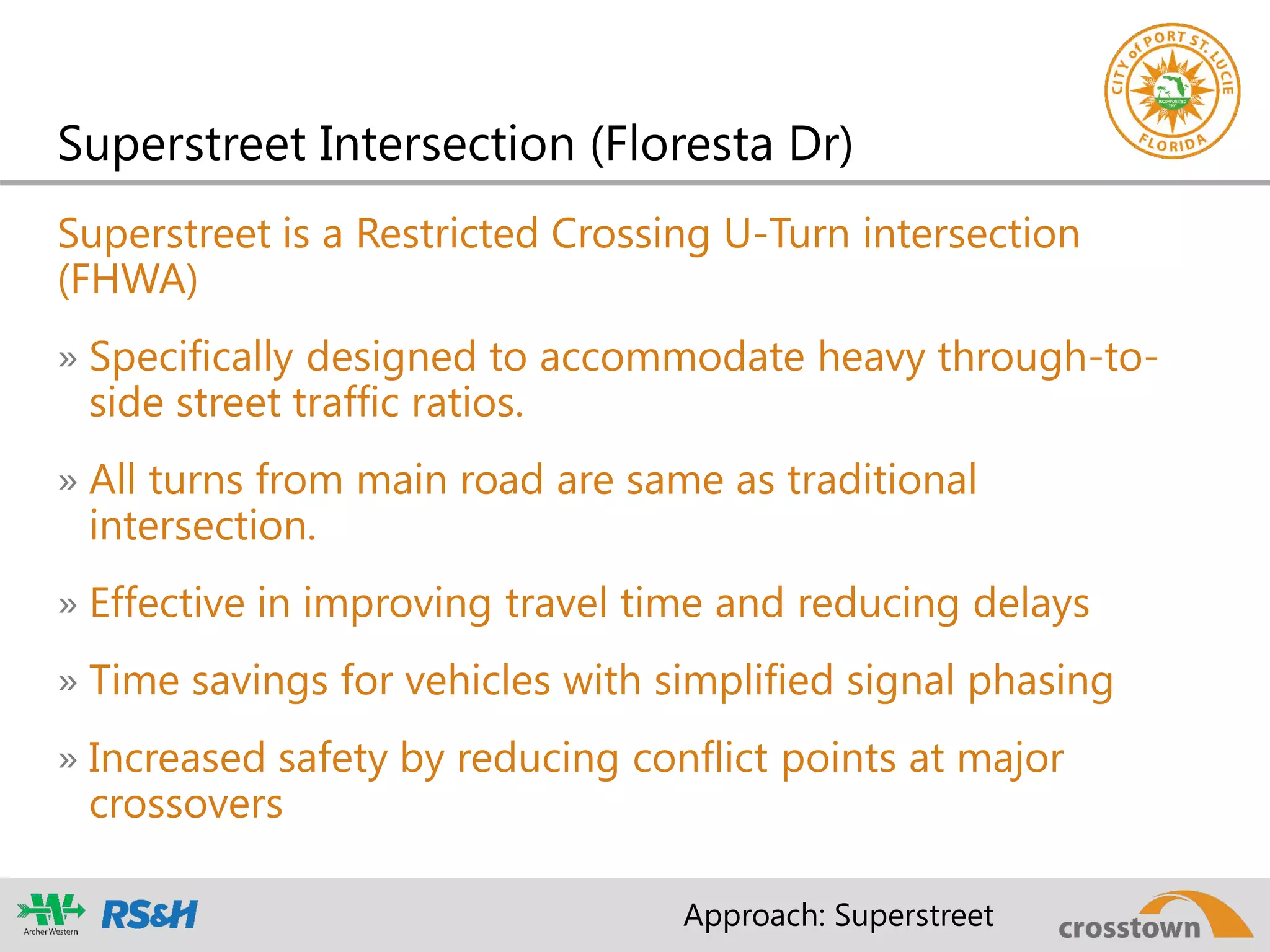

Superstreet is a Restricted Crossing U-Turn intersection
(FHWA)
» Specifically designed to accommodate heavy through-to-
side street traffic ratios.
» All turns from main road are same as traditional
intersection.
» Effective in improving travel time and reducing delays
» Time savings for vehicles with simplified signal phasing
» Increased safety by reducing conflict points at major
crossovers
Superstreet Intersection (Floresta Dr)
Approach: Superstreet

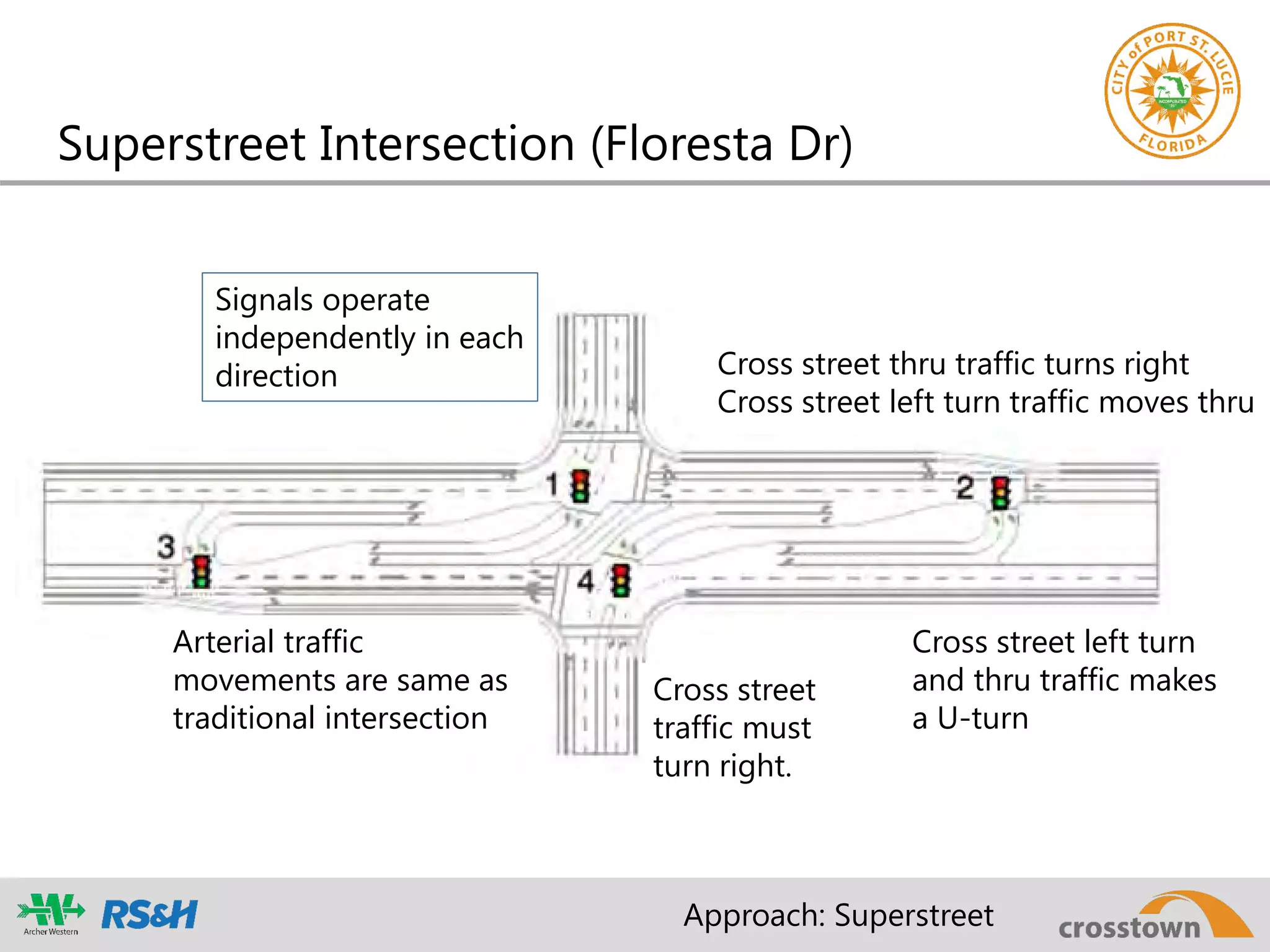

Minor Street (Floresta)Turning Movements
Left Turn Movement
Through Movement
Superstreet Intersection (Floresta Dr)
Arterial traffic
movements are same as
traditional intersection
Cross street
traffic must
turn right.
Cross street left turn
and thru traffic makes
a U-turn
Cross street thru traffic turns right
Cross street left turn traffic moves thru
Signals operate
independently in each
direction
Approach: Superstreet

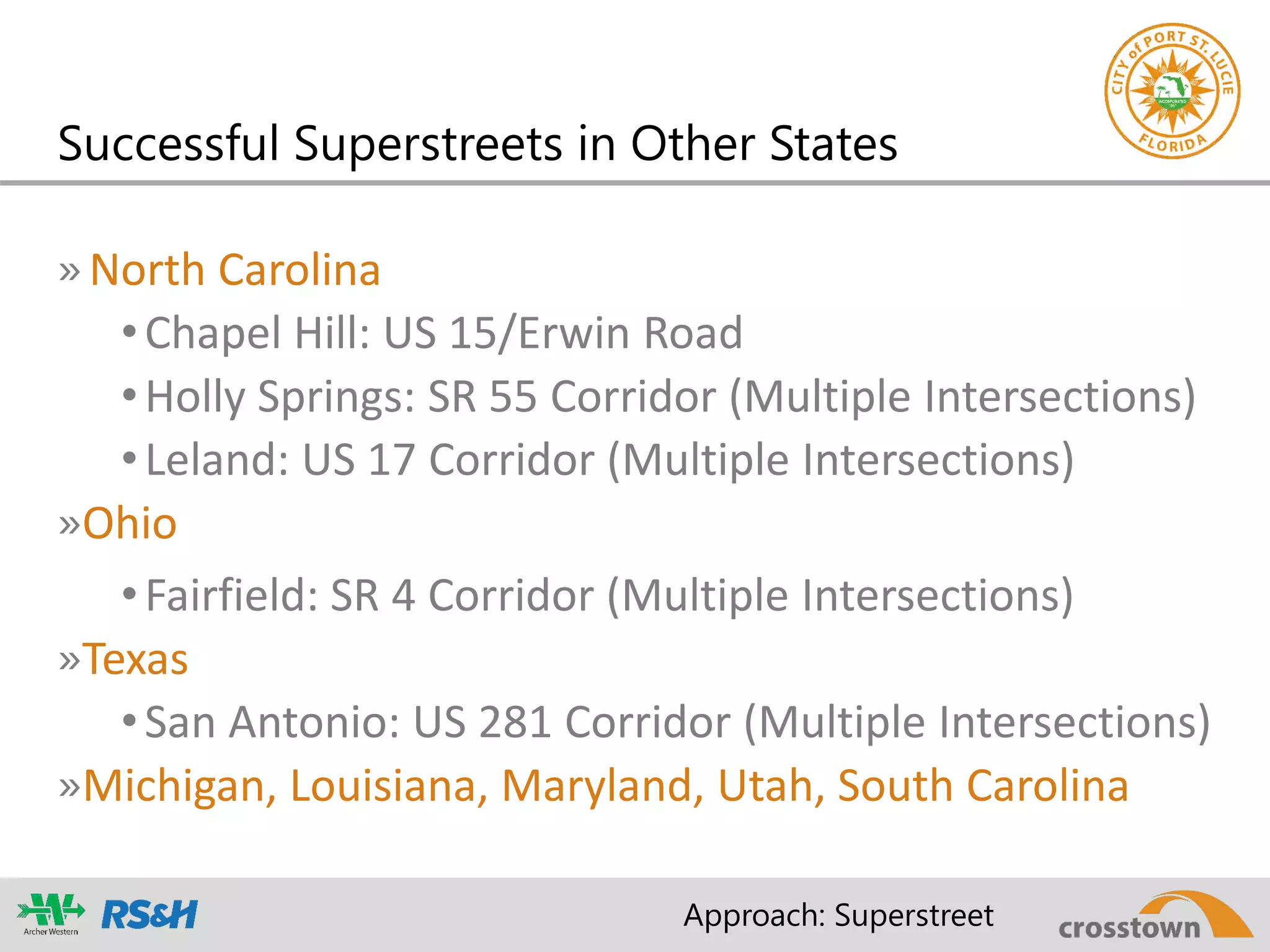

»North Carolina
•Chapel Hill: US 15/Erwin Road
•Holly Springs: SR 55 Corridor (Multiple Intersections)
•Leland: US 17 Corridor (Multiple Intersections)
»Ohio
•Fairfield: SR 4 Corridor (Multiple Intersections)
»Texas
•San Antonio: US 281 Corridor (Multiple Intersections)
»Michigan, Louisiana, Maryland, Utah, South Carolina
Successful Superstreets in Other States
Approach: Superstreet

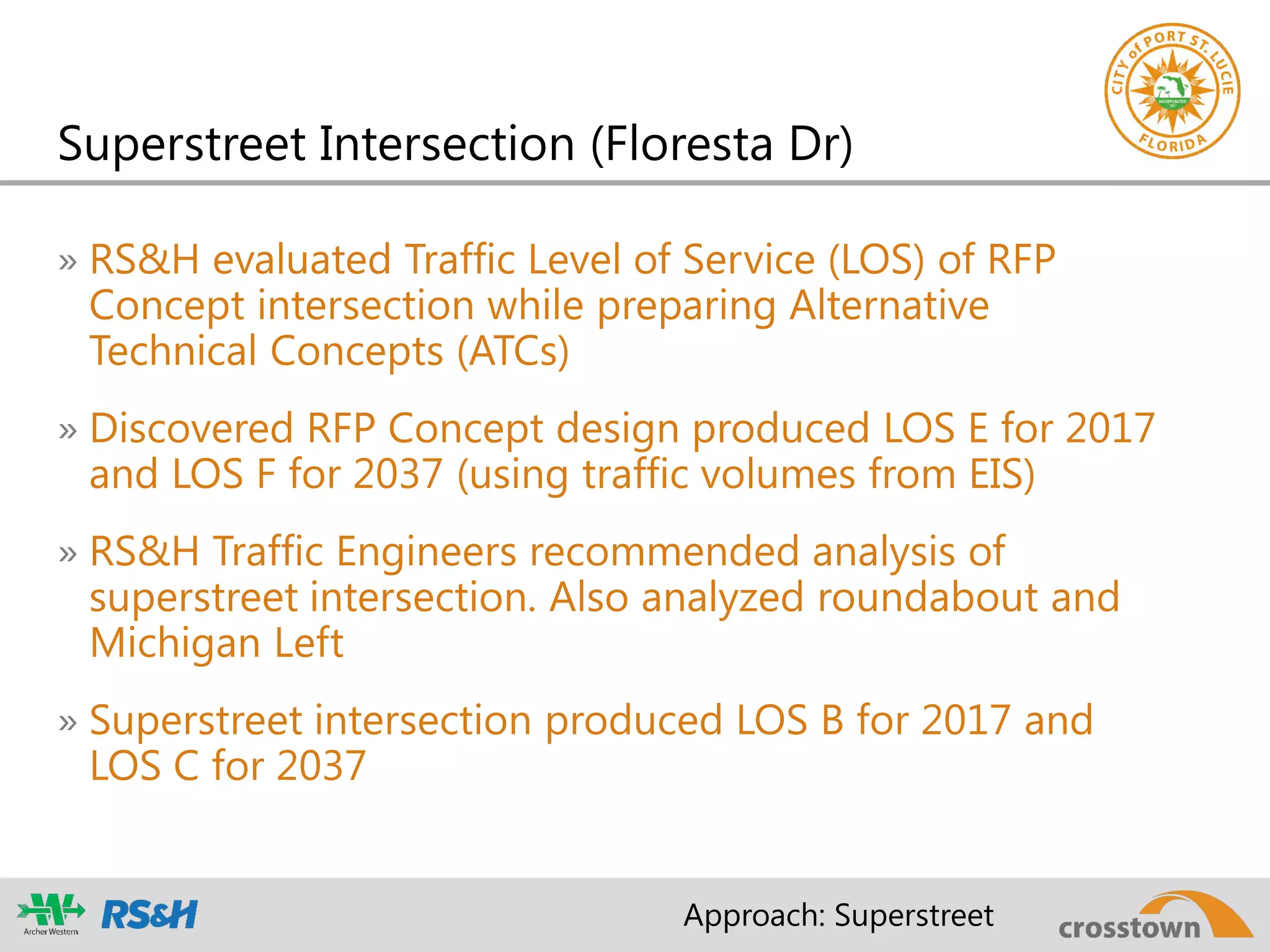

Superstreet Intersection (Floresta Dr)
» RS&H evaluated Traffic Level of Service (LOS) of RFP
Concept intersection while preparing Alternative
Technical Concepts (ATCs)
» Discovered RFP Concept design produced LOS E for 2017
and LOS F for 2037 (using traffic volumes from EIS)
» RS&H Traffic Engineers recommended analysis of
superstreet intersection. Also analyzed roundabout and
Michigan Left
» Superstreet intersection produced LOS B for 2017 and
LOS C for 2037
Approach: Superstreet
Superstreet Benefits
Approach: Superstreet
Measurement
Criteria
Traditional
Intersection
Superstreet
Intersection
Improvement
Opening Year (2017)
Level Of Service
E B 3 Levels
Design Year (2037)
Level Of Service
F C 3 Levels
Conflict Points 32 14 56% fewer
Average Delay Time 122.6 seconds 14.7 seconds 8 times faster
» Conflict Points reduced from 32 to 14 (56% reduction)
compared to traditional 4-leg intersection
• Fewer crashes
• Less severe crashes
» Pedestrian safety
• Large median refuge
• Conflict between pedestrians and left-turning vehicles
on Crosstown Parkway eliminated
• Conflict points reduced from 24 to 8 (67% reduction)
» Floresta Drive remains a neighborhood street.
» Emergency vehicles traverse mountable curb in median.
Safety Improvements of Superstreet
Approach: Superstreet
Safety Improvements of Superstreet
Traditional Intersection:
32 conflicts
Approach: Superstreet
Superstreet Intersection:
14 conflicts
Other Added Value
» Additional ATCs that purely add value:
• Provide overlooks on bridge
• Segmental block walls
• Implement Safety Edge™
Bridge Overlook
Segmental Block Walls
Approach: Other Added Value
Design-Build Procurement Results
» Archer Western/RS&H Team achieved highest technical score
and lowest bid!
» Bid price nearly $15M below maximum
Design-Build Procurement Results

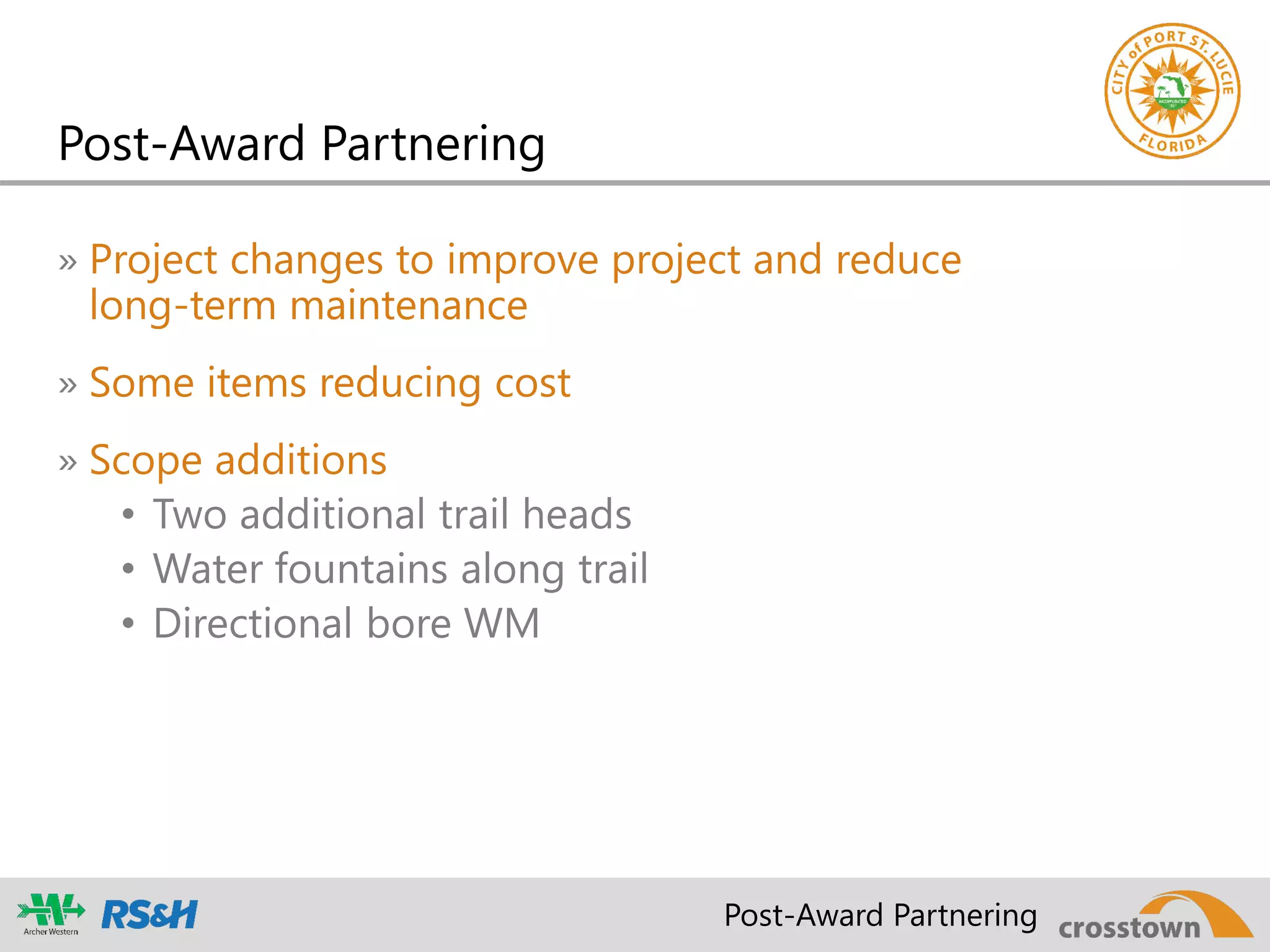

Post-Award Partnering
» Project changes to improve project and reduce
long-term maintenance
» Some items reducing cost
» Scope additions
• Two additional trail heads
• Water fountains along trail
• Directional bore WM
Post-Award Partnering
Where are we now?
»100% Plans under review
»SFWMD Permit - Administrative Hearing July 2016
»Anticipate construction to commence late 2016
»990 total contract days
»Project completion in 2018
Project Status
Questions?

More Related Content

What's hot

MARTA_Makeover_Exec_Summary_FINAL_072715
MARTA_Makeover_Exec_Summary_FINAL_072715MARTA_Makeover_Exec_Summary_FINAL_072715
MARTA_Makeover_Exec_Summary_FINAL_072715
Sarah McColley

Needs Study of North Dakota Roads and Bridges Status Report
Needs Study of North Dakota Roads and Bridges Status ReportNeeds Study of North Dakota Roads and Bridges Status Report
Needs Study of North Dakota Roads and Bridges Status Report
UGPTI


What's hot (20)

Kanata LRT Planning and Environmental Assessment Study
Kanata LRT Planning and Environmental Assessment StudyKanata LRT Planning and Environmental Assessment Study
Kanata LRT Planning and Environmental Assessment Study

Fairfax County Parkway Study Meeting, June 2016
Fairfax County Parkway Study Meeting, June 2016Fairfax County Parkway Study Meeting, June 2016
Fairfax County Parkway Study Meeting, June 2016

Rapid Transit Corridors Workshop, January 8, 2015
Rapid Transit Corridors Workshop, January 8, 2015Rapid Transit Corridors Workshop, January 8, 2015
Rapid Transit Corridors Workshop, January 8, 2015

Relief Line Project Assessment Phase 1A Consultation Presentation
Relief Line Project Assessment Phase 1A Consultation PresentationRelief Line Project Assessment Phase 1A Consultation Presentation
Relief Line Project Assessment Phase 1A Consultation Presentation

RTE Roundabout Analysis - Technical Data
RTE Roundabout Analysis - Technical DataRTE Roundabout Analysis - Technical Data
RTE Roundabout Analysis - Technical Data

SMCTA 101 Corridor Managed Lanes 092816
SMCTA 101 Corridor Managed Lanes 092816SMCTA 101 Corridor Managed Lanes 092816
SMCTA 101 Corridor Managed Lanes 092816

Relief Line Phase 3 Consultation Report
Relief Line Phase 3 Consultation ReportRelief Line Phase 3 Consultation Report
Relief Line Phase 3 Consultation Report

MARTA_Makeover_Exec_Summary_FINAL_072715
MARTA_Makeover_Exec_Summary_FINAL_072715MARTA_Makeover_Exec_Summary_FINAL_072715
MARTA_Makeover_Exec_Summary_FINAL_072715

Van Nuys Corridor Rapidway (Oct 2011 PowerPoint)
Van Nuys Corridor Rapidway (Oct 2011 PowerPoint)Van Nuys Corridor Rapidway (Oct 2011 PowerPoint)
Van Nuys Corridor Rapidway (Oct 2011 PowerPoint)

Dumbarton Crossbay
Dumbarton Crossbay Dumbarton Crossbay
Dumbarton Crossbay

Presentation - Park Lawn Lake Shore Transportation Master Plan Community Work...
Presentation - Park Lawn Lake Shore Transportation Master Plan Community Work...Presentation - Park Lawn Lake Shore Transportation Master Plan Community Work...
Presentation - Park Lawn Lake Shore Transportation Master Plan Community Work...

Steeles Avenue East Bridge Study PIC 1
Steeles Avenue East Bridge Study PIC 1Steeles Avenue East Bridge Study PIC 1
Steeles Avenue East Bridge Study PIC 1

Waterfront Transit Reset Public Meeting Presentation
Waterfront Transit Reset Public Meeting Presentation Waterfront Transit Reset Public Meeting Presentation
Waterfront Transit Reset Public Meeting Presentation

PM tools and techniques
PM tools and techniquesPM tools and techniques
PM tools and techniques

Yakima Valley Conference of Government's Prioritization Process
Yakima Valley Conference of Government's Prioritization ProcessYakima Valley Conference of Government's Prioritization Process
Yakima Valley Conference of Government's Prioritization Process

Needs Study of North Dakota Roads and Bridges Status Report
Needs Study of North Dakota Roads and Bridges Status ReportNeeds Study of North Dakota Roads and Bridges Status Report
Needs Study of North Dakota Roads and Bridges Status Report

Hunter Mill Road and Sunset Hills Road Study: Community Meeting #5 - Sept. 15...
Hunter Mill Road and Sunset Hills Road Study: Community Meeting #5 - Sept. 15...Hunter Mill Road and Sunset Hills Road Study: Community Meeting #5 - Sept. 15...
Hunter Mill Road and Sunset Hills Road Study: Community Meeting #5 - Sept. 15...

Kingston Greenline & Ulster County Trails Summit - KPRT Feasibility Study
Kingston Greenline & Ulster County Trails Summit - KPRT Feasibility StudyKingston Greenline & Ulster County Trails Summit - KPRT Feasibility Study
Kingston Greenline & Ulster County Trails Summit - KPRT Feasibility Study

February Transit Update Presentation
February Transit Update PresentationFebruary Transit Update Presentation
February Transit Update Presentation

AICPA GPAC presentation
AICPA GPAC presentationAICPA GPAC presentation
AICPA GPAC presentation


Similar to Crosstown apwa presentation2016 04-19

Public Forum 2 - Display Boards
Public Forum 2 - Display BoardsPublic Forum 2 - Display Boards
Public Forum 2 - Display Boards
GardinerEast

2.2 tri rail coastal link
2.2 tri rail coastal link2.2 tri rail coastal link
2.2 tri rail coastal link
ascemiami-dade

2.2 tri rail coastal link
2.2 tri rail coastal link2.2 tri rail coastal link
2.2 tri rail coastal link
ascemiami-dade

Torrey pines road corridor study final
Torrey pines road corridor study finalTorrey pines road corridor study final
Torrey pines road corridor study final
kday1

Dan Ross NextGen ppt FINAL
Dan Ross NextGen ppt FINALDan Ross NextGen ppt FINAL
Dan Ross NextGen ppt FINAL
Dan Ross

Portland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman
Portland's Complete Streets Policy - GSMSummit 2014, Bruce HymanPortland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman
Portland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman
GrowSmart Maine


Similar to Crosstown apwa presentation2016 04-19 (20)

Public Forum 2 - Display Boards
Public Forum 2 - Display BoardsPublic Forum 2 - Display Boards
Public Forum 2 - Display Boards

2.2 tri rail coastal link
2.2 tri rail coastal link2.2 tri rail coastal link
2.2 tri rail coastal link

2.2 tri rail coastal link
2.2 tri rail coastal link2.2 tri rail coastal link
2.2 tri rail coastal link

East Don Trail - Design Concepts
East Don Trail - Design ConceptsEast Don Trail - Design Concepts
East Don Trail - Design Concepts

RV 2014: Urban Circulator Roundtable: Shaping Cities one Challenge at a Time ...
RV 2014: Urban Circulator Roundtable: Shaping Cities one Challenge at a Time ...RV 2014: Urban Circulator Roundtable: Shaping Cities one Challenge at a Time ...
RV 2014: Urban Circulator Roundtable: Shaping Cities one Challenge at a Time ...

Steeles Bridge EA PIC#2 powerpoint 04_01_2017
Steeles Bridge  EA PIC#2 powerpoint 04_01_2017Steeles Bridge  EA PIC#2 powerpoint 04_01_2017
Steeles Bridge EA PIC#2 powerpoint 04_01_2017

CAP Metro Update 6/15/17
CAP Metro Update 6/15/17CAP Metro Update 6/15/17
CAP Metro Update 6/15/17

Scarborough Subway Extension - Public Meeting Presentation - January/February...
Scarborough Subway Extension - Public Meeting Presentation - January/February...Scarborough Subway Extension - Public Meeting Presentation - January/February...
Scarborough Subway Extension - Public Meeting Presentation - January/February...

Fairfax County Parkway and Franconia-Springfield Parkway Corridor Study
Fairfax County Parkway and Franconia-Springfield Parkway Corridor StudyFairfax County Parkway and Franconia-Springfield Parkway Corridor Study
Fairfax County Parkway and Franconia-Springfield Parkway Corridor Study

Fairfax County Parkway and Franconia-Springfield Parkway Corridor Study
Fairfax County Parkway and Franconia-Springfield Parkway Corridor StudyFairfax County Parkway and Franconia-Springfield Parkway Corridor Study
Fairfax County Parkway and Franconia-Springfield Parkway Corridor Study

VDOT: Fairfax County Board of Supervisors Transportation Committee: Dec. 13, ...
VDOT: Fairfax County Board of Supervisors Transportation Committee: Dec. 13, ...VDOT: Fairfax County Board of Supervisors Transportation Committee: Dec. 13, ...
VDOT: Fairfax County Board of Supervisors Transportation Committee: Dec. 13, ...

Cuyahoga Greenways: Community Meeting #1
Cuyahoga Greenways: Community Meeting #1Cuyahoga Greenways: Community Meeting #1
Cuyahoga Greenways: Community Meeting #1

Upp scoping session presentation 4 4-2019
Upp scoping session presentation 4 4-2019Upp scoping session presentation 4 4-2019
Upp scoping session presentation 4 4-2019

Torrey pines road corridor study final
Torrey pines road corridor study finalTorrey pines road corridor study final
Torrey pines road corridor study final

Park Lawn Lake Shore Transportation Master Plan Community Workshop 1 Display ...
Park Lawn Lake Shore Transportation Master Plan Community Workshop 1 Display ...Park Lawn Lake Shore Transportation Master Plan Community Workshop 1 Display ...
Park Lawn Lake Shore Transportation Master Plan Community Workshop 1 Display ...

SMART Plan Corridors' PD&Es Update
SMART Plan Corridors' PD&Es UpdateSMART Plan Corridors' PD&Es Update
SMART Plan Corridors' PD&Es Update

Dan Ross NextGen ppt FINAL
Dan Ross NextGen ppt FINALDan Ross NextGen ppt FINAL
Dan Ross NextGen ppt FINAL

I-66 Beltway to Haymarket - VDOT
 I-66 Beltway to Haymarket - VDOT I-66 Beltway to Haymarket - VDOT
I-66 Beltway to Haymarket - VDOT

State of the Trails 2015
State of the Trails 2015State of the Trails 2015
State of the Trails 2015

Portland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman
Portland's Complete Streets Policy - GSMSummit 2014, Bruce HymanPortland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman
Portland's Complete Streets Policy - GSMSummit 2014, Bruce Hyman


More from Florida Public Works Expo - 2016 - Tampa, Florida

More from Florida Public Works Expo - 2016 - Tampa, Florida (20)

Ada resurface apwa_2019_presentation
Ada resurface apwa_2019_presentationAda resurface apwa_2019_presentation
Ada resurface apwa_2019_presentation

Florida apwa sterling_overview_final_gordon_klein
Florida apwa sterling_overview_final_gordon_kleinFlorida apwa sterling_overview_final_gordon_klein
Florida apwa sterling_overview_final_gordon_klein

Managing stormwater to_minimize_groundwater_contaminant_migration_locklear
Managing stormwater to_minimize_groundwater_contaminant_migration_locklearManaging stormwater to_minimize_groundwater_contaminant_migration_locklear
Managing stormwater to_minimize_groundwater_contaminant_migration_locklear

2017 apwa conference fsb superstructure package young
2017 apwa conference fsb superstructure package young2017 apwa conference fsb superstructure package young
2017 apwa conference fsb superstructure package young

Stormwater modeling 411_troilo
Stormwater modeling 411_troiloStormwater modeling 411_troilo
Stormwater modeling 411_troilo

Apwa meeting nrcs_ewp_may_2017
Apwa meeting nrcs_ewp_may_2017Apwa meeting nrcs_ewp_may_2017
Apwa meeting nrcs_ewp_may_2017

Developing your path forward 2016 12-7 1500 v5-handouts
Developing your path forward 2016 12-7 1500 v5-handoutsDeveloping your path forward 2016 12-7 1500 v5-handouts
Developing your path forward 2016 12-7 1500 v5-handouts

APWA Public Works Director Roundtable 2016
APWA Public Works Director Roundtable 2016APWA Public Works Director Roundtable 2016
APWA Public Works Director Roundtable 2016

Let's fix funding! Panel APWA 2016
Let's fix funding! Panel APWA 2016Let's fix funding! Panel APWA 2016
Let's fix funding! Panel APWA 2016

Water utility budgeting flood to drought-understanding and predicting variabl...
Water utility budgeting flood to drought-understanding and predicting variabl...Water utility budgeting flood to drought-understanding and predicting variabl...
Water utility budgeting flood to drought-understanding and predicting variabl...

Acf environmental 2016 apwa fl expo - integrated infrastructure-an innovati...
Acf environmental   2016 apwa fl expo - integrated infrastructure-an innovati...Acf environmental   2016 apwa fl expo - integrated infrastructure-an innovati...
Acf environmental 2016 apwa fl expo - integrated infrastructure-an innovati...

Finding & keeping best employees
Finding & keeping best employeesFinding & keeping best employees
Finding & keeping best employees

Low impact development_coupled_with_floodplain_mitigation
Low impact development_coupled_with_floodplain_mitigationLow impact development_coupled_with_floodplain_mitigation
Low impact development_coupled_with_floodplain_mitigation

Manatee County Employee Training Program
Manatee County Employee Training ProgramManatee County Employee Training Program
Manatee County Employee Training Program

Fpwe2016 warm mix presentation
Fpwe2016 warm mix presentationFpwe2016 warm mix presentation
Fpwe2016 warm mix presentation

Locklear scalehouse presentation
Locklear scalehouse presentationLocklear scalehouse presentation
Locklear scalehouse presentation

warm mix casselberry comp
warm mix casselberry compwarm mix casselberry comp
warm mix casselberry comp

Ccwf restoration apwa
Ccwf restoration apwaCcwf restoration apwa
Ccwf restoration apwa

Technically speaking sheldon cooper
Technically speaking sheldon cooperTechnically speaking sheldon cooper
Technically speaking sheldon cooper

Cmp presentation 3 21-16
Cmp presentation 3 21-16Cmp presentation 3 21-16
Cmp presentation 3 21-16


Recently uploaded

一比一原版(GU毕业证)格里菲斯大学毕业证成绩单
一比一原版(GU毕业证)格里菲斯大学毕业证成绩单一比一原版(GU毕业证)格里菲斯大学毕业证成绩单
一比一原版(GU毕业证)格里菲斯大学毕业证成绩单
enbam

一比一原版(IC毕业证)帝国理工大学毕业证成绩单
一比一原版(IC毕业证)帝国理工大学毕业证成绩单一比一原版(IC毕业证)帝国理工大学毕业证成绩单
一比一原版(IC毕业证)帝国理工大学毕业证成绩单
exuyk

一比一原版(UniSA毕业证)南澳大学毕业证成绩单
一比一原版(UniSA毕业证)南澳大学毕业证成绩单一比一原版(UniSA毕业证)南澳大学毕业证成绩单
一比一原版(UniSA毕业证)南澳大学毕业证成绩单
aveka1

一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单
一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单
一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单
enbam

Advancing Impact Measurement | Public Good App House
Advancing Impact Measurement | Public Good App HouseAdvancing Impact Measurement | Public Good App House
Advancing Impact Measurement | Public Good App House
TechSoup


Recently uploaded (20)

Writing Sample-Title: Pioneering Urban Transformation: The Collective Power o...
Writing Sample-Title: Pioneering Urban Transformation: The Collective Power o...Writing Sample-Title: Pioneering Urban Transformation: The Collective Power o...
Writing Sample-Title: Pioneering Urban Transformation: The Collective Power o...

PACT launching workshop presentation-Final.pdf
PACT launching workshop presentation-Final.pdfPACT launching workshop presentation-Final.pdf
PACT launching workshop presentation-Final.pdf

MHM Roundtable Slide Deck WHA Side-event May 28 2024.pptx
MHM Roundtable Slide Deck WHA Side-event May 28 2024.pptxMHM Roundtable Slide Deck WHA Side-event May 28 2024.pptx
MHM Roundtable Slide Deck WHA Side-event May 28 2024.pptx

PPT Item # 6 - 7001 Broadway ARB Case # 933F
PPT Item # 6 - 7001 Broadway ARB Case # 933FPPT Item # 6 - 7001 Broadway ARB Case # 933F
PPT Item # 6 - 7001 Broadway ARB Case # 933F

What is the point of small housing associations.pptx
What is the point of small housing associations.pptxWhat is the point of small housing associations.pptx
What is the point of small housing associations.pptx

PPT Item # 5 - 5330 Broadway ARB Case # 930F
PPT Item # 5 - 5330 Broadway ARB Case # 930FPPT Item # 5 - 5330 Broadway ARB Case # 930F
PPT Item # 5 - 5330 Broadway ARB Case # 930F

一比一原版(GU毕业证)格里菲斯大学毕业证成绩单
一比一原版(GU毕业证)格里菲斯大学毕业证成绩单一比一原版(GU毕业证)格里菲斯大学毕业证成绩单
一比一原版(GU毕业证)格里菲斯大学毕业证成绩单

Item # 7 - BB Inspection Services Agreement
Item # 7 - BB Inspection Services AgreementItem # 7 - BB Inspection Services Agreement
Item # 7 - BB Inspection Services Agreement

Creating an Effective Veteran Policy in Ukraine
Creating an Effective Veteran Policy in UkraineCreating an Effective Veteran Policy in Ukraine
Creating an Effective Veteran Policy in Ukraine

一比一原版(IC毕业证)帝国理工大学毕业证成绩单
一比一原版(IC毕业证)帝国理工大学毕业证成绩单一比一原版(IC毕业证)帝国理工大学毕业证成绩单
一比一原版(IC毕业证)帝国理工大学毕业证成绩单

一比一原版(UniSA毕业证)南澳大学毕业证成绩单
一比一原版(UniSA毕业证)南澳大学毕业证成绩单一比一原版(UniSA毕业证)南澳大学毕业证成绩单
一比一原版(UniSA毕业证)南澳大学毕业证成绩单

一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单
一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单
一比一原版(UOW毕业证)伍伦贡大学毕业证成绩单

Counting Class for Micro Observers 2024.pptx
Counting Class for Micro Observers 2024.pptxCounting Class for Micro Observers 2024.pptx
Counting Class for Micro Observers 2024.pptx

Advancing Impact Measurement | Public Good App House
Advancing Impact Measurement | Public Good App HouseAdvancing Impact Measurement | Public Good App House
Advancing Impact Measurement | Public Good App House

Presentation on RBI and its functions , advantage and disadvantage
Presentation on RBI and its functions , advantage and disadvantagePresentation on RBI and its functions , advantage and disadvantage
Presentation on RBI and its functions , advantage and disadvantage

How to Save a Place: How to Fund Your Preservation Project
How to Save a Place: How to Fund Your Preservation ProjectHow to Save a Place: How to Fund Your Preservation Project
How to Save a Place: How to Fund Your Preservation Project

CourseHero 9KLDFSKJKSJDFKSDKFJSDKSLFJKSJL
CourseHero 9KLDFSKJKSJDFKSDKFJSDKSLFJKSJLCourseHero 9KLDFSKJKSJDFKSDKFJSDKSLFJKSJL
CourseHero 9KLDFSKJKSJDFKSDKFJSDKSLFJKSJL

2024: The FAR - Federal Acquisition Regulations, Part 36
2024: The FAR - Federal Acquisition Regulations, Part 362024: The FAR - Federal Acquisition Regulations, Part 36
2024: The FAR - Federal Acquisition Regulations, Part 36

Proposed Facility Types: Chesapeake Trails and Connectivity Plan
Proposed Facility Types: Chesapeake Trails and Connectivity PlanProposed Facility Types: Chesapeake Trails and Connectivity Plan
Proposed Facility Types: Chesapeake Trails and Connectivity Plan

PPT Item # 8 - Tuxedo Columbine 3way Stop
PPT Item # 8 - Tuxedo Columbine 3way StopPPT Item # 8 - Tuxedo Columbine 3way Stop
PPT Item # 8 - Tuxedo Columbine 3way Stop


Crosstown apwa presentation2016 04-19

  • 1. Crosstown Parkway Extension: Innovations Through Design-Build APWA Florida Chapter 2016 Public Works Expo April 19, 2016
  • 2. Presenters » Frank Knott, City of Port St. Lucie Public Works, Project Manager » Rachel Back, PE, CFM, RS&H, Inc., Design Project Manager » Stephen Park, PE, RS&H, Inc., Roadway Engineer of Record
  • 3. Technical Session Outline 1. Project History/Overview – Frank Knott 2. Design-Build Process – Rachel Back 3. Archer Western/RS&H Team Approach 1. Overview 2. Alternative Technical Concepts (ATCs) and Innovations 3. Superstreet Intersection – Stephen Park 4. Other Added Value 4. Design-Build Procurement Results 5. Post-Award Partnering 6. Project Visualization 7. Project Status 8. Questions
  • 4. Timeline 1980s -1990s - 3rd East-West River Crossing Planning Efforts – Completion of the Port St. Lucie Blvd. and Prima Vista Blvd. Bridges - City conveys over 1,000 acres of river property to FDEP 2000s - Federalization of the Project from Manth Lane to US-1 and the PD&E Study - Initiation of PD&E Study and conceptual alternatives/corridor analysis - 2005 Voter Referendum, 89% approval of $165M general obligation bond to fund Project - 2009 Opened 5 miles Crosstown Parkway Corridor from I-95 East to Manth Lane Project History/Overview
  • 5. Project History/Overview 2010s - Representative Corridor addressing “worst case scenario” impacts - MOU with FDEP - Draft EIS approved and LPA Route 1C adopted - FDEP’s Proprietary Mitigation Plan implemented February 2014 to Present - FHWA’s ROD Issued approving the LPA Route 1C - 1st Amendment FDEP MOU executed: revised Proprietary Mitigation Plan - City permit applications to SFWMD and USACE - Design-Build Procurement as LAP Project with FDOT Project History/Overview
  • 6. City’s PD&E/EIS Process Purpose & Need: • Provide additional bridge capacity/accommodate existing and projected travel demand • Relieve congested conditions on two existing river crossing corridors EDTM: Preparation of an EIS was determined to be the appropriate course of action Define & Evaluate Alternatives • Numerous corridors evaluated for 6-lane roadway and bridge crossing. • 6 of the 8 build alternatives, including a no-build evaluated in the EIS Purpose and Need 2002 Public Hearing 2011 Record of Decision 2014 Efficient Decision Making Define & Evaluate Alternatives Prepare Draft EIS Select Preferred Alternative Prepare Final EIS Project History/Overview
  • 7. City’s PD&E/EIS Process Purpose and Need 2002 Public Hearing 2011 Record of Decision 2014 Efficient Decision Making Define & Evaluate Alternatives Prepare Draft EIS Select Preferred Alternative Prepare Final EIS » Preparation of Draft EIS: • Minimization techniques to bridge environmentally sensitive lands/avoid temporary fill in wetlands during construction/maximize span lengths to reduce number of piers, and top down construction or use of temporary trestles • Developed in coordination with various federal and state agencies. » Public Hearing: September 22, 2011 – Over 400 people attended » Selection of Preferred Alternative: Alternative 1C selected November 11, 2011 and adopted by City on January 23, 2012 Project History/Overview
  • 8. City’s PD&E/EIS Process Purpose and Need 2002 Public Hearing 2011 Record of Decision 2014 Efficient Decision Making Define & Evaluate Alternatives Prepare Draft EIS Select Preferred Alternative Prepare Final EIS » Final EIS: • FHWA concurrence with selection of Alternative 1C • Signed by FHWA on November 14, 2013 » Record of Decision (ROD): February 24, 2014 signed by FHWA Project History/Overview » Final approval of Project and Alternative 1C corridor.
  • 9. Representative Corridor (RC) • RC was developed as “worst case scenario” • ERP submitted using RC approach • Mitigating the RC resolved FDEP’s concerns over the issuance of easements to the City to cross state park and sovereignty submerged lands (SSL) Project History/Overview
  • 10. FDEP Proprietary Mitigation: Water Quality Improvements Four Restoration Projects • Evans Creek • Site 5 West • Riverplace Upstream • Baffle Boxes at five locations Site 5 West –Before- Site 5 West –After- Project History/Overview
  • 11. FDEP Proprietary Mitigation: Recreational Savannas Recreation Area Trail • 1.25 mile multi-use trail • 8’ conc. with 3 boardwalk crossings Project History/Overview
  • 12. FDEP Proprietary Mitigation: Recreational Savannas Preserve State Park Education Center Improvements Project History/Overview Halpatiokee Trail Canoe Access Replacement
  • 13. Crosstown Parkway Segment 1 » From Manth Lane to US-1/Village Green Dr (Alt. 1C) » 1.5 miles roadway improvements in 330 ft R/W • 3 lanes in each direction • Bicycle lanes and pedestrian paths on both sides of road • Landscaped berm » 4,000 foot long bridge over North Fork of St. Lucie River • Signature bridge • Architectural towers at bridge approaches with art Project History/Overview
  • 14. Design-Build Process » FDOT District 4 Local Agency Program (LAP) Design-Build » Procurement by City using FDOT procedures » 3 City staff and 1 from FDOT District 4 on Technical Review and Selection Committees » City Engineer and 1 from FDOT District 4 on Alternative Technical Concepts (ATC) Committee » Planned Advertisement - March 20, 2014 » Official Advertisement - July 1, 2014 Design-Build Process
  • 15. Phase I » Expanded Letter of Interest (ELOI) oProject Experience and Resources oProject Approach and Understanding of Critical Issues » 20 Maximum Points, carried into Technical Score » Self-Shortlist based on Scores » 11 Design-Build Teams submitted ELOIs July 31, 2014 » CEI Selection - August 8, 2014: Target/Cardno » ELOI Scores provided - September 9, 2014 » Shortlist - September 25, 2014, 5 teams moved forward Design-Build Process
  • 16. Phase II » Pre-proposal Meeting/RFP Provided - October 7, 2014 » ATC Meetings/Submittals - October 28-December 2, 2014 » Final ATC Decisions - December 16, 2014 » Technical Proposals Due - January 13, 2015 (80 points max) » Page Turn Meeting - January 16, 2015 » Question and Answer Session - February 18, 2015 » Technical Scores Announced/Price Proposals Due - May 19, 2015 (Let Date) » Maximum Bid Price: $101,854,000 » Adjusted Scoring: Bid Price/Technical Score Design-Build Process
  • 17. Archer Western/RS&H Team Approach » Brainstormed for ATCs/Innovations • How to improve project • Not just cut costs • Provide best value to City/FDOT • Reduce maintenance, wetland impacts » Build Bridge from Temporary Trestle • Longer spans • Reduced cost/construction duration • Reduced wetland impacts Approach: Overview
  • 18. ATCs & Innovations » Developed potential ATCs and discussed at two ATC meetings » Submitted 19 ATCs in 4 submittals » 8 ATCs approved and implemented in Technical Proposal. 2 resulted in RFP changes for all to implement » Non-ATC Enhancements • Move U-Turns between Manth Ln and Preston Ln to improve safety (doubled distance for vehicle crossover) • Perform geotechnical investigations from temporary trestle, eliminating need for separate permit • Produce project visualization Approach: ATCs/Innovations
  • 19. Superstreet Intersection (Floresta Dr) Intersection Design N Approach: Superstreet
  • 20. Superstreet is a Restricted Crossing U-Turn intersection (FHWA) » Specifically designed to accommodate heavy through-to- side street traffic ratios. » All turns from main road are same as traditional intersection. » Effective in improving travel time and reducing delays » Time savings for vehicles with simplified signal phasing » Increased safety by reducing conflict points at major crossovers Superstreet Intersection (Floresta Dr) Approach: Superstreet
  • 21. Minor Street (Floresta)Turning Movements Left Turn Movement Through Movement
  • 22. Superstreet Intersection (Floresta Dr) Arterial traffic movements are same as traditional intersection Cross street traffic must turn right. Cross street left turn and thru traffic makes a U-turn Cross street thru traffic turns right Cross street left turn traffic moves thru Signals operate independently in each direction Approach: Superstreet
  • 23. »North Carolina •Chapel Hill: US 15/Erwin Road •Holly Springs: SR 55 Corridor (Multiple Intersections) •Leland: US 17 Corridor (Multiple Intersections) »Ohio •Fairfield: SR 4 Corridor (Multiple Intersections) »Texas •San Antonio: US 281 Corridor (Multiple Intersections) »Michigan, Louisiana, Maryland, Utah, South Carolina Successful Superstreets in Other States Approach: Superstreet
  • 24. Superstreet Intersection (Floresta Dr) » RS&H evaluated Traffic Level of Service (LOS) of RFP Concept intersection while preparing Alternative Technical Concepts (ATCs) » Discovered RFP Concept design produced LOS E for 2017 and LOS F for 2037 (using traffic volumes from EIS) » RS&H Traffic Engineers recommended analysis of superstreet intersection. Also analyzed roundabout and Michigan Left » Superstreet intersection produced LOS B for 2017 and LOS C for 2037 Approach: Superstreet
  • 25. Superstreet Benefits Approach: Superstreet Measurement Criteria Traditional Intersection Superstreet Intersection Improvement Opening Year (2017) Level Of Service E B 3 Levels Design Year (2037) Level Of Service F C 3 Levels Conflict Points 32 14 56% fewer Average Delay Time 122.6 seconds 14.7 seconds 8 times faster
  • 26. » Conflict Points reduced from 32 to 14 (56% reduction) compared to traditional 4-leg intersection • Fewer crashes • Less severe crashes » Pedestrian safety • Large median refuge • Conflict between pedestrians and left-turning vehicles on Crosstown Parkway eliminated • Conflict points reduced from 24 to 8 (67% reduction) » Floresta Drive remains a neighborhood street. » Emergency vehicles traverse mountable curb in median. Safety Improvements of Superstreet Approach: Superstreet
  • 27. Safety Improvements of Superstreet Traditional Intersection: 32 conflicts Approach: Superstreet Superstreet Intersection: 14 conflicts
  • 28. Other Added Value » Additional ATCs that purely add value: • Provide overlooks on bridge • Segmental block walls • Implement Safety Edge™ Bridge Overlook Segmental Block Walls Approach: Other Added Value
  • 29. Design-Build Procurement Results » Archer Western/RS&H Team achieved highest technical score and lowest bid! » Bid price nearly $15M below maximum Design-Build Procurement Results
  • 30. Post-Award Partnering » Project changes to improve project and reduce long-term maintenance » Some items reducing cost » Scope additions • Two additional trail heads • Water fountains along trail • Directional bore WM Post-Award Partnering
  • 31. Where are we now? »100% Plans under review »SFWMD Permit - Administrative Hearing July 2016 »Anticipate construction to commence late 2016 »990 total contract days »Project completion in 2018 Project Status
