Progressive Design-Build Delivery of
Multiple, Complex Utility Infrastructure
Projects: The City of Tampa’s Utility
Capital Improvement Projects

              Florida Chapter of APWA
      2012 APWA Annual Meeting and Trade Show
                   Tampa, Florida
                    April 3, 2012

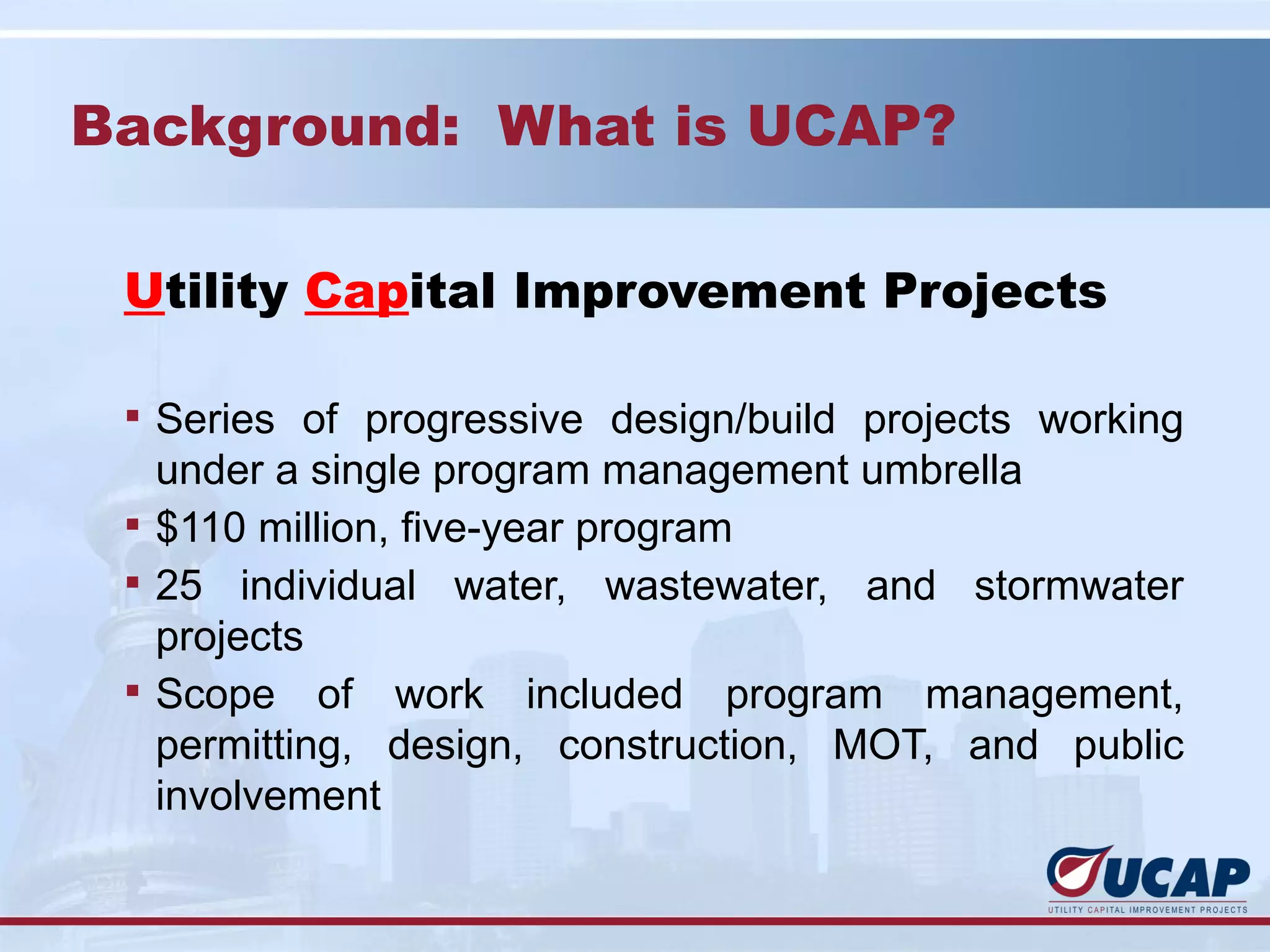

Background: What is UCAP?

 Utility Capital Improvement Projects

 § Series of progressive design/build projects working
   under a single program management umbrella
 § $110 million, five-year program
 § 25 individual water, wastewater, and stormwater
   projects
 § Scope of work included program management,
   permitting, design, construction, MOT, and public
   involvement

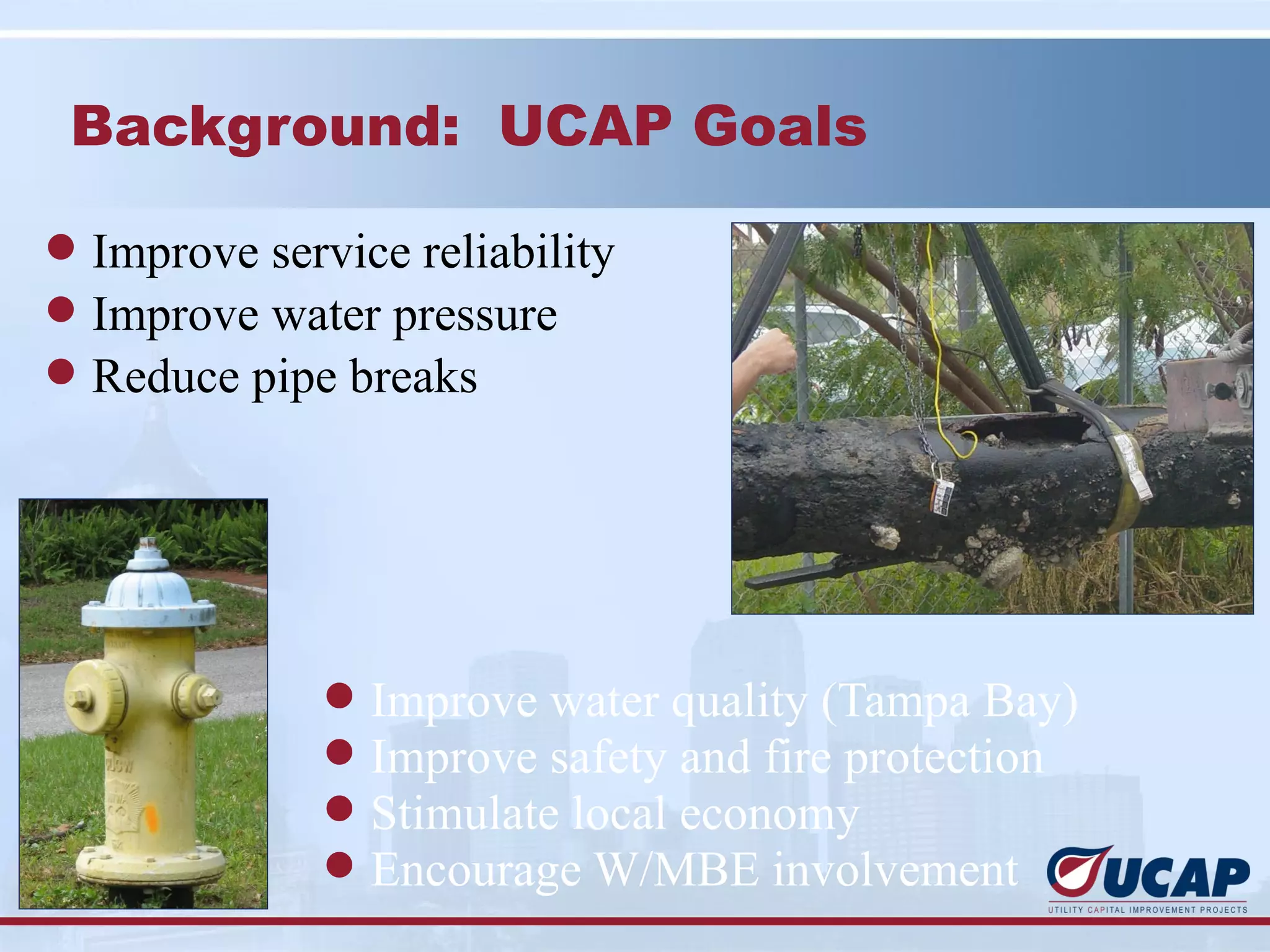

Background: UCAP Goals

l Improve service reliability
l Improve water pressure
l Reduce pipe breaks

              l   Improve water quality (Tampa Bay)
              l   Improve safety and fire protection
              l   Stimulate local economy
              l   Encourage W/MBE involvement

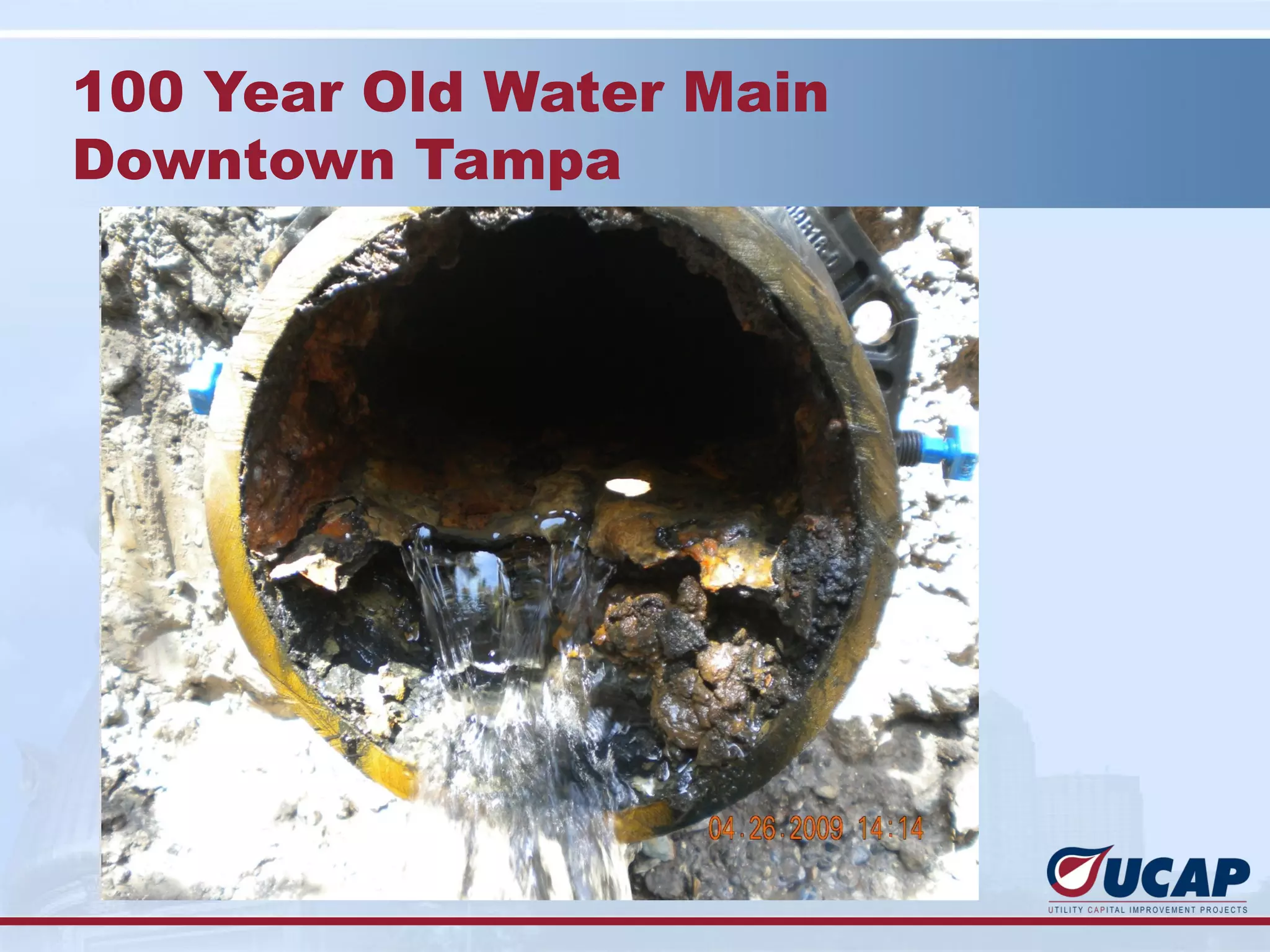

100 Year Old Water Main
Downtown Tampa

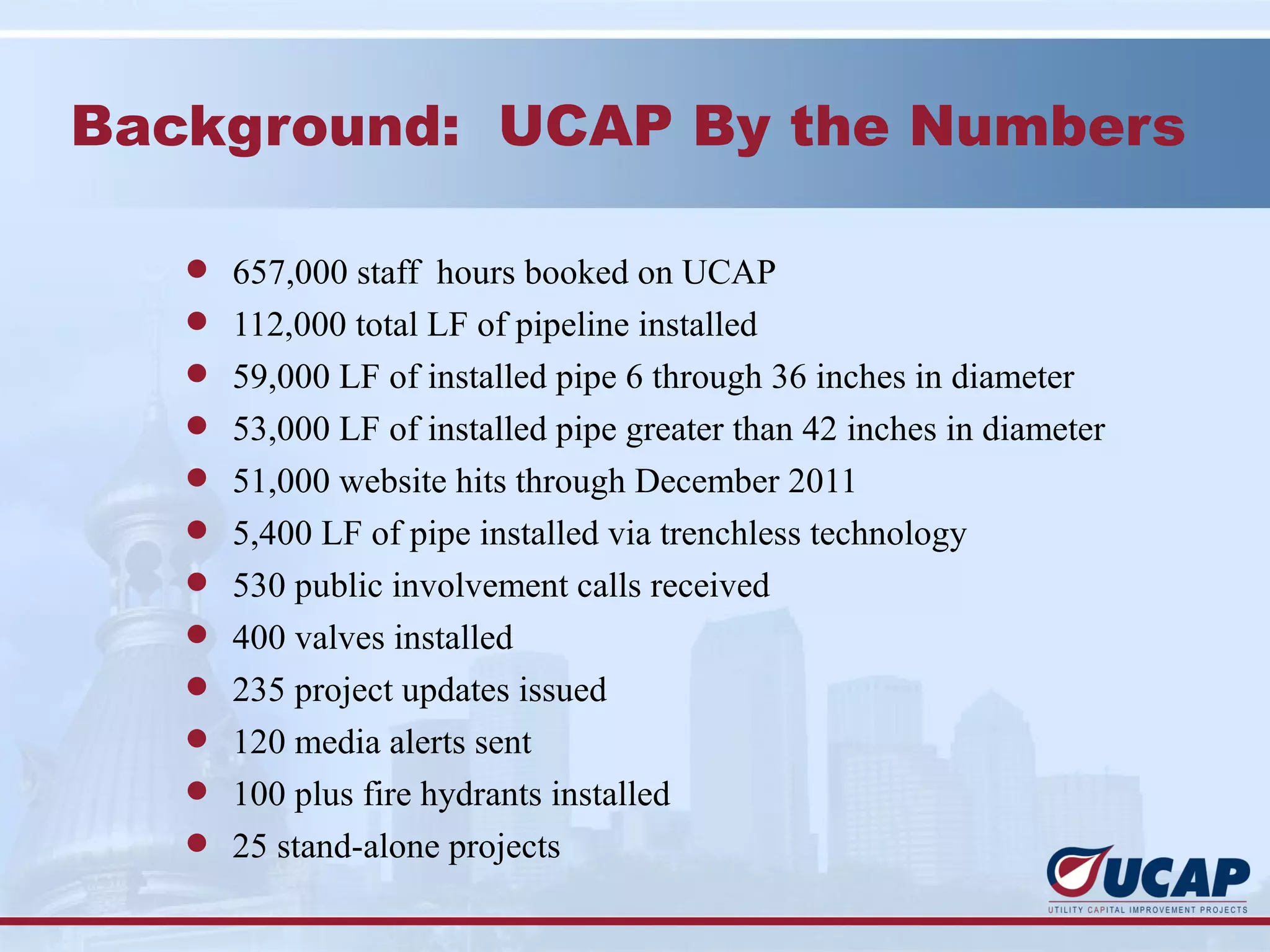

Background: UCAP By the Numbers

   l 657,000 staff hours booked on UCAP
   l 112,000 total LF of pipeline installed
   l 59,000 LF of installed pipe 6 through 36 inches in diameter
   l 53,000 LF of installed pipe greater than 42 inches in diameter
   l 51,000 website hits through December 2011
   l 5,400 LF of pipe installed via trenchless technology
   l 530 public involvement calls received
   l 400 valves installed
   l 235 project updates issued
   l 120 media alerts sent
   l 100 plus fire hydrants installed
   l 25 stand-alone projects

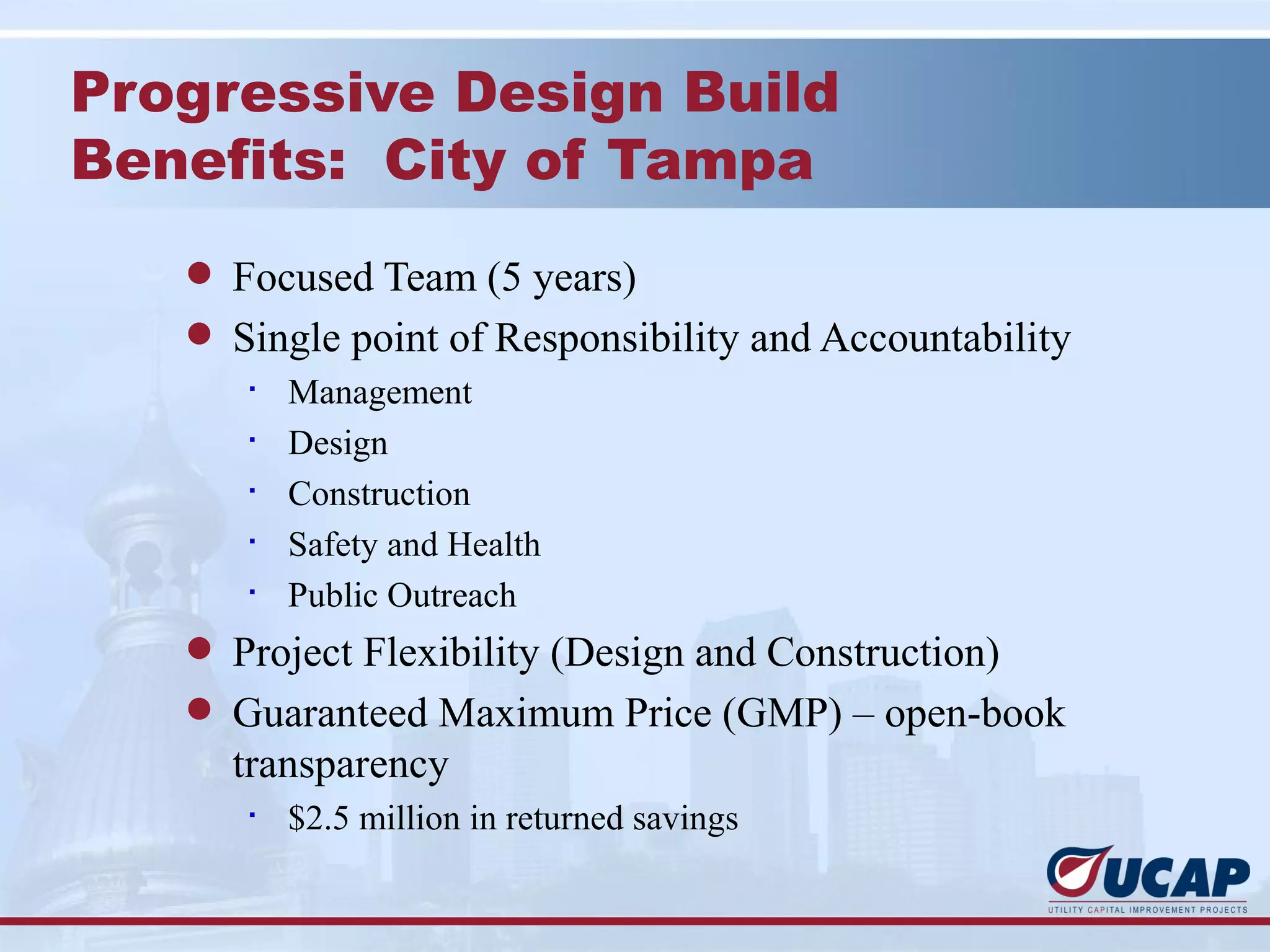

Progressive Design Build
Benefits: City of Tampa
   l Focused Team (5 years)
   l Single point of Responsibility and Accountability
      §
          Management
      §
          Design
      §
          Construction
      §
          Safety and Health
      §
          Public Outreach
   l Project Flexibility (Design and Construction)
   l Guaranteed Maximum Price (GMP) – open-book
     transparency
      §
          $2.5 million in returned savings
Benefit: Focused Team
Qualifications Based Selection
Benefit: Single Point of Responsibility

                               PROGRAM
                              MANAGEMEN
                                   T
                                 Tier 1

                                     D
                                     E
                                     Ti
                                     S
                                    er
                                     I
                                     2
                                     G
                                     N
                                    CONSTRUCTI
                                         ON
                                        Tier 3
Benefit: Single Point of Accountability

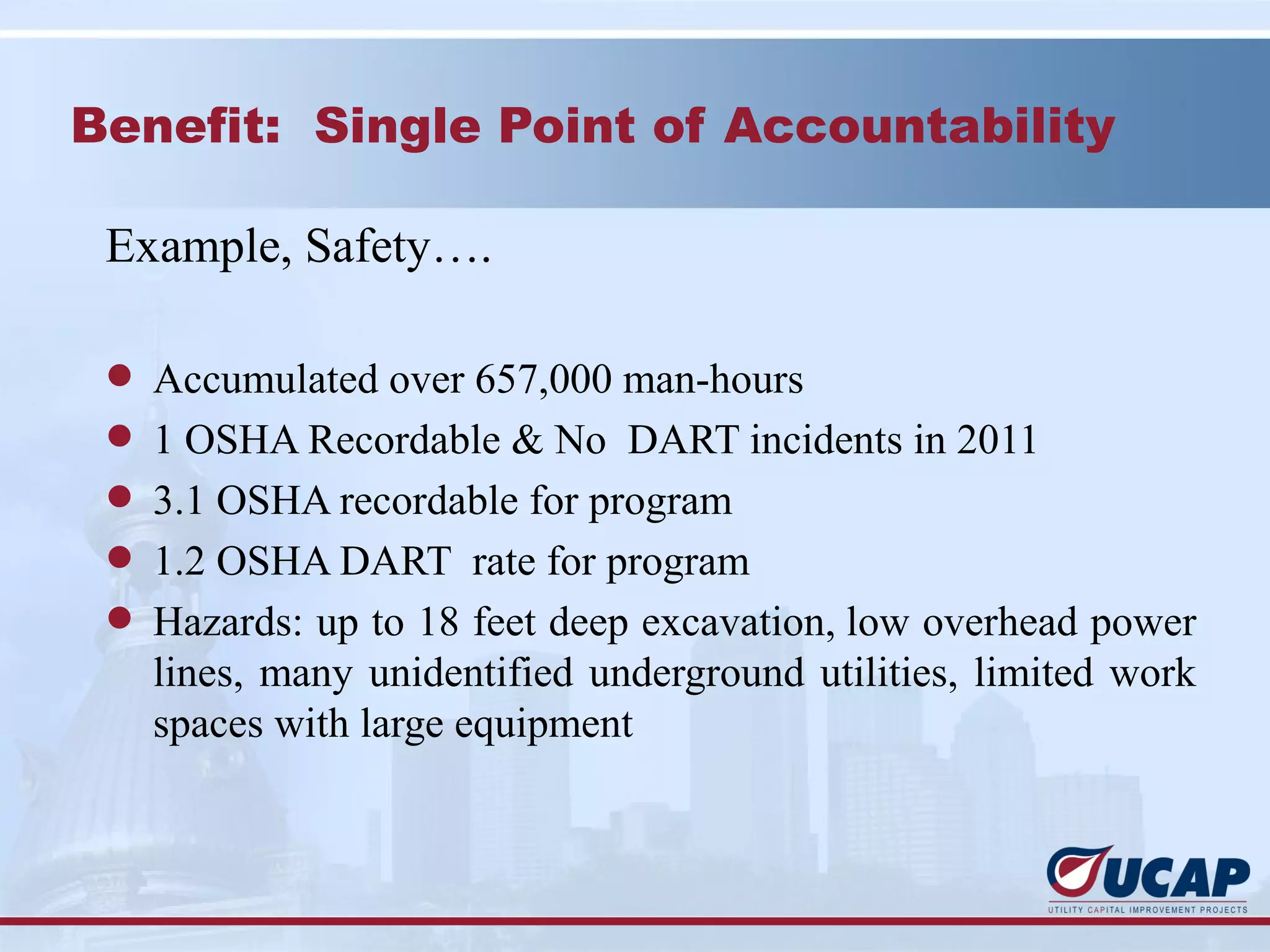

 Example, Safety….

 l Accumulated over 657,000 man-hours
 l 1 OSHA Recordable & No DART incidents in 2011
 l 3.1 OSHA recordable for program
 l 1.2 OSHA DART rate for program
 l Hazards: up to 18 feet deep excavation, low overhead power
   lines, many unidentified underground utilities, limited work
   spaces with large equipment

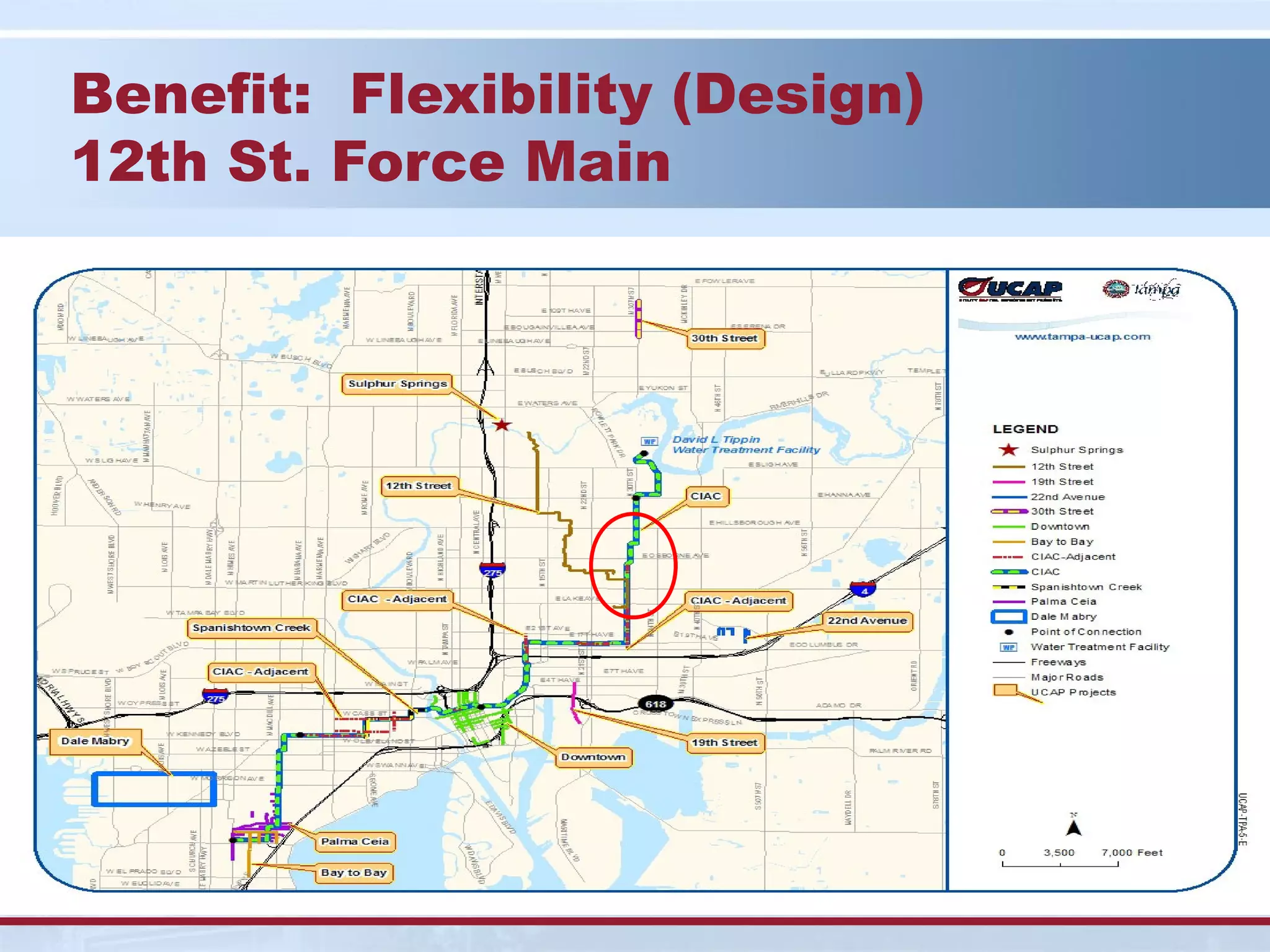

Benefit: Flexibility (Design)

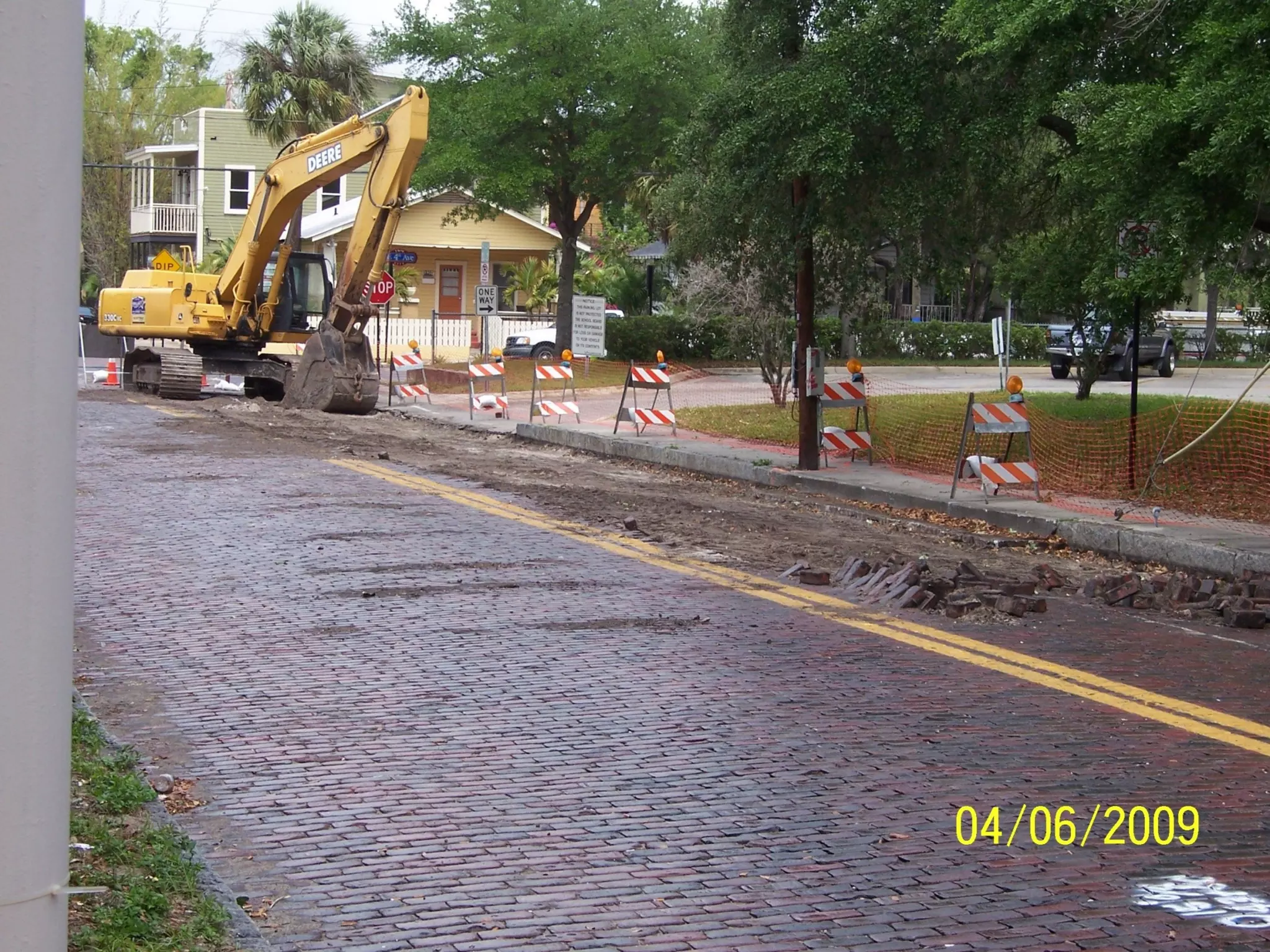

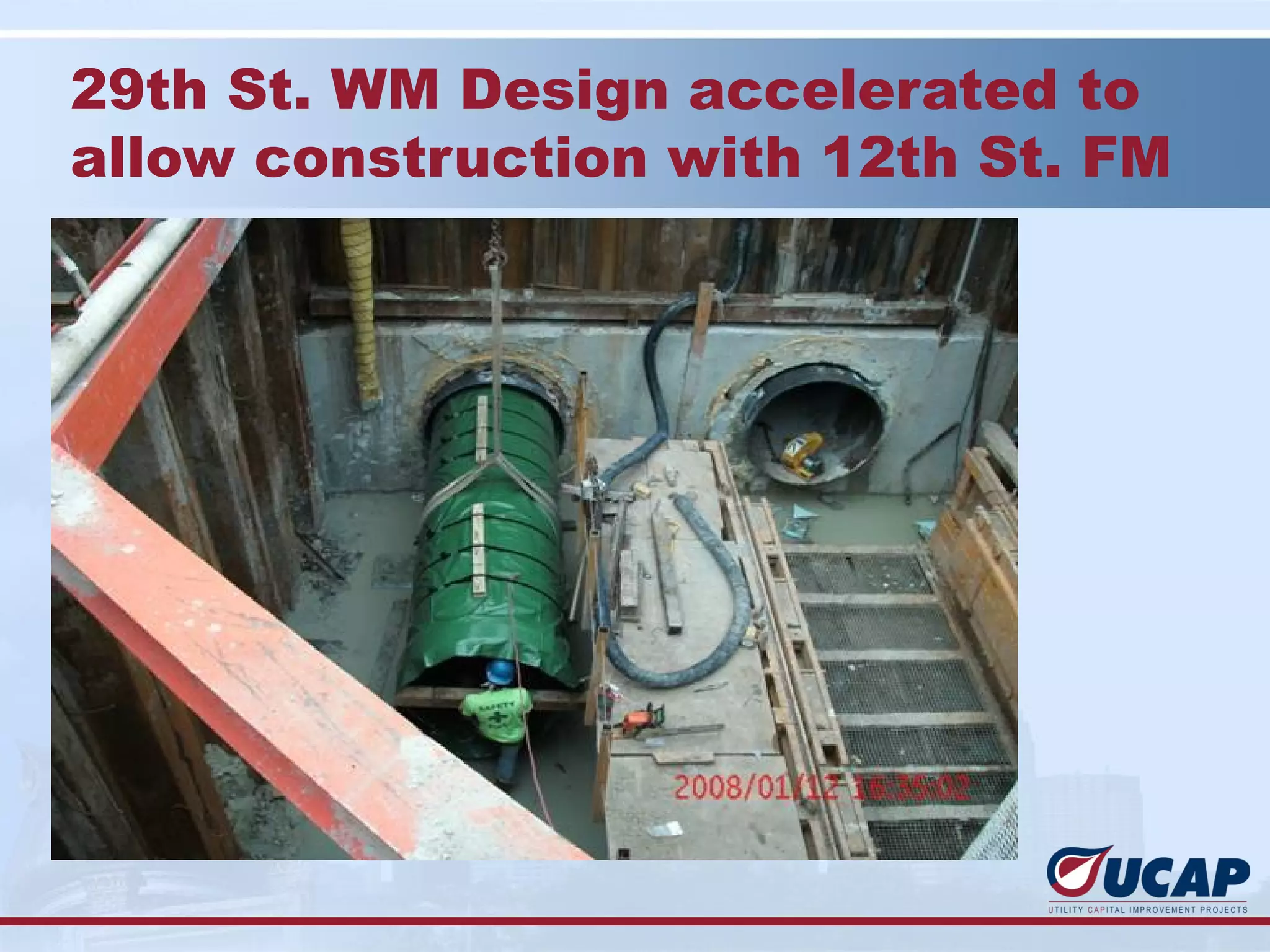

12th St. Force Main
29th St. WM Design accelerated to
allow construction with 12th St. FM

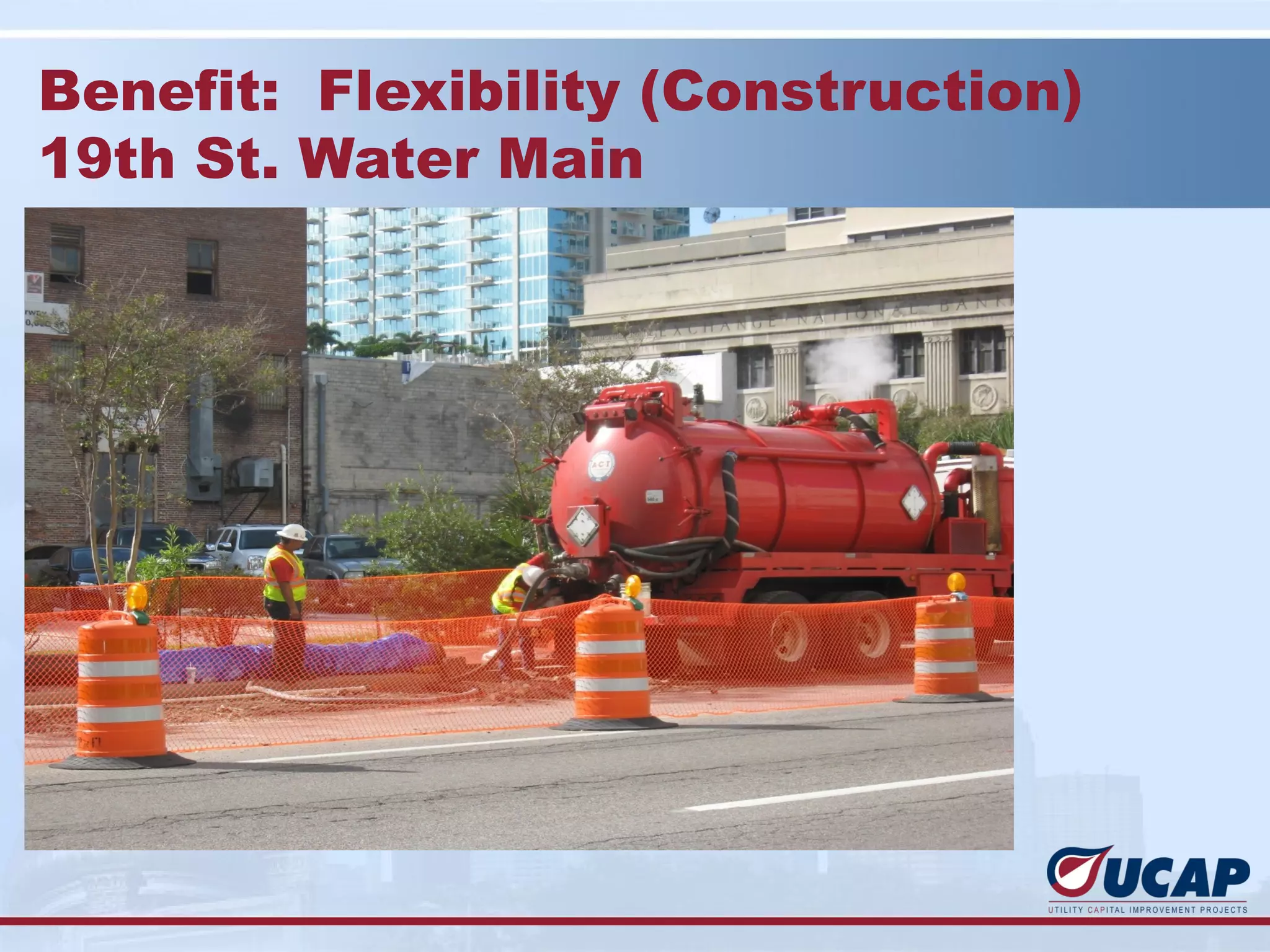

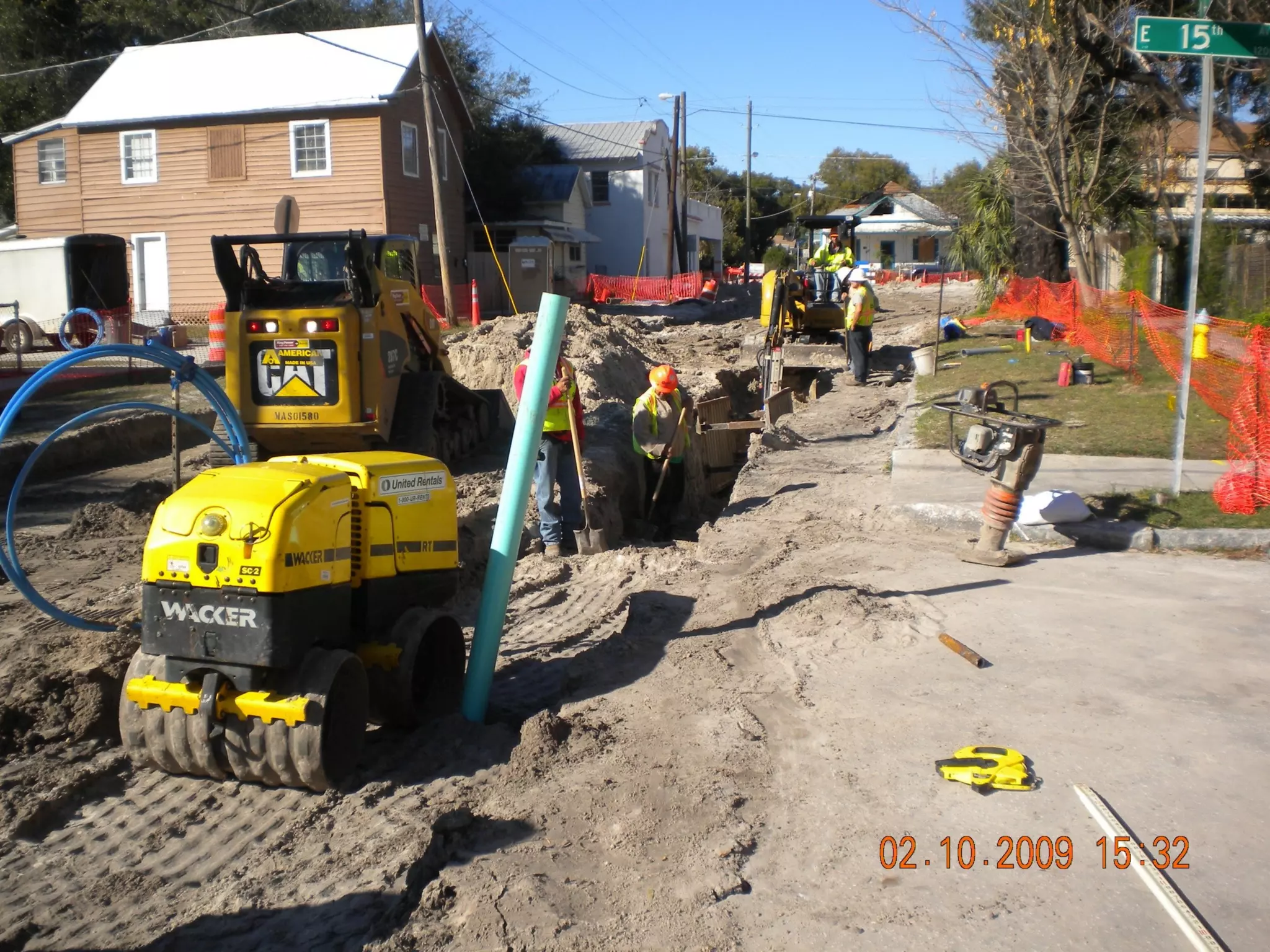

Benefit: Flexibility (Construction)

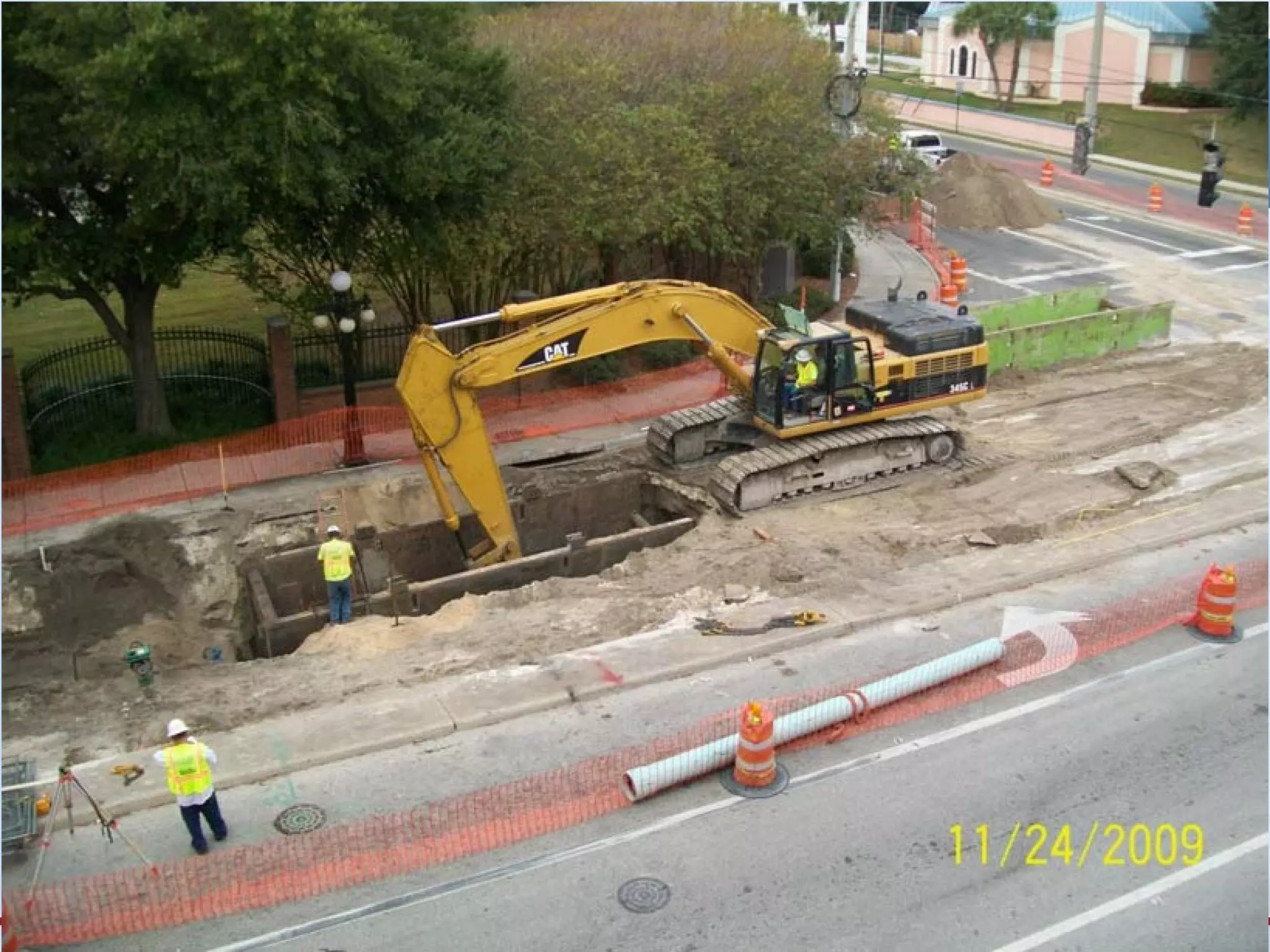

19th St. Water Main

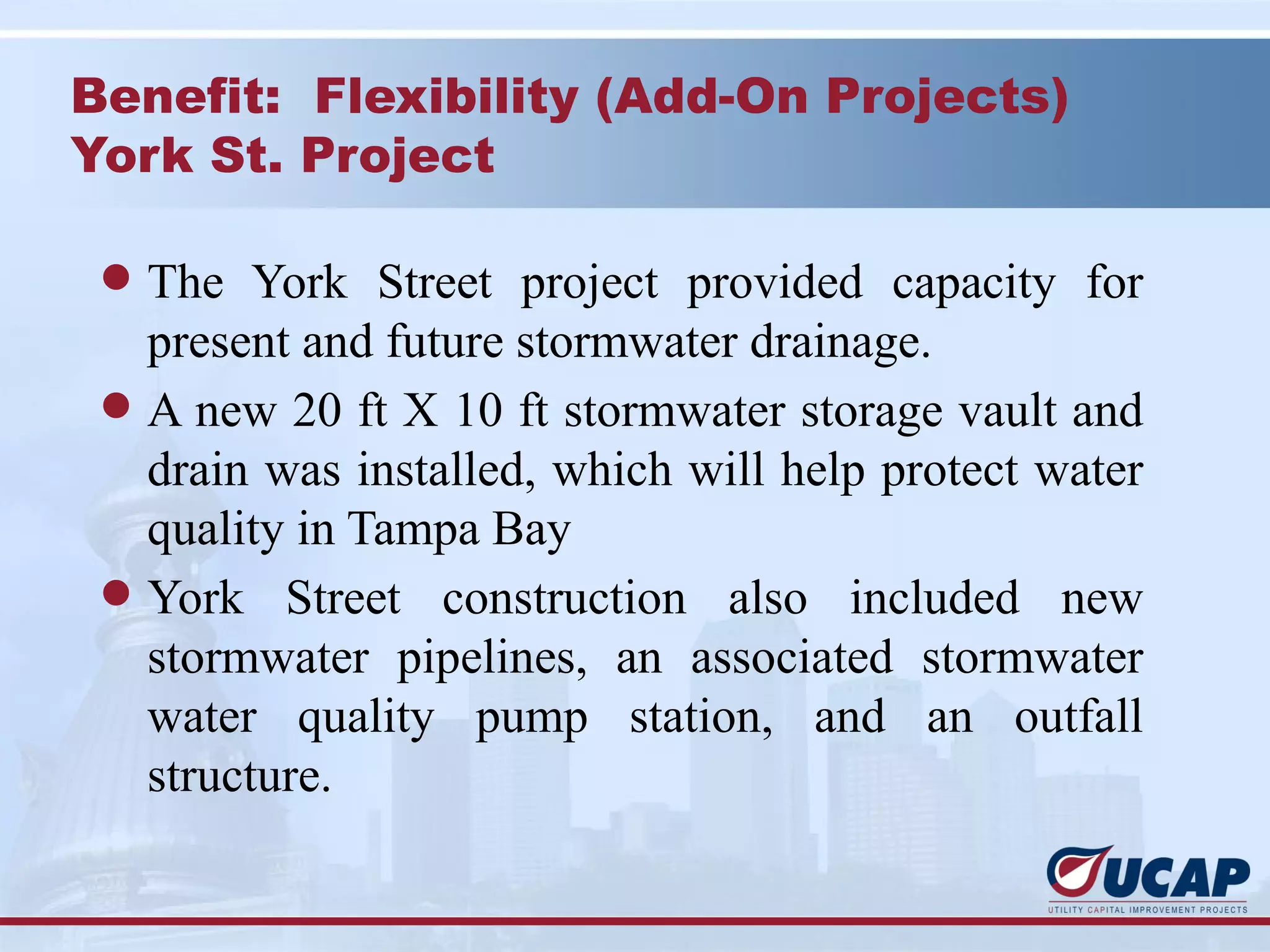

Benefit: Flexibility (Add-On Projects)
York St. Project

 l The York Street project provided capacity for
   present and future stormwater drainage.
 l A new 20 ft X 10 ft stormwater storage vault and
   drain was installed, which will help protect water
   quality in Tampa Bay
 l York Street construction also included new
   stormwater pipelines, an associated stormwater
   water quality pump station, and an outfall
   structure.

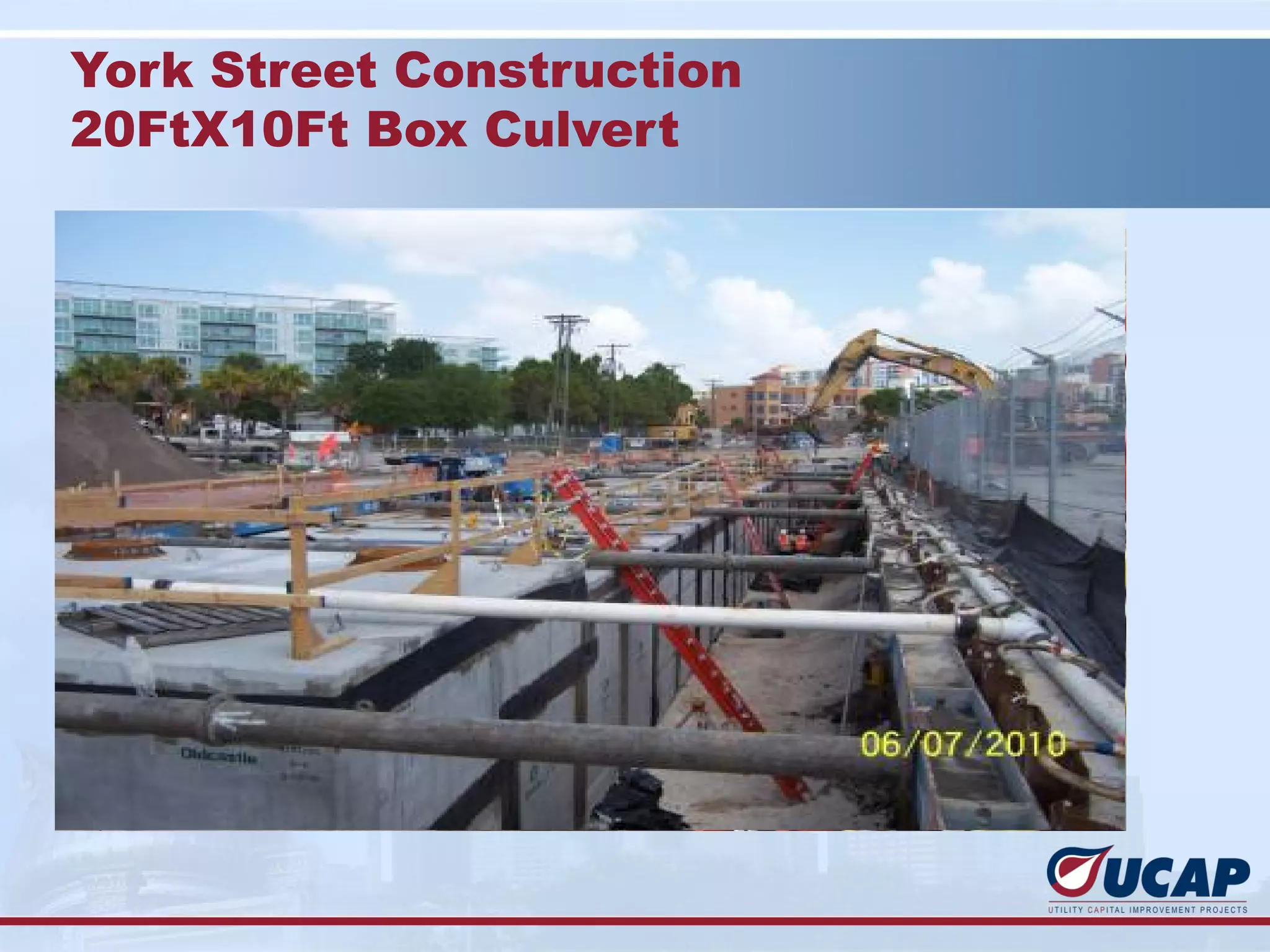

York Street Construction
20FtX10Ft Box Culvert
Open for Business….

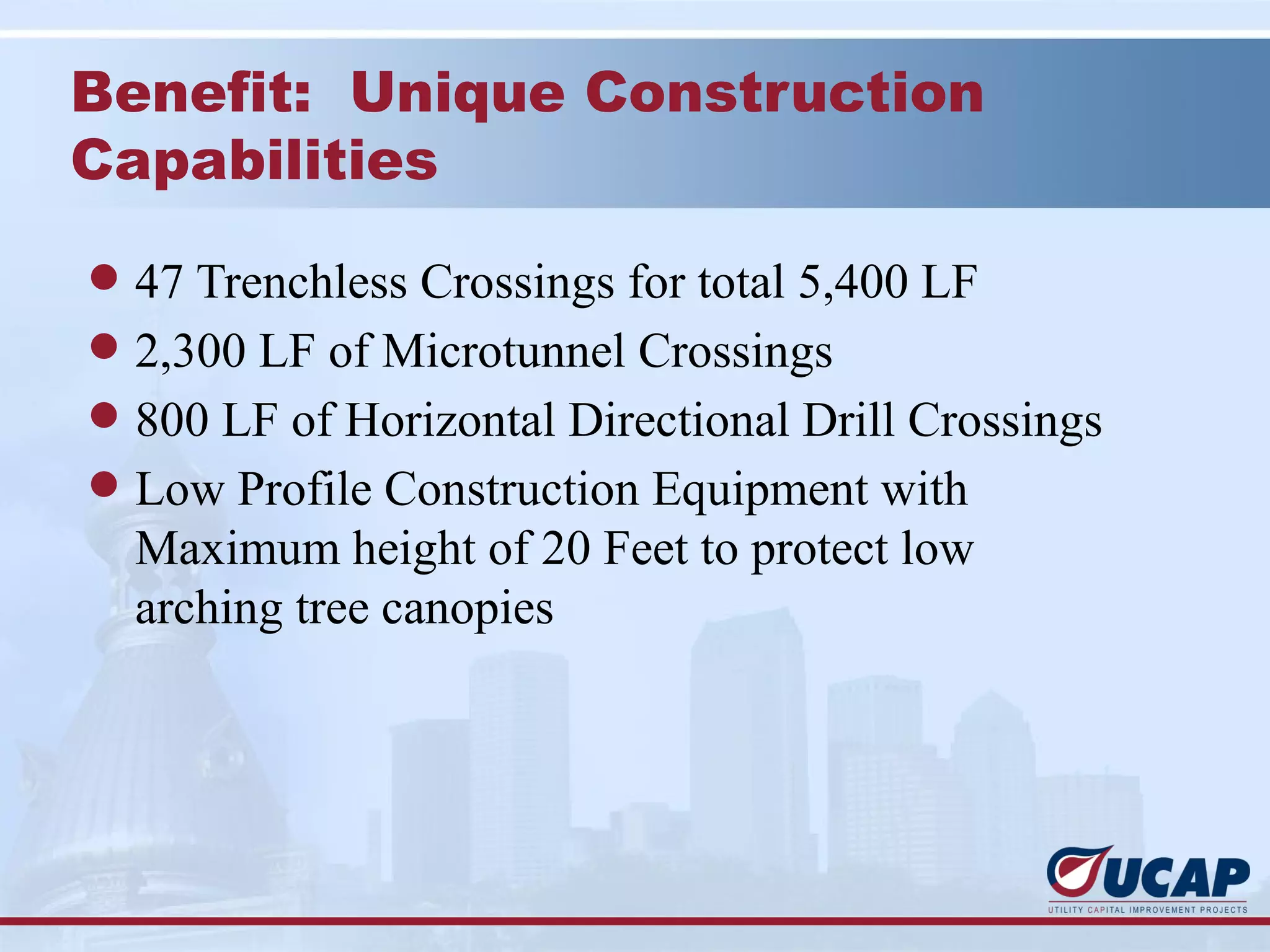

Benefit: Unique Construction
Capabilities

l 47 Trenchless Crossings for total 5,400 LF
l 2,300 LF of Microtunnel Crossings
l 800 LF of Horizontal Directional Drill Crossings
l Low Profile Construction Equipment with
  Maximum height of 20 Feet to protect low
  arching tree canopies

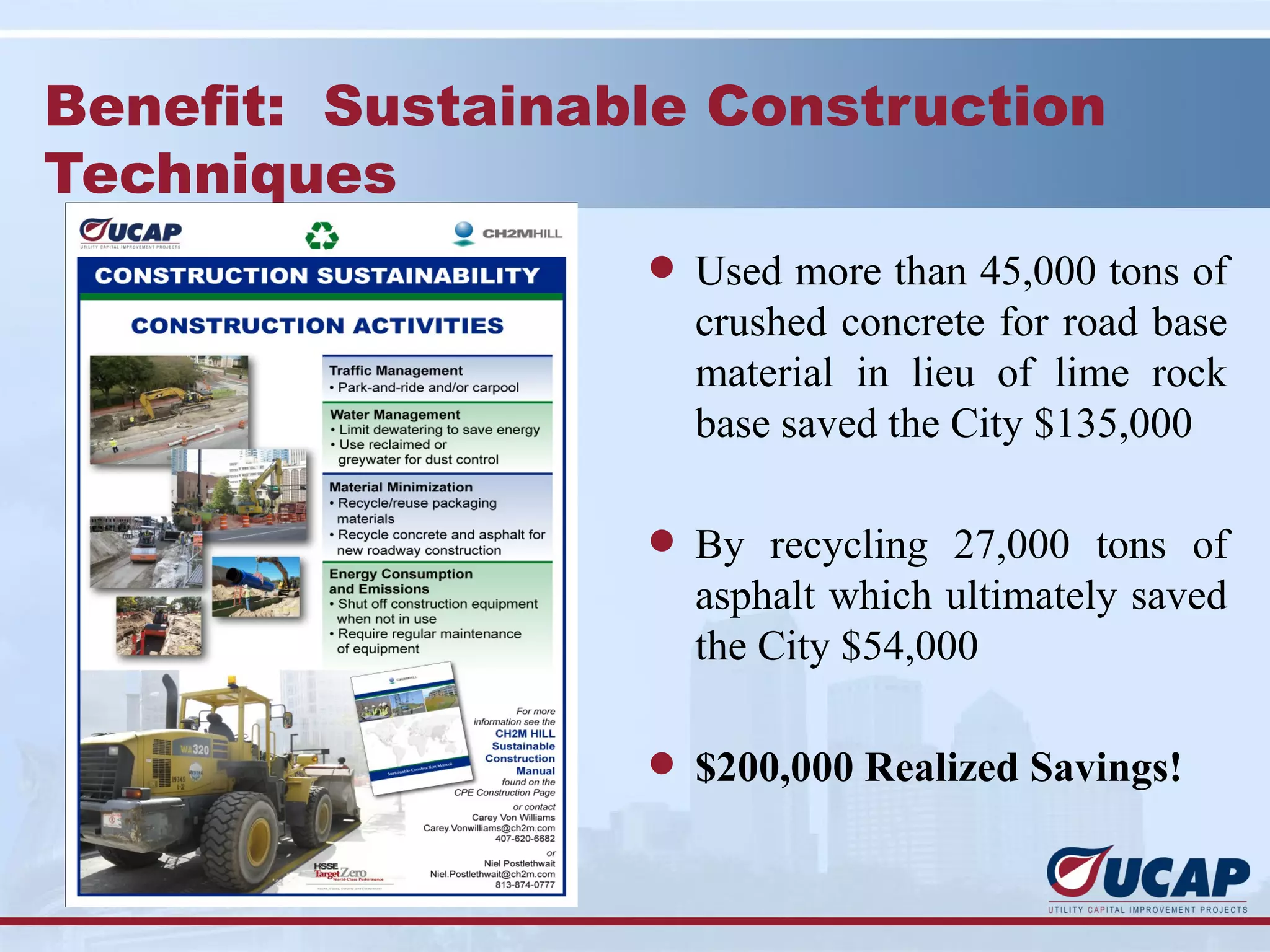

Benefit: Sustainable Construction
Techniques
                  l Used more than 45,000 tons of
                    crushed concrete for road base
                    material in lieu of lime rock
                    base saved the City $135,000

                  l By recycling 27,000 tons of
                    asphalt which ultimately saved
                    the City $54,000

                  l $200,000 Realized Savings!

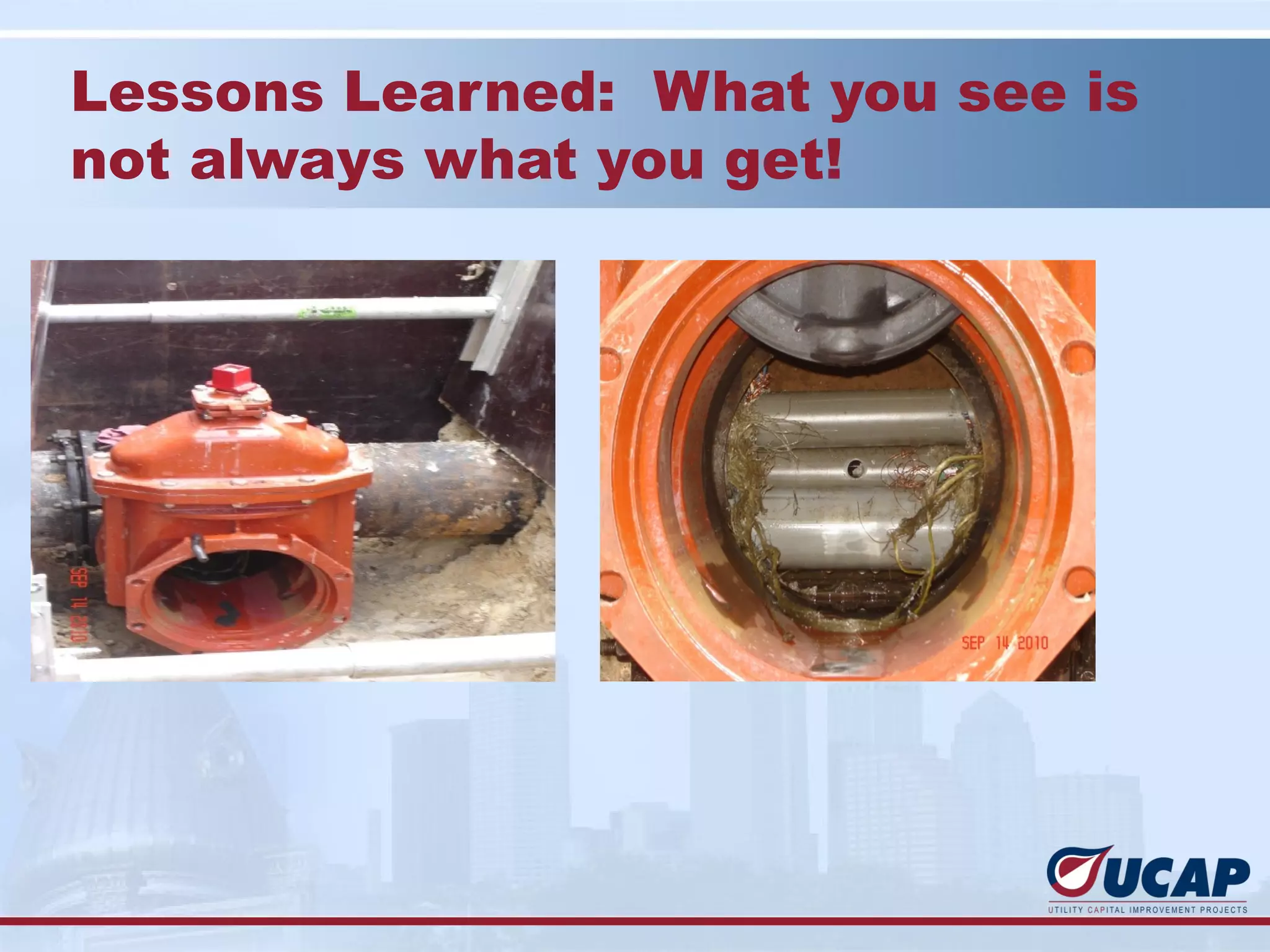

Lessons Learned: What you see is
not always what you get!

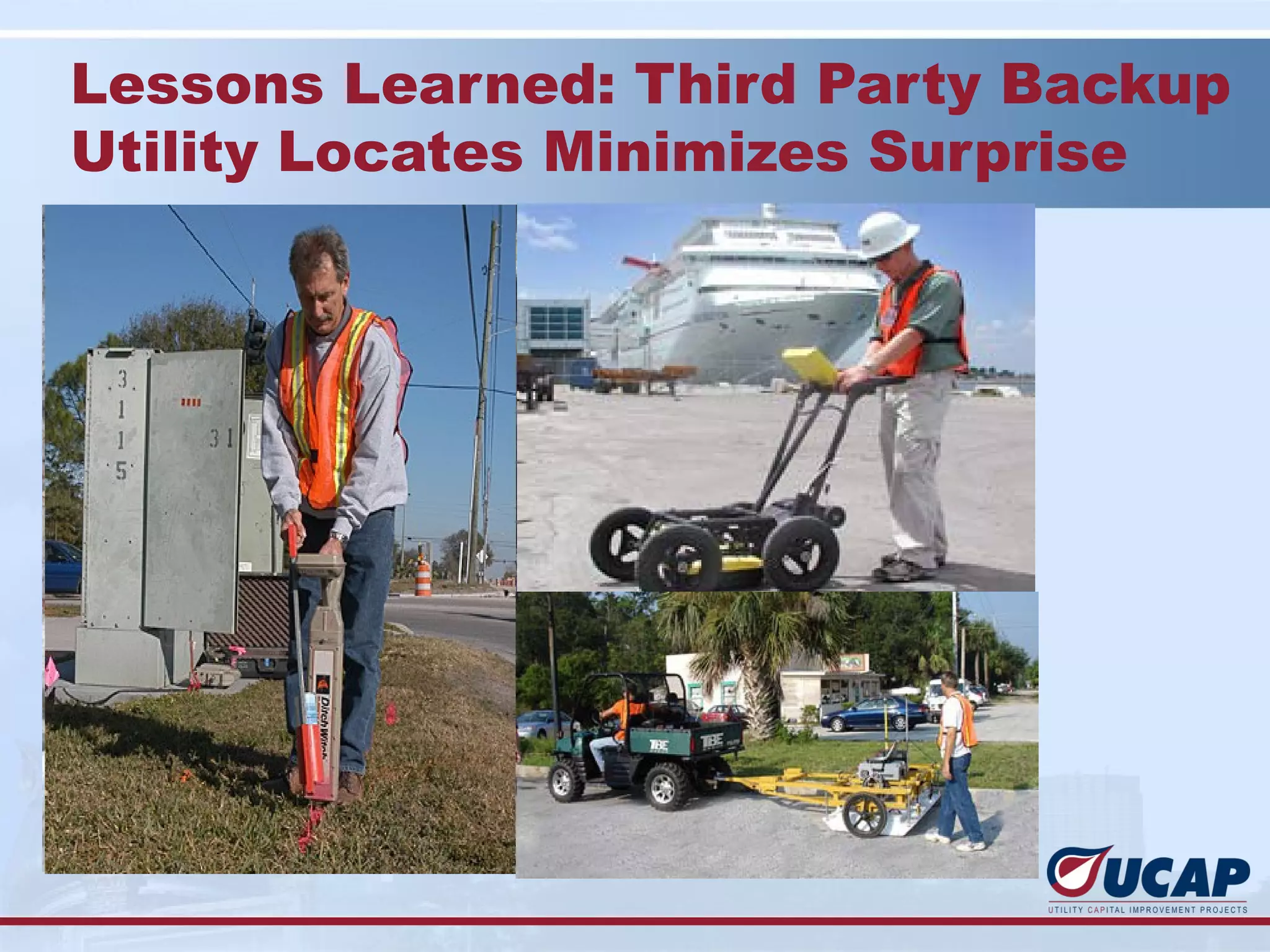

Lessons Learned: Third Party Backup
Utility Locates Minimizes Surprise

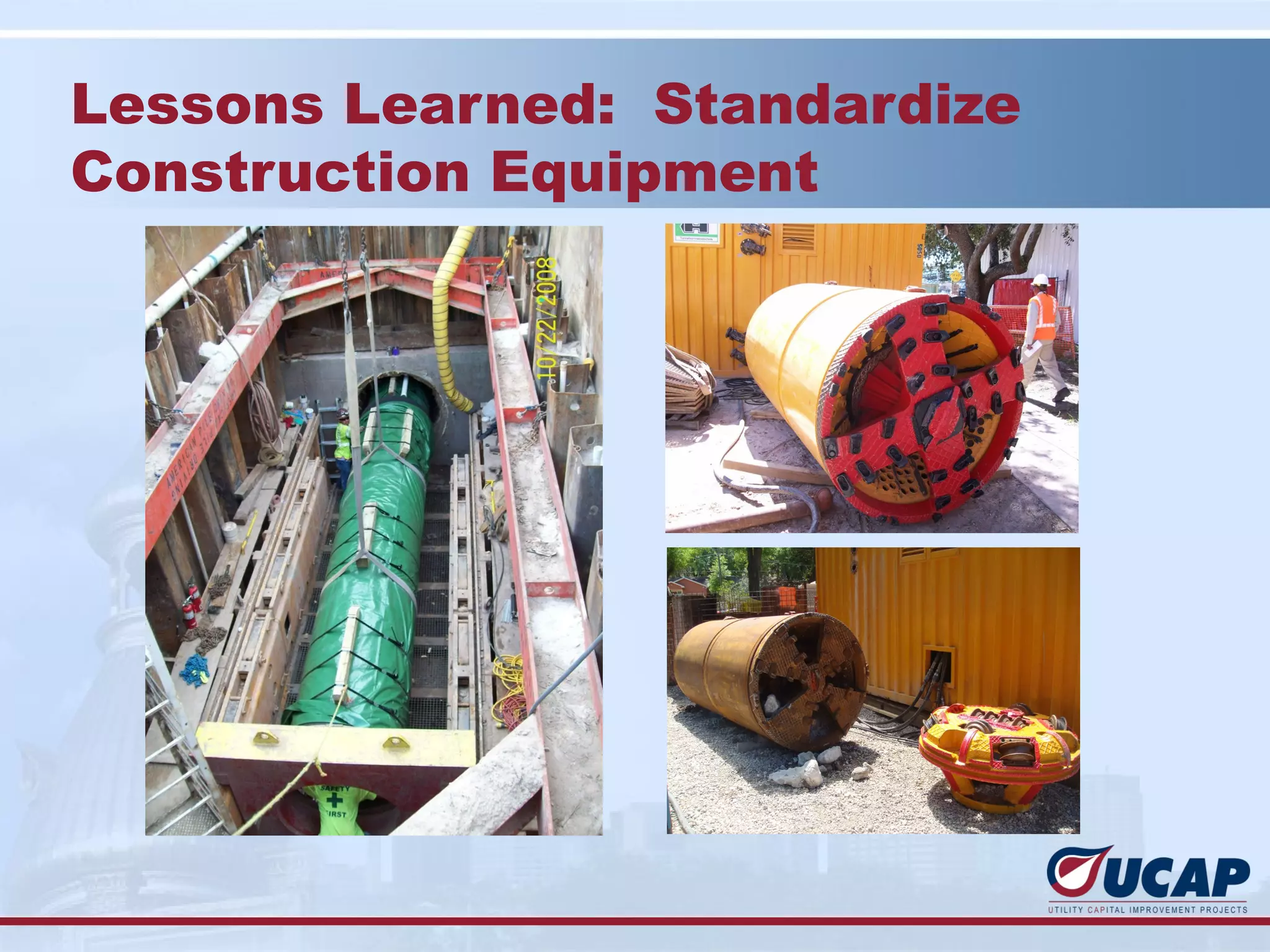

Lessons Learned: Standardize
Construction Equipment

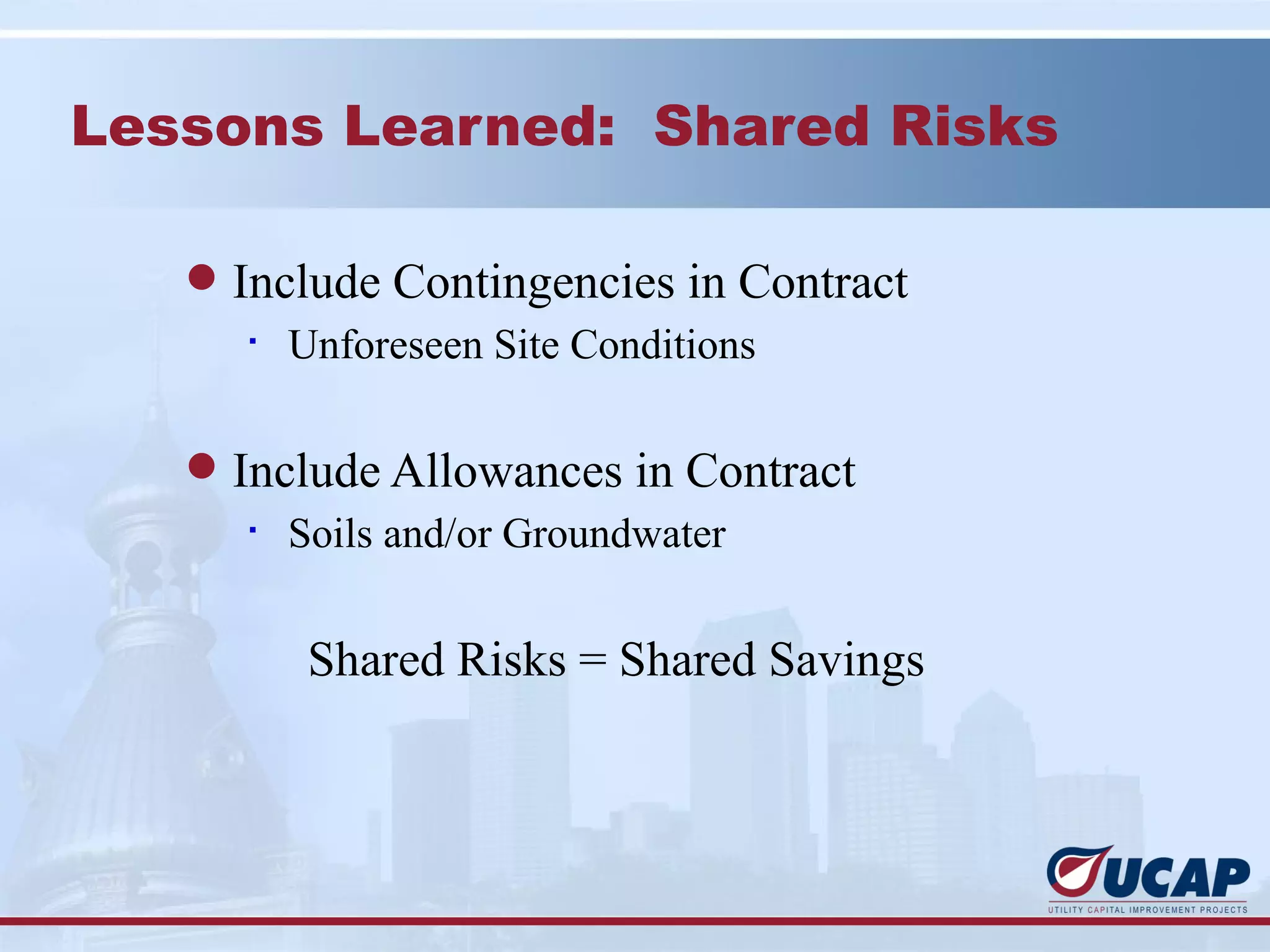

Lessons Learned: Shared Risks

   l Include Contingencies in Contract
      §
        Unforeseen Site Conditions

   l Include Allowances in Contract
      §
        Soils and/or Groundwater

        Shared Risks = Shared Savings

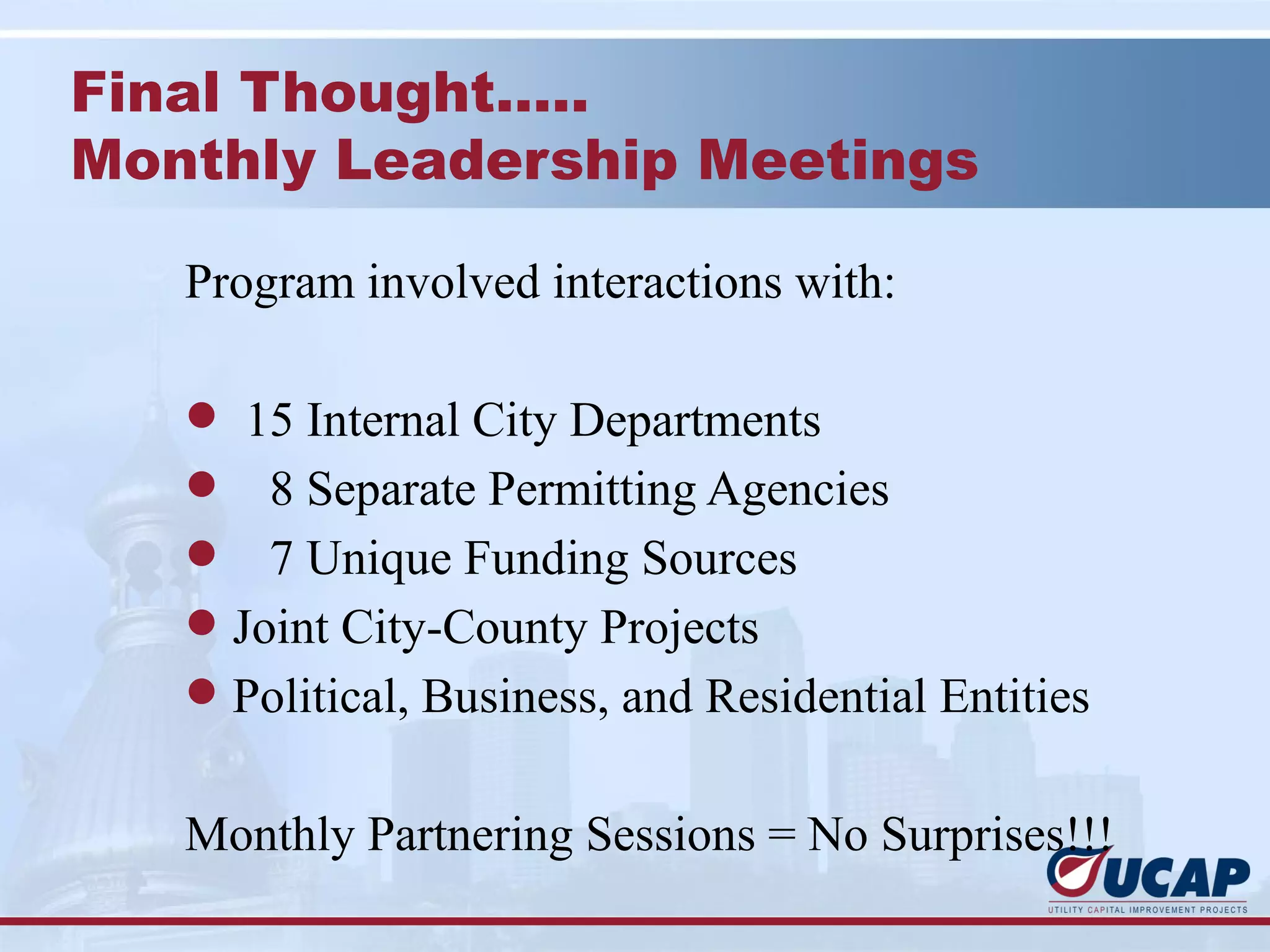

Final Thought…..
Monthly Leadership Meetings

   Program involved interactions with:

   l 15 Internal City Departments
   l 8 Separate Permitting Agencies
   l   7 Unique Funding Sources
   l Joint City-County Projects
   l Political, Business, and Residential Entities

   Monthly Partnering Sessions = No Surprises!!!
Public Outreach

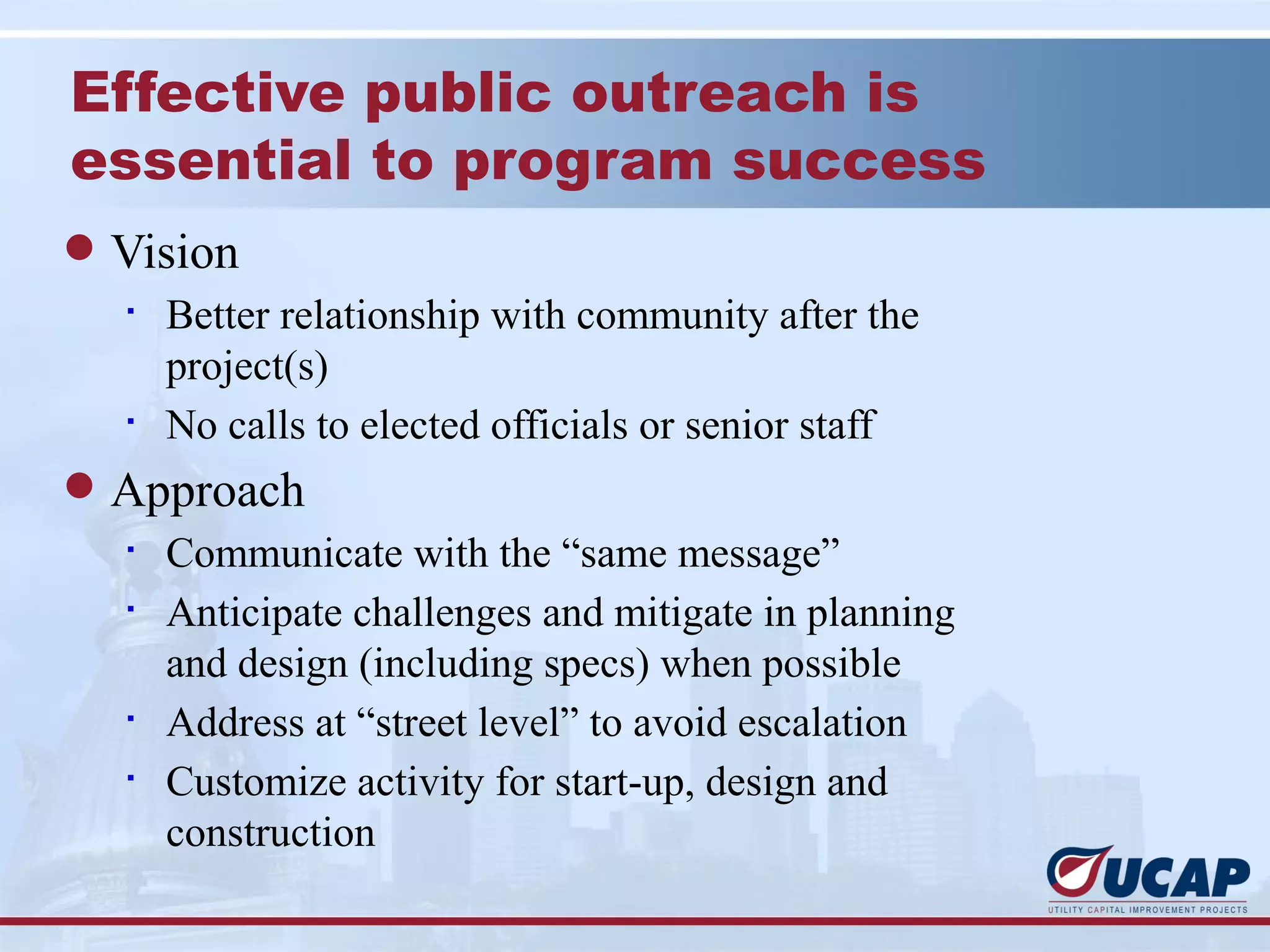

Effective public outreach is
essential to program success
l Vision
  §
    Better relationship with community after the
    project(s)
  §
    No calls to elected officials or senior staff
l Approach
  §
    Communicate with the “same message”
  §
    Anticipate challenges and mitigate in planning
    and design (including specs) when possible
  §
    Address at “street level” to avoid escalation
  §
    Customize activity for start-up, design and
    construction

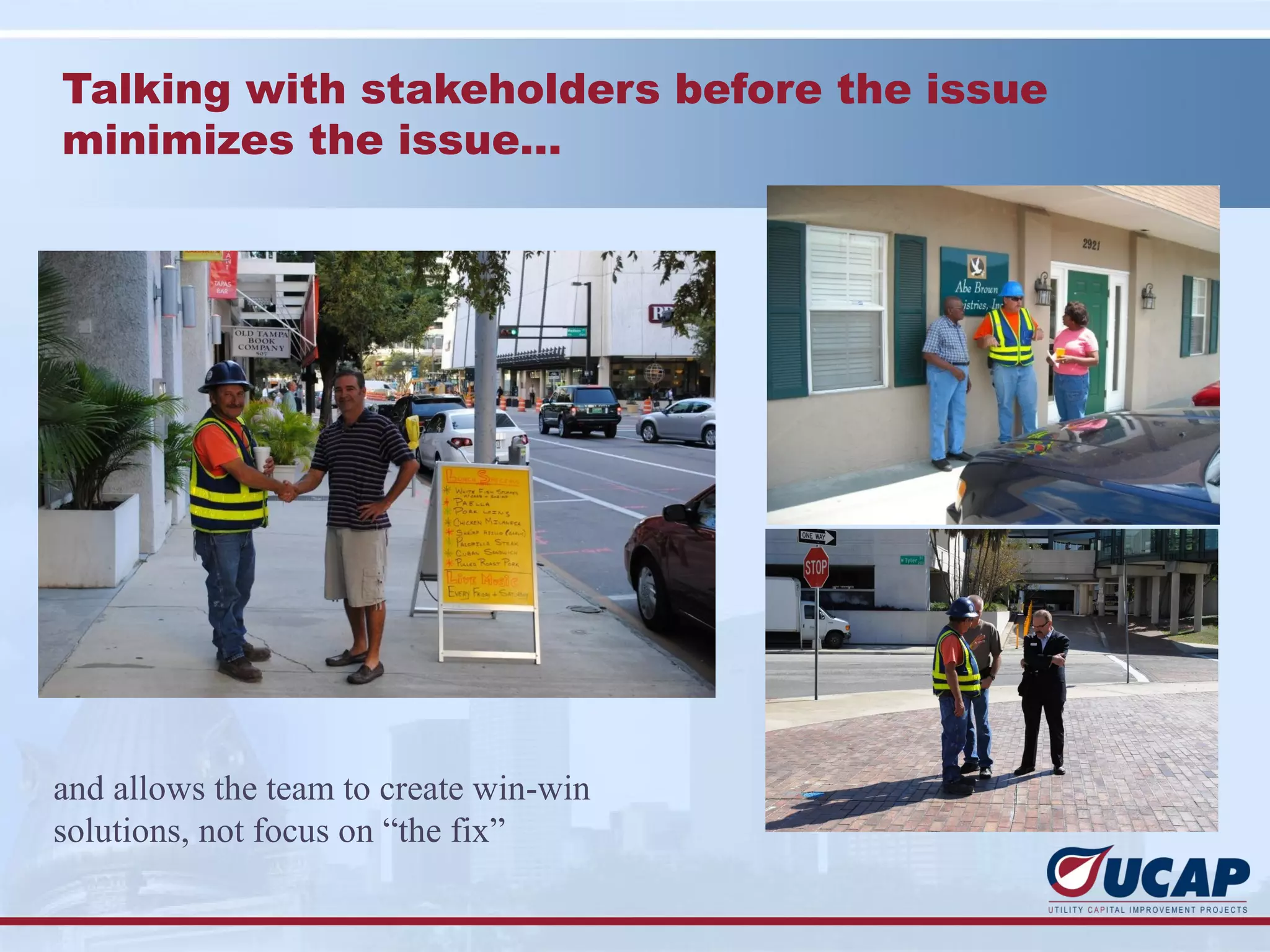

Talking with stakeholders before the issue
minimizes the issue…

and allows the team to create win-win
solutions, not focus on “the fix”
Understanding program issues
provides communication framework

   l Trees
   l Very tight work areas
   l Impacts to public events/venues
   l Traffic impacts
   l Business and property access
   l “NIMBY,” neighborhood concerns
   l Noise, dust, inconvenience
   l Public and worker safety
   l Field emergencies
   l Coordination between projects

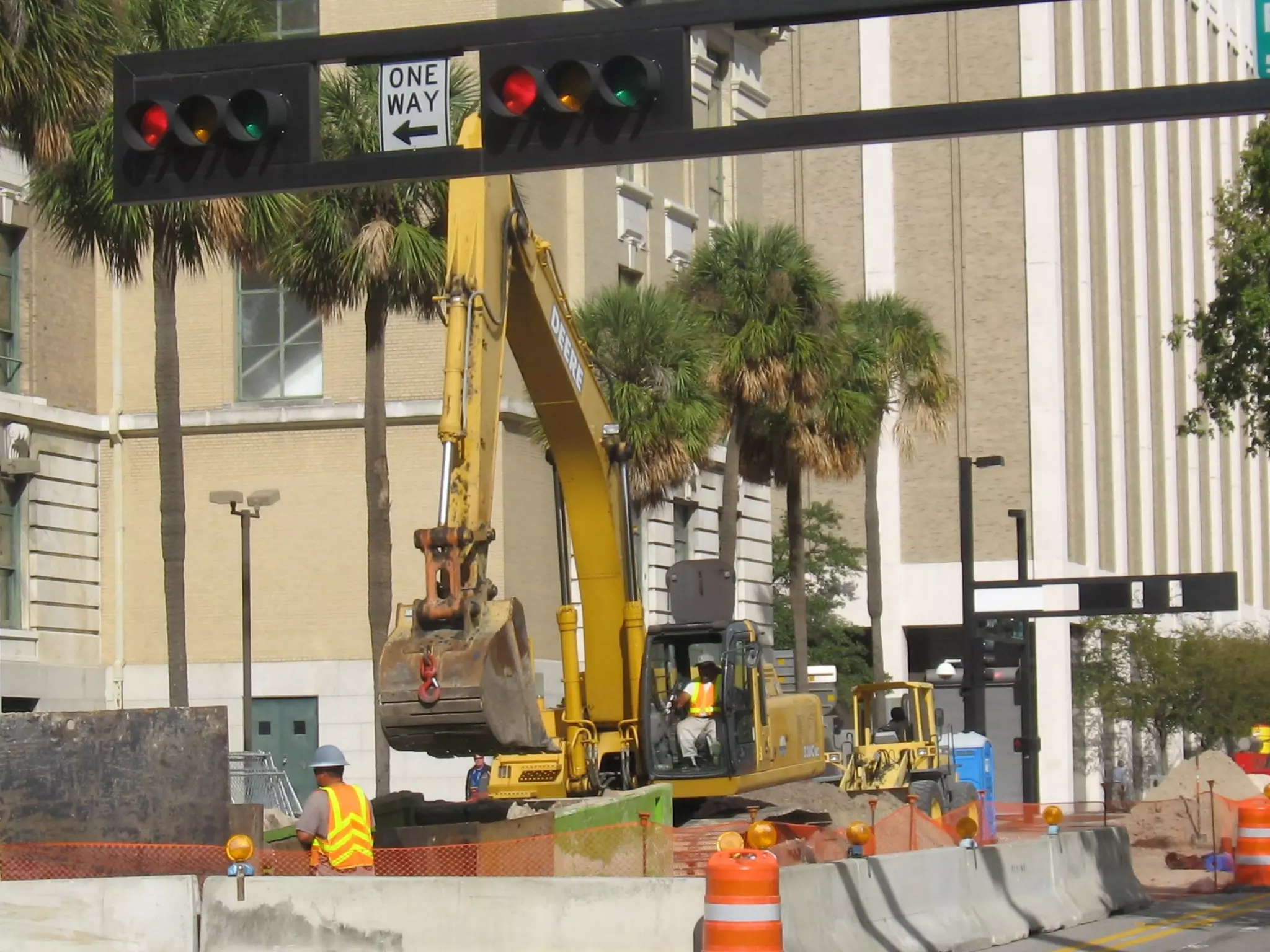

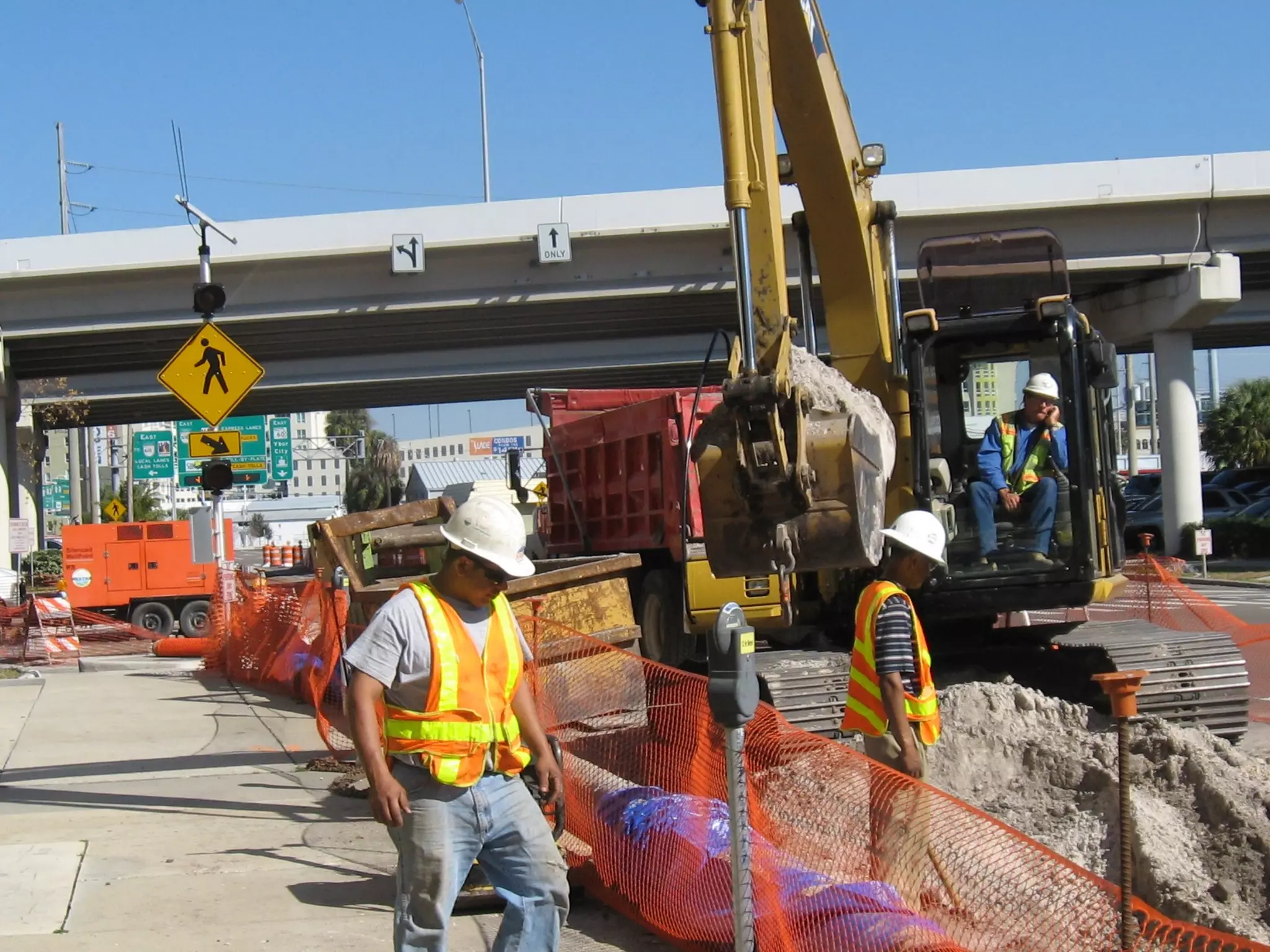

Managing construction and
communication downtown
Managing construction and
communication in residential areas
Public outreach fundamentals:
start-up

l Program Logo
l Identify stakeholders
l Media training
l Identify spokesperson, other team members
l Presentation
l Contact log/hotline

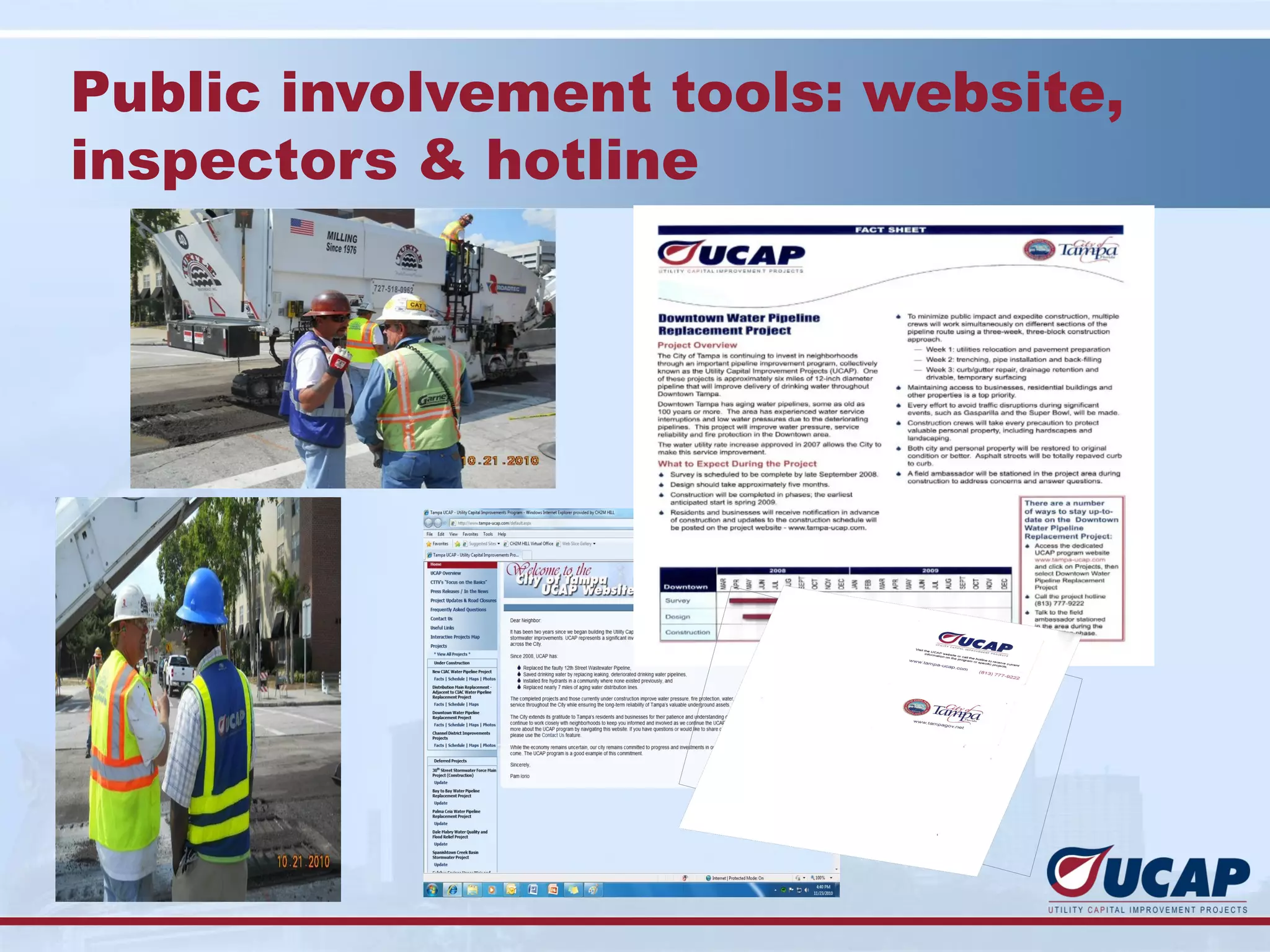

Public involvement tools: website,
inspectors & hotline
Program-wide communications ensure consistent
and effective outreach for all projects

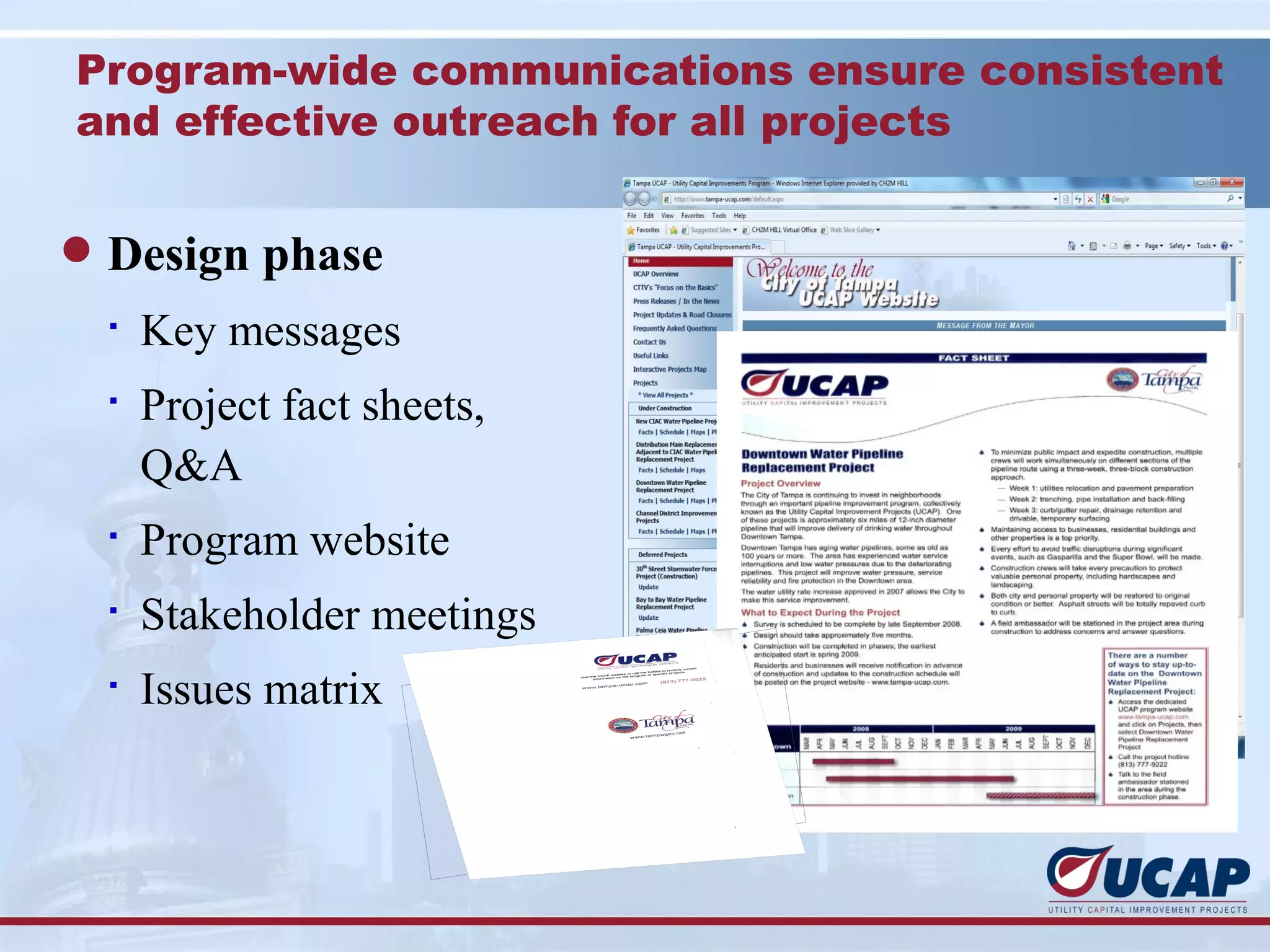

l Design phase
  §
      Key messages
  §
      Project fact sheets,
      Q&A
  §
      Program website
  §
      Stakeholder meetings
  §
      Issues matrix
Program-wide communications ensure consistent

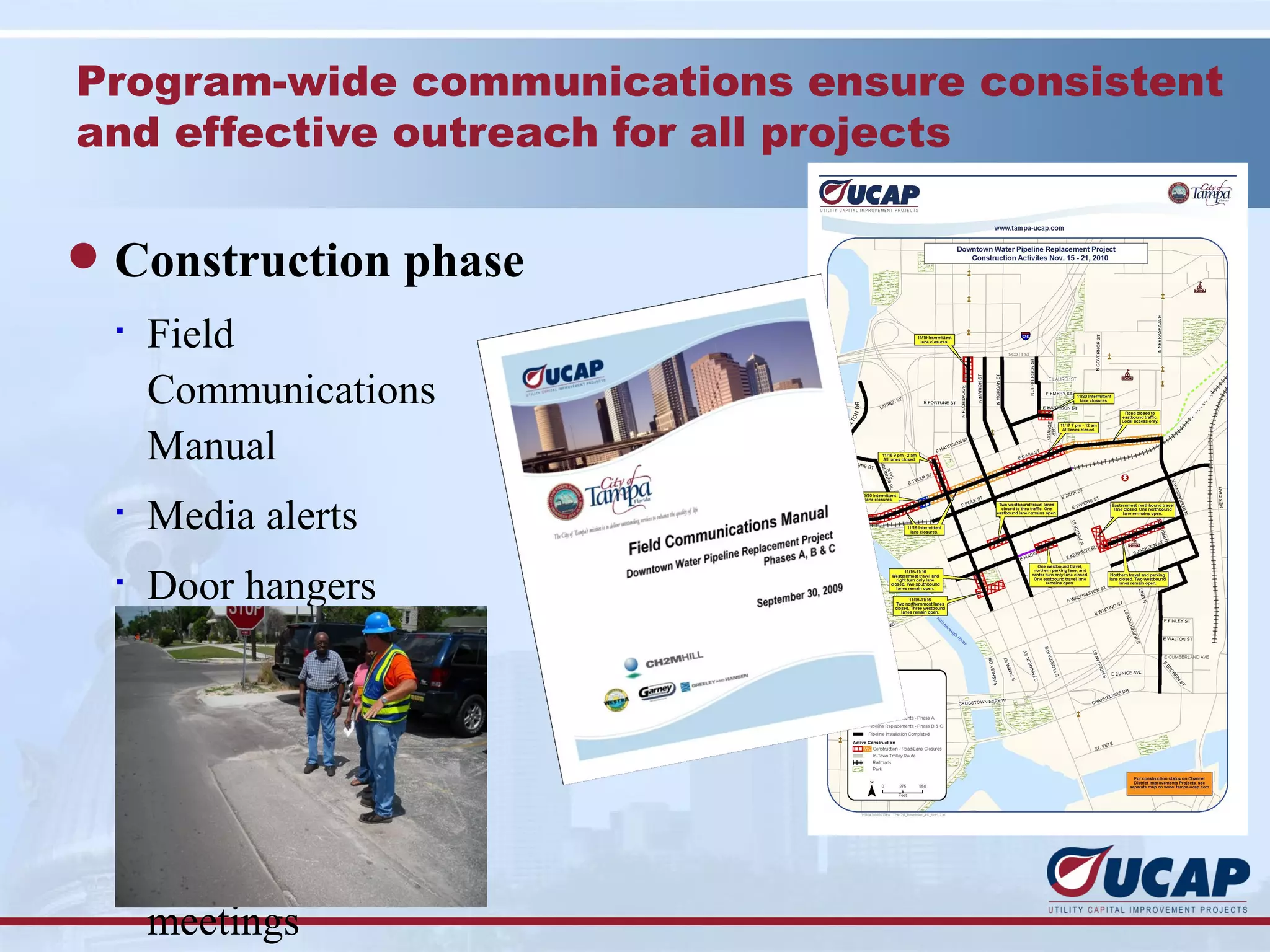

and effective outreach for all projects

l Construction phase
  §
      Field
      Communications
      Manual
  §
      Media alerts
  §
      Door hangers
  §
      VMB’s
  §
      Weekly updates
  §
      Field Ambassadors
  §
      Neighborhood
      meetings

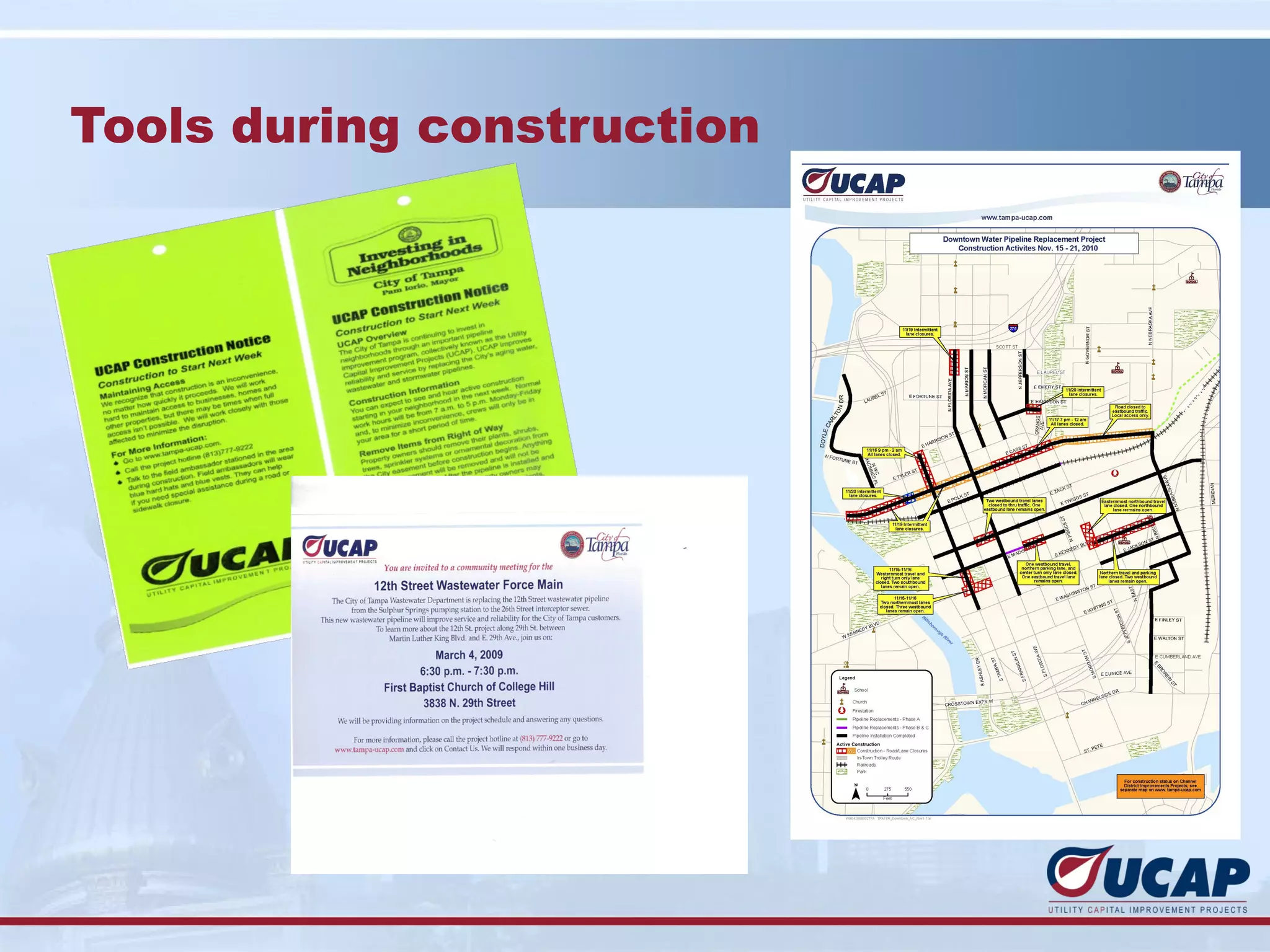

Tools during construction

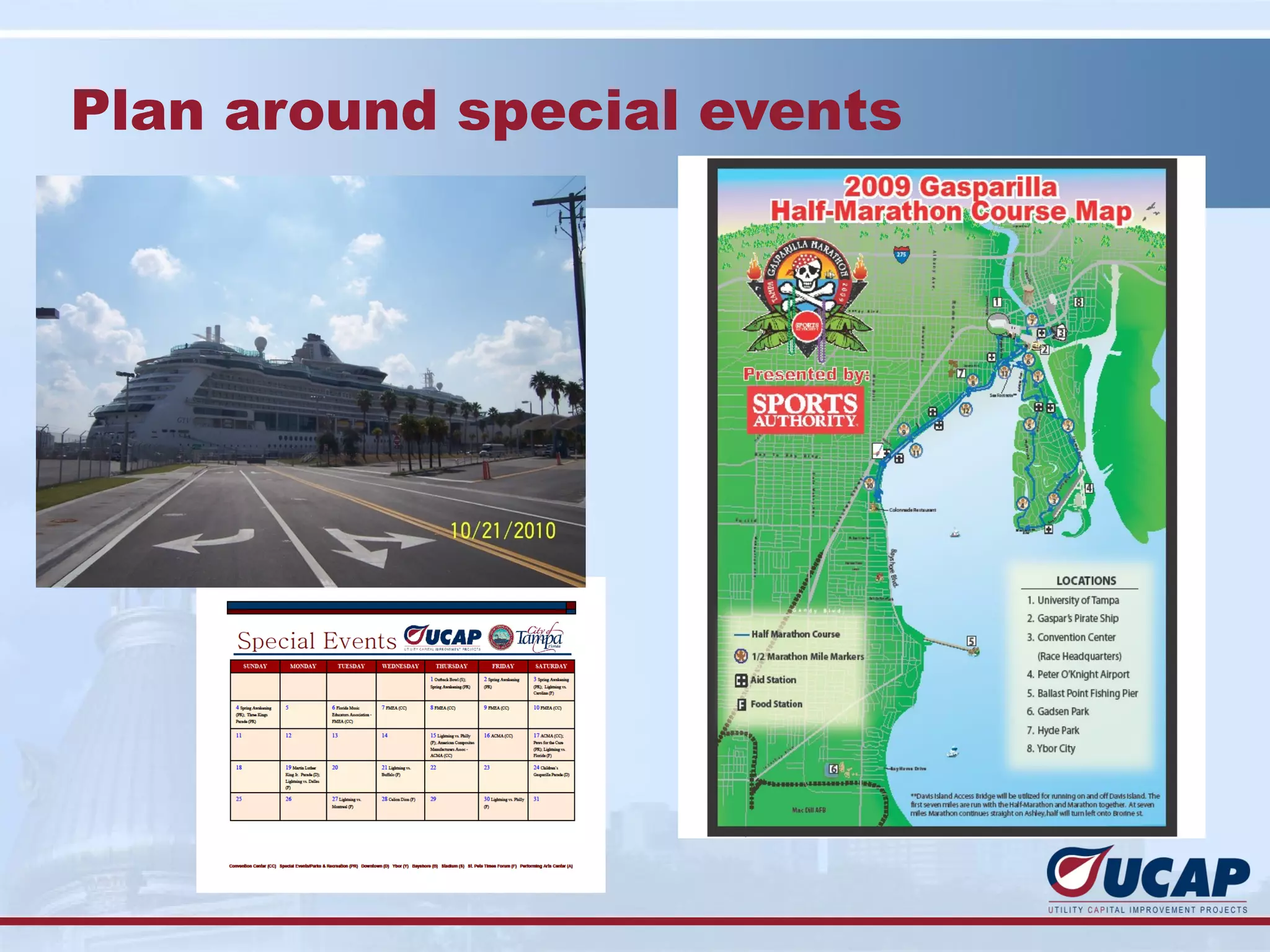

Plan around special events

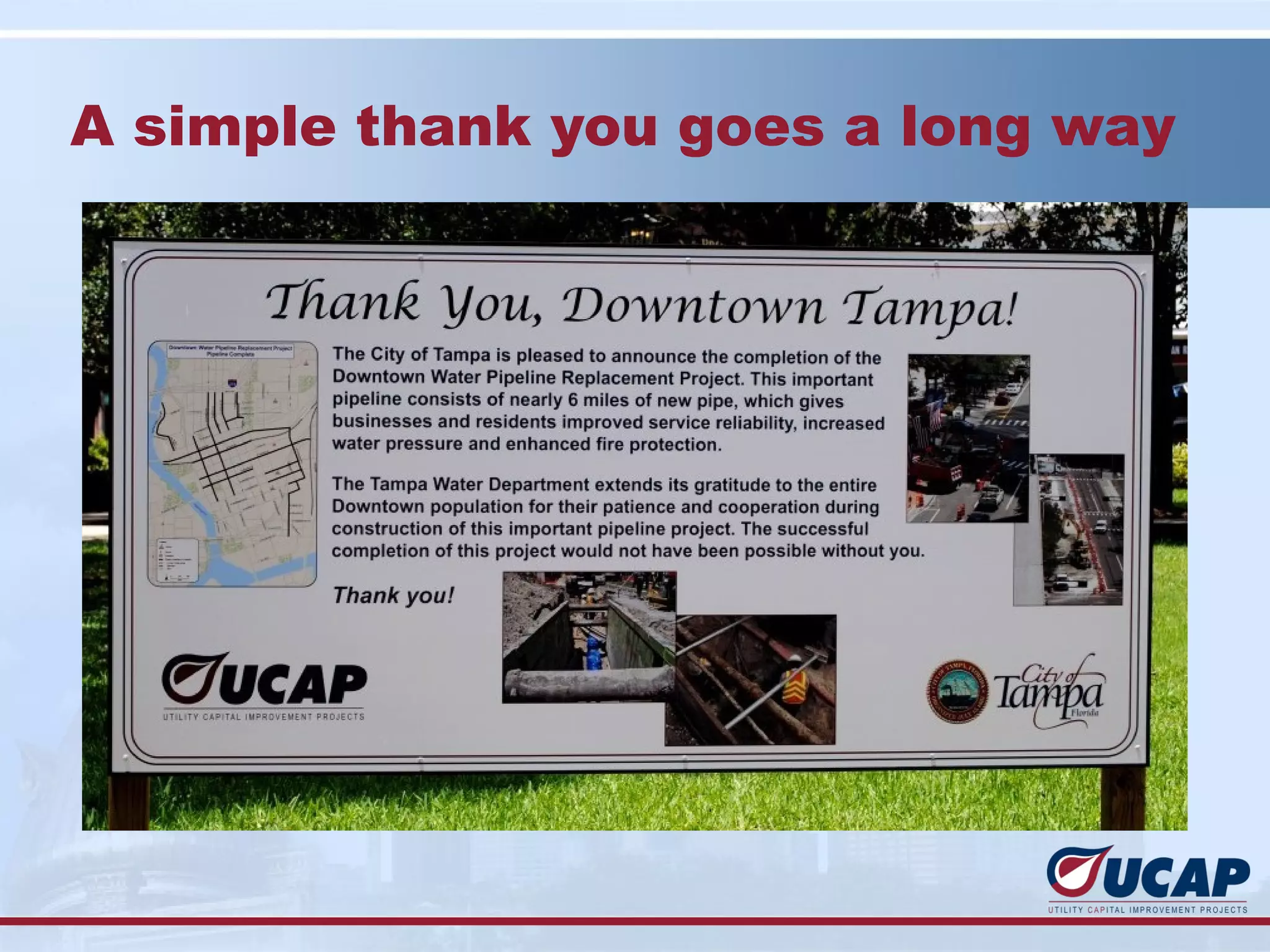

A simple thank you goes a long way

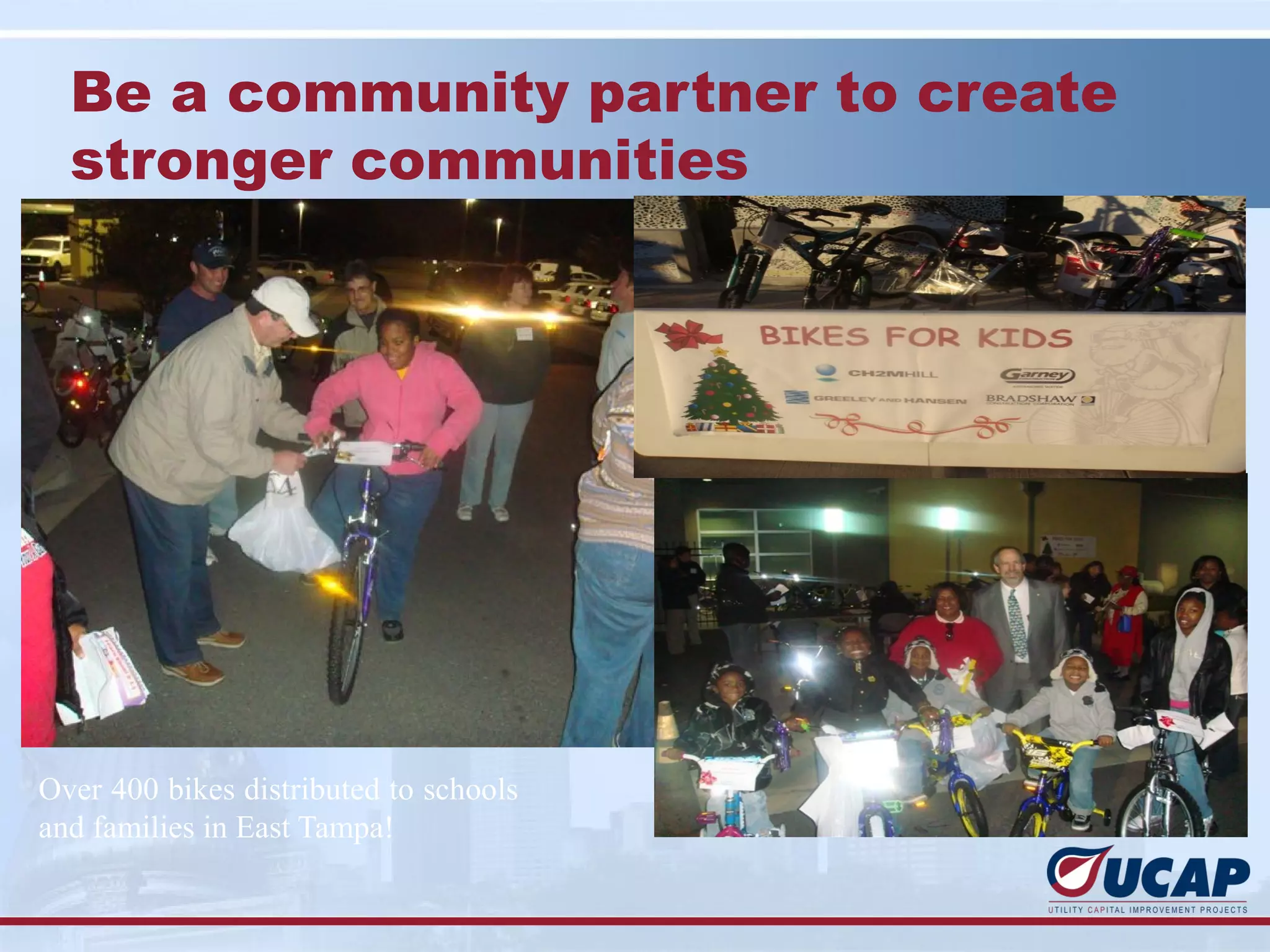

Be a community partner to create
  stronger communities

Over 400 bikes distributed to schools
and families in East Tampa!

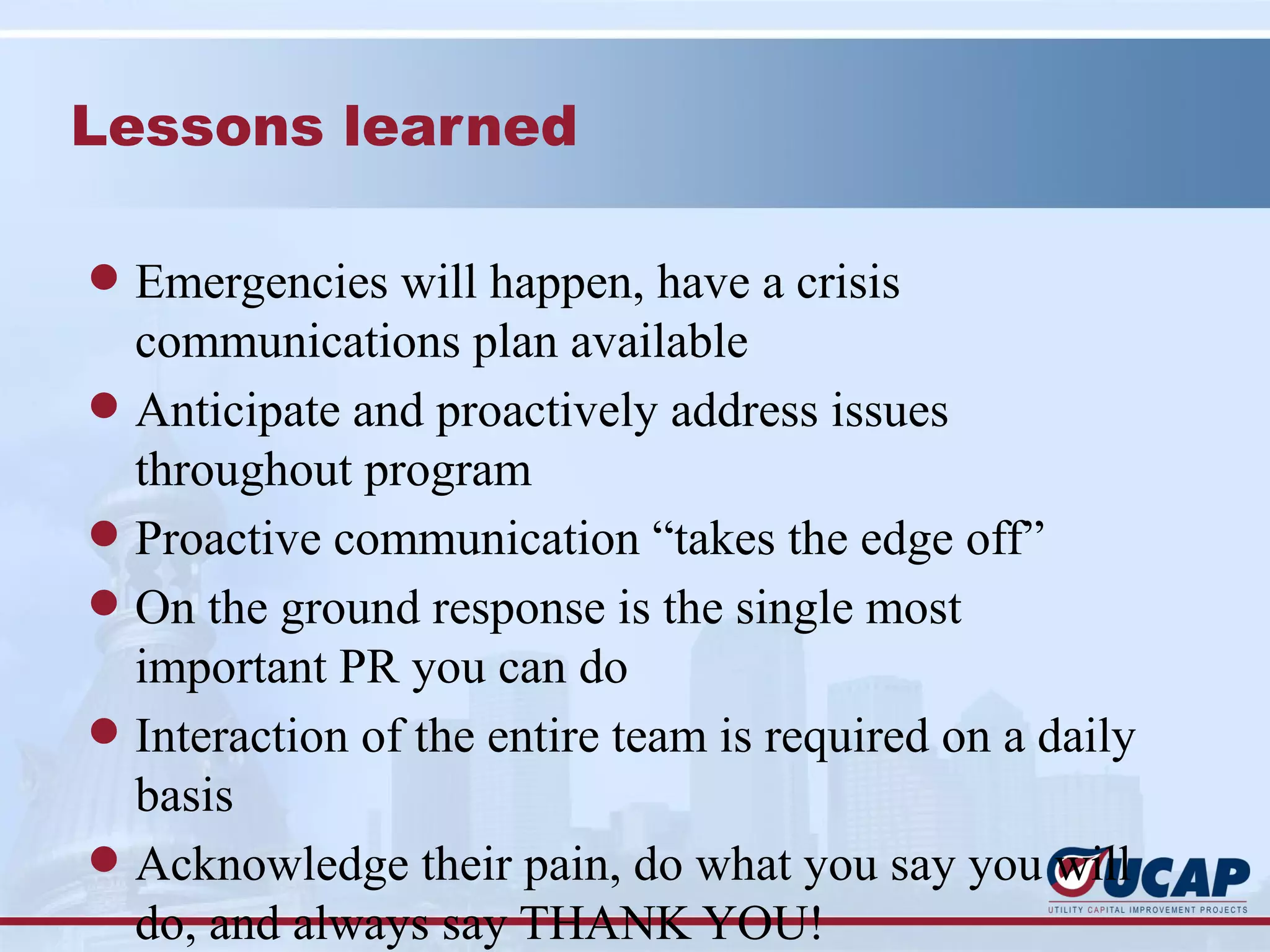

Lessons learned

l Emergencies will happen, have a crisis
  communications plan available
l Anticipate and proactively address issues
  throughout program
l Proactive communication “takes the edge off”
l On the ground response is the single most
  important PR you can do
l Interaction of the entire team is required on a daily
  basis
l Acknowledge their pain, do what you say you will
  do, and always say THANK YOU!
Consistent communications from design
through construction will gain public
support

                    “I just wanted to compliment you and
                    your team for one of the most
                    organized projects I've ever seen.  Your
                    work is impressive! ”

                    Best regards,

                    M. Lisa Shasteen, Esq.
                    President & CEO

Public Outreach Metrics…….
94% Reduction in Complaints!
Economic Benefits

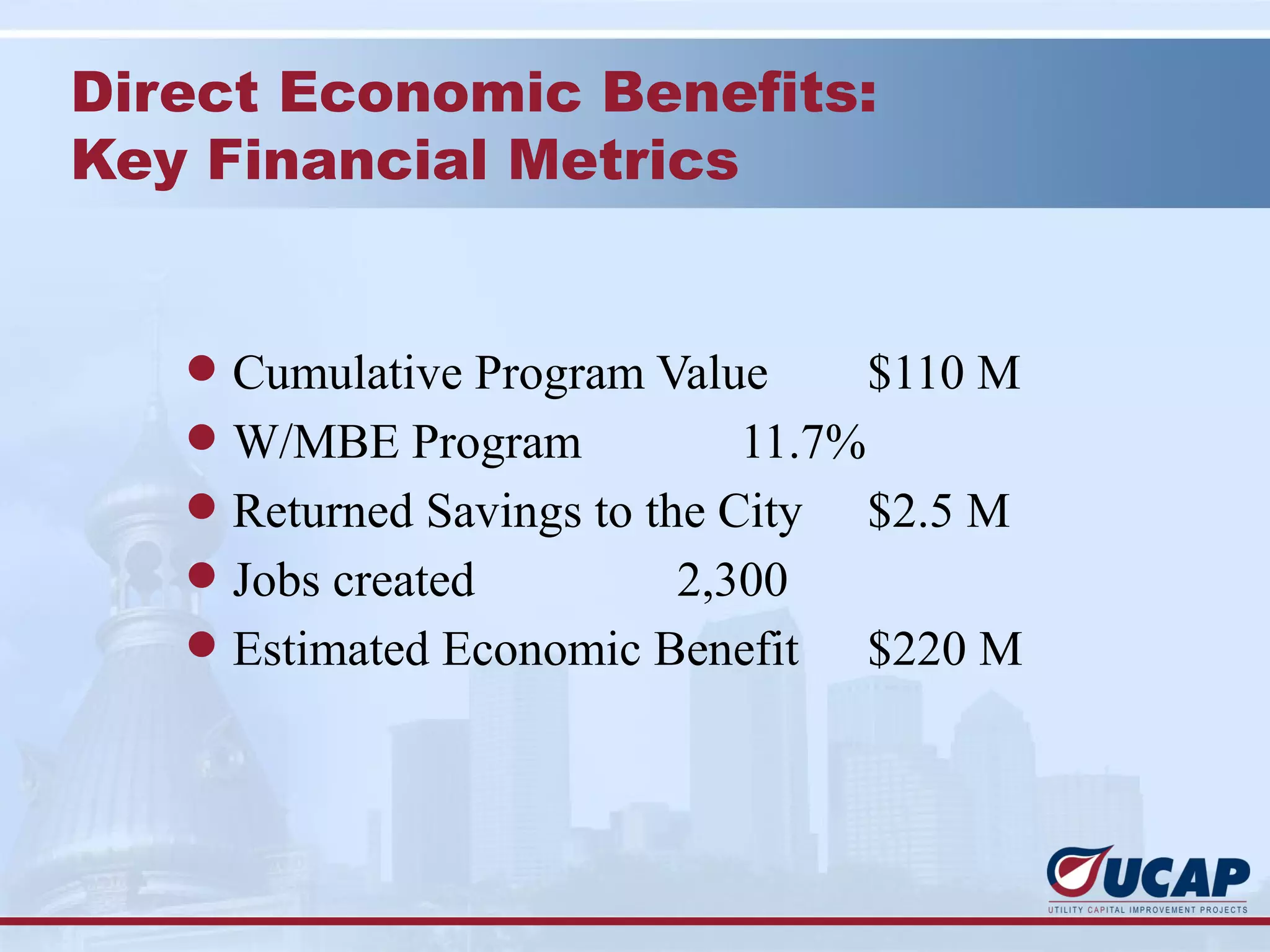

Direct Economic Benefits:
Key Financial Metrics

   l Cumulative Program Value     $110 M
   l W/MBE Program          11.7%
   l Returned Savings to the City   $2.5 M
   l Jobs created          2,300
   l Estimated Economic Benefit     $220 M

Primary UCAP Goals
 Achieved!!!
l Improve service reliability   
l Improve water pressure 
l Reduce pipe breaks 
l Improve water quality (Tampa Bay) 
l Improve safety and fire protection 
l Stimulate local economy 
l Encourage W/MBE involvement 

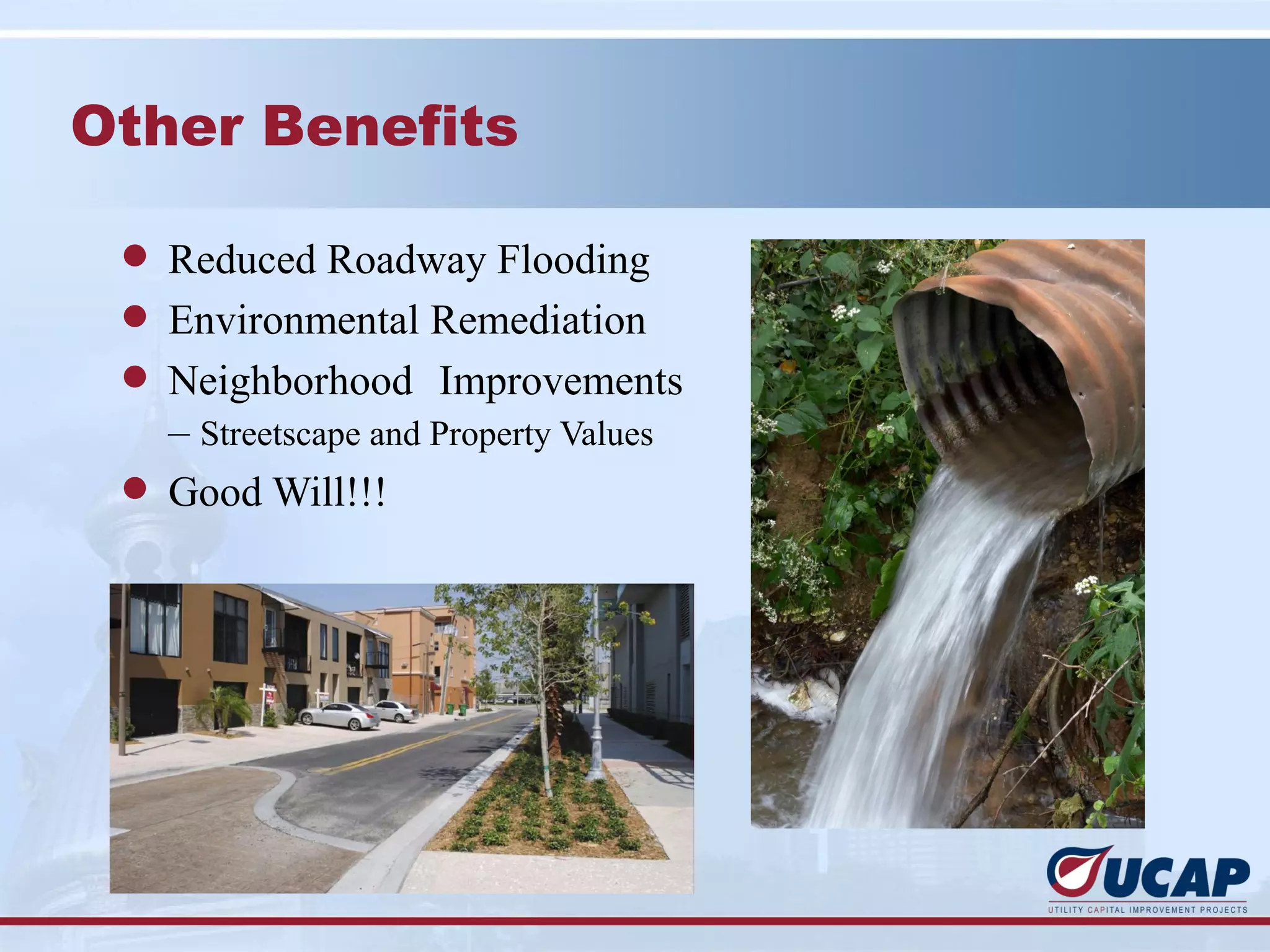

Other Benefits

 l Reduced Roadway Flooding
 l Environmental Remediation
 l Neighborhood Improvements
   – Streetscape and Property Values
 l Good Will!!!
Satisfied Customers….
                                                                     “I just wanted to compliment you and your team for
“You and your team have been absolutely terrific during              one of the most organized projects I’ve ever seen.
these construction projects.  Your promptness and attention          Your work is impressive!”
to our residents’ concerns has made our job a whole lot
easier and most certainly reduced the discomfort they may            B est regards,
have felt during the construction. Thank you for your
professionalism and caring while working here.”                      M . Lisa S hasteen, E sq.
                                                                     P resident & C E O
M ichelle, E d and C indy

M ichelle Van Loan                                            “For the past 4 weeks your construction crew have been
E ast Tampa D evelopment                                      working tirelessly putting new pipes down.  I have to inform
E conomic and Urban D evelopment D epartment                  you that M r. Andrew O zolnieks, the crew coordinator is a
                                                              wonderful person.  He came in on the first day before the
                                                              construction started in front of our business to inform us of
                                                              the process and how long it would las t and left his business
                                                              card in case any inconvenience should arise.  He even went
   A phone call was received from B rad Latourrette, a        further to find out from us each W ednesday what our
   motorist calling to express his appreciation for C .J.'s   schedule will be for our clients who usually come in on
   (G arney C onstruction) assistance.  M r. Latourrette      Fridays to visit their love ones .  M r. O zolnieks always make
   wanted to make C H2M HILL aware of his kindness            sure the crew is on time every Friday to enable our clients to
   and his help with his vehicle problems.                    get in and out without any problem during the visitation time
                                                              frame.  He is very devoted to his job, even getting our
   M aricelle Venegas                                         schedule before taking a few days off and letting the crew
   QC Ausa                                                    know what is required of them to accommodate us.”

                                                              Thanks,

                                                              P aulette Thomas
                                                              W ilson Funeral Home
Discussion
UCAP Contacts

Theresa B. Meyer, PE         Randy Houston, PE
UCAP Program Manager         Construction Manager
City of Tampa                CH2M Hill Constructors, Inc.
Theresa.meyer@tampagov.net   Randy.houston@ch2m.com

Wendy Nero                   Robert H. Garland, PE
Public Outreach Manager      Project Director/Design
CH2M Hill                    Greeley and Hansen
Wendy.nero@ch2m.com          rgarland@greeley-hansen.com

City of Tampa's Utility CIP Projects

  • 1.
    Progressive Design-Build Deliveryof Multiple, Complex Utility Infrastructure Projects: The City of Tampa’s Utility Capital Improvement Projects Florida Chapter of APWA 2012 APWA Annual Meeting and Trade Show Tampa, Florida April 3, 2012
  • 2.
    Background: What isUCAP? Utility Capital Improvement Projects § Series of progressive design/build projects working under a single program management umbrella § $110 million, five-year program § 25 individual water, wastewater, and stormwater projects § Scope of work included program management, permitting, design, construction, MOT, and public involvement
  • 3.
    Background: UCAP Goals lImprove service reliability l Improve water pressure l Reduce pipe breaks l Improve water quality (Tampa Bay) l Improve safety and fire protection l Stimulate local economy l Encourage W/MBE involvement
  • 4.
    100 Year OldWater Main Downtown Tampa
  • 5.
    Background: UCAP Bythe Numbers l 657,000 staff hours booked on UCAP l 112,000 total LF of pipeline installed l 59,000 LF of installed pipe 6 through 36 inches in diameter l 53,000 LF of installed pipe greater than 42 inches in diameter l 51,000 website hits through December 2011 l 5,400 LF of pipe installed via trenchless technology l 530 public involvement calls received l 400 valves installed l 235 project updates issued l 120 media alerts sent l 100 plus fire hydrants installed l 25 stand-alone projects
  • 6.
    Progressive Design Build Benefits:City of Tampa l Focused Team (5 years) l Single point of Responsibility and Accountability § Management § Design § Construction § Safety and Health § Public Outreach l Project Flexibility (Design and Construction) l Guaranteed Maximum Price (GMP) – open-book transparency § $2.5 million in returned savings
  • 7.
  • 8.
    Benefit: Single Pointof Responsibility PROGRAM MANAGEMEN T Tier 1 D E Ti S er I 2 G N CONSTRUCTI ON Tier 3
  • 9.
    Benefit: Single Pointof Accountability Example, Safety…. l Accumulated over 657,000 man-hours l 1 OSHA Recordable & No DART incidents in 2011 l 3.1 OSHA recordable for program l 1.2 OSHA DART rate for program l Hazards: up to 18 feet deep excavation, low overhead power lines, many unidentified underground utilities, limited work spaces with large equipment
  • 10.
  • 11.
    29th St. WMDesign accelerated to allow construction with 12th St. FM
  • 12.
  • 13.
    Benefit: Flexibility (Add-OnProjects) York St. Project l The York Street project provided capacity for present and future stormwater drainage. l A new 20 ft X 10 ft stormwater storage vault and drain was installed, which will help protect water quality in Tampa Bay l York Street construction also included new stormwater pipelines, an associated stormwater water quality pump station, and an outfall structure.
  • 14.
  • 15.
  • 16.
    Benefit: Unique Construction Capabilities l47 Trenchless Crossings for total 5,400 LF l 2,300 LF of Microtunnel Crossings l 800 LF of Horizontal Directional Drill Crossings l Low Profile Construction Equipment with Maximum height of 20 Feet to protect low arching tree canopies
  • 17.
    Benefit: Sustainable Construction Techniques l Used more than 45,000 tons of crushed concrete for road base material in lieu of lime rock base saved the City $135,000 l By recycling 27,000 tons of asphalt which ultimately saved the City $54,000 l $200,000 Realized Savings!
  • 18.
    Lessons Learned: Whatyou see is not always what you get!
  • 19.
    Lessons Learned: ThirdParty Backup Utility Locates Minimizes Surprise
  • 20.
  • 21.
    Lessons Learned: SharedRisks l Include Contingencies in Contract § Unforeseen Site Conditions l Include Allowances in Contract § Soils and/or Groundwater Shared Risks = Shared Savings
  • 22.
    Final Thought….. Monthly LeadershipMeetings Program involved interactions with: l 15 Internal City Departments l 8 Separate Permitting Agencies l 7 Unique Funding Sources l Joint City-County Projects l Political, Business, and Residential Entities Monthly Partnering Sessions = No Surprises!!!
  • 23.
  • 24.
    Effective public outreachis essential to program success l Vision § Better relationship with community after the project(s) § No calls to elected officials or senior staff l Approach § Communicate with the “same message” § Anticipate challenges and mitigate in planning and design (including specs) when possible § Address at “street level” to avoid escalation § Customize activity for start-up, design and construction
  • 25.
    Talking with stakeholdersbefore the issue minimizes the issue… and allows the team to create win-win solutions, not focus on “the fix”
  • 26.
    Understanding program issues providescommunication framework l Trees l Very tight work areas l Impacts to public events/venues l Traffic impacts l Business and property access l “NIMBY,” neighborhood concerns l Noise, dust, inconvenience l Public and worker safety l Field emergencies l Coordination between projects
  • 27.
  • 34.
  • 41.
    Public outreach fundamentals: start-up lProgram Logo l Identify stakeholders l Media training l Identify spokesperson, other team members l Presentation l Contact log/hotline
  • 42.
    Public involvement tools:website, inspectors & hotline
  • 43.
    Program-wide communications ensureconsistent and effective outreach for all projects l Design phase § Key messages § Project fact sheets, Q&A § Program website § Stakeholder meetings § Issues matrix
  • 44.
    Program-wide communications ensureconsistent and effective outreach for all projects l Construction phase § Field Communications Manual § Media alerts § Door hangers § VMB’s § Weekly updates § Field Ambassadors § Neighborhood meetings
  • 45.
  • 46.
  • 47.
    A simple thankyou goes a long way
  • 48.
    Be a communitypartner to create stronger communities Over 400 bikes distributed to schools and families in East Tampa!
  • 49.
    Lessons learned l Emergencieswill happen, have a crisis communications plan available l Anticipate and proactively address issues throughout program l Proactive communication “takes the edge off” l On the ground response is the single most important PR you can do l Interaction of the entire team is required on a daily basis l Acknowledge their pain, do what you say you will do, and always say THANK YOU!
  • 50.
    Consistent communications fromdesign through construction will gain public support “I just wanted to compliment you and your team for one of the most organized projects I've ever seen.  Your work is impressive! ”   Best regards,   M. Lisa Shasteen, Esq. President & CEO
  • 51.
    Public Outreach Metrics……. 94%Reduction in Complaints!
  • 52.
  • 53.
    Direct Economic Benefits: KeyFinancial Metrics l Cumulative Program Value $110 M l W/MBE Program 11.7% l Returned Savings to the City $2.5 M l Jobs created 2,300 l Estimated Economic Benefit $220 M
  • 54.
    Primary UCAP Goals Achieved!!! l Improve service reliability  l Improve water pressure  l Reduce pipe breaks  l Improve water quality (Tampa Bay)  l Improve safety and fire protection  l Stimulate local economy  l Encourage W/MBE involvement 
  • 55.
    Other Benefits lReduced Roadway Flooding l Environmental Remediation l Neighborhood Improvements – Streetscape and Property Values l Good Will!!!
  • 56.
    Satisfied Customers…. “I just wanted to compliment you and your team for “You and your team have been absolutely terrific during one of the most organized projects I’ve ever seen. these construction projects.  Your promptness and attention Your work is impressive!” to our residents’ concerns has made our job a whole lot easier and most certainly reduced the discomfort they may B est regards, have felt during the construction. Thank you for your professionalism and caring while working here.” M . Lisa S hasteen, E sq. P resident & C E O M ichelle, E d and C indy   M ichelle Van Loan “For the past 4 weeks your construction crew have been E ast Tampa D evelopment working tirelessly putting new pipes down.  I have to inform E conomic and Urban D evelopment D epartment you that M r. Andrew O zolnieks, the crew coordinator is a wonderful person.  He came in on the first day before the construction started in front of our business to inform us of the process and how long it would las t and left his business card in case any inconvenience should arise.  He even went A phone call was received from B rad Latourrette, a further to find out from us each W ednesday what our motorist calling to express his appreciation for C .J.'s schedule will be for our clients who usually come in on (G arney C onstruction) assistance.  M r. Latourrette Fridays to visit their love ones .  M r. O zolnieks always make wanted to make C H2M HILL aware of his kindness sure the crew is on time every Friday to enable our clients to and his help with his vehicle problems.   get in and out without any problem during the visitation time frame.  He is very devoted to his job, even getting our M aricelle Venegas schedule before taking a few days off and letting the crew QC Ausa know what is required of them to accommodate us.”   Thanks,   P aulette Thomas W ilson Funeral Home
  • 57.
  • 58.
    UCAP Contacts Theresa B.Meyer, PE Randy Houston, PE UCAP Program Manager Construction Manager City of Tampa CH2M Hill Constructors, Inc. Theresa.meyer@tampagov.net Randy.houston@ch2m.com Wendy Nero Robert H. Garland, PE Public Outreach Manager Project Director/Design CH2M Hill Greeley and Hansen Wendy.nero@ch2m.com rgarland@greeley-hansen.com
