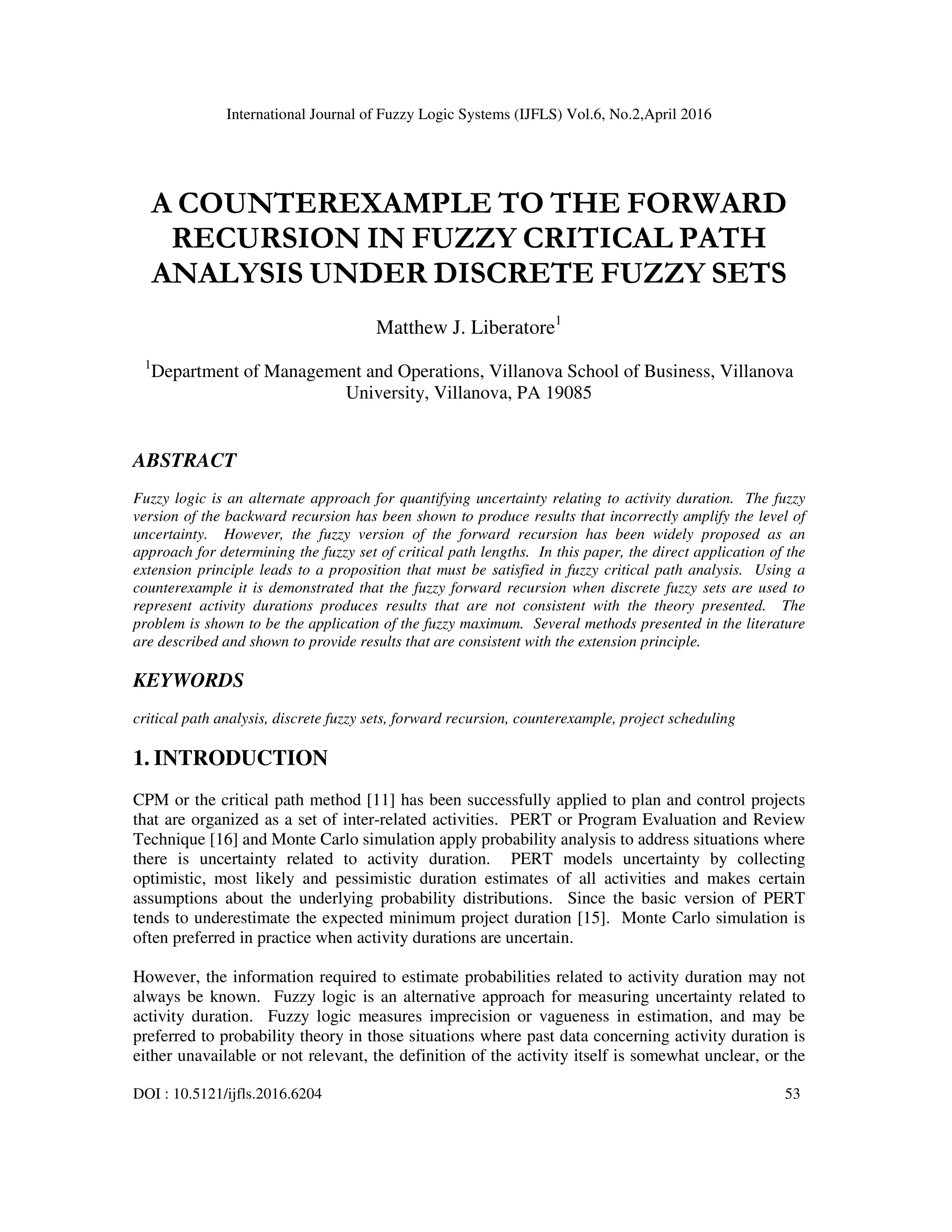

This document presents a counterexample demonstrating that the fuzzy forward recursion method for determining critical paths does not always produce results consistent with the extension principle when discrete fuzzy sets are used to represent activity durations.
The document first provides background on fuzzy sets and critical path analysis. It then presents a proposition stating that the membership function for fuzzy critical path lengths can be determined by taking the maximum of the minimum membership values across all activity durations in each configuration.
The document goes on to present a counterexample using a simple series-parallel network with 18 configurations. It shows that applying the fuzzy forward recursion produces a different membership value for one critical path length compared to directly applying the extension principle. This difference proves the fuzzy forward
EXACT SOLUTIONS OF A FAMILY OF HIGHER-DIMENSIONAL SPACE-TIME FRACTIONAL KDV-T...cscpconf
In this paper, based on the definition of conformable fractional derivative, the functional
variable method (FVM) is proposed to seek the exact traveling wave solutions of two higherdimensional
space-time fractional KdV-type equations in mathematical physics, namely the
(3+1)-dimensional space–time fractional Zakharov-Kuznetsov (ZK) equation and the (2+1)-
dimensional space–time fractional Generalized Zakharov-Kuznetsov-Benjamin-Bona-Mahony
(GZK-BBM) equation. Some new solutions are procured and depicted. These solutions, which
contain kink-shaped, singular kink, bell-shaped soliton, singular soliton and periodic wave
solutions, have many potential applications in mathematical physics and engineering. The
simplicity and reliability of the proposed method is verified.
