TOPS Offshore
                       Production Systems
                            (TOPS)
                             4th April 2011




Thursday, 28 July 11
Contact
                       • Inventor: Pat Haynes
                       • Organisations: A.P.Haynes Consulting/
                         Eboroil Ltd
                       • Norwegian Org nr 986455744
                       • Address: Jon Smørsv 4A, 1397 Nesøya
                       • Tel: +47 66847068 Mob Tel: +47 45275598
                       • Skype name : eboroil
                       • E-mail eboroil@me.com
Thursday, 28 July 11
The TOPS Concept
                       • The average water depth in the world is
                         3795m and this is a solution for the future
                       • all offshore oil and gas will based on having
                         a continuous process including exploration,
                         production, and refining and for certain
                         fields, transport ship (TOPS)
                       • most of the patents have lapsed
Thursday, 28 July 11
TOPS Eliminates
                 • delay in appraisal and development
                 • conventional rigs and platforms
                 • refineries
                 • over balanced drilling as per the BP GOM
                       blow-out
                 • significantly lowers blow out and pollution risk
                       in arctic areas and in deep water

Thursday, 28 July 11

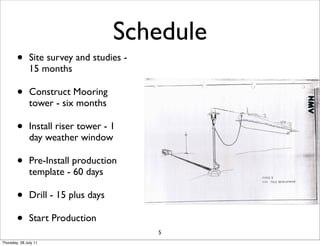

Schedule
        •      Site survey and studies -
               15 months

        •      Construct Mooring
               tower - six months

        •      Install riser tower - 1
               day weather window

        •      Pre-Install production
               template - 60 days

        •      Drill - 15 plus days

        •      Start Production
                                           5
Thursday, 28 July 11
Preliminaries
                       • establish bottom conditions, sea water
                         properties as well as wave and current
                         profile at the site (GEMS)
                       • establish if affecting marine mammals,
                         seabed corals and migratory bird paths
                         (NPL)
                       • shoot 3D seismic of the area
                       • establish that when the reservoir is de-
                         pressurised that there is no earthquake risk
                         (Geomec)

Thursday, 28 July 11
Components
                       • Mooring tower in steel in shallower waters
                         and Titanium in deep water (Mercon)
                       • Well template with co-mingled production,
                         water and gas injection services and heavy
                         oil splitting services together with subsea
                         processing (FMC/others ?)
                       • Aframax sized TOPS with dp 2 providing
                         direct well access for drilling and
                         intervening throughout the field life


Thursday, 28 July 11
Exploration Phase
                       • Design site specific TOPS mooring tower in
                         steel/Ti with 2000 ton barytes ballasted
                         base and hydrogen generators to suit
                         location (Mercon with SBM as
                         subcontractor)
                       • Install ocean energy generators, template
                         and flowlines (Technip/others?)
                       • Mobilise the TOPS ship and drill first well
                       • In event of dry well redeploy equipment
Thursday, 28 July 11
Financing
                       • in 1980 TOPS was based on paying the
                         shipowner 20% rate of return on the equity
                         in the original acquisition cost of the
                         reuseable components of the project
                       • The oilco requires to pay for the lower
                         buoy, the installation work and 90 days of
                         operations
                       • The leasing partners in TOPS are sought
Thursday, 28 July 11
TOPS Mooring Tower
                       • 2000 tons of barytes ballast in the base
                       • Upper buoy contains ballast tanks to allow
                         for installation and removal - reuseable
                       • Lower buoy at minus 160 ft have hose take
                         offs to the TOPS ship - site specific
                         ( Contitech)
                       • Ocean power to generate H2
                         (Magnomatics/ITM Power)


Thursday, 28 July 11
TOPS Template (FMC)
                       • 4 by 8 on 8’6” centres well slots
                       • each Christmas tree to incorporate shear
                         and blind rams and to be connected to a
                         co-mingling distribution manifold on the
                         central two rows for production at the
                         flowing wellhead pressure of the best well
                         and subsea separation.
                       • use duplex acoustic controls with hydraulic
                         accumulators on the template


Thursday, 28 July 11
Subcontractors to FMC
                       • Advance Energy Systems to crack heavy oil
                         to C13 and gases as appropriate
                       • Nemo Engineering - pipeline sledges
                       • Acoustic controls - used Cameron
                         successfully before and Kongsberg
                       • Water injection pumps, artificial lift, gas
                         injection and compression - Clavis are
                         developing a unique pump technology


Thursday, 28 July 11
TOPS
                       • station keeping by Dp2 with constant
                         tension mooring winch working at between
                         70 and 90 tons (Huismann/AXTech)
                       • Converted Aframax or OBO which can
                         have LNG tanks put in the holds for later
                         life operations (previous model in Eboroil jv
                         m.v.Arctic which was 25,000 dwt)
                       • Receive oil, gas, water and distribute oil,
                         gas, drill cuttings removal and pigging
                         services

Thursday, 28 July 11
Drilling
                       • 30” conductors installed on all wells in the
                         construction phase (Technip)
                       • use Casing Drilling technology to drill
                         underbalanced in a closed loop to contain
                         kicks (Schlumberger)
                       • use composite cable based push/pull
                         wireline (supplier yet to be chosen) to
                         retrieve bits etc


Thursday, 28 July 11
Drilling Operations
                       • Mount Helirig on the Port side of the ship
                         to work in the lee based on heading bow
                         quarter into the weather
                       • Have top drive and coil for intervention
                       • Recover and treat drill cuttings with
                         biodegradable oil solvent and dump cuttings
                       • have slip joint design by Aker accepted by
                         Schlumberger

Thursday, 28 July 11
Thoughts
                       • Stern into weather towards SALM
                       • Accommodation at stern
                       • Shottels bow and stern instead of Becker/
                         other rudders such as Schilling from main
                         engines
                       • New build
                       •

Thursday, 28 July 11
Process plant
                       • Have main processing subsea for separation
                         of oil, gas and water
                       • Mount equipment 3 m above cargo holds
                       • Have surface oil treatment as heating to 80
                         deg C to remove metals with activated
                         charcoal and then crack at 400 deg C to
                         diesel product specifications with a catalyst
                       • Have chemical injection and pigging services
Thursday, 28 July 11
Maximise Oil Recovery
                       •   Continuous monitoring of reservoir behaviour and
                           optimisation of offtake using multiple realisation of
                           static and dynamic reservoir models.

                       •   Continuously drill and intervene guided by 4D
                           seismic

                       •   To inject gas super critically until reservoir until
                           dry

                       •   Inject cation rich sea water to recover oil prior to
                           low surface tension water to break up macro oil in
                           water emulsions


Thursday, 28 July 11
Ship Operations
                       • Have Captain in charge of all operations
                       • Change crew every three weeks and
                         recharge activated charcoal using the dry
                         evacuation system (GEC)
                       • Have unidirectional currents and wave
                         energy generate hydrogen for dp system
                         (Magnomatics/Pulse Tidal/Green Fuel/ITM
                         Power)
                       • Be a zero emission ship
                       • Have shuttle tankers use a Remora unit
Thursday, 28 July 11

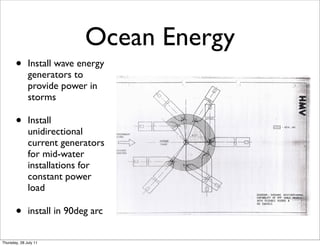

Ocean Energy
       •      Install wave energy
              generators to
              provide power in
              storms

       •      Install
              unidirectional
              current generators
              for mid-water
              installations for
              constant power
              load

       •      install in 90deg arc


Thursday, 28 July 11
Contingencies
               • Have two dp UT 705 offshore platform support
                       vessels with active stability tanks and acoustic
                       responders to shut down the template in case
                       of problems
               • Have oil skimming with a biodegradable oil
                       dispersant, bulk barytes, cement, fi-fi services,
                       anti collision radar, dry evacuation transfer
                       services
               • in the arctic amphibious life-boats and infra red
                       satellite based radar to navigate in minimum ice

Thursday, 28 July 11
The First Project
                       • The Irish Authorities have been approached
                         to develop Barryroe in conjunction with
                         the current Option holders
                       • All contracts will be at cost plus 20% and
                         there will be no bidding with technical
                         excellence deciding the contract award
                       • Intend to work with Lloyds Registry and
                         have IOM flag
