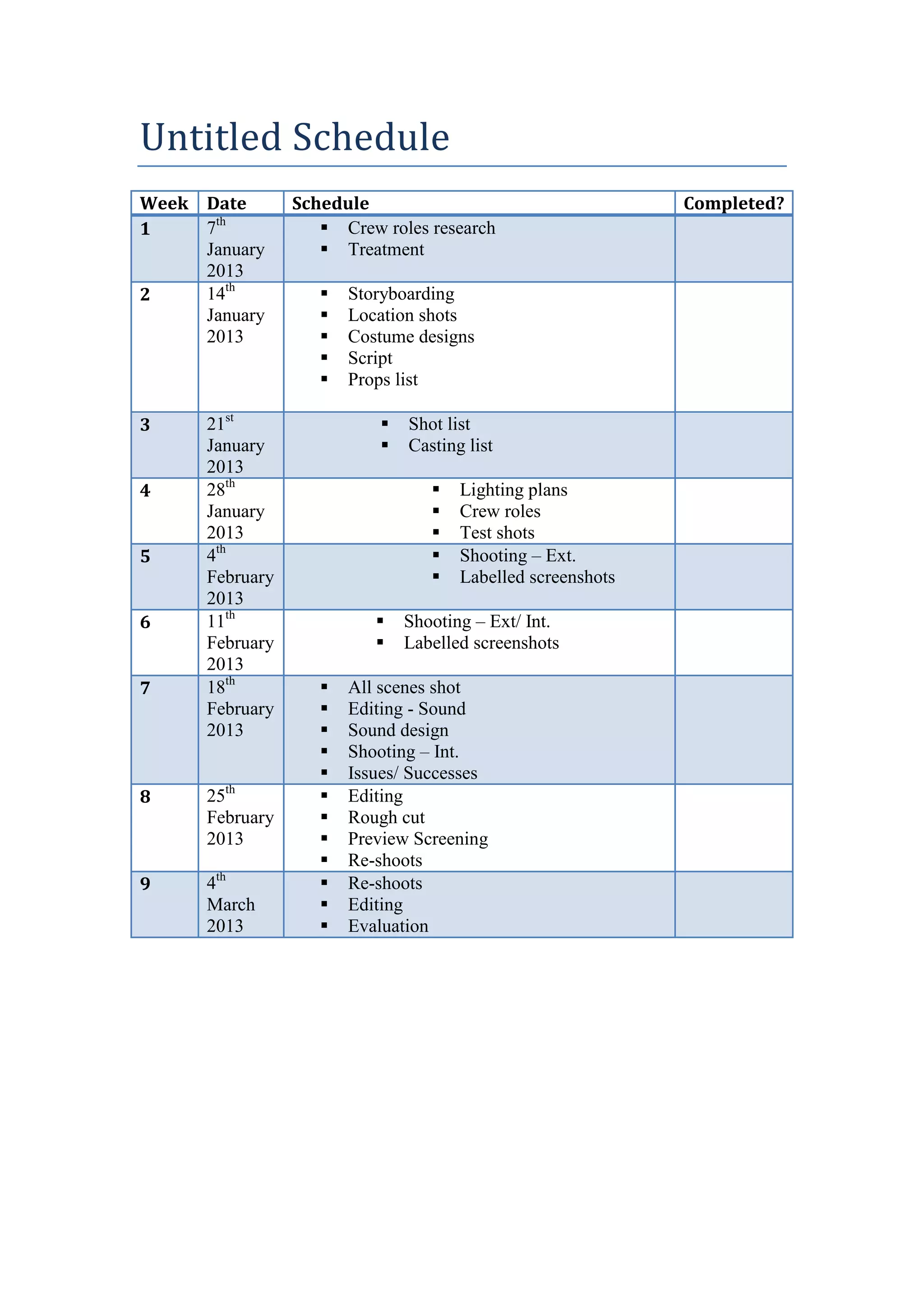

The document outlines a 9-week production schedule including crew roles research, storyboarding, location and costume designs, scripting, props, casting, lighting plans, test shots, exterior and interior shooting, editing, sound design, rough cuts, preview screenings, and potential re-shoots. Key dates include the first week focusing on crew roles, the second on pre-production elements, and weeks 5-7 centering on principal photography.
