The
  Effects
  of

Duration-­‐based
  Moving
  Windows

with

Estimation
  by
  Analogy

Sousuke
  Amasaki*

Chris
  Lokan†



Okayama
  Prefectural
  University*

UNSW
  Canberra†

Mensura
  2015
  in
  Kracow,
  Poland
  1

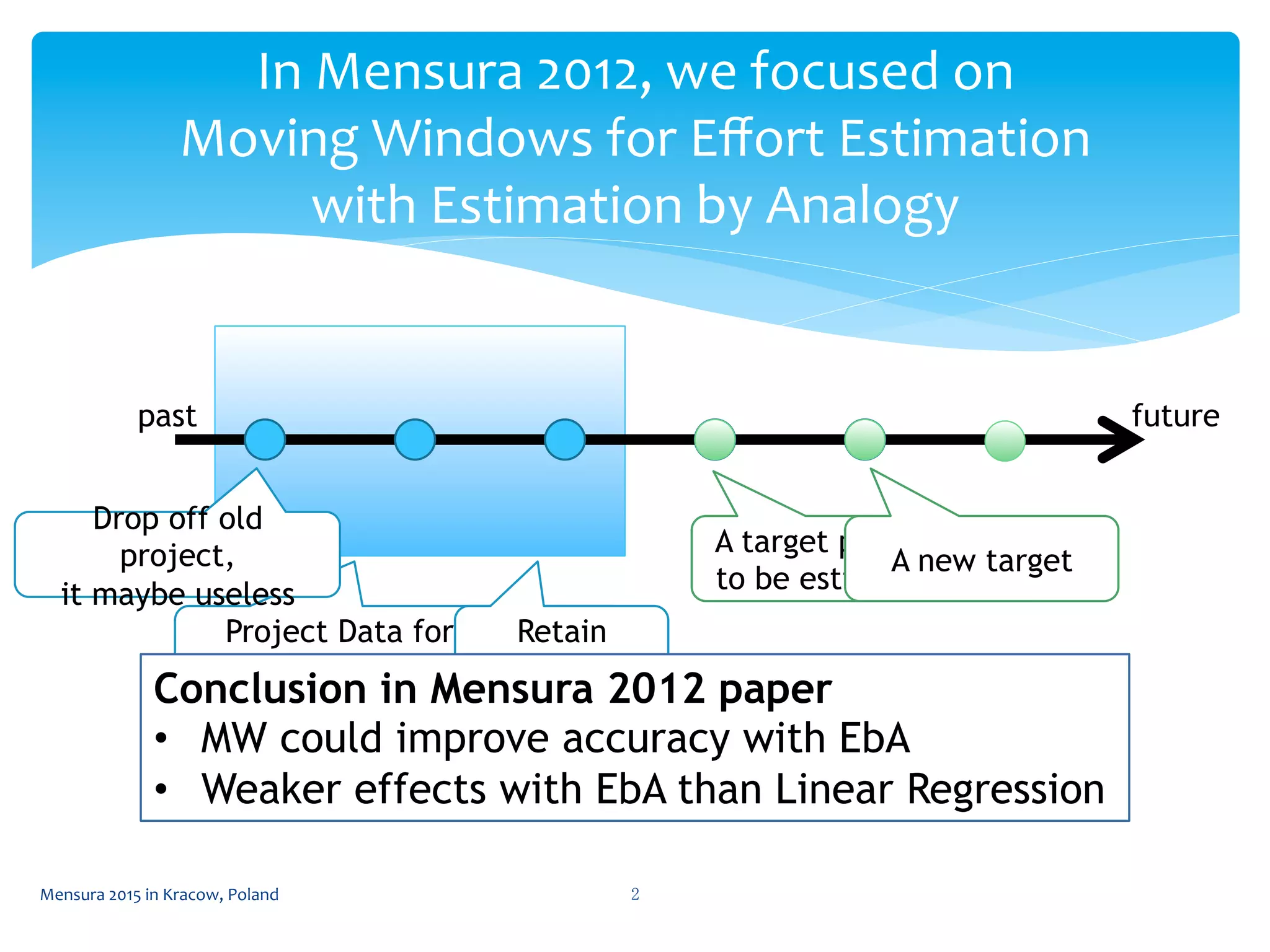

In
  Mensura
  2012,
  we
  focused
  on

Moving
  Windows
  for
  Effort
  Estimation

with
  Estimation
  by
  Analogy

2
 Mensura
  2015
  in
  Kracow,
  Poland

Project Data for Training
EbA Effort Estimation Model
A target project
to be estimated

Drop off old
project,
it maybe useless

Retain
Window Size

A new target

past
 future
Conclusion in Mensura 2012 paper
•  MW could improve accuracy with EbA
•  Weaker effects with EbA than Linear Regression
Window
  policies
  matter

3

p  MW
  was
  examined
  with
  LR
  and
  two
  policies
  [IST2014]*

p  Fixed-­‐size

p Retain
  N
  projects
  in
  a
  window

p  Fixed-­‐duration

p Retain
  projects
  within
  N
  months

p  Results
  show
  the
  difference
  in
  accuracy
  improvement




  *
  C.
  Lokan,
  E.
  Mendes.
  Investigating
  the
  use
  of
  duration-­‐based
  moving
  windows
  to
  improve
  software
  effort
  prediction:
  A
  replicated
  study,

Information
  and
  Software
  Technology
  56(9)
  ,
  pp.
  1063–1075,
  2014.

Mensura
  2015
  in
  Kracow,
  Poland

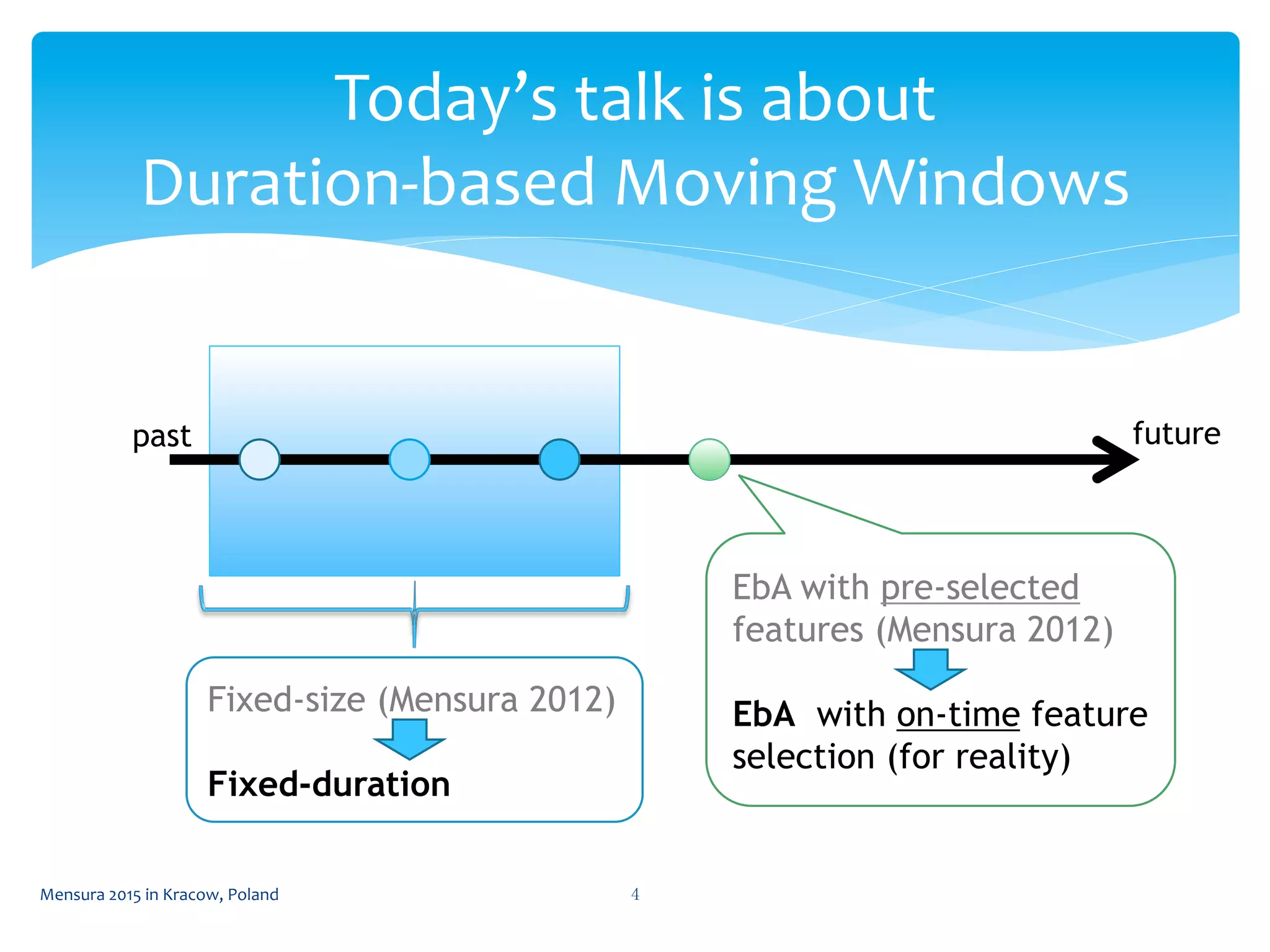

Today’s
  talk
  is
  about

Duration-­‐based
  Moving
  Windows

4
 Mensura
  2015
  in
  Kracow,
  Poland

past
 future
Fixed-size (Mensura 2012)
Fixed-duration
EbA with pre-selected
features (Mensura 2012)
EbA with on-time feature
selection (for reality)
Research
  Questions

5
 Mensura
  2015
  in
  Kracow,
  Poland

Is
  there
  a
  difference
  in
  the
  accuracy
  of
  estimates
  between
  EbA

with
  pre-­‐
  and
  on-­‐time
  selections
  using
  fixed-­‐size
  windows?

RQ1. Reconfirmation of Mensura 2012 results

Is
  there
  a
  difference
  in
  the
  accuracy
  of
  estimates

with
  and
  without
  MW
  with
  the
  revised
  EbA
  and
  fixed
  duration
  windows?

RQ2. Evaluation of Fixed-Duration Windows

RQ3. Comparison between window policies

How
  do
  these
  results
  compare
  with
  results
  based
  on
  fixed-­‐size
  windows?

The

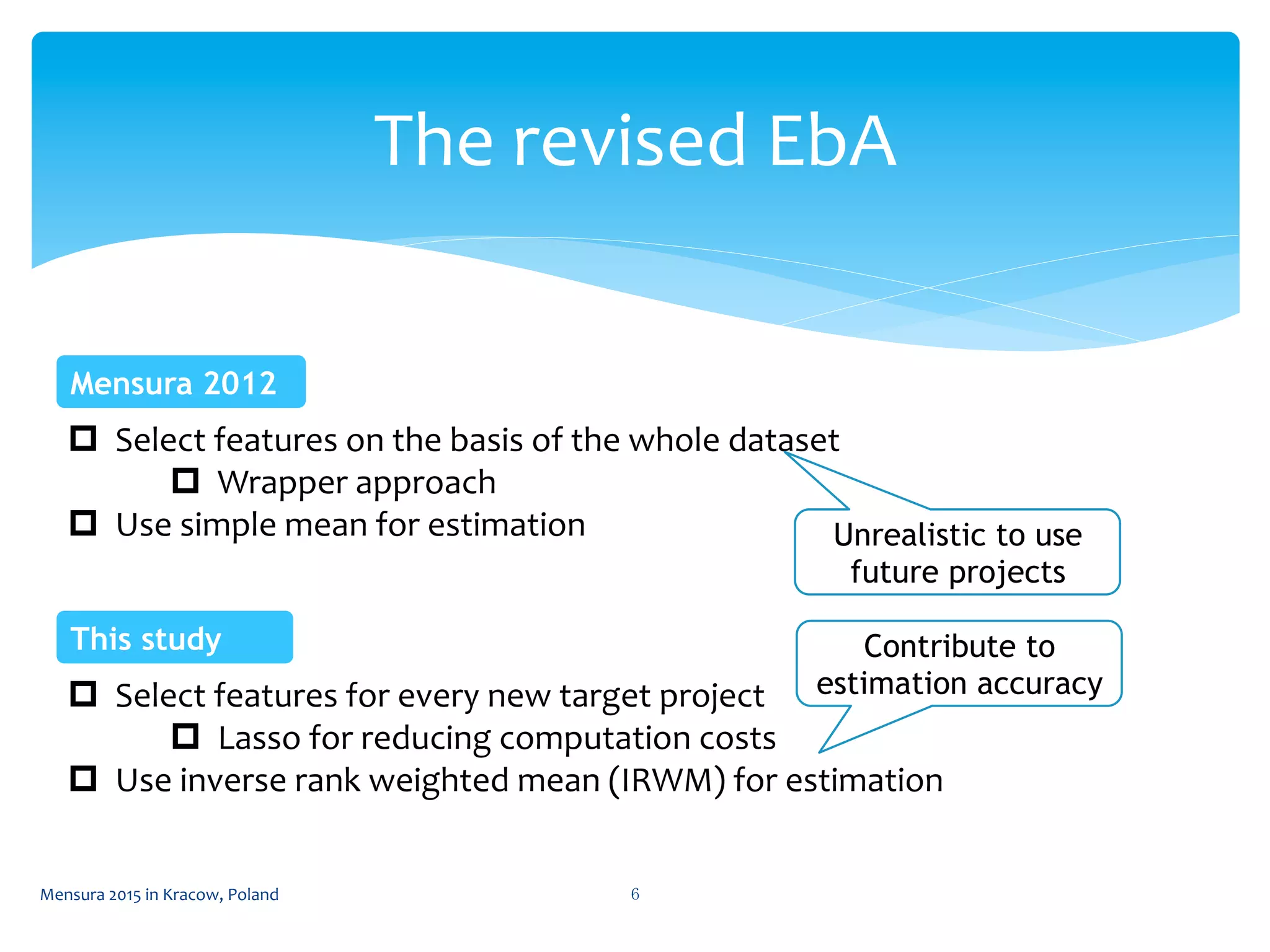

  revised
  EbA

Mensura
  2015
  in
  Kracow,
  Poland
  6

p  Select
  features
  on
  the
  basis
  of
  the
  whole
  dataset

p  Wrapper
  approach

p  Use
  simple
  mean
  for
  estimation

Mensura 2012

p  Select
  features
  for
  every
  new
  target
  project

p  Lasso
  for
  reducing
  computation
  costs

p  Use
  inverse
  rank
  weighted
  mean
  (IRWM)
  for
  estimation

This study

Unrealistic to use
future projects

Contribute to
estimation accuracy

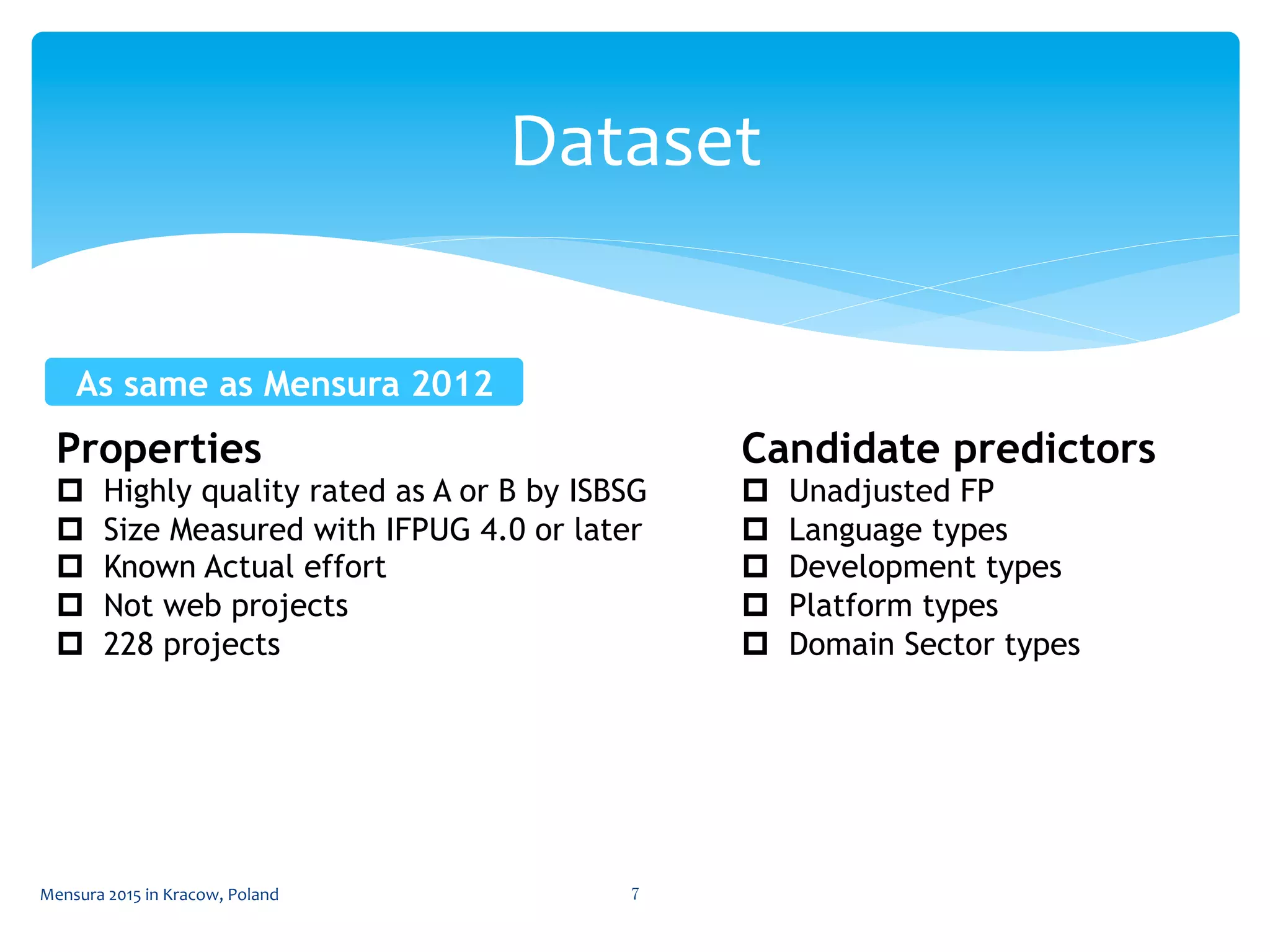

Dataset

Mensura
  2015
  in
  Kracow,
  Poland
  7

Properties
p  Highly quality rated as A or B by ISBSG
p  Size Measured with IFPUG 4.0 or later
p  Known Actual effort
p  Not web projects
p  228 projects
Candidate predictors
p  Unadjusted FP
p  Language types
p  Development types
p  Platform types
p  Domain Sector types
As same as Mensura 2012

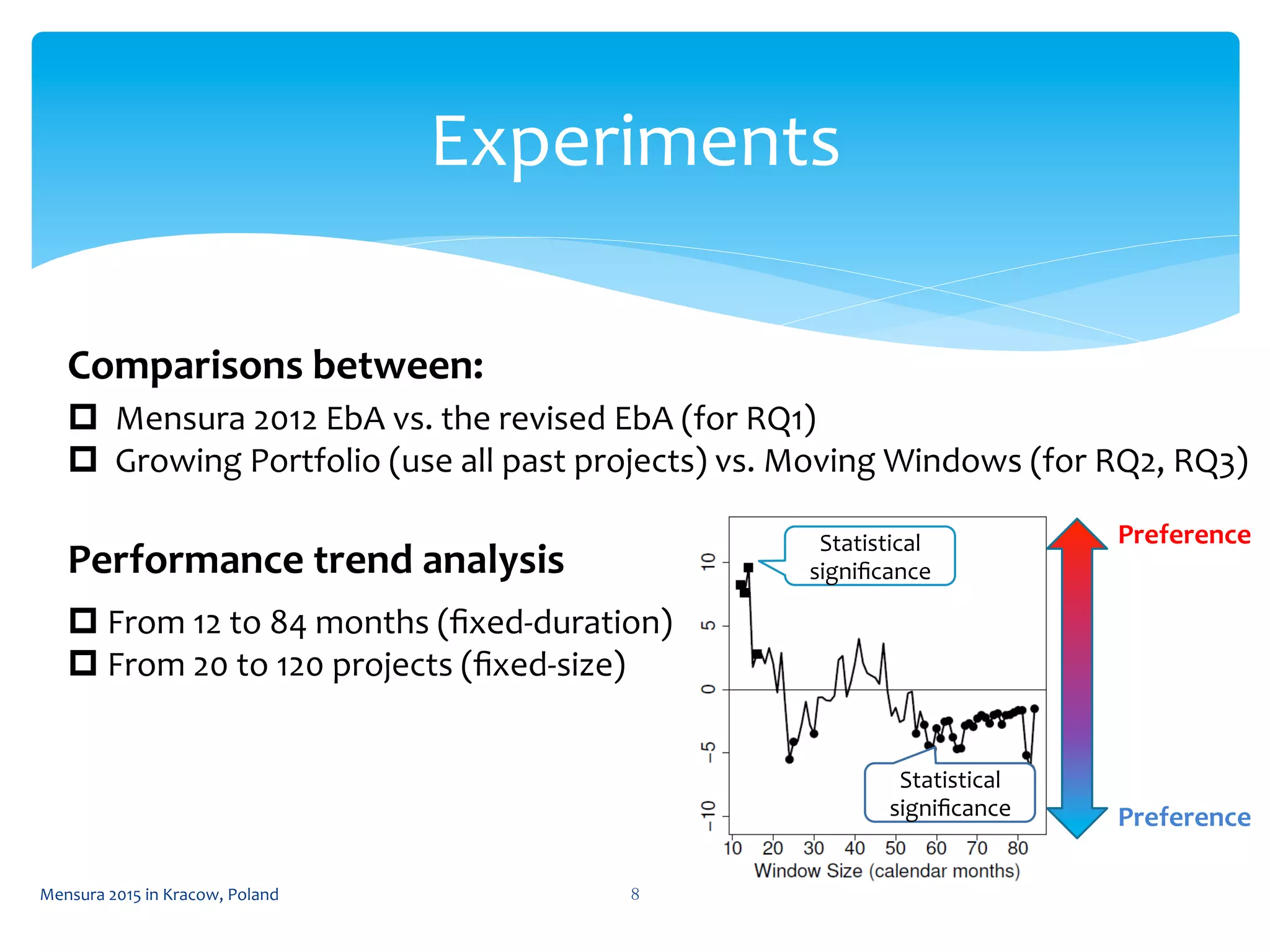

Experiments

Mensura
  2015
  in
  Kracow,
  Poland
  8

p  Mensura
  2012
  EbA
  vs.
  the
  revised
  EbA
  (for
  RQ1)

p  Growing
  Portfolio
  (use
  all
  past
  projects)
  vs.
  Moving
  Windows
  (for
  RQ2,
  RQ3)

Performance
  trend
  analysis

Preference
Preference
Statistical

significance

Statistical

significance

Comparisons
  between:
p From
  12
  to
  84
  months
  (fixed-­‐duration)

p From
  20
  to
  120
  projects
  (fixed-­‐size)

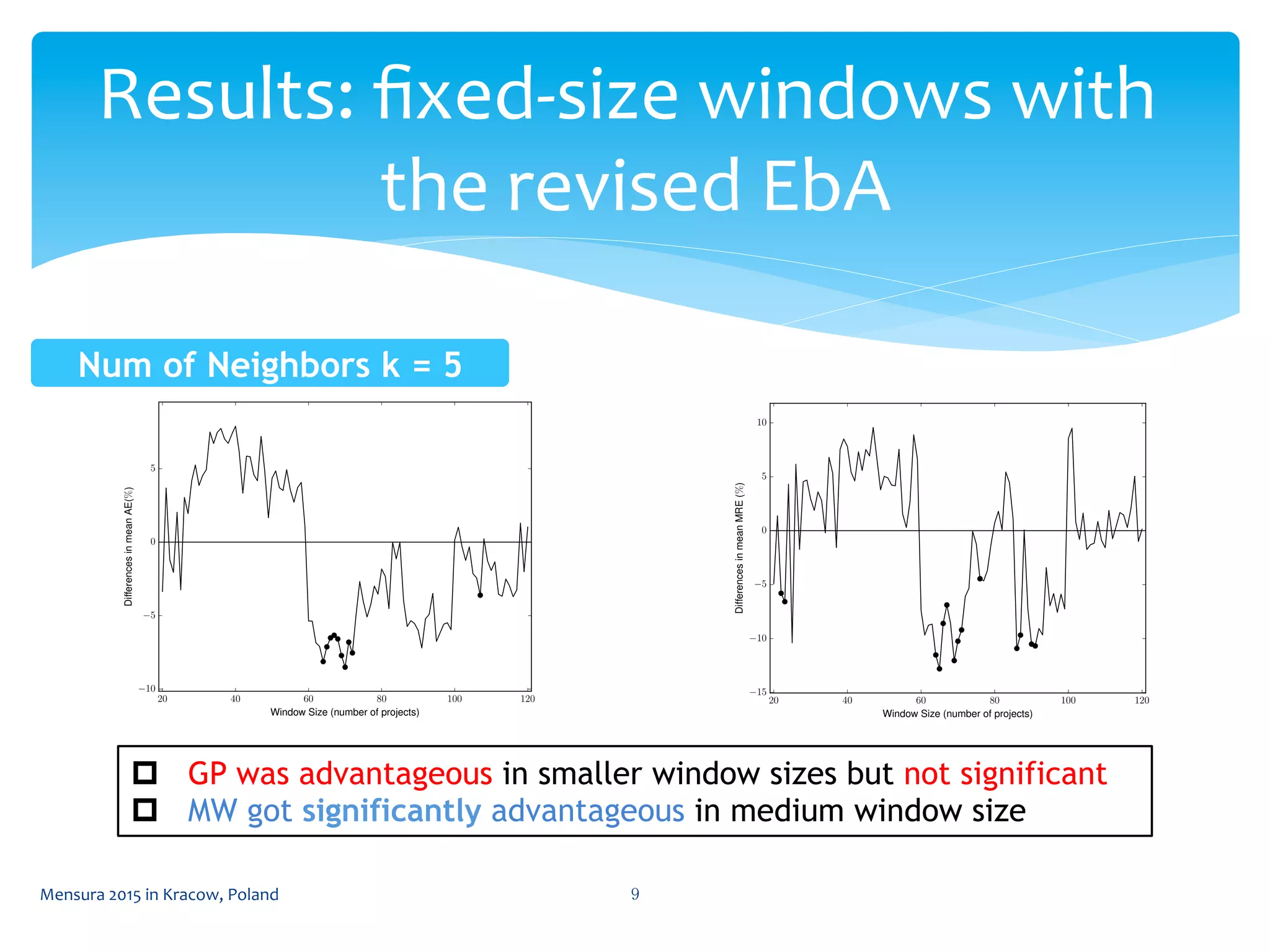

Results:
  fixed-­‐size
  windows
  with

the
  revised
  EbA

Mensura
  2015
  in
  Kracow,
  Poland
  9

8 Sousuke Amasaki and Chris Lokan
20 40 60 80 100 120
Window Size (number of projects)
10
5
0
5
DifferencesinmeanAE(%)
(a) Di↵erences in mean MAE
8 Sousuke Amasaki and Chris Lokan
(a) Di↵erences in mean MAE
20 40 60 80 100 120
Window Size (number of projects)
15
10
5
0
5
10
DifferencesinmeanMRE(%) (b) Di↵erences in mean MRE
Fig. 1: Results with Fixed-size Window, modified EbA with k = 5
Figure 1 and Table 2 revealed characteristics of moving windows compared
to the growing portfolio:
– With windows of up to 60 projects, MAE showed no significant preference
for any approach. The line starts below zero and quickly goes above zero
(favoring the growing portfolio), but the di↵erence was not significant as shown
p  GP was advantageous in smaller window sizes but not significant
p  MW got significantly advantageous in medium window size
Num of Neighbors k = 5

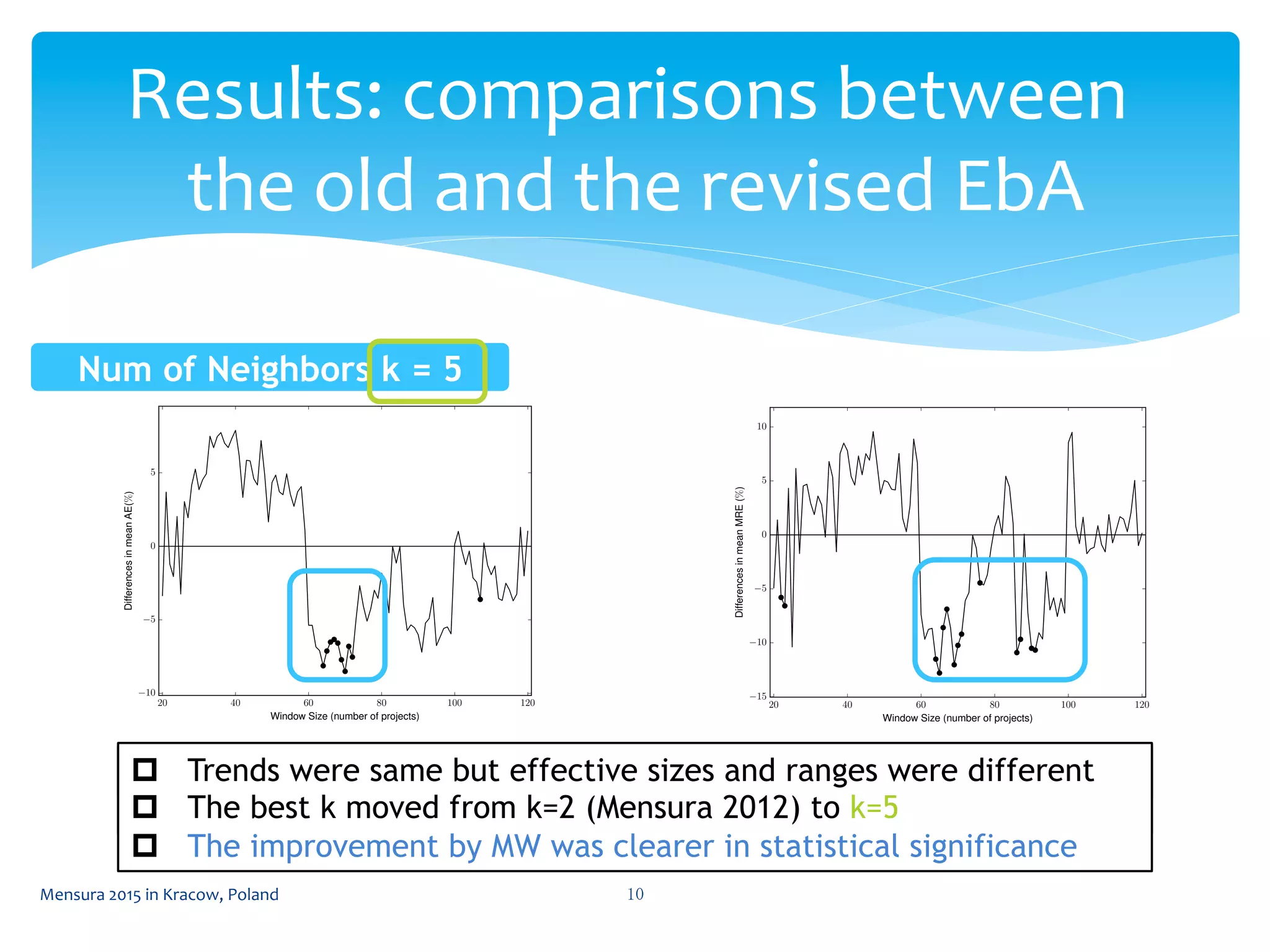

Results:
  comparisons
  between

the
  old
  and
  the
  revised
  EbA

Mensura
  2015
  in
  Kracow,
  Poland
  10

8 Sousuke Amasaki and Chris Lokan
20 40 60 80 100 120
Window Size (number of projects)
10
5
0
5
DifferencesinmeanAE(%)
(a) Di↵erences in mean MAE
8 Sousuke Amasaki and Chris Lokan
(a) Di↵erences in mean MAE
20 40 60 80 100 120
Window Size (number of projects)
15
10
5
0
5
10
DifferencesinmeanMRE(%)
(b) Di↵erences in mean MRE
Fig. 1: Results with Fixed-size Window, modified EbA with k = 5
Figure 1 and Table 2 revealed characteristics of moving windows compared
to the growing portfolio:
– With windows of up to 60 projects, MAE showed no significant preference
for any approach. The line starts below zero and quickly goes above zero
(favoring the growing portfolio), but the di↵erence was not significant as shown
Num of Neighbors k = 5

p  Trends were same but effective sizes and ranges were differentp  Trends were same but effective sizes and ranges were different
p  The best k moved from k=2 (Mensura 2012) to k=5
p  Trends were same but effective sizes and ranges were different
p  The best k moved from k=2 (Mensura 2012) to k=5
p  The improvement by MW was clearer in statistical significance
Results:

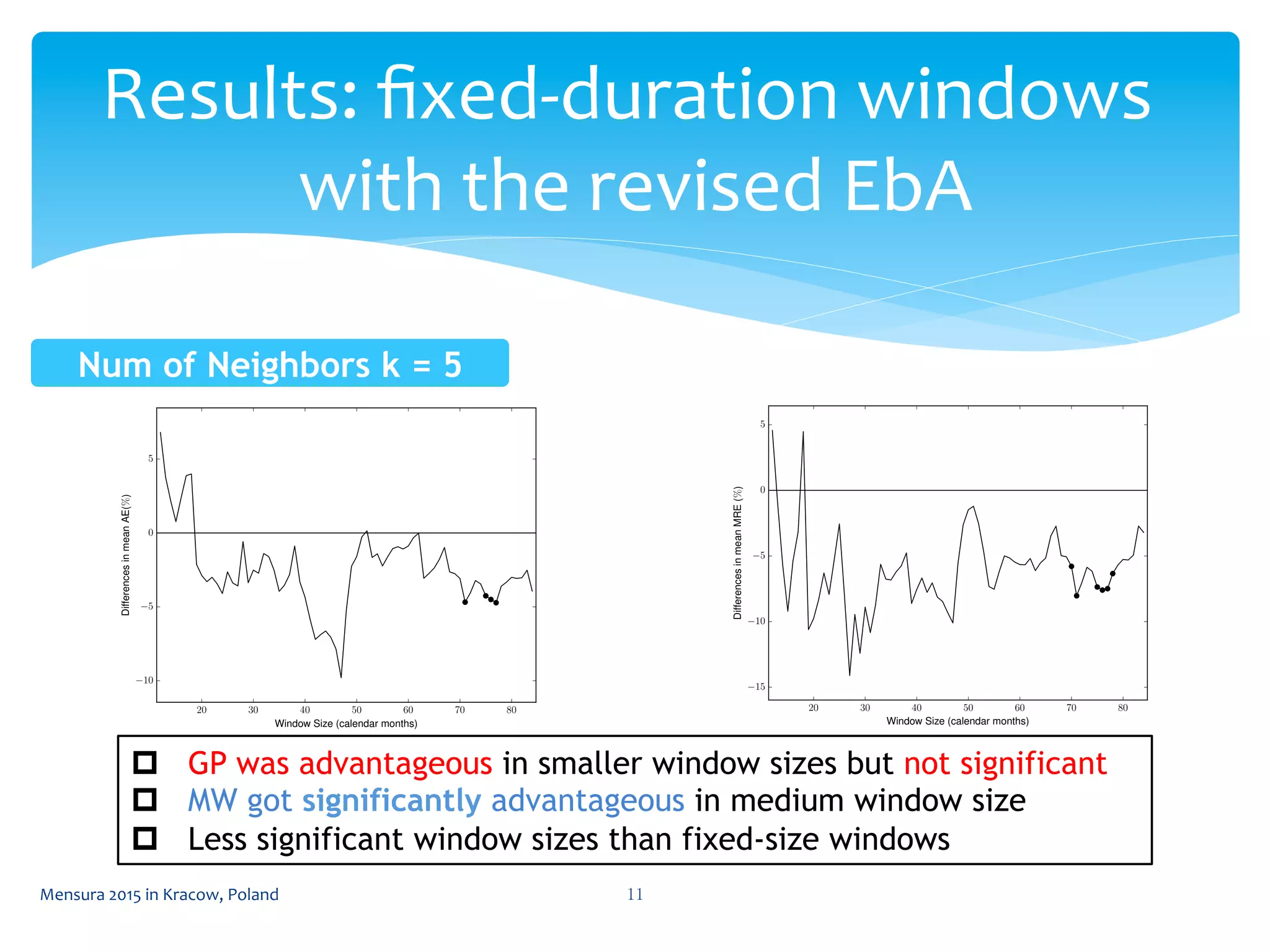

  fixed-­‐duration
  windows

with
  the
  revised
  EbA

Mensura
  2015
  in
  Kracow,
  Poland
  11

12 Sousuke Amasaki and Chris Lokan
20 30 40 50 60 70 80
Window Size (calendar months)
10
5
0
5
DifferencesinmeanAE(%)
(a) Di↵erences in mean MAE
(a) Di↵erences in mean MAE
20 30 40 50 60 70 80
Window Size (calendar months)
15
10
5
0
5
DifferencesinmeanMRE(%)
(b) Di↵erences in mean MRE
Fig. 2: Results with Fixed-duration Windows, EbA with k = 5
growing portfolio are larger with EbA than with LR, and the range of durations
for which windows are advantageous is narrower with EbA than with LR. The
di↵erence in advantageous window sizes and their number between EbA and
LR were reported in [4]. These observations were common between this study
and [4].
p  GP was advantageous in smaller window sizes but not significant
p  MW got significantly advantageous in medium window size
p  Less significant window sizes than fixed-size windows
Num of Neighbors k = 5
Results:

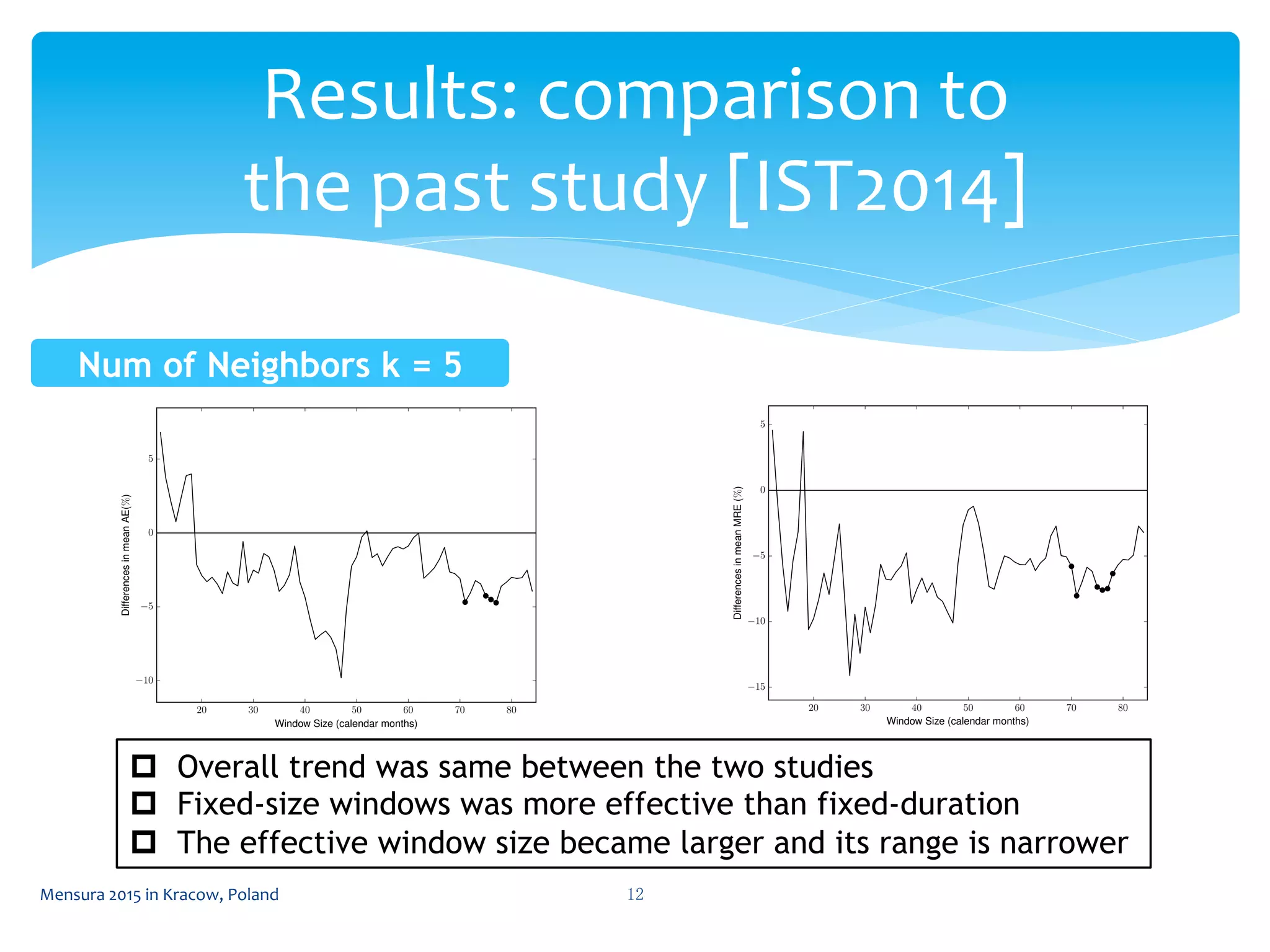

  comparison
  to

the
  past
  study
  [IST2014]

Mensura
  2015
  in
  Kracow,
  Poland
  12

12 Sousuke Amasaki and Chris Lokan
20 30 40 50 60 70 80
Window Size (calendar months)
10
5
0
5
DifferencesinmeanAE(%)
(a) Di↵erences in mean MAE
(a) Di↵erences in mean MAE
20 30 40 50 60 70 80
Window Size (calendar months)
15
10
5
0
5
DifferencesinmeanMRE(%)
(b) Di↵erences in mean MRE
Fig. 2: Results with Fixed-duration Windows, EbA with k = 5
growing portfolio are larger with EbA than with LR, and the range of durations
for which windows are advantageous is narrower with EbA than with LR. The
di↵erence in advantageous window sizes and their number between EbA and
LR were reported in [4]. These observations were common between this study
and [4].
Num of Neighbors k = 5

p  Overall trend was same between the two studies
p  Fixed-size windows was more effective than fixed-duration
p  The effective window size became larger and its range is narrower
Answers
  to
  RQs

13
 Mensura
  2015
  in
  Kracow,
  Poland

The
  change
  in
  estimation
  method
  made
  a
  difference,
  improving

the
  accuracy
  of
  estimates.

RQ1. Reconfirmation of Mensura 2012 results

The
  fixed-­‐duration
  windows
  can
  make
  a
  difference,
  and
  effective

to
  improve
  estimation
  accuracy.

RQ2. Evaluation of Fixed-Duration Windows

RQ3. Comparison between window policies

The
  fixed-­‐size
  and
  fixed-­‐duration
  window
  policies
  can
  lead
  to
  significantly

better
  estimation
  accuracy.
  But
  fixed-­‐size
  made
  clearer
  difference.

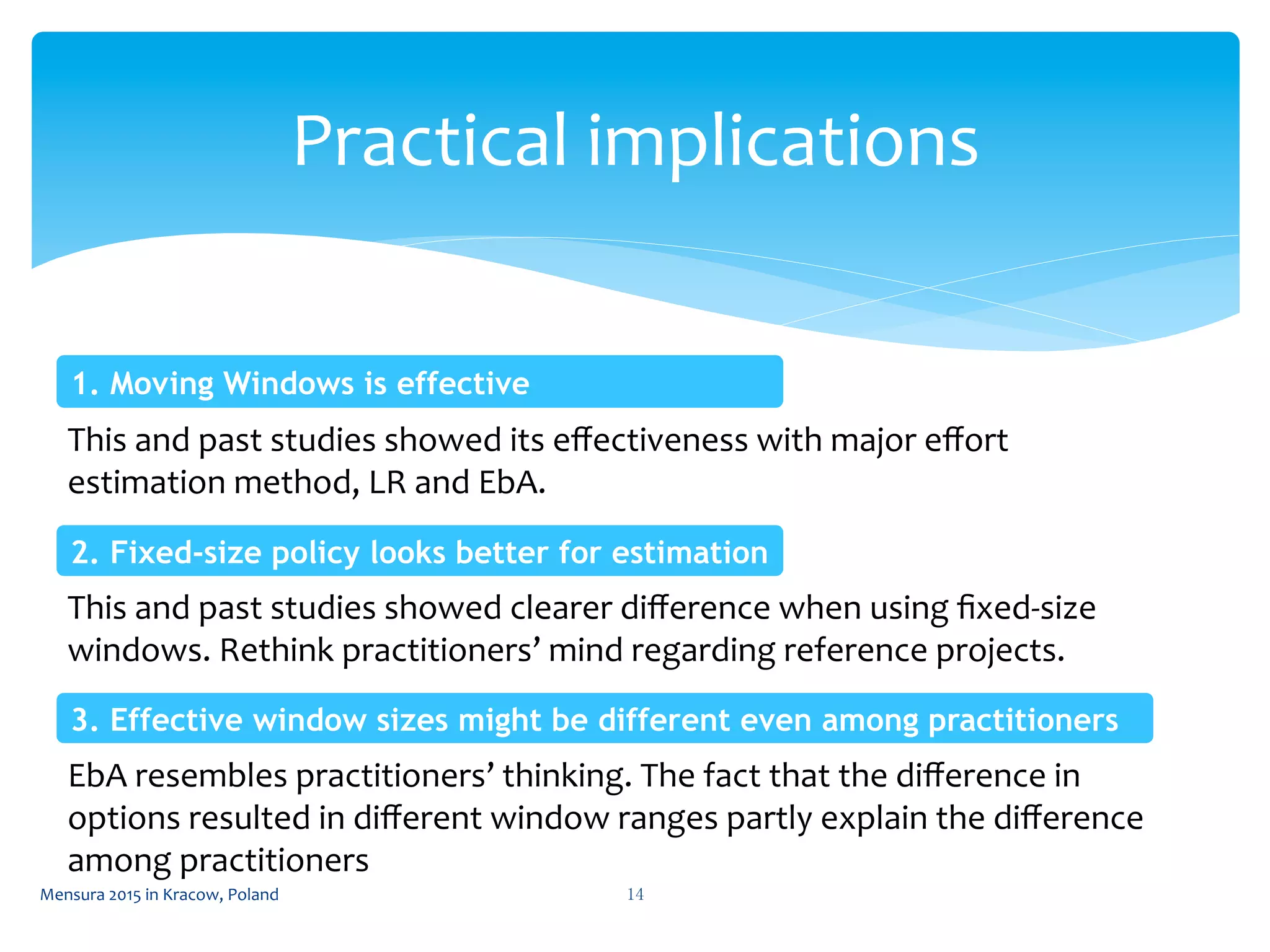

Practical
  implications

14
 Mensura
  2015
  in
  Kracow,
  Poland

This
  and
  past
  studies
  showed
  its
  effectiveness
  with
  major
  effort

estimation
  method,
  LR
  and
  EbA.

1. Moving Windows is effective

This
  and
  past
  studies
  showed
  clearer
  difference
  when
  using
  fixed-­‐size

windows.
  Rethink
  practitioners’
  mind
  regarding
  reference
  projects.

2. Fixed-size policy looks better for estimation

3. Effective window sizes might be different even among practitioners

EbA
  resembles
  practitioners’
  thinking.
  The
  fact
  that
  the
  difference
  in

options
  resulted
  in
  different
  window
  ranges
  partly
  explain
  the
  difference

among
  practitioners

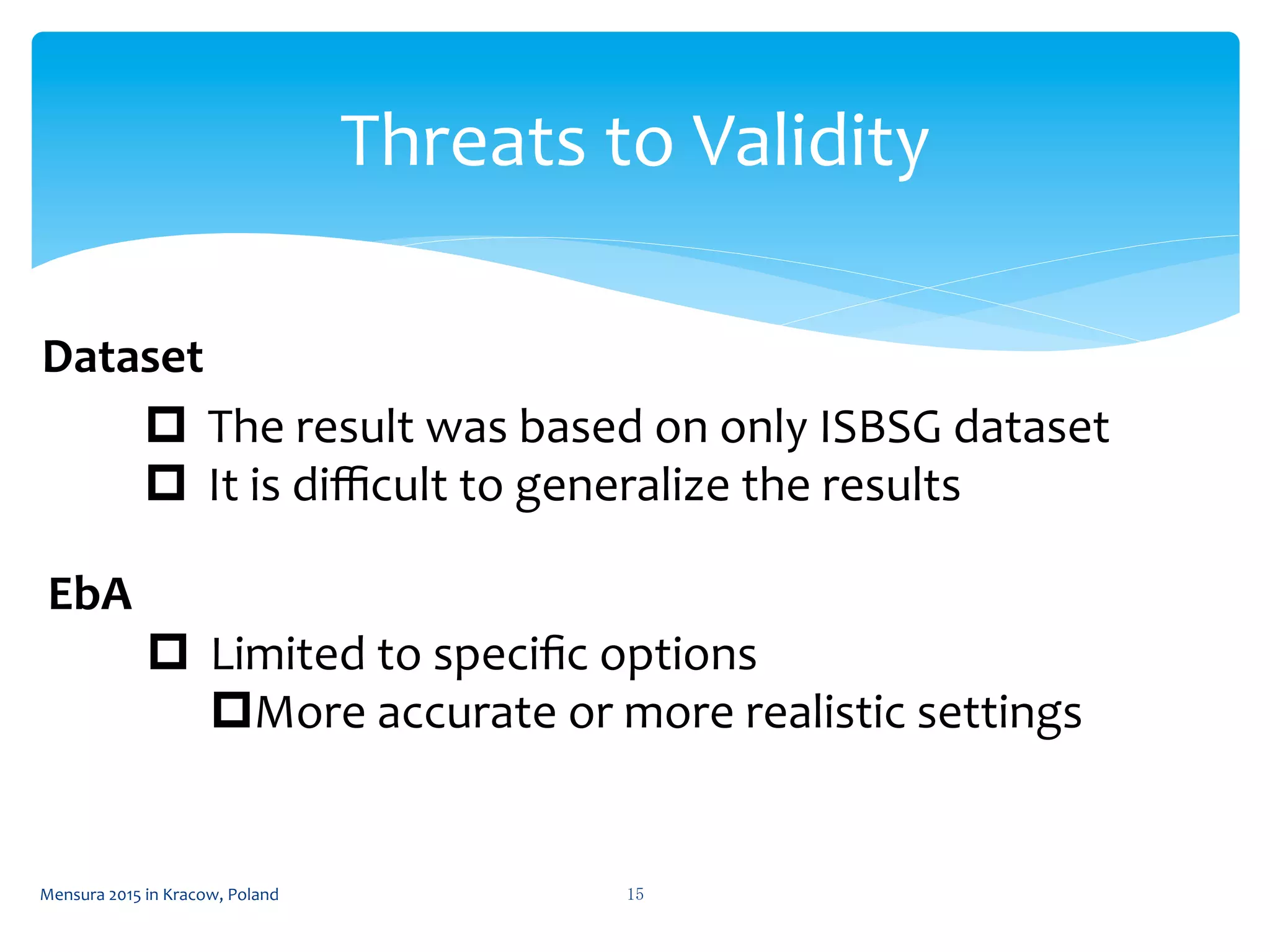

Threats
  to
  Validity

Mensura
  2015
  in
  Kracow,
  Poland
  15

p  The
  result
  was
  based
  on
  only
  ISBSG
  dataset

p  It
  is
  difficult
  to
  generalize
  the
  results

Dataset

EbA

p  Limited
  to
  specific
  options

p More
  accurate
  or
  more
  realistic
  settings

Conclusion

p  Fixed-­‐duration
  windows
  works
  with
  EbA

p  Under
  more
  realistic
  situation

p  The
  results
  brought
  some
  practical
  implications

p  ex.
  Fixed-­‐size
  policy
  is
  more
  suitable

p  Exploration
  of
  EbA
  options

p  Additional
  experiments
  on
  other
  datasets

16
 Mensura
  2015
  in
  Kracow,
  Poland

Future Work
Mensura
  2015
  in
  Kracow,
  Poland
  17

We
  welcome
  questions
  !

Sousuke
  Amasaki:
  amasaki@cse.oka-­‐pu.ac.jp












  Chris
  Lokan:
  c.lokan@adfa.edu.au

Contact
  info:


The effects of duration based moving windows with estimation by analogy - sousouke amasaki

  • 1.
    The  Effects  of   Duration-­‐based  Moving  Windows   with   Estimation  by  Analogy Sousuke  Amasaki*   Chris  Lokan†     Okayama  Prefectural  University*   UNSW  Canberra† Mensura  2015  in  Kracow,  Poland 1
  • 2.
    In  Mensura  2012,  we  focused  on   Moving  Windows  for  Effort  Estimation   with  Estimation  by  Analogy 2 Mensura  2015  in  Kracow,  Poland Project Data for Training EbA Effort Estimation Model A target project to be estimated Drop off old project, it maybe useless Retain Window Size A new target past future Conclusion in Mensura 2012 paper •  MW could improve accuracy with EbA •  Weaker effects with EbA than Linear Regression
  • 3.
    Window  policies  matter 3 p  MW  was  examined  with  LR  and  two  policies  [IST2014]*   p  Fixed-­‐size   p Retain  N  projects  in  a  window   p  Fixed-­‐duration   p Retain  projects  within  N  months   p  Results  show  the  difference  in  accuracy  improvement        *  C.  Lokan,  E.  Mendes.  Investigating  the  use  of  duration-­‐based  moving  windows  to  improve  software  effort  prediction:  A  replicated  study,   Information  and  Software  Technology  56(9)  ,  pp.  1063–1075,  2014.   Mensura  2015  in  Kracow,  Poland
  • 4.
    Today’s  talk  is  about   Duration-­‐based  Moving  Windows 4 Mensura  2015  in  Kracow,  Poland past future Fixed-size (Mensura 2012) Fixed-duration EbA with pre-selected features (Mensura 2012) EbA with on-time feature selection (for reality)
  • 5.
    Research  Questions 5 Mensura  2015  in  Kracow,  Poland Is  there  a  difference  in  the  accuracy  of  estimates  between  EbA   with  pre-­‐  and  on-­‐time  selections  using  fixed-­‐size  windows?   RQ1. Reconfirmation of Mensura 2012 results Is  there  a  difference  in  the  accuracy  of  estimates   with  and  without  MW  with  the  revised  EbA  and  fixed  duration  windows?   RQ2. Evaluation of Fixed-Duration Windows RQ3. Comparison between window policies How  do  these  results  compare  with  results  based  on  fixed-­‐size  windows?
  • 6.
    The  revised  EbA Mensura  2015  in  Kracow,  Poland 6 p  Select  features  on  the  basis  of  the  whole  dataset   p  Wrapper  approach   p  Use  simple  mean  for  estimation   Mensura 2012 p  Select  features  for  every  new  target  project   p  Lasso  for  reducing  computation  costs   p  Use  inverse  rank  weighted  mean  (IRWM)  for  estimation   This study Unrealistic to use future projects Contribute to estimation accuracy
  • 7.
    Dataset Mensura  2015  in  Kracow,  Poland 7 Properties p  Highly quality rated as A or B by ISBSG p  Size Measured with IFPUG 4.0 or later p  Known Actual effort p  Not web projects p  228 projects Candidate predictors p  Unadjusted FP p  Language types p  Development types p  Platform types p  Domain Sector types As same as Mensura 2012
  • 8.
    Experiments Mensura  2015  in  Kracow,  Poland 8 p  Mensura  2012  EbA  vs.  the  revised  EbA  (for  RQ1)   p  Growing  Portfolio  (use  all  past  projects)  vs.  Moving  Windows  (for  RQ2,  RQ3)   Performance  trend  analysis   Preference Preference Statistical   significance Statistical   significance Comparisons  between: p From  12  to  84  months  (fixed-­‐duration)   p From  20  to  120  projects  (fixed-­‐size)
  • 9.
    Results:  fixed-­‐size  windows  with   the  revised  EbA Mensura  2015  in  Kracow,  Poland 9 8 Sousuke Amasaki and Chris Lokan 20 40 60 80 100 120 Window Size (number of projects) 10 5 0 5 DifferencesinmeanAE(%) (a) Di↵erences in mean MAE 8 Sousuke Amasaki and Chris Lokan (a) Di↵erences in mean MAE 20 40 60 80 100 120 Window Size (number of projects) 15 10 5 0 5 10 DifferencesinmeanMRE(%) (b) Di↵erences in mean MRE Fig. 1: Results with Fixed-size Window, modified EbA with k = 5 Figure 1 and Table 2 revealed characteristics of moving windows compared to the growing portfolio: – With windows of up to 60 projects, MAE showed no significant preference for any approach. The line starts below zero and quickly goes above zero (favoring the growing portfolio), but the di↵erence was not significant as shown p  GP was advantageous in smaller window sizes but not significant p  MW got significantly advantageous in medium window size Num of Neighbors k = 5
  • 10.
    Results:  comparisons  between   the  old  and  the  revised  EbA Mensura  2015  in  Kracow,  Poland 10 8 Sousuke Amasaki and Chris Lokan 20 40 60 80 100 120 Window Size (number of projects) 10 5 0 5 DifferencesinmeanAE(%) (a) Di↵erences in mean MAE 8 Sousuke Amasaki and Chris Lokan (a) Di↵erences in mean MAE 20 40 60 80 100 120 Window Size (number of projects) 15 10 5 0 5 10 DifferencesinmeanMRE(%) (b) Di↵erences in mean MRE Fig. 1: Results with Fixed-size Window, modified EbA with k = 5 Figure 1 and Table 2 revealed characteristics of moving windows compared to the growing portfolio: – With windows of up to 60 projects, MAE showed no significant preference for any approach. The line starts below zero and quickly goes above zero (favoring the growing portfolio), but the di↵erence was not significant as shown Num of Neighbors k = 5 p  Trends were same but effective sizes and ranges were differentp  Trends were same but effective sizes and ranges were different p  The best k moved from k=2 (Mensura 2012) to k=5 p  Trends were same but effective sizes and ranges were different p  The best k moved from k=2 (Mensura 2012) to k=5 p  The improvement by MW was clearer in statistical significance
  • 11.
    Results:  fixed-­‐duration  windows   with  the  revised  EbA Mensura  2015  in  Kracow,  Poland 11 12 Sousuke Amasaki and Chris Lokan 20 30 40 50 60 70 80 Window Size (calendar months) 10 5 0 5 DifferencesinmeanAE(%) (a) Di↵erences in mean MAE (a) Di↵erences in mean MAE 20 30 40 50 60 70 80 Window Size (calendar months) 15 10 5 0 5 DifferencesinmeanMRE(%) (b) Di↵erences in mean MRE Fig. 2: Results with Fixed-duration Windows, EbA with k = 5 growing portfolio are larger with EbA than with LR, and the range of durations for which windows are advantageous is narrower with EbA than with LR. The di↵erence in advantageous window sizes and their number between EbA and LR were reported in [4]. These observations were common between this study and [4]. p  GP was advantageous in smaller window sizes but not significant p  MW got significantly advantageous in medium window size p  Less significant window sizes than fixed-size windows Num of Neighbors k = 5
  • 12.
    Results:  comparison  to   the  past  study  [IST2014] Mensura  2015  in  Kracow,  Poland 12 12 Sousuke Amasaki and Chris Lokan 20 30 40 50 60 70 80 Window Size (calendar months) 10 5 0 5 DifferencesinmeanAE(%) (a) Di↵erences in mean MAE (a) Di↵erences in mean MAE 20 30 40 50 60 70 80 Window Size (calendar months) 15 10 5 0 5 DifferencesinmeanMRE(%) (b) Di↵erences in mean MRE Fig. 2: Results with Fixed-duration Windows, EbA with k = 5 growing portfolio are larger with EbA than with LR, and the range of durations for which windows are advantageous is narrower with EbA than with LR. The di↵erence in advantageous window sizes and their number between EbA and LR were reported in [4]. These observations were common between this study and [4]. Num of Neighbors k = 5 p  Overall trend was same between the two studies p  Fixed-size windows was more effective than fixed-duration p  The effective window size became larger and its range is narrower
  • 13.
    Answers  to  RQs 13 Mensura  2015  in  Kracow,  Poland The  change  in  estimation  method  made  a  difference,  improving   the  accuracy  of  estimates.   RQ1. Reconfirmation of Mensura 2012 results The  fixed-­‐duration  windows  can  make  a  difference,  and  effective   to  improve  estimation  accuracy.   RQ2. Evaluation of Fixed-Duration Windows RQ3. Comparison between window policies The  fixed-­‐size  and  fixed-­‐duration  window  policies  can  lead  to  significantly   better  estimation  accuracy.  But  fixed-­‐size  made  clearer  difference.
  • 14.
    Practical  implications 14 Mensura  2015  in  Kracow,  Poland This  and  past  studies  showed  its  effectiveness  with  major  effort   estimation  method,  LR  and  EbA.   1. Moving Windows is effective This  and  past  studies  showed  clearer  difference  when  using  fixed-­‐size   windows.  Rethink  practitioners’  mind  regarding  reference  projects.   2. Fixed-size policy looks better for estimation 3. Effective window sizes might be different even among practitioners EbA  resembles  practitioners’  thinking.  The  fact  that  the  difference  in   options  resulted  in  different  window  ranges  partly  explain  the  difference   among  practitioners
  • 15.
    Threats  to  Validity Mensura  2015  in  Kracow,  Poland 15 p  The  result  was  based  on  only  ISBSG  dataset   p  It  is  difficult  to  generalize  the  results   Dataset   EbA   p  Limited  to  specific  options   p More  accurate  or  more  realistic  settings
  • 16.
    Conclusion p  Fixed-­‐duration  windows  works  with  EbA   p  Under  more  realistic  situation   p  The  results  brought  some  practical  implications   p  ex.  Fixed-­‐size  policy  is  more  suitable   p  Exploration  of  EbA  options   p  Additional  experiments  on  other  datasets   16 Mensura  2015  in  Kracow,  Poland Future Work
  • 17.
    Mensura  2015  in  Kracow,  Poland 17 We  welcome  questions  !   Sousuke  Amasaki:  amasaki@cse.oka-­‐pu.ac.jp                        Chris  Lokan:  c.lokan@adfa.edu.au   Contact  info:
