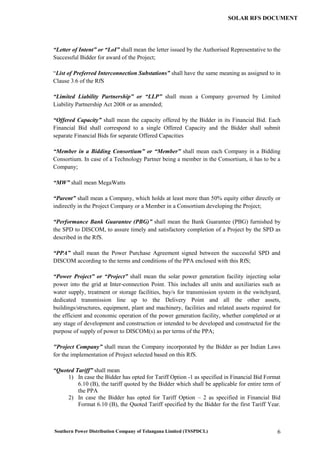

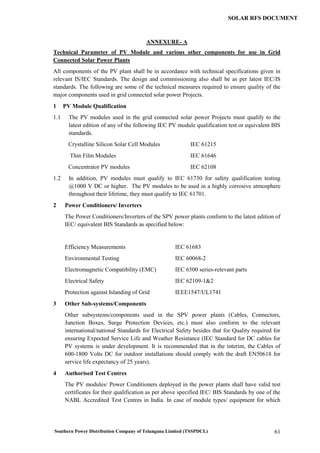

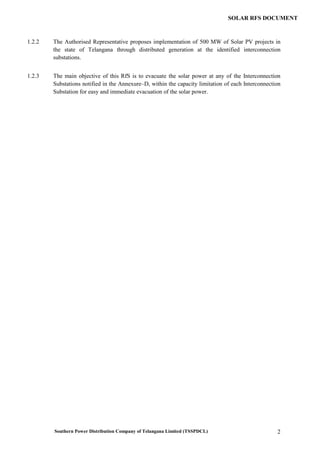

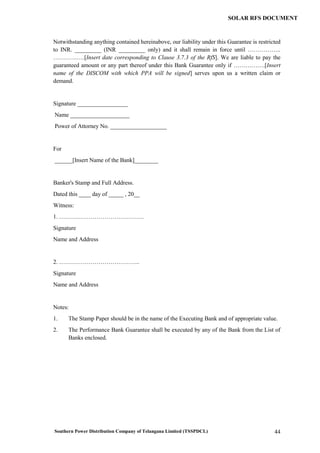

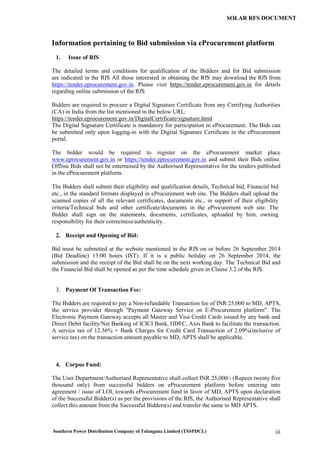

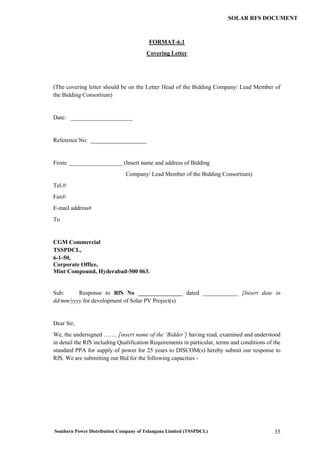

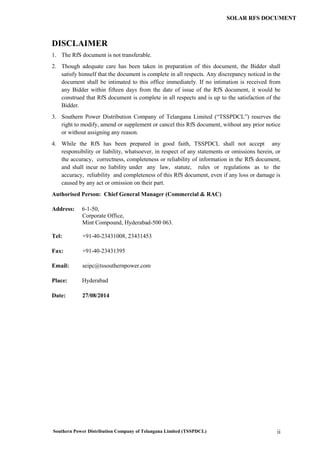

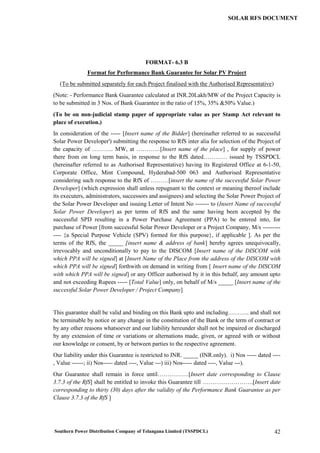

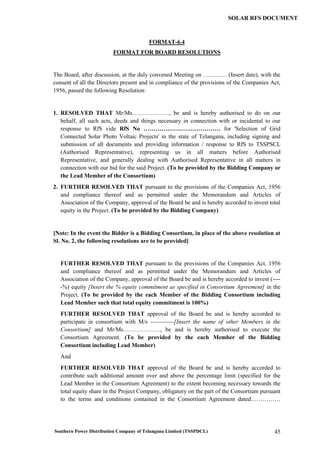

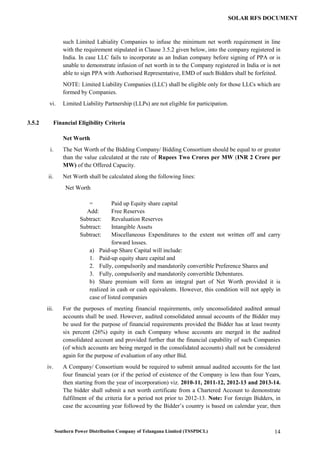

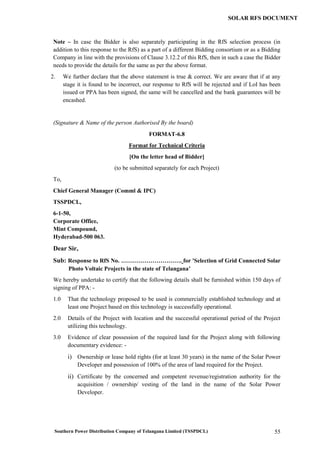

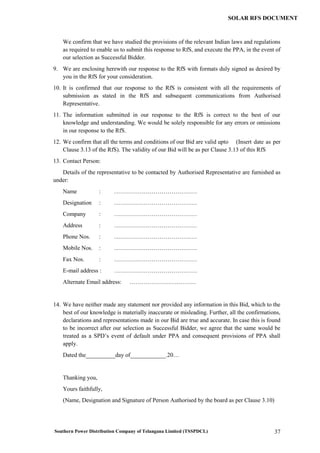

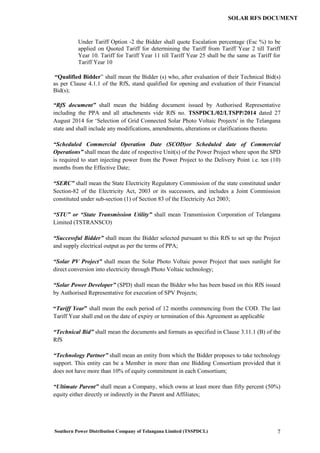

The document is a Request for Selection (RFS) from the Southern Power Distribution Company of Telangana Limited (TSSPDCL) for the procurement of 500 MW of solar power through a competitive bidding process, with a bid submission deadline of September 26, 2014. It outlines the bid submission requirements, including the need for digital signatures, transaction fees, and prequalification criteria, while specifying that all bids must be submitted online via the e-procurement platform. The document emphasizes the non-transferability of the RFS and TSSPDCL's authority to modify the terms without notice.
